Delay Analysis
……. wise after the Event?
Consilian
Building solutions for business problems

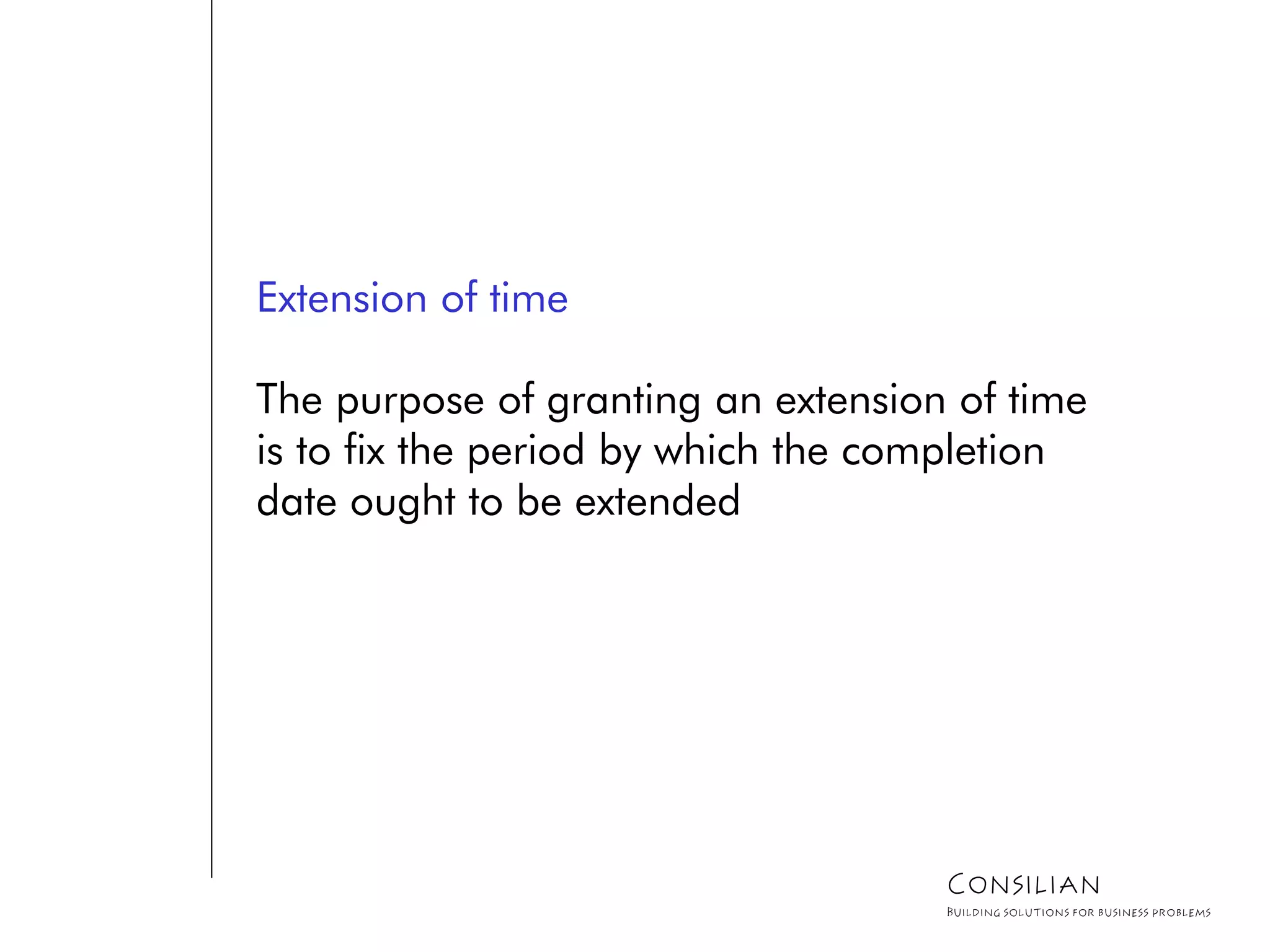

Extension of time
The purpose of granting an extension of time
is to fix the period by which the completion
date ought to be extended
Consilian
Building solutions for business problems

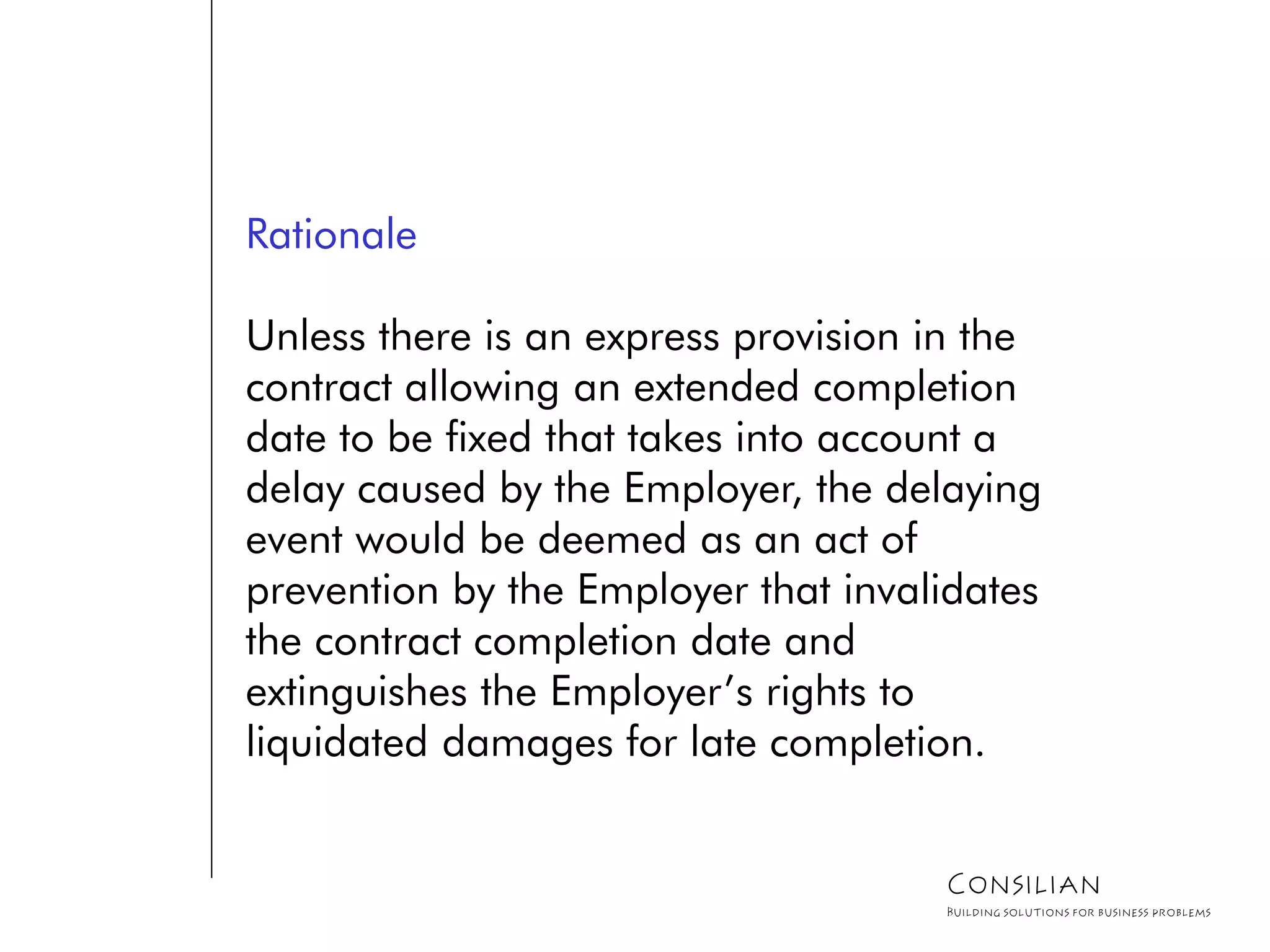

Rationale
Unless there is an express provision in the
contract allowing an extended completion
date to be fixed that takes into account a
delay caused by the Employer, the delaying
event would be deemed as an act of
prevention by the Employer that invalidates
the contract completion date and
extinguishes the Employer’s rights to
liquidated damages for late completion.
Consilian
Building solutions for business problems

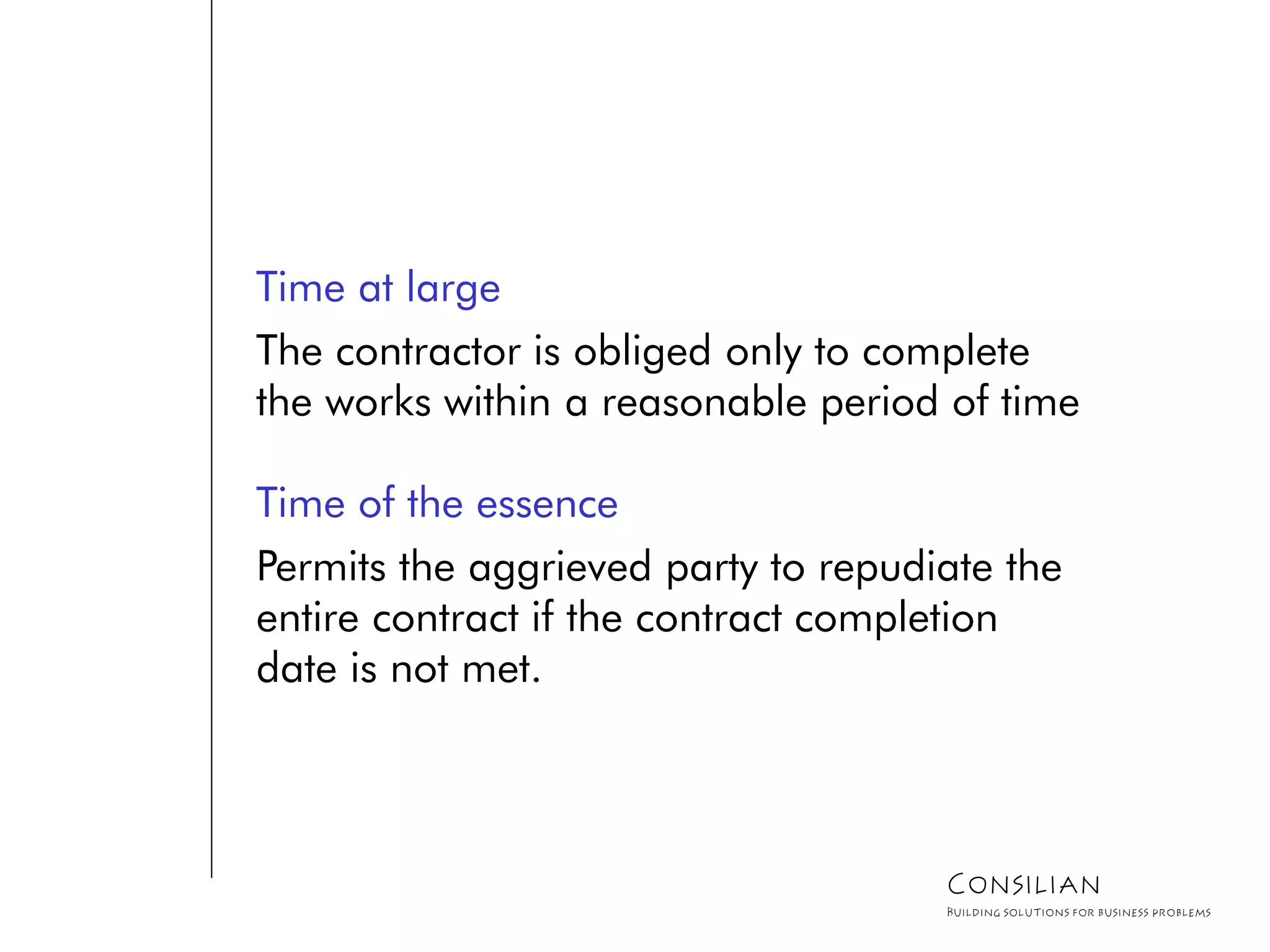

Time at large
The contractor is obliged only to complete
the works within a reasonable period of time
Time of the essence
Permits the aggrieved party to repudiate the
entire contract if the contract completion
date is not met.
Consilian
Building solutions for business problems
Peniffan
Management Ltd

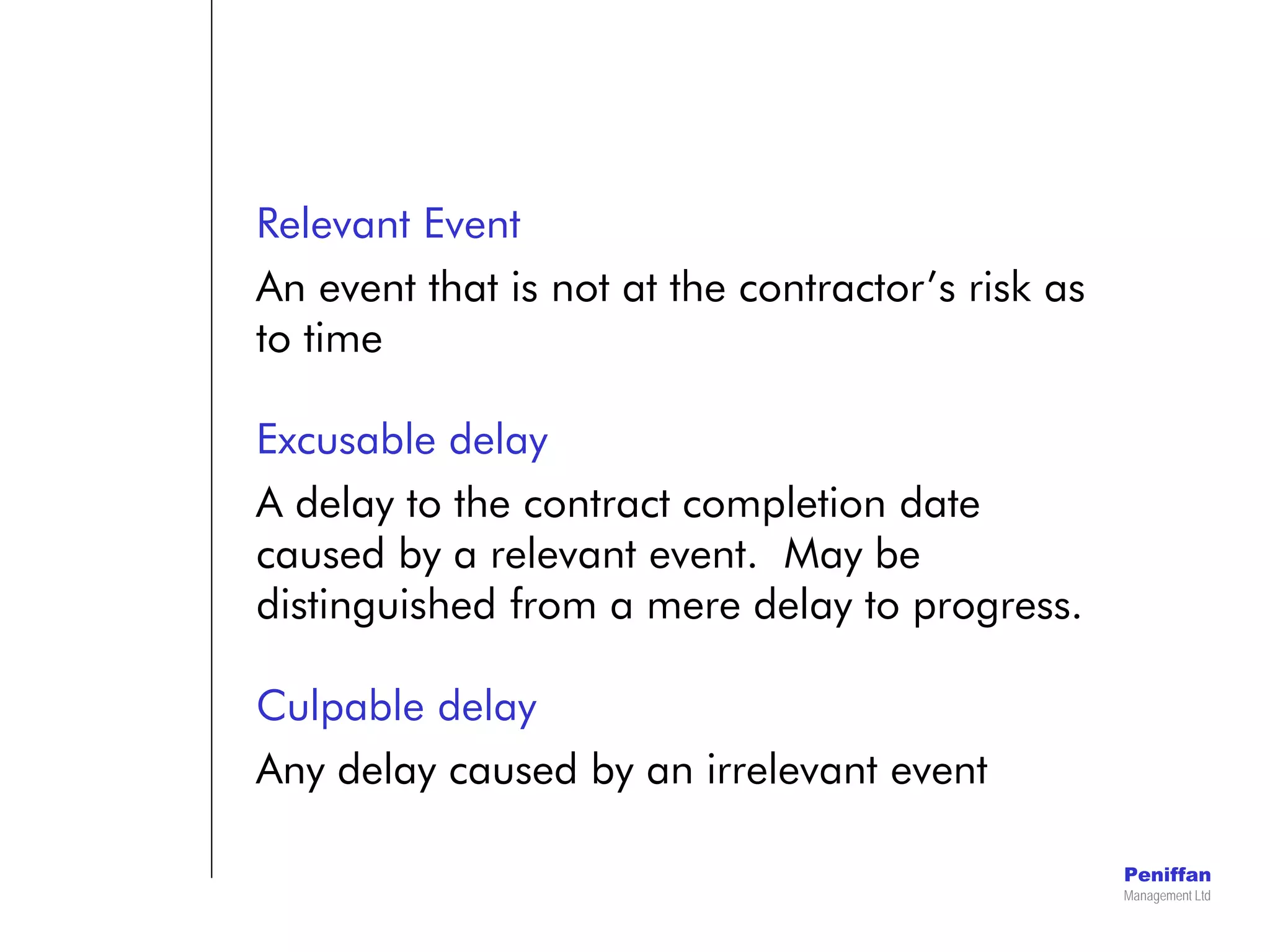

Relevant Event
An event that is not at the contractor’s risk as
to time
Excusable delay
A delay to the contract completion date
caused by a relevant event. May be
distinguished from a mere delay to progress.
Culpable delay
Any delay caused by an irrelevant event

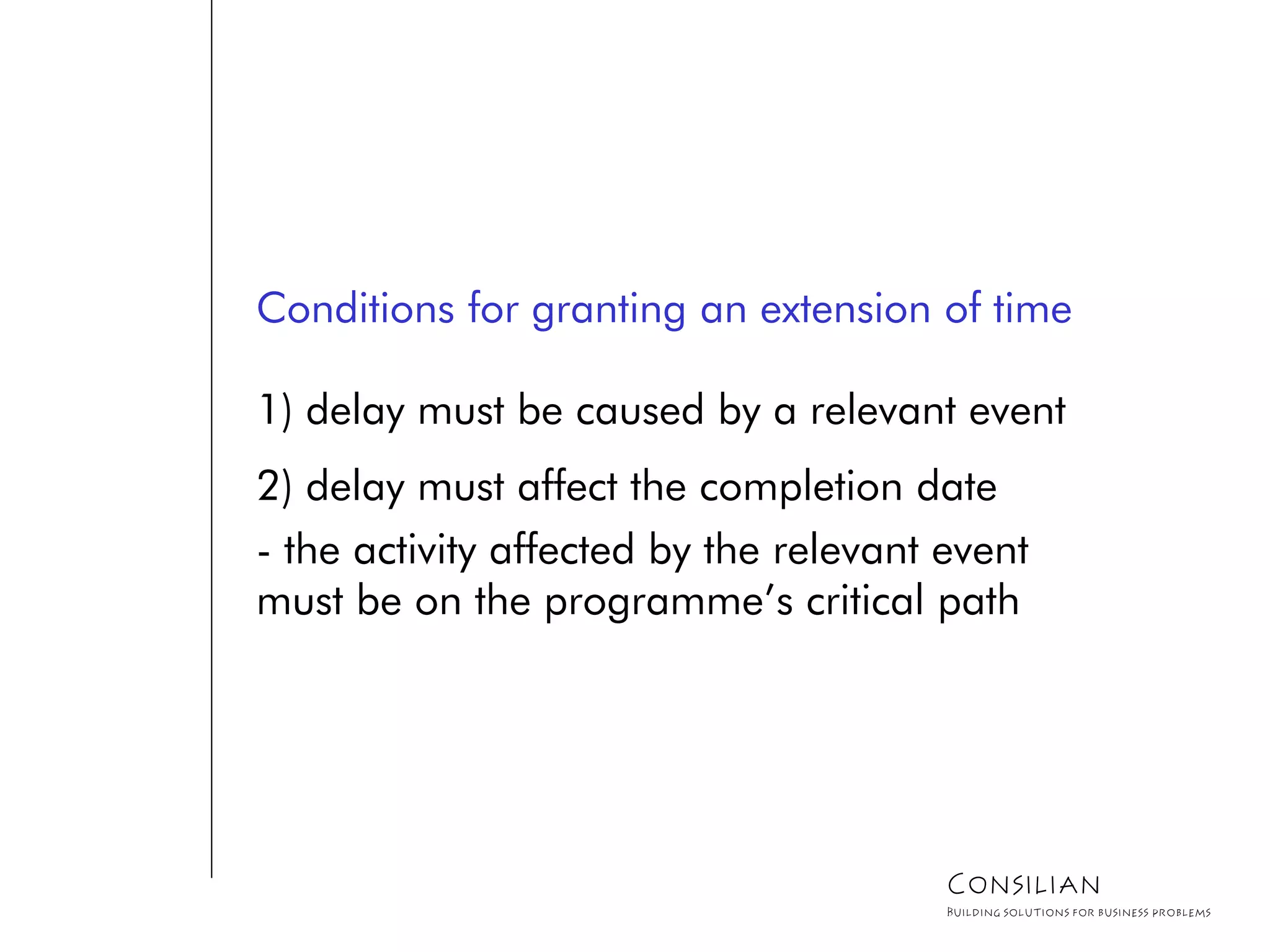

Conditions for granting an extension of time
1) delay must be caused by a relevant event
2) delay must affect the completion date
- the activity affected by the relevant event
must be on the programme’s critical path
Consilian
Building solutions for business problems

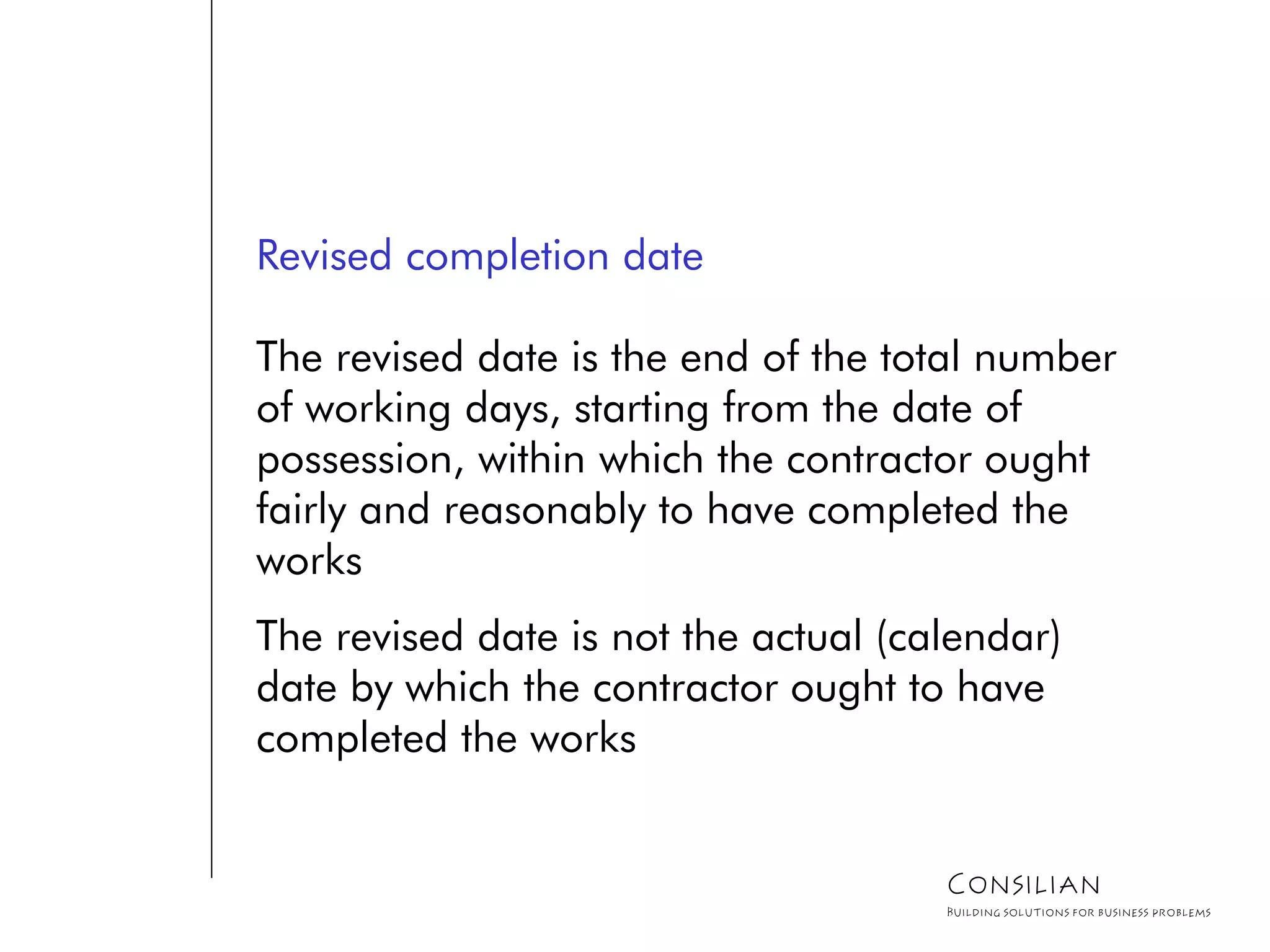

Revised completion date
The revised date is the end of the total number
of working days, starting from the date of
possession, within which the contractor ought
fairly and reasonably to have completed the
works
The revised date is not the actual (calendar)
date by which the contractor ought to have
completed the works
Consilian
Building solutions for business problems

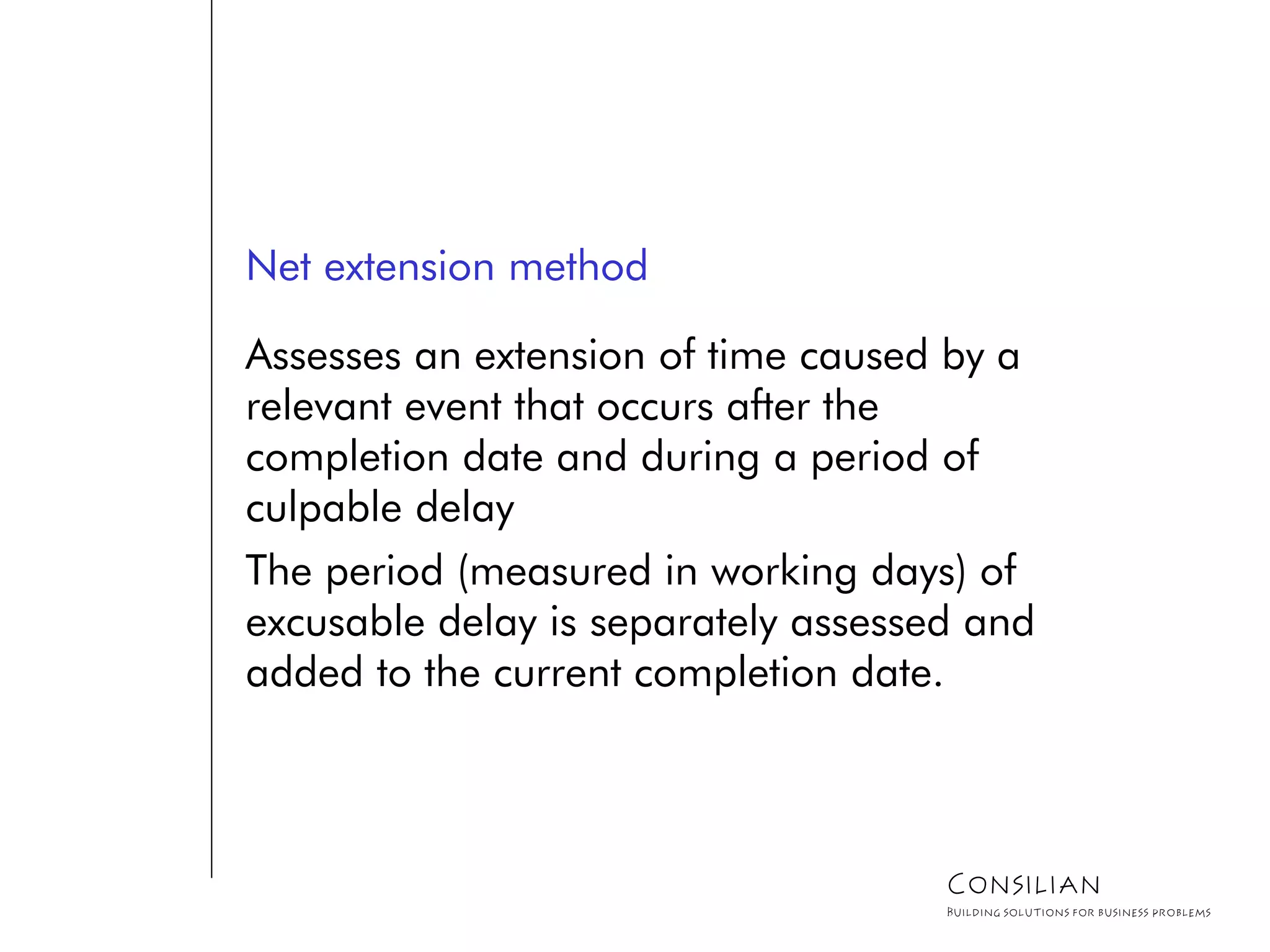

Net extension method
Assesses an extension of time caused by a
relevant event that occurs after the
completion date and during a period of
culpable delay
The period (measured in working days) of
excusable delay is separately assessed and
added to the current completion date.
Consilian
Building solutions for business problems

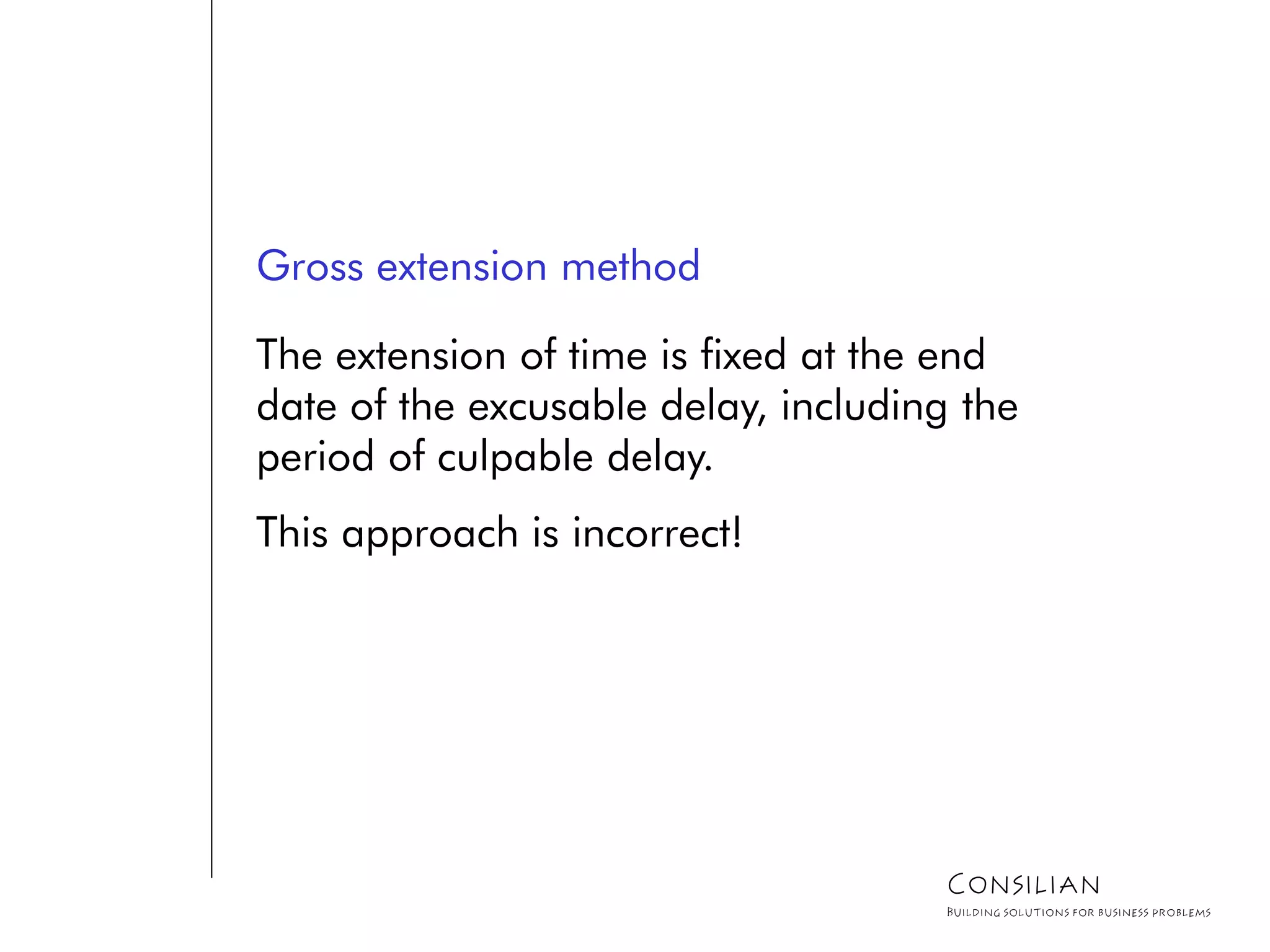

Gross extension method
The extension of time is fixed at the end
date of the excusable delay, including the
period of culpable delay.
This approach is incorrect!
Consilian
Building solutions for business problems

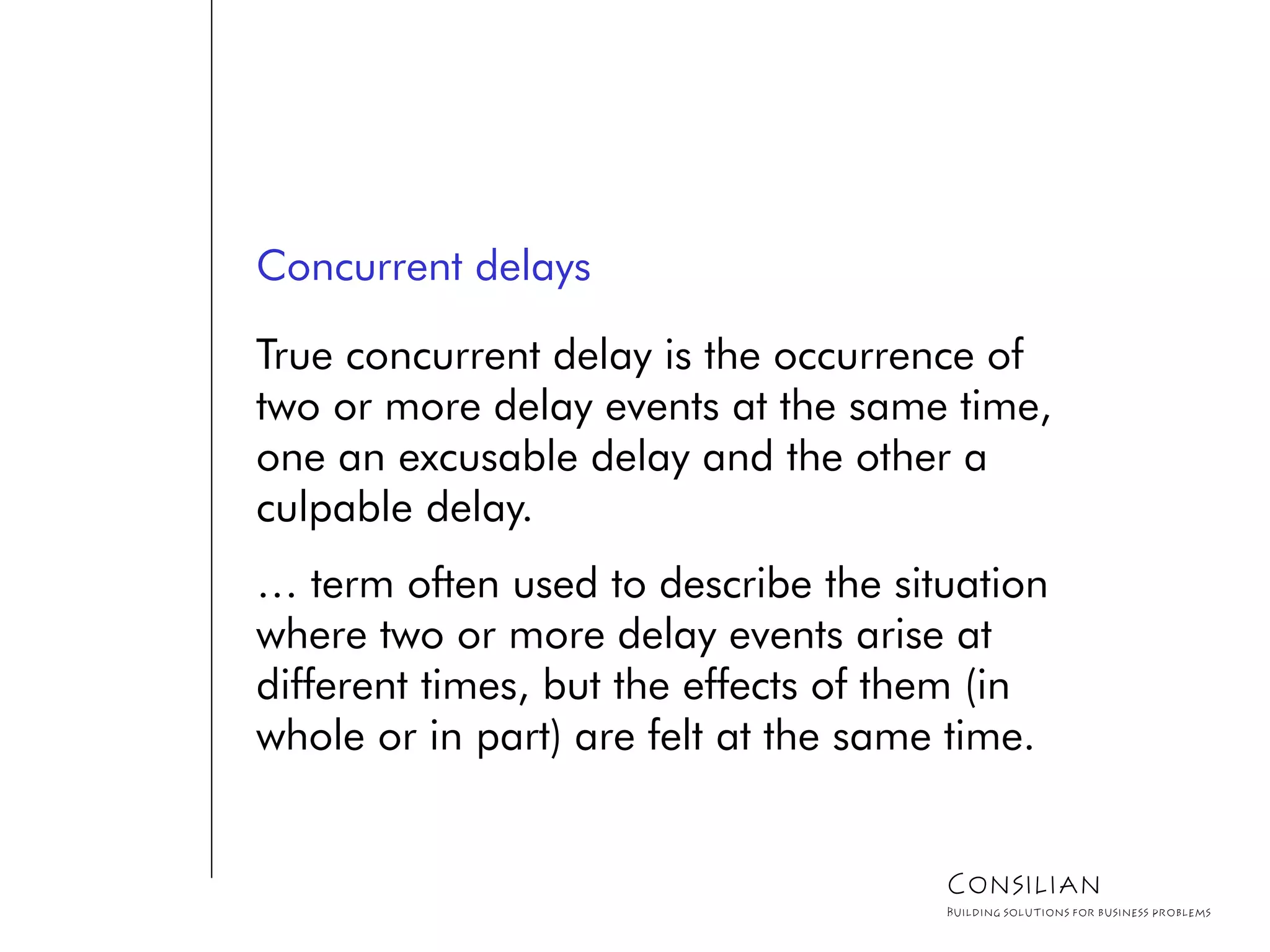

Concurrent delays
True concurrent delay is the occurrence of
two or more delay events at the same time,
one an excusable delay and the other a
culpable delay.
… term often used to describe the situation
where two or more delay events arise at
different times, but the effects of them (in
whole or in part) are felt at the same time.
Consilian
Building solutions for business problems

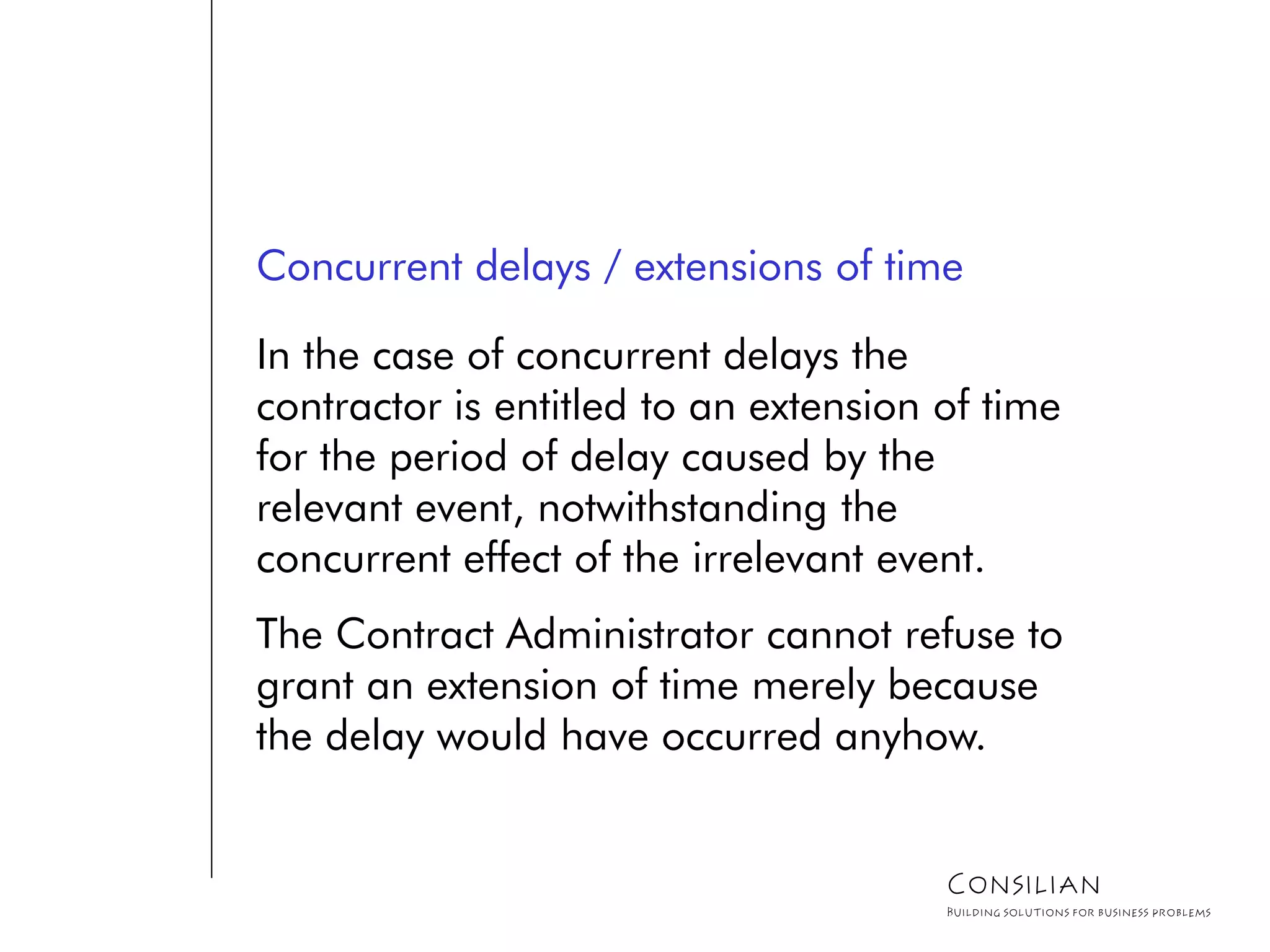

Concurrent delays / extensions of time
In the case of concurrent delays the
contractor is entitled to an extension of time
for the period of delay caused by the
relevant event, notwithstanding the
concurrent effect of the irrelevant event.
The Contract Administrator cannot refuse to
grant an extension of time merely because
the delay would have occurred anyhow.
Consilian

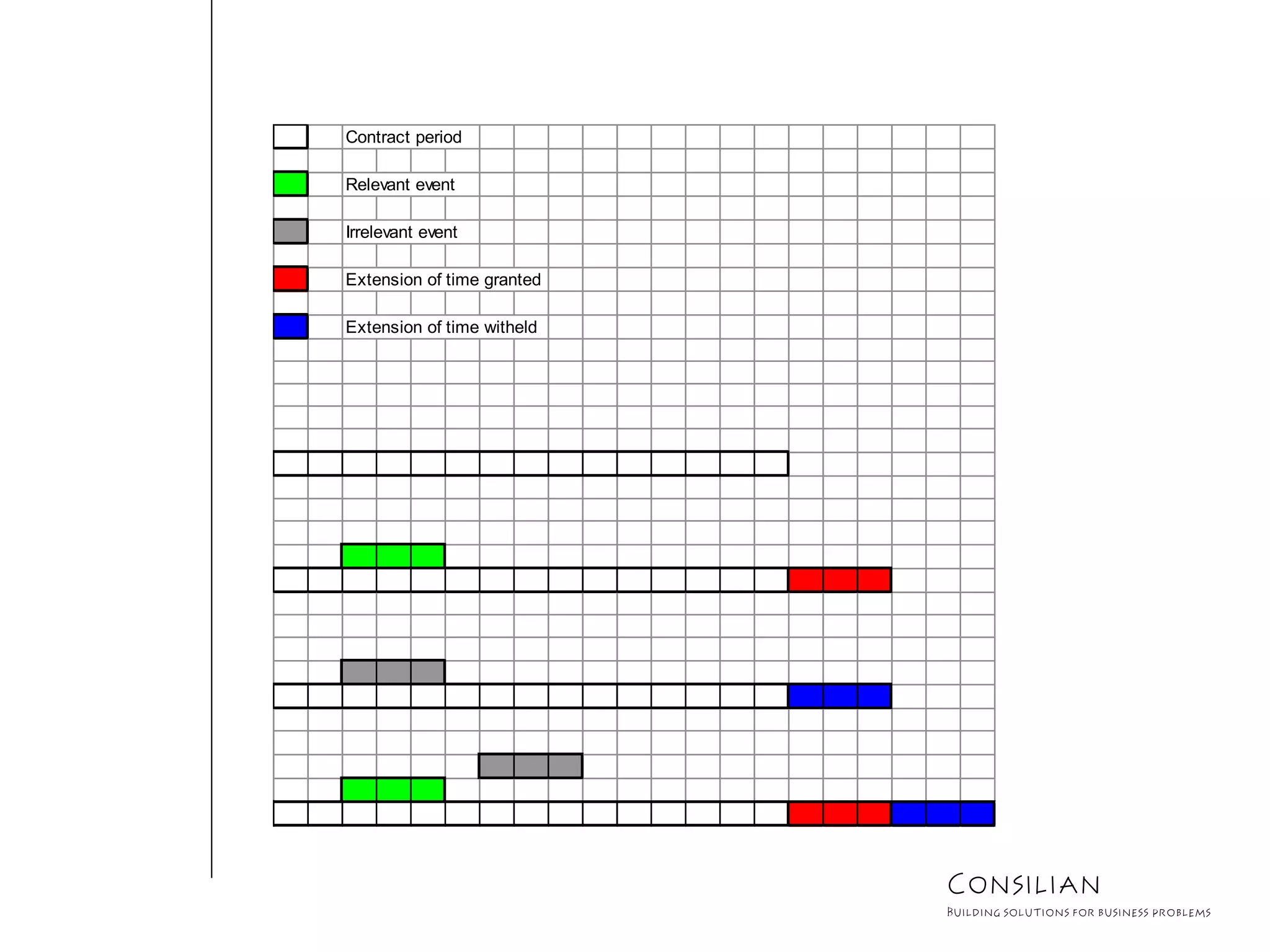

Building solutions for business problems
Contract period
Relevant event
Irrelevant event
Extension of time granted
Extension of time witheld
Consilian

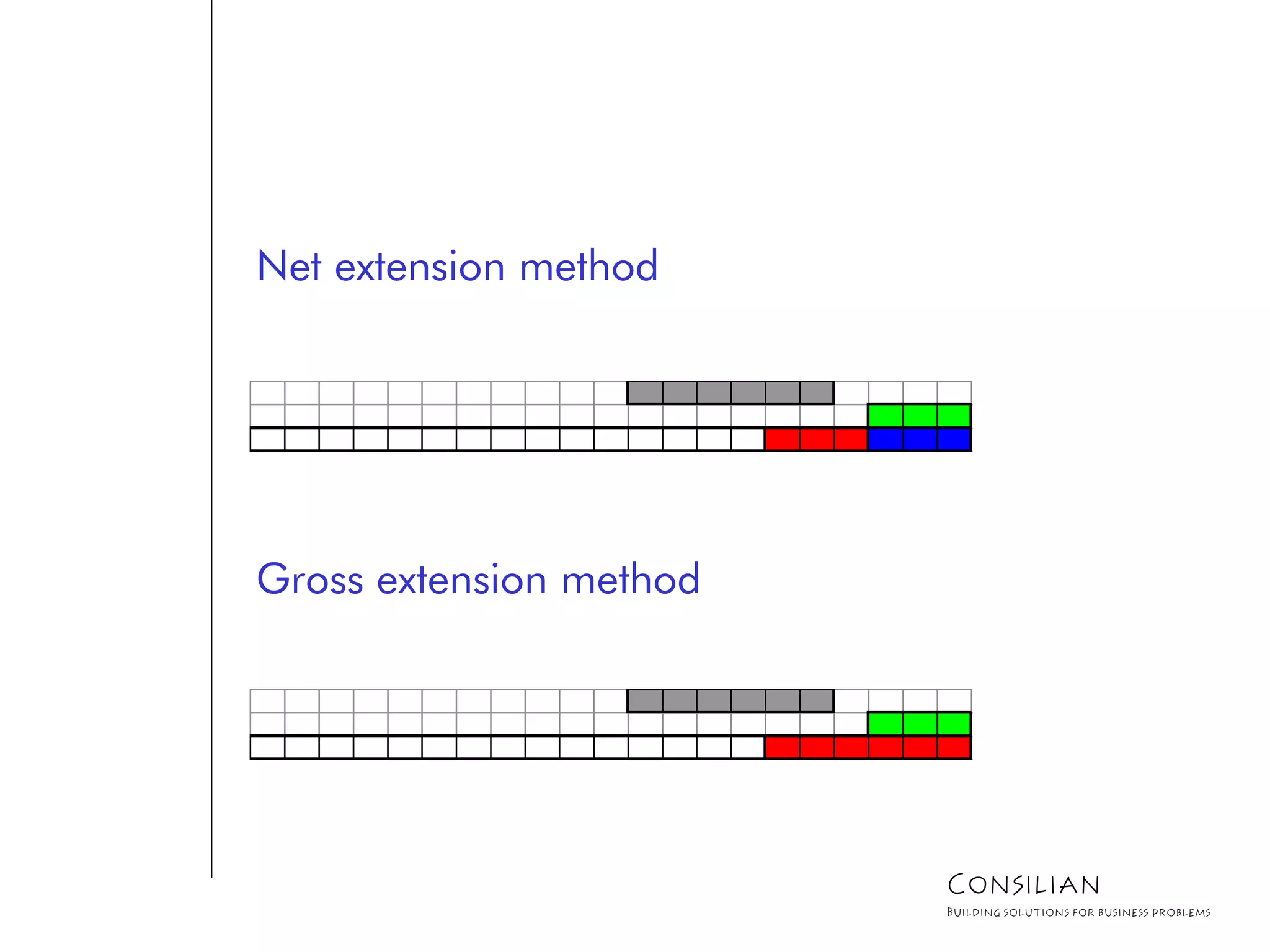

Building solutions for business problems
Net extension method
Gross extension method
Consilian
Building solutions for business problems

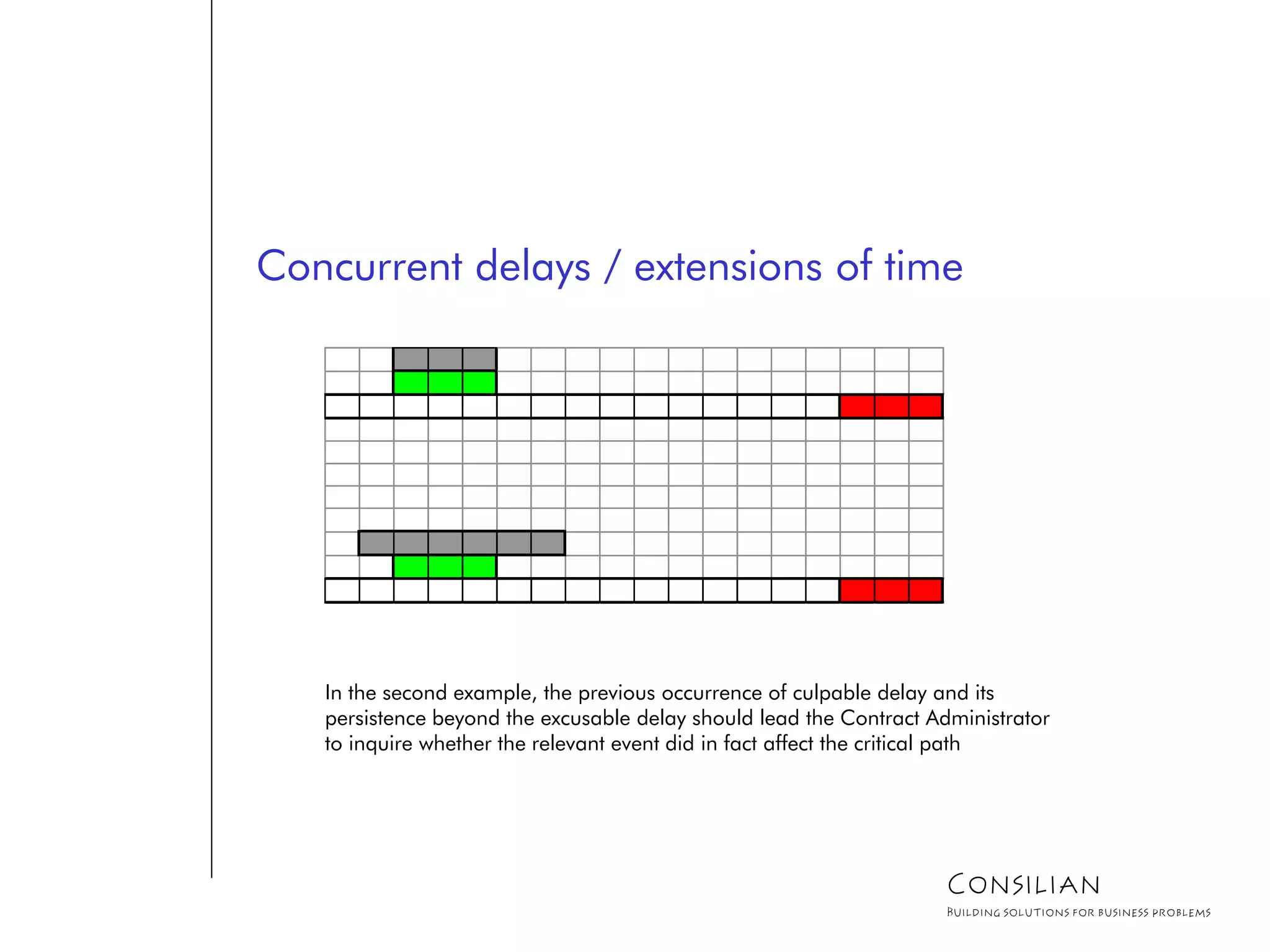

Concurrent delays / extensions of time
In the second example, the previous occurrence of culpable delay and its
persistence beyond the excusable delay should lead the Contract Administrator
to inquire whether the relevant event did in fact affect the critical path
Consilian
Building solutions for business problems

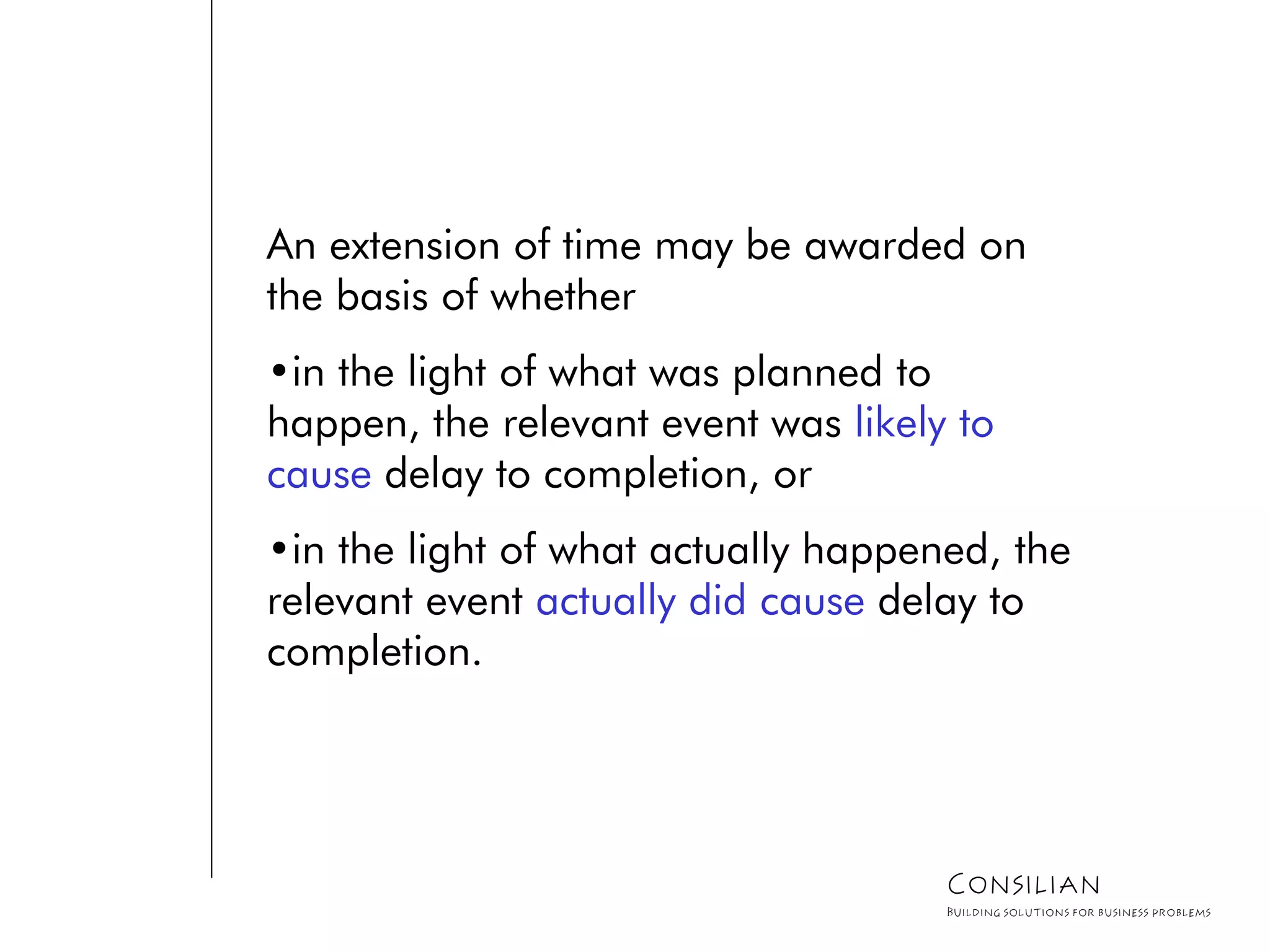

An extension of time may be awarded on
the basis of whether
•in the light of what was planned to
happen, the relevant event was likely to
cause delay to completion, or
•in the light of what actually happened, the
relevant event actually did cause delay to
completion.
Consilian
Building solutions for business problems

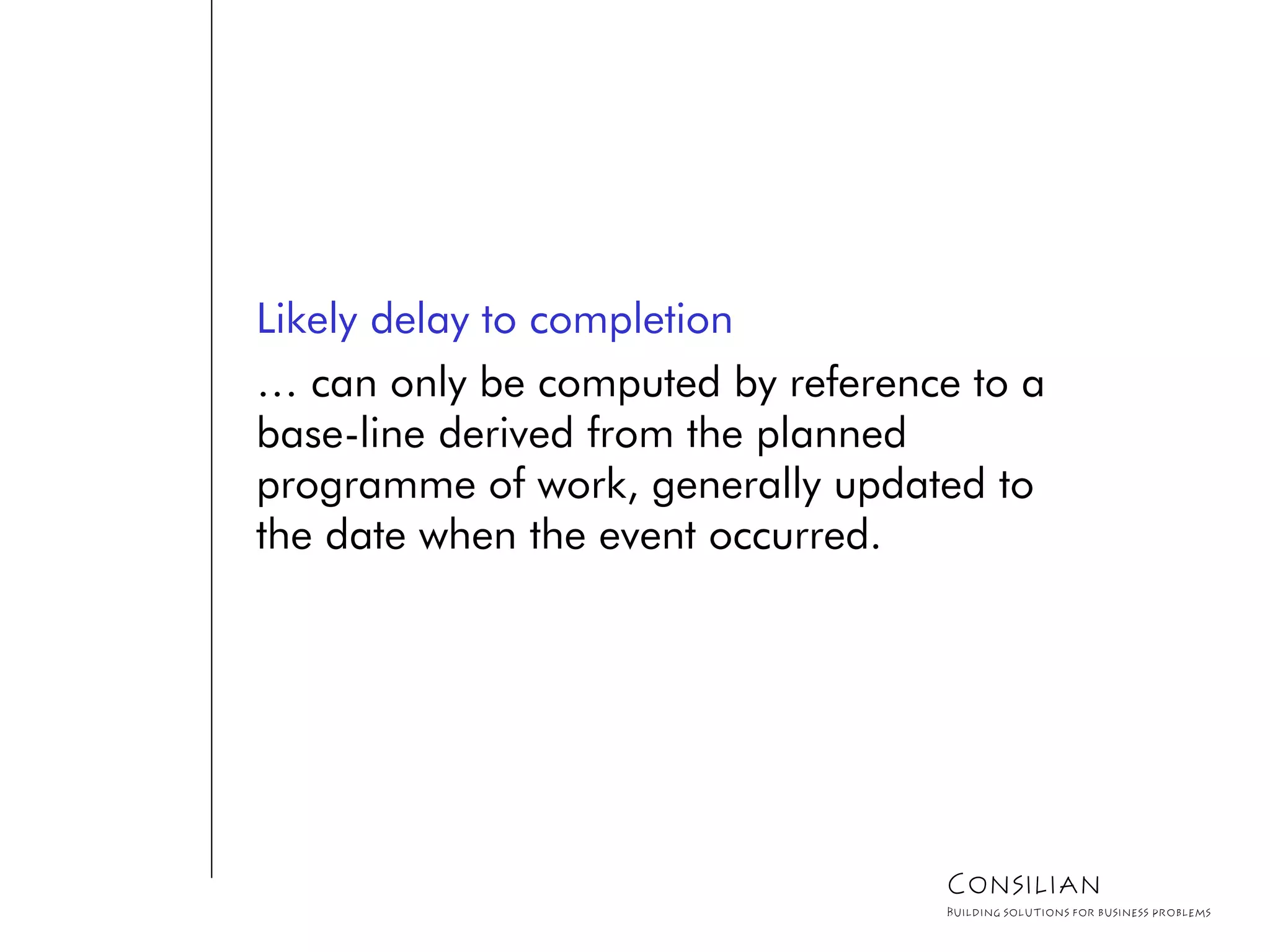

Likely delay to completion
… can only be computed by reference to a
base-line derived from the planned
programme of work, generally updated to
the date when the event occurred.
Consilian
Building solutions for business problems

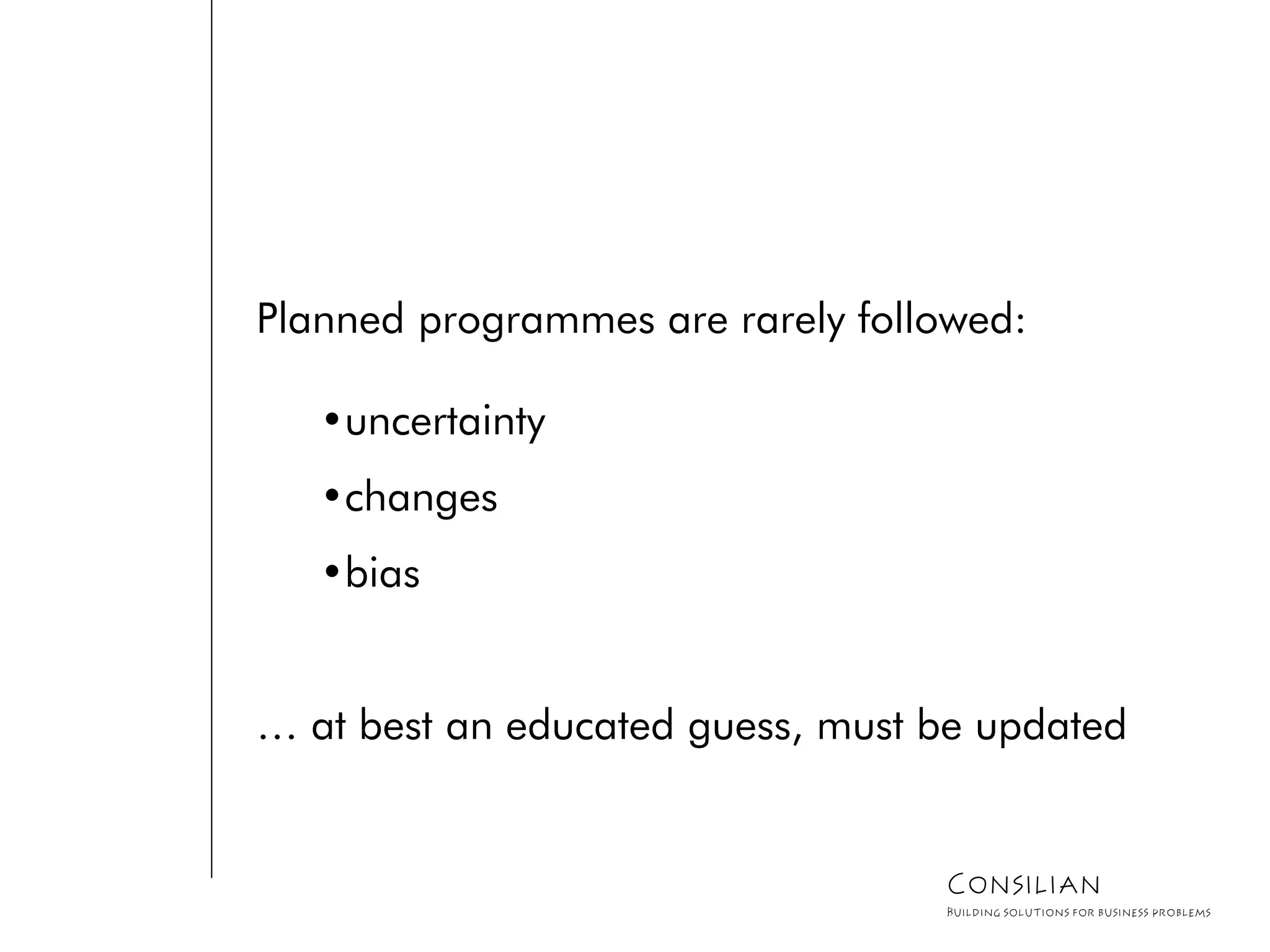

Planned programmes are rarely followed:
•uncertainty
•changes
•bias
… at best an educated guess, must be updated
Consilian
Building solutions for business problems

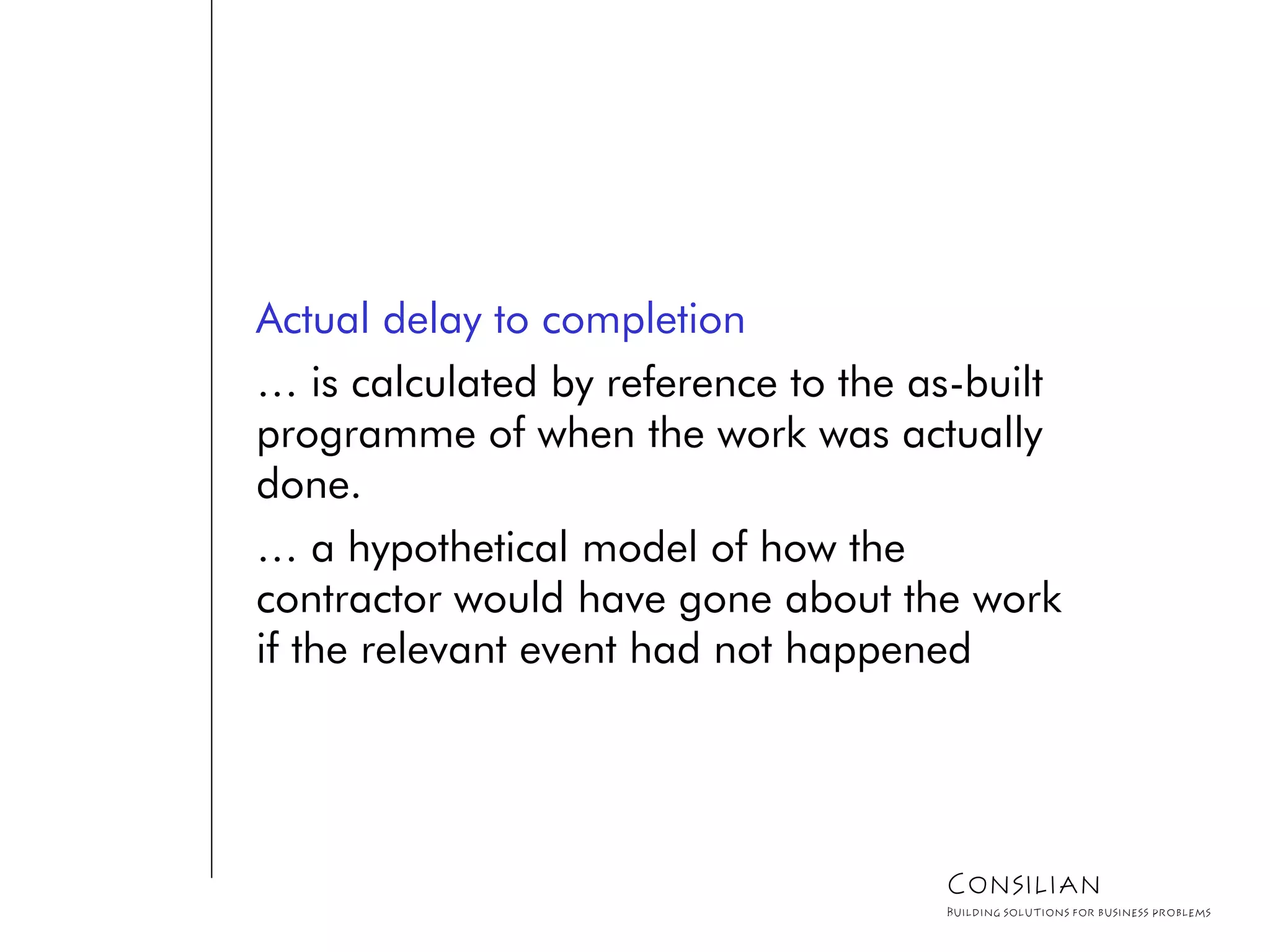

Actual delay to completion
… is calculated by reference to the as-built
programme of when the work was actually
done.
… a hypothetical model of how the
contractor would have gone about the work
if the relevant event had not happened
Consilian
Building solutions for business problems

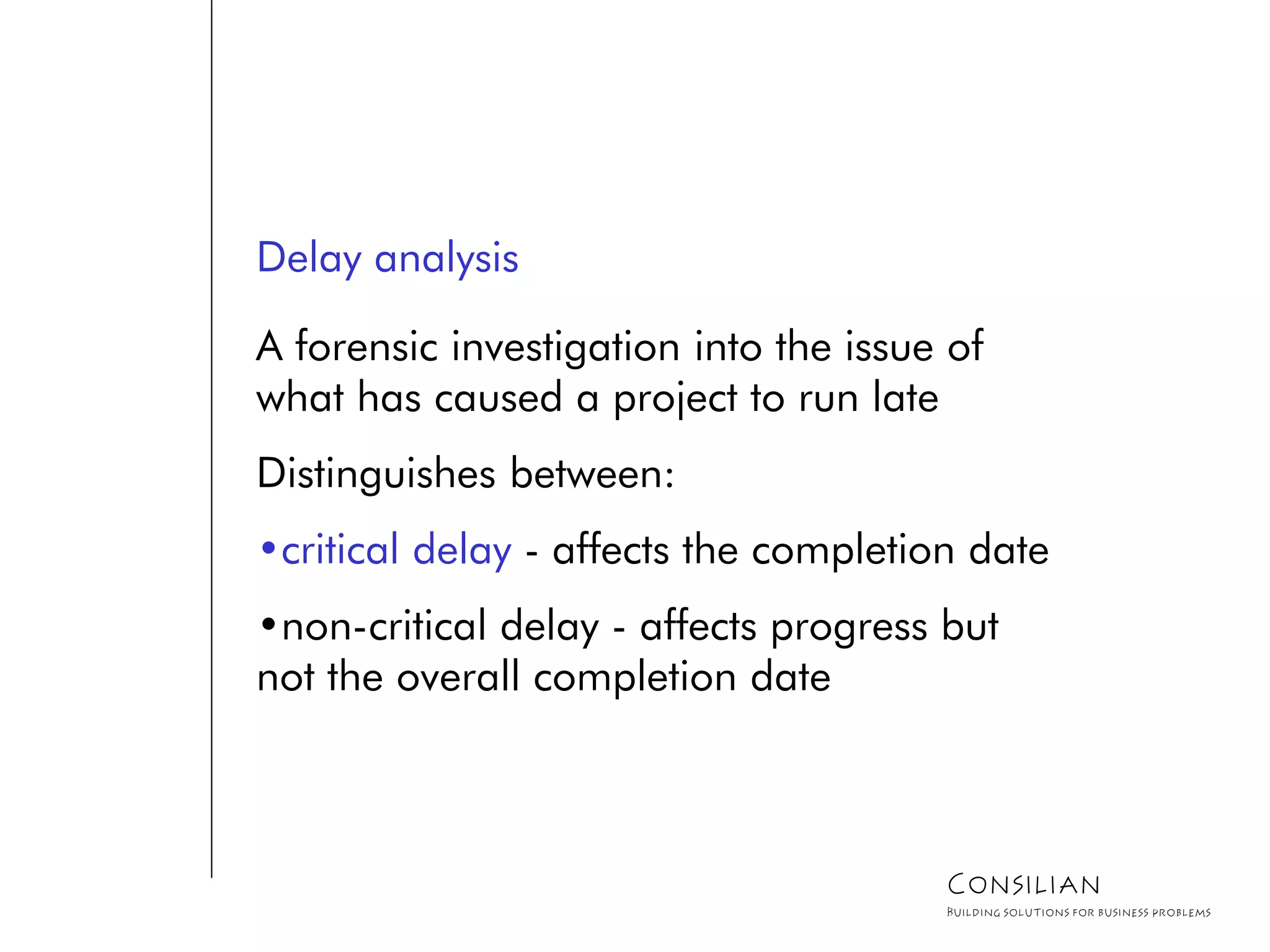

Delay analysis
A forensic investigation into the issue of
what has caused a project to run late
Distinguishes between:
•critical delay - affects the completion date
•non-critical delay - affects progress but
not the overall completion date
Consilian
Building solutions for business problems

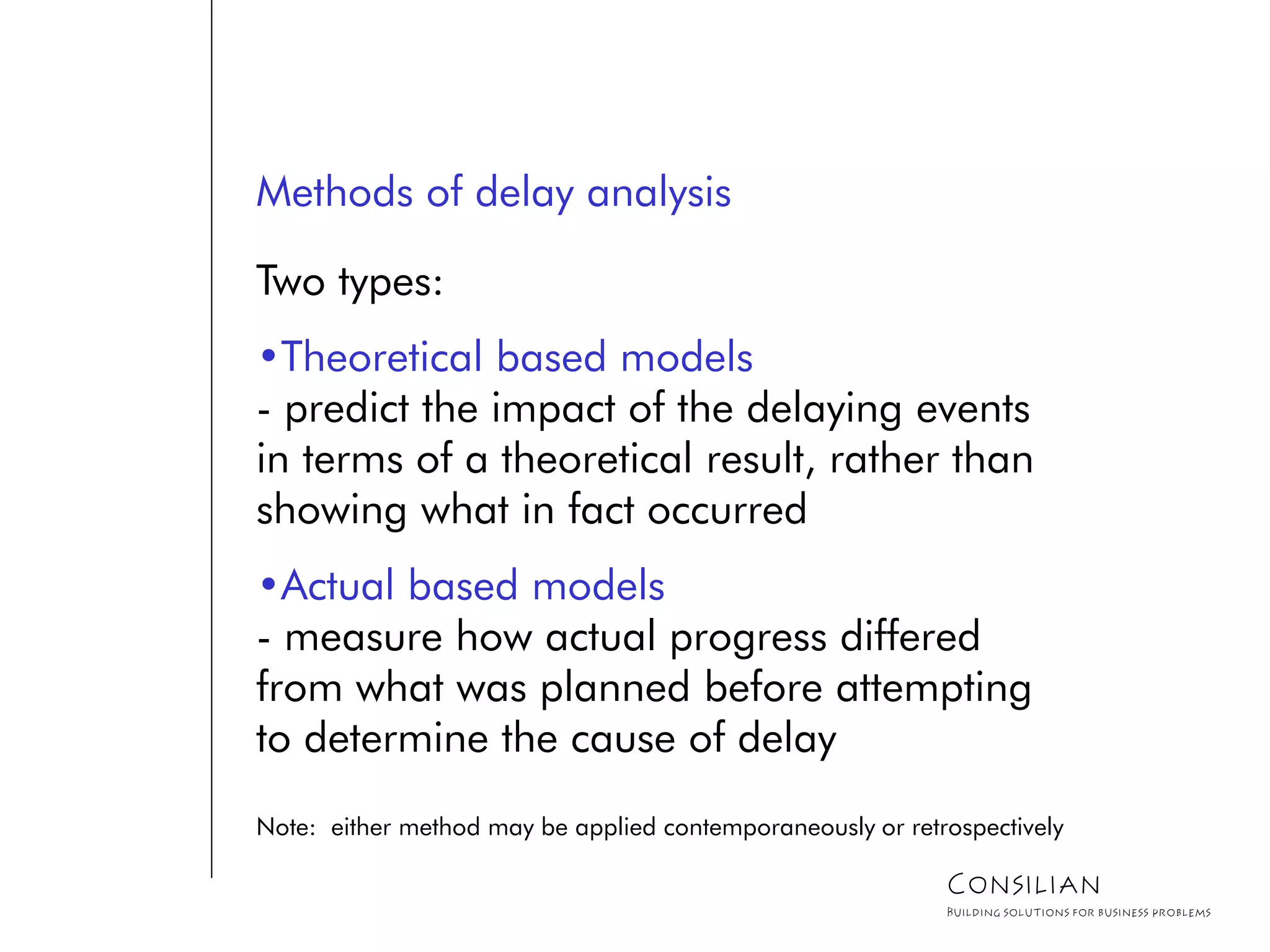

Methods of delay analysis
Two types:
•Theoretical based models
- predict the impact of the delaying events
in terms of a theoretical result, rather than
showing what in fact occurred
•Actual based models
- measure how actual progress differed
from what was planned before attempting
to determine the cause of delay
Note: either method may be applied contemporaneously or retrospectively
Consilian
Building solutions for business problems

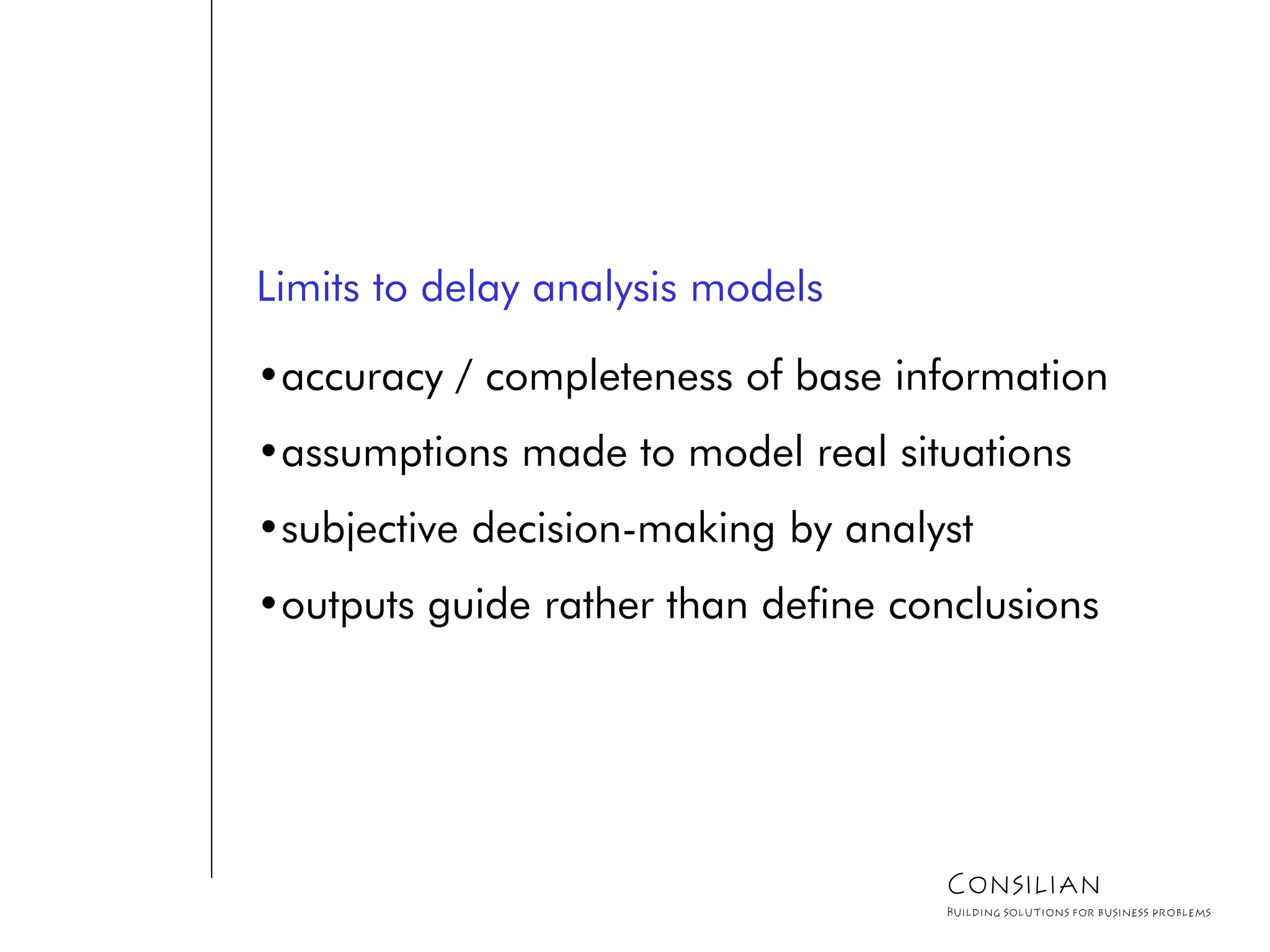

Limits to delay analysis models
•accuracy / completeness of base information
•assumptions made to model real situations
•subjective decision-making by analyst
•outputs guide rather than define conclusions
Consilian
Building solutions for business problems

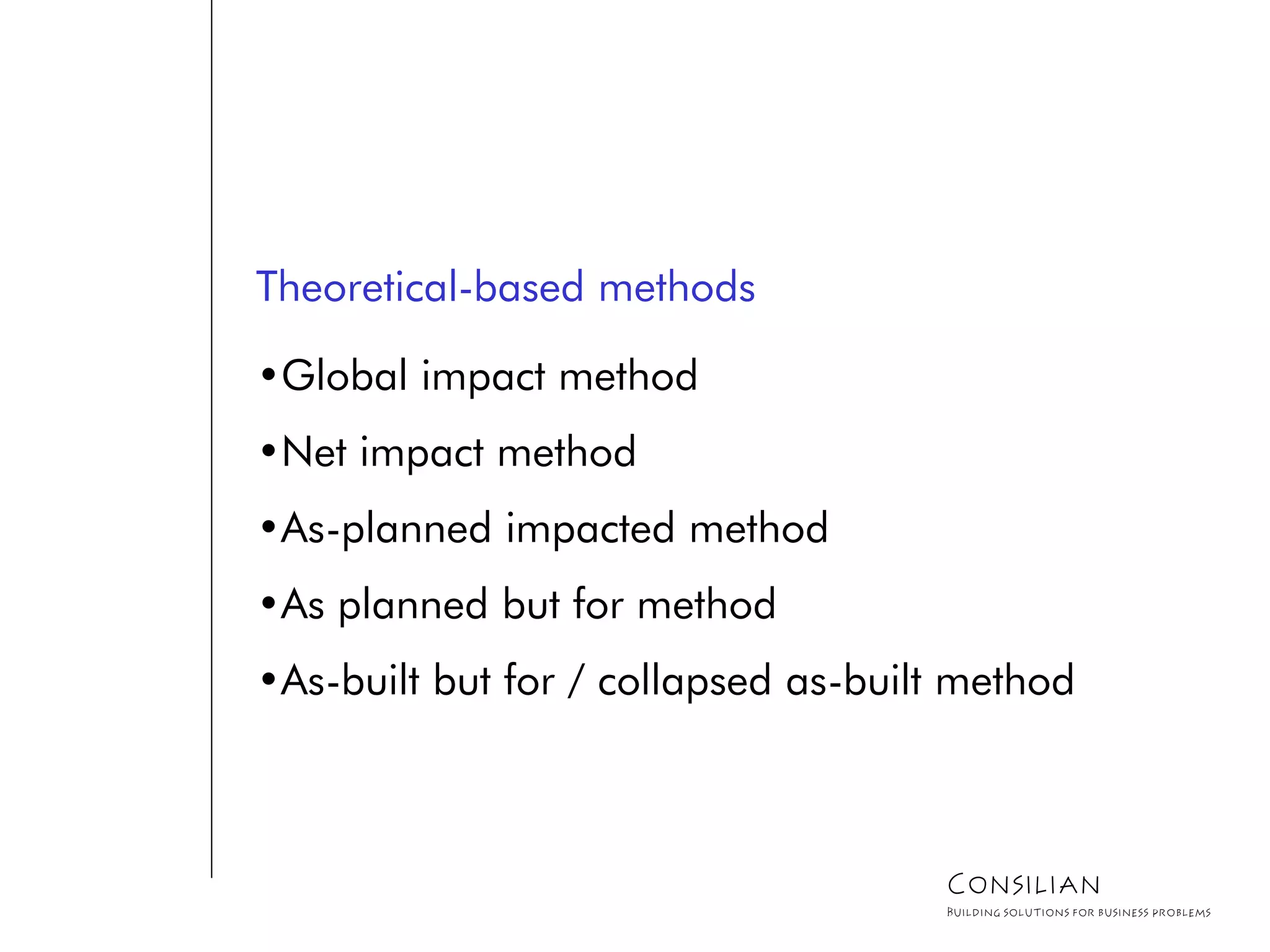

Theoretical-based methods
•Global impact method
•Net impact method
•As-planned impacted method
•As planned but for method
•As-built but for / collapsed as-built method
Consilian
Building solutions for business problems

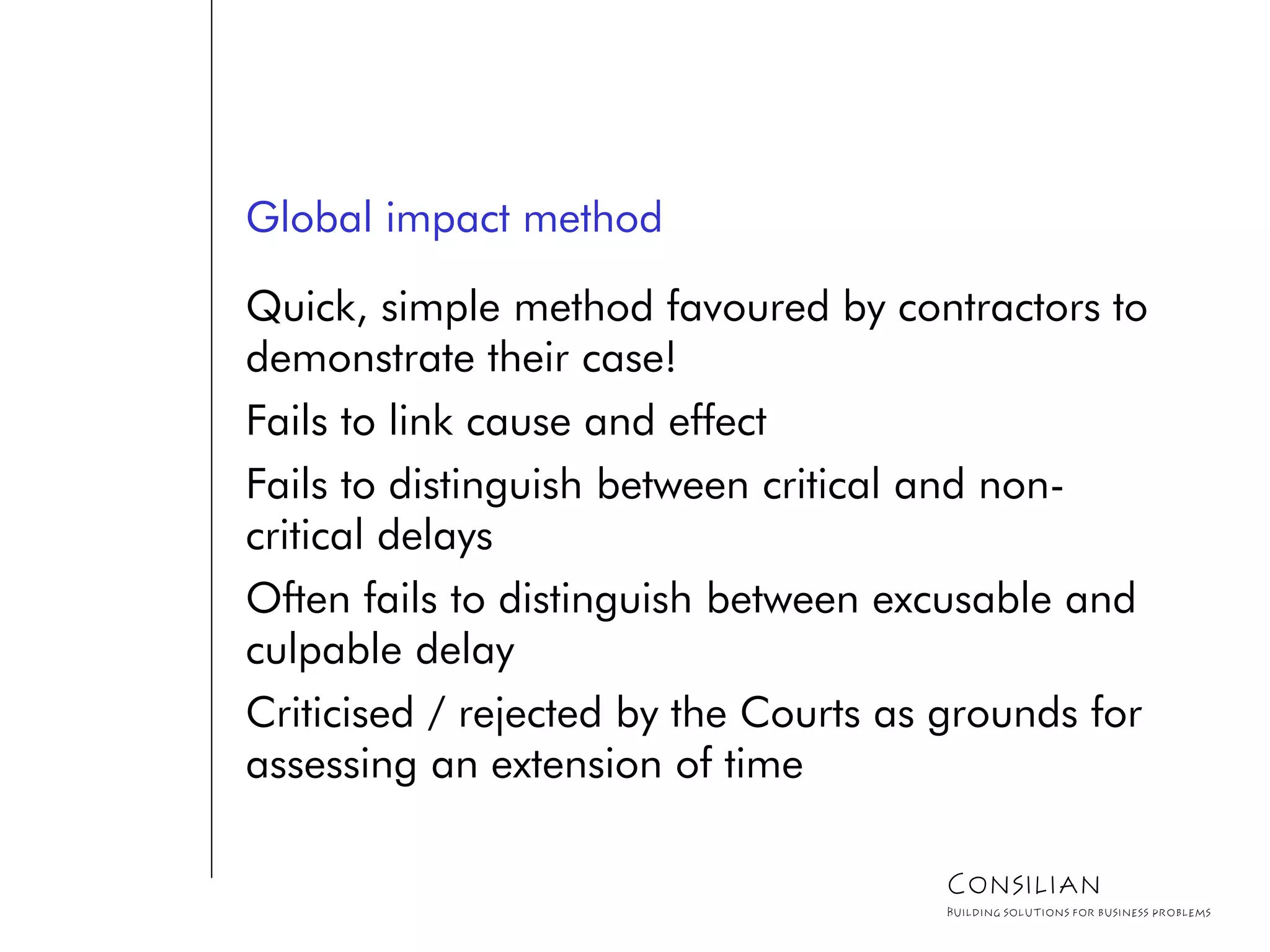

Global impact method
Quick, simple method favoured by contractors to
demonstrate their case!
Fails to link cause and effect
Fails to distinguish between critical and non-
critical delays
Often fails to distinguish between excusable and
culpable delay
Criticised / rejected by the Courts as grounds for
assessing an extension of time
Consilian
Building solutions for business problems

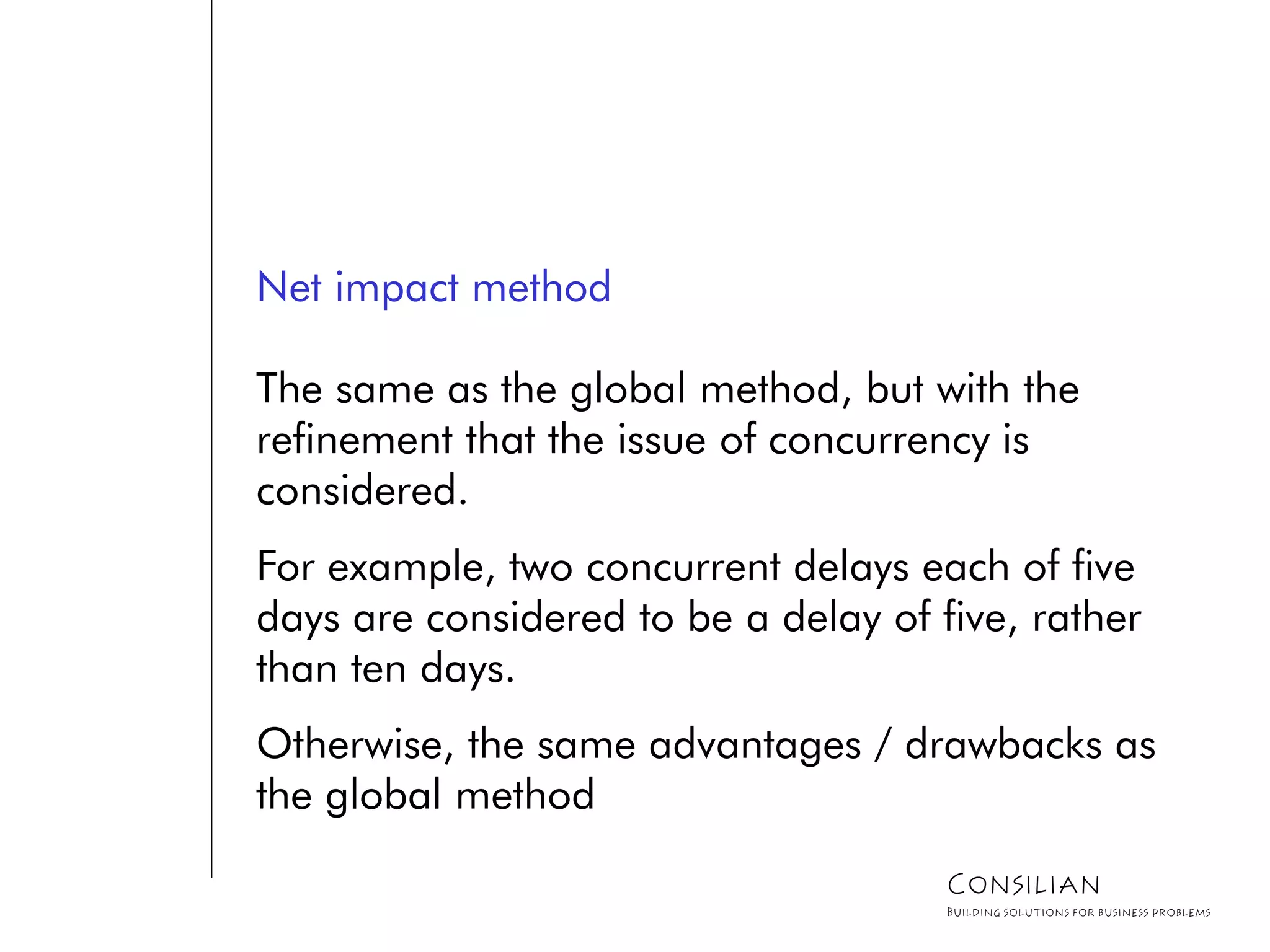

Net impact method
The same as the global method, but with the
refinement that the issue of concurrency is
considered.
For example, two concurrent delays each of five
days are considered to be a delay of five, rather
than ten days.
Otherwise, the same advantages / drawbacks as
the global method
Consilian
Building solutions for business problems

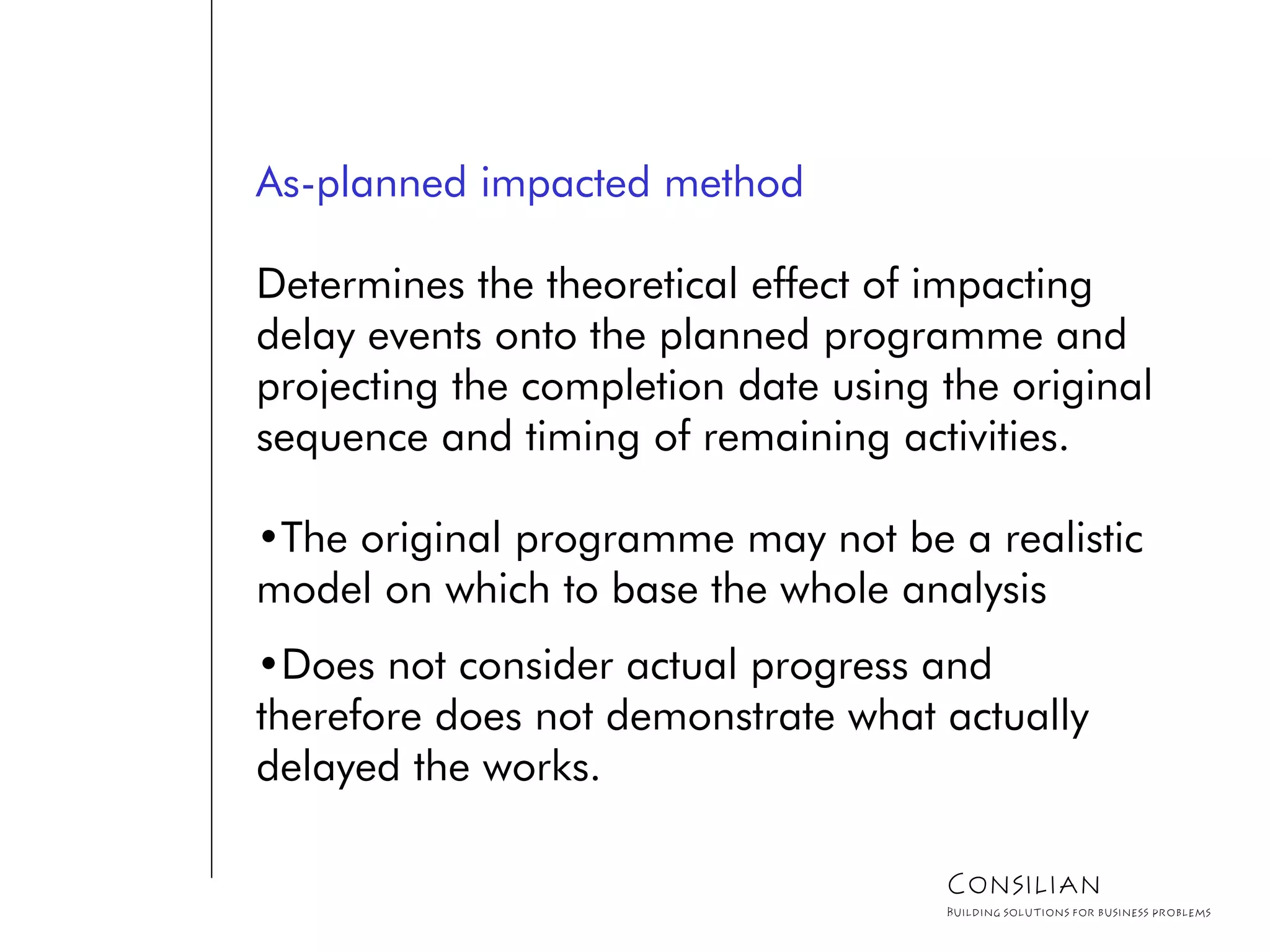

As-planned impacted method
Determines the theoretical effect of impacting
delay events onto the planned programme and
projecting the completion date using the original
sequence and timing of remaining activities.
•The original programme may not be a realistic
model on which to base the whole analysis
•Does not consider actual progress and
therefore does not demonstrate what actually
delayed the works.
Consilian
Building solutions for business problems

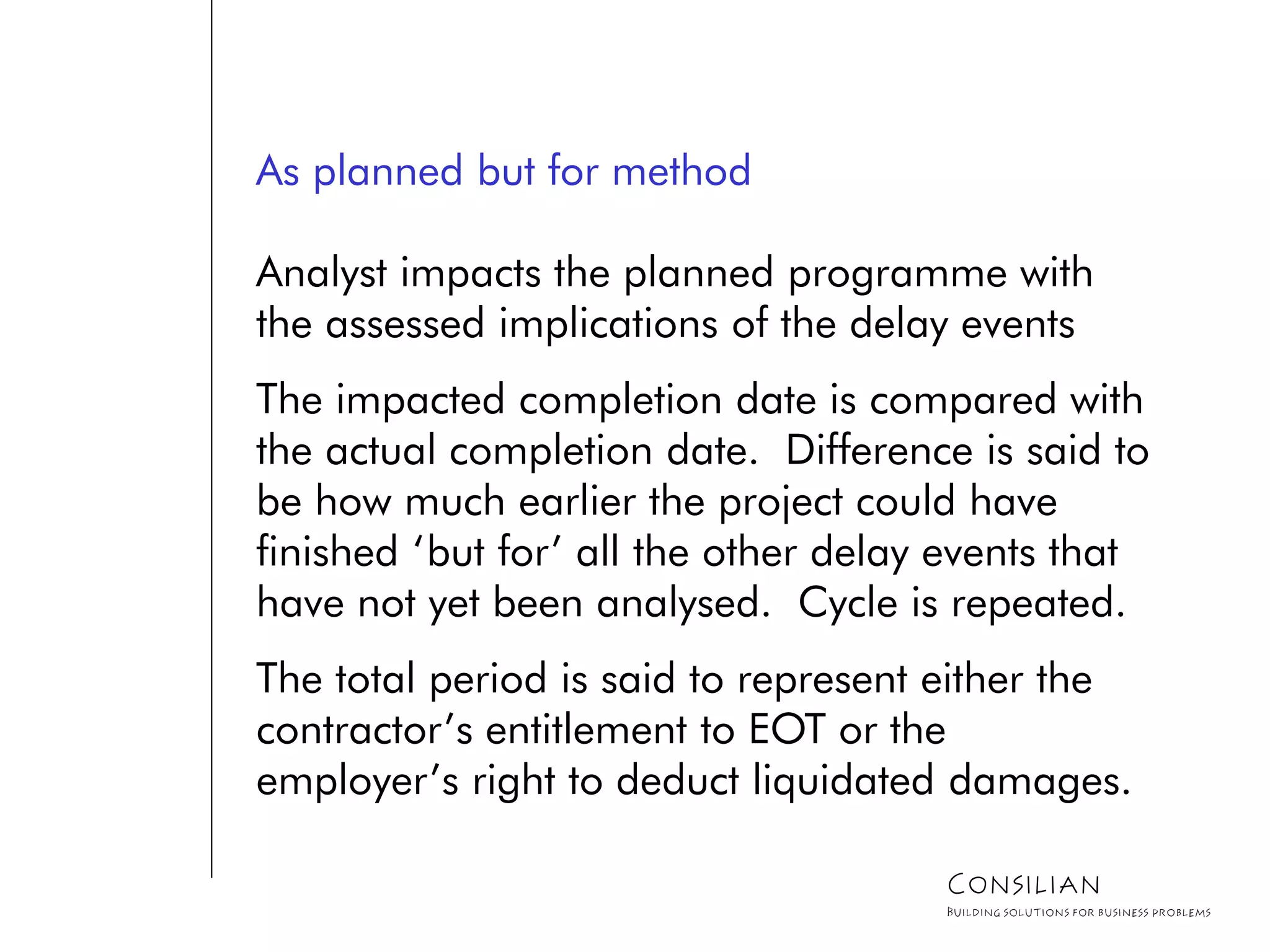

As planned but for method
Analyst impacts the planned programme with
the assessed implications of the delay events
The impacted completion date is compared with
the actual completion date. Difference is said to
be how much earlier the project could have
finished ‘but for’ all the other delay events that
have not yet been analysed. Cycle is repeated.
The total period is said to represent either the
contractor’s entitlement to EOT or the
employer’s right to deduct liquidated damages.
Consilian
Building solutions for business problems

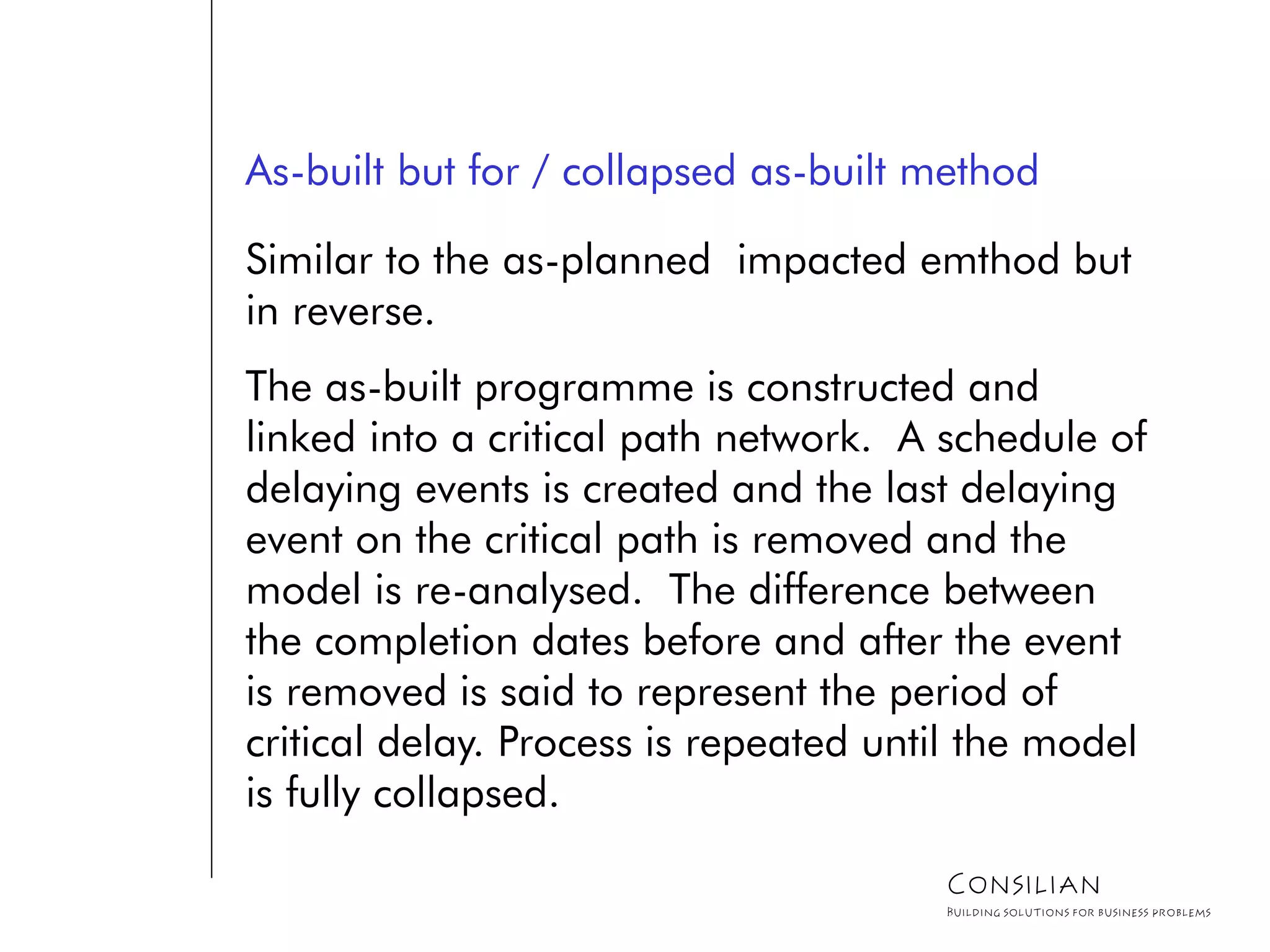

As-built but for / collapsed as-built method
Similar to the as-planned impacted emthod but
in reverse.
The as-built programme is constructed and
linked into a critical path network. A schedule of
delaying events is created and the last delaying
event on the critical path is removed and the
model is re-analysed. The difference between
the completion dates before and after the event
is removed is said to represent the period of
critical delay. Process is repeated until the model
is fully collapsed.
Consilian
Building solutions for business problems

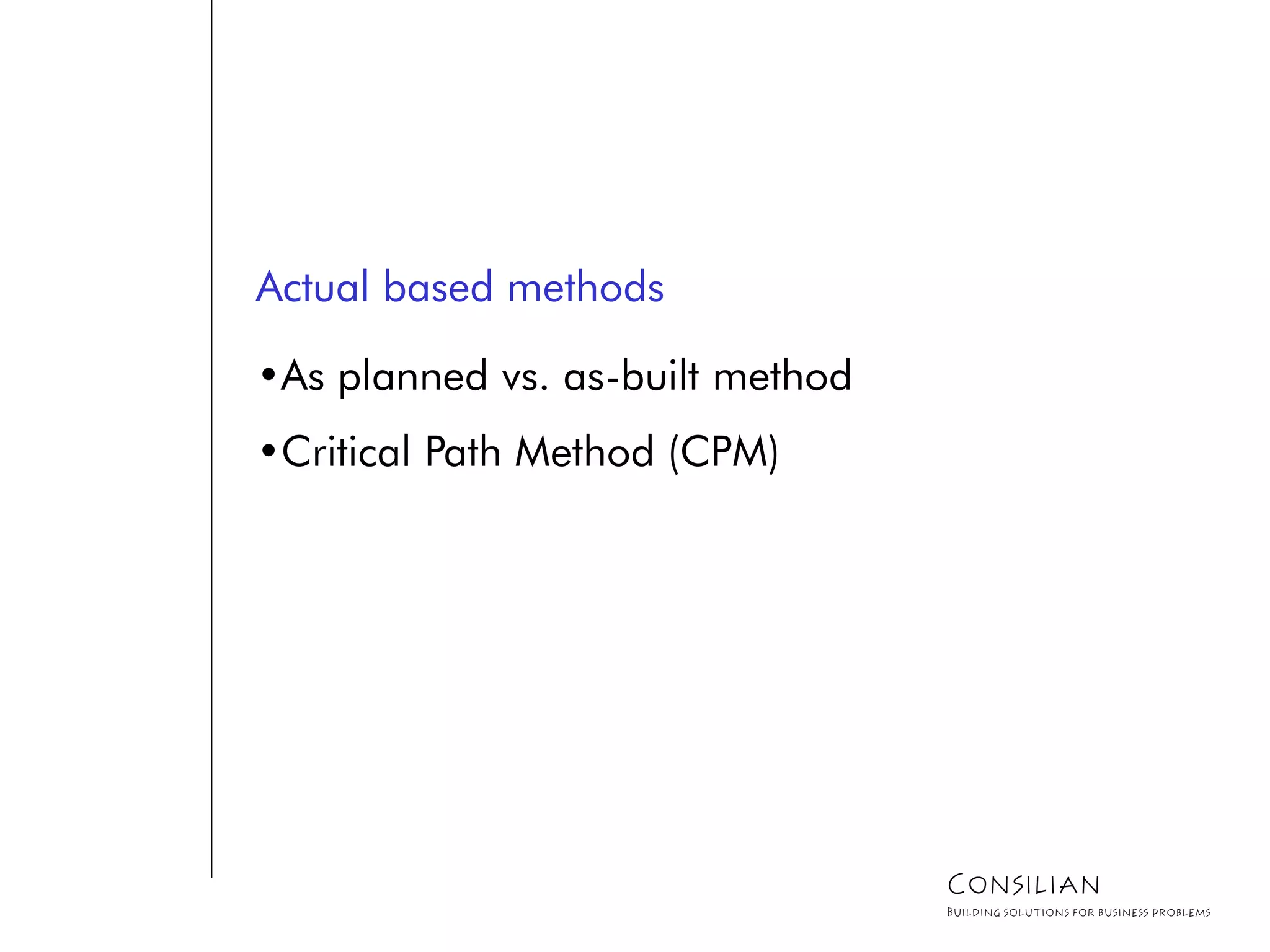

Actual based methods
•As planned vs. as-built method
•Critical Path Method (CPM)
Consilian
Building solutions for business problems

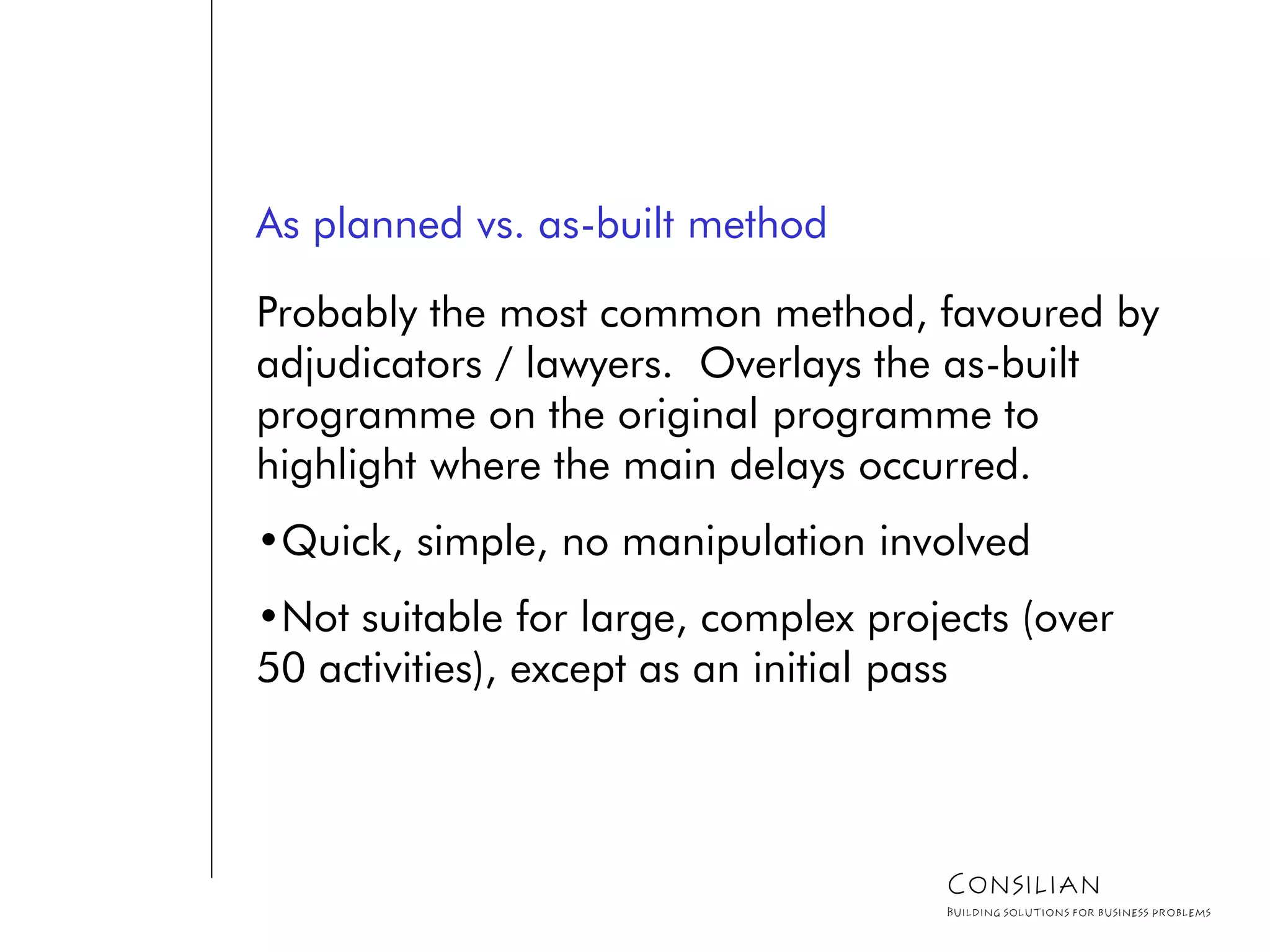

As planned vs. as-built method
Probably the most common method, favoured by
adjudicators / lawyers. Overlays the as-built
programme on the original programme to
highlight where the main delays occurred.
•Quick, simple, no manipulation involved
•Not suitable for large, complex projects (over
50 activities), except as an initial pass
Consilian
Building solutions for business problems

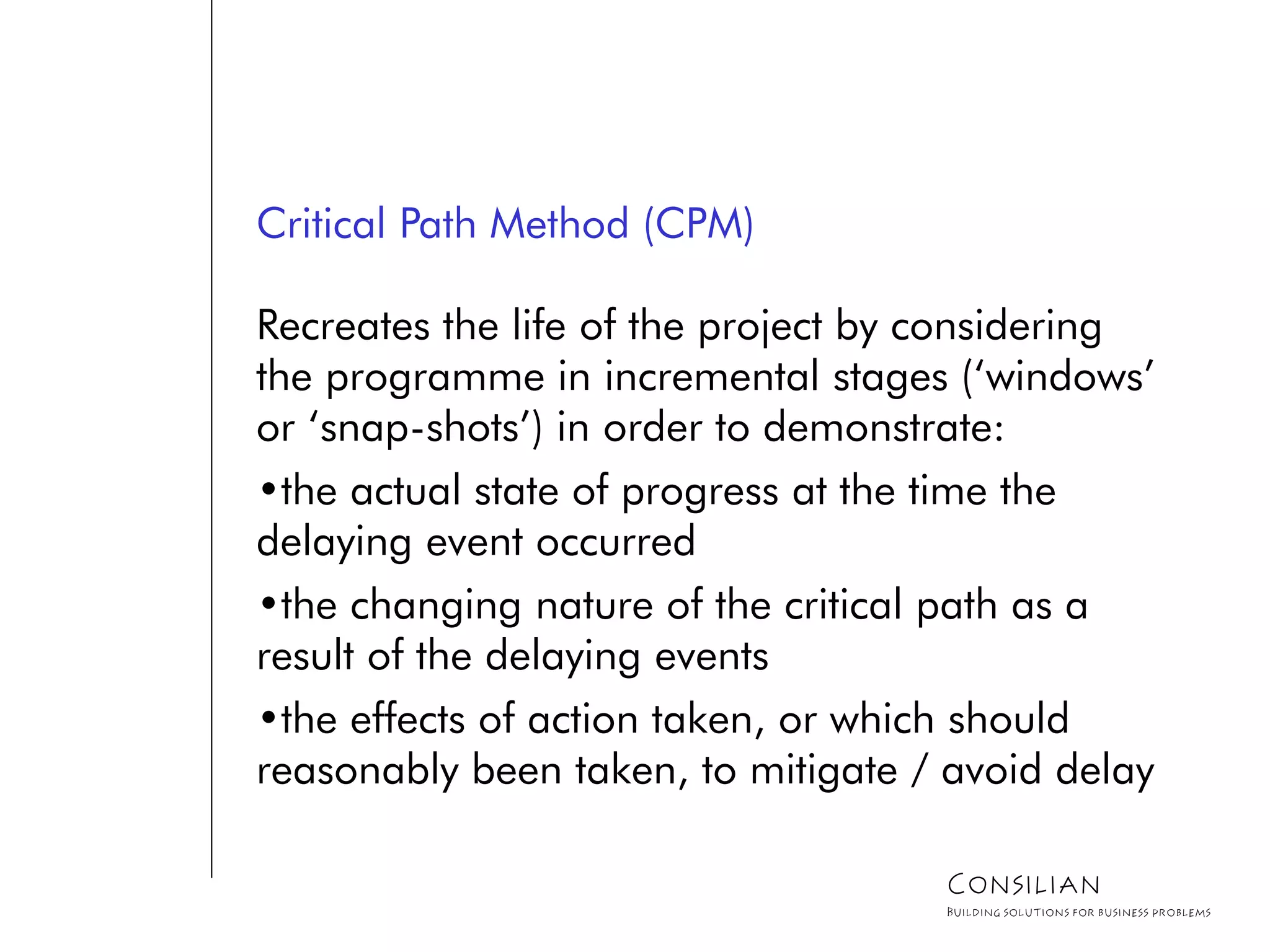

Critical Path Method (CPM)
Recreates the life of the project by considering
the programme in incremental stages (‘windows’
or ‘snap-shots’) in order to demonstrate:
•the actual state of progress at the time the
delaying event occurred
•the changing nature of the critical path as a
result of the delaying events
•the effects of action taken, or which should
reasonably been taken, to mitigate / avoid delay
Consilian
Building solutions for business problems

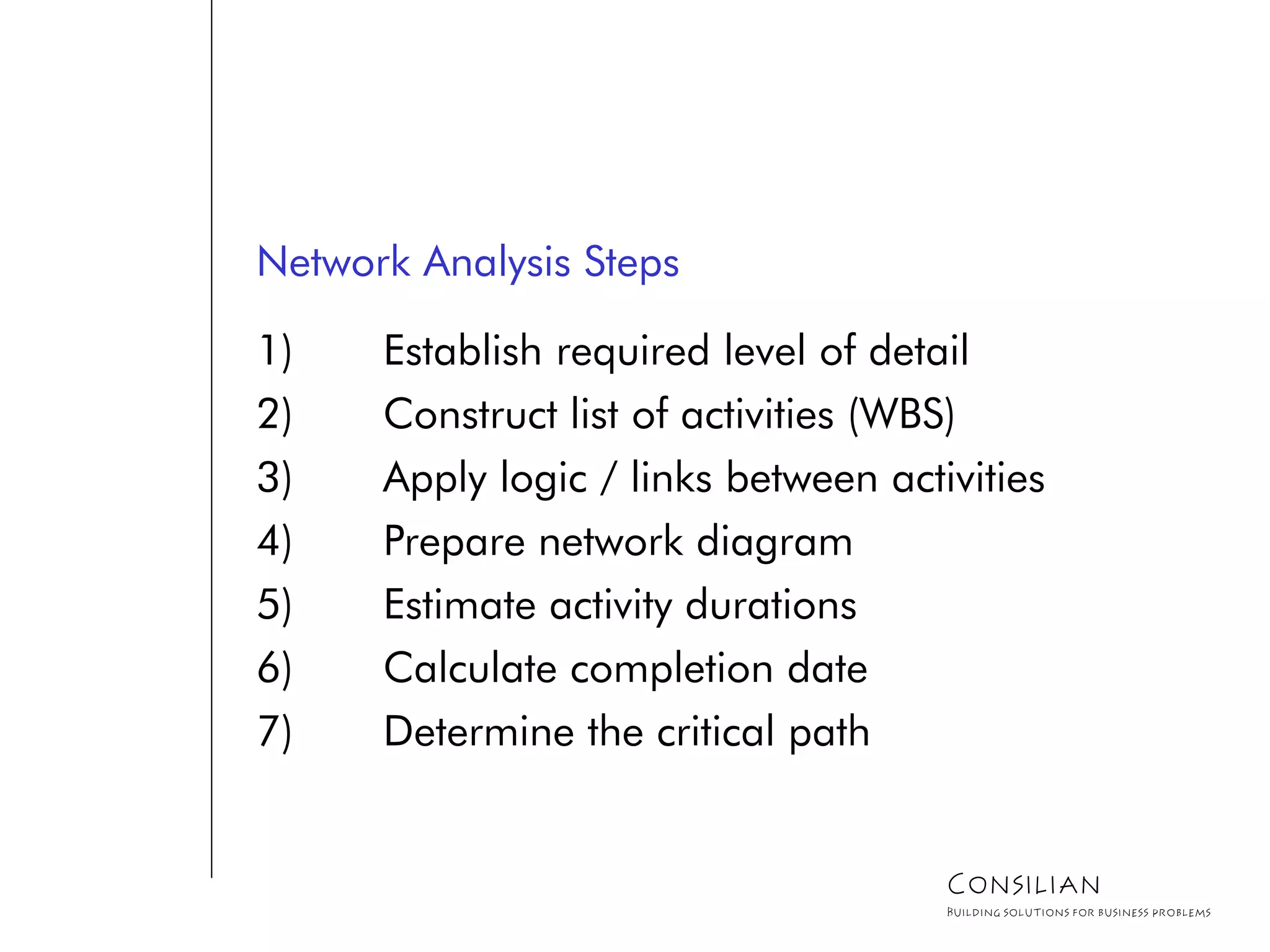

Network Analysis Steps
1) Establish required level of detail
2) Construct list of activities (WBS)
3) Apply logic / links between activities
4) Prepare network diagram
5) Estimate activity durations
6) Calculate completion date
7) Determine the critical path
Consilian
Building solutions for business problems

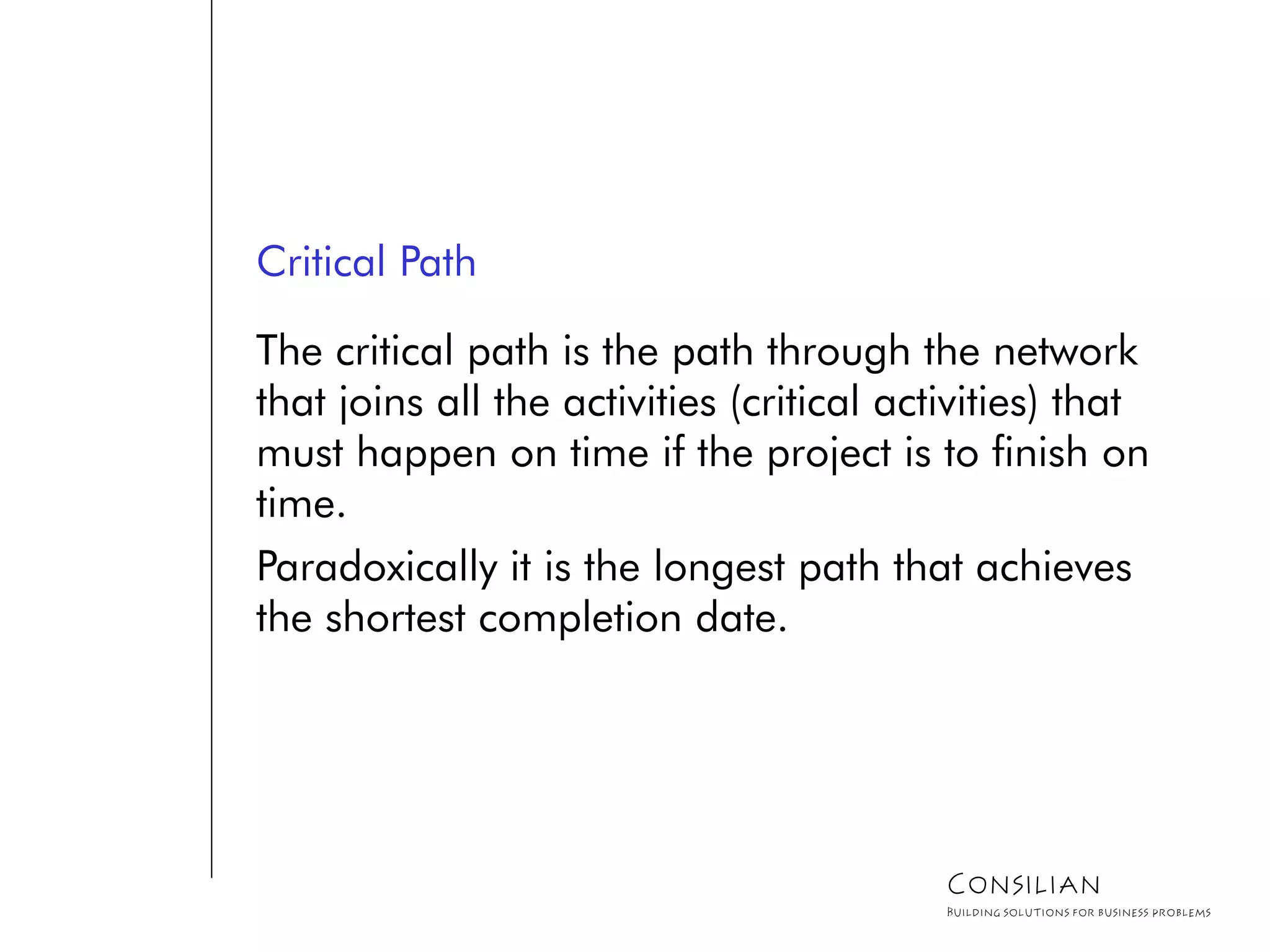

Critical Path
The critical path is the path through the network
that joins all the activities (critical activities) that
must happen on time if the project is to finish on
time.
Paradoxically it is the longest path that achieves
the shortest completion date.
Consilian
Building solutions for business problems

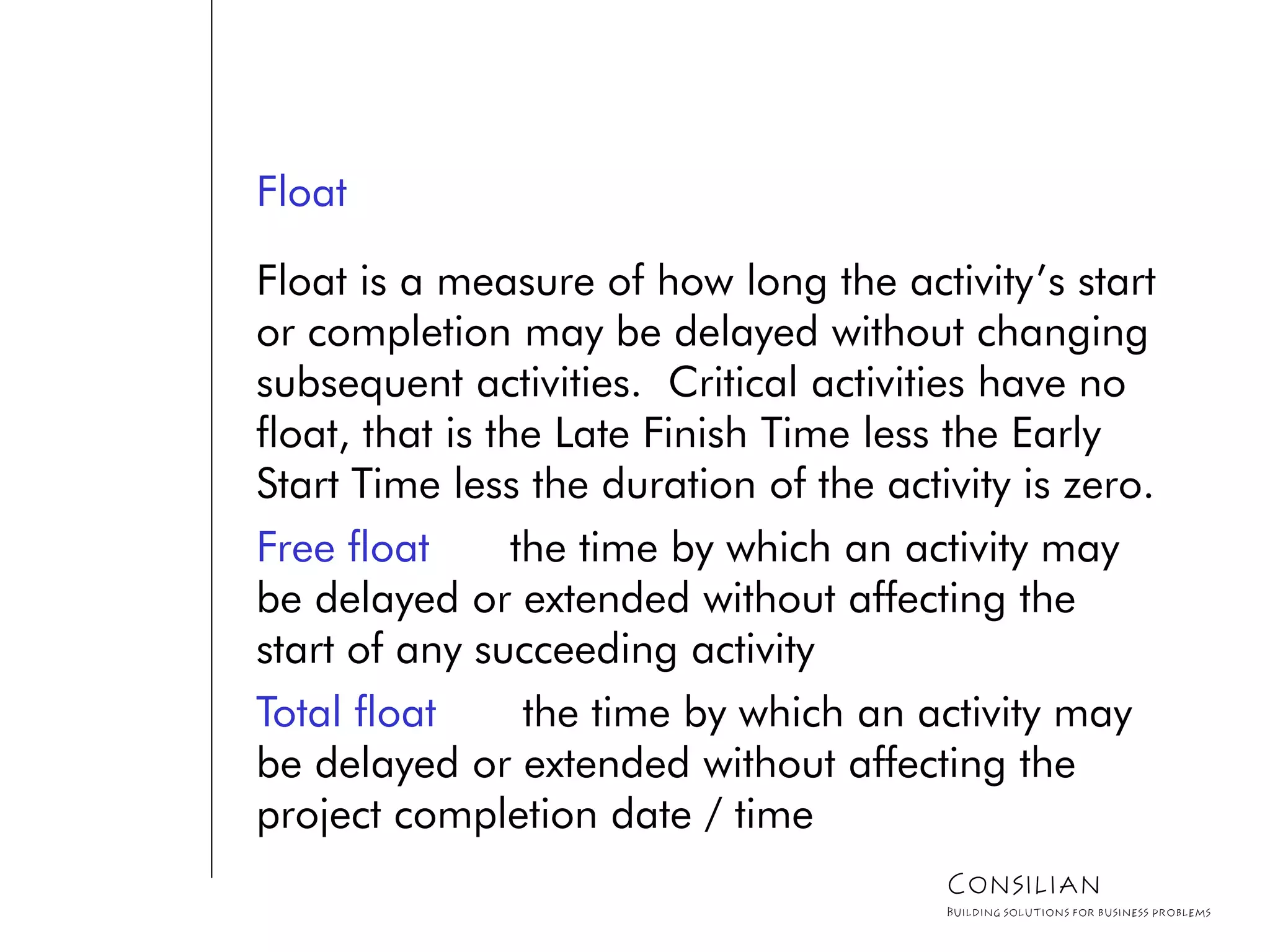

Float
Float is a measure of how long the activity’s start
or completion may be delayed without changing
subsequent activities. Critical activities have no
float, that is the Late Finish Time less the Early
Start Time less the duration of the activity is zero.
Free float the time by which an activity may
be delayed or extended without affecting the
start of any succeeding activity
Total float the time by which an activity may
be delayed or extended without affecting the
project completion date / time
Consilian
Building solutions for business problems

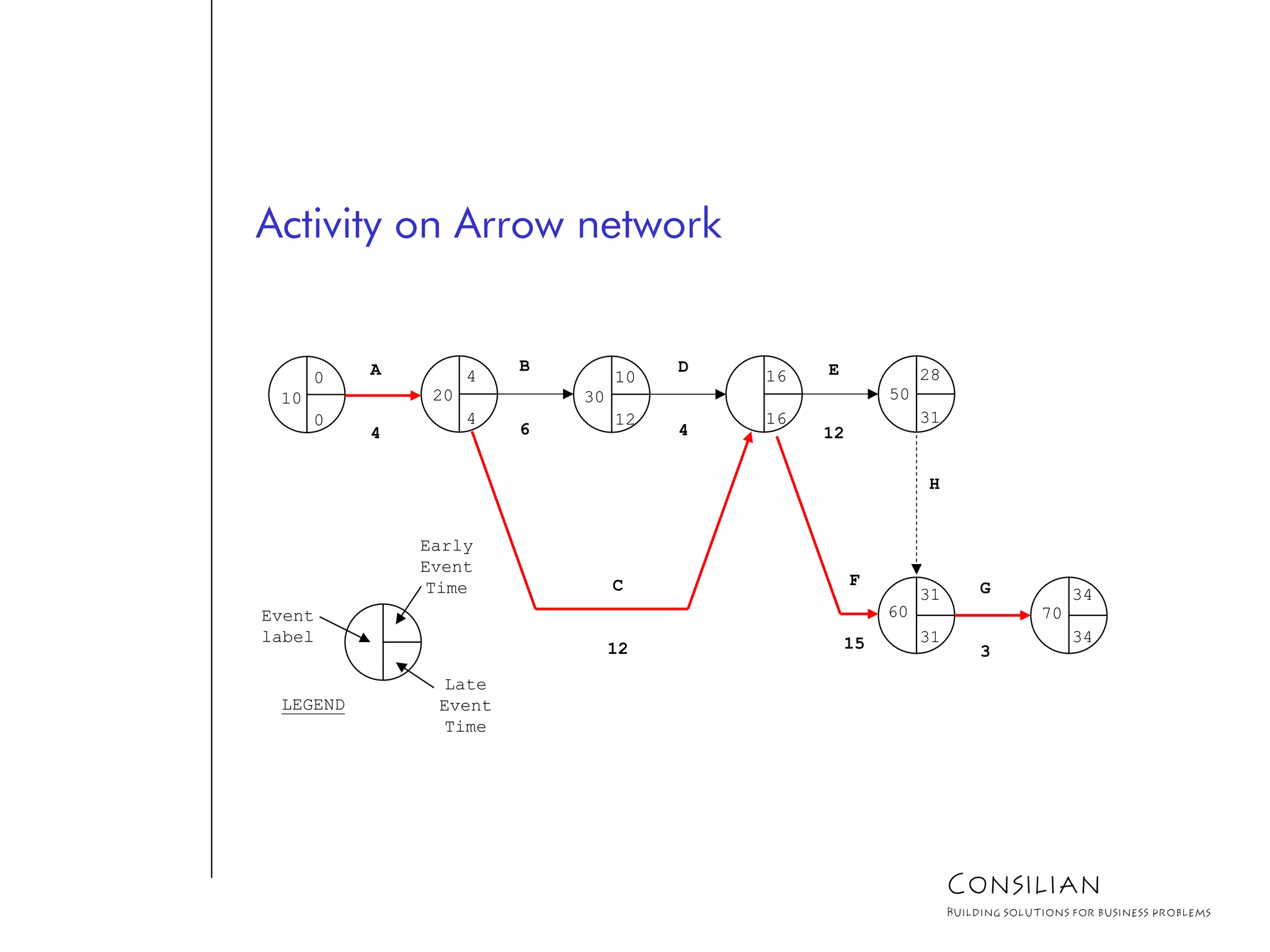

60
31
31
70
34
34
F
15
G
3
20
4
4
10
0
0
A
4
30
10
12
B
6
C
12
50
16
16
28
31
D
4
E
12
H
Early
Event
Time
Late
Event
Time
Event
label
LEGEND
Activity on Arrow network
Consilian
Building solutions for business problems

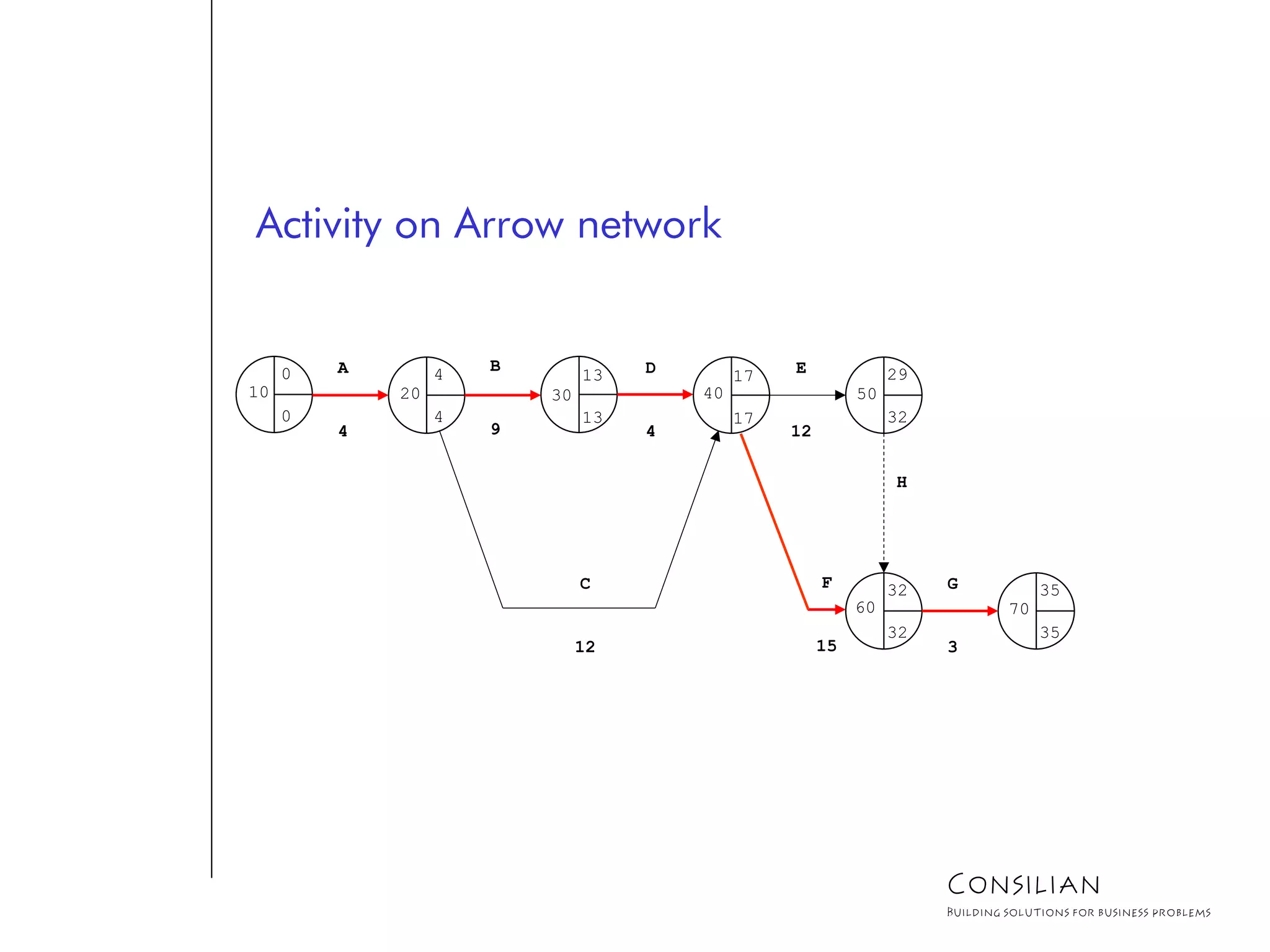

Activity on Arrow network
10
0
0
A
4
C
12
20
4
4
30
13
13
B
9
40
17
17
D
4
E
12
F
15
60
32
32
70
35
35
G
3
50
29
32
H
Consilian
Building solutions for business problems

Activities on the node networks
A network in which the nodes (rather than the
arrows) symbolise the activities. Also called a
Precedence Diagram.
Latest start
Activity label
Total float
Earliest
start
Duration
Consilian
Building solutions for business problems

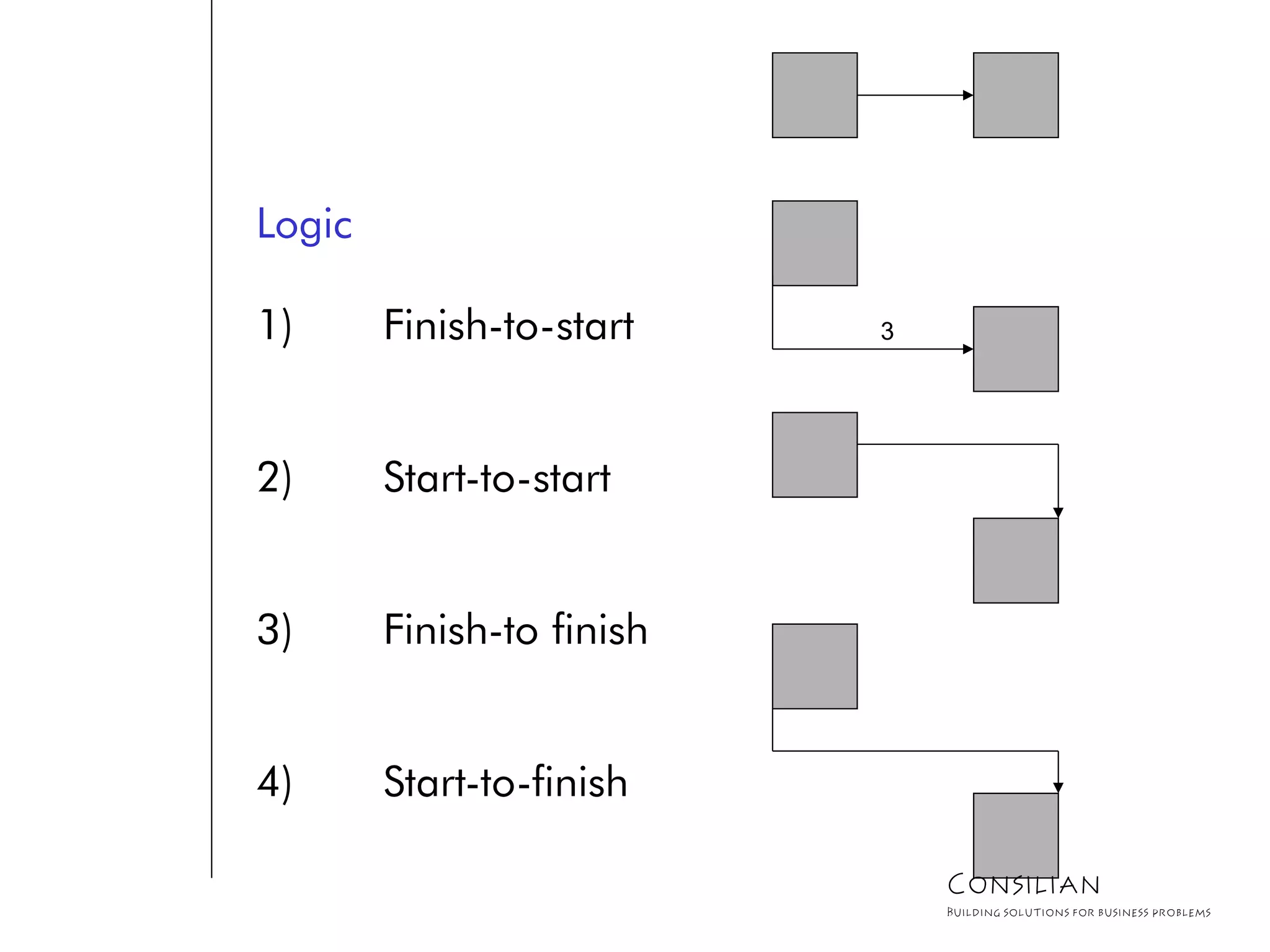

Logic
1) Finish-to-start
2) Start-to-start
3) Finish-to finish
4) Start-to-finish
3
Consilian
Building solutions for business problems

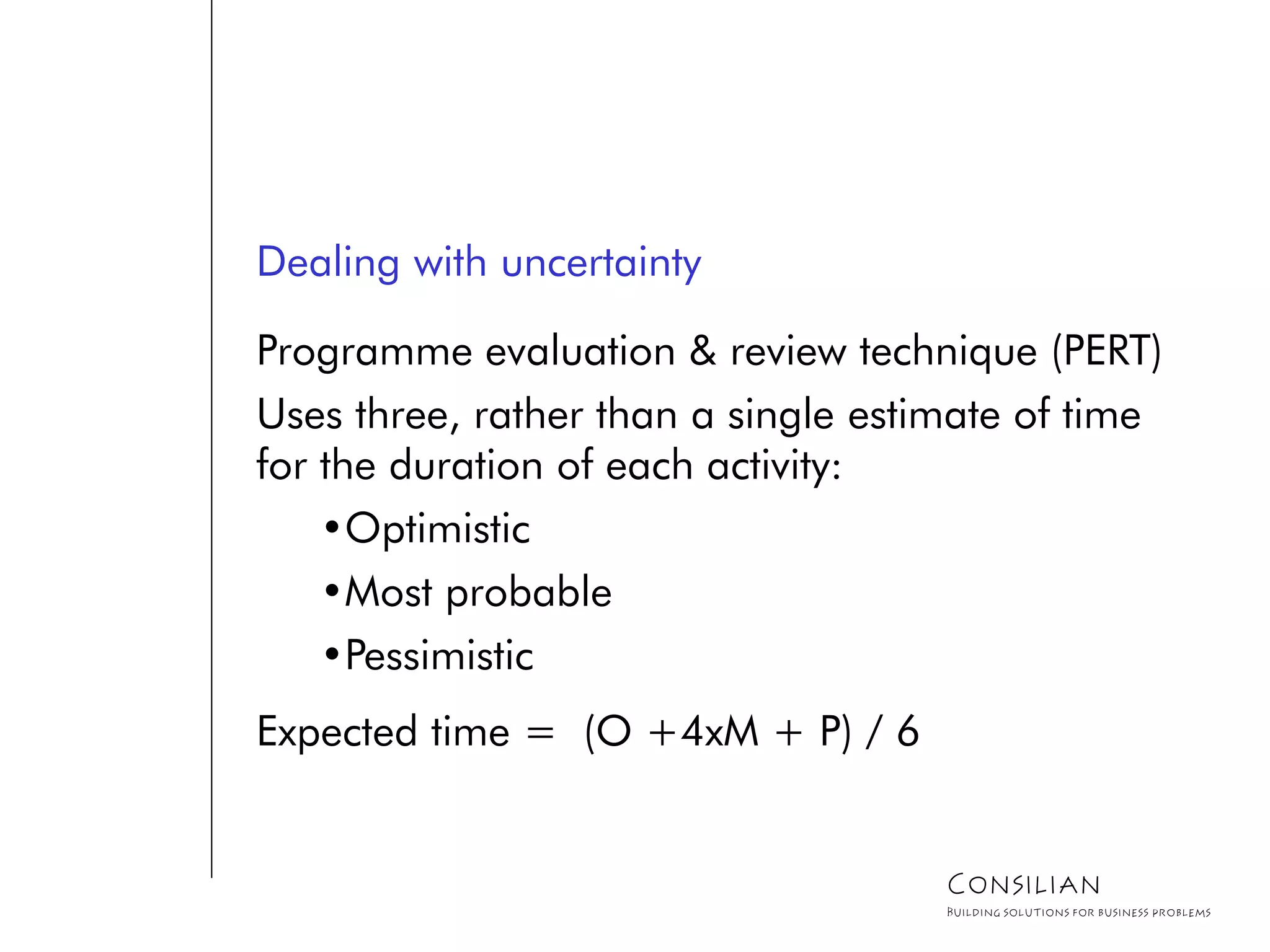

Dealing with uncertainty
Programme evaluation & review technique (PERT)
Uses three, rather than a single estimate of time
for the duration of each activity:
•Optimistic
•Most probable
•Pessimistic
Expected time = (O +4xM + P) / 6
Consilian
Building solutions for business problems

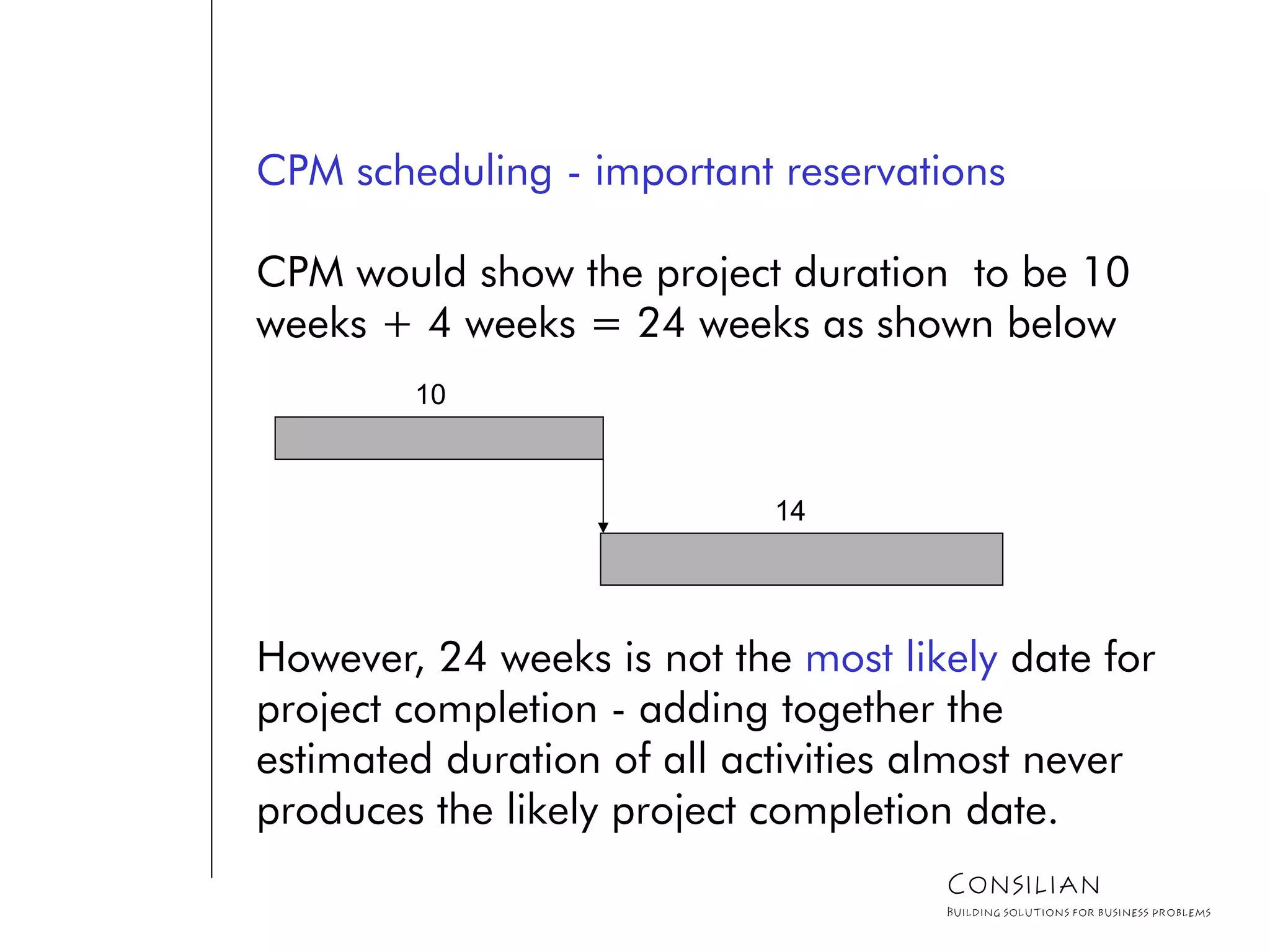

CPM scheduling - important reservations
CPM would show the project duration to be 10
weeks + 4 weeks = 24 weeks as shown below
10
14
However, 24 weeks is not the most likely date for
project completion - adding together the
estimated duration of all activities almost never
produces the likely project completion date.
Consilian
Building solutions for business problems

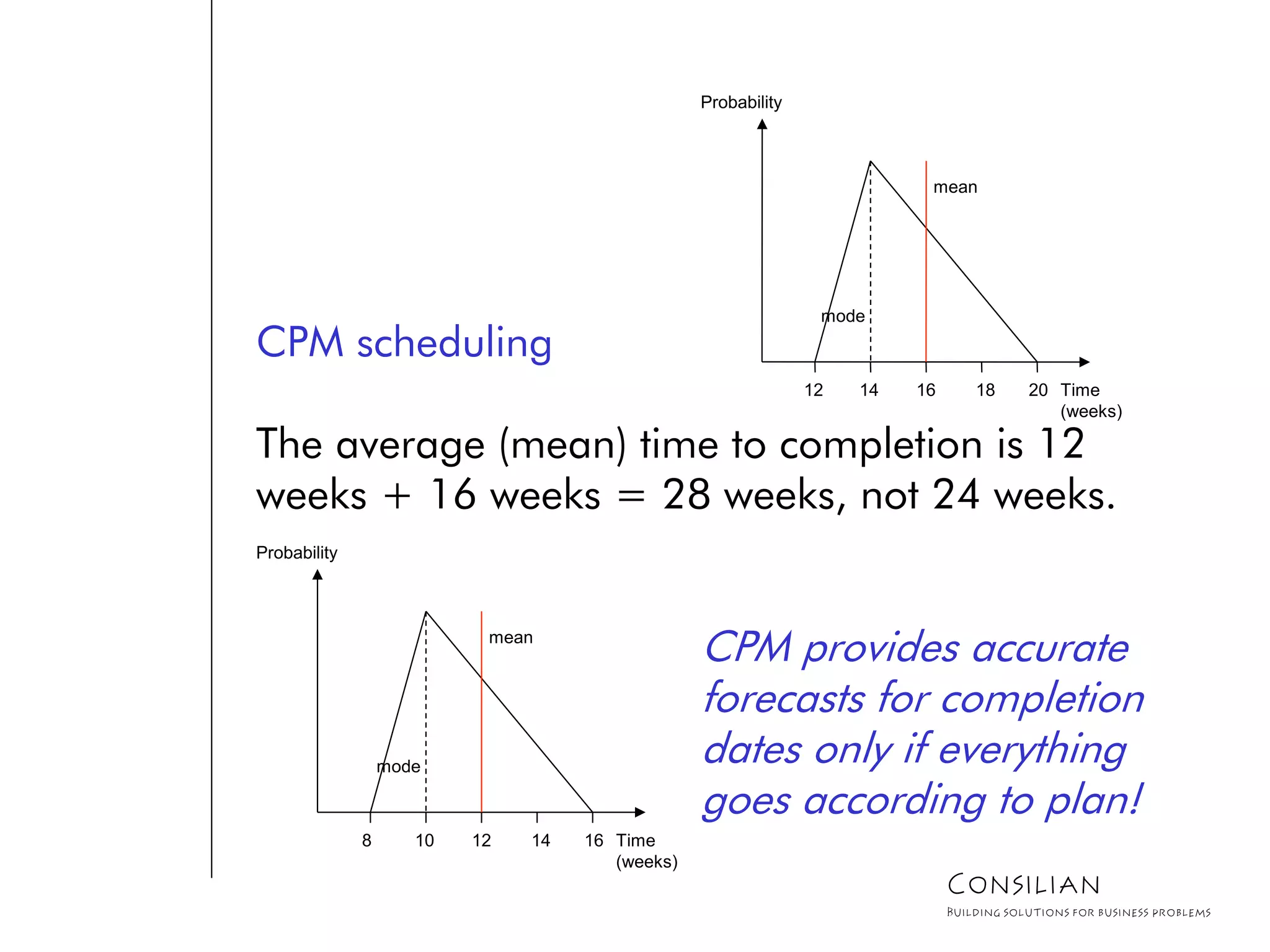

CPM scheduling
The average (mean) time to completion is 12
weeks + 16 weeks = 28 weeks, not 24 weeks.
8 10 12 14 16 Time
(weeks)
Probability
mean
mode
12 14 16 18 20 Time
(weeks)
Probability
mean
mode
CPM provides accurate
forecasts for completion
dates only if everything
goes according to plan!
Consilian
Building solutions for business problems

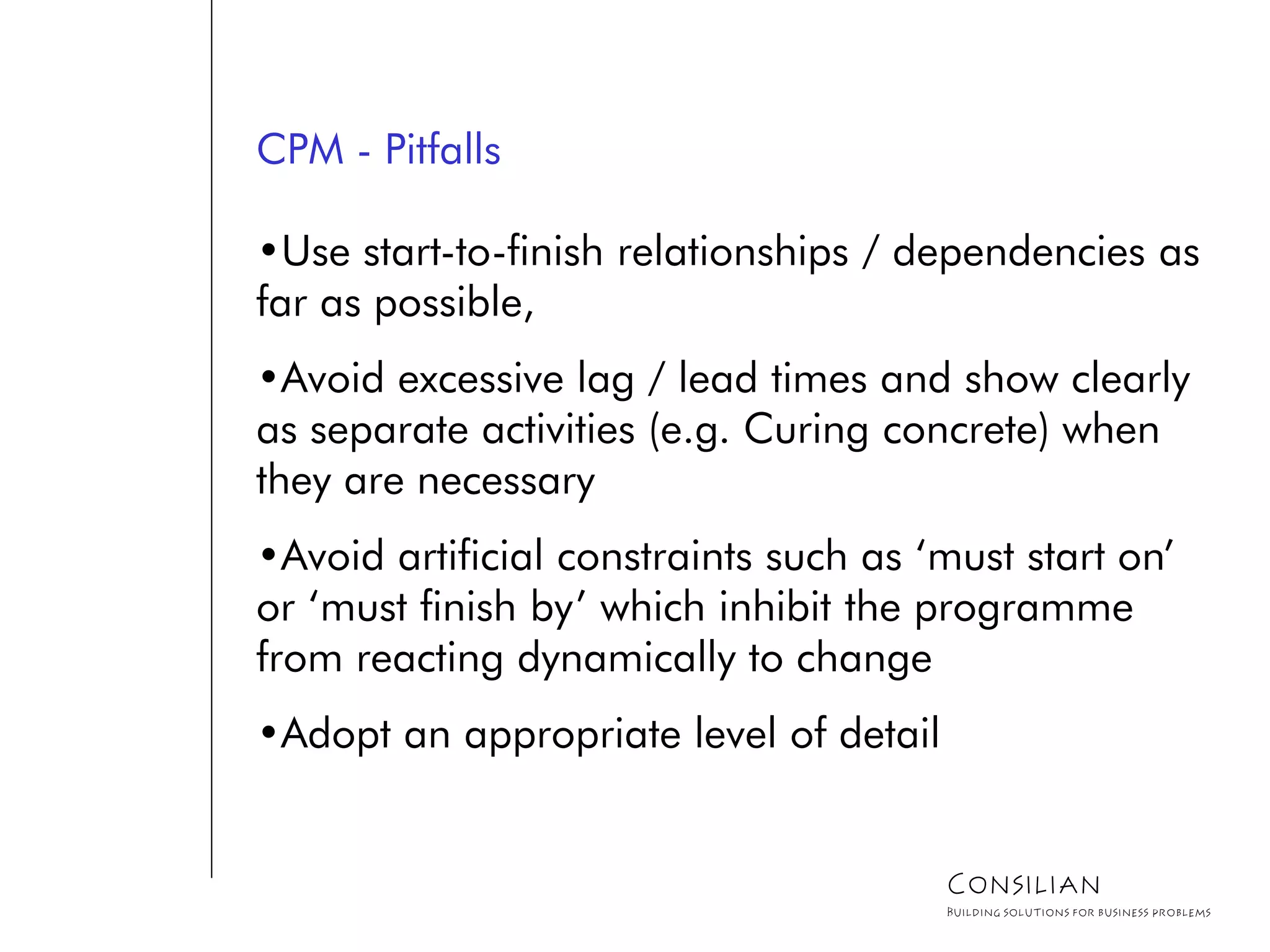

CPM - Pitfalls
•Use start-to-finish relationships / dependencies as
far as possible,
•Avoid excessive lag / lead times and show clearly
as separate activities (e.g. Curing concrete) when
they are necessary
•Avoid artificial constraints such as ‘must start on’
or ‘must finish by’ which inhibit the programme
from reacting dynamically to change
•Adopt an appropriate level of detail
Consilian
Building solutions for business problems

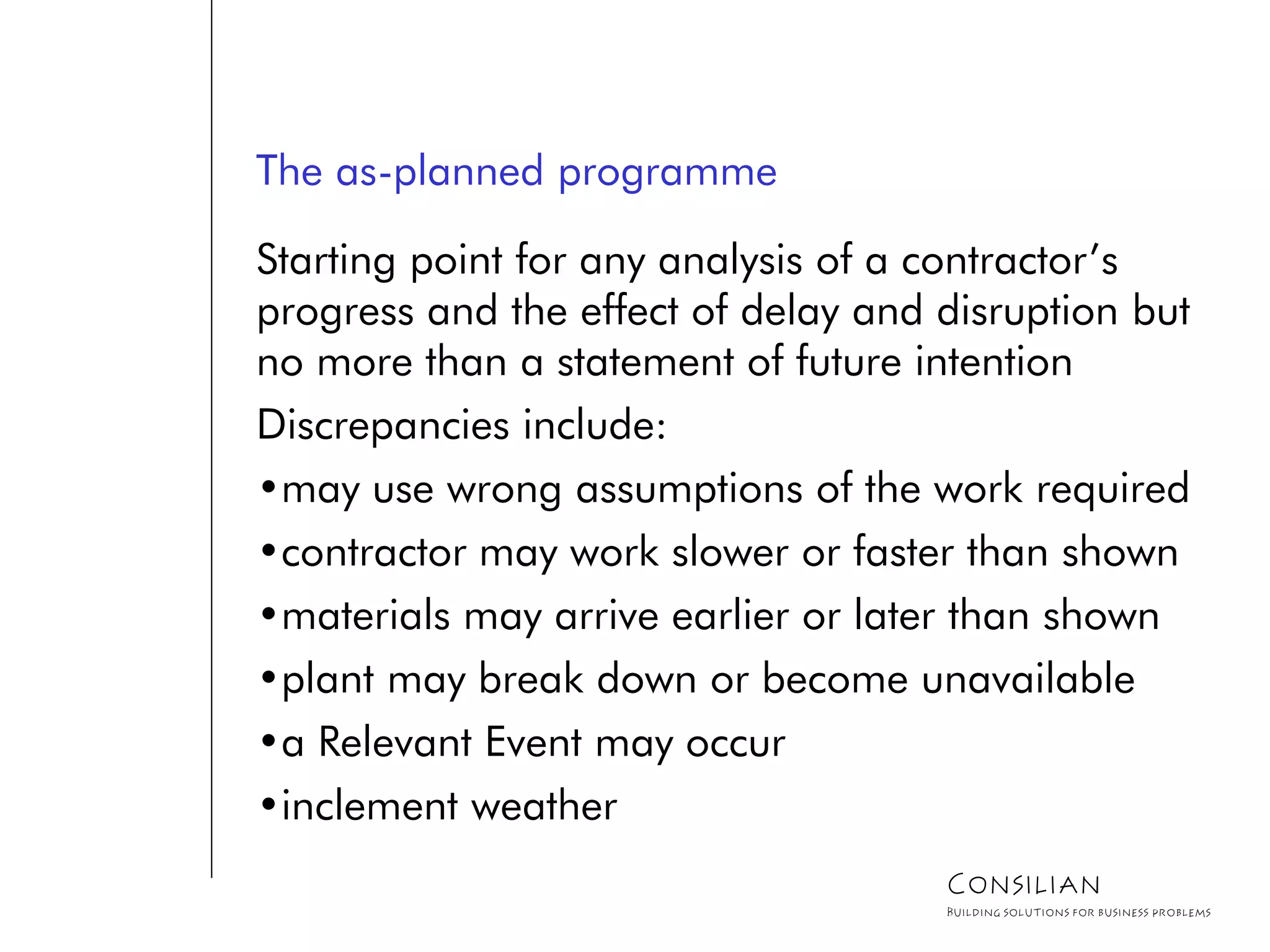

The as-planned programme
Starting point for any analysis of a contractor’s
progress and the effect of delay and disruption but
no more than a statement of future intention
Discrepancies include:
•may use wrong assumptions of the work required
•contractor may work slower or faster than shown
•materials may arrive earlier or later than shown
•plant may break down or become unavailable
•a Relevant Event may occur
•inclement weather
Consilian
Building solutions for business problems

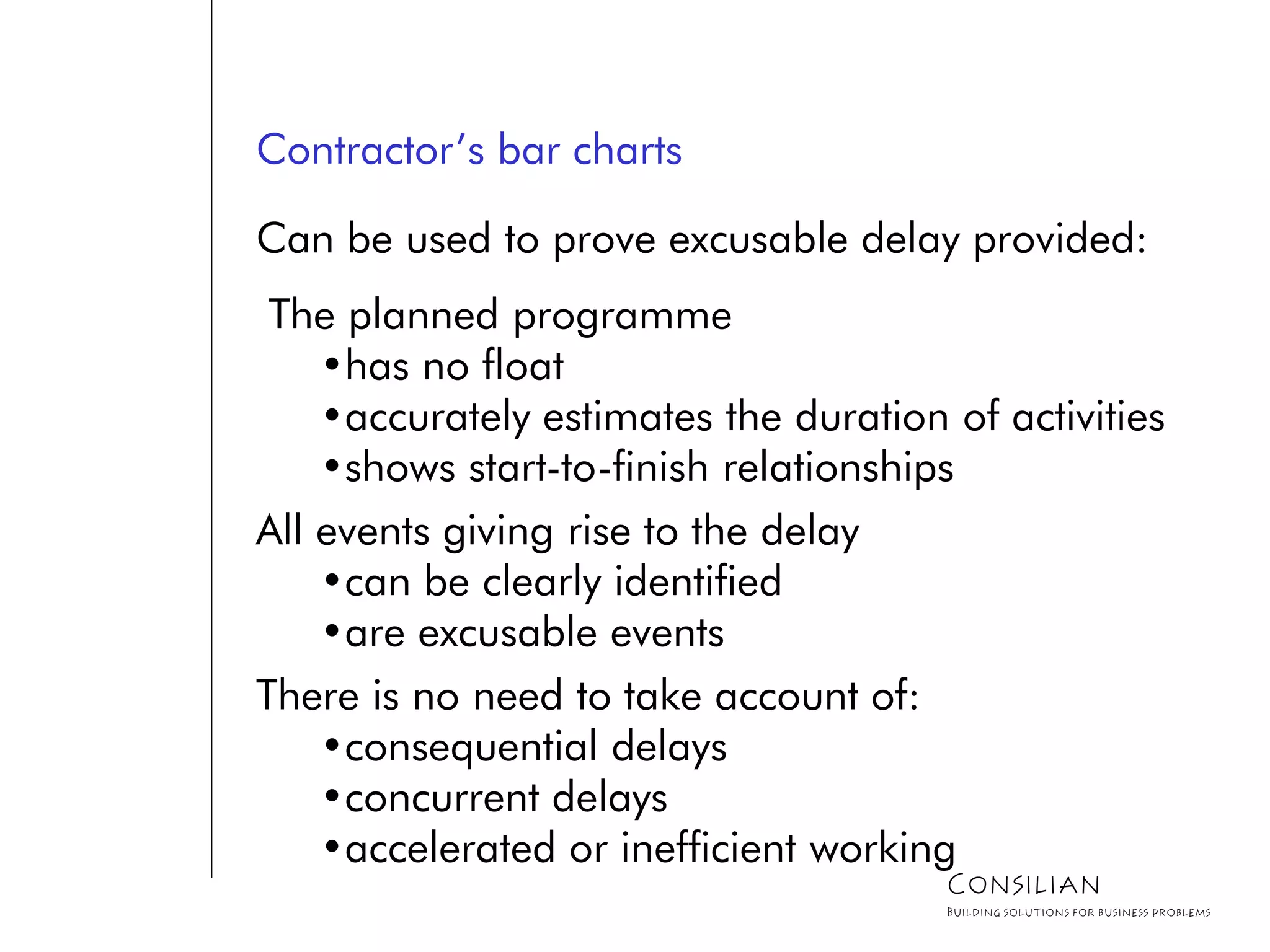

Contractor’s bar charts
Can be used to prove excusable delay provided:
The planned programme
•has no float
•accurately estimates the duration of activities
•shows start-to-finish relationships
All events giving rise to the delay
•can be clearly identified
•are excusable events
There is no need to take account of:
•consequential delays
•concurrent delays
•accelerated or inefficient working
Consilian
Building solutions for business problems

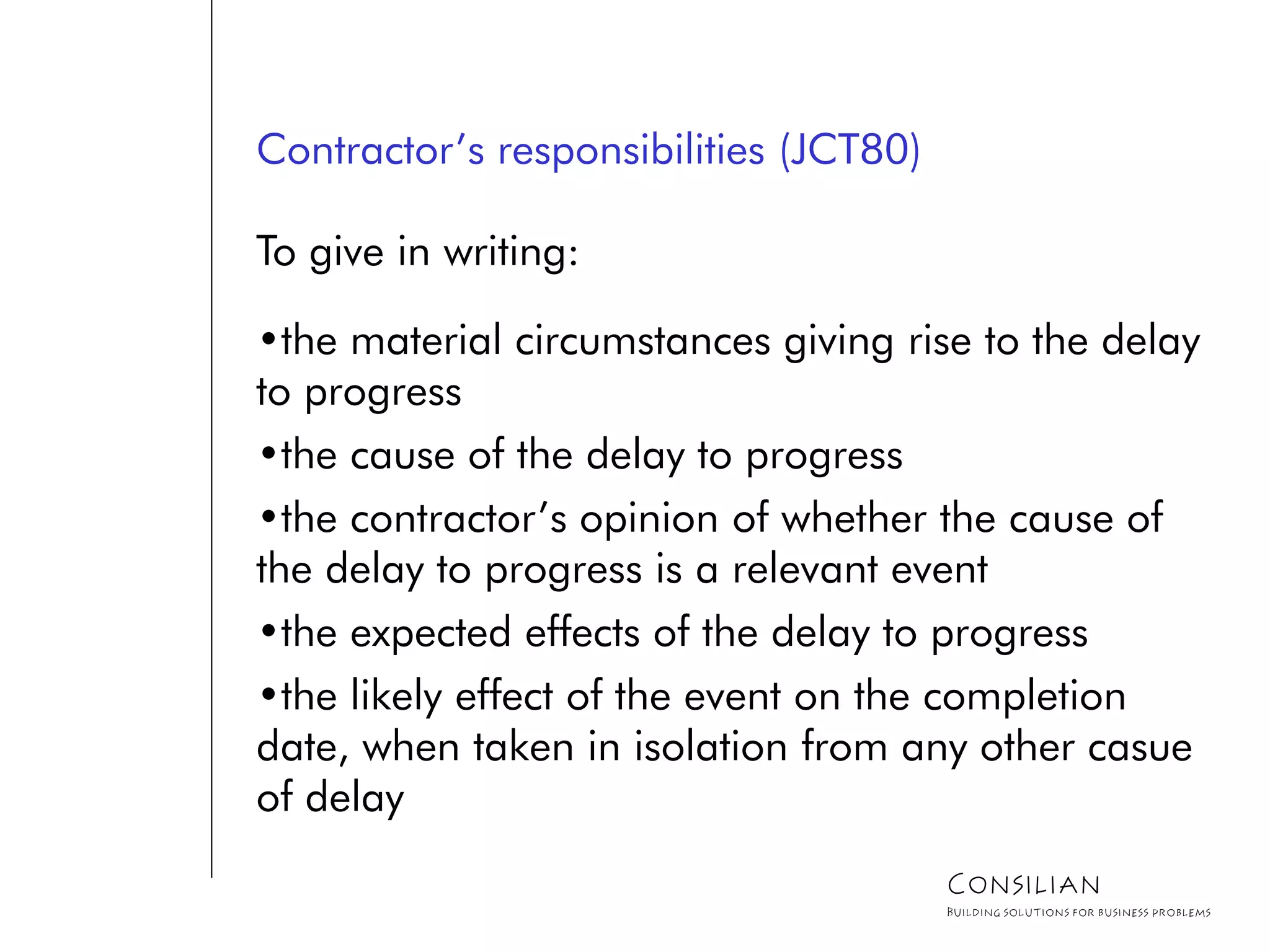

Contractor’s responsibilities (JCT80)
To give in writing:
•the material circumstances giving rise to the delay
to progress
•the cause of the delay to progress
•the contractor’s opinion of whether the cause of
the delay to progress is a relevant event
•the expected effects of the delay to progress
•the likely effect of the event on the completion
date, when taken in isolation from any other casue
of delay
Consilian
Building solutions for business problems

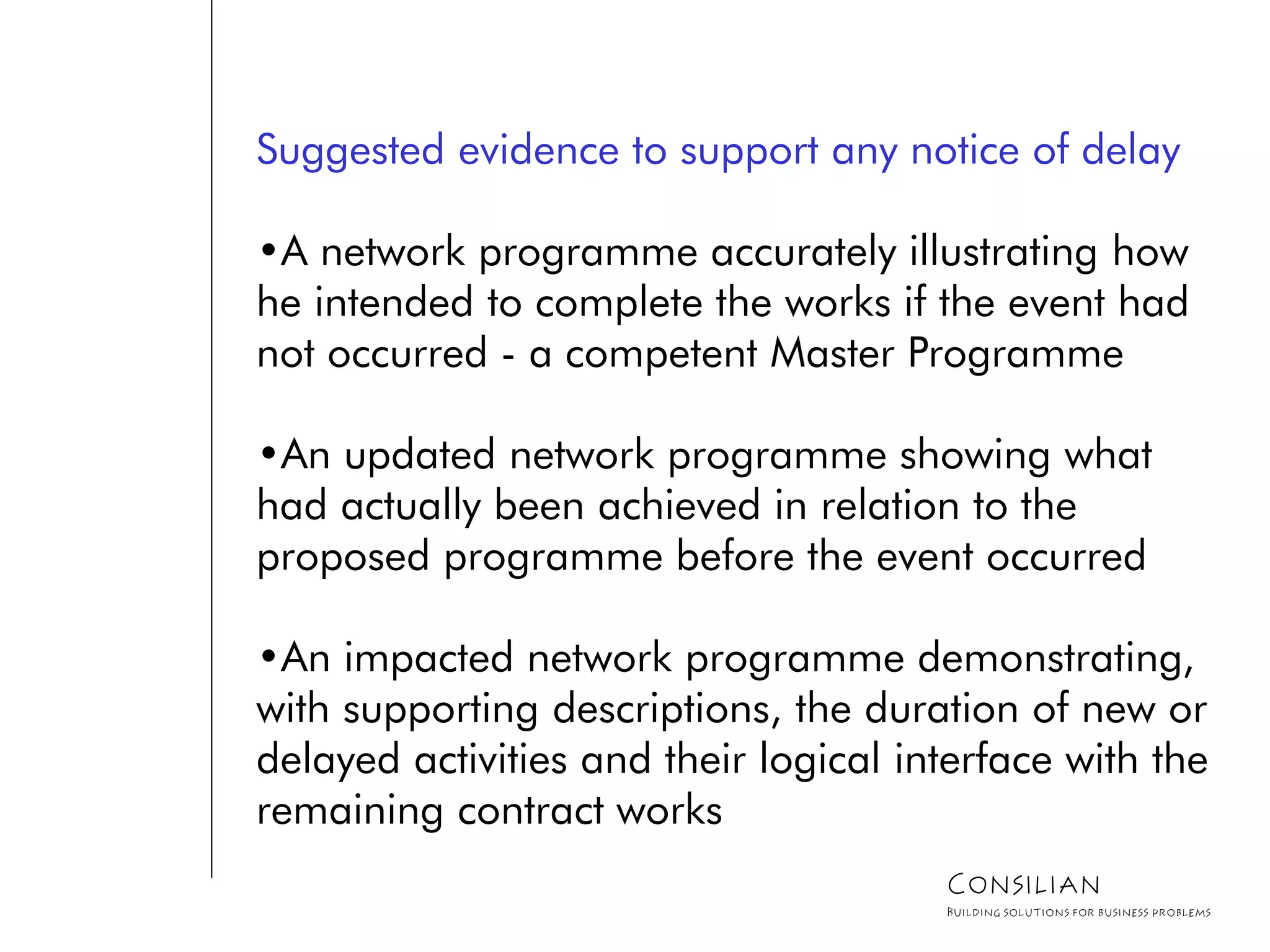

Suggested evidence to support any notice of delay
•A network programme accurately illustrating how
he intended to complete the works if the event had
not occurred - a competent Master Programme
•An updated network programme showing what
had actually been achieved in relation to the
proposed programme before the event occurred
•An impacted network programme demonstrating,
with supporting descriptions, the duration of new or
delayed activities and their logical interface with the
remaining contract works
Consilian
Building solutions for business problems

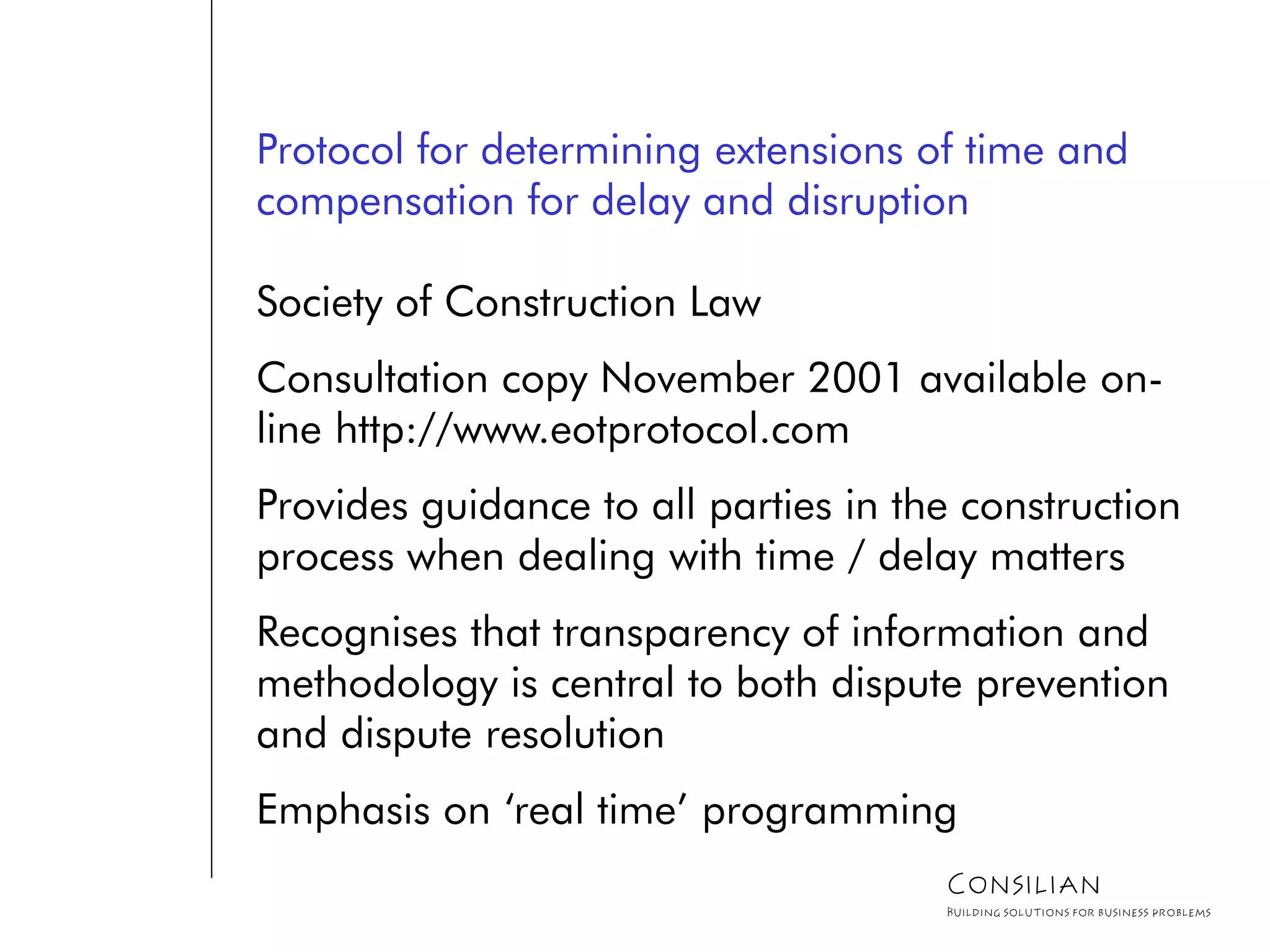

Protocol for determining extensions of time and
compensation for delay and disruption
Society of Construction Law
Consultation copy November 2001 available on-
line http://www.eotprotocol.com
Provides guidance to all parties in the construction
process when dealing with time / delay matters
Recognises that transparency of information and
methodology is central to both dispute prevention
and dispute resolution
Emphasis on ‘real time’ programming
Consilian
Building solutions for business problems

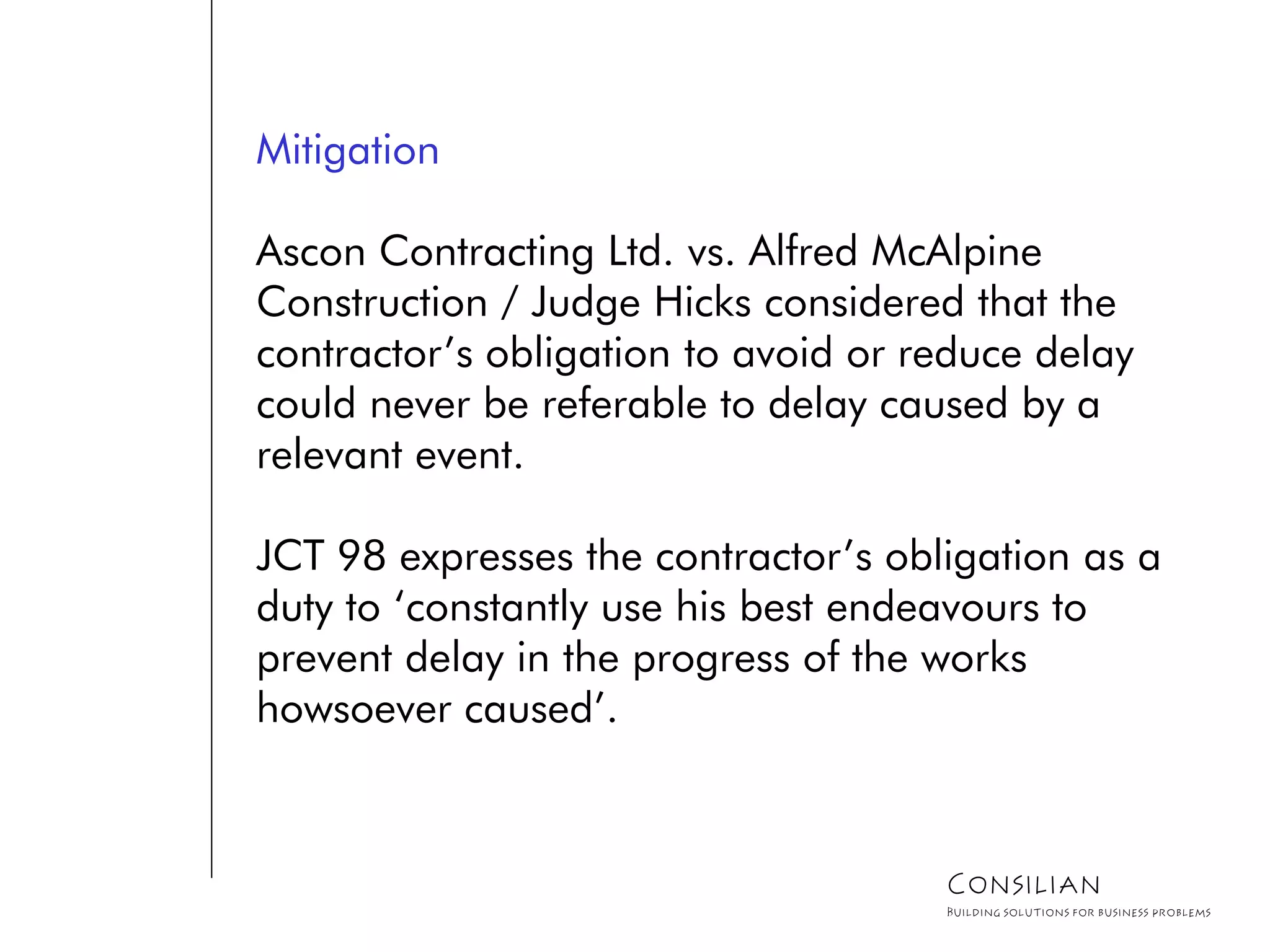

Mitigation
Ascon Contracting Ltd. vs. Alfred McAlpine
Construction / Judge Hicks considered that the
contractor’s obligation to avoid or reduce delay
could never be referable to delay caused by a
relevant event.
JCT 98 expresses the contractor’s obligation as a
duty to ‘constantly use his best endeavours to
prevent delay in the progress of the works
howsoever caused’.
Consilian
Building solutions for business problems
Consilian
Building solutions for business problems

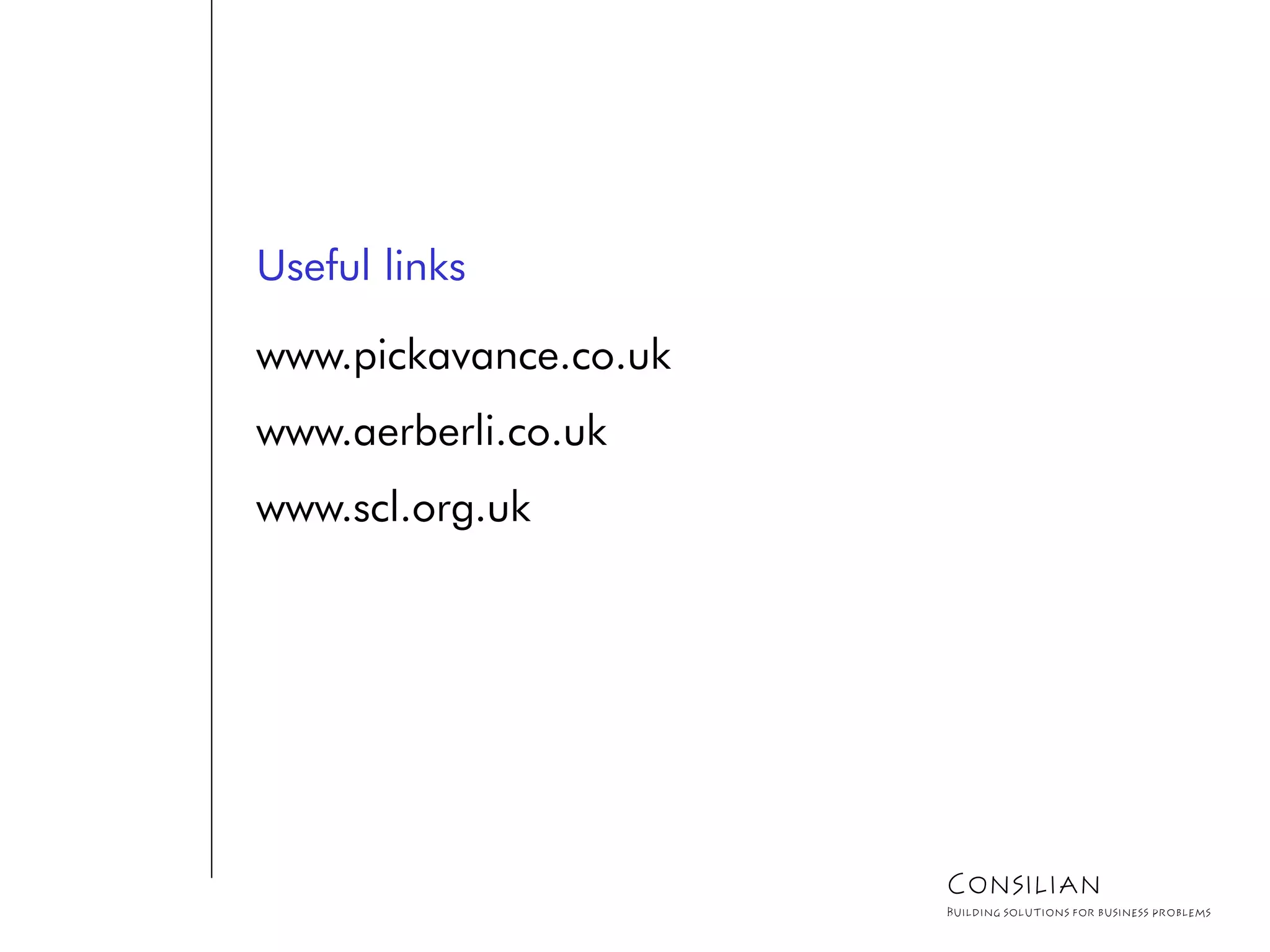

Useful links
www.pickavance.co.uk
www.aerberli.co.uk
www.scl.org.uk
Consilian
Building solutions for business problems

More Related Content

What's hot

Forensic schedule analysis acesss
Forensic schedule analysis acesssForensic schedule analysis acesss
Forensic schedule analysis acesss
McLachlan Lister Pty Limited

Construction Delay Analysis, Simplified
Construction Delay Analysis, SimplifiedConstruction Delay Analysis, Simplified
Construction Delay Analysis, Simplified
Michael Pink

Favorite Delay Analysis Methodologies Town Hall SEI
Favorite Delay Analysis Methodologies Town Hall SEIFavorite Delay Analysis Methodologies Town Hall SEI
Favorite Delay Analysis Methodologies Town Hall SEI
Chris Carson

Extension of Time (EOT) & Related Costs in Construction - Presentation Slides
Extension of Time (EOT) & Related Costs in Construction - Presentation SlidesExtension of Time (EOT) & Related Costs in Construction - Presentation Slides
Extension of Time (EOT) & Related Costs in Construction - Presentation Slides
Asia Master Training آسيا ماسترز للتدريب والتطوير

Fundamentals of scheduling
Fundamentals of schedulingFundamentals of scheduling
Fundamentals of scheduling
jmd2011

Construction delays
Construction delaysConstruction delays
Construction delays
Saida Njim

50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only
M Maged Hegazy, LLM, MBA, CCP, P3O

Claims 20.1 (Flow chart)
Claims 20.1 (Flow chart)Claims 20.1 (Flow chart)
Claims 20.1 (Flow chart)Fakhar-un -Nisa

Baseline Schedules 1
Baseline Schedules 1Baseline Schedules 1
Baseline Schedules 1
Chris Carson

Update Delay Analysis
Update Delay AnalysisUpdate Delay Analysis
Update Delay Analysis
Chris Carson

3. construction planning. construction project management
3. construction planning. construction project management3. construction planning. construction project management
3. construction planning. construction project managementKabilan Kabi

Schedule Updates
Schedule UpdatesSchedule Updates
Schedule Updates
Chris Carson

Concurrent Delay in Construction
Concurrent Delay in ConstructionConcurrent Delay in Construction
Concurrent Delay in Construction
M Maged Hegazy, LLM, MBA, CCP, P3O

Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...
Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...
Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...
Project Controls Expo

Extension of Time (EoT) in Construction Project presentation
Extension of Time (EoT) in Construction Project presentationExtension of Time (EoT) in Construction Project presentation
Extension of Time (EoT) in Construction Project presentation
Ayush Joshi

Essentials of EOT Claims
Essentials of EOT ClaimsEssentials of EOT Claims
Essentials of EOT Claims
M Maged Hegazy, LLM, MBA, CCP, P3O

Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)
mohamed Ismail

construction project planing
 construction project planing construction project planing
construction project planing
SANJEEV Wazir

What's hot (20)

Forensic schedule analysis acesss
Forensic schedule analysis acesssForensic schedule analysis acesss
Forensic schedule analysis acesss

Construction Delay Analysis, Simplified
Construction Delay Analysis, SimplifiedConstruction Delay Analysis, Simplified
Construction Delay Analysis, Simplified

Favorite Delay Analysis Methodologies Town Hall SEI
Favorite Delay Analysis Methodologies Town Hall SEIFavorite Delay Analysis Methodologies Town Hall SEI
Favorite Delay Analysis Methodologies Town Hall SEI

Extension of Time (EOT) & Related Costs in Construction - Presentation Slides
Extension of Time (EOT) & Related Costs in Construction - Presentation SlidesExtension of Time (EOT) & Related Costs in Construction - Presentation Slides
Extension of Time (EOT) & Related Costs in Construction - Presentation Slides

Schedule-Delay Analysis
Schedule-Delay AnalysisSchedule-Delay Analysis
Schedule-Delay Analysis

Fundamentals of scheduling
Fundamentals of schedulingFundamentals of scheduling
Fundamentals of scheduling

Construction delays
Construction delaysConstruction delays
Construction delays

50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only

Claims 20.1 (Flow chart)
Claims 20.1 (Flow chart)Claims 20.1 (Flow chart)
Claims 20.1 (Flow chart)

Baseline Schedules 1
Baseline Schedules 1Baseline Schedules 1
Baseline Schedules 1

Claims
ClaimsClaims
Claims

Update Delay Analysis
Update Delay AnalysisUpdate Delay Analysis
Update Delay Analysis

3. construction planning. construction project management
3. construction planning. construction project management3. construction planning. construction project management
3. construction planning. construction project management

Schedule Updates
Schedule UpdatesSchedule Updates
Schedule Updates

Concurrent Delay in Construction
Concurrent Delay in ConstructionConcurrent Delay in Construction
Concurrent Delay in Construction

Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...
Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...
Project Controls Expo 18th Nov 2014 - "PACING DELAY The Practical Effect on C...

Extension of Time (EoT) in Construction Project presentation
Extension of Time (EoT) in Construction Project presentationExtension of Time (EoT) in Construction Project presentation
Extension of Time (EoT) in Construction Project presentation

Essentials of EOT Claims
Essentials of EOT ClaimsEssentials of EOT Claims
Essentials of EOT Claims

Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)Time management in fidic red book 2017(prmg080 project)
Time management in fidic red book 2017(prmg080 project)

construction project planing
 construction project planing construction project planing
construction project planing

Similar to Delay analysis ... wise after the event.

Prolongation and HOOH Costs
Prolongation and HOOH CostsProlongation and HOOH Costs
Prolongation and HOOH Costs
Loay Ghazaleh MBA, BSc Civil Eng.

PECDisputeResolution25102018.pptx
PECDisputeResolution25102018.pptxPECDisputeResolution25102018.pptx
PECDisputeResolution25102018.pptx
IrfanAwan25

C. Site managment chapter 5.pptx
C. Site managment chapter 5.pptxC. Site managment chapter 5.pptx
C. Site managment chapter 5.pptx
EdenBekele5

Introduction to project management
Introduction to project managementIntroduction to project management
Introduction to project management
Chris Hattingh

Major Projects - Faster Better Cheaper
Major Projects - Faster Better CheaperMajor Projects - Faster Better Cheaper
Major Projects - Faster Better Cheaper
Ian Heptinstall

AACE Recommended Practice Time Impact Analysis 52R.pdf
AACE Recommended Practice Time Impact Analysis 52R.pdfAACE Recommended Practice Time Impact Analysis 52R.pdf
AACE Recommended Practice Time Impact Analysis 52R.pdf
Valerie Felton

Definition of requirements for each project phases.pdf
Definition of requirements for each project phases.pdfDefinition of requirements for each project phases.pdf
Definition of requirements for each project phases.pdf
calf_ville86

afar-04-construction-accounting-advanced-financial-accounting-reporting.pdf
afar-04-construction-accounting-advanced-financial-accounting-reporting.pdfafar-04-construction-accounting-advanced-financial-accounting-reporting.pdf
afar-04-construction-accounting-advanced-financial-accounting-reporting.pdf
Giovanniperez59

Professional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOTProfessional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOT
Yee Len Wan

Course ProjectPart 1 – Building Your Project PlanYou and your
Course ProjectPart 1 – Building Your Project PlanYou and your Course ProjectPart 1 – Building Your Project PlanYou and your
Course ProjectPart 1 – Building Your Project PlanYou and your
CruzIbarra161

The project plan
The project planThe project plan
The project plan
VatsalaPG

Extensions of Time - Contract Management
Extensions of Time - Contract ManagementExtensions of Time - Contract Management
Extensions of Time - Contract Management
brainquisitive

Saving time with CCPM
Saving time with CCPMSaving time with CCPM
Saving time with CCPM
Freek de Ruiter

Planning & Scheduling of Commercial Building using Microsoft Project & Applic...
Planning & Scheduling of Commercial Building using Microsoft Project & Applic...Planning & Scheduling of Commercial Building using Microsoft Project & Applic...
Planning & Scheduling of Commercial Building using Microsoft Project & Applic...
IRJET Journal

Mitigation Of Risks In Using Parallel Schedules
Mitigation Of Risks In Using Parallel SchedulesMitigation Of Risks In Using Parallel Schedules
Mitigation Of Risks In Using Parallel Schedules
Chris Carson

Mitigation of Risk in Dual Schedules
Mitigation of Risk in Dual SchedulesMitigation of Risk in Dual Schedules
Mitigation of Risk in Dual Schedules
Chris Carson

COVERTITLE PAGE Table of ContentsI. Integrated Projec
COVERTITLE PAGE Table of ContentsI. Integrated ProjecCOVERTITLE PAGE Table of ContentsI. Integrated Projec
COVERTITLE PAGE Table of ContentsI. Integrated Projec
CruzIbarra161

Project management Using Pert
Project management Using PertProject management Using Pert
Project management Using Pert
Vishnu RC Vijayan

GCC2015 Course_Day2
GCC2015 Course_Day2GCC2015 Course_Day2
GCC2015 Course_Day2JB Nartey

GCC2015 Course_Day2
GCC2015 Course_Day2GCC2015 Course_Day2
GCC2015 Course_Day2JB Nartey

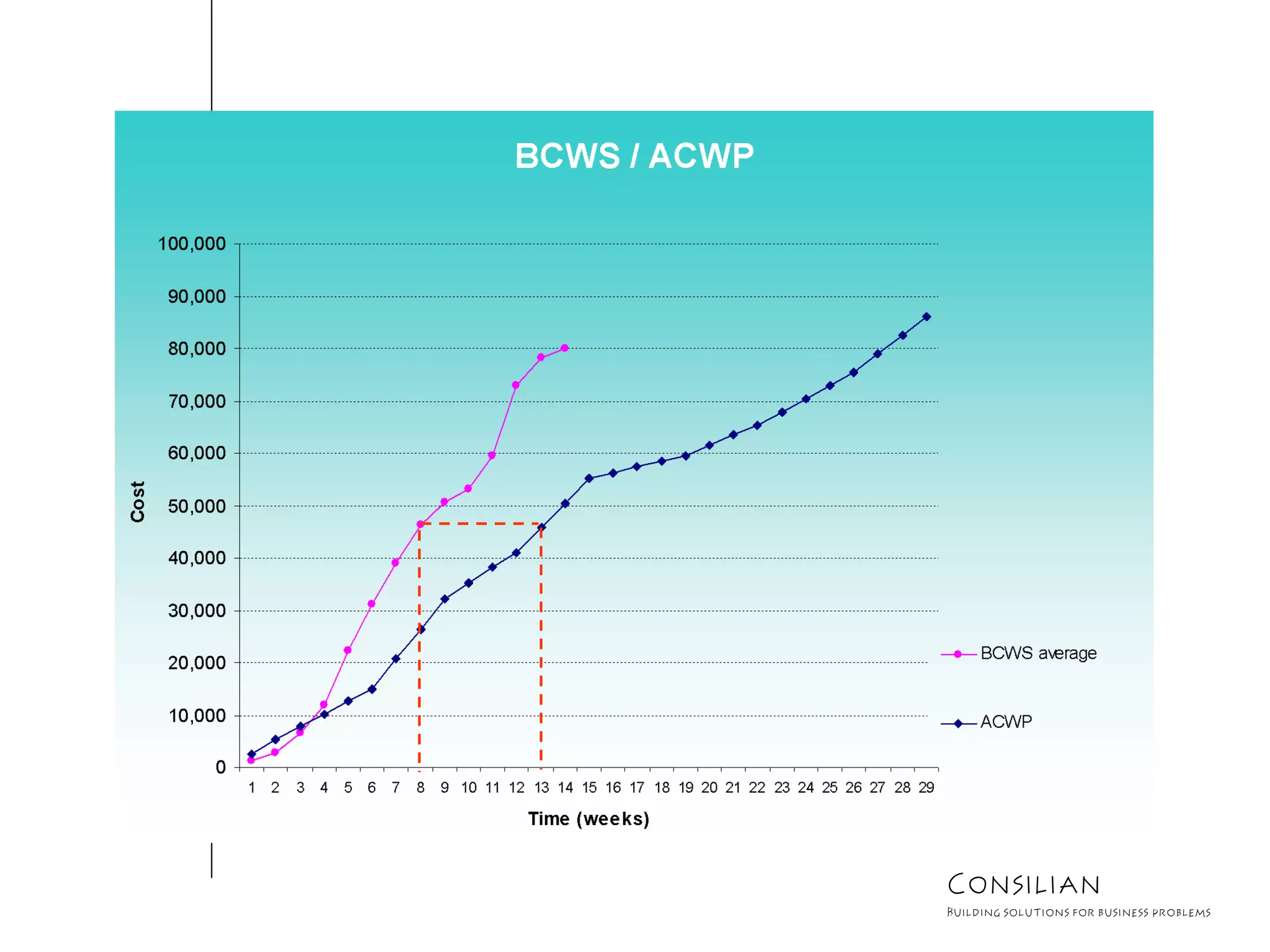

Similar to Delay analysis ... wise after the event. (20)

Prolongation and HOOH Costs
Prolongation and HOOH CostsProlongation and HOOH Costs
Prolongation and HOOH Costs

PECDisputeResolution25102018.pptx
PECDisputeResolution25102018.pptxPECDisputeResolution25102018.pptx
PECDisputeResolution25102018.pptx

C. Site managment chapter 5.pptx
C. Site managment chapter 5.pptxC. Site managment chapter 5.pptx
C. Site managment chapter 5.pptx

Introduction to project management
Introduction to project managementIntroduction to project management
Introduction to project management

Major Projects - Faster Better Cheaper
Major Projects - Faster Better CheaperMajor Projects - Faster Better Cheaper
Major Projects - Faster Better Cheaper

AACE Recommended Practice Time Impact Analysis 52R.pdf
AACE Recommended Practice Time Impact Analysis 52R.pdfAACE Recommended Practice Time Impact Analysis 52R.pdf
AACE Recommended Practice Time Impact Analysis 52R.pdf

Definition of requirements for each project phases.pdf
Definition of requirements for each project phases.pdfDefinition of requirements for each project phases.pdf
Definition of requirements for each project phases.pdf

afar-04-construction-accounting-advanced-financial-accounting-reporting.pdf
afar-04-construction-accounting-advanced-financial-accounting-reporting.pdfafar-04-construction-accounting-advanced-financial-accounting-reporting.pdf
afar-04-construction-accounting-advanced-financial-accounting-reporting.pdf

Professional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOTProfessional Practice II - Presentation - Construction Delays & EOT
Professional Practice II - Presentation - Construction Delays & EOT

Course ProjectPart 1 – Building Your Project PlanYou and your
Course ProjectPart 1 – Building Your Project PlanYou and your Course ProjectPart 1 – Building Your Project PlanYou and your
Course ProjectPart 1 – Building Your Project PlanYou and your

The project plan
The project planThe project plan
The project plan

Extensions of Time - Contract Management
Extensions of Time - Contract ManagementExtensions of Time - Contract Management
Extensions of Time - Contract Management

Saving time with CCPM
Saving time with CCPMSaving time with CCPM
Saving time with CCPM

Planning & Scheduling of Commercial Building using Microsoft Project & Applic...
Planning & Scheduling of Commercial Building using Microsoft Project & Applic...Planning & Scheduling of Commercial Building using Microsoft Project & Applic...
Planning & Scheduling of Commercial Building using Microsoft Project & Applic...

Mitigation Of Risks In Using Parallel Schedules
Mitigation Of Risks In Using Parallel SchedulesMitigation Of Risks In Using Parallel Schedules
Mitigation Of Risks In Using Parallel Schedules

Mitigation of Risk in Dual Schedules
Mitigation of Risk in Dual SchedulesMitigation of Risk in Dual Schedules
Mitigation of Risk in Dual Schedules

COVERTITLE PAGE Table of ContentsI. Integrated Projec
COVERTITLE PAGE Table of ContentsI. Integrated ProjecCOVERTITLE PAGE Table of ContentsI. Integrated Projec
COVERTITLE PAGE Table of ContentsI. Integrated Projec

Project management Using Pert
Project management Using PertProject management Using Pert
Project management Using Pert

GCC2015 Course_Day2
GCC2015 Course_Day2GCC2015 Course_Day2
GCC2015 Course_Day2

GCC2015 Course_Day2
GCC2015 Course_Day2GCC2015 Course_Day2
GCC2015 Course_Day2

Recently uploaded

Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...
Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...
Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...
Newman George Leech

How to keep your Home naturally Cool and Warm
How to keep your Home naturally Cool and WarmHow to keep your Home naturally Cool and Warm
How to keep your Home naturally Cool and Warm
Vinra Construction

Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...
Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...
Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...
Volition Properties

Biography and career about Lixin Azarmehr
Biography and career about Lixin AzarmehrBiography and career about Lixin Azarmehr
Biography and career about Lixin Azarmehr
Lixin Azarmehr

Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...
Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...
Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...
JagadishKR1

Killer Referans Bahcesehir Catalog Listing Turkey
Killer Referans Bahcesehir Catalog Listing TurkeyKiller Referans Bahcesehir Catalog Listing Turkey
Killer Referans Bahcesehir Catalog Listing Turkey
Listing Turkey

Omaxe Sports City Dwarka A Comprehensive Guide
Omaxe Sports City Dwarka A Comprehensive GuideOmaxe Sports City Dwarka A Comprehensive Guide
Omaxe Sports City Dwarka A Comprehensive Guide
omaxesportscitydwark

MC Heights-Best Construction Company in jhang
MC Heights-Best Construction Company in jhangMC Heights-Best Construction Company in jhang
MC Heights-Best Construction Company in jhang
laraibfatim009

Presentation to Windust Meadows HOA Board of Directors June 4, 2024: Focus o...
Presentation to Windust Meadows HOA Board of Directors June 4, 2024:  Focus o...Presentation to Windust Meadows HOA Board of Directors June 4, 2024:  Focus o...
Presentation to Windust Meadows HOA Board of Directors June 4, 2024: Focus o...
Joseph Lewis Aguirre

One20 North Vancouver Floor Plans by Three Shores Development.
One20 North Vancouver Floor Plans by Three Shores Development.One20 North Vancouver Floor Plans by Three Shores Development.
One20 North Vancouver Floor Plans by Three Shores Development.
VickyAulakh1

Optimizing Your MCA Lead Capture Process for Better Results
Optimizing Your MCA Lead Capture Process for Better ResultsOptimizing Your MCA Lead Capture Process for Better Results
Optimizing Your MCA Lead Capture Process for Better Results
Lead Generation Media

Green Homes, Islamabad Presentation .pdf
Green Homes, Islamabad Presentation .pdfGreen Homes, Islamabad Presentation .pdf
Green Homes, Islamabad Presentation .pdf
ticktoktips

Avrupa Konutlari Yenimahalle - Listing Turkey
Avrupa Konutlari Yenimahalle - Listing TurkeyAvrupa Konutlari Yenimahalle - Listing Turkey
Avrupa Konutlari Yenimahalle - Listing Turkey
Listing Turkey

How to Scan Tenants in NYC - You Should Know!
How to Scan Tenants in NYC - You Should Know!How to Scan Tenants in NYC - You Should Know!
How to Scan Tenants in NYC - You Should Know!
BelgiumManagement

One FNG by Group 108 Sector 142 Noida Construction Update
One FNG by Group 108 Sector 142 Noida Construction UpdateOne FNG by Group 108 Sector 142 Noida Construction Update
One FNG by Group 108 Sector 142 Noida Construction Update
One FNG

SVN Live 6.3.24 Weekly Property Broadcast
SVN Live 6.3.24 Weekly Property BroadcastSVN Live 6.3.24 Weekly Property Broadcast
SVN Live 6.3.24 Weekly Property Broadcast
SVN International Corp.

Simpolo Company Profile & Corporate Logo
Simpolo Company Profile & Corporate LogoSimpolo Company Profile & Corporate Logo
Simpolo Company Profile & Corporate Logo
simpolosparkteam

Brigade Insignia at Yelahanka Brochure.pdf
Brigade Insignia at Yelahanka Brochure.pdfBrigade Insignia at Yelahanka Brochure.pdf
Brigade Insignia at Yelahanka Brochure.pdf
SachinChauhan191

2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.
2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.
2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.
aashiyanastardevelop

Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...
Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...
Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...
JagadishKR1

Recently uploaded (20)

Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...
Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...
Oeiras Tech City, Developed by RE Capital and REIG, Will Become Lisbon's Futu...

How to keep your Home naturally Cool and Warm
How to keep your Home naturally Cool and WarmHow to keep your Home naturally Cool and Warm
How to keep your Home naturally Cool and Warm

Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...
Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...
Investing In The US As A Canadian… And How To Do It RIGHT!! (feat. Erwin Szet...

Biography and career about Lixin Azarmehr
Biography and career about Lixin AzarmehrBiography and career about Lixin Azarmehr
Biography and career about Lixin Azarmehr

Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...
Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...
Urbanrise Paradise on Earth - Unveiling Unprecedented Luxury in Exquisite Vil...

Killer Referans Bahcesehir Catalog Listing Turkey
Killer Referans Bahcesehir Catalog Listing TurkeyKiller Referans Bahcesehir Catalog Listing Turkey
Killer Referans Bahcesehir Catalog Listing Turkey

Omaxe Sports City Dwarka A Comprehensive Guide
Omaxe Sports City Dwarka A Comprehensive GuideOmaxe Sports City Dwarka A Comprehensive Guide
Omaxe Sports City Dwarka A Comprehensive Guide

MC Heights-Best Construction Company in jhang
MC Heights-Best Construction Company in jhangMC Heights-Best Construction Company in jhang
MC Heights-Best Construction Company in jhang

Presentation to Windust Meadows HOA Board of Directors June 4, 2024: Focus o...
Presentation to Windust Meadows HOA Board of Directors June 4, 2024:  Focus o...Presentation to Windust Meadows HOA Board of Directors June 4, 2024:  Focus o...
Presentation to Windust Meadows HOA Board of Directors June 4, 2024: Focus o...

One20 North Vancouver Floor Plans by Three Shores Development.
One20 North Vancouver Floor Plans by Three Shores Development.One20 North Vancouver Floor Plans by Three Shores Development.
One20 North Vancouver Floor Plans by Three Shores Development.

Optimizing Your MCA Lead Capture Process for Better Results
Optimizing Your MCA Lead Capture Process for Better ResultsOptimizing Your MCA Lead Capture Process for Better Results
Optimizing Your MCA Lead Capture Process for Better Results

Green Homes, Islamabad Presentation .pdf
Green Homes, Islamabad Presentation .pdfGreen Homes, Islamabad Presentation .pdf
Green Homes, Islamabad Presentation .pdf

Avrupa Konutlari Yenimahalle - Listing Turkey
Avrupa Konutlari Yenimahalle - Listing TurkeyAvrupa Konutlari Yenimahalle - Listing Turkey
Avrupa Konutlari Yenimahalle - Listing Turkey

How to Scan Tenants in NYC - You Should Know!
How to Scan Tenants in NYC - You Should Know!How to Scan Tenants in NYC - You Should Know!
How to Scan Tenants in NYC - You Should Know!

One FNG by Group 108 Sector 142 Noida Construction Update
One FNG by Group 108 Sector 142 Noida Construction UpdateOne FNG by Group 108 Sector 142 Noida Construction Update
One FNG by Group 108 Sector 142 Noida Construction Update

SVN Live 6.3.24 Weekly Property Broadcast
SVN Live 6.3.24 Weekly Property BroadcastSVN Live 6.3.24 Weekly Property Broadcast
SVN Live 6.3.24 Weekly Property Broadcast

Simpolo Company Profile & Corporate Logo
Simpolo Company Profile & Corporate LogoSimpolo Company Profile & Corporate Logo
Simpolo Company Profile & Corporate Logo

Brigade Insignia at Yelahanka Brochure.pdf
Brigade Insignia at Yelahanka Brochure.pdfBrigade Insignia at Yelahanka Brochure.pdf
Brigade Insignia at Yelahanka Brochure.pdf

2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.
2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.
2BHK-3BHK NEW FLAT FOR SALE IN TUPUDANA,RANCHI.

Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...
Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...
Elegant Evergreen Homes - Luxury Apartments Redefining Comfort in Yelahanka, ...

Delay analysis ... wise after the event.

  • 1. Delay Analysis ……. wise after the Event? Consilian Building solutions for business problems
  • 2. Extension of time The purpose of granting an extension of time is to fix the period by which the completion date ought to be extended Consilian Building solutions for business problems
  • 3. Rationale Unless there is an express provision in the contract allowing an extended completion date to be fixed that takes into account a delay caused by the Employer, the delaying event would be deemed as an act of prevention by the Employer that invalidates the contract completion date and extinguishes the Employer’s rights to liquidated damages for late completion. Consilian Building solutions for business problems
  • 4. Time at large The contractor is obliged only to complete the works within a reasonable period of time Time of the essence Permits the aggrieved party to repudiate the entire contract if the contract completion date is not met. Consilian Building solutions for business problems
  • 5. Peniffan Management Ltd Relevant Event An event that is not at the contractor’s risk as to time Excusable delay A delay to the contract completion date caused by a relevant event. May be distinguished from a mere delay to progress. Culpable delay Any delay caused by an irrelevant event
  • 6. Conditions for granting an extension of time 1) delay must be caused by a relevant event 2) delay must affect the completion date - the activity affected by the relevant event must be on the programme’s critical path Consilian Building solutions for business problems
  • 7. Revised completion date The revised date is the end of the total number of working days, starting from the date of possession, within which the contractor ought fairly and reasonably to have completed the works The revised date is not the actual (calendar) date by which the contractor ought to have completed the works Consilian Building solutions for business problems
  • 8. Net extension method Assesses an extension of time caused by a relevant event that occurs after the completion date and during a period of culpable delay The period (measured in working days) of excusable delay is separately assessed and added to the current completion date. Consilian Building solutions for business problems
  • 9. Gross extension method The extension of time is fixed at the end date of the excusable delay, including the period of culpable delay. This approach is incorrect! Consilian Building solutions for business problems
  • 10. Concurrent delays True concurrent delay is the occurrence of two or more delay events at the same time, one an excusable delay and the other a culpable delay. … term often used to describe the situation where two or more delay events arise at different times, but the effects of them (in whole or in part) are felt at the same time. Consilian Building solutions for business problems
  • 11. Concurrent delays / extensions of time In the case of concurrent delays the contractor is entitled to an extension of time for the period of delay caused by the relevant event, notwithstanding the concurrent effect of the irrelevant event. The Contract Administrator cannot refuse to grant an extension of time merely because the delay would have occurred anyhow. Consilian Building solutions for business problems
  • 12. Contract period Relevant event Irrelevant event Extension of time granted Extension of time witheld Consilian Building solutions for business problems
  • 13. Net extension method Gross extension method Consilian Building solutions for business problems
  • 14. Concurrent delays / extensions of time In the second example, the previous occurrence of culpable delay and its persistence beyond the excusable delay should lead the Contract Administrator to inquire whether the relevant event did in fact affect the critical path Consilian Building solutions for business problems
  • 15. An extension of time may be awarded on the basis of whether •in the light of what was planned to happen, the relevant event was likely to cause delay to completion, or •in the light of what actually happened, the relevant event actually did cause delay to completion. Consilian Building solutions for business problems
  • 16. Likely delay to completion … can only be computed by reference to a base-line derived from the planned programme of work, generally updated to the date when the event occurred. Consilian Building solutions for business problems
  • 17. Planned programmes are rarely followed: •uncertainty •changes •bias … at best an educated guess, must be updated Consilian Building solutions for business problems
  • 18. Actual delay to completion … is calculated by reference to the as-built programme of when the work was actually done. … a hypothetical model of how the contractor would have gone about the work if the relevant event had not happened Consilian Building solutions for business problems
  • 19. Delay analysis A forensic investigation into the issue of what has caused a project to run late Distinguishes between: •critical delay - affects the completion date •non-critical delay - affects progress but not the overall completion date Consilian Building solutions for business problems
  • 20. Methods of delay analysis Two types: •Theoretical based models - predict the impact of the delaying events in terms of a theoretical result, rather than showing what in fact occurred •Actual based models - measure how actual progress differed from what was planned before attempting to determine the cause of delay Note: either method may be applied contemporaneously or retrospectively Consilian Building solutions for business problems
  • 21. Limits to delay analysis models •accuracy / completeness of base information •assumptions made to model real situations •subjective decision-making by analyst •outputs guide rather than define conclusions Consilian Building solutions for business problems
  • 22. Theoretical-based methods •Global impact method •Net impact method •As-planned impacted method •As planned but for method •As-built but for / collapsed as-built method Consilian Building solutions for business problems
  • 23. Global impact method Quick, simple method favoured by contractors to demonstrate their case! Fails to link cause and effect Fails to distinguish between critical and non- critical delays Often fails to distinguish between excusable and culpable delay Criticised / rejected by the Courts as grounds for assessing an extension of time Consilian Building solutions for business problems
  • 24. Net impact method The same as the global method, but with the refinement that the issue of concurrency is considered. For example, two concurrent delays each of five days are considered to be a delay of five, rather than ten days. Otherwise, the same advantages / drawbacks as the global method Consilian Building solutions for business problems
  • 25. As-planned impacted method Determines the theoretical effect of impacting delay events onto the planned programme and projecting the completion date using the original sequence and timing of remaining activities. •The original programme may not be a realistic model on which to base the whole analysis •Does not consider actual progress and therefore does not demonstrate what actually delayed the works. Consilian Building solutions for business problems
  • 26. As planned but for method Analyst impacts the planned programme with the assessed implications of the delay events The impacted completion date is compared with the actual completion date. Difference is said to be how much earlier the project could have finished ‘but for’ all the other delay events that have not yet been analysed. Cycle is repeated. The total period is said to represent either the contractor’s entitlement to EOT or the employer’s right to deduct liquidated damages. Consilian Building solutions for business problems
  • 27. As-built but for / collapsed as-built method Similar to the as-planned impacted emthod but in reverse. The as-built programme is constructed and linked into a critical path network. A schedule of delaying events is created and the last delaying event on the critical path is removed and the model is re-analysed. The difference between the completion dates before and after the event is removed is said to represent the period of critical delay. Process is repeated until the model is fully collapsed. Consilian Building solutions for business problems
  • 28. Actual based methods •As planned vs. as-built method •Critical Path Method (CPM) Consilian Building solutions for business problems
  • 29. As planned vs. as-built method Probably the most common method, favoured by adjudicators / lawyers. Overlays the as-built programme on the original programme to highlight where the main delays occurred. •Quick, simple, no manipulation involved •Not suitable for large, complex projects (over 50 activities), except as an initial pass Consilian Building solutions for business problems
  • 30. Critical Path Method (CPM) Recreates the life of the project by considering the programme in incremental stages (‘windows’ or ‘snap-shots’) in order to demonstrate: •the actual state of progress at the time the delaying event occurred •the changing nature of the critical path as a result of the delaying events •the effects of action taken, or which should reasonably been taken, to mitigate / avoid delay Consilian Building solutions for business problems
  • 31. Network Analysis Steps 1) Establish required level of detail 2) Construct list of activities (WBS) 3) Apply logic / links between activities 4) Prepare network diagram 5) Estimate activity durations 6) Calculate completion date 7) Determine the critical path Consilian Building solutions for business problems
  • 32. Critical Path The critical path is the path through the network that joins all the activities (critical activities) that must happen on time if the project is to finish on time. Paradoxically it is the longest path that achieves the shortest completion date. Consilian Building solutions for business problems
  • 33. Float Float is a measure of how long the activity’s start or completion may be delayed without changing subsequent activities. Critical activities have no float, that is the Late Finish Time less the Early Start Time less the duration of the activity is zero. Free float the time by which an activity may be delayed or extended without affecting the start of any succeeding activity Total float the time by which an activity may be delayed or extended without affecting the project completion date / time Consilian Building solutions for business problems
  • 35. Activity on Arrow network 10 0 0 A 4 C 12 20 4 4 30 13 13 B 9 40 17 17 D 4 E 12 F 15 60 32 32 70 35 35 G 3 50 29 32 H Consilian Building solutions for business problems
  • 36. Activities on the node networks A network in which the nodes (rather than the arrows) symbolise the activities. Also called a Precedence Diagram. Latest start Activity label Total float Earliest start Duration Consilian Building solutions for business problems
  • 37. Logic 1) Finish-to-start 2) Start-to-start 3) Finish-to finish 4) Start-to-finish 3 Consilian Building solutions for business problems
  • 38. Dealing with uncertainty Programme evaluation & review technique (PERT) Uses three, rather than a single estimate of time for the duration of each activity: •Optimistic •Most probable •Pessimistic Expected time = (O +4xM + P) / 6 Consilian Building solutions for business problems
  • 39. CPM scheduling - important reservations CPM would show the project duration to be 10 weeks + 4 weeks = 24 weeks as shown below 10 14 However, 24 weeks is not the most likely date for project completion - adding together the estimated duration of all activities almost never produces the likely project completion date. Consilian Building solutions for business problems
  • 40. CPM scheduling The average (mean) time to completion is 12 weeks + 16 weeks = 28 weeks, not 24 weeks. 8 10 12 14 16 Time (weeks) Probability mean mode 12 14 16 18 20 Time (weeks) Probability mean mode CPM provides accurate forecasts for completion dates only if everything goes according to plan! Consilian Building solutions for business problems
  • 41. CPM - Pitfalls •Use start-to-finish relationships / dependencies as far as possible, •Avoid excessive lag / lead times and show clearly as separate activities (e.g. Curing concrete) when they are necessary •Avoid artificial constraints such as ‘must start on’ or ‘must finish by’ which inhibit the programme from reacting dynamically to change •Adopt an appropriate level of detail Consilian Building solutions for business problems
  • 42. The as-planned programme Starting point for any analysis of a contractor’s progress and the effect of delay and disruption but no more than a statement of future intention Discrepancies include: •may use wrong assumptions of the work required •contractor may work slower or faster than shown •materials may arrive earlier or later than shown •plant may break down or become unavailable •a Relevant Event may occur •inclement weather Consilian Building solutions for business problems
  • 43. Contractor’s bar charts Can be used to prove excusable delay provided: The planned programme •has no float •accurately estimates the duration of activities •shows start-to-finish relationships All events giving rise to the delay •can be clearly identified •are excusable events There is no need to take account of: •consequential delays •concurrent delays •accelerated or inefficient working Consilian Building solutions for business problems
  • 44. Contractor’s responsibilities (JCT80) To give in writing: •the material circumstances giving rise to the delay to progress •the cause of the delay to progress •the contractor’s opinion of whether the cause of the delay to progress is a relevant event •the expected effects of the delay to progress •the likely effect of the event on the completion date, when taken in isolation from any other casue of delay Consilian Building solutions for business problems
  • 45. Suggested evidence to support any notice of delay •A network programme accurately illustrating how he intended to complete the works if the event had not occurred - a competent Master Programme •An updated network programme showing what had actually been achieved in relation to the proposed programme before the event occurred •An impacted network programme demonstrating, with supporting descriptions, the duration of new or delayed activities and their logical interface with the remaining contract works Consilian Building solutions for business problems
  • 46. Protocol for determining extensions of time and compensation for delay and disruption Society of Construction Law Consultation copy November 2001 available on- line http://www.eotprotocol.com Provides guidance to all parties in the construction process when dealing with time / delay matters Recognises that transparency of information and methodology is central to both dispute prevention and dispute resolution Emphasis on ‘real time’ programming Consilian Building solutions for business problems
  • 47. Mitigation Ascon Contracting Ltd. vs. Alfred McAlpine Construction / Judge Hicks considered that the contractor’s obligation to avoid or reduce delay could never be referable to delay caused by a relevant event. JCT 98 expresses the contractor’s obligation as a duty to ‘constantly use his best endeavours to prevent delay in the progress of the works howsoever caused’. Consilian Building solutions for business problems
