GOAL PROGRAMMING Serhat  ÖKSÜZ Ahmet  TATIŞ Mehmet YILMAZ
THE VIEW OF THE PRESENTATION ●   Introduction ●   System approach to concurrent engineering   ●   Goal Programming   ●   Application Areas   ●   Weighting Method and Preemptive Method   ●   The Case Study and The Example   ●   Demonstration of The Model By Using Sets ●   Managerial implications for the company   ●   Conclusions and assessment
INTRODUCTION ●   Life-Cycle Costing (LCC) ; ● Time-Based Competition (TBC) ; ● T he three planning-horizon levels ; ▪   S trategic, ▪   I ntermediate , ▪   T actical ,
Concurrent Engineering Is the collaboration among   functional areas; Product design ,design for quality ,process design,   design  for manufacturing and planning ,logistic design  etc.  In the early phases of product design CE requires  : ▪  fast adaptation  ▪  product innovation ▪  short product delivery time to market  for a firm to remain competitive .  ▪

GOAL PROGRAMMING Introduced by Charnes and Cooper in 1960’s Provides a method of dealing with a collection of goals, rather than an explicit objective function. Objective is to minimize the deviation from   each of the goals that have been established. Constraints are “soft” in that you may violate one (i.e. not meet one goal) if it means you can make better progress toward one of the other goals.
Goal Programming Versus Linear Programming Multiple Goals (instead of one goal) Deviational Variables Minimized (instead of maximizing profit or minimizing cost of LP) “   Satisficing   ” (instead of optimizing)
APPLICATION AREAS Accounting  Agriculture  Economics  Engineering  Finance  Government  I nternational Context  Management  Marketing
Types Of Goal Programming 􀂅 Weights method: the single objective function is the weighted sum of the of the   functions   representing the goals of the problem.  MIN Z= w 1 d 1 +w 2 d 2 +…+w n d n 􀂅 Preemptive method: prioritizes the goals in order of importance, then optimizes one  goal  at a time.
CASE STUDY AND THE EXAMPLE COMPANY PROFILE ▪   Medical manufacturing company  producing skin prepping applicators ▪   10 years in the Industry  ▪  Hospitals, first aid users and indust rial companies are the customers ▪   125 employees ▪   17 million $   annual sales
Aim of the study Minimized  life cycle cost and time Timely introduction of products to market Increased deliver reliability Measurable improvement in supplier performance Improvements in changeover and setup technologies
CE TEAM Product designer Manufacturing engineer Quality control manager Marketing manager Purchasing manager Product design activities and practices are coordinated and accomplished concurrently. Suppliers  inputs and assistance is in terms of part and product is taken into consideration.
STRATEGIC GOALS (P 1 ) COST OF PRODUDUCTS TO MARKET (P 11 ) TIME OF PRODUDUCTS TO MARKET (P 12 ) ▪ Products research and  development cost  ▪ Engineering design cost ▪ Product investment cost ▪ Product investment and  developing cost ▪ Cost of quality ▪ Speed of response to customers ▪ Product time to market ▪   Design lead time ▪ Order-to-delivery cycle ▪ Total product delivery  time
INTERMEDIATE GOALS (P 2 ) THROUGHPUT COST (P 21 ) THROUGHPUT   TIME (P 22 ) ▪ Procurement cost   ▪ Non-recurring manufacturing  costs ▪ Recurring manufacturing costs ▪ Facilities cost   ▪ Initial logistics/support costs ▪ Cost of quality ▪ Manufacturing lead time ▪ Set-up time ▪   Producrtion cycle time ▪ Changeover time ▪ Delay time ▪ Distribution lead time ▪ Manufacturing response time ▪ Procurement lead time
TACTICAL  GOALS (P 3 ) OPERATIONAL AND MATERIAL COST (P 31 ) DELIVERY   TIMES (P 32 ) ▪ Operations cost  ▪ Maintenance  cost ▪ Product modification cost ▪ Facilities cost  ▪ Product phase-out and  disposal cost ▪ Delivery reliability ▪ Delivery speed

THE GOALS OF THE COMPANY  For products X 1  and X 2  ; STRATEGIC GOALS ▪   Engineering Des i gn Cost under 240   $ ▪   Cost Of Quality under 130 $ ▪  Minimum  Value Added to Product  320   $ INTERMED I ATE GOALS ▪   Recurring manufacturing cost under 170 $ ▪   Set up Time under 60 min TACTICAL GOALS  ▪   Delivery Reliability over 22 ▪   Operation Cost under 45 $
Strategic Goal   Engineering Design Cost   Total  EDC : 2  x 1  +  4 x 2 Upper Resource Limit :   240 2  x 1  +  4 x 2   =  240 +  d 1 +   - d 1 -   2  x 1  +  4 x 2   +  d 1 -  -   d 1 +   =  240 { 2  x 1  +  4 x 2   <   =  240 } d 1 +   indicates the  EDC  over  240   while   d 1 -   indicates  the  EDC  under the  goal . The objective is to minimize  d 1 +

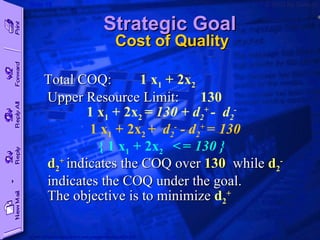

Strategic Goal   Cost of Quality Total  COQ :   1  x 1  +  2 x 2 Upper Resource Limit :   130 1  x 1  +  2 x 2   =  130 +  d 2 +   -  d 2 -   1  x 1  +  2 x 2   +  d 2 -  - d 2 +  =   130 { 1  x 1  +  2 x 2   <   =   130 } d 2 +   indicates the  COQ  over  130  while   d 2 -   indicates the  COQ  under the  goal . The objective is to minimize  d 2 +
Strategic Goal   Value Added to Product Total  VAP :   4 x 1  +  5 x 2 Upper Resource Limit :   320 4 x 1  +  5 x 2 =  320 +  d 3 + - d 3 -   4 x 1  +  5 x 2 +  d 3 -  - d 3 +  =   320 { 4 x 1  +  5 x 2  >   =   320 } d 3 +   indicates the  VAP  over  320   while   d 3 -   indicates the  VAP  under the  goal . The objective is to minimize  d 3 -
I ntermediate Goal   Recurring Manufacturing Cost Total  RMC :   4 x 1  +  3 x 2 Upper Resource Limit :   170 4 x 1  +  3 x 2 =  170 +  d 4 + - d 4 -   4 x 1  +  3 x 2 +  d 4 -  - d 4 +  =   170 { 4 x 1  +  3 x 2   <   =   170 } d 4 +   indicates the  RMC  over  170   while   d 4 -   indicates the  RMC  under the  goal . The objective is to minimize  d 4 +
I ntermediate Goal   Set-Up Time Total  SUT  :   3 x 1  +  4 x 2 Upper Resource Limit :   60 3 x 1  +  4 x 2 =  60 +  d 5 + - d 5 -   3 x 1  +  4 x 2 +  d 5 -  - d 5 +  =   60 { 3 x 1  +  4 x 2   <   =   60 } d 5 +   indicates the  SUT  over  60   while   d 5 -   indicates the  SUT  under the  goal . The objective is to minimize  d 5 +
Tactical Goal   Delivery Reliability Total  DR  :   3 x 1  +  4 x 2 Upper Resource Limit :   22 4 x 1  +  5 x 2 =  22 +  d 6 + - d 6 -   4 x 1  +  5 x 2 +  d 6 -  - d 6 +  =   22 { 4 x 1  +  5 x 2   >   =   22 } d 6 +   indicates the  DR  over  22   while   d 6 -   indicates the  DR  under the  goal . The objective is to minimize  d 6 -
Tactical Goal   Operations Cost Total  OC  :   3 x 1  +  4 x 2 Upper Resource Limit :   45 6 x 1  +  3 x 2 =  45 +  d 7 + - d 7 -   6 x 1  +  3 x 2 +  d 7 -  - d 7 +  =   45 { 6 x 1  +  3 x 2   <   =   45 } d 7 +   indicates the  OC  over  45   while   d 7 -   indicates the  OC  under the  goal . The objective is to minimize  d 7 +
The Model
The Model  The strategic goal  : Min d 1 +  + d 2 +  +   d 3 -  ; {   Min  w 1 d 1 +  +w 1 d 2 +  +w 1 d 3 -   +   w 2 d 4 +  +w 2 d 5 +   +   w 3   d 6 -  + w 3 d 7 +   } 2 x 1  +  4 x 2   +  d 1 -  -   d 1 +   =  240 ; 1 x 1  +  2 x 2   +  d 2 -  - d 2 +  =   130 ; 4 x 1  +  5 x 2 +  d 3 -  - d 3 +  =   320 ; 4 x 1  +  3 x 2 +  d 4 -  - d 4 +  =   170 ; 3 x 1  +  4 x 2 +  d 5 -  - d 5 +  =   60 ; 4 x 1  +  5 x 2 +  d 6 -  - d 6 +  =   22 ; 6 x 1  +  3 x 2 +  d 7 -  - d 7 +  =   45 ; x 1   ,  x 2   ,   d i +  ,   d i -     0

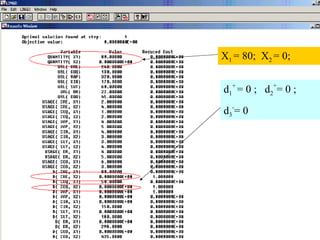

The solution Let the solution be: x 1   =  80  ,   x 2   = 0   ,  d 1 +  =0   , d 2 +  =   0 , d 3 -   =0
The Model  The intermediate goal  : Min d 4 +  + d 5 +  ; 2 x 1  +  4 x 2   +  d 1 -  -   d 1 +   =  240 ; 1 x 1  +  2 x 2   +  d 2 -  - d 2 +  =   130 ; 4 x 1  +  5 x 2 +  d 3 -  - d 3 +  =   320 ; 4 x 1  +  3 x 2 +  d 4 -  - d 4 +  =   170 ; 3 x 1  +  4 x 2 +  d 5 -  - d 5 +  =   60 ; 4 x 1  +  5 x 2 +  d 6 -  - d 6 +  =   22 ; 6 x 1  +  3 x 2 +  d 7 -  - d 7 +  =   45 ; d 1 +  =0  ;  d 2 +  =   0  ;  d 3 -   =   0  ;

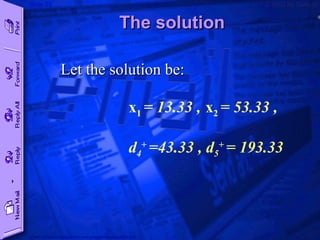

The solution Let the solution be: x 1   =  13.33  ,   x 2   =  53.33  ,  d 4 +  = 43.33  , d 5 +  =  193.33
The Model  The  tactical goal  : Min d 6 -  + d 7 +  ; 2 x 1  +  4 x 2   +  d 1 -  -   d 1 +   =  240 ; 1 x 1  +  2 x 2   +  d 2 -  - d 2 +  =   130 ; 4 x 1  +  5 x 2 +  d 3 -  - d 3 +  =   320 ; 4 x 1  +  3 x 2 +  d 4 -  - d 4 +  =   170 ; 3 x 1  +  4 x 2 +  d 5 -  - d 5 +  =   60 ; 4 x 1  +  5 x 2 +  d 6 -  - d 6 +  =   22 ; 6 x 1  +  3 x 2 +  d 7 -  - d 7 +  =   45 ; d 1 +  =0  ;  d 2 +  =   0  ;  d 3 -   =   0  ; d 4 +  = 43.33 ;  d 5 +  =  193.33 ;
The solution Let the solution be: x 1   =  13.33  ,   x 2   =  53.33  ,  (EDC)   d 1 +  =   0  &  d 1 -   =  0  , (COQ)  d 2 +  =   0  &  d 2 -   =  10   ,  (VAP)   d 3 +  =   0  &  d 3 -   =0  , (RMC)   d 4 +  =  43.3  &  d 4 -   =0  , (SUT)  d 5 +  =  193.3  &  d 5 -   =0  , (DR)   d 6 +  =  298 &  d 6 -   =  0   ,  (OC)   d 7 +  =  195  &  d 7 -   =0  .

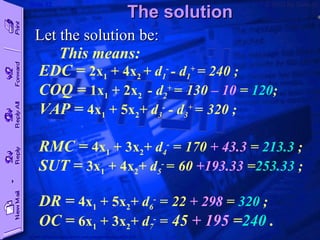

The solution Let the solution be: This means: EDC  =  2 x 1  +  4 x 2   +  d 1 -  -   d 1 +   =  240 ; COQ  =   1 x 1  +  2 x 2   - d 2 +  =   130  – 10  =  120 ; VAP =  4 x 1  +  5 x 2 +  d 3 -  - d 3 +  =   320 ; RMC =   4 x 1  +  3 x 2 +  d 4 -  =   170  + 43.3  =  213.3   ; SUT =  3 x 1  +  4 x 2 +  d 5 -   =   60  +193.33  = 253.33   ; DR =  4 x 1  +  5 x 2 +  d 6 -  =   22  + 298  =  320  ; OC =  6 x 1  +  3 x 2 +  d 7 -  =   45  + 195  = 240  .
Min d 1 + + d 2 + + d 3 -  2 x 1  + 4 x 2  + d 1 -   - d 1 +  = 240 1 x 1  + 2 x 2  + d 2 -   - d 2 +  = 130 4 x 1  + 5 x 2  + d 3 -  - d 3 +   = 320 4 x 1  + 3 x 2  + d 4 -   - d 4 +   = 170 3 x 1  + 4 x 2  + d 5 -   - d 5 +  = 60 4 x 1  + 5 x 2  + d 6 -   - d 6 +   = 22 6 x 1  + 3 x 2  + d 7 -  - d 7 +   = 45
X 1  = 80;  X 2  = 0; d 1 +   = 0 ;  d 2 + = 0 ; d 3 - = 0
Min d 4 + + d 5 +   2 x 1  + 4 x 2  + d 1 -   - d 1 +  = 240 1 x 1  + 2 x 2  + d 2 -   - d 2 +  = 130 4 x 1  + 5 x 2  + d 3 -  - d 3 +   = 320 4 x 1  + 3 x 2  + d 4 -   - d 4 +   = 170 3 x 1  + 4 x 2  + d 5 -   - d 5 +  = 60 4 x 1  + 5 x 2  + d 6 -   - d 6 +   = 22 6 x 1  + 3 x 2  + d 7 -  - d 7 +   = 45   d 1 + + d 2 + + d 3 -  = 0
X 1  = 13.33;  X 2  = 53.33; d 4 +  = 43.33 ;  d 5 +  = 193.33;
Min d 6 -  + d 7 +   2 x 1  + 4 x 2  + d 1 -   - d 1 +  = 240 1 x 1  + 2 x 2  + d 2 -   - d 2 +  = 130 4 x 1  + 5 x 2  + d 3 -  - d 3 +   = 320 4 x 1  + 3 x 2  + d 4 -   - d 4 +   = 170 3 x 1  + 4 x 2  + d 5 -   - d 5 +  = 60 4 x 1  + 5 x 2  + d 6 -   - d 6 +   = 22 6 x 1  + 3 x 2  + d 7 -  - d 7 +   = 45   d 1 + + d 2 + + d 3 -  = 0 d 4 +  +d 5 +   =  236.667;

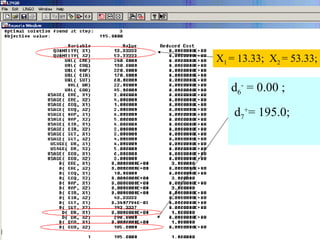

X 1  = 13.33;  X 2  = 53.33; d 6 -  = 0.00 ;  d 7 + = 195.0;
CONCLUSION PGP is particularly appropriate where there is a hierarchy of priority levels for the goals, as is the case in this paper   The most important decisions with regard to time and cost of products are made at the product design stage   Using CE optimises the LCC and TBC in order to be competitive
THANKS

Goal Programming

  • 1.
