SlideShare a Scribd company logo

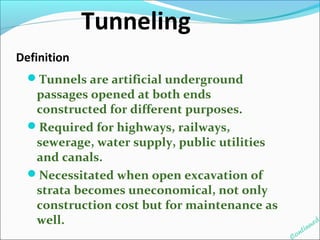

Definition
Tunnels are artificial underground
passages opened at both ends
constructed for different purposes.
Required for highways, railways,
sewerage, water supply, public utilities
and canals.
Necessitated when open excavation of
strata becomes uneconomical, not only
construction cost but for maintenance as
well.
Continued
Tunneling

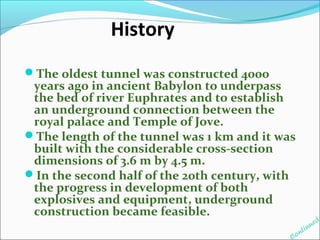

History
The oldest tunnel was constructed 4000
years ago in ancient Babylon to underpass
the bed of river Euphrates and to establish
an underground connection between the
royal palace and Temple of Jove.
The length of the tunnel was 1 km and it was
built with the considerable cross-section
dimensions of 3.6 m by 4.5 m.
In the second half of the 20th century, with
the progress in development of both
explosives and equipment, underground
construction became feasible.
Continued

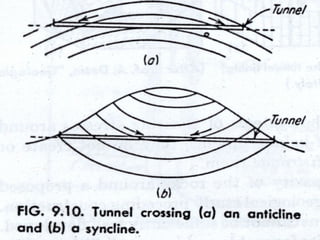

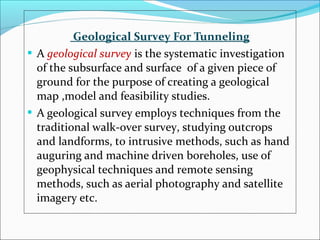

Geological Considerations or ground
properties before constructing any tunnel
project:
The engineering properties of a rock
generally depend not only on the matrix
(structure formed by the minerals) but
also imperfections in the structure such
as voids (pore space ),cracks ,inclusions,
grain boundaries and weak particles.
Pore spaces are largely made up of
continuous irregular capillary cracks
separating the mineral grains.

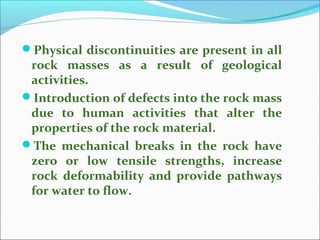

Physical discontinuities are present in all
rock masses as a result of geological
activities.
Introduction of defects into the rock mass
due to human activities that alter the
properties of the rock material.
The mechanical breaks in the rock have
zero or low tensile strengths, increase
rock deformability and provide pathways
for water to flow.

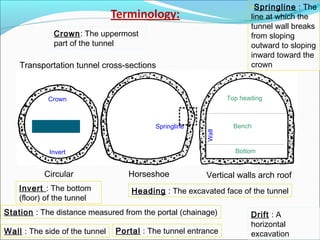

Crown: The uppermost
part of the tunnel

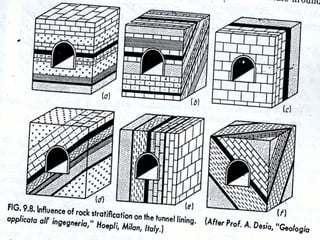

Transportation tunnel cross-sections
Wall
Crown
Core (strozze) Springline
Invert
•Springline : The
line at which the
tunnel wall breaks
from sloping
outward to sloping
inward toward the
crown
Top heading
Bench
Bottom

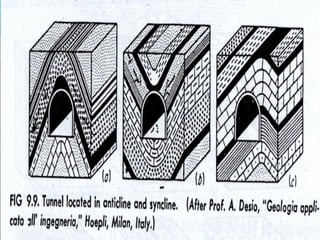

Circular Horseshoe Vertical walls arch roof
Invert : The bottom Heading : The excavated face of the tunnel
(floor) of the tunnel
Drift : A
horizontal
excavation
Station : The distance measured from the portal (chainage)
Wall : The side of the tunnel Portal : The tunnel entrance
The choice of tunnelling method
may be dictated by:

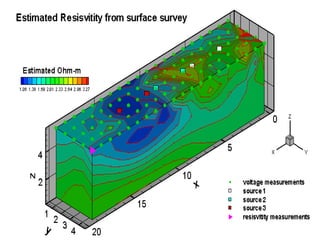

geological and hydrological
conditions
Weak rock under high stresses
leads to squeezing ground
conditions.
Brittle strong rock high stress
conditions may lead to rockbursting.
 cross-section and length of
continuous tunnel
local experience and time/cost
considerations (what is the value
of time in the project)
limits of surface disturbance,
and many others factors
Choice of method
depends upon
nature of strata
and geometry of
tunnel section
Continued

Methods divided into three categories
Firm ground- reasonable time available for
installing conventional support.
Soft ground- Conventional support can not be
installed.
Running ground- Special treatment required
before starting excavation
Continued
Classification ooff TTuunnnneelllliinngg
MMeetthhooddss bbaasseedd oonn ttyyppee ooff ssttrraattaa::

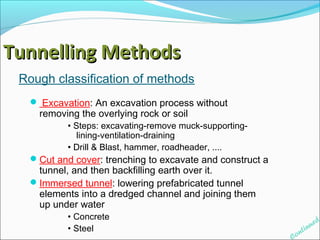

TTuunnnneelllliinngg MMeetthhooddss
Rough classification of methods
 Excavation: An excavation process without
removing the overlying rock or soil
• Steps: excavating-remove muck-supporting-lining-
ventilation-draining
• Drill & Blast, hammer, roadheader, ....
Cut and cover: trenching to excavate and construct a
tunnel, and then backfilling earth over it.
Immersed tunnel: lowering prefabricated tunnel
elements into a dredged channel and joining them
up under water
• Concrete
• Steel
Continued

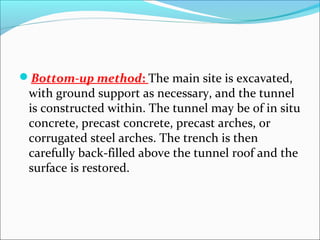

Bottom-up method: The main site is excavated,
with ground support as necessary, and the tunnel
is constructed within. The tunnel may be of in situ
concrete, precast concrete, precast arches, or
corrugated steel arches. The trench is then
carefully back-filled above the tunnel roof and the
surface is restored.

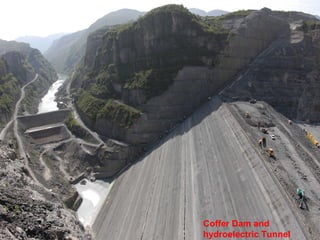

Coffer Dam and
hydroelectric Tunnel

Top-down method: Here side support walls and
cap beams are constructed from ground level
typically with slurry walls, or secant piling. Then a
shallow excavation allows making the tunnel roof
of precast beams or in situ concrete. The surface is
then restored except for access openings. This
allows early reinstatement of roadways, services
and other surface features. Excavation then takes
place under the permanent tunnel roof, and the
base slab is constructed.

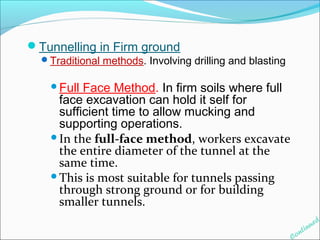

Tunnelling in Firm ground
Traditional methods. Involving drilling and blasting
Full Face Method. In firm soils where full
face excavation can hold it self for
sufficient time to allow mucking and
supporting operations.
In the full-face method, workers excavate
the entire diameter of the tunnel at the
same time.
This is most suitable for tunnels passing
through strong ground or for building
smaller tunnels.
Continued

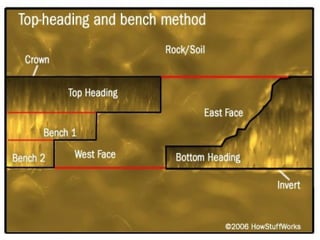

Top Heading and benching. When full face
excavation is not possible. Heading should be
sufficient distance ahead of benching.
In this technique, workers dig a smaller tunnel
known as a heading. Once the top heading has
advanced some distance into the rock, workers begin
excavating immediately below the floor of the top
heading; this is a bench.
 One advantage of the top-heading-and-bench
method is that engineers can use the heading tunnel
to gauge the stability of the rock before moving
forward with the project.
Excavation by tunnelling Methods
 Drift Method. In case of large or pilot tunnel , Drift is made
and then expanded. There can be more than one drifts.
 Different ‘drift methods’ depending on location of drift can be
used.
Tunnelling in Soft Strata
Tunnels constructed in soft materials
require temporary support immediately or
shortly after excavation. Way to provide
support are:
Suitably spaced bents of wood
Suitably spaced bents of steel for lagging
(covering)
Liner plates
Fore poling placed to retain material
between adjacent bents
Temporary supports must be designed for
higher working stress compared to those in
permanent designs.
Tunnelling in Soft Ground
Instantaneous support is required
No drilling and blasting.
Forepoling is done.
 Boards are driven ahead of the last ‘rib’, around
periphery
 Forepoles act as cantilevers beyond breasting
 Soil is excavated after removing the breast board and
new rib is erected
Continued
Because stand-up time is generally short when
tunneling through soft ground, cave-ins are a
constant threat. To prevent this from happening,
engineers use a special piece of equipment called a
shield.
A shield is an iron or steel cylinder literally pushed
into the soft soil. It carves a perfectly round hole and
supports the surrounding earth while workers remove
debris and install a permanent lining made of cast
iron or precast concrete.
When the workers complete a section, jacks push the
shield forward and they repeat the process.

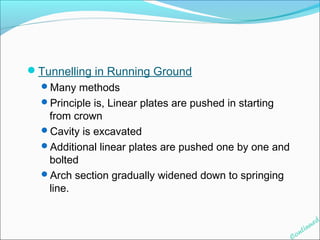

Tunnelling in Running Ground
Many methods
Principle is, Linear plates are pushed in starting
from crown
Cavity is excavated
Additional linear plates are pushed one by one and
bolted
Arch section gradually widened down to springing
line.
Continued

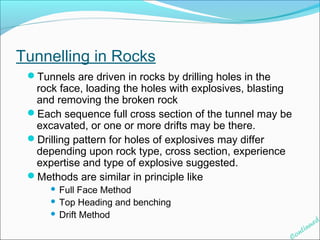

Tunnelling in Rocks
Tunnels are driven in rocks by drilling holes in the
rock face, loading the holes with explosives, blasting
and removing the broken rock
Each sequence full cross section of the tunnel may be
excavated, or one or more drifts may be there.
Drilling pattern for holes of explosives may differ
depending upon rock type, cross section, experience
expertise and type of explosive suggested.
Methods are similar in principle like
 Full Face Method
 Top Heading and benching
 Drift Method
Continued

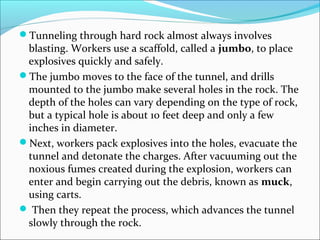

Tunneling through hard rock almost always involves
blasting. Workers use a scaffold, called a jumbo, to place
explosives quickly and safely.

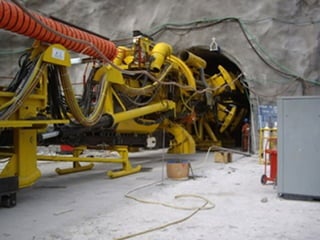

The jumbo moves to the face of the tunnel, and drills
mounted to the jumbo make several holes in the rock. The
depth of the holes can vary depending on the type of rock,
but a typical hole is about 10 feet deep and only a few
inches in diameter.
Next, workers pack explosives into the holes, evacuate the
tunnel and detonate the charges. After vacuuming out the
noxious fumes created during the explosion, workers can
enter and begin carrying out the debris, known as muck,
using carts.
 Then they repeat the process, which advances the tunnel
slowly through the rock.

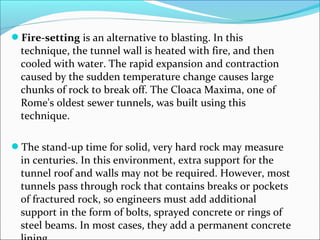

Fire-setting is an alternative to blasting. In this
technique, the tunnel wall is heated with fire, and then
cooled with water. The rapid expansion and contraction
caused by the sudden temperature change causes large
chunks of rock to break off. The Cloaca Maxima, one of
Rome's oldest sewer tunnels, was built using this
technique.
The stand-up time for solid, very hard rock may measure
in centuries. In this environment, extra support for the
tunnel roof and walls may not be required. However, most
tunnels pass through rock that contains breaks or pockets
of fractured rock, so engineers must add additional
support in the form of bolts, sprayed concrete or rings of
steel beams. In most cases, they add a permanent concrete
lining

Sequence of operation in Rocky
Strata (Drill and Blast)
Marking tunnel profile.
Setting up and drilling
Loading explosive and blasting
Removing the foul gases
Checking
Scaling
Mucking
Rock bolting and lining
Continued

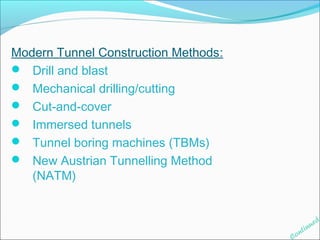

Modern Tunnel Construction Methods:
 Drill and blast
 Mechanical drilling/cutting
 Cut-and-cover
 Immersed tunnels
 Tunnel boring machines (TBMs)
 New Austrian Tunnelling Method
(NATM)
Continued
Road headers
Types of support
Steel arches
Steel ribs are used for reinforcement of weaker tunnel
sections, and give rigid to semi-rigid support. The ribs are
made from I-beam or H-beam structural steel bent to
conform to the requirements of a particular tunnel cross-section.
Timber may be used for packing between the beams and
the rock. However, providing continuous bedding against
the rock may considerably increase the load-bearing
capacity of the arches.
Continued

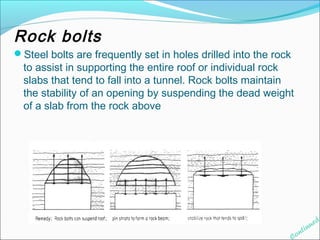

Rock bolts
Steel bolts are frequently set in holes drilled into the rock
to assist in supporting the entire roof or individual rock
slabs that tend to fall into a tunnel. Rock bolts maintain
the stability of an opening by suspending the dead weight
of a slab from the rock above
Continued
Shotcrete
Pneumatically applied mortar and concrete are
increasingly being used for the support of underground
excavations.
A combination of rock bolts and shotcrete has proved an
excellent temporary support for all qualities of rock.
Shotcrete is best known in tunnelling as an integral
component of the NATM (New Austrian Tunnelling
Method).
Quick-setting concrete is sprayed onto the bare rock
surface immediately after excavation, and rapidly hardens
to form a preliminary support until the final lining of
conventional poured concrete can be installed.
Continued

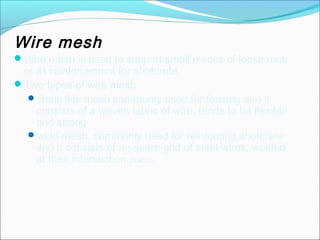

Wire mesh
Wire mesh is used to support small pieces of loose rock
or as reinforcement for shotcrete.
Two types of wire mesh
chain link mesh commonly used for fencing and it
consists of a woven fabric of wire, tends to be flexible
and strong
weld mesh. commonly used for reinforcing shotcrete
and it consists of a square grid of steel wires, welded
at their intersection points.

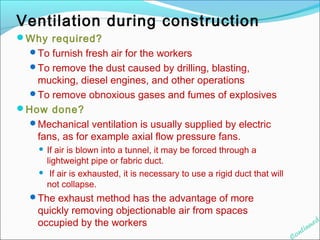

Ventilation during construction
Why required?
To furnish fresh air for the workers
To remove the dust caused by drilling, blasting,
mucking, diesel engines, and other operations
To remove obnoxious gases and fumes of explosives
How done?
Mechanical ventilation is usually supplied by electric
fans, as for example axial flow pressure fans.
 If air is blown into a tunnel, it may be forced through a
lightweight pipe or fabric duct.
 If air is exhausted, it is necessary to use a rigid duct that will
not collapse.
The exhaust method has the advantage of more
quickly removing objectionable air from spaces
occupied by the workers.
Continued
Ventilation of tunnels
Mechanical ventilation systems provide the temperature,
humidity and air velocity conditions necessary to give
tunnel users a reasonable degree of comfort during normal
operation.
 When a fire occurs in a tunnel, the system must also
provide a safe evacuation route for tunnel users and
access for fire fighting services.
The choice and design of a ventilation system depends on
these main factors:
tunnel length and volume
admissible air pollution around tunnel portals
fire safety considerations.
Key pollutants include carbon dioxide, nitrogen oxides,
nitrogen dioxide, hydrocarbons PM10 and lead.
Better understanding of ventilation techniques
Awareness of new safety and environmental legislation.
Geological Survey For Tunneling
 A geological survey is the systematic investigation
of the subsurface and surface of a given piece of
ground for the purpose of creating a geological
map ,model and feasibility studies.
 A geological survey employs techniques from the
traditional walk-over survey, studying outcrops
and landforms, to intrusive methods, such as hand
auguring and machine driven boreholes, use of
geophysical techniques and remote sensing
methods, such as aerial photography and satellite
imagery etc.
Types Of Geological Survey
 Mainly geological surveys are classified into
two types:
Surface Geological Survey
Subsurface Geological Survey
 Surface Geological Survey: includes on land
geology and geological
structures,landforms,hydrology,outcrop
pattern ,engineering properties etc
 Subsurface Geological Survey: : includes on
underground geology and geological
structures,Geo-hydrogeology,subsurface rock
or soil pattern etc
Surface Geological Survey
Geological profile is prepared along line of tunnel.
Geological observations are done along this profile
like engineering properties of rock/soil, geological
structures like fold,faults,joints,spring,stream,river
alignment and any seepage etc
Trial boring plan is prepared along the tunnel line.
Subsurface Geological Survey
Trial boring is done along the tunnel line.
Different rock and soil samples are collected
from subsurface and their physical and
chemical properties are observed.
Some samples are sent to laboratory for
determination of engineering properties like
shearing,strenght,permeability,porosity,compr
essive strenght,and other test are performed.
GWT(Ground Water Table) is noted and water

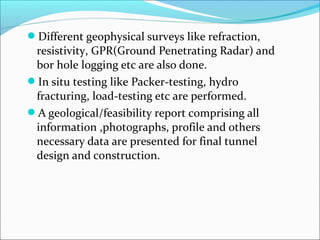

bearing strata is marked in geological profile.
Different geophysical surveys like refraction,
resistivity, GPR(Ground Penetrating Radar) and
bor hole logging etc are also done.
In situ testing like Packer-testing, hydro
fracturing, load-testing etc are performed.
A geological/feasibility report comprising all
information ,photographs, profile and others
necessary data are presented for final tunnel
design and construction.
Subsurface
Profiling/3 D
modelling

More Related Content

What's hot

Tunnelling methods
Tunnelling methodsTunnelling methods
Tunnelling methods
jagadish chintu

Study of tunnel engineering
Study of tunnel engineeringStudy of tunnel engineering
Study of tunnel engineering
Adil Shaikh

Geotechnical investigations for tunnelling
Geotechnical  investigations for tunnellingGeotechnical  investigations for tunnelling
Geotechnical investigations for tunnelling
Prof. A.Balasubramanian

Geology of Dams & Reservoirs
Geology of Dams & ReservoirsGeology of Dams & Reservoirs
Geology of Dams & Reservoirs
Hymavathi Jampani

Subsurface exploration
Subsurface exploration  Subsurface exploration
Subsurface exploration
Shruthi Hiremath

Tunnelling methods
Tunnelling methodsTunnelling methods
Tunnelling methods
Durgesh Kumar Yadav

Tunneling & Drilling Equipments
Tunneling & Drilling EquipmentsTunneling & Drilling Equipments
Tunneling & Drilling Equipments
Rajarshi Patty

Tunnel making methods and tunnel boring machine
Tunnel making methods and tunnel boring machine Tunnel making methods and tunnel boring machine
Tunnel making methods and tunnel boring machine mohammadsalikali

7. TUNNEL ENGINEERING
7. TUNNEL ENGINEERING7. TUNNEL ENGINEERING
7. TUNNEL ENGINEERING
VATSAL PATEL

types of dam
types of damtypes of dam
types of dam
Akshay Shinde

Tunneling exploration
Tunneling explorationTunneling exploration
Tunneling exploration
jamali husain

Slope stability
Slope stabilitySlope stability
Slope stability
Dr. Pallavi Badry

Well foundation
Well foundationWell foundation
Sinking of well foundation
Sinking of well foundationSinking of well foundation
Sinking of well foundation
Sourabh Jain

Tunnel and Underground Excavation Presentation
Tunnel and Underground Excavation PresentationTunnel and Underground Excavation Presentation
Tunnel and Underground Excavation Presentation
Chandan Pradhan

Tunnel Engineering.pptx
Tunnel Engineering.pptxTunnel Engineering.pptx
Tunnel Engineering.pptx
Priya Sarita Mane

Bridge
Bridge Bridge
Bridge illpa

Tunnels concepts
Tunnels conceptsTunnels concepts
Tunnels concepts
Sathish Kumar

Lining of tunnel
Lining of tunnelLining of tunnel
Lining of tunnel
Giri Guru

2 tunnels
2 tunnels2 tunnels
2 tunnels
Raghav Gadgil

What's hot (20)

Tunnelling methods
Tunnelling methodsTunnelling methods
Tunnelling methods

Study of tunnel engineering
Study of tunnel engineeringStudy of tunnel engineering
Study of tunnel engineering

Geotechnical investigations for tunnelling
Geotechnical  investigations for tunnellingGeotechnical  investigations for tunnelling
Geotechnical investigations for tunnelling

Geology of Dams & Reservoirs
Geology of Dams & ReservoirsGeology of Dams & Reservoirs
Geology of Dams & Reservoirs

Subsurface exploration
Subsurface exploration  Subsurface exploration
Subsurface exploration

Tunnelling methods
Tunnelling methodsTunnelling methods
Tunnelling methods

Tunneling & Drilling Equipments
Tunneling & Drilling EquipmentsTunneling & Drilling Equipments
Tunneling & Drilling Equipments

Tunnel making methods and tunnel boring machine
Tunnel making methods and tunnel boring machine Tunnel making methods and tunnel boring machine
Tunnel making methods and tunnel boring machine

7. TUNNEL ENGINEERING
7. TUNNEL ENGINEERING7. TUNNEL ENGINEERING
7. TUNNEL ENGINEERING

types of dam
types of damtypes of dam
types of dam

Tunneling exploration
Tunneling explorationTunneling exploration
Tunneling exploration

Slope stability
Slope stabilitySlope stability
Slope stability

Well foundation
Well foundationWell foundation
Well foundation

Sinking of well foundation
Sinking of well foundationSinking of well foundation
Sinking of well foundation

Tunnel and Underground Excavation Presentation
Tunnel and Underground Excavation PresentationTunnel and Underground Excavation Presentation
Tunnel and Underground Excavation Presentation

Tunnel Engineering.pptx
Tunnel Engineering.pptxTunnel Engineering.pptx
Tunnel Engineering.pptx

Bridge
Bridge Bridge
Bridge

Tunnels concepts
Tunnels conceptsTunnels concepts
Tunnels concepts

Lining of tunnel
Lining of tunnelLining of tunnel
Lining of tunnel

2 tunnels
2 tunnels2 tunnels
2 tunnels

Viewers also liked

The tunnel powerpoint
The tunnel powerpointThe tunnel powerpoint
The tunnel powerpointishict

Top down
Top down Top down
Top down
Angelito Pera

SCTP introduction
SCTP introductionSCTP introduction
SCTP introduction
Li Xiong

Digital Transmission
Digital TransmissionDigital Transmission
Digital Transmissionanuragyadav94

Networking Standards And Protocols
Networking Standards And ProtocolsNetworking Standards And Protocols
Networking Standards And ProtocolsSteven Cahill

Computer network switching
Computer network switchingComputer network switching
Computer network switching
Shivani Godha

Top Down and Bottom Up Design Model
Top Down and Bottom Up Design ModelTop Down and Bottom Up Design Model
Top Down and Bottom Up Design Model
Abdul Rahman Sherzad

Snmp
SnmpSnmp
Railway engineering
Railway engineeringRailway engineering
Railway engineering
hiranrathva

Stations and Yards of Railway
Stations and Yards of RailwayStations and Yards of Railway
Stations and Yards of Railway
Souvik Mondal

Railway engineering
Railway engineeringRailway engineering
Railway engineering
Shanmugaraj M

Water cycle and water budget
Water cycle and water budgetWater cycle and water budget
Water cycle and water budget
Mohsin Siddique

Stream flow measurement
Stream flow measurementStream flow measurement
Stream flow measurement
MOHIT MAYOOR

Station yards
Station yardsStation yards
Station yards
jagadish108

Precipitation and its estimation
Precipitation and its estimationPrecipitation and its estimation
Precipitation and its estimation
Mohsin Siddique

Geometric design of the track
Geometric design of the trackGeometric design of the track
Geometric design of the track
T.Naga Anusha

Points and crossings
Points and crossingsPoints and crossings
Points and crossings
hiranrathva

Floods
FloodsFloods
2 handouts-lecture-7
2  handouts-lecture-72  handouts-lecture-7
2 handouts-lecture-7
Saleem Malik

Viewers also liked (20)

The tunnel powerpoint
The tunnel powerpointThe tunnel powerpoint
The tunnel powerpoint

Top down
Top down Top down
Top down

SCTP introduction
SCTP introductionSCTP introduction
SCTP introduction

Digital Transmission
Digital TransmissionDigital Transmission
Digital Transmission

Networking Standards And Protocols
Networking Standards And ProtocolsNetworking Standards And Protocols
Networking Standards And Protocols

Computer network switching
Computer network switchingComputer network switching
Computer network switching

Top Down and Bottom Up Design Model
Top Down and Bottom Up Design ModelTop Down and Bottom Up Design Model
Top Down and Bottom Up Design Model

Congestion control
Congestion controlCongestion control
Congestion control

Snmp
SnmpSnmp
Snmp

Railway engineering
Railway engineeringRailway engineering
Railway engineering

Stations and Yards of Railway
Stations and Yards of RailwayStations and Yards of Railway
Stations and Yards of Railway

Railway engineering
Railway engineeringRailway engineering
Railway engineering

Water cycle and water budget
Water cycle and water budgetWater cycle and water budget
Water cycle and water budget

Stream flow measurement
Stream flow measurementStream flow measurement
Stream flow measurement

Station yards
Station yardsStation yards
Station yards

Precipitation and its estimation
Precipitation and its estimationPrecipitation and its estimation
Precipitation and its estimation

Geometric design of the track
Geometric design of the trackGeometric design of the track
Geometric design of the track

Points and crossings
Points and crossingsPoints and crossings
Points and crossings

Floods
FloodsFloods
Floods

2 handouts-lecture-7
2  handouts-lecture-72  handouts-lecture-7
2 handouts-lecture-7

Similar to Tunnelling

Tunnelling Methods.pdf
Tunnelling Methods.pdfTunnelling Methods.pdf
Tunnelling Methods.pdf
SuryoNegoro3

u1t4tunneling.pptx
u1t4tunneling.pptxu1t4tunneling.pptx
u1t4tunneling.pptx
MagudeaswaranP

Tunnelling
TunnellingTunnelling
Tunnel boring machines123
Tunnel boring machines123Tunnel boring machines123
Tunnel boring machines123
Arpit Srivastava

Lecture 6 p
Lecture 6 pLecture 6 p
UNIT 1a.pdf
UNIT 1a.pdfUNIT 1a.pdf
UNIT 1a.pdf
LovelyLavakumarLK

Ecg533 rock-tunnel-engineering
Ecg533 rock-tunnel-engineeringEcg533 rock-tunnel-engineering
Ecg533 rock-tunnel-engineeringJunaida Wally

tunnelsppt-170126104231-converted (1)-converted.pdf
tunnelsppt-170126104231-converted (1)-converted.pdftunnelsppt-170126104231-converted (1)-converted.pdf
tunnelsppt-170126104231-converted (1)-converted.pdf
BalpreetSingh47890

Cut and cover_sections
Cut and cover_sectionsCut and cover_sections
Cut and cover_sectionsjuwes

Trenching & Excavation
Trenching & ExcavationTrenching & Excavation
Trenching & Excavation
Shivananda Roy

MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702
MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702
MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702
Dr. BASWESHWAR JIRWANKAR

CHAPTER 5 DEEP FOUNDATION (2)7788788.ppt
CHAPTER 5 DEEP FOUNDATION (2)7788788.pptCHAPTER 5 DEEP FOUNDATION (2)7788788.ppt
CHAPTER 5 DEEP FOUNDATION (2)7788788.ppt
bryankalindo888

1 sethi
1 sethi1 sethi
shaftab-170524171214.pdf
shaftab-170524171214.pdfshaftab-170524171214.pdf
shaftab-170524171214.pdf
SaimHaq

Eurasia tunnel1
Eurasia tunnel1Eurasia tunnel1
Eurasia tunnel1
Ujwal Ujwal

Shaft
Shaft Shaft
Shaft
Pramoda Raj

Tunnel
TunnelTunnel
3 tunnel
3 tunnel3 tunnel
3 tunnel
SUKANTA MONDAL

Similar to Tunnelling (20)

Tunnelling Methods.pdf
Tunnelling Methods.pdfTunnelling Methods.pdf
Tunnelling Methods.pdf

u1t4tunneling.pptx
u1t4tunneling.pptxu1t4tunneling.pptx
u1t4tunneling.pptx

Tunnelling
TunnellingTunnelling
Tunnelling

Tunnel boring machines123
Tunnel boring machines123Tunnel boring machines123
Tunnel boring machines123

Lecture 6 p
Lecture 6 pLecture 6 p
Lecture 6 p

UNIT 1a.pdf
UNIT 1a.pdfUNIT 1a.pdf
UNIT 1a.pdf

Ecg533 rock-tunnel-engineering
Ecg533 rock-tunnel-engineeringEcg533 rock-tunnel-engineering
Ecg533 rock-tunnel-engineering

tunnelsppt-170126104231-converted (1)-converted.pdf
tunnelsppt-170126104231-converted (1)-converted.pdftunnelsppt-170126104231-converted (1)-converted.pdf
tunnelsppt-170126104231-converted (1)-converted.pdf

Cut and cover_sections
Cut and cover_sectionsCut and cover_sections
Cut and cover_sections

Trenching & Excavation
Trenching & ExcavationTrenching & Excavation
Trenching & Excavation

MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702
MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702
MODULE-V INFRASTRUCTURE ENGINEERING BTCVC702

CHAPTER 5 DEEP FOUNDATION (2)7788788.ppt
CHAPTER 5 DEEP FOUNDATION (2)7788788.pptCHAPTER 5 DEEP FOUNDATION (2)7788788.ppt
CHAPTER 5 DEEP FOUNDATION (2)7788788.ppt

1 sethi
1 sethi1 sethi
1 sethi

shaftab-170524171214.pdf
shaftab-170524171214.pdfshaftab-170524171214.pdf
shaftab-170524171214.pdf

Eurasia tunnel1
Eurasia tunnel1Eurasia tunnel1
Eurasia tunnel1

Shaft
Shaft Shaft
Shaft

Tunnel PDF.pdf
Tunnel PDF.pdfTunnel PDF.pdf
Tunnel PDF.pdf

Tunnel
TunnelTunnel
Tunnel

Tunnel
TunnelTunnel
Tunnel

3 tunnel
3 tunnel3 tunnel
3 tunnel

Recently uploaded

Hierarchical Digital Twin of a Naval Power System
Hierarchical Digital Twin of a Naval Power SystemHierarchical Digital Twin of a Naval Power System
Hierarchical Digital Twin of a Naval Power System
Kerry Sado

Railway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdfRailway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdf
TeeVichai

Design and Analysis of Algorithms-DP,Backtracking,Graphs,B&B
Design and Analysis of Algorithms-DP,Backtracking,Graphs,B&BDesign and Analysis of Algorithms-DP,Backtracking,Graphs,B&B
Design and Analysis of Algorithms-DP,Backtracking,Graphs,B&B
Sreedhar Chowdam

power quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptxpower quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptx
ViniHema

NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
Amil Baba Dawood bangali

MCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdfMCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdf
Osamah Alsalih

ASME IX(9) 2007 Full Version .pdf
ASME IX(9)  2007 Full Version       .pdfASME IX(9)  2007 Full Version       .pdf
ASME IX(9) 2007 Full Version .pdf
AhmedHussein950959

block diagram and signal flow graph representation
block diagram and signal flow graph representationblock diagram and signal flow graph representation
block diagram and signal flow graph representation
Divya Somashekar

Gen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdfGen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdf
gdsczhcet

The Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdfThe Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdf
Pipe Restoration Solutions

Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdfHybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
fxintegritypublishin

Water Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdfWater Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation & Control

Standard Reomte Control Interface - Neometrix
Standard Reomte Control Interface - NeometrixStandard Reomte Control Interface - Neometrix
Standard Reomte Control Interface - Neometrix
Neometrix_Engineering_Pvt_Ltd

Fundamentals of Electric Drives and its applications.pptx
Fundamentals of Electric Drives and its applications.pptxFundamentals of Electric Drives and its applications.pptx
Fundamentals of Electric Drives and its applications.pptx
manasideore6

AP LAB PPT.pdf ap lab ppt no title specific
AP LAB PPT.pdf ap lab ppt no title specificAP LAB PPT.pdf ap lab ppt no title specific
AP LAB PPT.pdf ap lab ppt no title specific
BrazilAccount1

Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...
Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...
Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...
AJAYKUMARPUND1

一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理
一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理
一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理
zwunae

HYDROPOWER - Hydroelectric power generation
HYDROPOWER - Hydroelectric power generationHYDROPOWER - Hydroelectric power generation
HYDROPOWER - Hydroelectric power generation
Robbie Edward Sayers

Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)
Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)
Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)
MdTanvirMahtab2

Student information management system project report ii.pdf
Student information management system project report ii.pdfStudent information management system project report ii.pdf
Student information management system project report ii.pdf
Kamal Acharya

Recently uploaded (20)

Hierarchical Digital Twin of a Naval Power System
Hierarchical Digital Twin of a Naval Power SystemHierarchical Digital Twin of a Naval Power System
Hierarchical Digital Twin of a Naval Power System

Railway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdfRailway Signalling Principles Edition 3.pdf
Railway Signalling Principles Edition 3.pdf

Design and Analysis of Algorithms-DP,Backtracking,Graphs,B&B
Design and Analysis of Algorithms-DP,Backtracking,Graphs,B&BDesign and Analysis of Algorithms-DP,Backtracking,Graphs,B&B
Design and Analysis of Algorithms-DP,Backtracking,Graphs,B&B

power quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptxpower quality voltage fluctuation UNIT - I.pptx
power quality voltage fluctuation UNIT - I.pptx

NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...

MCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdfMCQ Soil mechanics questions (Soil shear strength).pdf
MCQ Soil mechanics questions (Soil shear strength).pdf

ASME IX(9) 2007 Full Version .pdf
ASME IX(9)  2007 Full Version       .pdfASME IX(9)  2007 Full Version       .pdf
ASME IX(9) 2007 Full Version .pdf

block diagram and signal flow graph representation
block diagram and signal flow graph representationblock diagram and signal flow graph representation
block diagram and signal flow graph representation

Gen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdfGen AI Study Jams _ For the GDSC Leads in India.pdf
Gen AI Study Jams _ For the GDSC Leads in India.pdf

The Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdfThe Benefits and Techniques of Trenchless Pipe Repair.pdf
The Benefits and Techniques of Trenchless Pipe Repair.pdf

Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdfHybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdf

Water Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdfWater Industry Process Automation and Control Monthly - May 2024.pdf
Water Industry Process Automation and Control Monthly - May 2024.pdf

Standard Reomte Control Interface - Neometrix
Standard Reomte Control Interface - NeometrixStandard Reomte Control Interface - Neometrix
Standard Reomte Control Interface - Neometrix

Fundamentals of Electric Drives and its applications.pptx
Fundamentals of Electric Drives and its applications.pptxFundamentals of Electric Drives and its applications.pptx
Fundamentals of Electric Drives and its applications.pptx

AP LAB PPT.pdf ap lab ppt no title specific
AP LAB PPT.pdf ap lab ppt no title specificAP LAB PPT.pdf ap lab ppt no title specific
AP LAB PPT.pdf ap lab ppt no title specific

Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...
Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...
Pile Foundation by Venkatesh Taduvai (Sub Geotechnical Engineering II)-conver...

一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理
一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理
一比一原版(IIT毕业证)伊利诺伊理工大学毕业证成绩单专业办理

HYDROPOWER - Hydroelectric power generation
HYDROPOWER - Hydroelectric power generationHYDROPOWER - Hydroelectric power generation
HYDROPOWER - Hydroelectric power generation

Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)
Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)
Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)

Student information management system project report ii.pdf
Student information management system project report ii.pdfStudent information management system project report ii.pdf
Student information management system project report ii.pdf

Tunnelling

  • 1.
  • 2. Definition Tunnels are artificial underground passages opened at both ends constructed for different purposes. Required for highways, railways, sewerage, water supply, public utilities and canals. Necessitated when open excavation of strata becomes uneconomical, not only construction cost but for maintenance as well. Continued Tunneling
  • 3. History The oldest tunnel was constructed 4000 years ago in ancient Babylon to underpass the bed of river Euphrates and to establish an underground connection between the royal palace and Temple of Jove. The length of the tunnel was 1 km and it was built with the considerable cross-section dimensions of 3.6 m by 4.5 m. In the second half of the 20th century, with the progress in development of both explosives and equipment, underground construction became feasible. Continued
  • 4. Geological Considerations or ground properties before constructing any tunnel project: The engineering properties of a rock generally depend not only on the matrix (structure formed by the minerals) but also imperfections in the structure such as voids (pore space ),cracks ,inclusions, grain boundaries and weak particles. Pore spaces are largely made up of continuous irregular capillary cracks separating the mineral grains.
  • 5. Physical discontinuities are present in all rock masses as a result of geological activities. Introduction of defects into the rock mass due to human activities that alter the properties of the rock material. The mechanical breaks in the rock have zero or low tensile strengths, increase rock deformability and provide pathways for water to flow.
  • 6. Crown: The uppermost part of the tunnel Transportation tunnel cross-sections Wall Crown Core (strozze) Springline Invert •Springline : The line at which the tunnel wall breaks from sloping outward to sloping inward toward the crown Top heading Bench Bottom Circular Horseshoe Vertical walls arch roof Invert : The bottom Heading : The excavated face of the tunnel (floor) of the tunnel Drift : A horizontal excavation Station : The distance measured from the portal (chainage) Wall : The side of the tunnel Portal : The tunnel entrance
  • 7. The choice of tunnelling method may be dictated by: geological and hydrological conditions Weak rock under high stresses leads to squeezing ground conditions. Brittle strong rock high stress conditions may lead to rockbursting.  cross-section and length of continuous tunnel local experience and time/cost considerations (what is the value of time in the project) limits of surface disturbance, and many others factors Choice of method depends upon nature of strata and geometry of tunnel section Continued
  • 8. Methods divided into three categories Firm ground- reasonable time available for installing conventional support. Soft ground- Conventional support can not be installed. Running ground- Special treatment required before starting excavation Continued Classification ooff TTuunnnneelllliinngg MMeetthhooddss bbaasseedd oonn ttyyppee ooff ssttrraattaa::
  • 9. TTuunnnneelllliinngg MMeetthhooddss Rough classification of methods  Excavation: An excavation process without removing the overlying rock or soil • Steps: excavating-remove muck-supporting-lining- ventilation-draining • Drill & Blast, hammer, roadheader, .... Cut and cover: trenching to excavate and construct a tunnel, and then backfilling earth over it. Immersed tunnel: lowering prefabricated tunnel elements into a dredged channel and joining them up under water • Concrete • Steel Continued
  • 10. Bottom-up method: The main site is excavated, with ground support as necessary, and the tunnel is constructed within. The tunnel may be of in situ concrete, precast concrete, precast arches, or corrugated steel arches. The trench is then carefully back-filled above the tunnel roof and the surface is restored.
  • 11.
  • 12.
  • 13.
  • 14. Coffer Dam and hydroelectric Tunnel
  • 15.
  • 16.
  • 17. Top-down method: Here side support walls and cap beams are constructed from ground level typically with slurry walls, or secant piling. Then a shallow excavation allows making the tunnel roof of precast beams or in situ concrete. The surface is then restored except for access openings. This allows early reinstatement of roadways, services and other surface features. Excavation then takes place under the permanent tunnel roof, and the base slab is constructed.
  • 18.
  • 19.
  • 20.
  • 21.
  • 22. Tunnelling in Firm ground Traditional methods. Involving drilling and blasting Full Face Method. In firm soils where full face excavation can hold it self for sufficient time to allow mucking and supporting operations. In the full-face method, workers excavate the entire diameter of the tunnel at the same time. This is most suitable for tunnels passing through strong ground or for building smaller tunnels. Continued
  • 23.
  • 24.
  • 25. Top Heading and benching. When full face excavation is not possible. Heading should be sufficient distance ahead of benching. In this technique, workers dig a smaller tunnel known as a heading. Once the top heading has advanced some distance into the rock, workers begin excavating immediately below the floor of the top heading; this is a bench.  One advantage of the top-heading-and-bench method is that engineers can use the heading tunnel to gauge the stability of the rock before moving forward with the project.
  • 26.
  • 27. Excavation by tunnelling Methods  Drift Method. In case of large or pilot tunnel , Drift is made and then expanded. There can be more than one drifts.  Different ‘drift methods’ depending on location of drift can be used.
  • 28. Tunnelling in Soft Strata Tunnels constructed in soft materials require temporary support immediately or shortly after excavation. Way to provide support are: Suitably spaced bents of wood Suitably spaced bents of steel for lagging (covering) Liner plates Fore poling placed to retain material between adjacent bents Temporary supports must be designed for higher working stress compared to those in permanent designs.
  • 29. Tunnelling in Soft Ground Instantaneous support is required No drilling and blasting. Forepoling is done.  Boards are driven ahead of the last ‘rib’, around periphery  Forepoles act as cantilevers beyond breasting  Soil is excavated after removing the breast board and new rib is erected Continued
  • 30. Because stand-up time is generally short when tunneling through soft ground, cave-ins are a constant threat. To prevent this from happening, engineers use a special piece of equipment called a shield. A shield is an iron or steel cylinder literally pushed into the soft soil. It carves a perfectly round hole and supports the surrounding earth while workers remove debris and install a permanent lining made of cast iron or precast concrete. When the workers complete a section, jacks push the shield forward and they repeat the process.
  • 31.
  • 32. Tunnelling in Running Ground Many methods Principle is, Linear plates are pushed in starting from crown Cavity is excavated Additional linear plates are pushed one by one and bolted Arch section gradually widened down to springing line. Continued

  • 33. Tunnelling in Rocks Tunnels are driven in rocks by drilling holes in the rock face, loading the holes with explosives, blasting and removing the broken rock Each sequence full cross section of the tunnel may be excavated, or one or more drifts may be there. Drilling pattern for holes of explosives may differ depending upon rock type, cross section, experience expertise and type of explosive suggested. Methods are similar in principle like  Full Face Method  Top Heading and benching  Drift Method Continued
  • 34. Tunneling through hard rock almost always involves blasting. Workers use a scaffold, called a jumbo, to place explosives quickly and safely. The jumbo moves to the face of the tunnel, and drills mounted to the jumbo make several holes in the rock. The depth of the holes can vary depending on the type of rock, but a typical hole is about 10 feet deep and only a few inches in diameter. Next, workers pack explosives into the holes, evacuate the tunnel and detonate the charges. After vacuuming out the noxious fumes created during the explosion, workers can enter and begin carrying out the debris, known as muck, using carts.  Then they repeat the process, which advances the tunnel slowly through the rock.
  • 35.
  • 36.
  • 37. Fire-setting is an alternative to blasting. In this technique, the tunnel wall is heated with fire, and then cooled with water. The rapid expansion and contraction caused by the sudden temperature change causes large chunks of rock to break off. The Cloaca Maxima, one of Rome's oldest sewer tunnels, was built using this technique. The stand-up time for solid, very hard rock may measure in centuries. In this environment, extra support for the tunnel roof and walls may not be required. However, most tunnels pass through rock that contains breaks or pockets of fractured rock, so engineers must add additional support in the form of bolts, sprayed concrete or rings of steel beams. In most cases, they add a permanent concrete lining
  • 38. Sequence of operation in Rocky Strata (Drill and Blast) Marking tunnel profile. Setting up and drilling Loading explosive and blasting Removing the foul gases Checking Scaling Mucking Rock bolting and lining Continued
  • 39. Modern Tunnel Construction Methods:  Drill and blast  Mechanical drilling/cutting  Cut-and-cover  Immersed tunnels  Tunnel boring machines (TBMs)  New Austrian Tunnelling Method (NATM) Continued
  • 41.
  • 42.
  • 43. Types of support Steel arches Steel ribs are used for reinforcement of weaker tunnel sections, and give rigid to semi-rigid support. The ribs are made from I-beam or H-beam structural steel bent to conform to the requirements of a particular tunnel cross-section. Timber may be used for packing between the beams and the rock. However, providing continuous bedding against the rock may considerably increase the load-bearing capacity of the arches. Continued
  • 44.
  • 45. Rock bolts Steel bolts are frequently set in holes drilled into the rock to assist in supporting the entire roof or individual rock slabs that tend to fall into a tunnel. Rock bolts maintain the stability of an opening by suspending the dead weight of a slab from the rock above Continued
  • 46. Shotcrete Pneumatically applied mortar and concrete are increasingly being used for the support of underground excavations. A combination of rock bolts and shotcrete has proved an excellent temporary support for all qualities of rock. Shotcrete is best known in tunnelling as an integral component of the NATM (New Austrian Tunnelling Method). Quick-setting concrete is sprayed onto the bare rock surface immediately after excavation, and rapidly hardens to form a preliminary support until the final lining of conventional poured concrete can be installed. Continued
  • 47. Wire mesh Wire mesh is used to support small pieces of loose rock or as reinforcement for shotcrete. Two types of wire mesh chain link mesh commonly used for fencing and it consists of a woven fabric of wire, tends to be flexible and strong weld mesh. commonly used for reinforcing shotcrete and it consists of a square grid of steel wires, welded at their intersection points.
  • 48.
  • 49. Ventilation during construction Why required? To furnish fresh air for the workers To remove the dust caused by drilling, blasting, mucking, diesel engines, and other operations To remove obnoxious gases and fumes of explosives How done? Mechanical ventilation is usually supplied by electric fans, as for example axial flow pressure fans.  If air is blown into a tunnel, it may be forced through a lightweight pipe or fabric duct.  If air is exhausted, it is necessary to use a rigid duct that will not collapse. The exhaust method has the advantage of more quickly removing objectionable air from spaces occupied by the workers. Continued
  • 50. Ventilation of tunnels Mechanical ventilation systems provide the temperature, humidity and air velocity conditions necessary to give tunnel users a reasonable degree of comfort during normal operation.  When a fire occurs in a tunnel, the system must also provide a safe evacuation route for tunnel users and access for fire fighting services. The choice and design of a ventilation system depends on these main factors: tunnel length and volume admissible air pollution around tunnel portals fire safety considerations. Key pollutants include carbon dioxide, nitrogen oxides, nitrogen dioxide, hydrocarbons PM10 and lead. Better understanding of ventilation techniques Awareness of new safety and environmental legislation.
  • 51.
  • 52.
  • 53.
  • 54.
  • 55. Geological Survey For Tunneling  A geological survey is the systematic investigation of the subsurface and surface of a given piece of ground for the purpose of creating a geological map ,model and feasibility studies.  A geological survey employs techniques from the traditional walk-over survey, studying outcrops and landforms, to intrusive methods, such as hand auguring and machine driven boreholes, use of geophysical techniques and remote sensing methods, such as aerial photography and satellite imagery etc.
  • 56. Types Of Geological Survey  Mainly geological surveys are classified into two types: Surface Geological Survey Subsurface Geological Survey  Surface Geological Survey: includes on land geology and geological structures,landforms,hydrology,outcrop pattern ,engineering properties etc  Subsurface Geological Survey: : includes on underground geology and geological structures,Geo-hydrogeology,subsurface rock or soil pattern etc
  • 57. Surface Geological Survey Geological profile is prepared along line of tunnel. Geological observations are done along this profile like engineering properties of rock/soil, geological structures like fold,faults,joints,spring,stream,river alignment and any seepage etc Trial boring plan is prepared along the tunnel line.
  • 58.
  • 59.
  • 60.
  • 61.
  • 62.
  • 63. Subsurface Geological Survey Trial boring is done along the tunnel line. Different rock and soil samples are collected from subsurface and their physical and chemical properties are observed. Some samples are sent to laboratory for determination of engineering properties like shearing,strenght,permeability,porosity,compr essive strenght,and other test are performed. GWT(Ground Water Table) is noted and water bearing strata is marked in geological profile.
  • 64.
  • 65.
  • 66.
  • 67.
  • 68.
  • 69.
  • 70. Different geophysical surveys like refraction, resistivity, GPR(Ground Penetrating Radar) and bor hole logging etc are also done. In situ testing like Packer-testing, hydro fracturing, load-testing etc are performed. A geological/feasibility report comprising all information ,photographs, profile and others necessary data are presented for final tunnel design and construction.
  • 71.
  • 72.
  • 73.
  • 74.
  • 75.
  • 76.
  • 77.
  • 78.
  • 79.
