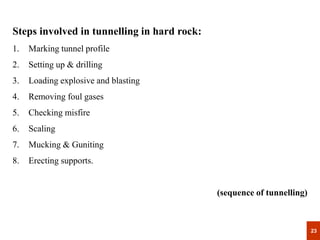

The document discusses drainage systems for tunnels. It explains that drainage systems control water entering tunnels during and after construction by preventing excess water and removing what does enter. Water comes from wash water used during drilling and groundwater. Drainage systems are either temporary, using open ditches or pumping, or permanent, including central drains, corrugated roofing with side drains, or single side drains. Central drains use a sloped drainage ditch to move water towards portals for pumping. Single side drains are suitable when tunnels only require a single lane and use a single large drain. Open ditches are simplest but work best in impervious soils and rock. Pumping systems collect water in sumps and use piston or

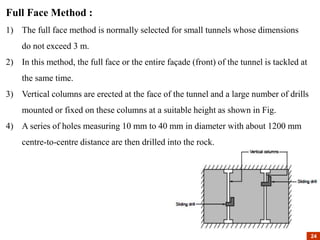

This document discusses the design and construction of hill roads in Nepal. Some key points:
- Hill roads are defined as roads with cross slopes of 25% or more, passing through mountainous terrain. They present many design challenges due to steep slopes, complex geology, and extreme weather.
- Special structures are often required for hill roads, such as retaining walls, drainage structures, and hairpin turns to navigate steep terrain without excessive length. Proper drainage, slope stability, and sight lines are important design considerations.
- Alignment must balance factors like temperature, rainfall, geology and more. River routes can provide gentler grades but require extensive drainage works, while ridge routes have steep grades and sharp turns.
A railway station has platforms for passengers to board and disembark trains. It also has a station building for ticket sales and waiting areas. Stations range in size from small stops to large terminals. A station yard contains multiple tracks for sorting trains, including passenger, goods, locomotive, and marshalling yards. Marshalling yards separate incoming cars and reform them into outbound trains using flat, gravity, or hump yard designs. Larger stations have more facilities for passengers and goods handling.
The document discusses the balanced cantilever method of bridge construction. It begins by explaining that this method is used for bridges with spans between 50-250m, and involves attaching precast or cast-in-place segments in an alternating manner from each end of cantilevers supported by piers. This method is well-suited for irregular spans, congested sites, and environmentally sensitive areas. It also discusses advantages like determinacy and reduced cracking risks. The document then goes into detail about construction sequences, member proportioning, superstructure types, and analysis of a specific balanced cantilever bridge in Kochi, India.

This document discusses tunnel failures and tunnel linings. It notes that tunnels can fail due to discontinuities in the surrounding rock/soil, stratified rock layers, stress, minerals, water pressure, seismic effects, and permanent soil displacement. Tunnel linings are needed to prevent collapse in loose rock and soft soils. Common tunnel lining materials include in-situ concrete, rock shotcrete, wire mesh, steel bolts, and pneumatically applied mortar and concrete. Modern tunnels often use precast concrete blocks for their lining in an advance construction method.
The document discusses causes of failure for weirs and barrages built on permeable foundations, including piping/undermining, uplift pressure, hydraulic jump, and scouring. It explains that piping occurs when water percolates through the foundation and erodes soil particles, creating a hollow channel. Uplift pressure from percolating water can also cause failure if the structure's weight cannot counterbalance it. Hydraulic jump and high-velocity surface flow can produce suction pressures and scour soil. The document recommends increasing the seepage path using sheet piles, increasing floor thickness to resist uplift, and using energy dissipaters and filters to prevent soil loss and structural failure.
Selection of Alignment & importance of track drainageRAMPRASAD KUMAWAT
This document discusses factors that affect railway alignment selection and the importance of track drainage. It lists 11 factors that influence alignment choices, including gauge, topography, stations/yards, and economics. Proper track drainage is also emphasized as crucial for track maintenance. Water can soften formations and cause ballast loss if not drained quickly. Good drainage ensures water flows off the track through clean ballast, sloped formations, and side drains. Maintaining drainage is important for track quality and reducing wear on components.
Tunnel engineering involves constructing underground passages through various materials like hard rock and soft soils. Key aspects of tunnel engineering include preliminary considerations like geological investigations of the tunnel route to understand ground conditions, selecting an appropriate tunnel shape and size based on factors like surrounding material and purpose, and using methods like timbering and shafts to excavate the tunnel safely. Drilling equipment suitable for the rock type and purpose is used to drill blast holes for excavating rock tunnels. Safety measures like adequate ventilation and drainage are also important considerations in tunnel engineering.
this presentation describes in details the sinking operation of well foundations in different conditions and situations. the content here is suitable only for basic knowledge and educational purposes.
The construction of a new railway track involves three main stages: earth work to prepare the formation, plate laying which involves laying rails and sleepers, and laying of ballast. There are different methods for plate laying such as the tramline method, telescopic method, and American method. Maintenance of the track is also important and involves daily inspection and maintenance as well as periodic maintenance to detect defects.
Tunnels can be constructed using various methods depending on factors like geological conditions and the length and diameter of the tunnel. Traditional methods include cut-and-cover where a trench is excavated and covered, drill-and-blast where explosives are used to break rock, and the use of tunnel boring machines. The New Austrian Tunnelling Method (NATM) employs flexible supports and monitoring to optimize reinforcement based on the rock type. It relies on conserving the inherent strength of the surrounding rock mass.
Tunnels are underground passages constructed for various purposes such as transportation, infrastructure, and military use. Key points from the document:
- Tunnels can carry vehicles, trains, water, sewage, and more underground or under water obstacles.
- They are built when roads encounter obstacles like mountains or water barriers to provide an alternative to bypassing or bridging over the obstacle.
- Tunnel construction has a long history dating back thousands of years, with modern techniques now using tunnel boring machines and advanced engineering methods.

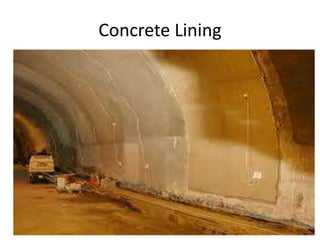

Lining is an integral part of Tunneling. Once the Shotcrete line ,i.e the B-line,is laid, the Kerb/Kicker or Say Beam is executed. Next Comes the Geotextile/Waterproofing Membrane. After that, C-line is laid which is referred to as inner lining.
This document provides terminology and descriptions related to underground structures like tunnels. It includes definitions of different tunnel construction elements and methods. Some key points covered include:
- Definitions of tunnel construction terms like adit, shaft, chamber, support, failure modes, and tunnelling methods.
- Descriptions of different tunnelling methods including shield tunnelling, cut-and-cover tunnelling, and tunnelling boring machines (TBMs).
- Factors that influence rock excavation for tunnels like geological structures, rock properties, and resistance to excavation.
- Examples of large irrigation tunnels including details of the Urfa Irrigation Tunnel in Turkey.
The document discusses different methods of tunneling in soft ground and hard rock. It describes various types of soft ground and factors that affect the choice of tunneling method. Methods for soft ground include those using timber supports as well as shield, compressed air, and linear plate methods. For hard rock, common techniques are the full face, heading and bench, and drift methods. Sequence of operations are provided for different soft ground and hard rock tunneling approaches.
Well foundations are commonly used for major bridges in India to resist large lateral forces. They are constructed similarly to conventional wells but are more rigid. Different well foundation shapes exist including circular, double D, and rectangular designs. The selection depends on the soil strata. For example, constructing a well foundation in bouldery soil like for the Pasighat Bridge in India was difficult due to large boulders and reduced working periods from heavy rainfall. Pneumatic caisson wells also risked worker health issues from changes in pressure. Proper planning of well construction based on soil data collection is important.
Here is the some basic information regarding Tunneling & Rock Drilling Equipments which I have collected from different resources (Internet,Professors,Experts,Engineers,Companies etc). It would be very helpful for M.Tech students of Construction Engineering & Management.
-RAJARSHI
This document discusses spillways and energy dissipators for dams. It defines spillways as structures used to safely release surplus water from reservoirs. The main types of spillways are main, auxiliary, and emergency spillways. Spillways can also be classified based on their prominent features, such as free overflow, overflow, side channel, open channel, tunnel, shaft, and siphon spillways. Energy dissipators, such as stilling basins and bucket types, are also discussed to reduce the energy of water flowing from spillways. Common energy dissipator types include horizontal and sloping apron stilling basins, and solid roller, slotted roller, and ski jump bucket dissipators.
Track alignment refers to the direction and position of a railway track. It includes horizontal and vertical elements. An ideal alignment considers factors like purpose of the track, feasibility, economy, safety, and aesthetics. Several surveys are conducted to determine the optimal route, including reconnaissance, preliminary, and location surveys. Proper gradient design is also important for safe and smooth train operation. Gradients must consider factors like locomotive performance, train loads, and terrain. The ruling gradient is the maximum design grade, while helper gradients require extra locomotives for steep sections. Momentum gradients can be steeper using kinetic energy from descending sections.

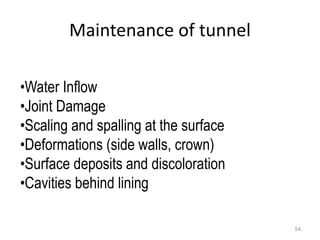

Tunnels are underground passages constructed for various purposes like transportation, utilities, and drainage. They are needed when surface excavation is uneconomical or causes too much disturbance. The document discusses the history of tunnel construction and various geological and engineering considerations involved. It describes different tunnel excavation methods based on the type of ground or rock, including drill-and-blast, tunnel boring machines, and new techniques like the New Austrian Tunnelling Method. Support methods are also discussed, ranging from timber supports in soft ground to steel arches and concrete linings in harder strata.
The document discusses various methods for railway track construction, maintenance, and operation. It describes the process for earthwork and preparing the track bed, including stabilizing poor soils. It then covers several tunneling methods for passing through rock and soft ground, as well as underwater. These include the full face method, heading and benching, drift system, pilot tunnel method, shield tunneling, and cut and cover method. It also discusses forepoling for tunneling through soft ground.
This document discusses geological considerations for successful tunneling. It describes how the rock type, geological structures, and groundwater conditions can impact tunnel construction. Competent rocks like massive igneous rocks allow safe but slow tunneling without lining, while incompetent or fractured rocks require support. Folded or jointed rocks, fault zones, and water-bearing formations present challenges. Proper site investigation is needed to evaluate the geology and plan appropriate excavation and support methods.
This document discusses the design and construction of hill roads in Nepal. Some key points:
- Hill roads are defined as roads with cross slopes of 25% or more, passing through mountainous terrain. They present many design challenges due to steep slopes, complex geology, and extreme weather.
- Special structures are often required for hill roads, such as retaining walls, drainage structures, and hairpin turns to navigate steep terrain without excessive length. Proper drainage, slope stability, and sight lines are important design considerations.
- Alignment must balance factors like temperature, rainfall, geology and more. River routes can provide gentler grades but require extensive drainage works, while ridge routes have steep grades and sharp turns.
A railway station has platforms for passengers to board and disembark trains. It also has a station building for ticket sales and waiting areas. Stations range in size from small stops to large terminals. A station yard contains multiple tracks for sorting trains, including passenger, goods, locomotive, and marshalling yards. Marshalling yards separate incoming cars and reform them into outbound trains using flat, gravity, or hump yard designs. Larger stations have more facilities for passengers and goods handling.
The document discusses the balanced cantilever method of bridge construction. It begins by explaining that this method is used for bridges with spans between 50-250m, and involves attaching precast or cast-in-place segments in an alternating manner from each end of cantilevers supported by piers. This method is well-suited for irregular spans, congested sites, and environmentally sensitive areas. It also discusses advantages like determinacy and reduced cracking risks. The document then goes into detail about construction sequences, member proportioning, superstructure types, and analysis of a specific balanced cantilever bridge in Kochi, India.
This document discusses tunnel failures and tunnel linings. It notes that tunnels can fail due to discontinuities in the surrounding rock/soil, stratified rock layers, stress, minerals, water pressure, seismic effects, and permanent soil displacement. Tunnel linings are needed to prevent collapse in loose rock and soft soils. Common tunnel lining materials include in-situ concrete, rock shotcrete, wire mesh, steel bolts, and pneumatically applied mortar and concrete. Modern tunnels often use precast concrete blocks for their lining in an advance construction method.
The document discusses causes of failure for weirs and barrages built on permeable foundations, including piping/undermining, uplift pressure, hydraulic jump, and scouring. It explains that piping occurs when water percolates through the foundation and erodes soil particles, creating a hollow channel. Uplift pressure from percolating water can also cause failure if the structure's weight cannot counterbalance it. Hydraulic jump and high-velocity surface flow can produce suction pressures and scour soil. The document recommends increasing the seepage path using sheet piles, increasing floor thickness to resist uplift, and using energy dissipaters and filters to prevent soil loss and structural failure.
Selection of Alignment & importance of track drainageRAMPRASAD KUMAWAT
This document discusses factors that affect railway alignment selection and the importance of track drainage. It lists 11 factors that influence alignment choices, including gauge, topography, stations/yards, and economics. Proper track drainage is also emphasized as crucial for track maintenance. Water can soften formations and cause ballast loss if not drained quickly. Good drainage ensures water flows off the track through clean ballast, sloped formations, and side drains. Maintaining drainage is important for track quality and reducing wear on components.
Tunnel engineering involves constructing underground passages through various materials like hard rock and soft soils. Key aspects of tunnel engineering include preliminary considerations like geological investigations of the tunnel route to understand ground conditions, selecting an appropriate tunnel shape and size based on factors like surrounding material and purpose, and using methods like timbering and shafts to excavate the tunnel safely. Drilling equipment suitable for the rock type and purpose is used to drill blast holes for excavating rock tunnels. Safety measures like adequate ventilation and drainage are also important considerations in tunnel engineering.
this presentation describes in details the sinking operation of well foundations in different conditions and situations. the content here is suitable only for basic knowledge and educational purposes.
The construction of a new railway track involves three main stages: earth work to prepare the formation, plate laying which involves laying rails and sleepers, and laying of ballast. There are different methods for plate laying such as the tramline method, telescopic method, and American method. Maintenance of the track is also important and involves daily inspection and maintenance as well as periodic maintenance to detect defects.
Tunnels can be constructed using various methods depending on factors like geological conditions and the length and diameter of the tunnel. Traditional methods include cut-and-cover where a trench is excavated and covered, drill-and-blast where explosives are used to break rock, and the use of tunnel boring machines. The New Austrian Tunnelling Method (NATM) employs flexible supports and monitoring to optimize reinforcement based on the rock type. It relies on conserving the inherent strength of the surrounding rock mass.
Tunnels are underground passages constructed for various purposes such as transportation, infrastructure, and military use. Key points from the document:
- Tunnels can carry vehicles, trains, water, sewage, and more underground or under water obstacles.
- They are built when roads encounter obstacles like mountains or water barriers to provide an alternative to bypassing or bridging over the obstacle.
- Tunnel construction has a long history dating back thousands of years, with modern techniques now using tunnel boring machines and advanced engineering methods.
Lining is an integral part of Tunneling. Once the Shotcrete line ,i.e the B-line,is laid, the Kerb/Kicker or Say Beam is executed. Next Comes the Geotextile/Waterproofing Membrane. After that, C-line is laid which is referred to as inner lining.
This document provides terminology and descriptions related to underground structures like tunnels. It includes definitions of different tunnel construction elements and methods. Some key points covered include:
- Definitions of tunnel construction terms like adit, shaft, chamber, support, failure modes, and tunnelling methods.
- Descriptions of different tunnelling methods including shield tunnelling, cut-and-cover tunnelling, and tunnelling boring machines (TBMs).
- Factors that influence rock excavation for tunnels like geological structures, rock properties, and resistance to excavation.
- Examples of large irrigation tunnels including details of the Urfa Irrigation Tunnel in Turkey.
The document discusses different methods of tunneling in soft ground and hard rock. It describes various types of soft ground and factors that affect the choice of tunneling method. Methods for soft ground include those using timber supports as well as shield, compressed air, and linear plate methods. For hard rock, common techniques are the full face, heading and bench, and drift methods. Sequence of operations are provided for different soft ground and hard rock tunneling approaches.
Well foundations are commonly used for major bridges in India to resist large lateral forces. They are constructed similarly to conventional wells but are more rigid. Different well foundation shapes exist including circular, double D, and rectangular designs. The selection depends on the soil strata. For example, constructing a well foundation in bouldery soil like for the Pasighat Bridge in India was difficult due to large boulders and reduced working periods from heavy rainfall. Pneumatic caisson wells also risked worker health issues from changes in pressure. Proper planning of well construction based on soil data collection is important.
Here is the some basic information regarding Tunneling & Rock Drilling Equipments which I have collected from different resources (Internet,Professors,Experts,Engineers,Companies etc). It would be very helpful for M.Tech students of Construction Engineering & Management.
-RAJARSHI
This document discusses spillways and energy dissipators for dams. It defines spillways as structures used to safely release surplus water from reservoirs. The main types of spillways are main, auxiliary, and emergency spillways. Spillways can also be classified based on their prominent features, such as free overflow, overflow, side channel, open channel, tunnel, shaft, and siphon spillways. Energy dissipators, such as stilling basins and bucket types, are also discussed to reduce the energy of water flowing from spillways. Common energy dissipator types include horizontal and sloping apron stilling basins, and solid roller, slotted roller, and ski jump bucket dissipators.
Track alignment refers to the direction and position of a railway track. It includes horizontal and vertical elements. An ideal alignment considers factors like purpose of the track, feasibility, economy, safety, and aesthetics. Several surveys are conducted to determine the optimal route, including reconnaissance, preliminary, and location surveys. Proper gradient design is also important for safe and smooth train operation. Gradients must consider factors like locomotive performance, train loads, and terrain. The ruling gradient is the maximum design grade, while helper gradients require extra locomotives for steep sections. Momentum gradients can be steeper using kinetic energy from descending sections.
Tunnels are underground passages constructed for various purposes like transportation, utilities, and drainage. They are needed when surface excavation is uneconomical or causes too much disturbance. The document discusses the history of tunnel construction and various geological and engineering considerations involved. It describes different tunnel excavation methods based on the type of ground or rock, including drill-and-blast, tunnel boring machines, and new techniques like the New Austrian Tunnelling Method. Support methods are also discussed, ranging from timber supports in soft ground to steel arches and concrete linings in harder strata.
The document discusses various methods for railway track construction, maintenance, and operation. It describes the process for earthwork and preparing the track bed, including stabilizing poor soils. It then covers several tunneling methods for passing through rock and soft ground, as well as underwater. These include the full face method, heading and benching, drift system, pilot tunnel method, shield tunneling, and cut and cover method. It also discusses forepoling for tunneling through soft ground.
This document discusses geological considerations for successful tunneling. It describes how the rock type, geological structures, and groundwater conditions can impact tunnel construction. Competent rocks like massive igneous rocks allow safe but slow tunneling without lining, while incompetent or fractured rocks require support. Folded or jointed rocks, fault zones, and water-bearing formations present challenges. Proper site investigation is needed to evaluate the geology and plan appropriate excavation and support methods.
This document discusses different types and construction methods of tunnels. It describes various tunnel shapes including rectangular, elliptical, circular, and horseshoe shapes. Common tunnel lining materials are discussed such as brick, concrete, precast segments, and sprayed concrete. Construction methods for tunnels include cut-and-cover, pipe jacking, shield tunnelling, tunnel boring machines (TBMs), and drill-and-blast for rock tunnels. The New Austrian Tunnelling Method and construction of submerged tunnels are also summarized.
This document discusses various aspects of tunnel construction including definitions, purposes, factors affecting construction, major tunnels in India, shapes of tunnels, geological surveys, design considerations, construction methods, and conclusions. It defines a tunnel as an underground passageway dug through surrounding soil or rock and enclosed except at entrances and exits. Common construction methods described are cut-and-cover, tunnel boring machine (TBM), shield technique, pipe jacking, and sprayed concrete. Design considerations include alignment, tunnel lining, groundwater control, ventilation, and investigation.
Tunnel is an artificially constructed underground passage to by- pass obstacles safely without disturbing the over burden. This module explains about tunnels, their parts, types and importance.
A tunnel boring machine (TBM) excavates tunnels with a circular cross section through a variety of soil and rock strata. TBMs can bore through varying ground conditions including soft ground, mixed face conditions and hard rock. The document discusses different tunnel construction methods such as drill-and-blast, TBMs, cut-and-cover and immersed tunnels. It also describes the various processes involved in tunnel boring including drilling, excavation, muck removal, ground treatment and tunnel lining. Selection of the appropriate construction method depends on geological conditions, tunnel dimensions, construction timelines and other factors.
tunnelling scope, construction techniques and necessityShashank Gaurav
This document discusses tunnel construction methods and planning. It describes the main types of tunnels based on application and construction method. The key construction methods covered are cut-and-cover, pipe jacking, shield tunneling, New Austrian tunneling method, and immersed tube tunneling. For each method, the document outlines the construction sequence, advantages, and disadvantages. Proper planning stages including investigations and alignment selection are also emphasized.
The document discusses various construction techniques used in building structures. It describes the basic components of a building like foundation, flooring, walls etc. It then explains concepts like abutments, piers which support bridges. Further, it discusses trenchless construction techniques - box jacking, pipe jacking, microtunneling, pipe bursting. Horizontal directional drilling and its stages are also summarized. Formwork techniques like jump formwork and slip formwork used for constructing high rise buildings are explained along with their advantages.
The document provides information about tunnel construction. It begins with an introduction and then discusses why tunnels are constructed, the history and classification of tunnels, different tunnel shapes, the tunnel construction process, and various tunnel construction methods. It also outlines the advantages of tunnels. Key points include that tunnels provide underground passages for transportation and utilities, and that modern construction methods include cut-and-cover, drill-and-blast, tunnel boring machines (TBM), and New Austrian tunneling.
The Eurasia Tunnel is a 5 km underground road tunnel in Istanbul, Turkey that connects the European and Asian sides of the city beneath the Bosphorus strait. It uses a tunnel boring machine and the New Austrian Tunnelling Method to bore through soil and rock as deep as 106 meters below sea level. The tunnel consists of two decks with two lanes each and features seismic joints to allow movement during earthquakes.
This document provides information on various topics related to tunnelling including introduction, role of geology, factors improving tunnelling, problems associated with tunnelling, future considerations, terms related to mining practices and tunnelling, tunnel service classification, methods of tunnelling, development of drills, equipment used, drilling processes, and specific drilling equipment. It discusses the importance of tunnels, describes different types of tunnels based on use and ground conditions, and outlines key factors to consider for tunnel design and construction methods.
The document discusses underground construction and tunneling techniques. It describes various tunnel shapes and factors to consider in tunnel construction like collapse prevention, ventilation, precision, and safety. Common tunneling methods include the tunnel boring machine (TBM) method, conventional drilling and blasting, and the tunneling shield method. Case studies of the Gotthard Base Tunnel and Bolu Tunnel are provided, along with conclusions on utilizing different construction methods and developing new technologies for small-scale tunneling projects.
Necessity/advantage of a tunnel, Classification of Tunnels,
Size and shape of a tunnel, Alignment of a Tunnel, Portals and Shafts,
Methods of Tunneling in Hard Rock and Soft ground, Mucking, Lighting
and Ventilation in tunnel, Dust control, Drainage of tunnels, Safety in
tunnel construction.
This document discusses tunneling and provides information on various topics related to tunnels. It introduces tunnels and their uses for transportation. It covers topics like lighting, ventilation, lining, size and shape of tunnels. It describes different types of tunnels and their applications. It also discusses advantages of tunnels and some limitations. In conclusion, it states that tunneling is effective for high traffic densities and has environmental benefits, but requires specialized expertise.
Hydraulic tunnels are underground water conduits that convey water without disturbing the surface. They have several advantages over surface canals, including less environmental impact, shorter routes, and not disturbing the natural landscape. However, they have higher construction costs and risks. Tunnels can be circular, D-shaped, or horseshoe-shaped depending on rock conditions. They require lining after excavation to increase strength and hydraulic capacity. Common excavation methods include drilling and blasting, tunnel boring machines, and the New Austrian Tunneling Method. Proper support like rock bolts and steel ribs is needed to prevent tunnel collapse.
Tunnels are underground passages constructed for various purposes such as transportation, infrastructure, and military use. They are built using various tunneling methods that depend on ground conditions and the intended use of the tunnel. A geological survey of the proposed tunnel route is crucial for determining the subsurface conditions and appropriate construction method. Tunnels require linings and ventilation systems to safely support the structure and remove gases during construction and use.
1. Soil investigations are conducted to obtain information useful for planning, designing and executing construction projects. This includes determining soil properties, groundwater levels, suitable foundation types and depths, bearing capacity, settlements, and lateral earth pressures.
2. Standard penetration tests are used to determine soil properties like relative density and strength. The test involves driving a split spoon sampler into the soil using a hammer and measuring the blow counts. Corrections are made for dilatancy and overburden pressure.
3. Piles can be classified based on material, load transfer method, construction method, use, and soil displacement. Components of a well foundation include the cutting edge, well curb, stining, bottom plug, sand fill
Metro Underground civil structures and track structures AR.pdfAshutoshRankawat
The document discusses underground structures for metro rail systems, including tunnels and stations. It describes the types of tunnels as generally using a twin bore single track structure. It outlines three main methods for constructing tunnels: cut and cover, NATM (New Austrian Tunnelling Method), and TBM (Tunnel Boring Machine). It provides details on the construction processes for each method. It also describes the typical design of underground metro stations and the two main construction methods: cut and cover (bottom up) and top down.
How to Download & Install Module From the Odoo App Store in Odoo 17Celine George
Custom modules offer the flexibility to extend Odoo's capabilities, address unique requirements, and optimize workflows to align seamlessly with your organization's processes. By leveraging custom modules, businesses can unlock greater efficiency, productivity, and innovation, empowering them to stay competitive in today's dynamic market landscape. In this tutorial, we'll guide you step by step on how to easily download and install modules from the Odoo App Store.
How to Manage Reception Report in Odoo 17Celine George
A business may deal with both sales and purchases occasionally. They buy things from vendors and then sell them to their customers. Such dealings can be confusing at times. Because multiple clients may inquire about the same product at the same time, after purchasing those products, customers must be assigned to them. Odoo has a tool called Reception Report that can be used to complete this assignment. By enabling this, a reception report comes automatically after confirming a receipt, from which we can assign products to orders.
Andreas Schleicher presents PISA 2022 Volume III - Creative Thinking - 18 Jun...EduSkills OECD
Andreas Schleicher, Director of Education and Skills at the OECD presents at the launch of PISA 2022 Volume III - Creative Minds, Creative Schools on 18 June 2024.
🔥🔥🔥🔥🔥🔥🔥🔥🔥
إضغ بين إيديكم من أقوى الملازم التي صممتها
ملزمة تشريح الجهاز الهيكلي (نظري 3)
💀💀💀💀💀💀💀💀💀💀
تتميز هذهِ الملزمة بعِدة مُميزات :
1- مُترجمة ترجمة تُناسب جميع المستويات
2- تحتوي على 78 رسم توضيحي لكل كلمة موجودة بالملزمة (لكل كلمة !!!!)
#فهم_ماكو_درخ
3- دقة الكتابة والصور عالية جداً جداً جداً
4- هُنالك بعض المعلومات تم توضيحها بشكل تفصيلي جداً (تُعتبر لدى الطالب أو الطالبة بإنها معلومات مُبهمة ومع ذلك تم توضيح هذهِ المعلومات المُبهمة بشكل تفصيلي جداً
5- الملزمة تشرح نفسها ب نفسها بس تكلك تعال اقراني
6- تحتوي الملزمة في اول سلايد على خارطة تتضمن جميع تفرُعات معلومات الجهاز الهيكلي المذكورة في هذهِ الملزمة
واخيراً هذهِ الملزمة حلالٌ عليكم وإتمنى منكم إن تدعولي بالخير والصحة والعافية فقط
كل التوفيق زملائي وزميلاتي ، زميلكم محمد الذهبي 💊💊
🔥🔥🔥🔥🔥🔥🔥🔥🔥
A Free 200-Page eBook ~ Brain and Mind Exercise.pptxOH TEIK BIN
(A Free eBook comprising 3 Sets of Presentation of a selection of Puzzles, Brain Teasers and Thinking Problems to exercise both the mind and the Right and Left Brain. To help keep the mind and brain fit and healthy. Good for both the young and old alike.
Answers are given for all the puzzles and problems.)
With Metta,
Bro. Oh Teik Bin 🙏🤓🤔🥰
Temple of Asclepius in Thrace. Excavation resultsKrassimira Luka
The temple and the sanctuary around were dedicated to Asklepios Zmidrenus. This name has been known since 1875 when an inscription dedicated to him was discovered in Rome. The inscription is dated in 227 AD and was left by soldiers originating from the city of Philippopolis (modern Plovdiv).
1. Tunnels :-
1) Alignment & Surveys.
2) Cross section of highway & railway tunnels.
3) Tunneling methods in hard rock and soft grounds.
4) Tunnel lining, drainage, ventilation and lighting of tunnels.
5) Advances in tunneling techniques.
6) Tunnel boring machines and case studies.

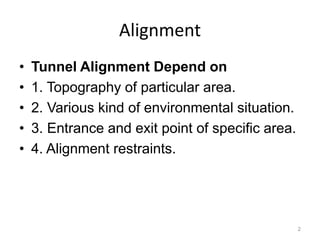

2. Alignment
• Tunnel Alignment Depend on
• 1. Topography of particular area.
• 2. Various kind of environmental situation.
• 3. Entrance and exit point of specific area.
• 4. Alignment restraints.
2
5. 5
Tunnel
A tunnel is an underground or underwater passageway, dug through the surrounding
soil/earth/rock and enclosed except for entrance and exit, commonly at each end.

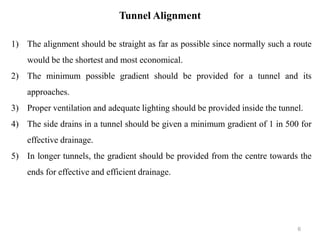

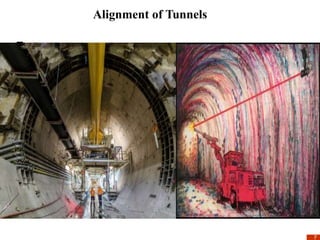

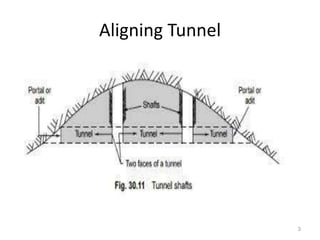

6. Tunnel Alignment
1) The alignment should be straight as far as possible since normally such a route
would be the shortest and most economical.
2) The minimum possible gradient should be provided for a tunnel and its
approaches.

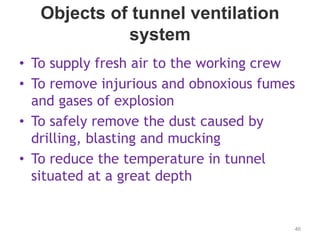

3) Proper ventilation and adequate lighting should be provided inside the tunnel.

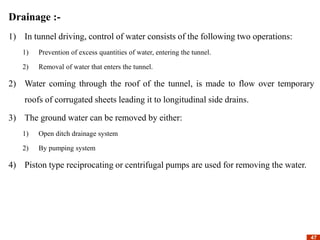

4) The side drains in a tunnel should be given a minimum gradient of 1 in 500 for
effective drainage.
5) In longer tunnels, the gradient should be provided from the centre towards the
ends for effective and efficient drainage.
6
8. 8

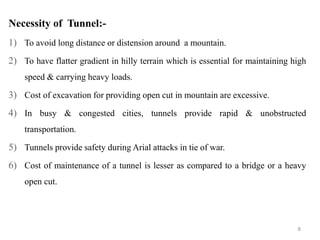

Necessity of Tunnel:-
1) To avoid long distance or distension around a mountain.
2) To have flatter gradient in hilly terrain which is essential for maintaining high
speed & carrying heavy loads.
3) Cost of excavation for providing open cut in mountain are excessive.
4) In busy & congested cities, tunnels provide rapid & unobstructed
transportation.
5) Tunnels provide safety during Arial attacks in tie of war.
6) Cost of maintenance of a tunnel is lesser as compared to a bridge or a heavy
open cut.
9. 9

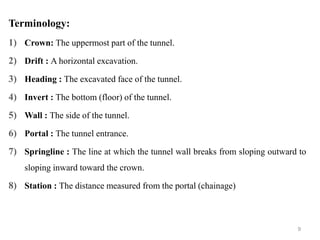

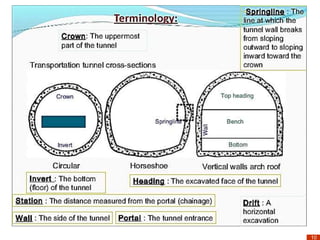

Terminology:
1) Crown: The uppermost part of the tunnel.
2) Drift : A horizontal excavation.
3) Heading : The excavated face of the tunnel.
4) Invert : The bottom (floor) of the tunnel.
5) Wall : The side of the tunnel.
6) Portal : The tunnel entrance.
7) Springline : The line at which the tunnel wall breaks from sloping outward to
sloping inward toward the crown.
8) Station : The distance measured from the portal (chainage)
22. 22
22

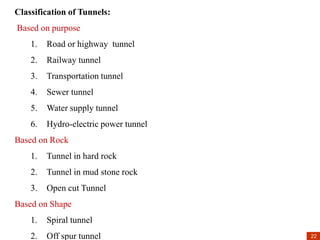

Classification of Tunnels:
Based on purpose
1. Road or highway tunnel
2. Railway tunnel
3. Transportation tunnel
4. Sewer tunnel
5. Water supply tunnel
6. Hydro-electric power tunnel
Based on Rock
1. Tunnel in hard rock
2. Tunnel in mud stone rock
3. Open cut Tunnel
Based on Shape
1. Spiral tunnel
2. Off spur tunnel
23. 23
23
Steps involved in tunnelling in hard rock:
1. Marking tunnel profile
2. Setting up & drilling
3. Loading explosive and blasting
4. Removing foul gases
5. Checking misfire
6. Scaling
7. Mucking & Guniting
8. Erecting supports.
(sequence of tunnelling)
24. Full Face Method :
1) The full face method is normally selected for small tunnels whose dimensions
do not exceed 3 m.
2) In this method, the full face or the entire façade (front) of the tunnel is tackled at
the same time.
3) Vertical columns are erected at the face of the tunnel and a large number of drills
mounted or fixed on these columns at a suitable height as shown in Fig.
4) A series of holes measuring 10 mm to 40 mm in diameter with about 1200 mm
centre-to-centre distance are then drilled into the rock.
24
24

25. Advantages of Full Face Method:
a. Since an entire section of the tunnel is tackled at one time, the method is
completed expeditiously.
b. Mucking tracks, which are tracks used for collecting muck, can be laid on
the tunnel floor and extended as the work progresses.
c. With the development of the ‘jumbo’ or drill carriage, this method can be
used for larger tunnels too.
Disadvantages:
a. The method requires heavy mechanical equipment.
b. It is not very suitable for unstable rocks.
c. It can normally be adopted for small tunnels only.
25
26. 26
26

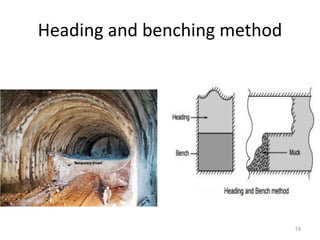

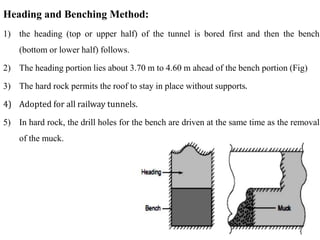

Heading and Benching Method:
1) the heading (top or upper half) of the tunnel is bored first and then the bench
(bottom or lower half) follows.
2) The heading portion lies about 3.70 m to 4.60 m ahead of the bench portion (Fig)
3) The hard rock permits the roof to stay in place without supports.
4) Adopted for all railway tunnels.
5) In hard rock, the drill holes for the bench are driven at the same time as the removal
of the muck.
27. 27

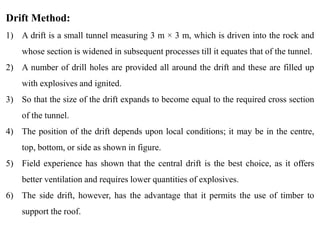

Drift Method:
1) A drift is a small tunnel measuring 3 m × 3 m, which is driven into the rock and
whose section is widened in subsequent processes till it equates that of the tunnel.
2) A number of drill holes are provided all around the drift and these are filled up
with explosives and ignited.
3) So that the size of the drift expands to become equal to the required cross section
of the tunnel.

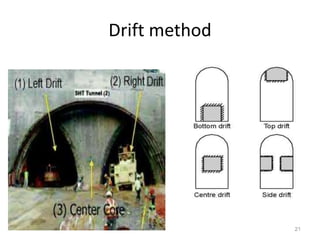

4) The position of the drift depends upon local conditions; it may be in the centre,
top, bottom, or side as shown in figure.
5) Field experience has shown that the central drift is the best choice, as it offers
better ventilation and requires lower quantities of explosives.
6) The side drift, however, has the advantage that it permits the use of timber to
support the roof.

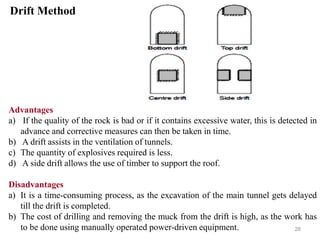

28. 28
Drift Method
Advantages
a) If the quality of the rock is bad or if it contains excessive water, this is detected in
advance and corrective measures can then be taken in time.
b) A drift assists in the ventilation of tunnels.
c) The quantity of explosives required is less.
d) A side drift allows the use of timber to support the roof.
Disadvantages
a) It is a time-consuming process, as the excavation of the main tunnel gets delayed
till the drift is completed.
b) The cost of drilling and removing the muck from the drift is high, as the work has
to be done using manually operated power-driven equipment.
29. 29

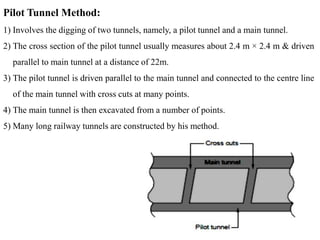

Pilot Tunnel Method:
1) Involves the digging of two tunnels, namely, a pilot tunnel and a main tunnel.
2) The cross section of the pilot tunnel usually measures about 2.4 m × 2.4 m & driven
parallel to main tunnel at a distance of 22m.
3) The pilot tunnel is driven parallel to the main tunnel and connected to the centre line
of the main tunnel with cross cuts at many points.
4) The main tunnel is then excavated from a number of points.
5) Many long railway tunnels are constructed by his method.
30. 30
Perimeter Method:
1) Excavation is done along the perimeter in order of stages no. 1,2,3,4 & 5.
2) This method is also known as German method.
31. 31
31

Tunnelling Through Soft Ground:
1) Compressed Method
2) Forepoling Method

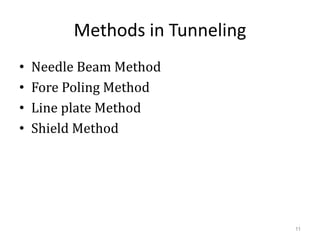

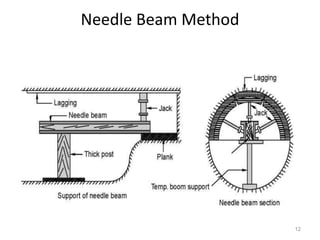

3) Needle Beam Method
4) Five Piece Set Method

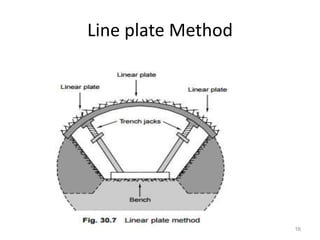

5) Liner Plates Methods
6) Other Methods
1) American Method
2) English Method
3) German Method
4) Austrian Method
5) Italian Method
6) Belgian Method
7) Army Method
8) Shield Method
32. 32
32

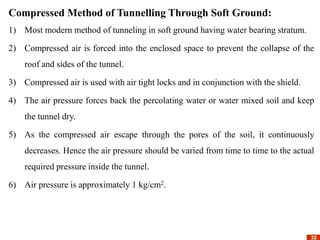

Compressed Method of Tunnelling Through Soft Ground:
1) Most modern method of tunneling in soft ground having water bearing stratum.
2) Compressed air is forced into the enclosed space to prevent the collapse of the
roof and sides of the tunnel.
3) Compressed air is used with air tight locks and in conjunction with the shield.
4) The air pressure forces back the percolating water or water mixed soil and keep
the tunnel dry.
5) As the compressed air escape through the pores of the soil, it continuously
decreases. Hence the air pressure should be varied from time to time to the actual
required pressure inside the tunnel.
6) Air pressure is approximately 1 kg/cm2.
33. 33
33

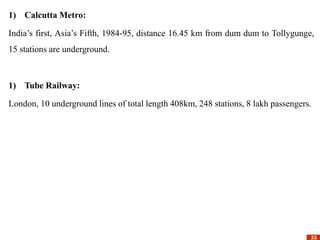

1) Calcutta Metro:
India’s first, Asia’s Fifth, 1984-95, distance 16.45 km from dum dum to Tollygunge,
15 stations are underground.
1) Tube Railway:
London, 10 underground lines of total length 408km, 248 stations, 8 lakh passengers.
34. 34
34

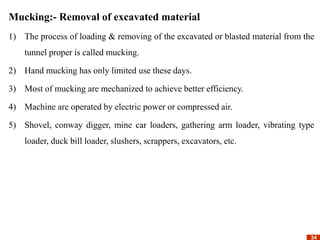

Mucking:- Removal of excavated material
1) The process of loading & removing of the excavated or blasted material from the
tunnel proper is called mucking.
2) Hand mucking has only limited use these days.
3) Most of mucking are mechanized to achieve better efficiency.
4) Machine are operated by electric power or compressed air.
5) Shovel, conway digger, mine car loaders, gathering arm loader, vibrating type
loader, duck bill loader, slushers, scrappers, excavators, etc.
36. 36
36

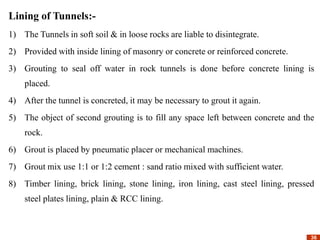

Lining of Tunnels:-
1) The Tunnels in soft soil & in loose rocks are liable to disintegrate.
2) Provided with inside lining of masonry or concrete or reinforced concrete.
3) Grouting to seal off water in rock tunnels is done before concrete lining is
placed.
4) After the tunnel is concreted, it may be necessary to grout it again.
5) The object of second grouting is to fill any space left between concrete and the
rock.
6) Grout is placed by pneumatic placer or mechanical machines.
7) Grout mix use 1:1 or 1:2 cement : sand ratio mixed with sufficient water.
8) Timber lining, brick lining, stone lining, iron lining, cast steel lining, pressed
steel plates lining, plain & RCC lining.
37. Linning of Tunnel
37
The tunnel lining definition means the finishing
touch given to the cross-section of a Tunnel.

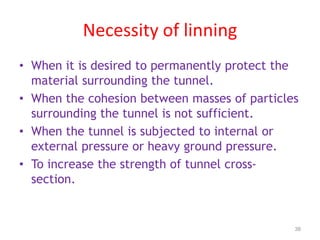

38. Necessity of linning
• When it is desired to permanently protect the
material surrounding the tunnel.
• When the cohesion between masses of particles
surrounding the tunnel is not sufficient.
• When the tunnel is subjected to internal or
external pressure or heavy ground pressure.
• To increase the strength of tunnel cross-
section.
38
39. Materials used for tunnel lining
1.Brick and stone masonry
2.Cement mortar
3.Timber
4.Cast iron
39
44. 44
44

Ventilation :-
1) The use of drilling machine, detonators, large explosive charges, loading
machine, dust etc. require the provision of an efficient system for ventilation in
view of the large number of men working at the tunnel face.
2) The most efficient ventilation system relies upon a combination of blower &
exhaust fan.
3) Immediately after blasting, exhaust system is used for 15 to 30 min. to draw
smoke & dust.
4) For rest of the working time, fans are reversed for blowing in fresh air.
46. Objects of tunnel ventilation
system
• To supply fresh air to the working crew
• To remove injurious and obnoxious fumes
and gases of explosion
• To safely remove the dust caused by
drilling, blasting and mucking
• To reduce the temperature in tunnel
situated at a great depth
46
47. 47
47

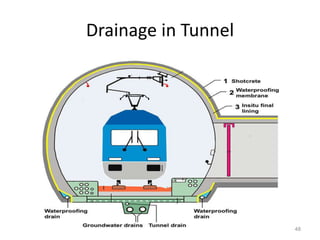

Drainage :-
1) In tunnel driving, control of water consists of the following two operations:
1) Prevention of excess quantities of water, entering the tunnel.
2) Removal of water that enters the tunnel.
2) Water coming through the roof of the tunnel, is made to flow over temporary
roofs of corrugated sheets leading it to longitudinal side drains.
3) The ground water can be removed by either:
1) Open ditch drainage system
2) By pumping system
4) Piston type reciprocating or centrifugal pumps are used for removing the water.
49. 49
49

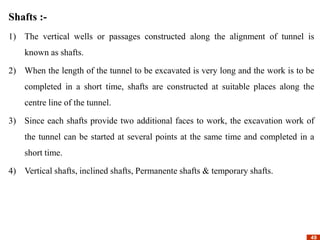

Shafts :-
1) The vertical wells or passages constructed along the alignment of tunnel is
known as shafts.
2) When the length of the tunnel to be excavated is very long and the work is to be
completed in a short time, shafts are constructed at suitable places along the
centre line of the tunnel.
3) Since each shafts provide two additional faces to work, the excavation work of
the tunnel can be started at several points at the same time and completed in a
short time.
4) Vertical shafts, inclined shafts, Permanente shafts & temporary shafts.
50. 50
50

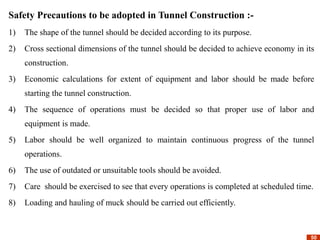

Safety Precautions to be adopted in Tunnel Construction :-
1) The shape of the tunnel should be decided according to its purpose.
2) Cross sectional dimensions of the tunnel should be decided to achieve economy in its
construction.
3) Economic calculations for extent of equipment and labor should be made before
starting the tunnel construction.
4) The sequence of operations must be decided so that proper use of labor and
equipment is made.
5) Labor should be well organized to maintain continuous progress of the tunnel
operations.

6) The use of outdated or unsuitable tools should be avoided.
7) Care should be exercised to see that every operations is completed at scheduled time.
8) Loading and hauling of muck should be carried out efficiently.
52. 52
52
Commonly used shaped of the tunnel :-
1) Circular
2) Horse shoe
3) Rectangular
4) Elliptical
5) Egg shaped
6) Segmental roof section
53. 53
53

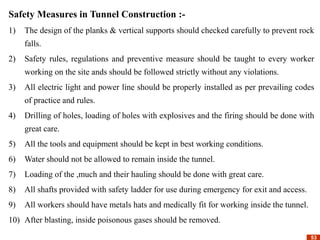

Safety Measures in Tunnel Construction :-
1) The design of the planks & vertical supports should checked carefully to prevent rock
falls.
2) Safety rules, regulations and preventive measure should be taught to every worker
working on the site ands should be followed strictly without any violations.
3) All electric light and power line should be properly installed as per prevailing codes
of practice and rules.
4) Drilling of holes, loading of holes with explosives and the firing should be done with
great care.
5) All the tools and equipment should be kept in best working conditions.
6) Water should not be allowed to remain inside the tunnel.
7) Loading of the ,much and their hauling should be done with great care.
8) All shafts provided with safety ladder for use during emergency for exit and access.
9) All workers should have metals hats and medically fit for working inside the tunnel.
10) After blasting, inside poisonous gases should be removed.
54. Maintenance of tunnel
54
•Water Inflow
•Joint Damage
•Scaling and spalling at the surface
•Deformations (side walls, crown)
•Surface deposits and discoloration
•Cavities behind lining
55. 55

•Accumulation of water in invert
•Cracking
•Exposed reinforcement / Corroded
reinforcement
•Weathered surfaces
•Honeycombing
•Deposits in drainage system, drain
clogging
