Index Introduction: why accelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)

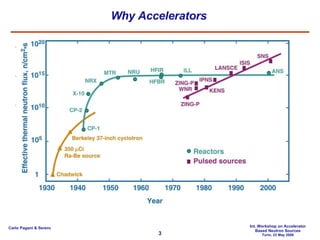

Why Accelerators Easily pulsed beams No chain reactions Very high typical fluxes A 1 mA beam delivers to the target 6·10 15  particles per second
Accelerators and Neutrons The accelerator A particle accelerator is delivering energy to the beam via a rotational electric field acting on the charged particles. Depending on the reaction chosen for neutron production, either proton or deutons are accelerated (high intensity simple particles with maximum charge to mass ratio). Superconducting accelerators are preferred for their higher efficiency in the power conversion from plug to beam.

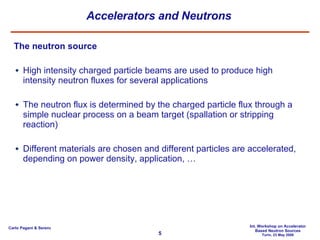

Accelerators and Neutrons The neutron source High intensity charged particle beams are used to produce high intensity neutron fluxes for several applications The neutron flux is determined by the charged particle flux through a simple nuclear process on a beam target (spallation or stripping reaction) Different materials are chosen and different particles are accelerated, depending on power density, application, …

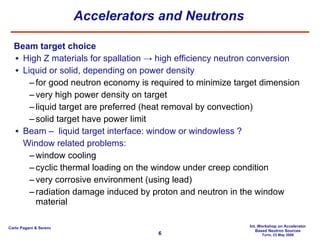

Accelerators and Neutrons Beam target choice High Z materials for spallation -> high efficiency neutron conversion Liquid or solid, depending on power density for good neutron economy is required to minimize target dimension very high power density on target liquid target are preferred (heat removal by convection) solid target have power limit Beam –  liquid target interface: window or windowless ?  Window related problems: window cooling cyclic thermal loading on the window under creep condition very corrosive environment (using lead) radiation damage induced by proton and neutron in the window material
Neutron generation 1/3 Spallation reaction An heavy metal target hit by a high energy proton generates neutrons proton ~1 GeV  ->  20 - 30 neutrons Characteristics : High conversion factor neutrons/protons Wide neutron energy spectrum For high neutron production efficiency, required high energy proton beam

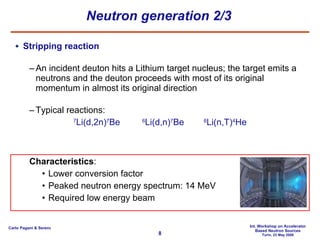

Neutron generation 2/3 Stripping reaction An incident deuton hits a Lithium target nucleus; the target emits a neutrons and the deuton proceeds with most of its original momentum in almost its original direction Typical reactions: 7 Li(d,2n) 7 Be   6 Li(d,n) 7 Be   6 Li(n,T) 4 He Characteristics : Lower conversion factor Peaked neutron energy spectrum: 14 MeV Required low energy beam

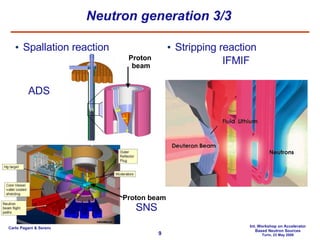

Spallation reaction ADS   SNS Neutron generation 3/3 Stripping reaction IFMIF Proton beam Proton beam
Applications 1/3 Nuclear fusion (IFMIF) Fusion reactors will produce high neutron fluxes at 14 MeV This will bring to high material irradiation To guarantee reactor operation, required materials with: ITER: 3 dpa/lifetime DEMO: > 20 dpa/year Required a material test facility for material verifications

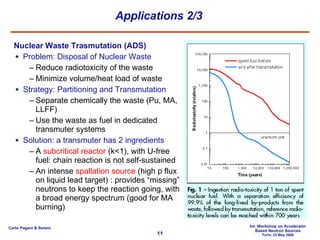

Applications 2/3 Nuclear Waste Trasmutation (ADS) Problem: Disposal of Nuclear Waste Reduce radiotoxicity of the waste Minimize volume/heat load of waste Strategy: Partitioning and Transmutation Separate chemically the waste (Pu, MA, LLFF) Use the waste as fuel in dedicated transmuter systems Solution: a transmuter has 2 ingredients A  subcritical reactor  (k<1), with U-free fuel: chain reaction is not self-sustained An intense  spallation source  (high p flux on liquid lead target) : provides “missing” neutrons to keep the reaction going, with a broad energy spectrum (good for MA burning)

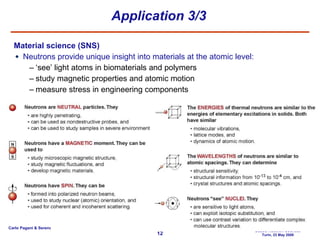

Application 3/3 Material science (SNS) Neutrons provide unique insight into materials at the atomic level: ‘ see’ light atoms in biomaterials and polymers study magnetic properties and atomic motion measure stress in engineering components

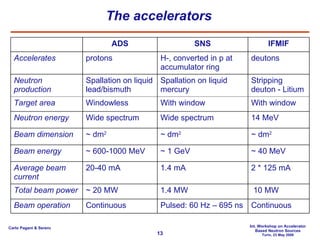

The accelerators ~ dm 2 ~ dm 2 ~ dm 2 Beam dimension 14 MeV Wide spectrum Wide spectrum Neutron energy 10 MW 1.4 MW ~ 20 MW Total beam power 2 * 125 mA 1.4 mA 20-40 mA Average beam current Continuous Pulsed: 60 Hz – 695 ns Continuous Beam operation Stripping deuton - Litium Spallation on liquid mercury Spallation on liquid lead/bismuth Neutron production deutons H-, converted in p at accumulator ring protons Accelerates With window With window Windowless Target area ~ 40 MeV ~ 1 GeV ~ 600-1000 MeV Beam energy IFMIF SNS ADS
Index Introduction: why accelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
Particle Accelerators The name Particle Accelerator is a historical one  connected to the concept of an energy increase related to a velocity change, that is an acceleration.  For  protons and ions  that has been the case for a while: Electrostatic accelerators Linacs Cyclotrons Synchrotron concept and strong focusing  scheme pushed energies to e level where the Energy increase is dominated by the particle mass increase and the  velocity  is  very close to the speed of light.

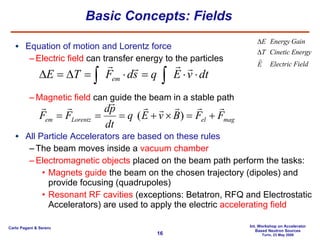

Basic Concepts: Fields Equation of motion and Lorentz force Electric field  can transfer energy to the particles Magnetic field  can guide the beam in a stable path All Particle Accelerators are based on these rules The beam moves inside a  vacuum chamber Electromagnetic objects  placed on the beam path perform the tasks: Magnets guide  the beam on the chosen trajectory (dipoles) and provide focusing (quadrupoles) Resonant RF cavities  (exceptions: Betatron, RFQ and Electrostatic Accelerators) are used to apply the electric  accelerating field

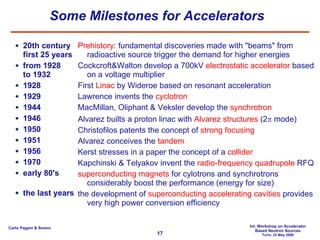

Some Milestones for Accelerators  20th century first 25 years from 1928 to 1932 1928  1929 1944 1946 1950 1951  1956 1970 early 80's the last years Prehistory : fundamental discoveries made with &quot;beams&quot; from radioactive source trigger the demand for higher energies Cockcroft&Walton develop a 700kV  electrostatic accelerator  based on a voltage multiplier First  Linac  by Wideroe based on resonant acceleration Lawrence invents the  cyclotron MacMillan, Oliphant & Veksler develop the  synchrotron Alvarez builts a proton linac with  Alvarez structures  (2   mode) Christofilos patents the concept of  strong focusing Alvarez conceives the  tandem Kerst stresses in a paper the concept of a  collider Kapchinski & Telyakov invent the  radio-frequency quadrupole  RFQ superconducting magnets  for cylotrons and synchrotrons considerably boost the performance (energy for size) the development of  superconducting accelerating cavities  provides very high power conversion efficiency

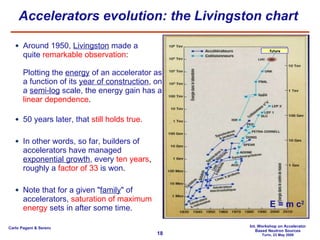

Accelerators evolution: the Livingston chart  Around 1950,  Livingston  made a  quite   remarkable observation : Plotting the  energy  of an accelerator as a function of its  year of construction , on a  semi-log  scale, the energy gain has a   linear dependence . 50 years later, that   still holds true.  In other words, so far, builders of accelerators have managed  exponential growth , every   ten years ,  roughly a   factor of 33   is won . Note that for a given &quot; family &quot; of accelerators,   saturation of maximum energy   sets in after some time. future E = m c 2
An  RF source  generates an  electric field  in a region of a resonant metallic structure; the  particles  of the beam need to be  localized in   bunches  and  properly phased  with respect to the field so that the beam is “accelerated” Two  possible  designs : NC  Travelling wave structures SC  Standing wave cavities Linac RF acceleration concept Traveling wave V ph  ≈ c   and  Vg < c   Standing wave V ph  = 0  and  Vg = c      mode bunches Electric field
RF Linac Overview Particle Source Linac structure : Acceleration (cavities) Transverse focusing (magnets) Electric power Vacuum Cooling RF power and controls Output beam   (experiments,  users,  applications ...) Subsystems SNS - ORNL TTF - DESY

Energy gain and dissipated power To accelerate particles efficiently,   very high electric field   is required   In any structure (cavity) holding an electromagnetic field, both   dissipated power and stored energy scale quadratically   with the fields   The   efficiency of a cavity  depends from: Its quality factor,  Q driven by the surface resistance,  R s Its shunt impedance,  r function of the cavity geometry and of the surface resistance,  R s For efficient acceleration  Q, r  and  r/Q  must all be  as high as possible U is the energy stored in the cavity  P diss  is the power dissipated on its surface Δ V is the voltage seen by the beam “ r over Q ” is purely  a geometrical factor Good material  for maximum Q and r  (that is minimum P diss ) Good design  for maximum r/Q L R C
Why Superconductivity in RF linacs? In normal conducting linac a  huge amount of power  is deposited in the copper structure, in the form of  heat , that needs to be  removed by water cooling  (in order not to melt the structures) Dissipated power can be much higher than the power transferred into the beam for acceleration Superconductivity , at the expenses of higher complexity, drastically  reduces the dissipated power  and the cavities transfer more efficiently the RF power to the beam In short: NC linac: lower capital cost, but high operational cost SC linac: slightly higher capital cost, but low operational cost
Superconductivity whenever possible  For a good but  not perfect conductor  ( ρ   ≠  0) , the  fields and currents penetrate  into the conductor in a  small layer  at the cavity surface (the skin depth ,  δ ) With RF fields, a SC cavity dissipate power, not all electrons are in Cooper pairs. In NC linac a huge amount of power is deposited in the copper structure: MW to have MV Pulsed operation and Low Duty Cycle SC SuperConducting NC   or RT NormalConducting Nb Cu
Superconductivity whenever possible  Superconductivity,  drastically reduces the dissipated power.  But some  drawbacks Higher complexity : refrigeration  and cryomodules Carnot and  refrigeration  plant  efficiencies Higher technology : cavity treatments Simpler geometries:  lower shunt impedance And two big  advantages: Large bore radius : less beam losses CW  or  high duty cicle  preferred

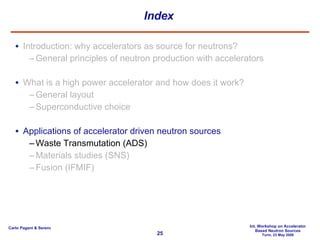

Index Introduction: why accelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
ADS proton beam requirements Very high duty cycle, possibly CW  Energy of the order of 1 GeV, determined by neutron production rate per GeV  and per proton (optimum value reached at ~1 GeV) energy dissipated in the input window (rapidly decreasing with energy,  when E<few GeV) beam power from several MW up to tens of MW few MW for a “demo” plant of ~100 MWth ~20 MW for an industrial burner of ~1500 MWth Very few beam trips per year accepted if longer then 1 second No limitation for very short beam trips: << 1 second
The proton linacs
Linac or cyclotron 1/2 Most powerful CW proton accelerators (MW-size facilities) Linacs LAMPF/LANSCE (~1970) 800 MeV 1 mA H +  average current  Peak H +  current 16.5 mA @ 100 Hz and 625   s pulse length NC  accelerator Cyclotrons PSI – separated sector (1974) Original design was for 100   A From 72 to 590 MeV ~2 mA average current Beam losses at extraction < 1   A
Linac or cyclotron 2/2 Cyclotron No remarkable R&D programs Its cost scales quadratically with the output energy Very high reliability and availability at PSI, but further improvement looks very difficult Not applicables concepts of redundancy and spare on line Linear Accelerator A  worldwide R&D effort is in progress High potentiality of these machines has been proven: Sources, RFQs and SRF technology successfully operated cost per MeV is decreasing with energy Linac (except front end) has intrinsic modularity: Easy redundant and “spares on line” design

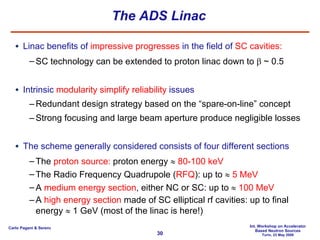

The ADS Linac Linac benefits of  impressive progresses  in the field of  SC cavities: SC technology can be extended to proton linac down to   ~ 0.5 Intrinsic  modularity   simplify reliability  issues Redundant design strategy based on the “spare-on-line” concept Strong focusing and large beam aperture produce negligible losses  The scheme generally considered consists of four different sections The  proton source:  proton energy     80-100 keV The Radio Frequency Quadrupole ( RFQ ): up to     5 MeV A  medium energy section , either NC or SC: up to     100 MeV A  high energy section  made of SC elliptical rf cavities: up to final energy    1 GeV (most of the linac is here!)

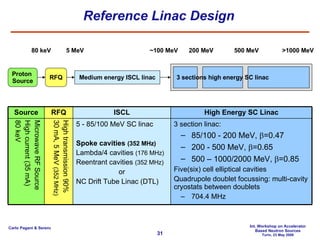

Reference Linac Design Proton  Source RFQ Medium energy ISCL linac 3 sections high energy SC linac 80 keV 5 MeV ~ 100 MeV 200 MeV 500 MeV >1000 MeV 3 section linac: 85/100  -  20 0 MeV,   =0. 47 20 0   -  50 0 MeV,   =0.65 50 0   –   1 0 00 /2000  MeV,   =0.8 5 Five (six)  cell  elliptical  cavities Quadrupole doublet focussing: multi - cavity cryostats between doublets 704.4 MHz 5   -  85/100  MeV SC linac Spoke cavities   (352 MHz) Lambda/4 cavities  (176 MHz) Reentrant cavities   (352 MHz) or NC Drift Tube Linac (DTL)  High transmission 90% 30 mA, 5 MeV   (352 MHz) Microwave  RF Source High current (3 5  mA) 80  keV High Energy  SC  Linac ISCL RFQ Source
Linac Design Accelerator design performed in the EU PDS-XADS program (5° FWP) Choice of superconducting linac Modular: same concept for Prototype and Industrial scale

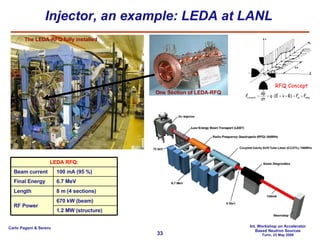

Injector, an example: LEDA at LANL RFQ Concept 1.2 MW (structure) 670 kW (beam) RF Power 8 m (4 sections) Length 6.7 MeV Final Energy 100 mA (95 %) Beam current LEDA RFQ: One Section of LEDA-RFQ The LEDA-RFQ fully installed
High energy section: the test module  Elliptical   =0.47 cavities have been produced, vertically tested and will be equipped to be tested in an horizontal test module by INFN - LASA
The Reliability Issue The small number (few per year) of beam trips allowed during the accelerator operation, requires a  detailed analysis of the accelerator availability and reliability , much deeper that in the past applications  The reliability analysis of a complex system is an  iterative process , which starts from a preliminary design of the whole system and its components and is followed by the development of the Reliability Block Diagram (RBD).
Some Remarks  on  Linac  Reliability In order to meet the # of stops > 1 s The beam startup procedure for a multi MW beam will be certainly  > 1 s operation with faulty components needs to be achieved  Linac must tolerate single failures of most of components Procedures for “adjusting” beam transport and repairing of components without interrupting the beam while marinating acceptable losses As a consequence Components and subsystems divided in two major categories if they lead to: Failures requiring a beam stop Failures that can be repaired while the beam is on, or later… As general rules Components falling in the first category should have the highest reliability Typically passive components overdesigned and overtested  Components falling in the second category should have the highest accessibility for repairing or substitution For example, this suggest the choice of a double tunnel design, with most of ancillaries situated in a free-access tunnel (Power supplies, RF generators, etc.)
Index Introduction: why accelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
SNS Guiding Principles SNS will provide  high availability, high reliability  operation of the world’s most powerful  pulsed neutron source Research conducted at SNS will be at the  forefront of biology, chemistry, physics, materials science and engineering SNS will be able to provide  cold neutrons  (useful for research on polymers and proteins) SNS expects 1000-2000  users  per year from  academia, government, and industry Flexible instrument strategy  that supports both general user access and dedicated access for expert instrument teams that contribute to construction and operation of instruments

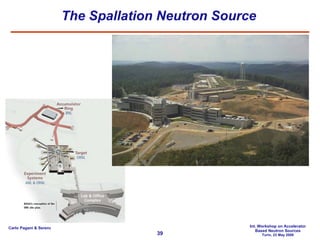

The Spallation Neutron Source
Neutron generation H-  ions are produced in the front end  ion source H-  are  accelerated to ~1GeV  in Linac (NC and SC) On injection into ring  2x e- are stripped to form p Protons  are accumulated and  compressed into a 1 µs  pulse width in the ring (~120 turns of the ring, p are traveling at ~0.9c) A  kicker magnet   knocks the proton  pulse out of the ring orbit into the beamline that takes the p’s to the  Hg target Beam losses  need to be preserved below 1 W/m along the whole machine and beamlines to limit activation
Power Ramp-up Progress “We are starting to get to real beam power levels” 160 KW: ISIS Power Record
Beam Target and Neutron Moderation Spallation target Mercury was chosen for the target for several reasons it is not damaged by radiation, as are solids it has a high atomic number, making it a source of numerous neutrons (the average mercury nucleus has 120 neutrons and 80 protons) because it is liquid at room temperature, it is better able than a solid target to dissipate the large, rapid rise in temperature and withstand the shock effects arising from the rapid high-energy pulses Neutron moderation The neutrons coming out of the target must be turned into low-energy neutrons suitable for research moderated to room temperature or colder passing them through cells filled with water (to produce room-temperature neutrons) or through containers of liquid hydrogen at a temperature of 20 K (to produce cold neutrons) The moderators are located above and below the target

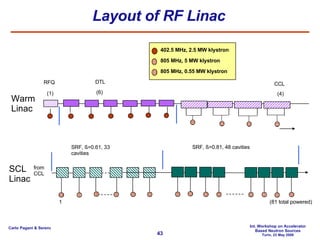

Layout of RF Linac 805 MHz, 0.55 MW klystron 805 MHz, 5 MW   klystron 402.5 MHz, 2.5 MW klystron SRF, ß=0.61, 33 cavities 1 from  CCL 186 MeV 86.8 MeV 2.5  MeV RFQ (1) DTL (6) CCL (4) SRF, ß=0.81, 48 cavities 1000  MeV (81 total powered) 379 MeV Warm Linac SCL Linac

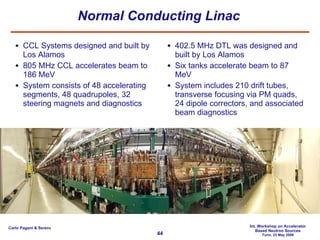

Normal Conducting Linac CCL Systems designed and built by Los Alamos  805 MHz CCL accelerates beam to 186 MeV  System consists of 48 accelerating segments, 48 quadrupoles, 32 steering magnets and diagnostics 402.5 MHz DTL was designed and built by Los Alamos  Six tanks accelerate beam to 87 MeV System includes 210 drift tubes, transverse focusing via PM quads, 24 dipole correctors, and associated beam diagnostics

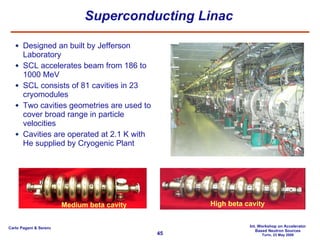

Superconducting Linac Designed an built by Jefferson Laboratory SCL accelerates beam from 186 to 1000 MeV SCL consists of 81 cavities in 23 cryomodules Two cavities geometries are used to cover broad range in particle velocities Cavities are operated at 2.1 K with He supplied by Cryogenic Plant Medium beta cavity High beta cavity
Others SNS Parameters Protons per pulse on target 1.5x10 14  protons  Energy per pulse on target 24 kJ  Average linac macropulse H- current 26 mA  Linac beam macropulse duty factor 6% Front end length 7.5 m  Linac length 331 m  HEBT length 170 m  Ring circumference 248 m  RTBT length 150 m  Ion type (Ring, RTBT, Target) proton  Ring filling time 1.0 ms  Ring revolution frequency 1.058 MHz  Number of injected turns 1060  Ring filling fraction 68%  Ring extraction beam gap 250 ns  Maximum uncontrolled beam loss  1 W/m  Number of ambient / cold moderators 1/3  Number of neutron beam shutters 18
SNS Instruments

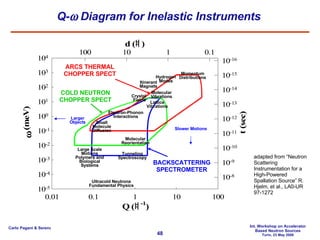

Q-   Diagram for Inelastic Instruments adapted from “Neutron Scattering Instrumentation for a High-Powered Spallation Source” R. Hjelm, et al., LA0-UR 97-1272 Momentum Distributions Itinerant Magnets Crystal  Fields Molecular Vibrations Lattice Vibrations Small Molecule Diffusion Large Scale Motions Polymers and Biological Systems Tunneling Spectroscopy Electron-Phonon Interactions Hydrogen Modes Molecular Reorientation Ultracold Neutrons Fundamental Physics Slower Motions Larger Objects ARCS THERMAL CHOPPER SPECT COLD NEUTRON CHOPPER SPECT BACKSCATTERING SPECTROMETER
SNS Reflectometers R min < 5×10 -10 Q max  ~ 1.5 Å -1  (Liquids)   ~ 7 Å -1  (Magnetism) d min ~ 7 Å 50-100× NIST NG-1 Magnetism: vertical sample Liquids: horizontal sample
Diffraction Highest flux a short wavelengths is crucial for studies of local disorder in complex materials Nanoscale Ordered Materials Diffractometer (NOMAD)
High Pressure Cells Limit Sample Volume Pressure cell of the type to be employed on SNAP (Spallation Neutrons and Pressure) beamline
Index Introduction: why accelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)

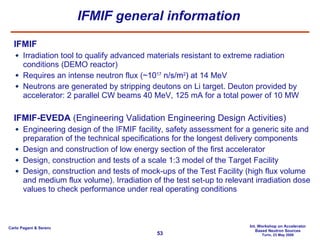

IFMIF general information IFMIF Irradiation tool to qualify advanced materials resistant to extreme radiation conditions (DEMO reactor) Requires an intense neutron flux (~ 10 17  n/s/m 2 ) at  14 MeV Neutrons are generated by stripping deutons on Li target. Deuton provided by accelerator: 2 parallel CW beams 40 MeV, 125 mA for a total power of 10 MW IFMIF-EVEDA  (Engineering Validation Engineering Design Activities) Engineering design of the IFMIF facility, safety assessment for a generic site and preparation of the technical specifications for the longest delivery components Design and construction of low energy section of the first accelerator Design, construction and tests of a scale 1:3 model of the Target Facility Design, construction and tests of mock-ups of the Test Facility (high flux volume and medium flux volume). Irradiation of the test set-up to relevant irradiation dose values to check performance under real operating conditions
ITER 3 dpa/lifetime IFMIF 20-55 dpa/year Plasma Facing Materials Structural Materials Functional Materials Advanced Materials are at a critical path DEMO 30 dpa/year
IFMIF Main Objectives Neutron  flux :  10 MW deuton beam power on the test module is equivalent to 1 MW/m 2  neutron beam 4.5 10 17  n/m 2 /s 3 10 -7  dpa/s for Fe Neutron  spectrum :  fit to probable DEMO first wall Neutron fluence  accumulation : DEMO relevant (150 dpa/few years) Neutron flux  gradient : about 10 % in volume Machine  availability : 70 % (quasi continuous operation) Good accessibility of irradiation volume for experimentation and instrumentation neutron flux coolant flow (He) 200 50 50 [mm]
IFMIF Principles RFQ HWR HEBT Typical reactions 7 Li(d,2n) 7 Be 6 Li(d,n) 7 Be 6 Li(n,T) 4 He Source Accelerator (x 2) Test Cell Low flux (< 1 dpa/an, > 8 L) Medium flux (20 – 1 dpa/an, 6 L) Lithium target High flux (> 20 dpa/an, 0.5 L)
IFMIF “Artist View” Ion Source RF Quadrupole Post Irradiation Experiment Facilities High Energy Beam Transport Li Target Li Loop Test Modules inside Test Cells Half-wave resonators  0  20  40 m
IFMIF Accelerator A high intensity ion source, delivers a beam of deutons of 140 mA to 100 keV A RFQ (Radio Frequency Quadrupole) cavity put « in packages » and accelerate the deutons until a 5 MeV energy Elements of linear accelerator to reach the final energy (10 MeV at EVEDA, 40 MeV at IFMIF) A transport line up to the beam stop of 1,2 MW for EVEDA phase and up to the liquid lithium target of 10 MW for IFMIF

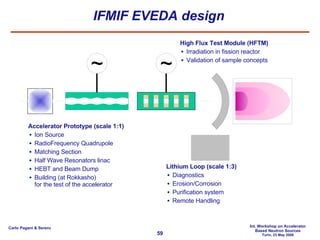

IFMIF EVEDA design Accelerator Prototype (scale 1:1) Ion Source RadioFrequency Quadrupole Matching Section Half Wave Resonators linac HEBT and Beam Dump Building (at Rokkasho) for the test of the accelerator Lithium Loop (scale 1:3) Diagnostics Erosion/Corrosion Purification system Remote Handling High Flux Test Module (HFTM) Irradiation in fission reactor Validation of sample concepts ~ ~

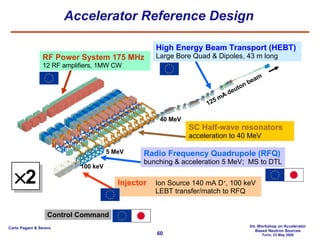

Accelerator Reference Design High Energy Beam Transport (HEBT) Large Bore Quad & Dipoles, 43 m long SC Half-wave resonators acceleration to 40 MeV Radio Frequency Quadrupole (RFQ) bunching & acceleration 5 MeV;  MS to DTL RF Power System 175 MHz 12 RF amplifiers, 1MW CW 100 keV Injector Ion Source 140 mA D + , 100 keV LEBT transfer/match to RFQ 5 MeV 40 MeV 125 mA deuton beam Control Command  2

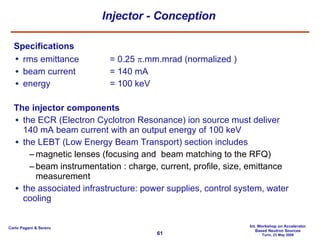

Injector - Conception Specifications rms emittance = 0.25   .mm.mrad (normalized ) beam current = 140 mA energy = 100 keV The injector components the ECR (Electron Cyclotron Resonance) ion source must deliver 140 mA beam current with an output energy of 100 keV the LEBT (Low Energy Beam Transport) section includes magnetic lenses (focusing and  beam matching to the RFQ) beam instrumentation : charge, current, profile, size, emittance measurement the associated infrastructure: power supplies, control system, water cooling

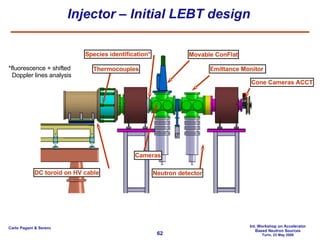

Injector – Initial LEBT design Cone Cameras ACCT Cameras Neutron detector Emittance Monitor  DC toroid on HV cable Movable ConFlat Species identification* Thermocouples *fluorescence + shifted   Doppler lines analysis

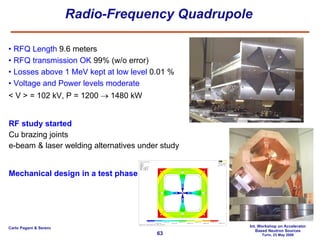

Radio-Frequency Quadrupole RFQ Length  9.6 meters RFQ transmission OK  99% (w/o error) Losses above 1 MeV kept at low level  0.01 % Voltage and Power levels moderate < V > = 102 kV, P = 1200    1480 kW RF study started Cu brazing joints e-beam & laser welding alternatives under study Mechanical design in a test phase
Old design: DTL and Matching Section 1st tank parameters Conventional Alvarez technology 1 RF coupler / tank RF Frequency 175 MHz Input energy 5.02 MeV Output energy 9.02 MeV Internal length 4.67 m Internal diameter 1.074 m Number of cells 33 Total power 680 kW Power dissipation 180 kW Efficiency 73.5 % Power coupler Stem-box Cover Tuning Slug Post Coupler Drift Tube  Stem Drift Tube To vacuum pump Bulk Tuner
Present design:  Half-wave resonators (HWR)  IFMIF/EVEDA Project Committee meeting (10-11 October 2007) Accelerator Facility Project Plan Superconducting solution: existing modules module double of the one currently operating at SOREQ    L~ 5 m group cavities in long cryostats and conservative gradients Take 175 MHz HWR with big aperture 8-10-12 6 4.5 MV/m 40-50 mm SC IFMIF 5.5 MV/m 30 mm SARAF* project
Lithium target Engineering design of the target system includes  thermal, thermo-structural and thermo-hydraulic analyses  of the target assembly, backplate, Li components, Li loop and purification system The Lithium circuit The Lithium target Quench Tank Deuteron Beams Li Target ( T 2.5 cm,  W 26 cm) EM Pump HX(Li / Organic Oil) Dump Tank (9 m 3 -Li) HX(Organic Oil / Water) 130 L/s, 250   C Cold Trap (220   C) N Hot Trap (600   C) T Hot Trap (250   C)

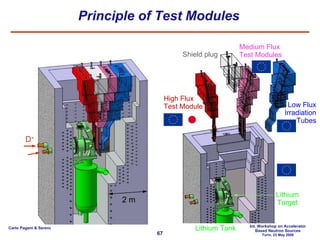

Principle of Test Modules 2 m D + Medium Flux Test Modules High Flux Test Module Low Flux Irradiation Tubes Lithium Target Lithium Tank Shield plug
Irradiation modules overview VIT MF-CF MF-LBV MF-TR Upper internal flange Upper reflector Lateral reflector 12 rigs Lower reflector Helium inlet duct Helium exit duct HFTM
IFMIF Medium Flux Test Module 3 independent samples in creep fatigue
Conclusions Present and future large facilities are based to a large extent on the superconducting  RF linac technology that has been pioneered for the High Energy Physics machines in the last decades LEP at CERN (e+e- collider with SRF cavities) CEBAF at TJNAF (recirculated SRF linac) TESLA and ILC (next generation linear colliders proposed for precision  physics in the Higgs sector after LHC discovery) SNS moved from NC design to SC after project approval and during construction Future facilities rely on SC linacs at even lower energies to benefit from SC technology

Serena barbanotti INFN milano

  • 1.
  • 2.
    Index Introduction: whyaccelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
  • 3.
    Why Accelerators Easilypulsed beams No chain reactions Very high typical fluxes A 1 mA beam delivers to the target 6·10 15 particles per second
  • 4.
    Accelerators and NeutronsThe accelerator A particle accelerator is delivering energy to the beam via a rotational electric field acting on the charged particles. Depending on the reaction chosen for neutron production, either proton or deutons are accelerated (high intensity simple particles with maximum charge to mass ratio). Superconducting accelerators are preferred for their higher efficiency in the power conversion from plug to beam.
  • 5.
    Accelerators and NeutronsThe neutron source High intensity charged particle beams are used to produce high intensity neutron fluxes for several applications The neutron flux is determined by the charged particle flux through a simple nuclear process on a beam target (spallation or stripping reaction) Different materials are chosen and different particles are accelerated, depending on power density, application, …
  • 6.
    Accelerators and NeutronsBeam target choice High Z materials for spallation -> high efficiency neutron conversion Liquid or solid, depending on power density for good neutron economy is required to minimize target dimension very high power density on target liquid target are preferred (heat removal by convection) solid target have power limit Beam – liquid target interface: window or windowless ? Window related problems: window cooling cyclic thermal loading on the window under creep condition very corrosive environment (using lead) radiation damage induced by proton and neutron in the window material
  • 7.

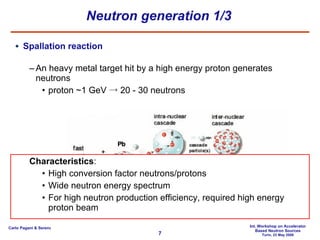

    Neutron generation 1/3Spallation reaction An heavy metal target hit by a high energy proton generates neutrons proton ~1 GeV -> 20 - 30 neutrons Characteristics : High conversion factor neutrons/protons Wide neutron energy spectrum For high neutron production efficiency, required high energy proton beam
  • 8.
    Neutron generation 2/3Stripping reaction An incident deuton hits a Lithium target nucleus; the target emits a neutrons and the deuton proceeds with most of its original momentum in almost its original direction Typical reactions: 7 Li(d,2n) 7 Be 6 Li(d,n) 7 Be 6 Li(n,T) 4 He Characteristics : Lower conversion factor Peaked neutron energy spectrum: 14 MeV Required low energy beam
  • 9.
    Spallation reaction ADS SNS Neutron generation 3/3 Stripping reaction IFMIF Proton beam Proton beam
  • 10.

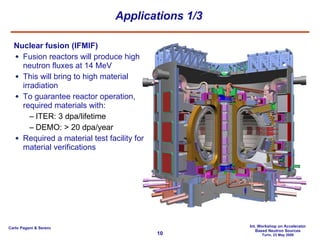

    Applications 1/3 Nuclearfusion (IFMIF) Fusion reactors will produce high neutron fluxes at 14 MeV This will bring to high material irradiation To guarantee reactor operation, required materials with: ITER: 3 dpa/lifetime DEMO: > 20 dpa/year Required a material test facility for material verifications
  • 11.
    Applications 2/3 NuclearWaste Trasmutation (ADS) Problem: Disposal of Nuclear Waste Reduce radiotoxicity of the waste Minimize volume/heat load of waste Strategy: Partitioning and Transmutation Separate chemically the waste (Pu, MA, LLFF) Use the waste as fuel in dedicated transmuter systems Solution: a transmuter has 2 ingredients A subcritical reactor (k<1), with U-free fuel: chain reaction is not self-sustained An intense spallation source (high p flux on liquid lead target) : provides “missing” neutrons to keep the reaction going, with a broad energy spectrum (good for MA burning)
  • 12.
    Application 3/3 Materialscience (SNS) Neutrons provide unique insight into materials at the atomic level: ‘ see’ light atoms in biomaterials and polymers study magnetic properties and atomic motion measure stress in engineering components
  • 13.
    The accelerators ~dm 2 ~ dm 2 ~ dm 2 Beam dimension 14 MeV Wide spectrum Wide spectrum Neutron energy 10 MW 1.4 MW ~ 20 MW Total beam power 2 * 125 mA 1.4 mA 20-40 mA Average beam current Continuous Pulsed: 60 Hz – 695 ns Continuous Beam operation Stripping deuton - Litium Spallation on liquid mercury Spallation on liquid lead/bismuth Neutron production deutons H-, converted in p at accumulator ring protons Accelerates With window With window Windowless Target area ~ 40 MeV ~ 1 GeV ~ 600-1000 MeV Beam energy IFMIF SNS ADS
  • 14.
    Index Introduction: whyaccelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
  • 15.

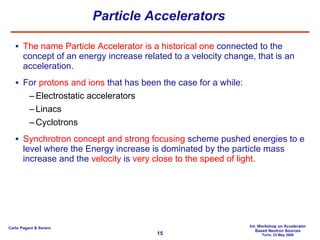

    Particle Accelerators Thename Particle Accelerator is a historical one connected to the concept of an energy increase related to a velocity change, that is an acceleration. For protons and ions that has been the case for a while: Electrostatic accelerators Linacs Cyclotrons Synchrotron concept and strong focusing scheme pushed energies to e level where the Energy increase is dominated by the particle mass increase and the velocity is very close to the speed of light.
  • 16.
    Basic Concepts: FieldsEquation of motion and Lorentz force Electric field can transfer energy to the particles Magnetic field can guide the beam in a stable path All Particle Accelerators are based on these rules The beam moves inside a vacuum chamber Electromagnetic objects placed on the beam path perform the tasks: Magnets guide the beam on the chosen trajectory (dipoles) and provide focusing (quadrupoles) Resonant RF cavities (exceptions: Betatron, RFQ and Electrostatic Accelerators) are used to apply the electric accelerating field
  • 17.
    Some Milestones forAccelerators 20th century first 25 years from 1928 to 1932 1928 1929 1944 1946 1950 1951 1956 1970 early 80's the last years Prehistory : fundamental discoveries made with &quot;beams&quot; from radioactive source trigger the demand for higher energies Cockcroft&Walton develop a 700kV electrostatic accelerator based on a voltage multiplier First Linac by Wideroe based on resonant acceleration Lawrence invents the cyclotron MacMillan, Oliphant & Veksler develop the synchrotron Alvarez builts a proton linac with Alvarez structures (2  mode) Christofilos patents the concept of strong focusing Alvarez conceives the tandem Kerst stresses in a paper the concept of a collider Kapchinski & Telyakov invent the radio-frequency quadrupole RFQ superconducting magnets for cylotrons and synchrotrons considerably boost the performance (energy for size) the development of superconducting accelerating cavities provides very high power conversion efficiency
  • 18.
    Accelerators evolution: theLivingston chart Around 1950, Livingston made a quite remarkable observation : Plotting the energy of an accelerator as a function of its year of construction , on a semi-log scale, the energy gain has a linear dependence . 50 years later, that still holds true. In other words, so far, builders of accelerators have managed exponential growth , every ten years , roughly a factor of 33 is won . Note that for a given &quot; family &quot; of accelerators, saturation of maximum energy sets in after some time. future E = m c 2
  • 19.

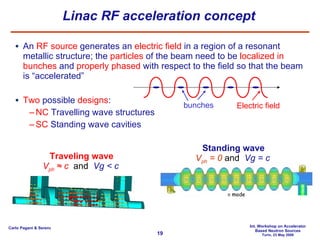

    An RFsource generates an electric field in a region of a resonant metallic structure; the particles of the beam need to be localized in bunches and properly phased with respect to the field so that the beam is “accelerated” Two possible designs : NC Travelling wave structures SC Standing wave cavities Linac RF acceleration concept Traveling wave V ph ≈ c and Vg < c Standing wave V ph = 0 and Vg = c  mode bunches Electric field
  • 20.

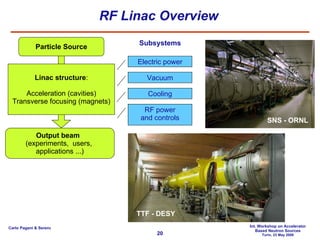

    RF Linac OverviewParticle Source Linac structure : Acceleration (cavities) Transverse focusing (magnets) Electric power Vacuum Cooling RF power and controls Output beam (experiments, users, applications ...) Subsystems SNS - ORNL TTF - DESY
  • 21.
    Energy gain anddissipated power To accelerate particles efficiently, very high electric field is required In any structure (cavity) holding an electromagnetic field, both dissipated power and stored energy scale quadratically with the fields The efficiency of a cavity depends from: Its quality factor, Q driven by the surface resistance, R s Its shunt impedance, r function of the cavity geometry and of the surface resistance, R s For efficient acceleration Q, r and r/Q must all be as high as possible U is the energy stored in the cavity P diss is the power dissipated on its surface Δ V is the voltage seen by the beam “ r over Q ” is purely a geometrical factor Good material for maximum Q and r (that is minimum P diss ) Good design for maximum r/Q L R C
  • 22.
    Why Superconductivity inRF linacs? In normal conducting linac a huge amount of power is deposited in the copper structure, in the form of heat , that needs to be removed by water cooling (in order not to melt the structures) Dissipated power can be much higher than the power transferred into the beam for acceleration Superconductivity , at the expenses of higher complexity, drastically reduces the dissipated power and the cavities transfer more efficiently the RF power to the beam In short: NC linac: lower capital cost, but high operational cost SC linac: slightly higher capital cost, but low operational cost
  • 23.

    Superconductivity whenever possible For a good but not perfect conductor ( ρ ≠ 0) , the fields and currents penetrate into the conductor in a small layer at the cavity surface (the skin depth , δ ) With RF fields, a SC cavity dissipate power, not all electrons are in Cooper pairs. In NC linac a huge amount of power is deposited in the copper structure: MW to have MV Pulsed operation and Low Duty Cycle SC SuperConducting NC or RT NormalConducting Nb Cu
  • 24.

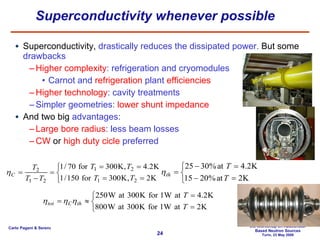

    Superconductivity whenever possible Superconductivity, drastically reduces the dissipated power. But some drawbacks Higher complexity : refrigeration and cryomodules Carnot and refrigeration plant efficiencies Higher technology : cavity treatments Simpler geometries: lower shunt impedance And two big advantages: Large bore radius : less beam losses CW or high duty cicle preferred
  • 25.
    Index Introduction: whyaccelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
  • 26.

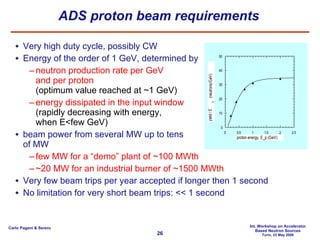

    ADS proton beamrequirements Very high duty cycle, possibly CW Energy of the order of 1 GeV, determined by neutron production rate per GeV and per proton (optimum value reached at ~1 GeV) energy dissipated in the input window (rapidly decreasing with energy, when E<few GeV) beam power from several MW up to tens of MW few MW for a “demo” plant of ~100 MWth ~20 MW for an industrial burner of ~1500 MWth Very few beam trips per year accepted if longer then 1 second No limitation for very short beam trips: << 1 second
  • 27.
  • 28.

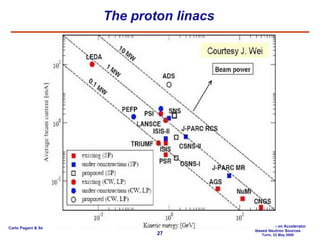

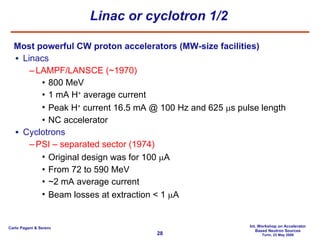

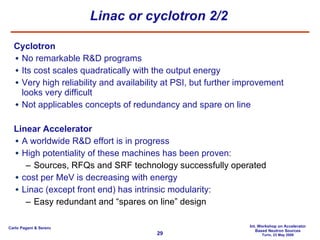

    Linac or cyclotron1/2 Most powerful CW proton accelerators (MW-size facilities) Linacs LAMPF/LANSCE (~1970) 800 MeV 1 mA H + average current Peak H + current 16.5 mA @ 100 Hz and 625  s pulse length NC accelerator Cyclotrons PSI – separated sector (1974) Original design was for 100  A From 72 to 590 MeV ~2 mA average current Beam losses at extraction < 1  A
  • 29.
    Linac or cyclotron2/2 Cyclotron No remarkable R&D programs Its cost scales quadratically with the output energy Very high reliability and availability at PSI, but further improvement looks very difficult Not applicables concepts of redundancy and spare on line Linear Accelerator A worldwide R&D effort is in progress High potentiality of these machines has been proven: Sources, RFQs and SRF technology successfully operated cost per MeV is decreasing with energy Linac (except front end) has intrinsic modularity: Easy redundant and “spares on line” design
  • 30.
    The ADS LinacLinac benefits of impressive progresses in the field of SC cavities: SC technology can be extended to proton linac down to  ~ 0.5 Intrinsic modularity simplify reliability issues Redundant design strategy based on the “spare-on-line” concept Strong focusing and large beam aperture produce negligible losses The scheme generally considered consists of four different sections The proton source: proton energy  80-100 keV The Radio Frequency Quadrupole ( RFQ ): up to  5 MeV A medium energy section , either NC or SC: up to  100 MeV A high energy section made of SC elliptical rf cavities: up to final energy  1 GeV (most of the linac is here!)
  • 31.
    Reference Linac DesignProton Source RFQ Medium energy ISCL linac 3 sections high energy SC linac 80 keV 5 MeV ~ 100 MeV 200 MeV 500 MeV >1000 MeV 3 section linac: 85/100 - 20 0 MeV,  =0. 47 20 0 - 50 0 MeV,  =0.65 50 0 – 1 0 00 /2000 MeV,  =0.8 5 Five (six) cell elliptical cavities Quadrupole doublet focussing: multi - cavity cryostats between doublets 704.4 MHz 5 - 85/100 MeV SC linac Spoke cavities (352 MHz) Lambda/4 cavities (176 MHz) Reentrant cavities (352 MHz) or NC Drift Tube Linac (DTL) High transmission 90% 30 mA, 5 MeV (352 MHz) Microwave RF Source High current (3 5 mA) 80 keV High Energy SC Linac ISCL RFQ Source
  • 32.

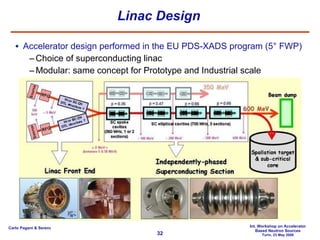

    Linac Design Acceleratordesign performed in the EU PDS-XADS program (5° FWP) Choice of superconducting linac Modular: same concept for Prototype and Industrial scale
  • 33.
    Injector, an example:LEDA at LANL RFQ Concept 1.2 MW (structure) 670 kW (beam) RF Power 8 m (4 sections) Length 6.7 MeV Final Energy 100 mA (95 %) Beam current LEDA RFQ: One Section of LEDA-RFQ The LEDA-RFQ fully installed
  • 34.

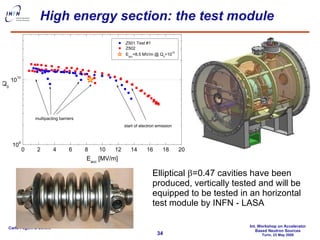

    High energy section:the test module Elliptical  =0.47 cavities have been produced, vertically tested and will be equipped to be tested in an horizontal test module by INFN - LASA
  • 35.

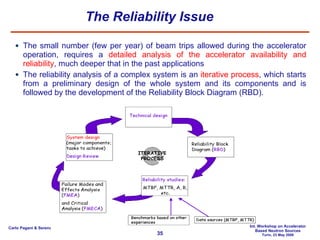

    The Reliability IssueThe small number (few per year) of beam trips allowed during the accelerator operation, requires a detailed analysis of the accelerator availability and reliability , much deeper that in the past applications  The reliability analysis of a complex system is an iterative process , which starts from a preliminary design of the whole system and its components and is followed by the development of the Reliability Block Diagram (RBD).
  • 36.
    Some Remarks on Linac Reliability In order to meet the # of stops > 1 s The beam startup procedure for a multi MW beam will be certainly > 1 s operation with faulty components needs to be achieved Linac must tolerate single failures of most of components Procedures for “adjusting” beam transport and repairing of components without interrupting the beam while marinating acceptable losses As a consequence Components and subsystems divided in two major categories if they lead to: Failures requiring a beam stop Failures that can be repaired while the beam is on, or later… As general rules Components falling in the first category should have the highest reliability Typically passive components overdesigned and overtested Components falling in the second category should have the highest accessibility for repairing or substitution For example, this suggest the choice of a double tunnel design, with most of ancillaries situated in a free-access tunnel (Power supplies, RF generators, etc.)
  • 37.
    Index Introduction: whyaccelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
  • 38.

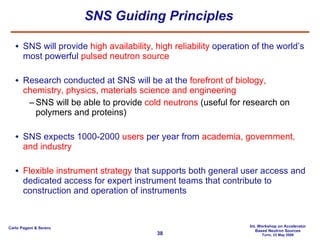

    SNS Guiding PrinciplesSNS will provide high availability, high reliability operation of the world’s most powerful pulsed neutron source Research conducted at SNS will be at the forefront of biology, chemistry, physics, materials science and engineering SNS will be able to provide cold neutrons (useful for research on polymers and proteins) SNS expects 1000-2000 users per year from academia, government, and industry Flexible instrument strategy that supports both general user access and dedicated access for expert instrument teams that contribute to construction and operation of instruments
  • 39.

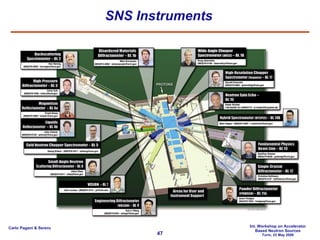

  • 40.

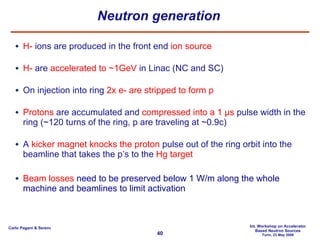

    Neutron generation H- ions are produced in the front end ion source H- are accelerated to ~1GeV in Linac (NC and SC) On injection into ring 2x e- are stripped to form p Protons are accumulated and compressed into a 1 µs pulse width in the ring (~120 turns of the ring, p are traveling at ~0.9c) A kicker magnet knocks the proton pulse out of the ring orbit into the beamline that takes the p’s to the Hg target Beam losses need to be preserved below 1 W/m along the whole machine and beamlines to limit activation
  • 41.

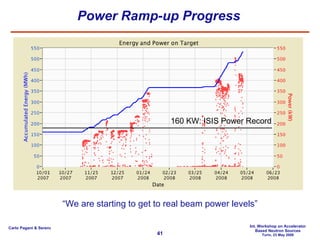

    Power Ramp-up Progress“We are starting to get to real beam power levels” 160 KW: ISIS Power Record
  • 42.

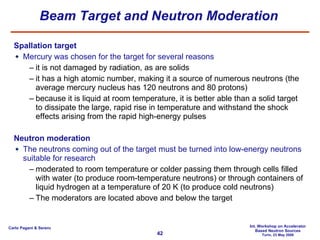

    Beam Target andNeutron Moderation Spallation target Mercury was chosen for the target for several reasons it is not damaged by radiation, as are solids it has a high atomic number, making it a source of numerous neutrons (the average mercury nucleus has 120 neutrons and 80 protons) because it is liquid at room temperature, it is better able than a solid target to dissipate the large, rapid rise in temperature and withstand the shock effects arising from the rapid high-energy pulses Neutron moderation The neutrons coming out of the target must be turned into low-energy neutrons suitable for research moderated to room temperature or colder passing them through cells filled with water (to produce room-temperature neutrons) or through containers of liquid hydrogen at a temperature of 20 K (to produce cold neutrons) The moderators are located above and below the target
  • 43.
    Layout of RFLinac 805 MHz, 0.55 MW klystron 805 MHz, 5 MW klystron 402.5 MHz, 2.5 MW klystron SRF, ß=0.61, 33 cavities 1 from CCL 186 MeV 86.8 MeV 2.5 MeV RFQ (1) DTL (6) CCL (4) SRF, ß=0.81, 48 cavities 1000 MeV (81 total powered) 379 MeV Warm Linac SCL Linac
  • 44.
    Normal Conducting LinacCCL Systems designed and built by Los Alamos 805 MHz CCL accelerates beam to 186 MeV System consists of 48 accelerating segments, 48 quadrupoles, 32 steering magnets and diagnostics 402.5 MHz DTL was designed and built by Los Alamos Six tanks accelerate beam to 87 MeV System includes 210 drift tubes, transverse focusing via PM quads, 24 dipole correctors, and associated beam diagnostics
  • 45.
    Superconducting Linac Designedan built by Jefferson Laboratory SCL accelerates beam from 186 to 1000 MeV SCL consists of 81 cavities in 23 cryomodules Two cavities geometries are used to cover broad range in particle velocities Cavities are operated at 2.1 K with He supplied by Cryogenic Plant Medium beta cavity High beta cavity
  • 46.
    Others SNS ParametersProtons per pulse on target 1.5x10 14 protons Energy per pulse on target 24 kJ Average linac macropulse H- current 26 mA Linac beam macropulse duty factor 6% Front end length 7.5 m Linac length 331 m HEBT length 170 m Ring circumference 248 m RTBT length 150 m Ion type (Ring, RTBT, Target) proton  Ring filling time 1.0 ms Ring revolution frequency 1.058 MHz Number of injected turns 1060  Ring filling fraction 68% Ring extraction beam gap 250 ns Maximum uncontrolled beam loss 1 W/m Number of ambient / cold moderators 1/3  Number of neutron beam shutters 18
  • 47.
  • 48.
    Q-  Diagram for Inelastic Instruments adapted from “Neutron Scattering Instrumentation for a High-Powered Spallation Source” R. Hjelm, et al., LA0-UR 97-1272 Momentum Distributions Itinerant Magnets Crystal Fields Molecular Vibrations Lattice Vibrations Small Molecule Diffusion Large Scale Motions Polymers and Biological Systems Tunneling Spectroscopy Electron-Phonon Interactions Hydrogen Modes Molecular Reorientation Ultracold Neutrons Fundamental Physics Slower Motions Larger Objects ARCS THERMAL CHOPPER SPECT COLD NEUTRON CHOPPER SPECT BACKSCATTERING SPECTROMETER
  • 49.

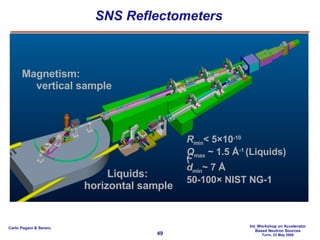

    SNS Reflectometers Rmin < 5×10 -10 Q max ~ 1.5 Å -1 (Liquids) ~ 7 Å -1 (Magnetism) d min ~ 7 Å 50-100× NIST NG-1 Magnetism: vertical sample Liquids: horizontal sample
  • 50.

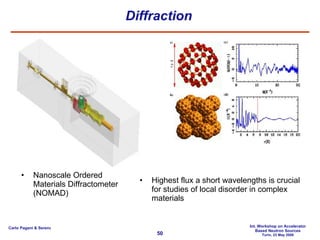

    Diffraction Highest fluxa short wavelengths is crucial for studies of local disorder in complex materials Nanoscale Ordered Materials Diffractometer (NOMAD)
  • 51.
    High Pressure CellsLimit Sample Volume Pressure cell of the type to be employed on SNAP (Spallation Neutrons and Pressure) beamline
  • 52.
    Index Introduction: whyaccelerators as source for neutrons? General principles of neutron production with accelerators What is a high power accelerator and how does it work? General layout Superconductive choice Applications of accelerator driven neutron sources Waste Transmutation (ADS) Materials studies (SNS) Fusion (IFMIF)
  • 53.
    IFMIF general informationIFMIF Irradiation tool to qualify advanced materials resistant to extreme radiation conditions (DEMO reactor) Requires an intense neutron flux (~ 10 17 n/s/m 2 ) at 14 MeV Neutrons are generated by stripping deutons on Li target. Deuton provided by accelerator: 2 parallel CW beams 40 MeV, 125 mA for a total power of 10 MW IFMIF-EVEDA (Engineering Validation Engineering Design Activities) Engineering design of the IFMIF facility, safety assessment for a generic site and preparation of the technical specifications for the longest delivery components Design and construction of low energy section of the first accelerator Design, construction and tests of a scale 1:3 model of the Target Facility Design, construction and tests of mock-ups of the Test Facility (high flux volume and medium flux volume). Irradiation of the test set-up to relevant irradiation dose values to check performance under real operating conditions
  • 54.
    ITER 3 dpa/lifetimeIFMIF 20-55 dpa/year Plasma Facing Materials Structural Materials Functional Materials Advanced Materials are at a critical path DEMO 30 dpa/year
  • 55.

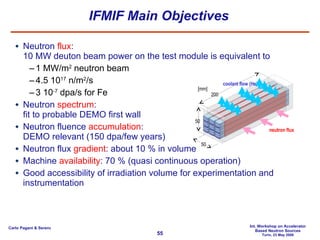

    IFMIF Main ObjectivesNeutron flux : 10 MW deuton beam power on the test module is equivalent to 1 MW/m 2 neutron beam 4.5 10 17 n/m 2 /s 3 10 -7 dpa/s for Fe Neutron spectrum : fit to probable DEMO first wall Neutron fluence accumulation : DEMO relevant (150 dpa/few years) Neutron flux gradient : about 10 % in volume Machine availability : 70 % (quasi continuous operation) Good accessibility of irradiation volume for experimentation and instrumentation neutron flux coolant flow (He) 200 50 50 [mm]
  • 56.
    IFMIF Principles RFQHWR HEBT Typical reactions 7 Li(d,2n) 7 Be 6 Li(d,n) 7 Be 6 Li(n,T) 4 He Source Accelerator (x 2) Test Cell Low flux (< 1 dpa/an, > 8 L) Medium flux (20 – 1 dpa/an, 6 L) Lithium target High flux (> 20 dpa/an, 0.5 L)
  • 57.

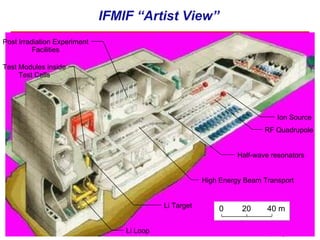

    IFMIF “Artist View”Ion Source RF Quadrupole Post Irradiation Experiment Facilities High Energy Beam Transport Li Target Li Loop Test Modules inside Test Cells Half-wave resonators 0 20 40 m
  • 58.

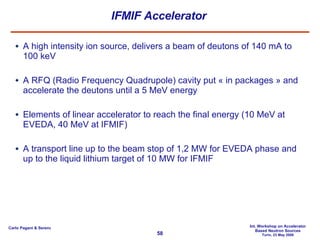

    IFMIF Accelerator Ahigh intensity ion source, delivers a beam of deutons of 140 mA to 100 keV A RFQ (Radio Frequency Quadrupole) cavity put « in packages » and accelerate the deutons until a 5 MeV energy Elements of linear accelerator to reach the final energy (10 MeV at EVEDA, 40 MeV at IFMIF) A transport line up to the beam stop of 1,2 MW for EVEDA phase and up to the liquid lithium target of 10 MW for IFMIF
  • 59.
    IFMIF EVEDA designAccelerator Prototype (scale 1:1) Ion Source RadioFrequency Quadrupole Matching Section Half Wave Resonators linac HEBT and Beam Dump Building (at Rokkasho) for the test of the accelerator Lithium Loop (scale 1:3) Diagnostics Erosion/Corrosion Purification system Remote Handling High Flux Test Module (HFTM) Irradiation in fission reactor Validation of sample concepts ~ ~
  • 60.
    Accelerator Reference DesignHigh Energy Beam Transport (HEBT) Large Bore Quad & Dipoles, 43 m long SC Half-wave resonators acceleration to 40 MeV Radio Frequency Quadrupole (RFQ) bunching & acceleration 5 MeV; MS to DTL RF Power System 175 MHz 12 RF amplifiers, 1MW CW 100 keV Injector Ion Source 140 mA D + , 100 keV LEBT transfer/match to RFQ 5 MeV 40 MeV 125 mA deuton beam Control Command  2
  • 61.
    Injector - ConceptionSpecifications rms emittance = 0.25  .mm.mrad (normalized ) beam current = 140 mA energy = 100 keV The injector components the ECR (Electron Cyclotron Resonance) ion source must deliver 140 mA beam current with an output energy of 100 keV the LEBT (Low Energy Beam Transport) section includes magnetic lenses (focusing and beam matching to the RFQ) beam instrumentation : charge, current, profile, size, emittance measurement the associated infrastructure: power supplies, control system, water cooling
  • 62.
    Injector – InitialLEBT design Cone Cameras ACCT Cameras Neutron detector Emittance Monitor DC toroid on HV cable Movable ConFlat Species identification* Thermocouples *fluorescence + shifted Doppler lines analysis
  • 63.
    Radio-Frequency Quadrupole RFQLength 9.6 meters RFQ transmission OK 99% (w/o error) Losses above 1 MeV kept at low level 0.01 % Voltage and Power levels moderate < V > = 102 kV, P = 1200  1480 kW RF study started Cu brazing joints e-beam & laser welding alternatives under study Mechanical design in a test phase
  • 64.

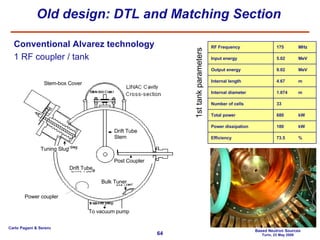

    Old design: DTLand Matching Section 1st tank parameters Conventional Alvarez technology 1 RF coupler / tank RF Frequency 175 MHz Input energy 5.02 MeV Output energy 9.02 MeV Internal length 4.67 m Internal diameter 1.074 m Number of cells 33 Total power 680 kW Power dissipation 180 kW Efficiency 73.5 % Power coupler Stem-box Cover Tuning Slug Post Coupler Drift Tube Stem Drift Tube To vacuum pump Bulk Tuner
  • 65.

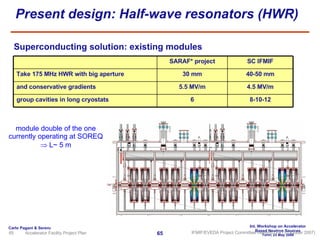

    Present design: Half-wave resonators (HWR) IFMIF/EVEDA Project Committee meeting (10-11 October 2007) Accelerator Facility Project Plan Superconducting solution: existing modules module double of the one currently operating at SOREQ  L~ 5 m group cavities in long cryostats and conservative gradients Take 175 MHz HWR with big aperture 8-10-12 6 4.5 MV/m 40-50 mm SC IFMIF 5.5 MV/m 30 mm SARAF* project
  • 66.

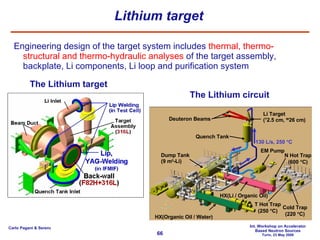

    Lithium target Engineeringdesign of the target system includes thermal, thermo-structural and thermo-hydraulic analyses of the target assembly, backplate, Li components, Li loop and purification system The Lithium circuit The Lithium target Quench Tank Deuteron Beams Li Target ( T 2.5 cm, W 26 cm) EM Pump HX(Li / Organic Oil) Dump Tank (9 m 3 -Li) HX(Organic Oil / Water) 130 L/s, 250  C Cold Trap (220  C) N Hot Trap (600  C) T Hot Trap (250  C)
  • 67.
    Principle of TestModules 2 m D + Medium Flux Test Modules High Flux Test Module Low Flux Irradiation Tubes Lithium Target Lithium Tank Shield plug
  • 68.

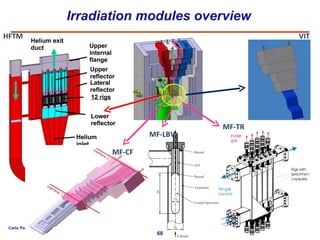

    Irradiation modules overviewVIT MF-CF MF-LBV MF-TR Upper internal flange Upper reflector Lateral reflector 12 rigs Lower reflector Helium inlet duct Helium exit duct HFTM
  • 69.

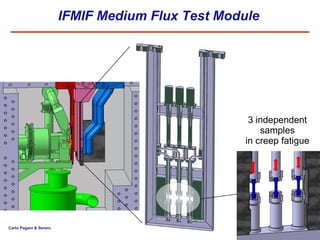

    IFMIF Medium FluxTest Module 3 independent samples in creep fatigue
