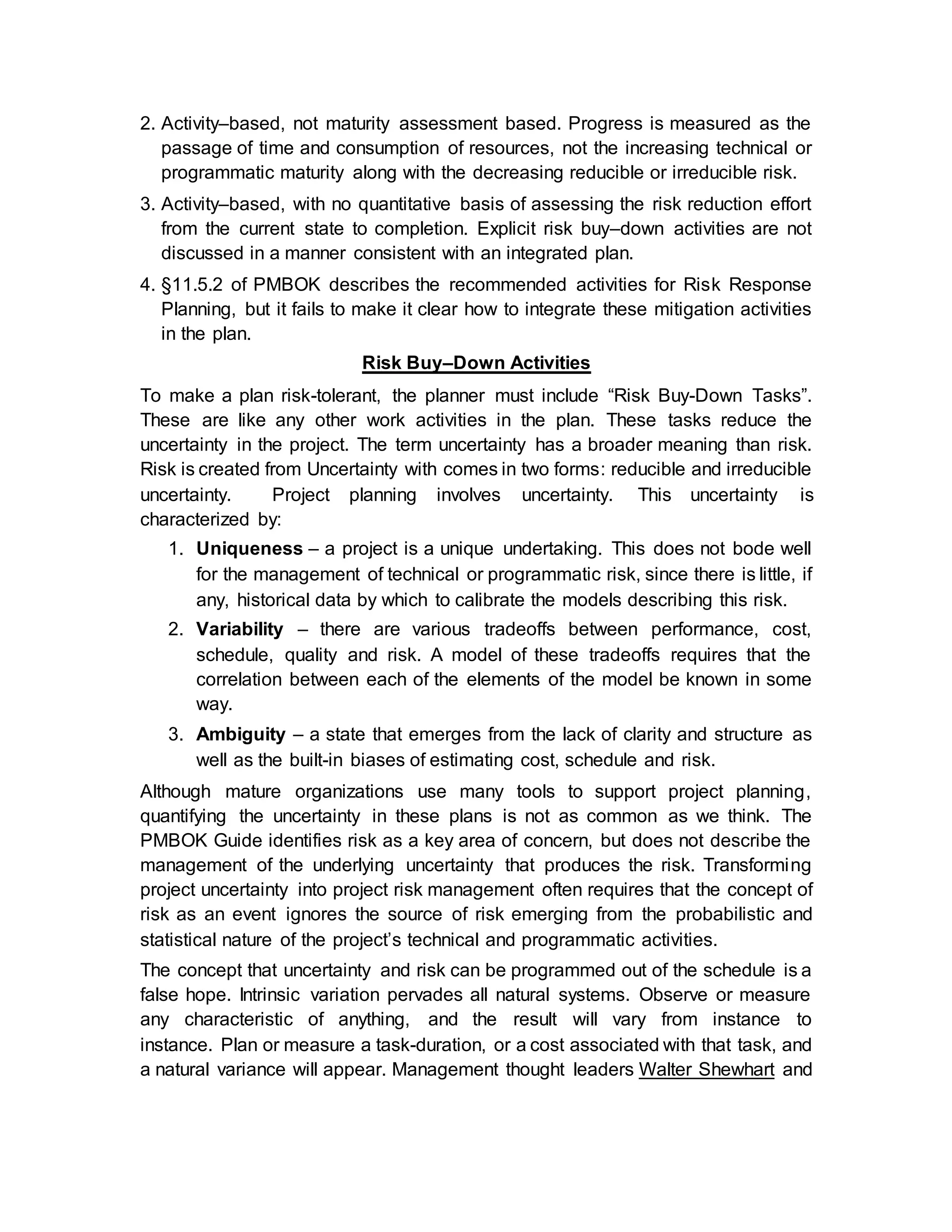

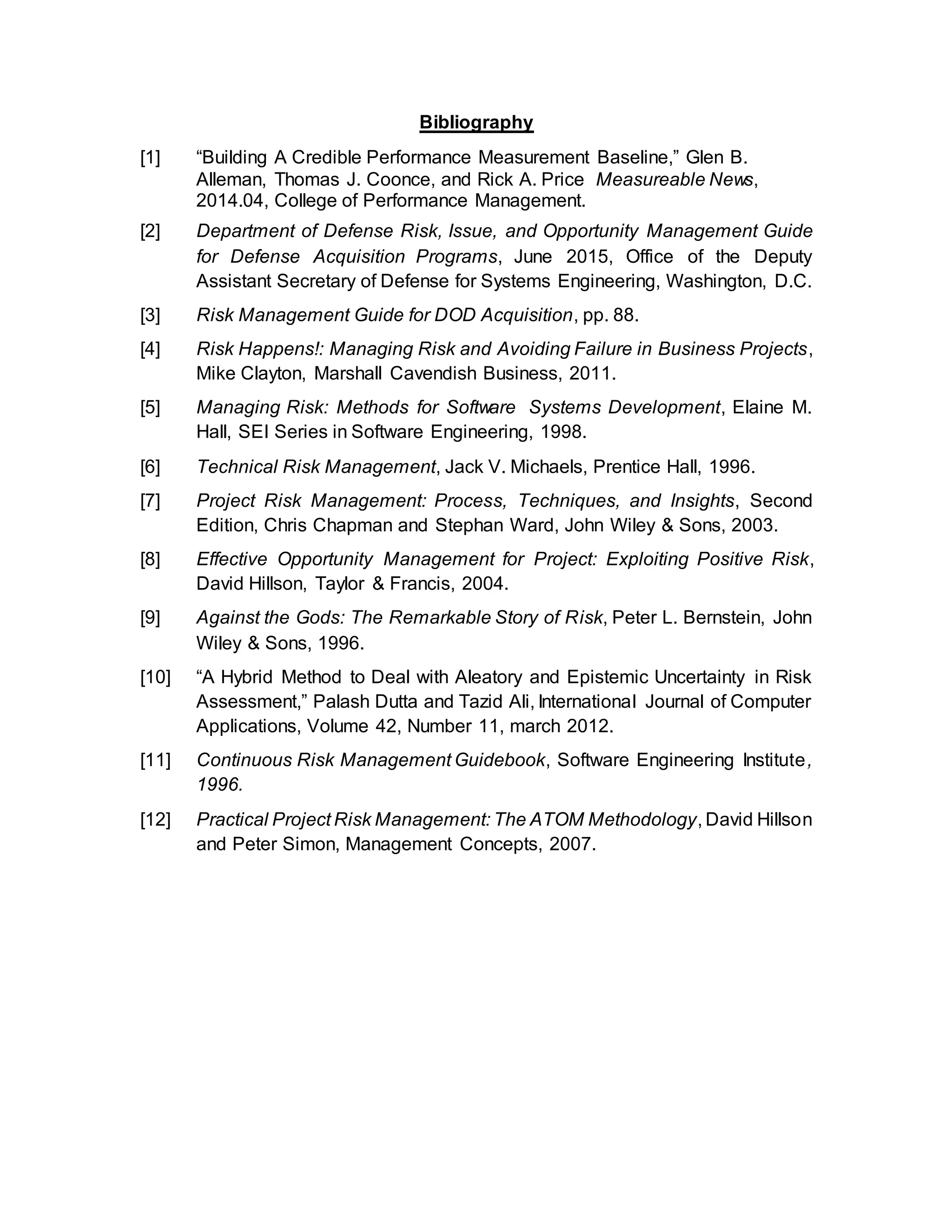

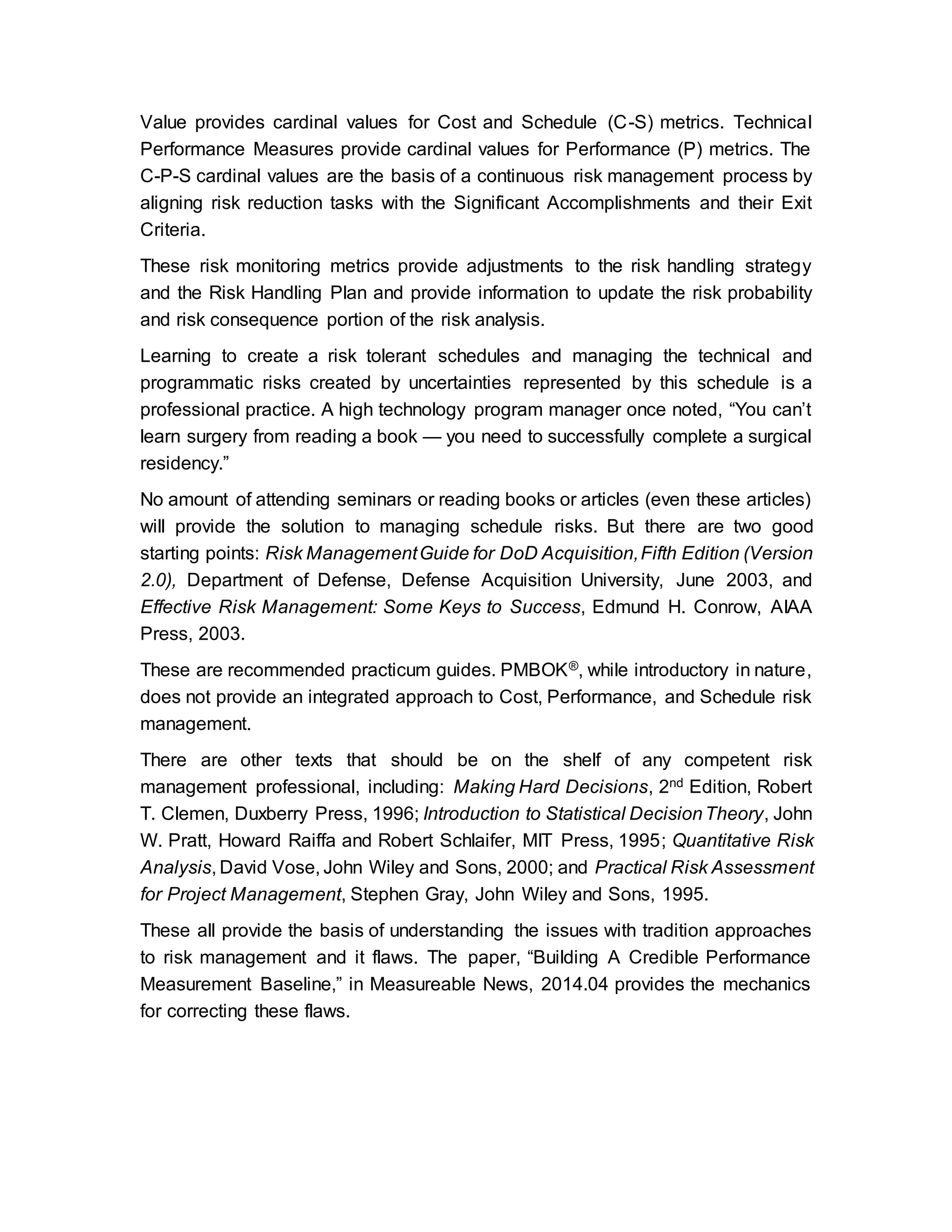

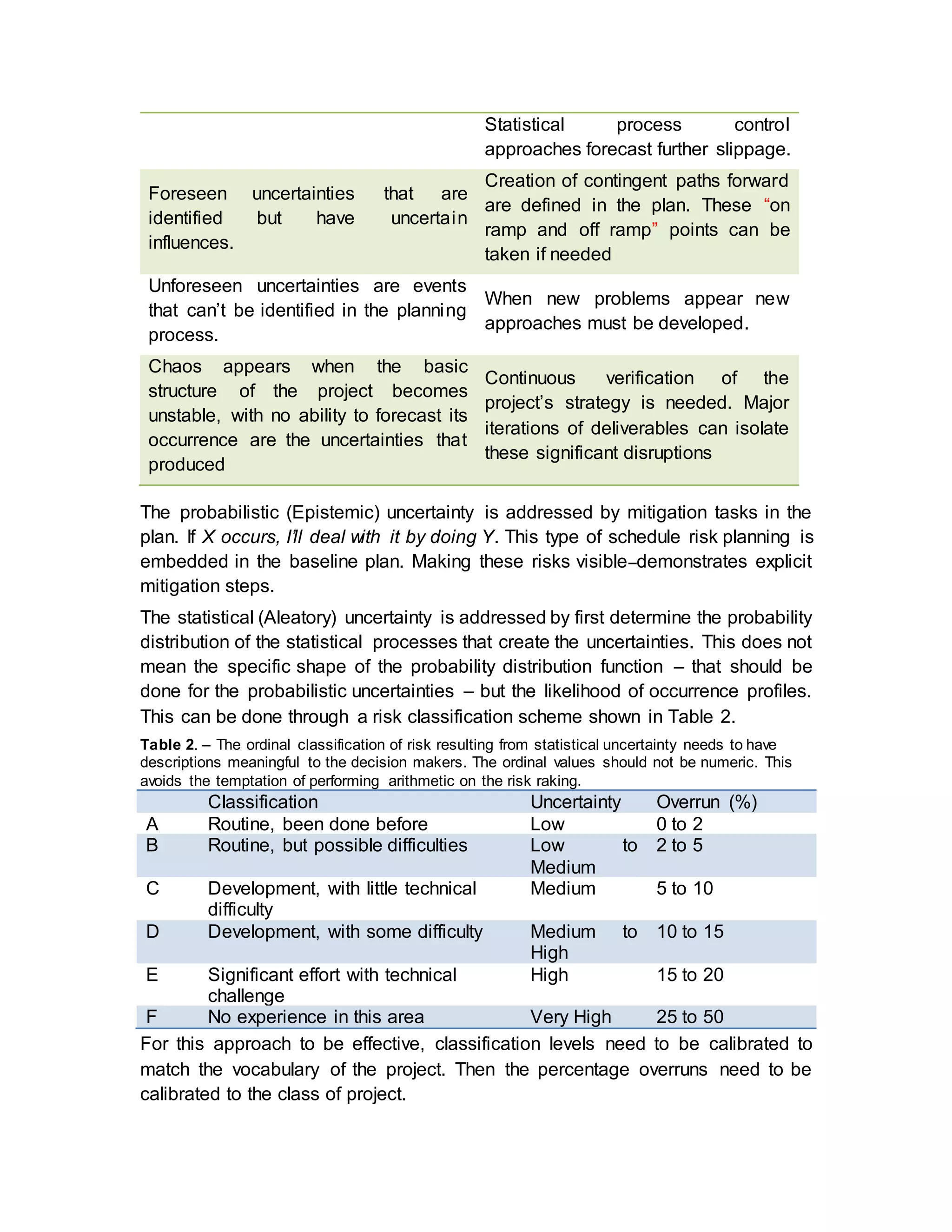

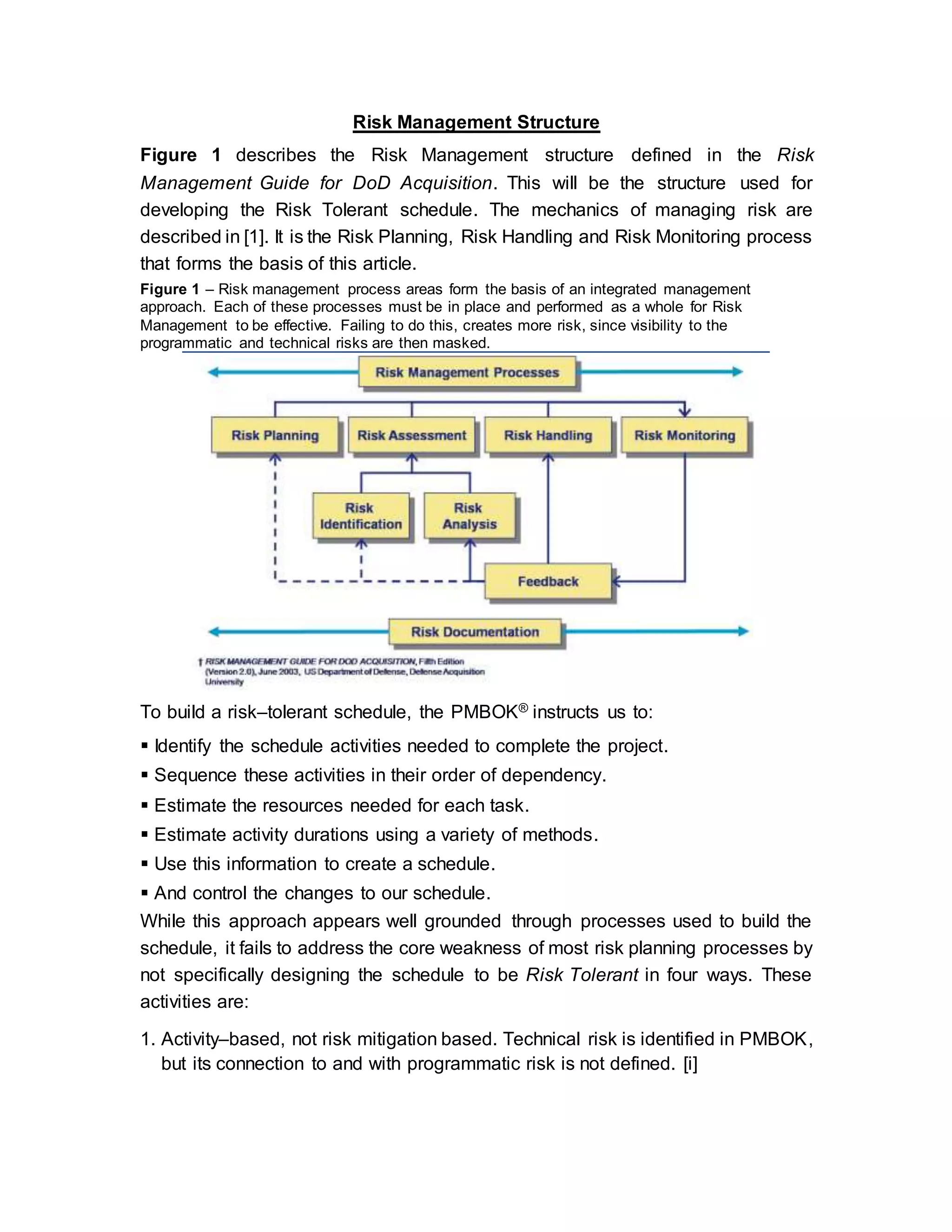

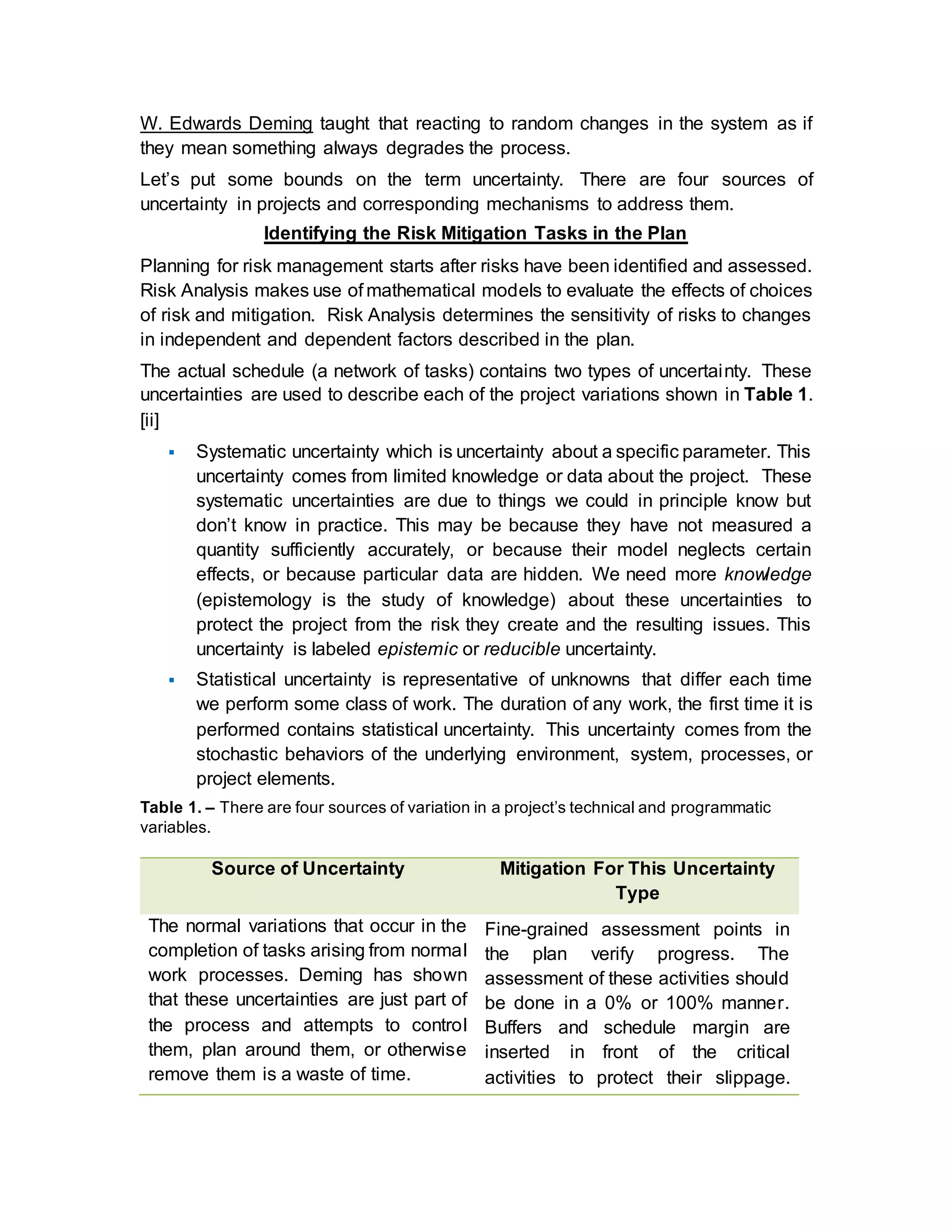

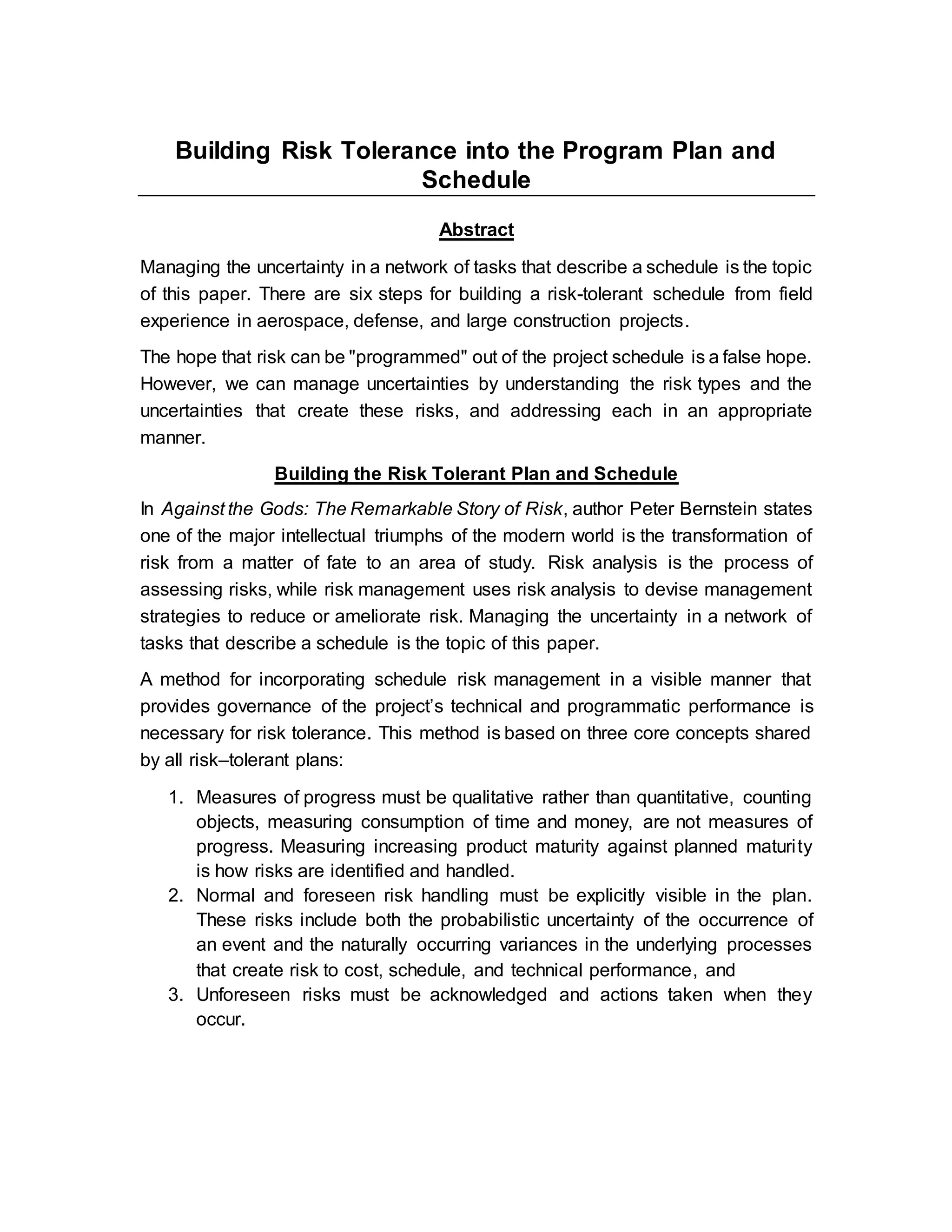

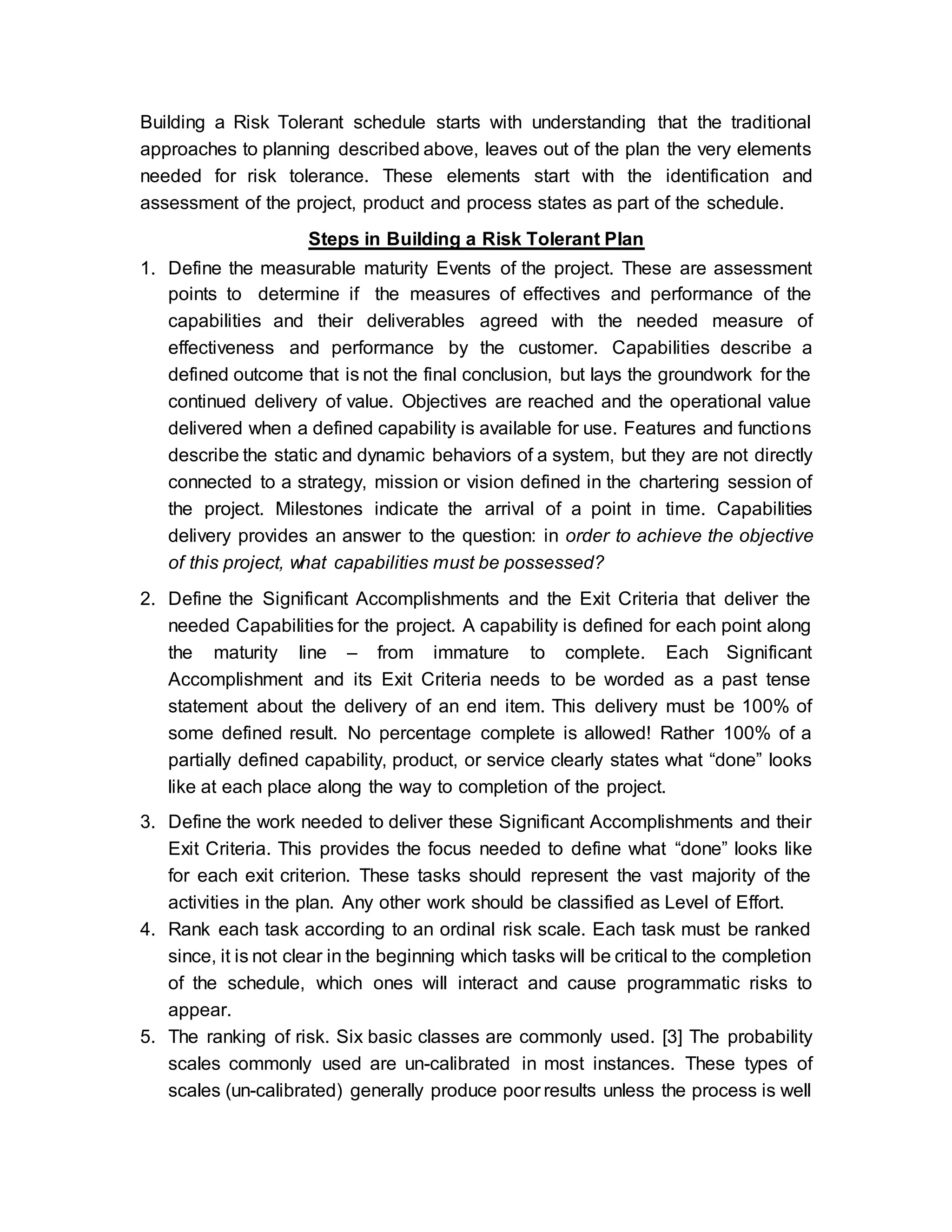

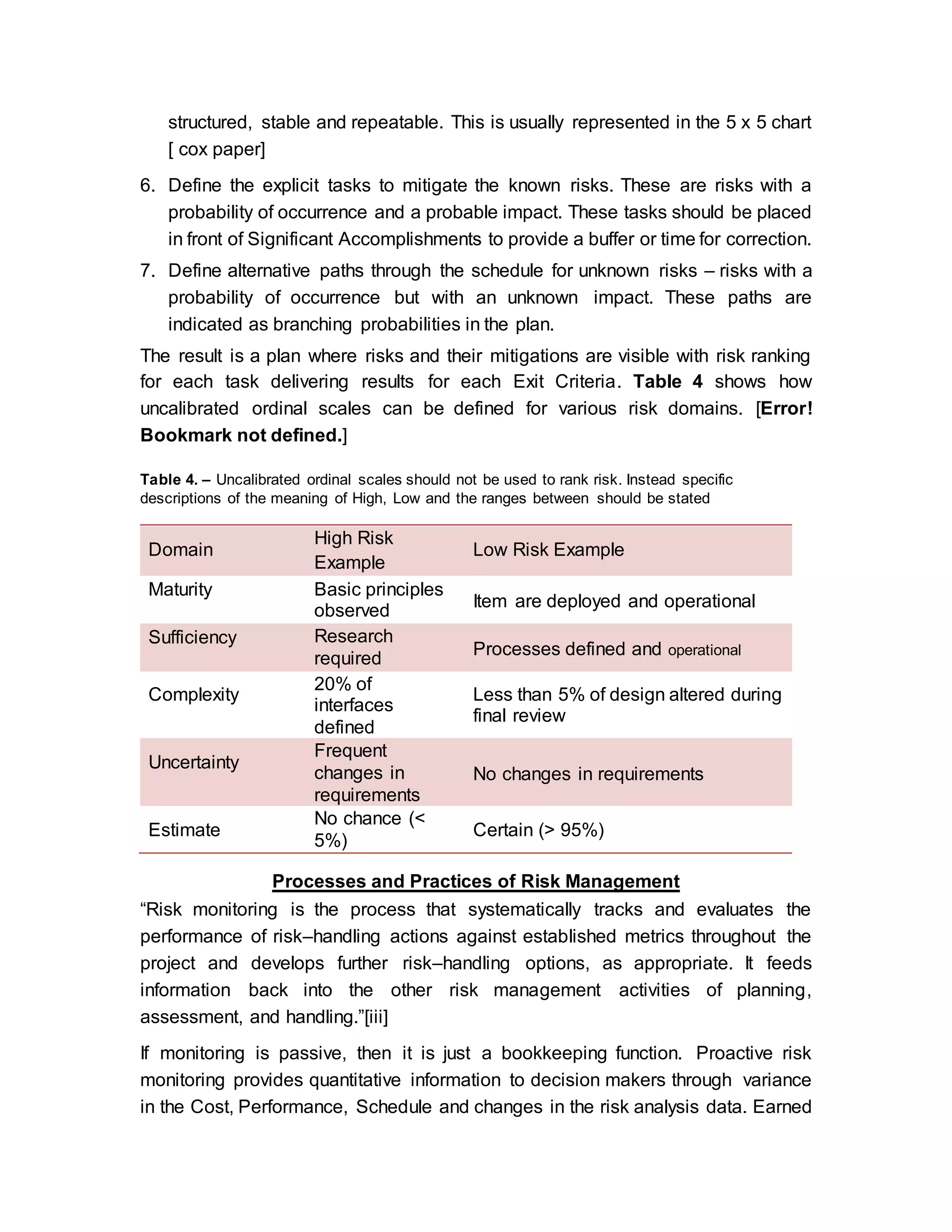

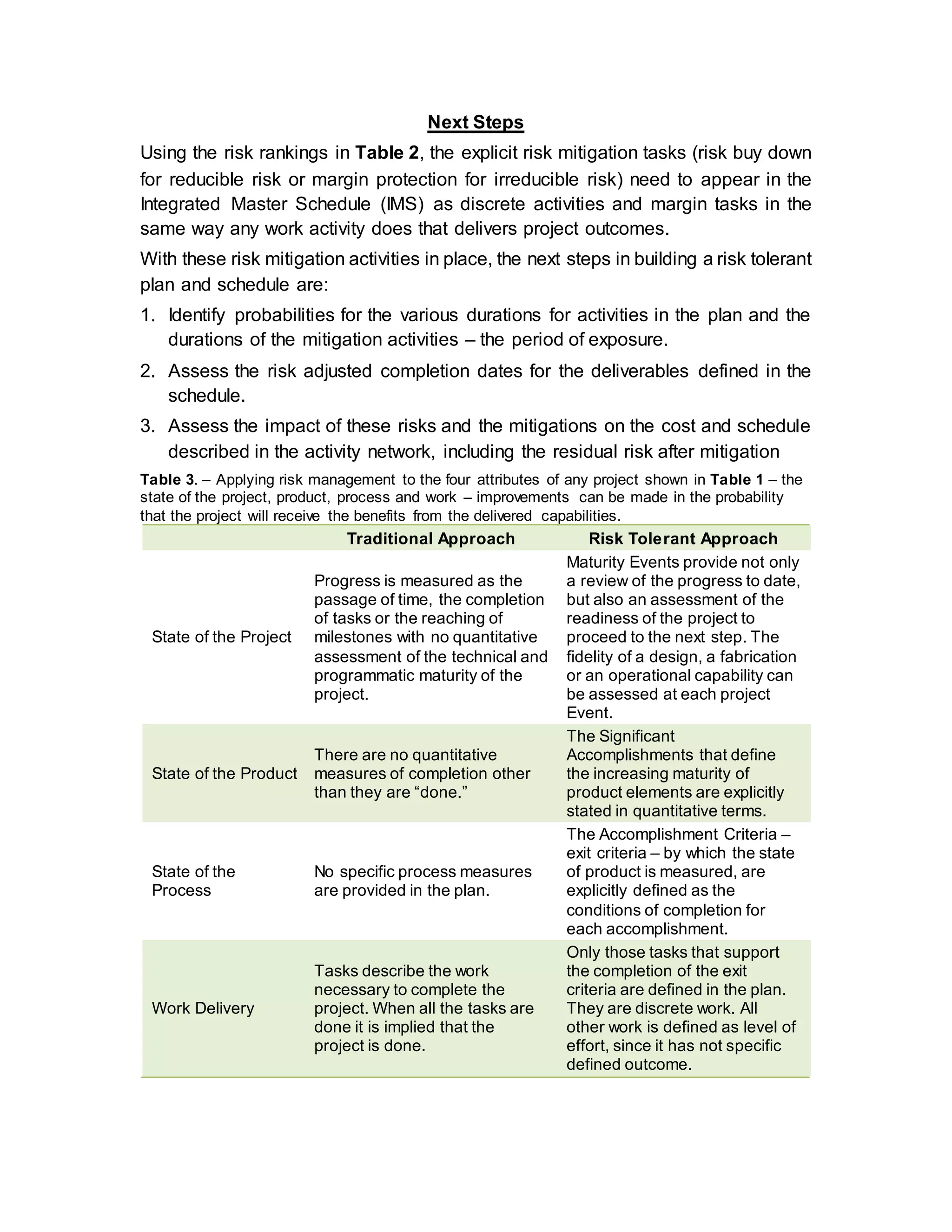

This document provides guidance on building a risk-tolerant project schedule. It discusses identifying risks and uncertainties, defining risk mitigation tasks, and incorporating them explicitly into the schedule. Key steps include: 1) Defining measurable maturity milestones; 2) Defining accomplishments and exit criteria; 3) Defining work to meet exit criteria; 4) Ranking tasks by risk level; 5) Defining risk mitigation tasks; and 6) Planning alternative paths for unknown risks. This makes risks and mitigations visible, allowing continuous risk monitoring and adjustment of the risk handling strategy.
