2. CONTENTS

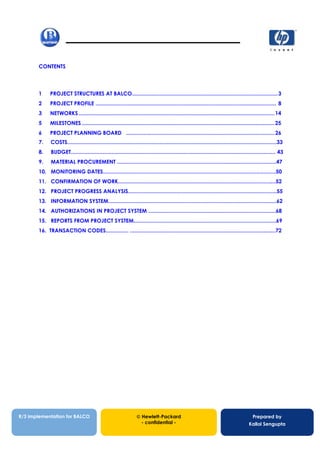

1 PROJECT STRUCTURES AT BALCO................................................................................................3
2 PROJECT PROFILE ....................................................................................................................... 8
3 NETWORKS .................................................................................................................................14
5 MILESTONES ...............................................................................................................................25
6 PROJECT PLANNING BOARD ..................................................................................................26
7. COSTS..........................................................................................................................................33
8. BUDGET....................................................................................................................................... 43
9. MATERIAL PROCUREMENT .........................................................................................................47
10. MONITORING DATES..................................................................................................................50
11. CONFIRMATION OF WORK........................................................................................................52
12. PROJECT PROGRESS ANALYSIS..................................................................................................55
13. INFORMATION SYSTEM...............................................................................................................62
14. AUTHORIZATIONS IN PROJECT SYSTEM ....................................................................................68
15. REPORTS FROM PROJECT SYSTEM..............................................................................................69
16. TRANSACTION CODES............... ................................................................................................72
13/12/200213/12/200213/12/2002
R/3 implementation for BALCO Hewlett-Packard
- confidential -
Prepared by
Kallol Sengupta
3. 13/12/20021

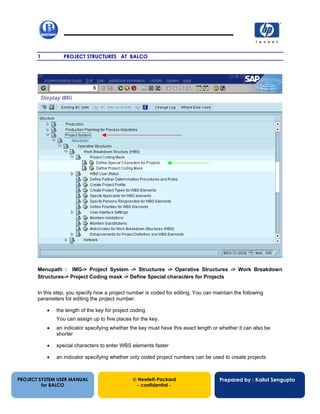

1 PROJECT STRUCTURES AT BALCO

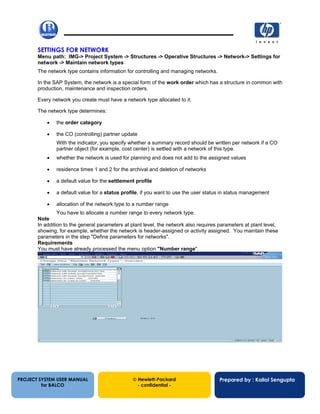

Menupath : IMG-> Project System -> Structures -> Operative Structures -> Work Breakdown
Structures-> Project Coding mask -> Define Special characters for Projects
In this step, you specify how a project number is coded for editing. You can maintain the following
parameters for editing the project number:
• the length of the key for project coding
You can assign up to five places for the key.
• an indicator specifying whether the key must have this exact length or whether it can also be
shorter
• special characters to enter WBS elements faster
• an indicator specifying whether only coded project numbers can be used to create projects
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
4. 13/12/20022
Menupath : IMG-> Project System -> Structures -> Operative Structures -> Work Breakdown
Structures-> Project Coding mask -> Define Project Coding mask
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
5. 13/12/20023
In this step, you create masks for editing the project number. Masks help display complex project numbers. They can
also be used to indicate the position of a WBS element in the project hierarchy.
You can create a mask for every key you want to use in project coding.
The following characters are available for editing:
• X for alphanumeric characters
• 0 for numeric characters
• special characters to organize the project numbers
The Project Code for Balco is based on the following codification:
Project ID :
First two digits are based on the project executing agency (e.g. Smelter & Power)
CP/000-XX-XX-XX-XX-XX BALCO 540 MW Captive Power Plant
SM/000-XX-XX-XX-XX-XX BALCO Smelter Project
Third character is a separator ‘/ ‘
Numeric part is to be used for running project number.
Alphanumeric part is to be used for coding WBS hierarchy
The subsequent coding mask follows logic as explained below:
000 Project serial number.
XX 1st Level of the WBS element - Major work packages (e.g. EPC,NEPC for Power Project)
XX 2nd level of the WBS element : Major Work packages based on person responsible
(e.g. under EPC -- Boiler, Turbine, BOP, Electrical, C&I)
XX 3rd level WBS Element for further breakdown of the Major Work packages
XX 4th level WBS Element for further breakdown of the structure
XX 5th level WBS Element for breakdown of the structure
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
6. 13/12/20024

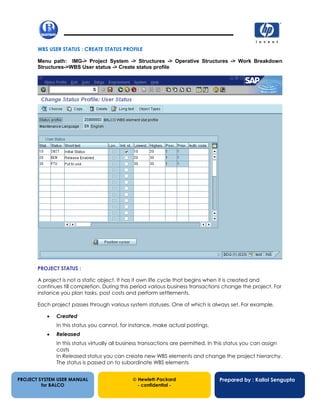

WBS USER STATUS : CREATE STATUS PROFILE
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Work Breakdown
Structures->WBS User status -> Create status profile
PROJECT STATUS :
A project is not a static object. It has it own life cycle that begins when it is created and
continues till completion. During this period various business transactions change the project. For
instance you plan tasks, post costs and perform settlements.
Each project passes through various system statuses. One of which is always set. For example,
• Created
In this status you cannot, for instance, make actual postings.
• Released
In this status virtually all business transactions are permitted. In this status you can assign
costs
In Released status you can create new WBS elements and change the project hierarchy.
The status is passed on to subordinate WBS elements
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
7. 13/12/20025
Technically Completed
You use this status for WBS elements that are completed from a technical point of view,
but where you still expect costs to accrue. The prerequisite is ‘Created’ or ‘Released’
status must have been set.
In status Technically completed, you can create new subordinate WBS elements (with a
warning). The status is passed on to subordinate WBS elements.
The status allows
o You from assigning networks, production orders or CO orders to the WBS element.
o You to post actual costs
o You to transfer actual costs
You can cancel the Technically completed status. In this case the system sets the
Released status.
Closed Status
You use this status for a work breakdown structure or WBS element that has been
completed from both a logistic and an accounting point of view.
Prerequisite : You can only set the Closed status, if the project definition or the WBS
element have either the Released or the Technically completed status.
In the Closed status you can no longer make any changes to the project hierarchy. The
status is passed on to subordinate WBS elements.
The status allows you to post actual costs to orders and networks that are assigned to the WBS
element, as long as their status permit this
The status prohibits
• You from assigning networks, production orders or CO orders to the WBS element.
• You from posting actual costs to the WBS element
The status deactivates assets in construction that are assigned to the WBS element.
You can cancel the Closed status. In this case the system sets the Technically completed status
In BALCO, the system has been configured to raise purchase requisition automatically once the
WBS elements & Networks are released.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
8. 13/12/20026
DEFINE AUTHORISATION KEY FOR WBS
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Work Breakdown
Structures->WBS User status -> Define authorization key for WBS
In this step you define authorization keys which you can use to set up authorization checks when you
manually set or delete a user status. When the system sets a user status as a reaction to business
transaction, it does not perform an authorization check.
When you set or delete a user status, the system checks whether the user is authorized for this action. In
addition to the status profile and the object type, the system also checks the authorization key assigned
to the user status in question.
In BALCO the following authorization keys have been defined :
Z0000001 -> BALCO: Auth key to sub for approve
Z0000002 -> BALCO :Auth key to approve
Z0000003 -> BALCO: to release WBS/Network

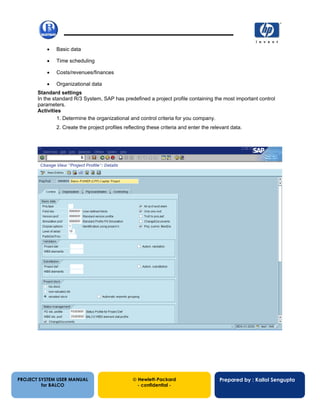

PROJECT PROFILE
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Work Breakdown
Structures->WBS User status -> Create Project Profile
The project profile contains default values and other control parameters such as the planning method for
dates and costs.
In case of BALCO, select Z000002 (Balco -SMELTER Capital Project )
Z000003 (Balco -POWER (CPP) Capital Project)
The project profile contains default values and other control parameters such as the planning method for
dates and costs.
The data that you enter in the project profile will be copied into a project in its project definition or in the
WBS elements which can later be overwritten.
Examples
• To call up the graphic, you must first have specified various graphic profiles in the project profile.
• To carry out cost planning you must specify a planning profile.
• To carry out financial budgeting you must specify a financial planning profile
The values in the project profile determine the functionality of certain areas of the Project System and
cannot be changed without careful thought. Do not change profiles and key from related functions which
are defined in the project profile, such as the costing sheet or the results analysis key. These changes
could effect existing objects.
You must maintain the following sections for the project profile:
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
9. 13/12/20027
• Basic data
• Time scheduling
• Costs/revenues/finances
• Organizational data
Standard settings
In the standard R/3 System, SAP has predefined a project profile containing the most important control
parameters.
Activities
1. Determine the organizational and control criteria for you company.
2. Create the project profiles reflecting these criteria and enter the relevant data.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
11. 13/12/20029
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta

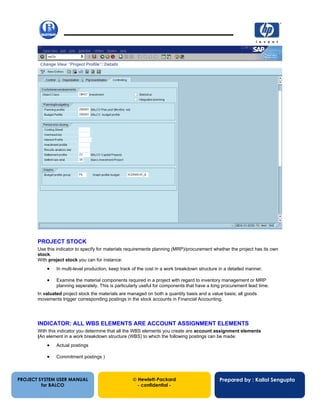

PROJECT STOCK
Use this indicator to specify for materials requirements planning (MRP)/procurement whether the project has its own
stock.
With project stock you can for instance:
• In multi-level production, keep track of the cost in a work breakdown structure in a detailed manner.
• Examine the material components required in a project with regard to inventory management or MRP
planning seperately. This is particularly useful for components that have a long procurement lead time.
In valuated project stock the materials are managed on both a quantity basis and a value basis; all goods
movements trigger corresponding postings in the stock accounts in Financial Accounting.
INDICATOR: ALL WBS ELEMENTS ARE ACCOUNT ASSIGNMENT ELEMENTS
With this indicator you determine that all the WBS elements you create are account assignment elements
(An element in a work breakdown structure (WBS) to which the following postings can be made:
• Actual postings
• Commitment postings )
12. 13/12/200210
INDICATOR: WBS CAN ONLY HAVE ONE WBS ELEMENT WITH LEVEL 1
Use this indicator to specify that there can only be one WBS element at the first level (root) for each project definition
WBS SCHEDULING PROFILE :
The indicator is copied as a default value from the project profile; it can be changed in the control data when you
create a project. It is valid for all WBS elements.
The system calculates the scheduled start and finish of the activities in the WBS elements, their capacity
requirements, and the float times, when the work breakdown structure (WBS) is scheduled.
The start and finish dates of the WBS elements are the basis for determining the scheduled dates.
SCHEDULING SCENARIO
The following scheduling scenarios are avaialable :
• Top-Down Scenario (2)
The scheduling dates are defined by top hierarchy elements, that is the project definition or the
WBS elements, and limit the dates of the activities. The dates of the activities must lie within the
basic dates of the WBS elements to which the activities are assigned. Similarly the basic dates of
a WBS element must be within the basic dates of its superior WBS element.
• Bottom-Up Scenario (1)
The dates are passed on from the bottom of the hieratrchy to the top, that is from the activities to
the corresponding WBS elements and then up through the hierarchy to the project definition. The
dates of the superior WBS element are checked to see whether they include the dates of the
subordinate activity or WBS element. If this is not the case, the basic dates of the superior WBS
element or project definition are changed correspondingly.
If no activities or other WBS elements are assigned to a WBS element, the system uses the basic
dates of the WBS elementa as scheduled dates.
• Free scheduling ( )
You can choose the scheduling parameters as you like.
INDICATOR: READ PROJECT WITH ACTIVITIES
You can use this indicator to determine whether all activities in the WBS elements will be read in when
the Project Builder, time scheduling, structure planning or the project planning board is activated.
You can improve the performance of the system by not setting this indicator for projects that contain a lot
of activities
PLANNING METHOD FOR PROJECT BASIC DATES
To plan basic dates you must specify a planning method. This only to the work breakdown striucture and
not to activities:
• In Top Down Planning you plan the dates starting from the top WBS element in the hierarchy.
The dates that you maintain in the subordinate WBS elements must lie within the dates periods of
the superior WBS elements.
• In Bottom Up Planning you plan the dates starting from the subordinate WBS elements. The
dates of the superior WBS elements are only changed, if thery do not include the dates of the
subordinate WBS elements.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
13. 13/12/200211
• In Strict Bottom Up Planning you specify that the dates of subordinate WBS elements
determine the dates of the superior elements. If you have already entered dates for the superior
WBS elements, the system deletes them, and calculates new dates based on the dates of the
subordinate WBS elements.
• In Free Planning you plan the dates without hierarchical dependencies.
DEFINITION: OBJECT CLASS
CONTROLLING (CO)
The object class categorizes Controlling objects according to their business function and enables you to
analyze cost flows within Controlling from different business perspectives.
The following object classes are available:
• Overhead
• Production
• Investment
• Profitability analysis and sales
While certain object types automatically belong to a particular class (for example, cost centers belong to
the "Overhead" class), others need to be explicitly assigned to an object class in their master record (this
is the case with internal orders and work breakdown structure elements, for example).
In addition to the functional area, the object class is required to determine or explain certain values in the
external accounting components.
DEFINITION: SETTLEMENT PROFILE
A requirement for creating a settlement rule.
You define the following parameters in the settlement profile:
• Allowed settlement receivers (such as cost center or asset)
• Default values for the settlement structure and the PA transfer structure
• Allocation bases for defining the settlement shares (using percentages or equivalence numbers -
or both)
• Maximum number of distribution rules
• Residence period of the settlement documents
• Document type for settlements relevant to accounting (more specifically, to the balance sheet)
• Definitions for the settlement of actual costs or the cost of sales
STRATEGY FOR DETERMINING SETTLEMENT RULE IN WBS ELEMENT
Key describing the strategy for generating settlement rules automatically in WBS elements.
You use the strategy to determine the following for each settlement parameter:
• Control parameters for the objects to which the strategy applies, such as billing elements
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
14. 13/12/200212

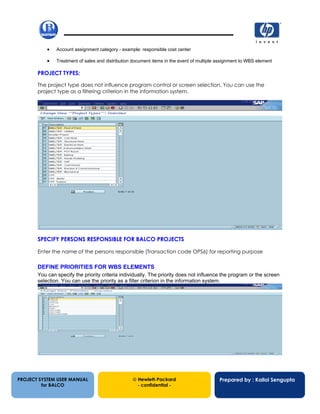

• Account assignment category - example: responsible cost center
• Treatment of sales and distribution document items in the event of multiple assignment to WBS element
PROJECT TYPES:
The project type does not influence program control or screen selection. You can use the
project type as a filtering criterion in the information system.
SPECIFY PERSONS RESPONSIBLE FOR BALCO PROJECTS
Enter the name of the persons responsible (Transaction code OPS6) for reporting purpose
DEFINE PRIORITIES FOR WBS ELEMENTS
You can specify the priority criteria individually. The priority does not influence the program or the screen
selection. You can use the priority as a filter criterion in the information system.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
15. 13/12/200213

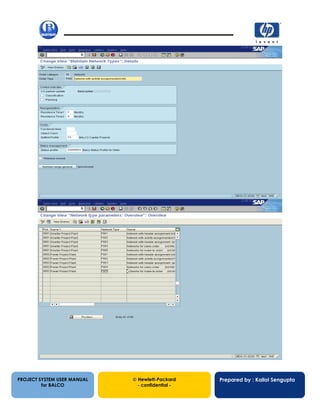

NETWORKS
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Network
MAINTAIN AUTHORIZATION KEY FOR NETWORKS
In this step you define authorization keys which you can use to set up authorization checks when you manually set
or delete a user status. When the system sets a user status as a reaction to business transaction, it does not perform
an authorization check.
When you set or delete a user status, the system checks whether the user is authorized for this action. In addition to
the status profile and the object type, the system also checks the authorization key assigned to the user status in
question.
Example
You want to define that certain user statuses can be changed only by a specified employee group.
To do this, create an authorization key and assign it to the relevant user statuses.
In the general authorization maintenance you can then assign authorizations for this key via the authorization
object B_USERSTAT.
Activities
1. Check whether you want to define authorizations for your user statuses.
2. If necessary, create authorization keys as follows:
a) Choose "New entries".
b) Enter a key and an explanatory text in the appropriate fields and choose "Save".
You have now created the authorization key.
3. Assign the authorization key to one or more user statuses in your status profile.
4. Define corresponding authorizations and include them in the relevant authorization profiles.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
16. 13/12/200214
SETTINGS FOR NETWORK
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Network-> Settings for
network -> Maintain network types
The network type contains information for controlling and managing networks.
In the SAP System, the network is a special form of the work order which has a structure in common with
production, maintenance and inspection orders.
Every network you create must have a network type allocated to it.
The network type determines:
• the order category
• the CO (controlling) partner update
With the indicator, you specify whether a summary record should be written per network if a CO
partner object (for example, cost center) is settled with a network of this type.
• whether the network is used for planning and does not add to the assigned values
• residence times 1 and 2 for the archival and deletion of networks
• a default value for the settlement profile
• a default value for a status profile, if you want to use the user status in status management
• allocation of the network type to a number range
You have to allocate a number range to every network type.
Note
In addition to the general parameters at plant level, the network also requires parameters at plant level,
showing, for example, whether the network is header-assigned or activity assigned. You maintain these
parameters in the step "Define parameters for networks".
Requirements
You must have already processed the menu option "Number range".
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
18. 13/12/200216
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta

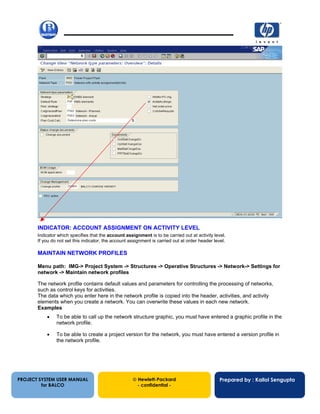

INDICATOR: ACCOUNT ASSIGNMENT ON ACTIVITY LEVEL
Indicator which specifies that the account assignment is to be carried out at activity level.
If you do not set this indicator, the account assignment is carried out at order header level.
MAINTAIN NETWORK PROFILES
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Network-> Settings for
network -> Maintain network profiles
The network profile contains default values and parameters for controlling the processing of networks,
such as control keys for activities.
The data which you enter here in the network profile is copied into the header, activities, and activity
elements when you create a network. You can overwrite these values in each new network.
Examples
• To be able to call up the network structure graphic, you must have entered a graphic profile in the
network profile.
• To be able to create a project version for the network, you must have entered a version profile in
the network profile.
20. 13/12/200218

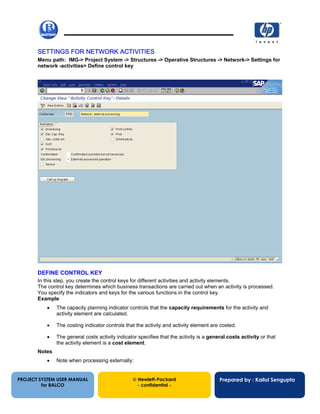

SETTINGS FOR NETWORK ACTIVITIES
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Network-> Settings for
network -activities> Define control key

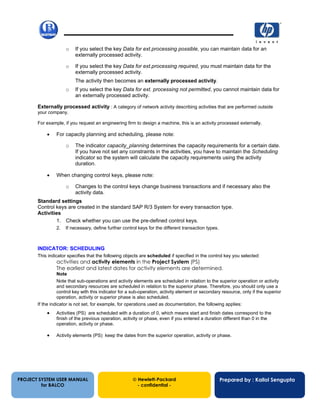

DEFINE CONTROL KEY
In this step, you create the control keys for different activities and activity elements.
The control key determines which business transactions are carried out when an activity is processed.
You specify the indicators and keys for the various functions in the control key.
Example
• The capacity planning indicator controls that the capacity requirements for the activity and
activity element are calculated.
• The costing indicator controls that the activity and activity element are costed.
• The general costs activity indicator specifies that the activity is a general costs activity or that
the activity element is a cost element.
Notes
• Note when processing externally:
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
21. 13/12/200219
o If you select the key Data for ext.processing possible, you can maintain data for an
externally processed activity.
o If you select the key Data for ext.processing required, you must maintain data for the
externally processed activity.
The activity then becomes an externally processed activity.
o If you select the key Data for ext. processing not permitted, you cannot maintain data for
an externally processed activity.
Externally processed activity : A category of network activity describing activities that are performed outside
your company.
For example, if you request an engineering firm to design a machine, this is an activity processed externally.
• For capacity planning and scheduling, please note:
o The indicator capacity_planning determines the capacity requirements for a certain date.
If you have not set any constraints in the activities, you have to maintain the Scheduling
indicator so the system will calculate the capacity requirements using the activity
duration.
• When changing control keys, please note:
o Changes to the control keys change business transactions and if necessary also the
activity data.
Standard settings
Control keys are created in the standard SAP R/3 System for every transaction type.
Activities
1. Check whether you can use the pre-defined control keys.
2. If necessary, define further control keys for the different transaction types.
INDICATOR: SCHEDULING
This indicator specifies that the following objects are scheduled if specified in the control key you selected:
activities and activity elements in the Project System (PS)
The earliest and latest dates for activity elements are determined.
Note
Note that sub-operations and activity elements are scheduled in relation to the superior operation or activity
and secondary resources are scheduled in relation to the superior phase. Therefore, you should only use a
control key with this indicator for a sub-operation, activity element or secondary resource, only if the superior
operation, activity or superior phase is also scheduled.
If the indicator is not set, for example, for operations used as documentation, the following applies:
• Activities (PS) are scheduled with a duration of 0, which means start and finish dates correspond to the
finish of the previous operation, activity or phase, even if you entered a duration different than 0 in the
operation, activity or phase.
• Activity elements (PS) keep the dates from the superior operation, activity or phase.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
22. 13/12/200220

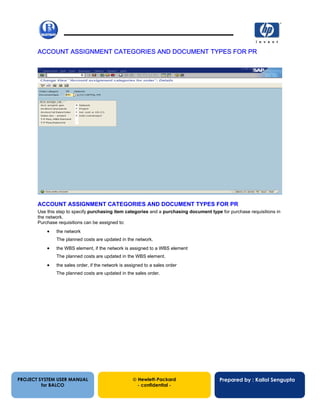

ACCOUNT ASSIGNMENT CATEGORIES AND DOCUMENT TYPES FOR PR
ACCOUNT ASSIGNMENT CATEGORIES AND DOCUMENT TYPES FOR PR
Use this step to specify purchasing item categories and a purchasing document type for purchase requisitions in
the network.
Purchase requisitions can be assigned to:
• the network
The planned costs are updated in the network.
• the WBS element, if the network is assigned to a WBS element
The planned costs are updated in the WBS element.
• the sales order, if the network is assigned to a sales order
The planned costs are updated in the sales order.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
23. 13/12/200221
CHANGE MANAGEMENT :
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Network-> Define
change profile
For BALCO, Change profile ZS0001 has been created.
You use this profile to determine how configuration changes in networks are treated.
The parameters are divided into following groups:
• Settings
Here you define whether the necessary changes steps are executed all together or whether individual steps
can be executed.
• Handling conflict situations
You can specify whether particular situations for an action constitute a conflict and whether this conflict has
informative character or a warning or an error is issued.
The actions change, delete, create or reassign for objects activity, activity element, componnent or PRT are
taken into consideration. The situation can also be handled differently, depending on the status of the object,
for whether the (superior) activity has been released, partially confirmed or finally confirmed.
Activities
1. Define the profile for configuration change management for networks.
2. Assign the profiles to:
o Materials (material master: tab page Work Scheduling)
and/or
o Network types
If you create a project using assembly processing, the profile in the material master is used first; if no profile has been
entered in the material master, the profile is taken from the network type.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
26. 13/12/200224

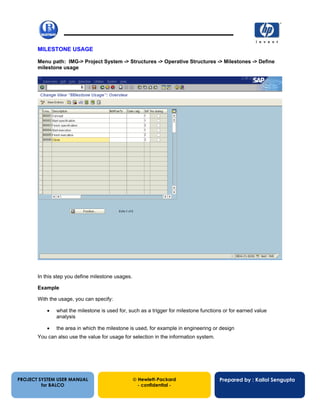

MILESTONE USAGE
Menu path: IMG-> Project System -> Structures -> Operative Structures -> Milestones -> Define
milestone usage
In this step you define milestone usages.
Example
With the usage, you can specify:
• what the milestone is used for, such as a trigger for milestone functions or for earned value
analysis
• the area in which the milestone is used, for example in engineering or design
You can also use the value for usage for selection in the information system.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
27. 13/12/200225

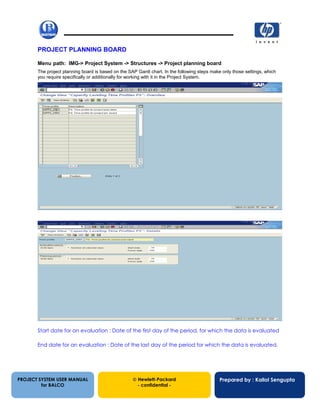

PROJECT PLANNING BOARD
Menu path: IMG-> Project System -> Structures -> Project planning board
The project planning board is based on the SAP Gantt chart. In the following steps make only those settings, which
you require specifically or additionally for working with it in the Project System.
Start date for an evaluation : Date of the first day of the period, for which the data is evaluated
End date for an evaluation : Date of the last day of the period for which the data is evaluated.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
28. 13/12/200226

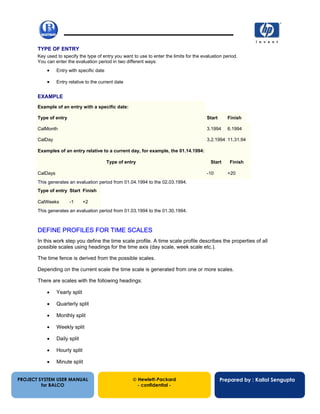

TYPE OF ENTRY
Key used to specify the type of entry you want to use to enter the limits for the evaluation period.
You can enter the evaluation period in two different ways:
• Entry with specific date
• Entry relative to the current date
EXAMPLE
Example of an entry with a specific date:
Type of entry Start Finish
CalMonth 3.1994 6.1994
CalDay 3.2.1994 11.31.94
Examples of an entry relative to a current day, for example, the 01.14.1994:
Type of entry Start Finish
CalDays -10 +20
This generates an evaluation period from 01.04.1994 to the 02.03.1994.
Type of entry Start Finish
CalWeeks -1 +2
This generates an evaluation period from 01.03.1994 to the 01.30.1994.
DEFINE PROFILES FOR TIME SCALES
In this work step you define the time scale profile. A time scale profile describes the properties of all
possible scales using headings for the time axis (day scale, week scale etc.).
The time fence is derived from the possible scales.
Depending on the current scale the time scale is generated from one or more scales.
There are scales with the following headings:
• Yearly split
• Quarterly split
• Monthly split
• Weekly split
• Daily split
• Hourly split
• Minute split
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
29. 13/12/200227

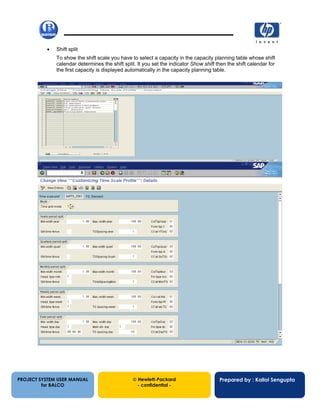

• Shift split
To show the shift scale you have to select a capacity in the capacity planning table whose shift
calendar determines the shift split. It you set the indicator Show shift then the shift calendar for
the first capacity is displayed automatically in the capacity planning table.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
30. 13/12/200228
DEFINE SCALE FOR THE TIME AXIS
In this step you define
• the scale for the various segments on the time axis (see next section)
• whether when the capacity planning table is called up the non-work times that are common to all capacities
are hidden.
Segments of the time scale:
In the capacity planning table you see a segment of the (infinite) time scale. This segment is defined by the
evaluation period in the time profile. You define the time scale of the time axis for the following segments:
• Pre-evaluation period
This represents the period between the start of the evaluations until the start of planning.
• Planning period
This represents the period between the start and the end of planning.
• Post-evaluation period
This represents the period between end of planning and end of evaluation.
A scale is defined as the length per unit of time e.g. 40 mm per day.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
31. 13/12/200229
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
SCALE FACTOR EVALUATION LEAD PERIOD/PLANNING PERIOD
Gives the relationship between the scale for the pre-evaluation period and that for the planning period. The
relationship is shown in percentage terms.
EXAMPLES
You selected 40 mm (=4 cm) per day as a scale for the planning period. If you now enter 20.00 (%) as the
relationship then the scale for the evaluation lead-time is: 40 mm * 20 % = 8 mm, that is, 0.8 cm per day.
LENGTH PER UNIT OF TIME FOR THE EVALUATION
Value giving the length over which a unit of time of the evaluation preliminary lead-time is displayed.
DEFINE PROFILES FOR THE PROJECT PLANNING BOARD
Menu path: IMG-> Project System -> Structures -> Project planning board -> Define profiles for
the Project Planning Board
You can maintain different values in the profile of the project planning board:
• Default values
Default values are copied when you call up the project planning board and you can change them
interactively once you're in the project planning board at any time.
• Graphics profile
A graphics profile must exist in order for you to be able to call up the project planning board. The graphics
profile has a name and a group and is composed of several simple profiles for colors and forms, for
example.
You can maintain the graphics profile in Customizing for all SAP graphics.
• Fields that are displayed in the table area of the project planning board
You can group all fields to be displayed in the table area into a profile.
32. 13/12/200230

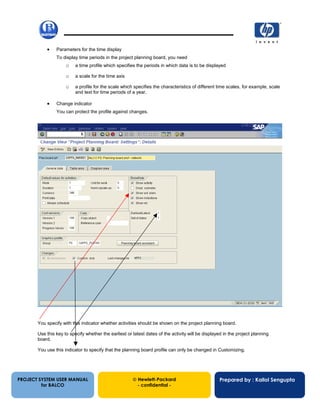

• Parameters for the time display
To display time periods in the project planning board, you need
o a time profile which specifies the periods in which data is to be displayed
o a scale for the time axis
o a profile for the scale which specifies the characteristics of different time scales, for example, scale
and text for time periods of a year.
• Change indicator
You can protect the profile against changes.
You specify with this indicator whether activities should be shown on the project planning board.
Use this key to specify whether the earliest or latest dates of the activity will be displayed in the project planning
board.
You use this indicator to specify that the planning board profile can only be changed in Customizing.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
33. 13/12/200231
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
Description that should appear to the left of the date bar in the Gantt chart.
34. 13/12/200232

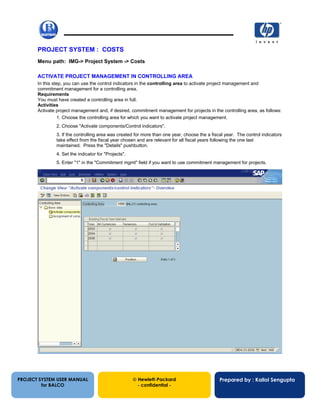

PROJECT SYSTEM : COSTS
Menu path: IMG-> Project System -> Costs
ACTIVATE PROJECT MANAGEMENT IN CONTROLLING AREA
In this step, you can use the control indicators in the controlling area to activate project management and
commitment management for a controlling area.
Requirements
You must have created a controlling area in full.
Activities
Activate project management and, if desired, commitment management for projects in the controlling area, as follows:
1. Choose the controlling area for which you want to activate project management.
2. Choose "Activate components/Control indicators".
3. If the controlling area was created for more than one year, choose the a fiscal year. The control indicators
take effect from the fiscal year chosen and are relevant for all fiscal years following the one last
maintained. Press the "Details" pushbutton.
4. Set the indicator for "Projects".
5. Enter "1" in the "Commitment mgmt" field if you want to use commitment management for projects.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
35. 13/12/200233
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
MAINTAIN CURRENCY EXCHANGE RATES FOR PROJECTS
Note : It will be maintained by BALCO FINANCE department.
Transaction code : OB08
You use this step to stipulate how currencies are translated.
The exchange rates are required for plan and actual postings to, among other things:
• translate foreign currency amounts on posting or clearing
• verify rates entered manually
• determine the profit/loss on exchange rate differences
• value open items in foreign currency
• value foreign currency account balances
• determine the controlling area currency equivalents of amounts posted in different
company code currencies

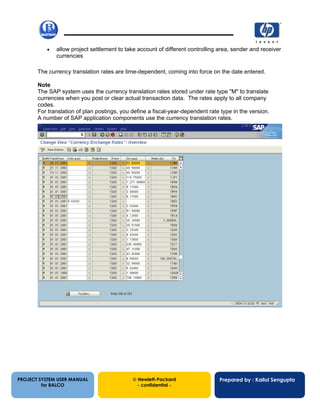

36. 13/12/200234
• allow project settlement to take account of different controlling area, sender and receiver
currencies
The currency translation rates are time-dependent, coming into force on the date entered.
Note
The SAP system uses the currency translation rates stored under rate type "M" to translate
currencies when you post or clear actual transaction data. The rates apply to all company
codes.
For translation of plan postings, you define a fiscal-year-dependent rate type in the version.
A number of SAP application components use the currency translation rates.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
37. 13/12/200235

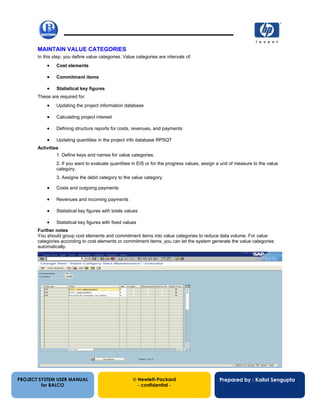

MAINTAIN VALUE CATEGORIES
In this step, you define value categories. Value categories are intervals of:
• Cost elements
• Commitment items
• Statistical key figures
These are required for:
• Updating the project information database
• Calculating project interest
• Defining structure reports for costs, revenues, and payments
• Updating quantities in the project info database RPSQT
Activities
1. Define keys and names for value categories.
2. If you want to evaluate quantities in EIS or for the progress values, assign a unit of measure to the value
category.
3. Assigne the debit category to the value category.
• Costs and outgoing payments
• Revenues and incoming payments
• Statistical key figures with totals values
• Statistical key figures with fixed values
Further notes
You should group cost elements and commitment items into value categories to reduce data volume. For value
categories according to cost elements or commitment items, you can let the system generate the value categories
automatically.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
38. 13/12/200236
ASSIGN COST ELEMENTS TO VALUE CATEGORIES
In this step, you define a cost element, a cost element interval or a cost element group as a value
category.
Recommendation
The check for whether cost elements exist is faster if you enter a cost element interval rather than a cost
element group.
Activities
1. Choose a value category and access the detail screen.
2. Define a cost element, a cost element interval or cost element group as the value category.
ADDITIONAL HINTS
If you change the value categories later, you will have to reconstruct the project information database
(transaction CJEN) if plan data already exists. This is necessary to avoid data inconsistencies.
Value categories can be created automatically. To do this, go to the implementation guide and choose
Information System -> General Functions -> Project Info Database -> Set update control.
When value categories are automatically created, a value category is created for each posted cost
element with the same description. For example, if you post cost element 415000, the system creates
value category 415000.
EASY COST PLANNING AND EXECUTION SERVICES
Easy cost planning is method of costing that enables costs to be planned quickly and easily for objects
such as Work breakdown structure elements
CREATE COSTING VARIANT
You can use costing variants to combine all the controlling parameters for costing.
The costing variant represents the link between the application and customizing because all costings must reference
a costing variant as they are made and stored.
The costing variant controls how the costing is to be carried out. With it, you control:
• Whether the costing results are to be regarded as plan costs or actual costs
• Which prices are used to value the materials, internal activities and external activities
• How overhead surcharges are calculated
The following are part of the costing variant:
• costing type 08 for the project unit costing
• valuation variant
Note
It is technically possible to have more the same costing type and valuation variant in more than one costing variant,
but you should avoid this because it can lead to one variant overwriting the data for another.
The reason for this is the key format for costing results in the database. This key form is based on the costing type
and valuation variant, no the costing variant.
Standard Settings
The SAP standard system contains a number of predefined costing variants
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
39. 13/12/200237
SAP Recommendation
When you use Easy Cost Planning, we recommend you use costing variant PS06, which we deliver as standard.
Assign a different valuation variant to each of the costing variants you want to use to store costings. If you do this,
you will subsequently be able to change the valuation strategies as and when you want.
Activities
1. Enter an alpha-numeric key and an appropriate short text for the costing variant.
2. In the detail screen, assign a costing type and a valuation variant to the costing variant.
If you want to use your own paramters, you must carry out the steps Define costing types and Define
valuation variants.
3. If you are using the costing variant for a model costing, you stipulate whether cost elements have to be
assigned to the costing items. The costs for other reference objects in the unit costing must be totaled using
cost elements.
Further notes
You need the costing variant for:
• The costing (plan costs) and cost determination (actual costs) for networks and network activities.
Store two costing variants: one for plan costs and one for actual costs
o As default values for the application in the Project System implementation guide in the network
parameters for the network type
o In the application, in the extras for the network header (if you did not define a costing variant in the
network parameters
In the network header data, choose Goto -> Network header -> Supplement.
• The unit costing for projects or WBS elements
You define the costing variant:
o As a default value for the application in the cost planning profile
o In the application, when you access the unit costing from structure- oriented cost planning
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
40. 13/12/200238
ASSIGN PLAN PROFILE TO COSTING VARIANT
In this process step you assign the costing variant to the plan profile.
This assignment determines how the system costs and valuates a project with the appropriate plan profile.
You should bear in mind that the system uses the costing variant from the plan profile only as a default value. You
can override this assignment when you create the cost estimate by entering a different costing variant.
Activities
Assign a costing variant to the plan profile.
ASSIGN PLAN PROFILE TO PROJECT PROFILE
In this step, you assign the plan profile to the project profile.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
41. 13/12/200239
MANUAL COST PLANNING IN WBS
In this step, you enter the settings, which enable you to plan costs manually in the WBS element. You can
choose the following planning forms in the Project System:
• Hierarchy planning
o Costs (cost-element independent)
• Detailed planning
o Primary costs
o Activity input
o Statistical key figures
o Overhead
• unit costing
Menu path: IMG-> Project System -> Costs -> Planned Costs -> Manual Cost planning in
WBS -> Hierarchical Cost Planning
In this step, you enter the settings for structure planning.
CREATE/CHANGE PLANNING PROFILE
In this step, you create new plan profiles or maintain existing ones.
You need planning profiles for the planning methods below:
• Overall planning for internal orders
• Hierarchy cost planning for projects
• Preliminary costing for production orders that do not have a quantity structure (CO production orders).
• Cost planning for investment programs or investment measures, and for appropriation requests.
• Financial budgeting
You can create new planning profiles, or change existing ones.
The following settings are important:
• Time frame
You can specify which values are to be planned, and in which fiscal years.
• Value display
You can specify which standard view the system is to display with the plan value, when you call up the initial
screen for planning. You can default the number of decimal places and the display factor.
• Detail planning
This is where you store default values for cost element planning, activity input planning, and unit costing.
You use the plan profile to regulate the following project-specific settings:
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
42. 13/12/200240
• Planning on all WBS elements or only on planning elements
• Bottom-Up planning within hierarchical planning
• Automatic revenue planning
You can decide whether the system updates plan revenues on the corresponding billing elements. Where
necessary, the same applies to plan payments from sales documents that have been assigned to projects.
Prerequisites
To include the following as default values in planning, you need to do the following IMG activites and maintain the
parameters.
• Maintain Cost Element Groups
o Primary costs
o Revenues
• To plan activity input
o Maintain Cost Center Groups
o Maintain Activity Types
o Maintain Activity Type Groups
• Maintain Statistical Key Figure Groups
• For unit costing
Create Costing Variant
Activities
Activities
1. Check the planning profiles provided by the SAP standard.
2. If necessary, change the detail settings for the existing planning profiles. Alternatively, create new
planning profiles by choosing "New entries".
3. Assign the planning profile to an order type, program type, appropriation request type, project or FM area.
ADDITIONAL INFORMATION
You can assign planning profiles to a project as follows:
o As a default value in the Implementation Guide (IMG) for the Project System
- In the project profile of a project definition (operative structures)
- In the project profile of a standard project definition (basic data)
o In the application menu for the project system
o In the control data of the project definition, if there is planning profile was stored in the project
profile (In the maintenance screen for the project definition, choose "Detail -> Control").
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
43. 13/12/200241
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
Now Assign plan profile of BALCO to project profile of BALCO
44. 13/12/200242

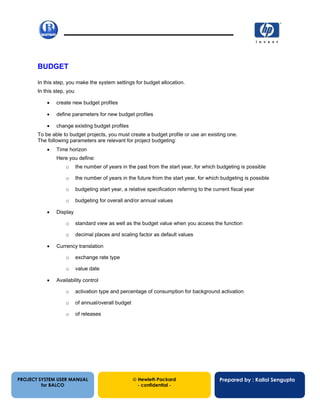

BUDGET
In this step, you make the system settings for budget allocation.
In this step, you
• create new budget profiles
• define parameters for new budget profiles
• change existing budget profiles
To be able to budget projects, you must create a budget profile or use an existing one.
The following parameters are relevant for project budgeting:
• Time horizon
Here you define:
o the number of years in the past from the start year, for which budgeting is possible
o the number of years in the future from the start year, for which budgeting is possible
o budgeting start year, a relative specification referring to the current fiscal year
o budgeting for overall and/or annual values
• Display
o standard view as well as the budget value when you access the function
o decimal places and scaling factor as default values
• Currency translation
o exchange rate type
o value date
• Availability control
o activation type and percentage of consumption for background activation
o of annual/overall budget
o of releases
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
45. 13/12/200243
In the project budget profile, the "Overall" indicator, working in conjunction with the "Releases"
indicator, has the following effect:
Ind. "Overall" Ind. "Releases" Avail. control against...
X X Released overall budget
- X Released annual budget
X - Overall budget
- - Annual budget
The activation type controls availability control. There are three activation types:
0 = cannot activate
This activity type may cause an already active availability control to be deactivated.
1 = automatic activation when budget is assigned
You must maintain at least one tolerance limit for the budget profile.
2 = background activation when percentage of consumption is exceeded
You must enter a percentage of consumption in background activation. The percentage of
consumption represents the relationship of committed funds to the budget as a percentage.
You must maintain at least one tolerance limit for the budget profile to have the system check the
posting.
Note
o If you change the availability control configuration after budgeting, you should have the
system recalculate the assigned values.
To do this, restart availability control for your project.
o If you are also using the Funds Management component, you can greatly improve
performance by only activating availability control in Funds Management or only
activating it for projects.
Activity
1. Use "Details" to check the standard budget profiles delivered with the system.
2. Change the detail settings for the budget profiles or create budget profiles using "New entries".
Additional information
You can assign a budget profile to a project
• as a default value in Project System configuration
o in the project profile for a project definition (operative structures)
o in the project profile for a standard project definition (basic data)
• in the Project System application menu
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
46. 13/12/200244
o in the control data for the project definition (Operative structures menu, Work breakdown
struc -> Change -> Project definition, Details -> Organization -> Plan profile
STIPULATE DEFAULT BUDGET PROFILE FOR PROJECT DEFINITION
In this step, you assign the budget profile to the project profile.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
47. 13/12/200245

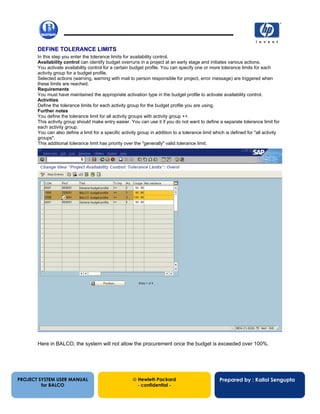

DEFINE TOLERANCE LIMITS
In this step you enter the tolerance limits for availability control.
Availability control can identify budget overruns in a project at an early stage and initiates various actions.
You activate availability control for a certain budget profile. You can specify one or more tolerance limits for each
activity group for a budget profile.
Selected actions (warning, warning with mail to person responsible for project, error message) are triggered when
these limits are reached.
Requirements
You must have maintained the appropriate activation type in the budget profile to activate availability control.
Activities
Define the tolerance limits for each activity group for the budget profile you are using.
Further notes
You define the tolerance limit for all activity groups with activity group ++.
This activity group should make entry easier. You can use it if you do not want to define a separate tolerance limit for
each activity group.
You can also define a limit for a specific activity group in addition to a tolerance limit which is defined for "all activity
groups".
This additional tolerance limit has priority over the "generally" valid tolerance limit.
Here in BALCO, the system will not allow the procurement once the budget is exceeded over 100%.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
48. 13/12/200246
MATERIAL PROCUREMENT
In this section you set up the system for procuring materials:
• You can define combinations of settings for component procurement that are frequently used, so that you do
not have to maintain these settings for each component.
• You can check the following settings:
o Account assignment types and purchasing document type of the purchase requisitions for networks
o Movement types for goods movements in the Project System
You only have to make changes here, if you do not want to use the SAP standard settings.
• You can activate MRP groups for requirements grouping.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
49. 13/12/200247

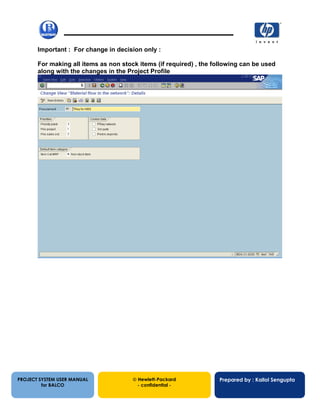

Important : For change in decision only :
For making all items as non stock items (if required) , the following can be used
along with the changes in the Project Profile
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
50. 13/12/200248

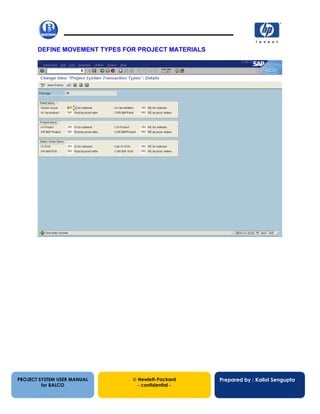

DEFINE MOVEMENT TYPES FOR PROJECT MATERIALS
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
51. 13/12/200249

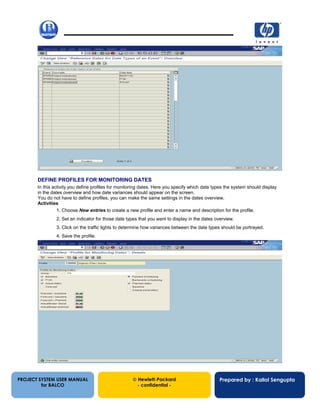

MONITORING DATES
Menu path : Project system -> Material -> Monitoring dates-> Define events
In the following steps you configure the system for Monitoring Dates. You can use this function to define events for
components in a project and to monitor the dates of these events.
DEFINE EVENTS
In this activity you define events for components in a project. You can then monitor dates for this event.
Activities
1. Create a new event by choosing New entries.
2. Enter a name and description for the event.
3. Save the event
ASSIGN REFERENCE DATES TO EVENTS
In this activity you assign a reference date to a date type for an event.
You can use date fields as reference dates. These date fields could, for instance, come from the network activity or a
sales document.
Requirements
You must have already defined the event.
Activities
1. Choose New entries.
2. Enter an event and a date type.
3. Assign a reference date to the date type and event by selecting a table and a field in this table.
If you select Confirmations for purchase order item as the table, an additional field appears in which you
have to enter the Confirmation category.
4. If the assigned reference date is not unique, determine which date the system should use by selecting an
entry in Display.
5. Save your data.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
52. 13/12/200250
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
DEFINE PROFILES FOR MONITORING DATES
In this activity you define profiles for monitoring dates. Here you specify which date types the system should display
in the dates overview and how date variances should appear on the screen.
You do not have to define profiles, you can make the same settings in the dates overview.
Activities
1. Choose New entries to create a new profile and enter a name and description for the profile.
2. Set an indicator for those date types that you want to display in the dates overview.
3. Click on the traffic lights to determine how variances between the date types should be portrayed.
4. Save the profile.
53. 13/12/200251
CONFIRMATION OF WORK
Menu path : Project system -> Confirmation
DEFINE CONFIRMATION PARAMETERS
The configurations for the confirmation are specified for each plant and network type.
You can specify the following parameters:
• when confirming, a final confirmation is automatically proposed
• the dates of the confirmation may lie in the future
• the error log for cost calculation is displayed
• percentages for the allowed deviation from work and duration
Define the confirmation parameters per plant and network type.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
54. 13/12/200252
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
PARTIAL/FINAL CONFIRMATION
Specifies what sort of confirmation is to be automatically proposed.
For automatic final confirmation, the confirmed quantity of the operation or the order (yield qty + rework qty + scrap
qty) determines whether the confirmation is saved as a partial or final confirmation:
• If the confirmed quantity is less than the quantity possible, the confirmation is saved as a partial
confirmation.
• If the confirmed quantity is more than (that is, greater than or equal to) the quantity possible, the
confirmation is saved as a final confirmation.
The quantity possible corresponds to the planned operation or order quantity, or to the confirmed yield of operations
that have been finally confirmed, provided that finally confirmed operations exist.
PROPOSE DATES
Specifies that for the confirmation of operations, the system is to propose the start and finish dates of the individual
operation segments, as calculated by lead time scheduling.
The system differentiates between the proposed dates before the first confirmation and the proposed dates before
all other confirmations:
The following dates are proposed for the first confirmation:
• In the start of work field: The earliest start date of the operation or, if this date is in the future, the current
date with the time
55. 13/12/200253
• In the end of work field: The current date with the time
The following dates are proposed for all other confirmation:
• In the start of work field: The actual finish of the last confirmation
• In the end of work field: The current date with the time

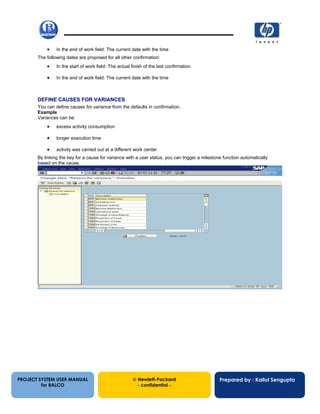

DEFINE CAUSES FOR VARIANCES
You can define causes for variance from the defaults in confirmation.
Example
Variances can be:
• excess activity consumption
• longer execution time
• activity was carried out at a different work center
By linking the key for a cause for variance with a user status, you can trigger a milestone function automatically
based on the cause.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
56. 13/12/200254
PROJECT PROGRESS ANALYSIS
MAINTAIN PROGRESS VERSION
In this step, you maintain the progress version. You define the control data for POC/earned value calculation.
You enter this setting separately for each company code.
Example
Recommendation
Use the standard progress version.
Activities
1. In the section General Version Definition, create a CO version with only the usage progress analysis.
2. Save this version.
3. Select the version and choose Project Progress Analysis Settings.
4. Enter the control data for the progress version and choose Save.
DEFINE STATISTICAL KEY FIGURE FOR PERCENTAGE OF COMPLETION
In this activity, you stipulate the statistical key figures in which the percentages of completion (POCs) are recorded.
You make the settings per controlling area.
A statistical key figure must be assigned so that you can evaluate the POC in reporting.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
57. 13/12/200255

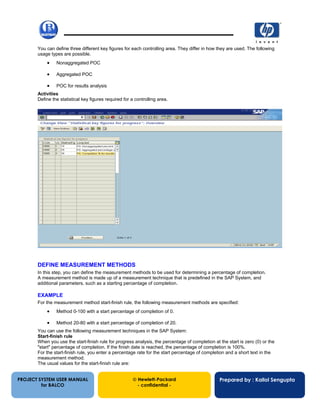

You can define three different key figures for each controlling area. They differ in how they are used. The following
usage types are possible.
• Nonaggregated POC
• Aggregated POC
• POC for results analysis
Activities
Define the statistical key figures required for a controlling area.
DEFINE MEASUREMENT METHODS
In this step, you can define the measurement methods to be used for determining a percentage of completion.
A measurement method is made up of a measurement technique that is predefined in the SAP System, and
additional parameters, such as a starting percentage of completion.
EXAMPLE
For the measurement method start-finish rule, the following measurement methods are specified:
• Method 0-100 with a start percentage of completion of 0.
• Method 20-80 with a start percentage of completion of 20.
You can use the following measurement techniques in the SAP System:
Start-finish rule
When you use the start-finish rule for progress analysis, the percentage of completion at the start is zero (0) or the

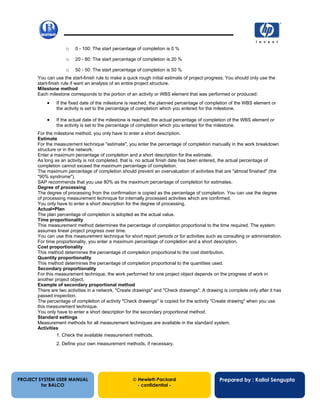

"start" percentage of completion. If the finish date is reached, the percentage of completion is 100%.
For the start-finish rule, you enter a percentage rate for the start percentage of completion and a short text in the
measurement method.
The usual values for the start-finish rule are:
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
58. 13/12/200256
o 0 - 100: The start percentage of completion is 0 %
o 20 - 80: The start percentage of completion is 20 %
o 50 - 50: The start percentage of completion is 50 %
You can use the start-finish rule to make a quick rough initial estimate of project progress. You should only use the
start-finish rule if want an analysis of an entire project structure.
Milestone method
Each milestone corresponds to the portion of an activity or WBS element that was performed or produced:
• If the fixed date of the milestone is reached, the planned percentage of completion of the WBS element or
the activity is set to the percentage of completion which you entered for the milestone.
• If the actual date of the milestone is reached, the actual percentage of completion of the WBS element or
the activity is set to the percentage of completion which you entered for the milestone.
For the milestone method, you only have to enter a short description.

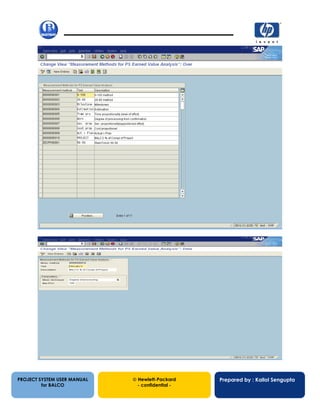

Estimate
For the measurement technique "estimate", you enter the percentage of completion manually in the work breakdown
structure or in the network.
Enter a maximum percentage of completion and a short description for the estimate.
As long as an activity is not completed, that is, no actual finish date has been entered, the actual percentage of
completion cannot exceed the maximum percentage of completion.
The maximum percentage of completion should prevent an overvaluation of activities that are "almost finished" (the
"90% syndrome").
SAP recommends that you use 80% as the maximum percentage of completion for estimates.
Degree of processing
The degree of processing from the confirmation is copied as the percentage of completion. You can use the degree
of processing measurement technique for internally processed activities which are confirmed.
You only have to enter a short description for the degree of processing.
Actual=Plan
The plan percentage of completion is adopted as the actual value.
Time proportionality
This measurement method determines the percentage of completion proportional to the time required. The system
assumes linear project progress over time.
You can use this measurement technique for short report periods or for activities such as consulting or administration.
For time proportionality, you enter a maximum percentage of completion and a short description.
Cost proportionality
This method determines the percentage of completion proportional to the cost distribution.
Quantity proportionality
This method determines the percentage of completion proportional to the quantities used.
Secondary proportionality
For this measurement technique, the work performed for one project object depends on the progress of work in
another project object.
Example of secondary proportional method
There are two activities in a network, "Create drawings" and "Check drawings". A drawing is complete only after it has
passed inspection.
The percentage of completion of activity "Check drawings" is copied for the activity "Create drawing" when you use
this measurement technique.
You only have to enter a short description for the secondary proportional method.
Standard settings
Measurement methods for all measurement techniques are available in the standard system.
Activities
1. Check the available measurement methods.
2. Define your own measurement methods, if necessary.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
60. 13/12/200258

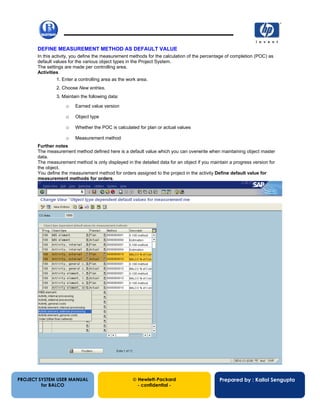

DEFINE MEASUREMENT METHOD AS DEFAULT VALUE
In this activity, you define the measurement methods for the calculation of the percentage of completion (POC) as
default values for the various object types in the Project System.
The settings are made per controlling area.
Activities
1. Enter a controlling area as the work area.
2. Choose New entries.
3. Maintain the following data:
o Earned value version
o Object type
o Whether the POC is calculated for plan or actual values
o Measurement method
Further notes
The measurement method defined here is a default value which you can overwrite when maintaining object master
data.
The measurement method is only displayed in the detailed data for an object if you maintain a progress version for
the object.
You define the measurement method for orders assigned to the project in the activity Define default value for
measurement methods for orders.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
61. 13/12/200259

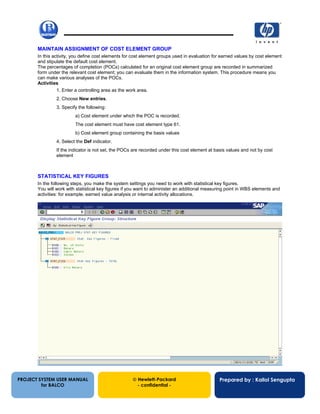

MAINTAIN ASSIGNMENT OF COST ELEMENT GROUP
In this activity, you define cost elements for cost element groups used in evaluation for earned values by cost element
and stipulate the default cost element.
The percentages of completion (POCs) calculated for an original cost element group are recorded in summarized
form under the relevant cost element; you can evaluate them in the information system. This procedure means you
can make various analyses of the POCs.
Activities
1. Enter a controlling area as the work area.
2. Choose New entries.
3. Specify the following:
a) Cost element under which the POC is recorded.
The cost element must have cost element type 61.
b) Cost element group containing the basis values
4. Select the Def indicator.
If the indicator is not set, the POCs are recorded under this cost element at basis values and not by cost
element
STATISTICAL KEY FIGURES
In the following steps, you make the system settings you need to work with statistical key figures.
You will work with statistical key figures if you want to administer an additional measuring point in WBS elements and
activities: for example, earned value analysis or internal activity allocations.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
62. 13/12/200260
ASSIGN STATISTICAL KEY FIGURES TO VALUE CATEGORIES
In this step, you define
statistical key figures as value categories.
Requirements
The value categories must have been maintained. For more information, see Maintain value categories.
MAINTAIN VALUE CATEGORIES
In this step, you define value categories. Value categories are intervals of:
• Cost elements
• Commitment items
• Statistical key figures
These are required for:
• Updating the project information database
• Calculating project interest
• Defining structure reports for costs, revenues, and payments
• Updating quantities in the project info database RPSQT
Activities
1. Select a value category which is allowed for the posting of statistical key figures.
2. Call up the detail screen.
3. Enter a statistical key figure or an interval.
Further notes
Note that the unit of measure for the value category must agree with aggregation processing in the statistical key
figure. For example, if the unit of measure in the value category is HRS; the total value or fixed value in the statistical
key figure must also be HRS.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
63. 13/12/200261
INFORMATION SYSTEM
DEFINE DATABASE SELECTION PROFILES
All data in the information system comes from or is derived from the logical Project System database (PSJ).
You need the profile for this database for all analyses in the Project System.
In the database profile, you determine:
• the project view according to which the selected data is displayed on the screen, for example, sorted
according to profit center.
• the maximum explosion level for the selection.
The level of detail depends on the project view and the selection criteria.
Example: You select the following objects in the database:
o a work breakdown structure that has five hierarchy levels
o a network, including subnetworks, that has four hierarchy levels.
You maintain 5 as a maximum level. In this case, the network objects will not be displayed in the information
system.
• the objects that are selected in the database.
Notes
Once you are within an analysis, you cannot select any more objects from the database.
You determine the scope of selection on the relevant initial screens.
Standard settings
Database profiles are available with the standard R/3 System.
Activities
1. Create a database profile.
2. Enter the database profile in the overall profile.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
65. 13/12/200263

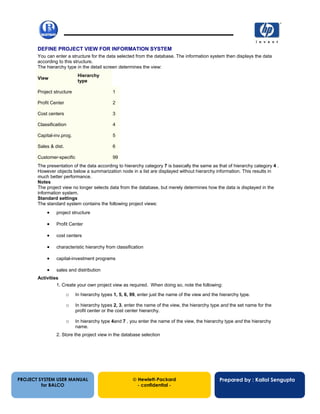

DEFINE PROJECT VIEW FOR INFORMATION SYSTEM
You can enter a structure for the data selected from the database. The information system then displays the data
according to this structure.
The hierarchy type in the detail screen determines the view:
View
Hierarchy
type
Project structure 1
Profit Center 2
Cost centers 3
Classificaition 4
Capital-inv.prog. 5
Sales & dist. 6
Customer-specific 99
The presentation of the data according to hierarchy category 7 is basically the same as that of hierarchy category 4 .
However objects below a summarization node in a list are displayed without hierarchy information. This results in
much better performance.
Notes
The project view no longer selects data from the database, but merely determines how the data is displayed in the
information system.
Standard settings
The standard system contains the following project views:
• project structure
• Profit Center
• cost centers
• characteristic hierarchy from classification
• capital-investment programs
• sales and distribution
Activities
1. Create your own project view as required. When doing so, note the following:
o In hierarchy types 1, 5, 6, 99, enter just the name of the view and the hierarchy type.
o In hierarchy types 2, 3, enter the name of the view, the hierarchy type and the set name for the
profit center or the cost center hierarchy.
o In hierarchy type 4and 7 , you enter the name of the view, the hierarchy type and the hierarchy
name.
2. Store the project view in the database selection
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
67. 13/12/200265

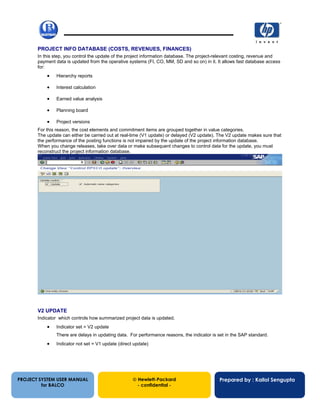

PROJECT INFO DATABASE (COSTS, REVENUES, FINANCES)
In this step, you control the update of the project information database. The project-relevant costing, revenue and
payment data is updated from the operative systems (FI, CO, MM, SD and so on) in it. It allows fast database access
for:
• Hierarchy reports
• Interest calculation
• Earned value analysis
• Planning board
• Project versions
For this reason, the cost elements and commitment items are grouped together in value categories.
The update can either be carried out at real-time (V1 update) or delayed (V2 update). The V2 update makes sure that
the performance of the posting functions is not impaired by the update of the project information database.
When you change releases, take over data or make subsequent changes to control data for the update, you must
reconstruct the project information database.
V2 UPDATE
Indicator which controls how summarized project data is updated.
• Indicator set = V2 update
There are delays in updating data. For performance reasons, the indicator is set in the SAP standard.
• Indicator not set = V1 update (direct update)
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
68. 13/12/200266
CREATE VALUE CATEGORIES AUTOMATICALLY
If this indicator is set, automatically creates a value category for each commitment item or cost element newly posted
to, giving it the same description.
If the indicator is not set, you must maintain the assignment of cost elements and commitment items to value
categories manually. The advantage of doing this is that you can assign groups or ranges of cost
elements/commitment items to one value category. This significantly improves performance.
If you set this indicator after postings have already been made, you must maintain the missing assignments manually
or reconstruct the project information database. Otherwise, no value category is assigned to cost
elements/commitment items to which postings have already been made.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
69. 13/12/200267

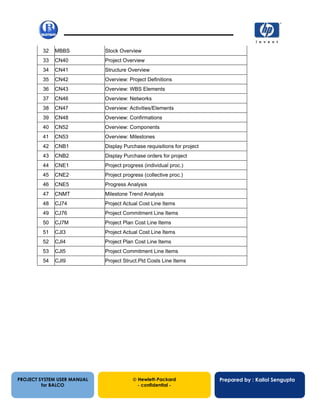

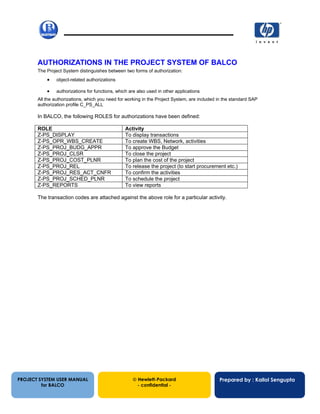

AUTHORIZATIONS IN THE PROJECT SYSTEM OF BALCO
The Project System distinguishes between two forms of authorization:
• object-related authorizations
• authorizations for functions, which are also used in other applications
All the authorizations, which you need for working in the Project System, are included in the standard SAP
authorization profile C_PS_ALL
In BALCO, the following ROLES for authorizations have been defined:
ROLE Activity
Z-PS_DISPLAY To display transactions
Z-PS_OPR_WBS_CREATE To create WBS, Network, activities
Z-PS_PROJ_BUDG_APPR To approve the Budget
Z-PS_PROJ_CLSR To close the project
Z-PS_PROJ_COST_PLNR To plan the cost of the project
Z-PS_PROJ_REL To release the project (to start procurement etc.)
Z-PS_PROJ_RES_ACT_CNFR To confirm the activities
Z-PS_PROJ_SCHED_PLNR To schedule the project
Z-PS_REPORTS To view reports
The transaction codes are attached against the above role for a particular activity.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
70. 13/12/200268
REPORTS FROM PROJECT SYSTEM
1
PS01
Logistics-Project Systems-Information Systems Tree (All
Reports)
2 CN41 - Structure Overview
3 CN42N - Project Definitions
4 CN43N - WBS Elements
5 CN46N - Networks
6 CN47N - Activities
7 CN49N - Relationships
8 CN53N - Milestones
9 S_ALR_87013531 - Costs/Revenues/Expenditures/Receipts
10 S_ALR_87013532 - Plan/Actual/Variance
11 S_ALR_87013533 - Plan/Actual/Commitment/Rem.Plan/Assigned
12 S_ALR_87013534 - Plan 1/Plan 2/Actual/Commitments
13 S_ALR_87013535 - Actual in CO Area/Object/Transaction Currency
14 S_ALR_87013536 - Plan/Actual/Down Payment as Expense
15 S_ALR_87013537 - Commitment Detail
16 S_ALR_87013538 - Project Version Comparison: Actual/Plan
17 S_ALR_87100185 - Actual Costs for Each Month (Current Fiscal Year)
18 S_ALR_87100186 - Planned Costs for Each Month (Current Fiscal Year)
19 S_ALR_87100187 - Commitments for Each Month (Current Fiscal Year)
20 S_ALR_87100188 - Cumulated Actual Costs
21 S_ALR_87100190 - Plan/Actual/Variance for Each Project and Person Respon
22 S_ALR_87013557 - Budget/Actual/Variance
23 S_ALR_87013558 - Budget/Actual/Commitment/Rem Plan/Assigned
24 S_ALR_87013559 - Budget/Distributed/Plan/Distributed
25 S_ALR_87013560 - Budget Updates
26 S_ALR_87100191 - Receipts/Expenditures in Fiscal Year
27 S_ALR_87013573 - Receipts/Expenditures for All Fiscal Years
28 S_ALR_87013575 - Plan/Actual/Commt
29 S_ALR_87013574 - Expenditures
30 me5j Purchase requisitions
31 ME2J Purchase Orders
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
71. 13/12/200269
32 MBBS Stock Overview
33 CN40 Project Overview
34 CN41 Structure Overview
35 CN42 Overview: Project Definitions
36 CN43 Overview: WBS Elements
37 CN46 Overview: Networks
38 CN47 Overview: Activities/Elements
39 CN48 Overview: Confirmations
40 CN52 Overview: Components
41 CN53 Overview: Milestones
42 CNB1 Display Purchase requisitions for project
43 CNB2 Display Purchase orders for project
44 CNE1 Project progress (individual proc.)
45 CNE2 Project progress (collective proc.)
46 CNE5 Progress Analysis
47 CNMT Milestone Trend Analysis
48 CJ74 Project Actual Cost Line Items
49 CJ76 Project Commitment Line Items
50 CJ7M Project Plan Cost Line Items
51 CJI3 Project Actual Cost Line Items
52 CJI4 Project Plan Cost Line Items
53 CJI5 Project Commitment Line Items
54 CJI9 Project Struct.Pld Costs Line Items
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
72. 13/12/200270
TRANSACTION CODES IN PROJECT SYSTEM
1 CJ20n Create Work Breakdown Structure
2 CJ02 Change Work Breakdown Structure
3 CJ06 Create Project Definition
4 CJ07 Change Project Definition
5 CJ11 Create WBS Element
6 CJ12 Change WBS Element
7 CJ20 Structure planning : Change
8 CJ20N Project Builder
9 CJ21 Change Basic Dates
10 CJ25 Change Actual Dates
11 CJ27 Project planning board
12 CJ2B Change project planning board
13 CJ2D Structure planning : Create
14 CJ40 Change Project Plan
15 CJ91 Create Standard WBS
16 CJ92 Change Standard WBS
17 CJ9BS Copy Project Planning
18 CJ9CS Copy Project Actual Data to Plan
19 CJ9D Copy Plan Versions
20 CJR2 PS: Change plan CElem/Activ. input
21 CJR4 PS: Change plan primary cost element
22 CJSG Generate WBS Element Group
23 CN01 Create standard network
24 CN02 Change standard network
25 CN04 Edit PS Text Catalog
26 CN11 Create standard milestone
27 CN12 Change standard milestone
28 CN21 Create Network
29 CN22 Change Network
30 CN24 Overall Network Scheduling
31 CN25 Confirm Completions in Network
32 CN27 Collective confirm.
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
73. 13/12/200271
PROJECT SYSTEM USER MANUAL
for BALCO
Hewlett-Packard
- confidential -
Prepared by : Kallol Sengupta
33 CN29 Cancel Network Confirmation
34 CJ30 Change Original Budget
35 CJ34 Transfer Project Budget
36 CJ35 Return Budget from Project
37 CJ36 Supplement Budget to Project
38 CJ37 Budget Supplement in Project
39 CJ38 Return Budget in Project
40 CJ3A Change Budget Document
41 ME51 PR Creation
42 CJ88 Individual settlement for relevant WBS
43 CJ02 Change relevant WBS status to "PTU"
44 CJ02 Change relevant WBS status to "TECO"
45 AIAB Maintence of settlement rule for AUC
46 AIBU Settle AUC to Fixed Asset
