Project Management for Every Size IT Project
         Vonnie (Yvonne) Simonsen, PMP

             Ames Research Center
               Code I Directorate
           Project Management Office

                                         Used with Permission
Topic Overview

         The NASA Ames Research Center OCIO has developed and
       implemented a scaled approach (Lite/Medium frameworks) to
          Project Management utilizing NPR 7120.7 as the basis.

  The Lite and Medium project classifications provide flexibility in
 managing projects with the added benefit of structure, templates,
                   and on line training modules.

PM Challenge: February 2010                                        2
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                3

Why a Scaled Project Lifecycle Framework?
Why did we need a scalable Project Framework?
   PROBLEM
   • Project Managers were not provided a common project management framework to follow for
       projects below the NPR 7120.7 thresholds. A standardized, consistent, holistic project
       management approach did not exist.
   • Management did not have an integrated standard view of projects across the Directorate and
       associated resource allocation data.
   SOLUTION
   • Develop and implement a scalable Project Framework that emulates project management best
       practices for projects below the NPR 7120.7 threshold.

                                                       DIRECTORATE
                                                        IT PROJECTS
                 $500k and Over: Projects are                           Under $500k: Projects are
                 required to follow the NPR 7120.7                      required to follow the Code I
                 project management structure         $500K
                                                                        Project Lifecycle Framework
                                                     and over
                                                                Under
                                                                $500K

   PM Challenge: February 2010                                                                          4
Why a Scaled Project Lifecycle Framework?
 Why did we need a scalable Project Framework?
             7102.7 IT Project Lifecycle                    7120.7 Framework: Project Review
                                                                        and KDPs
                                                           1.    System Concept Review (SCR)
                                                           2.    KDP A – approval to move to Concept
                                                                 Development Phase
                                                           3.    Enterprise Architecture Review (EA)
                                                           4.    Info. /System Security Review
                                                           5.    Information Assessment
                                                           6.    System Requirement Review (SRR)
                                                           7.    KDP B – approval to move to Prelim
                                                                 Design Phase
                                                           8.    Preliminary Design Review (PDR)
                                                           9.    Risk Assessment
                                                           10.   KDP C – approval to move to Final
                                                                 Design & Build Phase
• Why not apply the full NPR 7120.7 to ALL                 11.   Critical Design Review
  Projects?                                                12.   KDP D – approval to move to Sys
                                                                 Assembly Integration & Test Phase
    IT teams need to balance NPR 7120.7 with project       13.   Certification of Security Controls
                                                           14.   Security Accreditation Decision
    agility and customer requirements. If an IT project
                                                           15.   Test Readiness Review
    has an implementation timeframe of two months,         16.   Operational Readiness Review (ORR)
                                                           17.   KDP E – approval to move to Deploy Ops
    does it add value to require ALL projects 16 project         & Sustainment Phase
                                                           18.   Project Completion Review (PCR)
    reviews and six KDPs of NPR 7120.7?
                                                           19.   EA Service Review (EASR)
                                                           20.   Annual Self-Assessment of Controls
                                                           21.   KDP F – approval to move to
                                                                 Decommissioning Phase
                                                           22.   Decommissioning Review (DR)

 PM Challenge: February 2010                                                                              5
Why a Scaled Project Lifecycle Framework?
Why did we need a scalable Project Framework?
•          Why is the tailored Framework necessary?
         •         Ensures Projects are following consistent and standard set of implementation
                   processes and success criteria
                  •        Formulating, approving, implementing, and evaluating
                  •        Disseminating lessons learned
                  •        Aligning NASA’s IT investment and management practices with business
                           requirements and strategic initiatives
         •         Two way communication: provide insight and oversight to management as
                   well as a forum to reach out to Management for assistance

    PM Challenge: February 2010                                                                   6

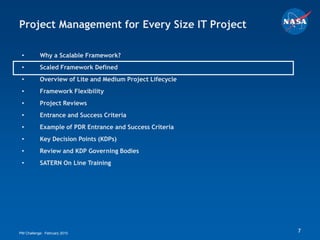

Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                7

Scaled Framework Defined
What is the Scaled Project Lifecycle Framework?
• The Scaled Project Lifecycle Framework:

     • Is based on NASA’s NPR 7120.7, that establishes the program and project management
       requirements for NASA IT programs and projects.

     • NASA requires projects follow the NPR 7120.7 if the total development and implementation
       cost is $500,000 or more and/or the investment affects more than one Center. The NPR
       7120.7 does not address projects under the thresholds.

                                                    DIRECTORATE

              $500k and Over: Projects are           IT PROJECTS
              required to follow the NPR 7120.7                      Under $500k: No common
              project management structure                           project management structure
                                                   $500K
                                                  and over
                                                                     existed within Code I prior to the
                                                             Under   development of the Lite and
                                                             $500K   Medium Project Lifecycle
                                                                     Framework

PM Challenge: February 2010                                                                               8

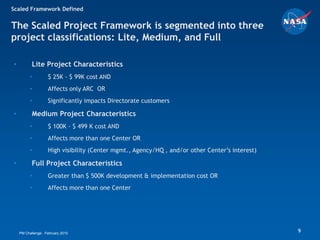

Scaled Framework Defined

The Scaled Project Framework is segmented into three
project classifications: Lite, Medium, and Full

•          Lite Project Characteristics
         •         $ 25K - $ 99K cost AND
         •         Affects only ARC OR
         •         Significantly impacts Directorate customers

•          Medium Project Characteristics
         •         $ 100K - $ 499 K cost AND
         •         Affects more than one Center OR
         •         High visibility (Center mgmt., Agency/HQ , and/or other Center’s interest)

•          Full Project Characteristics
         •         Greater than $ 500K development & implementation cost OR
         •         Affects more than one Center

    PM Challenge: February 2010                                                                 9
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                10
Overview of the Lite and Medium Project Lifecycle Framework
    Lite: Lifecycle Framework
    LITE: $ 25K-$99K cost, effects only the Center, significantly impacts Directorate customers
LIFECYCLE PHASES                          Formulation                                  APPROVAL                      Implementation

                                          Initiation                                Acquisition & Development                    Implementation            Operations

Project Lifecycle        Pre-Phase A:         Phase A: Concept             Phase B:             Phase C: Final      Phase D: System               Phase E:         Phase F:
Phases                  Concept Studies         Development           Preliminary Design        Design & Build    Assembly Integration         Deploy. Ops &   Decommissioning
                                                                                                                         & Test                 Sustainment

Key Decision
Points (KDPS)                                                                           KDP-C                                            KDP-E

Project Reviews
                                            System Requirement         Preliminary Design                              Operational.
                                              Review (SRR)               Review (PDR)                               Readiness Review
                                                                                                                         (ORR)
EA Reviews and
Requirements

IT Security /System
C&A Reviews &                                Info./ System Security                                              --Certification of Security
                                                 Categorization
Requirements                                                                                                               Controls
                                                                                                                    --Security Accred.
                                                                                                                        Decision
Record Mgmt. &
Privacy Reviews

Available              1.   FAD              1.   Framework           1. PDR Criteria                            1. ORR Criteria
                                                  Agreement           2. PDR                                     2. ORR Presentation           •
Templates
                                             2.   SRR Criteria           Presentation                            3. KDP E
                                             3.   Info./ System       3. KDP C
                                                  Security            4. Baseline Project
                                                  Categorization         Plan
                                                  Instructions        5. Baseline MS
                                             4.   SRR                    Project
                                                  Presentation           Schedule
                                             5.   Project Plan
                                             6.   MS Project
                                                  Schedule

      PM Challenge: February 2010                                                                                                                                       11
Overview of the Lite and Medium Project Lifecycle Framework
 Medium: Lifecycle Framework
 MEDIUM: $ 100K-$ 499K cost, effects more than one Center, high visibility (Center mgmt., Agency/HQ , and/or other Center’s interest)
LIFECYCLE PHASES                          Formulation                                  APPROVAL                            Implementation

                                          Initiation                                Acquisition & Development                        Implementation              Operations

Project Lifecycle        Pre-Phase A:         Phase A: Concept             Phase B:             Phase C: Final             Phase D: System            Phase E:           Phase F:
Phases                  Concept Studies         Development           Preliminary Design        Design & Build           Assembly Integration      Deploy. Ops &     Decommissioning
                                                                                                                                & Test              Sustainment

Key Decision
Points (KDPS)                                                                           KDP-C                    KDP-D                         KDP-E

Project Reviews
                                            System Requirement         Preliminary Design   Critical Design Review            Operational.             Project
                                              Review (SRR)               Review (PDR)                (CDR)                 Readiness Review          Completion
                                                                                                                                (ORR)               Review (PCR)
                                                                      Project Management
                                                                        Review (PMR)
EA Reviews and
Requirements

IT Security /System
                                             Info./ System Security
C&A Reviews &                                                                                                        --Certification of Security
                                                 Categorization                                                                Controls
Requirements
                                                                                                                          --Security Accred.
                                                                                                                              Decision
Record Mgmt. &
Privacy Reviews

Available              1. FAD                1.   Framework           1. PDR Criteria       1. CDR Criteria          1. ORR Criteria               1. PCR Criteria
                                                  Agreement           2. PDR                2. CDR                   2. ORR Presentation           2. PCR
Templates
                                             2.   SRR Criteria           Presentation          Presentation          3. KDP E                         Presentation
                                             3.   Info./ System       3. PMR Criteria       3. KDP D
                                                  Security            4. PMR
                                                  Categorization         Presentation
                                                  Instructions        5. KDP C
                                             4.   SRR                 6. Baseline Project
                                                  Presentation           Plan
                                             5.   Project Plan        7. Baseline MS
                                             6.   MS Project             Project
                                                  Schedule               Schedule
      PM Challenge: February 2010                                                                                                                                             12
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                13
Framework Flexibility
    The Framework is flexible and can be tailored
    to each project
•   Even though the Framework builds discipline into Directorate’s Project Management
    capabilities, it is flexible and can be tailored to each project. The Project Manager
    determines the appropriate reviews and KDPs.

•   The Project Management Office helps project leads determine their project
    management approach and provides training/coaching as necessary. This helps
    project leads understand what is required and how to get started.

•   Each Phase may require project review(s) and a KDP review before the project can
    move forward. The reviews and KDPs are called the Project Framework. Depending
    on the project, the Project Manager has the option to:

             •         Present reviews and Key Decision Points (KDPs) together at the same Board meeting. For example;
                       present SRR, PDR, KDP C together instead of separate meetings with approval from Division/Office
                       Lead according to the Framework Agreement.
             •         Add additional reviews (Test Readiness Reviews, additional Security reviews, EA Review, Change Control
                       reviews, etc.) with approval from Division/Office Lead according to the Framework Agreement.
                       Additionally, management can add further reviews if necessary.
             •         Delete unnecessary reviews that do not add value to the project with approval from Division/Office
                       Lead according to the Framework Agreement.
    PM Challenge: February 2010                                                                                             14
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                15
Project Reviews
                                                                      REVIEWS
Review                     Description                                                                                           Lite   Medium
Information / System       Analysis of the information types to be stored and processed in the system to address three IT
Security                   security objectives (Confidentiality, Integrity, and Availability). Determines the potential impact          
Categorization             that a loss would have on the system or functional line of business supported by the information
                           system and the level of IT security required to manage risk to an acceptable level. The result of
                           the analysis is an “IT security category,” validated by an appropriate NASA authority.
                           NOTE: The Information/System Security Categorization Review is different from the other formal
                           reviews required by the Code I Project Lifecycle Framework. The Information/System Security
                           Categorization Review is NOT a formal review or meeting. It is a process that requires all Code I
                           Projects to follow procedures documented in standard operating procedures (SOP). See the
                           Information / System Security Categorization Instructions on the PMO website.
System                     The SRR examines the functional, technical, performance, and security requirements for the
Requirements               system and elements of the preliminary Project Plan and ensures that the requirements and the                
Review (SRR)               selected concept will satisfy the system objectives.
Preliminary Design         The PDR demonstrates that the preliminary design meets all system requirements with
Review (PDR)               acceptable risk and within the cost and schedule constraints and establishes the basis for                   
                           proceeding with detailed design. It will show that the correct design option has been selected,
                           interfaces have been identified, and verification methods have been described.
Project Management         Purpose of PMR: The PMR demonstrates that the project is managed to the Code I program and
Review (PMR)               project management requirements and best practices. The project meets requirements with                       
                           acceptable risk and within the cost and schedule constraints and establishes the basis for
                           proceeding with the management of detailed design.
Critical Design            The CDR confirms that the maturity of the design is appropriate to support proceeding with
Review (CDR)               implementation, that it was developed in conjunction with stakeholders, demonstrates that the                 
                           design meets detailed requirements, and identifies open design issues for the purpose of
                           obtaining a decision to proceed with development and deployment. It reviews the technical
                           architecture to ascertain the effect on the enterprise architecture and reviews the application
                           security design and the inclusion of security controls.

  PM Challenge: February 2010                                                                                                             16
Project Reviews (continued)
                                                                      REVIEWS
Review                     Description                                                                                        Lite   Medium
Security                   Comprehensive assessment of the management, operational and technical security controls and
Certification              other safeguards of an IT system. Establishes the extent to which a particular design and                 
                           implementation meets documented security requirements and any necessary remedial actions.
                           NOTE: This is a continuation of the of the IT Security processes you started in Phase A,
                           Information/System Security Categorization Instructions. Like the Information/System Security
                           Categorization Review, the Security Certification is NOT a formal review or meeting. It is a
                           process that requires all Code I Projects to follow procedures documented in the SOP.
                           You must complete the Security Certification before holding an ORR.
Security                   Formal declaration by an Authorizing Official that an IT system is compliant with established
Accreditation              security requirements, that any residual risks identified during the risk mitigation process are          
                           acceptable, and that the system is approved to operate using a prescribed set of safeguards.
                           NOTE: This is a continuation of the of the IT Security processes you started in Phase A,
                           Information/System Security Categorization Instructions. Like the Information/System Security
                           Categorization Review, the Security Accreditation is NOT a formal review or meeting. It is a
                           process that requires all Code I Projects to follow procedures documented in the SOP.
                           You must complete the Security Certification before holding an ORR.
Operational                The ORR determines that the project is ready to go-live with the system or service:
Readiness Review           requirements have been met; the functionality, performance, and security controls have been               
(ORR)                      thoroughly tested; procedures are in place for operations; the users have been adequately
                           trained; and, the organization responsible for operations and sustaining engineering is ready to
                           assume responsibility. It ensures a security plan is in place and that system authorization has
                           been received.
Project Completion         The PCR provides assurance that the implemented system is performing as expected and that all
Review (PCR)               necessary support requirements are in place and functioning properly. It confirms that the                 
                           system is operating properly in its production environment. It is the official closeout of the
                           project and project team. The final project schedule is published and remaining open risks are
                           transferred, closed, or accepted. At the conclusion of the PCR, the system is considered fully
                           operational.

  PM Challenge: February 2010                                                                                                          17
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                18
Entrance and Success Criteria
• What are entrance and success criteria for each review?
    •   The entrance and success criteria are the recommended best practices for technical reviews conducted
        as a part of information technology projects. Entrance criteria and success criteria are the minimum
        requirements that should be completed before holding a review and the requirements to pass a review.
    •   At the beginning of each phase, the project will determine the appropriate entrance and success
        criteria for the review and send it to the Review Board for review and approval well in advance of the
        actual Review.

• How are entrance and success criteria for each review developed?
    •   The PMO has developed recommended entrance and success criteria for each review based on the NPR
        7120.7 but paired down to reflect the Lite and Medium project classifications within the Scaled Project
        Lifecycle Framework and formatted it to a user-friendly checklist. The framework allows for additions
        or deletions (with justification) to the entrance and success criteria as appropriate due to the unique
        nature of each project.
    •   The entrance and success criteria should reflect the nature of the system under development; be
        appropriate for the project’s size, risk, and importance; and be achievable with approved project
        resources and on an acceptable schedule.
    •   The Project Manager and team determine the appropriate entrance and success criteria.

  PM Challenge: February 2010                                                                                     19
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                20
Example of PDR Entrance & Success Criteria:
 Preliminary Design Review (PDR) Criteria:
 Lite and Medium
NASA LIFECYCLE                            Formulation                                 APPROVAL                            Implementation
PHASES
                                          Initiation                               Acquisition & Development                        Implementation             Operations

Project Lifecycle        Pre-Phase A:         Phase A: Concept            Phase B:             Phase C: Final             Phase D: System             Phase E:         Phase F:
Phases                  Concept Studies         Development          Preliminary Design        Design & Build           Assembly Integration       Deploy. Ops &   Decommissioning
                                                                                                                               & Test               Sustainment

Key Decision
Points (KDPS)                                                                          KDP-C                    KDP-D                      KDP-E

Project Reviews
                                            System Requirement        Preliminary Design   Critical Design Review            Operational.              Project
                                              Review (SRR)              Review (PDR)                (CDR)                 Readiness Review           Completion
                                                                                                                               (ORR)                Review (PCR)

                                                                     Project Management
                                                                       Review (PMR)

EA Reviews and
Requirements

IT Security
/System C&A                                 Info./ System Security                                                   --Certification of Security
                                                Categorization                                                      Controls (completed before
Reviews &
                                           (completed before SRR)                                                               ORR)
Requirements
                                                                                                                    --Security Accred. Decision
                                                                                                                      (completed before ORR)

Record Mgmt. &
Privacy Reviews

      PM Challenge: February 2010                                                                                                                                           21
Example of PDR Entrance and Success Criteria:
PDR Entrance and Success Criteria
Purpose of PDR: The PDR demonstrates that the preliminary design meets all system
requirements with acceptable risk and within the cost and schedule constraints and establishes
the basis for proceeding with detailed design. It will show that the correct design options have
been selected, interfaces have been identified, and verification methods have been described.

                                                     Preliminary Design Review (PDR)
                      Entrance Criteria                                    Success Criteria                Required? Choose
                                                                                                              Yes or No
1      A preliminary PDR agenda, success criteria, and                                                        Yes  No
       charge to the board have been agreed to by the
       technical team, project manager, and review
       chair prior to the PDR.
2      Successful completion of the SRR and responses       SRR RFAs are closed or a timely closure plan      Yes  No
       has been made to all SRR and Requests for            exists for those remaining open.
       Action (RFAs), or a timely closure plan exists for
       those remaining open
3      RECOMMENDED: PDR technical work products
       listed below for both hardware and software
       system elements have been made available to
       the cognizant participants prior to the review:
3A     MS Project Schedule                                  High confidence exists in the MS Project          Yes  No
                                                            Schedule baseline, and adequate
                                                            documentation exists and/or will exist in a
                                                            timely manner to allow proceeding with
                                                            development, integration, and test.

PM Challenge: February 2010                                                                                               22
Example of PDR Entrance and Success Criteria:
PDR Entrance and Success Criteria
                                                   Preliminary Design Review (PDR)
                        Entrance Criteria                                Success Criteria                Required? Choose
                                                                                                            Yes or No
  3B     Updated costs                                     Adequate technical and programmatic margins      Yes  No
                                                           and resources exist to complete the
                                                           development within budget, schedule, and
                                                           risk constraints.
  3C     Updated Risk assessment and mitigation            The project risks are understood, and plans      Yes  No
                                                           and a process and resources exist to
                                                           effectively manage them.
  3D     Preliminary subsystem design specifications for   The preliminary design is expected to meet       Yes  No
         each configuration item (hardware and software)   the requirements at an acceptable level of
         with supporting tradeoff analyses and data, as    risk.
         required. The preliminary software design
         specification needs to include a completed
         definition of the software architecture,
         preliminary database design description, and
         data conversion plan as applicable.

  PM Challenge: February 2010                                                                                           23
Example of PDR Entrance and Success Criteria:
    Optional: Additional PDR Entrance & Success criteria
                                                      Preliminary Design Review (PDR)
                       Entrance Criteria                                      Success Criteria                    Required? Choose
                                                                                                                      Yes or No
4       OPTIONAL (due to the unique nature of each
        project): PDR technical work products listed
        below for both hardware and software system
        elements have been made available to the
        cognizant participants prior to the review:
4A      Updated baselined documentation, as required        Agreement exists for the top-level requirements,         Yes  No
                                                            including success criteria and any sponsor-imposed
                                                            constraints, and ensures that these are finalized,
                                                            stated clearly, and are consistent with the prelim.
                                                            Design.
4B      Updated logistics documentation, as required        Adequate logistics processes are in place meeting        Yes  No
                                                            the project’s requirements.
4C      Applicable technical plans (e.g., technical         Adequate technical margins exist with respect to         Yes  No
        performance measurement plan, reliability           performance requirements.
        program plan, quality assurance plan)
4D      Operational concept                                 The operational concept is technically sound. It         Yes  No
                                                            includes (where appropriate) human factors that
                                                            apply, and requirements for its execution flow
                                                            down.

    PM Challenge: February 2010                                                                                             24
Example of PDR Entrance and Success Criteria:
Optional: Additional PDR Entrance & Success criteria
                                                    Preliminary Design Review (PDR)
                 Entrance Criteria                                      Success Criteria                              Required?
                                                                                                                   Choose Yes or No
4E       Applicable standards                   Applicable standards are being met per the project’s                  Yes  No
                                                requirements.
4F       Engineering drawing tree               Engineering drawing tree is sound.                                    Yes  No
4G       Interface control documents            Definition of the technical interfaces is consistent with the         Yes  No
                                                overall technical maturity and provides an acceptable level of
                                                risk.
4H       Verification/validation plan           The flow down of verifiable requirements is complete and              Yes  No
                                                proper or, if not, an adequate plan exists for timely resolution
                                                of open items. Requirements are traceable to system goals and
                                                objectives.
4I       Plans to respond to regulatory         Plan in place to meet project’s requirements regulatory               Yes  No
         requirements (e.g., Section 508), as   requirements.
         required
4J       Requirements traceability matrix       The flow down of verifiable requirements is complete and              Yes  No
                                                proper or, if not, an adequate plan exists for timely resolution
                                                of open items. Requirements are traceable to system goals and
                                                objectives.
4K       Disposal plan                          Plan in place to meet project’s disposal requirements.                Yes  No

4L       Technical resource utilization         Adequate technical and programmatic margins and resources             Yes  No
         estimates and margins                  exist to complete the development within budget, schedule,
                                                and risk constraints.

     PM Challenge: February 2010                                                                                              25
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                26
Key Decision Points (KDPs)
                                                                  KDPS
Review                     Description                                                                                        Lite   Medium
KDP C - Lite               KDP C is a point in time where the Decision Authority makes a decision on the readiness of
                           project to progress to the next phase of the lifecycle, Phase C - Final Design & Build. Projects    
                           must have completed or have a solid plan to complete all Requests for Action (RFAs) brought up
                           by the Board during the Information/System Security Categorization, SRR, and PDR
KDP C - Medium             KDP C is a point in time where the Decision Authority makes a decision on the readiness of
                           project to progress to the next phase of the lifecycle, Phase C - Final Design & Build. Projects           
                           must have completed or have a solid plan to complete all Requests for Action (RFAs) brought up
                           by the Board during the Information/System Security Categorization, SRR, PMR, and PDR.
KDP D – Medium             KDP D is a point in time where the Decision Authority makes a decision on the readiness of
                           project to progress to the next phase of the lifecycle, Phase D - System Assembly Integration &            
                           Test. Projects must have completed or have a solid plan to complete all Requests for Action
                           (RFAs) brought up by the Board during the CDR.
KDP E                      KDP E is a point in time where the Decision Authority makes a decision on the readiness of
                           project to “go-live” and progress the next phase of the lifecycle, Phase E – Deployment,                  
                           Operations, and Sustainment. Projects must have completed or have a solid plan to complete all
                           Requests for Action (RFAs) brought up by the Board during the ORR, Security Accreditation, and
                           Security Certification.

  PM Challenge: February 2010                                                                                                          27
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                28
Who should attend a Review and KDP?
 •            Project Manager & Technical Lead:
          •         At a minimum, the Project Manager and Technical Lead present to the Governing Body. Other individuals
                    involved in the project may be invited, however it is recommended that participants be limited to only
                    those only those who must absolutely attend.

 •            Reviews Governing Body:
          •         The Governing Body is charted to approve, approve with Requests for Action, or disapprove the review. The
                    Governing Body membership differs from one project to the next. For example, an infrastructure project
                    may require a different Governing Body membership than a software development project. Project
                    Managers are responsible for working with their management chain (and Project Sponsor, Customer, etc. if
                    necessary) to select the appropriate members for the Governing Body. See the following slide for PMO
                    recommendations on Governing Body membership for each review.

 •            KDP Decision Authority Governing Body:
          •         The KDP Decision Authority is charted to approve, approve with Requests for Action, or disapprove the
                    Projects passing to the next Phase of the Project Life cycle. The KDP Governing Body may be either the
                    Directorate IT Project Management Board (IT PMB), the Center IT PMB or the Agency IT PMB depending on
                    the nature of the project and the interest at higher levels.

Note: As best practice, projects should not use their reviews as the only communication vehicle to reach out. Projects
should be communicating projects status to other interested parties through open forums, all-hand meetings, weekly
meeting, emails, newsletters, reports, etc.

     PM Challenge: February 2010                                                                                         29
Review and Governing Bodies
Lite: Recommended Governing Body Membership
                Lite Classification – Governing Body Membership Recommendation
Review/KDP                                      Recommended Governing Body Membership
System Requirement Review (SRR)                 Division/Office Representative (Chair)
                                                Customer/Stakeholder Representative
                                                Governance & Policy Representative
                                                System Owner
Info/System Security Categorization Review
Preliminary Design Review (PDR)                 Division/Office Representative (Chair)
                                                Enterprise Architecture (EA) Representative
                                                ITSM Representative
                                                Technical Peers
                                                System Owner
KDP C - IT Project Management Board             Code I IT PMB
Certification of Security Controls & Security
Accreditation Decision
Operational Readiness Review (ORR)              CIO Representative (Chair)
                                                Customer/Stakeholder Representative
                                                Division/Office Representative
                                                Governance & Policy Representative
                                                Help Desk Rep (as applicable)
                                                IT Security Representative
                                                Operations Representative
                                                System Owner
KDP E                                           Code I IT PMB

PM Challenge: February 2010                                                                   30
Review and Governing Body
Medium: Recommended Governing Body Membership

        Medium Classification – Governing Body Membership                 Medium Classification – Governing Body Membership
                        Recommendations                                            Recommendations (continued)
Review/KDP                Recommended Governing Body                Review/KDP                  Recommended Governing Body
                          Membership                                                            Membership
SRR                       Division/Office Representative (Chair)    Certification of Security
                          CIO Representative                        Controls & Security
                          Governance & Policy Representative        Accreditation Decision
                          Customer/Stakeholder Representative       ORR                         CIO Representative (Chair)
                          Help Desk Representative                                              Customer/Stakeholder
                                                                                                       Representative
Info./System
Security                                                                                        Division/Office Rep
Categorization                                                                                  Governance & Policy Rep
Review                                                                                          Help Desk Rep (as applicable)
PDR                       Division/Office Representative (Chair)                                IT Security Representative
                          EA Representative                                                     Operations Representative
                          ITSM Representative                                                   System Owner
                          Technical Peers                           KDP E                       Code I IT PMB
PMR                       PMO Representative (Chair)                PCR                         CIO Rep (Chair)
                          Budget Management Office Representative                               Customer/Stakeholder
                                                                                                       Representative
KDP C                     Code I IT PMB
                                                                                                Division/Office Rep
CDR                       Division/Office Representative (Chair)                                PMO Representative
                          Customer/Stakeholder Representative
                          Enterprise Architecture Representative
                          Technical Peers
KDP D                     Code I IT PMB

PM Challenge: February 2010                                                                                                     31
Project Management for Every Size IT Project

 •         Why a Scalable Framework?
 •         Scaled Framework Defined
 •         Overview of Lite and Medium Project Lifecycle
 •         Framework Flexibility
 •         Project Reviews
 •         Entrance and Success Criteria
 •         Example of PDR Entrance and Success Criteria
 •         Key Decision Points (KDPs)
 •         Review and KDP Governing Bodies
 •         SATERN On Line Training

PM Challenge: February 2010                                32

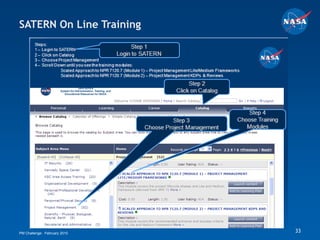

SATERN On Line Training

PM Challenge: February 2010   33
Thanks for attending today’s presentation…..

                                               34

More Related Content

What's hot

Gary.humphreys
Gary.humphreysGary.humphreys
Gary.humphreysNASAPMC

K.pagel.beene
K.pagel.beeneK.pagel.beene
K.pagel.beeneNASAPMC

Murphy.dar jean.jean
Murphy.dar jean.jeanMurphy.dar jean.jean
Murphy.dar jean.jeanNASAPMC

Lau.cheevon
Lau.cheevonLau.cheevon
Lau.cheevonNASAPMC

Snow lee
Snow leeSnow lee
Snow leeNASAPMC

Terry.conroy
Terry.conroyTerry.conroy
Terry.conroyNASAPMC

Thomas.mc vittie
Thomas.mc vittieThomas.mc vittie
Thomas.mc vittieNASAPMC

Majerowicz
MajerowiczMajerowicz
MajerowiczNASAPMC

Bilardo.vince
Bilardo.vinceBilardo.vince
Bilardo.vinceNASAPMC

Jenks.ken
Jenks.kenJenks.ken
Jenks.kenNASAPMC

Armstrong
ArmstrongArmstrong
ArmstrongNASAPMC

Sally godfreyheatherrarick
Sally godfreyheatherrarickSally godfreyheatherrarick
Sally godfreyheatherrarickNASAPMC

Gonzales.matthew
Gonzales.matthewGonzales.matthew
Gonzales.matthewNASAPMC

Semancik.susan
Semancik.susanSemancik.susan
Semancik.susanNASAPMC

Chen.tim
Chen.timChen.tim
Chen.timNASAPMC

Stefanini.trinh
Stefanini.trinhStefanini.trinh
Stefanini.trinhNASAPMC

Kirsch.mike
Kirsch.mikeKirsch.mike
Kirsch.mikeNASAPMC

Louis.cioletti
Louis.ciolettiLouis.cioletti
Louis.ciolettiNASAPMC

Bobby.german
Bobby.germanBobby.german
Bobby.germanNASAPMC

What's hot (20)

Gary.humphreys
Gary.humphreysGary.humphreys
Gary.humphreys

K.pagel.beene
K.pagel.beeneK.pagel.beene
K.pagel.beene

Murphy.dar jean.jean
Murphy.dar jean.jeanMurphy.dar jean.jean
Murphy.dar jean.jean

Lau.cheevon
Lau.cheevonLau.cheevon
Lau.cheevon

Snow lee
Snow leeSnow lee
Snow lee

Terry.conroy
Terry.conroyTerry.conroy
Terry.conroy

Thomas.mc vittie
Thomas.mc vittieThomas.mc vittie
Thomas.mc vittie

Majerowicz
MajerowiczMajerowicz
Majerowicz

Bilardo.vince
Bilardo.vinceBilardo.vince
Bilardo.vince

Jenks.ken
Jenks.kenJenks.ken
Jenks.ken

Armstrong
ArmstrongArmstrong
Armstrong

Sally godfreyheatherrarick
Sally godfreyheatherrarickSally godfreyheatherrarick
Sally godfreyheatherrarick

Gonzales.matthew
Gonzales.matthewGonzales.matthew
Gonzales.matthew

Semancik.susan
Semancik.susanSemancik.susan
Semancik.susan

Chen.tim
Chen.timChen.tim
Chen.tim

Stefanini.trinh
Stefanini.trinhStefanini.trinh
Stefanini.trinh

Kirsch.mike
Kirsch.mikeKirsch.mike
Kirsch.mike

Louis.cioletti
Louis.ciolettiLouis.cioletti
Louis.cioletti

Bobby.german
Bobby.germanBobby.german
Bobby.german

Symons
SymonsSymons
Symons

Viewers also liked

Graham dave
Graham daveGraham dave
Graham daveNASAPMC

Mullane stanley-hamilton-wise
Mullane stanley-hamilton-wiseMullane stanley-hamilton-wise
Mullane stanley-hamilton-wiseNASAPMC

Skytland.nick
Skytland.nickSkytland.nick
Skytland.nickNASAPMC

Benedict.robert
Benedict.robertBenedict.robert
Benedict.robertNASAPMC

Project management roundtable summary final
Project management roundtable summary finalProject management roundtable summary final
Project management roundtable summary finalNASAPMC

Viewers also liked (6)

Graham dave
Graham daveGraham dave
Graham dave

Mullane stanley-hamilton-wise
Mullane stanley-hamilton-wiseMullane stanley-hamilton-wise
Mullane stanley-hamilton-wise

Skytland.nick
Skytland.nickSkytland.nick
Skytland.nick

Bitten
BittenBitten
Bitten

Benedict.robert
Benedict.robertBenedict.robert
Benedict.robert

Project management roundtable summary final
Project management roundtable summary finalProject management roundtable summary final
Project management roundtable summary final

Similar to Vonnie simonsen

Petze.lara
Petze.laraPetze.lara
Petze.laraNASAPMC

1844final 100811113357 Phpapp01
1844final 100811113357 Phpapp011844final 100811113357 Phpapp01
1844final 100811113357 Phpapp01pmfigliola

1844final 100811113357 Phpapp01
1844final 100811113357 Phpapp011844final 100811113357 Phpapp01
1844final 100811113357 Phpapp01pmfigliola

Corcoran webster
Corcoran websterCorcoran webster
Corcoran websterNASAPMC

Framework for Analyzing Public Investment Management
Framework for Analyzing Public Investment ManagementFramework for Analyzing Public Investment Management
Framework for Analyzing Public Investment Managementicgfmconference

Skyward Erp Presentation
Skyward Erp PresentationSkyward Erp Presentation
Skyward Erp Presentationvishalnvora1

Project Governance Model
Project Governance ModelProject Governance Model
Project Governance ModelConstient

A Successful Improvement Process With Measurable Results
A Successful Improvement Process With  Measurable ResultsA Successful Improvement Process With  Measurable Results
A Successful Improvement Process With Measurable ResultsRam Yonish

A successful improvement process with measurable results
A successful improvement process with  measurable resultsA successful improvement process with  measurable results
A successful improvement process with measurable resultsRam Yonish

Key Considerations for a Successful Hyperion Planning Implementation
Key Considerations for a Successful Hyperion Planning ImplementationKey Considerations for a Successful Hyperion Planning Implementation
Key Considerations for a Successful Hyperion Planning ImplementationAlithya

Project management in pharmaceutical generic industry basics and standards
Project management in pharmaceutical generic industry basics and standardsProject management in pharmaceutical generic industry basics and standards
Project management in pharmaceutical generic industry basics and standardsJayesh Khatri

Comfori red-sop seminar-ppt brochure-091012
Comfori red-sop seminar-ppt brochure-091012Comfori red-sop seminar-ppt brochure-091012
Comfori red-sop seminar-ppt brochure-091012REDceo.net

Project Management at First National Bank
Project Management at First National BankProject Management at First National Bank
Project Management at First National BankIsis Quiñones

Vanessa.jeff
Vanessa.jeffVanessa.jeff
Vanessa.jeffNASAPMC

Louis.cioletti
Louis.ciolettiLouis.cioletti
Louis.ciolettiNASAPMC

HITSC 2010 06-30 slides
HITSC 2010 06-30 slidesHITSC 2010 06-30 slides
HITSC 2010 06-30 slidesBrian Ahier

Career Pyramid - Charles Fain
Career Pyramid - Charles FainCareer Pyramid - Charles Fain
Career Pyramid - Charles FainCharles D Fain

Similar to Vonnie simonsen (20)

Petze.lara
Petze.laraPetze.lara
Petze.lara

1844final 100811113357 Phpapp01
1844final 100811113357 Phpapp011844final 100811113357 Phpapp01
1844final 100811113357 Phpapp01

1844final 100811113357 Phpapp01
1844final 100811113357 Phpapp011844final 100811113357 Phpapp01
1844final 100811113357 Phpapp01

Corcoran webster
Corcoran websterCorcoran webster
Corcoran webster

Framework for Analyzing Public Investment Management
Framework for Analyzing Public Investment ManagementFramework for Analyzing Public Investment Management
Framework for Analyzing Public Investment Management

Skyward Erp Presentation
Skyward Erp PresentationSkyward Erp Presentation
Skyward Erp Presentation

Project Governance Model
Project Governance ModelProject Governance Model
Project Governance Model

A Successful Improvement Process With Measurable Results
A Successful Improvement Process With  Measurable ResultsA Successful Improvement Process With  Measurable Results
A Successful Improvement Process With Measurable Results

A successful improvement process with measurable results
A successful improvement process with  measurable resultsA successful improvement process with  measurable results
A successful improvement process with measurable results

Key Considerations for a Successful Hyperion Planning Implementation
Key Considerations for a Successful Hyperion Planning ImplementationKey Considerations for a Successful Hyperion Planning Implementation
Key Considerations for a Successful Hyperion Planning Implementation

Project management in pharmaceutical generic industry basics and standards
Project management in pharmaceutical generic industry basics and standardsProject management in pharmaceutical generic industry basics and standards
Project management in pharmaceutical generic industry basics and standards

T349
T349T349
T349

Comfori red-sop seminar-ppt brochure-091012
Comfori red-sop seminar-ppt brochure-091012Comfori red-sop seminar-ppt brochure-091012
Comfori red-sop seminar-ppt brochure-091012

Project Management at First National Bank
Project Management at First National BankProject Management at First National Bank
Project Management at First National Bank

Vanessa.jeff
Vanessa.jeffVanessa.jeff
Vanessa.jeff

Louis.cioletti
Louis.ciolettiLouis.cioletti
Louis.cioletti

HITSC 2010 06-30 slides
HITSC 2010 06-30 slidesHITSC 2010 06-30 slides
HITSC 2010 06-30 slides

Career Pyramid - Charles Fain
Career Pyramid - Charles FainCareer Pyramid - Charles Fain
Career Pyramid - Charles Fain

T348 Asm Iweb
T348 Asm IwebT348 Asm Iweb
T348 Asm Iweb

T348 Asm Iweb
T348 Asm IwebT348 Asm Iweb
T348 Asm Iweb

More from NASAPMC

Bejmuk bo
Bejmuk boBejmuk bo
Bejmuk boNASAPMC

Baniszewski john
Baniszewski johnBaniszewski john
Baniszewski johnNASAPMC

Yew manson
Yew mansonYew manson
Yew mansonNASAPMC

Wood frank
Wood frankWood frank
Wood frankNASAPMC

Wood frank
Wood frankWood frank
Wood frankNASAPMC

Wessen randi (cd)
Wessen randi (cd)Wessen randi (cd)
Wessen randi (cd)NASAPMC

Vellinga joe
Vellinga joeVellinga joe
Vellinga joeNASAPMC

Trahan stuart
Trahan stuartTrahan stuart
Trahan stuartNASAPMC

Stock gahm
Stock gahmStock gahm
Stock gahmNASAPMC

Smalley sandra
Smalley sandraSmalley sandra
Smalley sandraNASAPMC

Seftas krage
Seftas krageSeftas krage
Seftas krageNASAPMC

Sampietro marco
Sampietro marcoSampietro marco
Sampietro marcoNASAPMC

Rudolphi mike
Rudolphi mikeRudolphi mike
Rudolphi mikeNASAPMC

Roberts karlene
Roberts karleneRoberts karlene
Roberts karleneNASAPMC

Rackley mike
Rackley mikeRackley mike
Rackley mikeNASAPMC

Paradis william
Paradis williamParadis william
Paradis williamNASAPMC

Osterkamp jeff
Osterkamp jeffOsterkamp jeff
Osterkamp jeffNASAPMC

O'keefe william
O'keefe williamO'keefe william
O'keefe williamNASAPMC

Muller ralf
Muller ralfMuller ralf
Muller ralfNASAPMC

Mulenburg jerry
Mulenburg jerryMulenburg jerry
Mulenburg jerryNASAPMC

More from NASAPMC (20)

Bejmuk bo
Bejmuk boBejmuk bo
Bejmuk bo

Baniszewski john
Baniszewski johnBaniszewski john
Baniszewski john

Yew manson
Yew mansonYew manson
Yew manson

Wood frank
Wood frankWood frank
Wood frank

Wood frank
Wood frankWood frank
Wood frank

Wessen randi (cd)
Wessen randi (cd)Wessen randi (cd)
Wessen randi (cd)

Vellinga joe
Vellinga joeVellinga joe
Vellinga joe

Trahan stuart
Trahan stuartTrahan stuart
Trahan stuart

Stock gahm
Stock gahmStock gahm
Stock gahm

Smalley sandra
Smalley sandraSmalley sandra
Smalley sandra

Seftas krage
Seftas krageSeftas krage
Seftas krage

Sampietro marco
Sampietro marcoSampietro marco
Sampietro marco

Rudolphi mike
Rudolphi mikeRudolphi mike
Rudolphi mike

Roberts karlene
Roberts karleneRoberts karlene
Roberts karlene

Rackley mike
Rackley mikeRackley mike
Rackley mike

Paradis william
Paradis williamParadis william
Paradis william

Osterkamp jeff
Osterkamp jeffOsterkamp jeff
Osterkamp jeff

O'keefe william
O'keefe williamO'keefe william
O'keefe william

Muller ralf
Muller ralfMuller ralf
Muller ralf

Mulenburg jerry
Mulenburg jerryMulenburg jerry
Mulenburg jerry

Recently uploaded

BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,noida100girls

Organizational Structure Running A Successful Business
Organizational Structure Running A Successful BusinessOrganizational Structure Running A Successful Business
Organizational Structure Running A Successful BusinessSeta Wicaksana

Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...lizamodels9

Independent Call Girls Andheri Nightlaila 9967584737
Independent Call Girls Andheri Nightlaila 9967584737Independent Call Girls Andheri Nightlaila 9967584737
Independent Call Girls Andheri Nightlaila 9967584737Riya Pathan

FULL ENJOY Call girls in Paharganj Delhi | 8377087607
FULL ENJOY Call girls in Paharganj Delhi | 8377087607FULL ENJOY Call girls in Paharganj Delhi | 8377087607
FULL ENJOY Call girls in Paharganj Delhi | 8377087607dollysharma2066

BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,noida100girls

Investment in The Coconut Industry by Nancy Cheruiyot
Investment in The Coconut Industry by Nancy CheruiyotInvestment in The Coconut Industry by Nancy Cheruiyot
Investment in The Coconut Industry by Nancy Cheruiyotictsugar

Annual General Meeting Presentation Slides
Annual General Meeting Presentation SlidesAnnual General Meeting Presentation Slides
Annual General Meeting Presentation SlidesKeppelCorporation

8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR
8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR
8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCRashishs7044

Market Sizes Sample Report - 2024 Edition
Market Sizes Sample Report - 2024 EditionMarket Sizes Sample Report - 2024 Edition
Market Sizes Sample Report - 2024 EditionMintel Group

Youth Involvement in an Innovative Coconut Value Chain by Mwalimu Menza
Youth Involvement in an Innovative Coconut Value Chain by Mwalimu MenzaYouth Involvement in an Innovative Coconut Value Chain by Mwalimu Menza
Youth Involvement in an Innovative Coconut Value Chain by Mwalimu Menzaictsugar

Case study on tata clothing brand zudio in detail
Case study on tata clothing brand zudio in detailCase study on tata clothing brand zudio in detail
Case study on tata clothing brand zudio in detailAriel592675

Marketing Management Business Plan_My Sweet Creations
Marketing Management Business Plan_My Sweet CreationsMarketing Management Business Plan_My Sweet Creations
Marketing Management Business Plan_My Sweet Creationsnakalysalcedo61

Digital Transformation in the PLM domain - distrib.pdf
Digital Transformation in the PLM domain - distrib.pdfDigital Transformation in the PLM domain - distrib.pdf
Digital Transformation in the PLM domain - distrib.pdfJos Voskuil

Flow Your Strategy at Flight Levels Day 2024
Flow Your Strategy at Flight Levels Day 2024Flow Your Strategy at Flight Levels Day 2024
Flow Your Strategy at Flight Levels Day 2024Kirill Klimov

MAHA Global and IPR: Do Actions Speak Louder Than Words?
MAHA Global and IPR: Do Actions Speak Louder Than Words?MAHA Global and IPR: Do Actions Speak Louder Than Words?
MAHA Global and IPR: Do Actions Speak Louder Than Words?Olivia Kresic

The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024christinemoorman

Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...lizamodels9

Recently uploaded (20)

BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Greater Noida ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,

Organizational Structure Running A Successful Business
Organizational Structure Running A Successful BusinessOrganizational Structure Running A Successful Business
Organizational Structure Running A Successful Business

Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...
Lowrate Call Girls In Sector 18 Noida ❤️8860477959 Escorts 100% Genuine Servi...

Independent Call Girls Andheri Nightlaila 9967584737
Independent Call Girls Andheri Nightlaila 9967584737Independent Call Girls Andheri Nightlaila 9967584737
Independent Call Girls Andheri Nightlaila 9967584737

FULL ENJOY Call girls in Paharganj Delhi | 8377087607
FULL ENJOY Call girls in Paharganj Delhi | 8377087607FULL ENJOY Call girls in Paharganj Delhi | 8377087607
FULL ENJOY Call girls in Paharganj Delhi | 8377087607

BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,
BEST Call Girls In Old Faridabad ✨ 9773824855 ✨ Escorts Service In Delhi Ncr,

Investment in The Coconut Industry by Nancy Cheruiyot
Investment in The Coconut Industry by Nancy CheruiyotInvestment in The Coconut Industry by Nancy Cheruiyot
Investment in The Coconut Industry by Nancy Cheruiyot

Annual General Meeting Presentation Slides
Annual General Meeting Presentation SlidesAnnual General Meeting Presentation Slides
Annual General Meeting Presentation Slides

8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR
8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR
8447779800, Low rate Call girls in Kotla Mubarakpur Delhi NCR

Market Sizes Sample Report - 2024 Edition
Market Sizes Sample Report - 2024 EditionMarket Sizes Sample Report - 2024 Edition
Market Sizes Sample Report - 2024 Edition

Youth Involvement in an Innovative Coconut Value Chain by Mwalimu Menza
Youth Involvement in an Innovative Coconut Value Chain by Mwalimu MenzaYouth Involvement in an Innovative Coconut Value Chain by Mwalimu Menza
Youth Involvement in an Innovative Coconut Value Chain by Mwalimu Menza

Corporate Profile 47Billion Information Technology
Corporate Profile 47Billion Information TechnologyCorporate Profile 47Billion Information Technology
Corporate Profile 47Billion Information Technology

Case study on tata clothing brand zudio in detail
Case study on tata clothing brand zudio in detailCase study on tata clothing brand zudio in detail
Case study on tata clothing brand zudio in detail

Marketing Management Business Plan_My Sweet Creations
Marketing Management Business Plan_My Sweet CreationsMarketing Management Business Plan_My Sweet Creations
Marketing Management Business Plan_My Sweet Creations

Digital Transformation in the PLM domain - distrib.pdf
Digital Transformation in the PLM domain - distrib.pdfDigital Transformation in the PLM domain - distrib.pdf
Digital Transformation in the PLM domain - distrib.pdf

Flow Your Strategy at Flight Levels Day 2024
Flow Your Strategy at Flight Levels Day 2024Flow Your Strategy at Flight Levels Day 2024
Flow Your Strategy at Flight Levels Day 2024

MAHA Global and IPR: Do Actions Speak Louder Than Words?
MAHA Global and IPR: Do Actions Speak Louder Than Words?MAHA Global and IPR: Do Actions Speak Louder Than Words?
MAHA Global and IPR: Do Actions Speak Louder Than Words?

The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024The CMO Survey - Highlights and Insights Report - Spring 2024
The CMO Survey - Highlights and Insights Report - Spring 2024

Japan IT Week 2024 Brochure by 47Billion (English)
Japan IT Week 2024 Brochure by 47Billion (English)Japan IT Week 2024 Brochure by 47Billion (English)
Japan IT Week 2024 Brochure by 47Billion (English)

Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...
Call Girls In Connaught Place Delhi ❤️88604**77959_Russian 100% Genuine Escor...

Vonnie simonsen

  • 1. Project Management for Every Size IT Project Vonnie (Yvonne) Simonsen, PMP Ames Research Center Code I Directorate Project Management Office Used with Permission
  • 2. Topic Overview The NASA Ames Research Center OCIO has developed and implemented a scaled approach (Lite/Medium frameworks) to Project Management utilizing NPR 7120.7 as the basis. The Lite and Medium project classifications provide flexibility in managing projects with the added benefit of structure, templates, and on line training modules. PM Challenge: February 2010 2
  • 3. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 3
  • 4. Why a Scaled Project Lifecycle Framework? Why did we need a scalable Project Framework? PROBLEM • Project Managers were not provided a common project management framework to follow for projects below the NPR 7120.7 thresholds. A standardized, consistent, holistic project management approach did not exist. • Management did not have an integrated standard view of projects across the Directorate and associated resource allocation data. SOLUTION • Develop and implement a scalable Project Framework that emulates project management best practices for projects below the NPR 7120.7 threshold. DIRECTORATE IT PROJECTS $500k and Over: Projects are Under $500k: Projects are required to follow the NPR 7120.7 required to follow the Code I project management structure $500K Project Lifecycle Framework and over Under $500K PM Challenge: February 2010 4
  • 5. Why a Scaled Project Lifecycle Framework? Why did we need a scalable Project Framework? 7102.7 IT Project Lifecycle 7120.7 Framework: Project Review and KDPs 1. System Concept Review (SCR) 2. KDP A – approval to move to Concept Development Phase 3. Enterprise Architecture Review (EA) 4. Info. /System Security Review 5. Information Assessment 6. System Requirement Review (SRR) 7. KDP B – approval to move to Prelim Design Phase 8. Preliminary Design Review (PDR) 9. Risk Assessment 10. KDP C – approval to move to Final Design & Build Phase • Why not apply the full NPR 7120.7 to ALL 11. Critical Design Review Projects? 12. KDP D – approval to move to Sys Assembly Integration & Test Phase IT teams need to balance NPR 7120.7 with project 13. Certification of Security Controls 14. Security Accreditation Decision agility and customer requirements. If an IT project 15. Test Readiness Review has an implementation timeframe of two months, 16. Operational Readiness Review (ORR) 17. KDP E – approval to move to Deploy Ops does it add value to require ALL projects 16 project & Sustainment Phase 18. Project Completion Review (PCR) reviews and six KDPs of NPR 7120.7? 19. EA Service Review (EASR) 20. Annual Self-Assessment of Controls 21. KDP F – approval to move to Decommissioning Phase 22. Decommissioning Review (DR) PM Challenge: February 2010 5
  • 6. Why a Scaled Project Lifecycle Framework? Why did we need a scalable Project Framework? • Why is the tailored Framework necessary? • Ensures Projects are following consistent and standard set of implementation processes and success criteria • Formulating, approving, implementing, and evaluating • Disseminating lessons learned • Aligning NASA’s IT investment and management practices with business requirements and strategic initiatives • Two way communication: provide insight and oversight to management as well as a forum to reach out to Management for assistance PM Challenge: February 2010 6
  • 7. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 7
  • 8. Scaled Framework Defined What is the Scaled Project Lifecycle Framework? • The Scaled Project Lifecycle Framework: • Is based on NASA’s NPR 7120.7, that establishes the program and project management requirements for NASA IT programs and projects. • NASA requires projects follow the NPR 7120.7 if the total development and implementation cost is $500,000 or more and/or the investment affects more than one Center. The NPR 7120.7 does not address projects under the thresholds. DIRECTORATE $500k and Over: Projects are IT PROJECTS required to follow the NPR 7120.7 Under $500k: No common project management structure project management structure $500K and over existed within Code I prior to the Under development of the Lite and $500K Medium Project Lifecycle Framework PM Challenge: February 2010 8
  • 9. Scaled Framework Defined The Scaled Project Framework is segmented into three project classifications: Lite, Medium, and Full • Lite Project Characteristics • $ 25K - $ 99K cost AND • Affects only ARC OR • Significantly impacts Directorate customers • Medium Project Characteristics • $ 100K - $ 499 K cost AND • Affects more than one Center OR • High visibility (Center mgmt., Agency/HQ , and/or other Center’s interest) • Full Project Characteristics • Greater than $ 500K development & implementation cost OR • Affects more than one Center PM Challenge: February 2010 9
  • 10. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 10
  • 11. Overview of the Lite and Medium Project Lifecycle Framework Lite: Lifecycle Framework LITE: $ 25K-$99K cost, effects only the Center, significantly impacts Directorate customers LIFECYCLE PHASES Formulation APPROVAL Implementation Initiation Acquisition & Development Implementation Operations Project Lifecycle Pre-Phase A: Phase A: Concept Phase B: Phase C: Final Phase D: System Phase E: Phase F: Phases Concept Studies Development Preliminary Design Design & Build Assembly Integration Deploy. Ops & Decommissioning & Test Sustainment Key Decision Points (KDPS) KDP-C KDP-E Project Reviews System Requirement Preliminary Design Operational. Review (SRR) Review (PDR) Readiness Review (ORR) EA Reviews and Requirements IT Security /System C&A Reviews & Info./ System Security --Certification of Security Categorization Requirements Controls --Security Accred. Decision Record Mgmt. & Privacy Reviews Available 1. FAD 1. Framework 1. PDR Criteria 1. ORR Criteria Agreement 2. PDR 2. ORR Presentation • Templates 2. SRR Criteria Presentation 3. KDP E 3. Info./ System 3. KDP C Security 4. Baseline Project Categorization Plan Instructions 5. Baseline MS 4. SRR Project Presentation Schedule 5. Project Plan 6. MS Project Schedule PM Challenge: February 2010 11
  • 12. Overview of the Lite and Medium Project Lifecycle Framework Medium: Lifecycle Framework MEDIUM: $ 100K-$ 499K cost, effects more than one Center, high visibility (Center mgmt., Agency/HQ , and/or other Center’s interest) LIFECYCLE PHASES Formulation APPROVAL Implementation Initiation Acquisition & Development Implementation Operations Project Lifecycle Pre-Phase A: Phase A: Concept Phase B: Phase C: Final Phase D: System Phase E: Phase F: Phases Concept Studies Development Preliminary Design Design & Build Assembly Integration Deploy. Ops & Decommissioning & Test Sustainment Key Decision Points (KDPS) KDP-C KDP-D KDP-E Project Reviews System Requirement Preliminary Design Critical Design Review Operational. Project Review (SRR) Review (PDR) (CDR) Readiness Review Completion (ORR) Review (PCR) Project Management Review (PMR) EA Reviews and Requirements IT Security /System Info./ System Security C&A Reviews & --Certification of Security Categorization Controls Requirements --Security Accred. Decision Record Mgmt. & Privacy Reviews Available 1. FAD 1. Framework 1. PDR Criteria 1. CDR Criteria 1. ORR Criteria 1. PCR Criteria Agreement 2. PDR 2. CDR 2. ORR Presentation 2. PCR Templates 2. SRR Criteria Presentation Presentation 3. KDP E Presentation 3. Info./ System 3. PMR Criteria 3. KDP D Security 4. PMR Categorization Presentation Instructions 5. KDP C 4. SRR 6. Baseline Project Presentation Plan 5. Project Plan 7. Baseline MS 6. MS Project Project Schedule Schedule PM Challenge: February 2010 12
  • 13. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 13
  • 14. Framework Flexibility The Framework is flexible and can be tailored to each project • Even though the Framework builds discipline into Directorate’s Project Management capabilities, it is flexible and can be tailored to each project. The Project Manager determines the appropriate reviews and KDPs. • The Project Management Office helps project leads determine their project management approach and provides training/coaching as necessary. This helps project leads understand what is required and how to get started. • Each Phase may require project review(s) and a KDP review before the project can move forward. The reviews and KDPs are called the Project Framework. Depending on the project, the Project Manager has the option to: • Present reviews and Key Decision Points (KDPs) together at the same Board meeting. For example; present SRR, PDR, KDP C together instead of separate meetings with approval from Division/Office Lead according to the Framework Agreement. • Add additional reviews (Test Readiness Reviews, additional Security reviews, EA Review, Change Control reviews, etc.) with approval from Division/Office Lead according to the Framework Agreement. Additionally, management can add further reviews if necessary. • Delete unnecessary reviews that do not add value to the project with approval from Division/Office Lead according to the Framework Agreement. PM Challenge: February 2010 14
  • 15. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 15
  • 16. Project Reviews REVIEWS Review Description Lite Medium Information / System Analysis of the information types to be stored and processed in the system to address three IT Security security objectives (Confidentiality, Integrity, and Availability). Determines the potential impact   Categorization that a loss would have on the system or functional line of business supported by the information system and the level of IT security required to manage risk to an acceptable level. The result of the analysis is an “IT security category,” validated by an appropriate NASA authority. NOTE: The Information/System Security Categorization Review is different from the other formal reviews required by the Code I Project Lifecycle Framework. The Information/System Security Categorization Review is NOT a formal review or meeting. It is a process that requires all Code I Projects to follow procedures documented in standard operating procedures (SOP). See the Information / System Security Categorization Instructions on the PMO website. System The SRR examines the functional, technical, performance, and security requirements for the Requirements system and elements of the preliminary Project Plan and ensures that the requirements and the   Review (SRR) selected concept will satisfy the system objectives. Preliminary Design The PDR demonstrates that the preliminary design meets all system requirements with Review (PDR) acceptable risk and within the cost and schedule constraints and establishes the basis for   proceeding with detailed design. It will show that the correct design option has been selected, interfaces have been identified, and verification methods have been described. Project Management Purpose of PMR: The PMR demonstrates that the project is managed to the Code I program and Review (PMR) project management requirements and best practices. The project meets requirements with  acceptable risk and within the cost and schedule constraints and establishes the basis for proceeding with the management of detailed design. Critical Design The CDR confirms that the maturity of the design is appropriate to support proceeding with Review (CDR) implementation, that it was developed in conjunction with stakeholders, demonstrates that the  design meets detailed requirements, and identifies open design issues for the purpose of obtaining a decision to proceed with development and deployment. It reviews the technical architecture to ascertain the effect on the enterprise architecture and reviews the application security design and the inclusion of security controls. PM Challenge: February 2010 16
  • 17. Project Reviews (continued) REVIEWS Review Description Lite Medium Security Comprehensive assessment of the management, operational and technical security controls and Certification other safeguards of an IT system. Establishes the extent to which a particular design and   implementation meets documented security requirements and any necessary remedial actions. NOTE: This is a continuation of the of the IT Security processes you started in Phase A, Information/System Security Categorization Instructions. Like the Information/System Security Categorization Review, the Security Certification is NOT a formal review or meeting. It is a process that requires all Code I Projects to follow procedures documented in the SOP. You must complete the Security Certification before holding an ORR. Security Formal declaration by an Authorizing Official that an IT system is compliant with established Accreditation security requirements, that any residual risks identified during the risk mitigation process are   acceptable, and that the system is approved to operate using a prescribed set of safeguards. NOTE: This is a continuation of the of the IT Security processes you started in Phase A, Information/System Security Categorization Instructions. Like the Information/System Security Categorization Review, the Security Accreditation is NOT a formal review or meeting. It is a process that requires all Code I Projects to follow procedures documented in the SOP. You must complete the Security Certification before holding an ORR. Operational The ORR determines that the project is ready to go-live with the system or service: Readiness Review requirements have been met; the functionality, performance, and security controls have been   (ORR) thoroughly tested; procedures are in place for operations; the users have been adequately trained; and, the organization responsible for operations and sustaining engineering is ready to assume responsibility. It ensures a security plan is in place and that system authorization has been received. Project Completion The PCR provides assurance that the implemented system is performing as expected and that all Review (PCR) necessary support requirements are in place and functioning properly. It confirms that the  system is operating properly in its production environment. It is the official closeout of the project and project team. The final project schedule is published and remaining open risks are transferred, closed, or accepted. At the conclusion of the PCR, the system is considered fully operational. PM Challenge: February 2010 17
  • 18. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 18
  • 19. Entrance and Success Criteria • What are entrance and success criteria for each review? • The entrance and success criteria are the recommended best practices for technical reviews conducted as a part of information technology projects. Entrance criteria and success criteria are the minimum requirements that should be completed before holding a review and the requirements to pass a review. • At the beginning of each phase, the project will determine the appropriate entrance and success criteria for the review and send it to the Review Board for review and approval well in advance of the actual Review. • How are entrance and success criteria for each review developed? • The PMO has developed recommended entrance and success criteria for each review based on the NPR 7120.7 but paired down to reflect the Lite and Medium project classifications within the Scaled Project Lifecycle Framework and formatted it to a user-friendly checklist. The framework allows for additions or deletions (with justification) to the entrance and success criteria as appropriate due to the unique nature of each project. • The entrance and success criteria should reflect the nature of the system under development; be appropriate for the project’s size, risk, and importance; and be achievable with approved project resources and on an acceptable schedule. • The Project Manager and team determine the appropriate entrance and success criteria. PM Challenge: February 2010 19
  • 20. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 20
  • 21. Example of PDR Entrance & Success Criteria: Preliminary Design Review (PDR) Criteria: Lite and Medium NASA LIFECYCLE Formulation APPROVAL Implementation PHASES Initiation Acquisition & Development Implementation Operations Project Lifecycle Pre-Phase A: Phase A: Concept Phase B: Phase C: Final Phase D: System Phase E: Phase F: Phases Concept Studies Development Preliminary Design Design & Build Assembly Integration Deploy. Ops & Decommissioning & Test Sustainment Key Decision Points (KDPS) KDP-C KDP-D KDP-E Project Reviews System Requirement Preliminary Design Critical Design Review Operational. Project Review (SRR) Review (PDR) (CDR) Readiness Review Completion (ORR) Review (PCR) Project Management Review (PMR) EA Reviews and Requirements IT Security /System C&A Info./ System Security --Certification of Security Categorization Controls (completed before Reviews & (completed before SRR) ORR) Requirements --Security Accred. Decision (completed before ORR) Record Mgmt. & Privacy Reviews PM Challenge: February 2010 21
  • 22. Example of PDR Entrance and Success Criteria: PDR Entrance and Success Criteria Purpose of PDR: The PDR demonstrates that the preliminary design meets all system requirements with acceptable risk and within the cost and schedule constraints and establishes the basis for proceeding with detailed design. It will show that the correct design options have been selected, interfaces have been identified, and verification methods have been described. Preliminary Design Review (PDR) Entrance Criteria Success Criteria Required? Choose Yes or No 1 A preliminary PDR agenda, success criteria, and  Yes  No charge to the board have been agreed to by the technical team, project manager, and review chair prior to the PDR. 2 Successful completion of the SRR and responses SRR RFAs are closed or a timely closure plan  Yes  No has been made to all SRR and Requests for exists for those remaining open. Action (RFAs), or a timely closure plan exists for those remaining open 3 RECOMMENDED: PDR technical work products listed below for both hardware and software system elements have been made available to the cognizant participants prior to the review: 3A MS Project Schedule High confidence exists in the MS Project  Yes  No Schedule baseline, and adequate documentation exists and/or will exist in a timely manner to allow proceeding with development, integration, and test. PM Challenge: February 2010 22
  • 23. Example of PDR Entrance and Success Criteria: PDR Entrance and Success Criteria Preliminary Design Review (PDR) Entrance Criteria Success Criteria Required? Choose Yes or No 3B Updated costs Adequate technical and programmatic margins  Yes  No and resources exist to complete the development within budget, schedule, and risk constraints. 3C Updated Risk assessment and mitigation The project risks are understood, and plans  Yes  No and a process and resources exist to effectively manage them. 3D Preliminary subsystem design specifications for The preliminary design is expected to meet  Yes  No each configuration item (hardware and software) the requirements at an acceptable level of with supporting tradeoff analyses and data, as risk. required. The preliminary software design specification needs to include a completed definition of the software architecture, preliminary database design description, and data conversion plan as applicable. PM Challenge: February 2010 23
  • 24. Example of PDR Entrance and Success Criteria: Optional: Additional PDR Entrance & Success criteria Preliminary Design Review (PDR) Entrance Criteria Success Criteria Required? Choose Yes or No 4 OPTIONAL (due to the unique nature of each project): PDR technical work products listed below for both hardware and software system elements have been made available to the cognizant participants prior to the review: 4A Updated baselined documentation, as required Agreement exists for the top-level requirements,  Yes  No including success criteria and any sponsor-imposed constraints, and ensures that these are finalized, stated clearly, and are consistent with the prelim. Design. 4B Updated logistics documentation, as required Adequate logistics processes are in place meeting  Yes  No the project’s requirements. 4C Applicable technical plans (e.g., technical Adequate technical margins exist with respect to  Yes  No performance measurement plan, reliability performance requirements. program plan, quality assurance plan) 4D Operational concept The operational concept is technically sound. It Yes  No includes (where appropriate) human factors that apply, and requirements for its execution flow down. PM Challenge: February 2010 24
  • 25. Example of PDR Entrance and Success Criteria: Optional: Additional PDR Entrance & Success criteria Preliminary Design Review (PDR) Entrance Criteria Success Criteria Required? Choose Yes or No 4E Applicable standards Applicable standards are being met per the project’s  Yes  No requirements. 4F Engineering drawing tree Engineering drawing tree is sound.  Yes  No 4G Interface control documents Definition of the technical interfaces is consistent with the  Yes  No overall technical maturity and provides an acceptable level of risk. 4H Verification/validation plan The flow down of verifiable requirements is complete and  Yes  No proper or, if not, an adequate plan exists for timely resolution of open items. Requirements are traceable to system goals and objectives. 4I Plans to respond to regulatory Plan in place to meet project’s requirements regulatory  Yes  No requirements (e.g., Section 508), as requirements. required 4J Requirements traceability matrix The flow down of verifiable requirements is complete and  Yes  No proper or, if not, an adequate plan exists for timely resolution of open items. Requirements are traceable to system goals and objectives. 4K Disposal plan Plan in place to meet project’s disposal requirements.  Yes  No 4L Technical resource utilization Adequate technical and programmatic margins and resources  Yes  No estimates and margins exist to complete the development within budget, schedule, and risk constraints. PM Challenge: February 2010 25
  • 26. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 26
  • 27. Key Decision Points (KDPs) KDPS Review Description Lite Medium KDP C - Lite KDP C is a point in time where the Decision Authority makes a decision on the readiness of project to progress to the next phase of the lifecycle, Phase C - Final Design & Build. Projects  must have completed or have a solid plan to complete all Requests for Action (RFAs) brought up by the Board during the Information/System Security Categorization, SRR, and PDR KDP C - Medium KDP C is a point in time where the Decision Authority makes a decision on the readiness of project to progress to the next phase of the lifecycle, Phase C - Final Design & Build. Projects  must have completed or have a solid plan to complete all Requests for Action (RFAs) brought up by the Board during the Information/System Security Categorization, SRR, PMR, and PDR. KDP D – Medium KDP D is a point in time where the Decision Authority makes a decision on the readiness of project to progress to the next phase of the lifecycle, Phase D - System Assembly Integration &  Test. Projects must have completed or have a solid plan to complete all Requests for Action (RFAs) brought up by the Board during the CDR. KDP E KDP E is a point in time where the Decision Authority makes a decision on the readiness of project to “go-live” and progress the next phase of the lifecycle, Phase E – Deployment,   Operations, and Sustainment. Projects must have completed or have a solid plan to complete all Requests for Action (RFAs) brought up by the Board during the ORR, Security Accreditation, and Security Certification. PM Challenge: February 2010 27
  • 28. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 28
  • 29. Who should attend a Review and KDP? • Project Manager & Technical Lead: • At a minimum, the Project Manager and Technical Lead present to the Governing Body. Other individuals involved in the project may be invited, however it is recommended that participants be limited to only those only those who must absolutely attend. • Reviews Governing Body: • The Governing Body is charted to approve, approve with Requests for Action, or disapprove the review. The Governing Body membership differs from one project to the next. For example, an infrastructure project may require a different Governing Body membership than a software development project. Project Managers are responsible for working with their management chain (and Project Sponsor, Customer, etc. if necessary) to select the appropriate members for the Governing Body. See the following slide for PMO recommendations on Governing Body membership for each review. • KDP Decision Authority Governing Body: • The KDP Decision Authority is charted to approve, approve with Requests for Action, or disapprove the Projects passing to the next Phase of the Project Life cycle. The KDP Governing Body may be either the Directorate IT Project Management Board (IT PMB), the Center IT PMB or the Agency IT PMB depending on the nature of the project and the interest at higher levels. Note: As best practice, projects should not use their reviews as the only communication vehicle to reach out. Projects should be communicating projects status to other interested parties through open forums, all-hand meetings, weekly meeting, emails, newsletters, reports, etc. PM Challenge: February 2010 29
  • 30. Review and Governing Bodies Lite: Recommended Governing Body Membership Lite Classification – Governing Body Membership Recommendation Review/KDP Recommended Governing Body Membership System Requirement Review (SRR) Division/Office Representative (Chair) Customer/Stakeholder Representative Governance & Policy Representative System Owner Info/System Security Categorization Review Preliminary Design Review (PDR) Division/Office Representative (Chair) Enterprise Architecture (EA) Representative ITSM Representative Technical Peers System Owner KDP C - IT Project Management Board Code I IT PMB Certification of Security Controls & Security Accreditation Decision Operational Readiness Review (ORR) CIO Representative (Chair) Customer/Stakeholder Representative Division/Office Representative Governance & Policy Representative Help Desk Rep (as applicable) IT Security Representative Operations Representative System Owner KDP E Code I IT PMB PM Challenge: February 2010 30
  • 31. Review and Governing Body Medium: Recommended Governing Body Membership Medium Classification – Governing Body Membership Medium Classification – Governing Body Membership Recommendations Recommendations (continued) Review/KDP Recommended Governing Body Review/KDP Recommended Governing Body Membership Membership SRR Division/Office Representative (Chair) Certification of Security CIO Representative Controls & Security Governance & Policy Representative Accreditation Decision Customer/Stakeholder Representative ORR CIO Representative (Chair) Help Desk Representative Customer/Stakeholder Representative Info./System Security Division/Office Rep Categorization Governance & Policy Rep Review Help Desk Rep (as applicable) PDR Division/Office Representative (Chair) IT Security Representative EA Representative Operations Representative ITSM Representative System Owner Technical Peers KDP E Code I IT PMB PMR PMO Representative (Chair) PCR CIO Rep (Chair) Budget Management Office Representative Customer/Stakeholder Representative KDP C Code I IT PMB Division/Office Rep CDR Division/Office Representative (Chair) PMO Representative Customer/Stakeholder Representative Enterprise Architecture Representative Technical Peers KDP D Code I IT PMB PM Challenge: February 2010 31
  • 32. Project Management for Every Size IT Project • Why a Scalable Framework? • Scaled Framework Defined • Overview of Lite and Medium Project Lifecycle • Framework Flexibility • Project Reviews • Entrance and Success Criteria • Example of PDR Entrance and Success Criteria • Key Decision Points (KDPs) • Review and KDP Governing Bodies • SATERN On Line Training PM Challenge: February 2010 32
  • 33. SATERN On Line Training PM Challenge: February 2010 33
  • 34. Thanks for attending today’s presentation….. 34
