Broad-Based Teams
Case Study #1 - Composite Crew Module (CCM)

        Project Management Challenge 2009
              Daytona Beach, Florida
                February 24-25, 2009

         Mike Kirsch, CCM Project Manager
        NASA Engineering and Safety Center
                 Principal Engineer

                            Engineering Excellence
         This briefing is for status only and may not represent complete engineering information
NESC Overview

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information
NESC Overview

•   In 2003, the NASA Engineering & Safety Center (NESC) was formed as a
    response to a Columbia Accident Investigation Board observation
•   The NESC mission is to provide the Agency’s Programs and Projects with
    rigorous independent technical perspectives on their most critical
    technical issues

Five years later – The NESC remains independent:
•   Centrally managed and funded through the Office of Chief Engineer
•   Small staff of senior leaders and technical experts to lead broad based
    engineering teams in “tiger team” fashion
•   Unaffiliated with and unbiased by any specific NASA Program or Center
•   Has an independent engineering chain of command to assure an avenue for
    consideration of all points of view
•   Facilitating hands-on design and development experience

                                       Engineering Excellence
                    This briefing is for status only and may not represent complete engineering information
NESC Background

    NESC emphasis is to create broad-based teams to enable networks that
    discourage silos
•    Recruit team membership                                                                         •     Facilitate inter-Center
     from a broad community                                                                                collaboration
•    Increase inter-Center                                                                           •     Encourage inter-Center
     knowledge and information                                                                             relationships and
     flow                                                                                                  communities of practice

                                           Engineering Excellence
                        This briefing is for status only and may not represent complete engineering information
NESC Composite Crew Module

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information
January 2007 NASA Administrator
chartered the NESC to form an
agency team to…
 • design and build a composite crew module,
 • gain hands-on design, build, and test
   experience,
 • in anticipation that future exploration
   system may be made of composite
   materials.

                                                Engineering Excellence
                             This briefing is for status only and may not represent complete engineering information

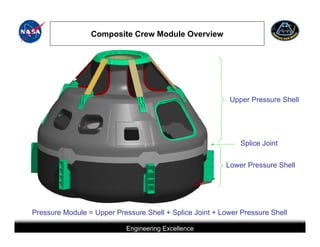

Composite Crew Module Overview

                                                                                                              Upper Pressure Shell

                                                                                                                 Splice Joint

                                                                                                             Lower Pressure Shell

Pressure Module = Upper Pressure Shell + Splice Joint + Lower Pressure Shell

                                      Engineering Excellence
                   This briefing is for status only and may not represent complete engineering information

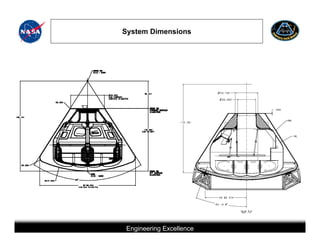

System Dimensions

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

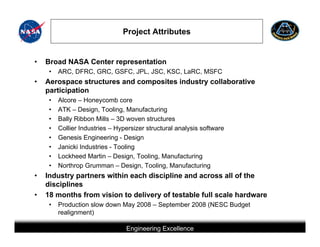

Project Attributes

•   Broad NASA Center representation
     •   ARC, DFRC, GRC, GSFC, JPL, JSC, KSC, LaRC, MSFC
•   Aerospace structures and composites industry collaborative
    participation
     •   Alcore – Honeycomb core
     •   ATK – Design, Tooling, Manufacturing
     •   Bally Ribbon Mills – 3D woven structures
     •   Collier Industries – Hypersizer structural analysis software
     •   Genesis Engineering - Design
     •   Janicki Industries - Tooling
     •   Lockheed Martin – Design, Tooling, Manufacturing
     •   Northrop Grumman – Design, Tooling, Manufacturing
•   Industry partners within each discipline and across all of the
    disciplines
•   18 months from vision to delivery of testable full scale hardware
     •   Production slow down May 2008 – September 2008 (NESC Budget
         realignment)

                                          Engineering Excellence
                       This briefing is for status only and may not represent complete engineering information
Project Management
                                   Project Manager                             Mike Kirsch                             LARC
                                   Deputy Project Mgr--Technical Integration   Jeff Stewart                            GSFC
                                   Deputy Project Mgr--Technology Dev.         Paul Roberts                            LARC
                                   Administrative Assistant                    Terri Derby                             ATK (Swales)

                                  Support                                                                                        Advisors
    Resource Analyst            Pamela Throckmorton         LARC                              Advisor                       Damodar Ambur                LARC
    Pro-E & IT Admin            Mike Mongilio               ATK (Swales)                      Advisor                       Tom Modlin                   JSC
    Program Support             Steve Summit                ATK (Iuka)                        Advisor                       Joe Pellicciotti             GSFC
                                                                                              Advisor                       Tod Palm                     NGC

  Testing         Materials                                Analysis                         Design Engineering                       Manufacturing                  NDE
     Lead            Lead                                      Lead                                     Lead                               Lead                     Lead
 Sotiris Kellas     Dan Polis                               Jim Jeans                                Jeff Stewart                      Larry Pelham              Ken Hodges
    LARC             GSFC                               Genesis Engineering                             GSFC                              MSFC                      JSC

 Chip McCann      Wade Jackson             David Sleight                 Craig Collier              Ian Fernandez         Dawson Vincent      Randy Sparks       Tristan Curry
     JSC             LARC                     LARC                  Collier Research Corp                ARC               NGC (MSFC)        ATK (Clearfield)         UAH
 John Thesken      Ben Rodini          Jonathan Bartley-Cho              Phil Yarrington            Dave Paddock           Mike Western        Tom McCabe        Elliott Cramer
     GRC             SGT              Northrop Grumman Corp          Collier Research Corp             LARC                   Janicki           ATK (Iuka)            LARC
 Donny Wang       Ron Schmidt             Eric Schleicher                                             Jerry Stuart
                                                                        Steve Rickman                    NGC                Eric Friesen     Chip Henderson      Brad Parker
    NGC              LMC                  ATK (Swales)                                                                                                             GSFC
                                                                             JSC                                               Janicki         ATK (Iuka)
 Marc Dinardo                                                                                         Luis Santos
                                           Perry Wagner                  Laurie Carrillo                                  Robert Boscia          Fred Hall        Jeff Stone
    LMC                                                                                                  GSFC
                                           ATK (Swales)                       JSC                                            Alcore             ATK (Iuka)        ATK (Iuka)
                                                                                                   Dan Richardson
Wayne Sawyer                             Charles Kaprielian                                                                                                      Sam Russell
                                                                        Angel Alvarez-              ATK (Swales)          Terry Graham     Touch (ATK)
   AS&M                                    ATK (Swales)                                                                                                            MSFC
                                                                         Hernandez                                         ATK (MSFC)      Stephen Williams
                                                                                                       Bill Kelly
Jared Schoenly                                                              JSC                                                            Rance Jones          James Walker
                                          Brett Bednarcyk                                            ATK (Swales)            Mike Abel
     AMA                                                                                                                                   Cindy Sowards           MSFC
                                                GRC                      Ed Fasanella                                           ATK
                                                                                                    Doug Lenhardt                          Danny Lambert
                                                                            LaRC                                                           Andrew Johnson       Steven Johnson
                                                                                                        KSC
                                                                                                                                           Jerry Gray             ATK (Iuka)
                                                                            Al Tabiei               Craig Bowser                           Phil Thompson
                                                                             MPSE                   ATK Swales                                                   Scott Ragasa
                                                                                                                                                                     UAH

                                                              Engineering Excellence
                                           This briefing is for status only and may not represent complete engineering information

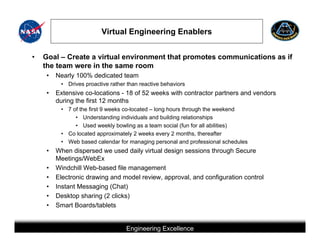

Virtual Engineering Enablers

•   Goal – Create a virtual environment that promotes communications as if
    the team were in the same room
     •   Nearly 100% dedicated team
          • Drives proactive rather than reactive behaviors
     •   Extensive co-locations - 18 of 52 weeks with contractor partners and vendors
         during the first 12 months
          • 7 of the first 9 weeks co-located – long hours through the weekend
               • Understanding individuals and building relationships
               • Used weekly bowling as a team social (fun for all abilities)
          • Co located approximately 2 weeks every 2 months, thereafter
          • Web based calendar for managing personal and professional schedules
     •   When dispersed we used daily virtual design sessions through Secure
         Meetings/WebEx
     •   Windchill Web-based file management
     •   Electronic drawing and model review, approval, and configuration control
     •   Instant Messaging (Chat)
     •   Desktop sharing (2 clicks)
     •   Smart Boards/tablets

                                           Engineering Excellence
                        This briefing is for status only and may not represent complete engineering information

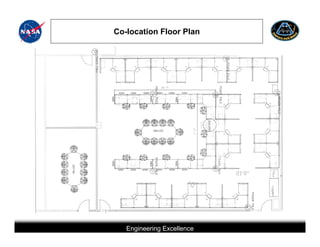

Co-location Floor Plan

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

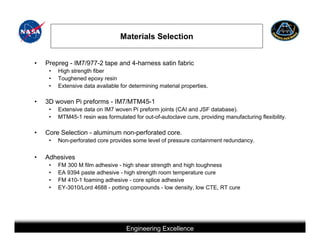

Materials Selection

•   Prepreg - IM7/977-2 tape and 4-harness satin fabric
     •   High strength fiber
     •   Toughened epoxy resin
     •   Extensive data available for determining material properties.

•   3D woven Pi preforms - IM7/MTM45-1
     •   Extensive data on IM7 woven Pi preform joints (CAI and JSF database).
     •   MTM45-1 resin was formulated for out-of-autoclave cure, providing manufacturing flexibility.

•   Core Selection - aluminum non-perforated core.
     •   Non-perforated core provides some level of pressure containment redundancy.

•   Adhesives
     •   FM 300 M film adhesive - high shear strength and high toughness
     •   EA 9394 paste adhesive - high strength room temperature cure
     •   FM 410-1 foaming adhesive - core splice adhesive
     •   EY-3010/Lord 4688 - potting compounds - low density, low CTE, RT cure

                                            Engineering Excellence
                         This briefing is for status only and may not represent complete engineering information

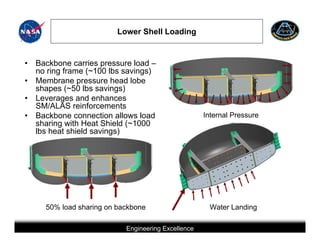

Lower Shell Loading

•   Backbone carries pressure load –
    no ring frame (~100 lbs savings)
•   Membrane pressure head lobe
    shapes (~50 lbs savings)
•   Leverages and enhances
    SM/ALAS reinforcements
•   Backbone connection allows load                                                          Internal Pressure
    sharing with Heat Shield (~1000
    lbs heat shield savings)

      50% load sharing on backbone                                                               Water Landing

                                       Engineering Excellence
                    This briefing is for status only and may not represent complete engineering information

New Technology - Cobonded Joints - Air Force CAI

                                                                                 •      Replaces bonded or bolted
                                                                                        joints
                                                                                 •      3D-woven “Pi” shape preform
                                                                                 •      Cobonded Pi preforms
                                                                                        comprise majority of
                                                                                        connections
                                                                                 •      Lobe core tapers out before Pi
                                                                                 •      Also used to bond Gussets to
                                                                                        upper shell

                            Engineering Excellence
         This briefing is for status only and may not represent complete engineering information

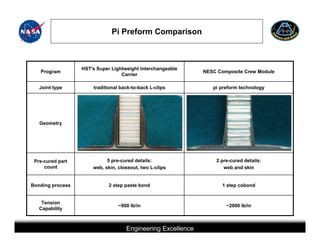

Pi Preform Comparison

                  HST's Super Lightweight Interchangeable
   Program                                                                                       NESC Composite Crew Module
                                  Carrier

   Joint type         traditional back-to-back L-clips                                                  pi preform technology

   Geometry

 Pre-cured part             5 pre-cured details:                                                          2 pre-cured details:
     count            web, skin, closeout, two L-clips                                                       web and skin

Bonding process                2 step paste bond                                                              1 step cobond

    Tension
                                     ~900 lb/in                                                                   ~2000 lb/in
   Capability

                                           Engineering Excellence
                        This briefing is for status only and may not represent complete engineering information

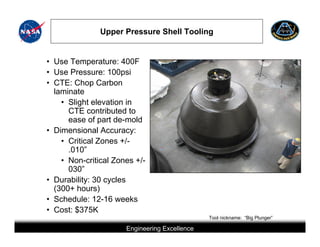

Upper Pressure Shell Tooling

• Use Temperature: 400F
• Use Pressure: 100psi
• CTE: Chop Carbon
  laminate
    • Slight elevation in
      CTE contributed to
      ease of part de-mold
• Dimensional Accuracy:
    • Critical Zones +/-
      .010”
    • Non-critical Zones +/-
      030”
• Durability: 30 cycles
  (300+ hours)
• Schedule: 12-16 weeks
• Cost: $375K
                                                                                           Tool nickname: “Big Plunger”

                                 Engineering Excellence
              This briefing is for status only and may not represent complete engineering information

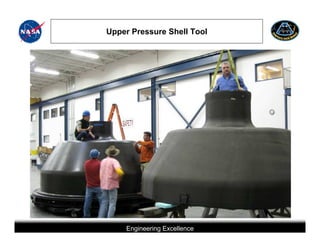

Upper Pressure Shell Tool

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

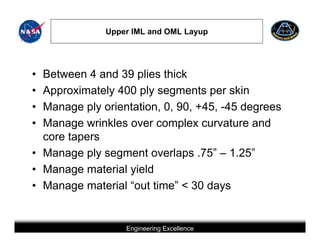

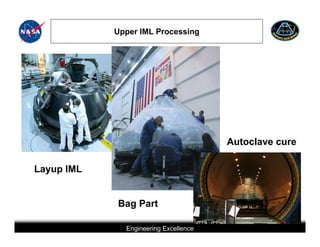

Upper IML Processing

                                                                                                      Autoclave cure

Layup IML

                         Bag Part

                               Engineering Excellence
            This briefing is for status only and may not represent complete engineering information

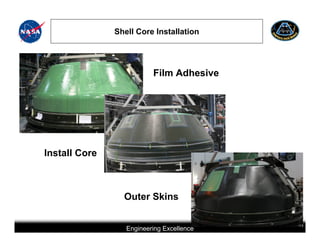

Shell Core Installation

                                                      Film Adhesive

 Install Core

                                  Outer Skins
Debagging                                                       Tacked Ceiling Core
                                   Engineering Excellence
                This briefing is for status only and may not represent complete engineering information

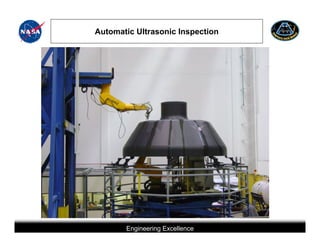

Automatic Ultrasonic Inspection

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

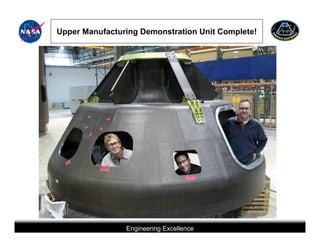

Upper Manufacturing Demonstration Unit Complete!

                            Engineering Excellence
         This briefing is for status only and may not represent complete engineering information

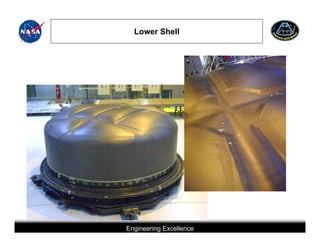

Lower Shell

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information
Upper IML and OML Layup

• Between 4 and 39 plies thick
• Approximately 400 ply segments per skin
• Manage ply orientation, 0, 90, +45, -45 degrees
• Manage wrinkles over complex curvature and
  core tapers
• Manage ply segment overlaps .75” – 1.25”
• Manage material yield
• Manage material “out time” < 30 days

                                Engineering Excellence
             This briefing is for status only and may not represent complete engineering information

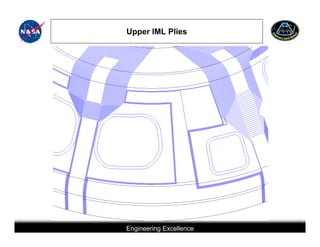

Upper IML Plies

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information
1 IML Ply Segment

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

1 ply segment

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information
Flat Patterns

•   Integrated electronic process flow exists
•   Design, Manufacturing, and Inspection via
     •   CAD, NASTRAN, FiberSIM, flat patterns, laser projection, layup, inspection

                                         Engineering Excellence
                      This briefing is for status only and may not represent complete engineering information
Civil Servant “Hands On” Experience

                     Ian Fernandez,
                     Design Engineer
                     ARC
Dave Sleight,
Structural Analyst
LaRC

     Cecilia Larrosa,
     Aerospace engineering intern
     ARC
                                         Engineering Excellence
                      This briefing is for status only and may not represent complete engineering information

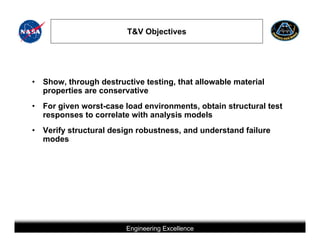

T&V Objectives

•   Show, through destructive testing, that allowable material
    properties are conservative
•   For given worst-case load environments, obtain structural test
    responses to correlate with analysis models
•   Verify structural design robustness, and understand failure
    modes

                                     Engineering Excellence
                  This briefing is for status only and may not represent complete engineering information

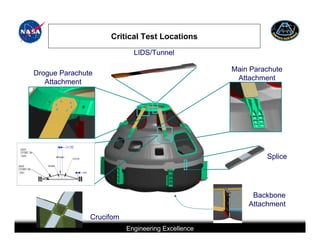

Critical Test Locations
                                           LIDS/Tunnel

                                                                                                             Main Parachute
Drogue Parachute
                                                                                                              Attachment
   Attachment

                                                                                                                      Splice

                                                                                                                  Backbone
                                                                                                                 Attachment
               Crucifom
                                      Engineering Excellence
                   This briefing is for status only and may not represent complete engineering information
Building Block Approach Tests

•   Coupon
     •   Sandwich flatwise tension - complete
     •   Edgewise compression - complete
     •   Pi preform (1/8” clevis)
           •   pull off - complete
           •   shear - complete
     •   Visual impact study tests – on hold
     •   Permeability tests – before and after impact – in work
•   Element
     •   LIDS/tunnel double lap joint - complete
     •   Splice
           •   Acreage - complete
           •   Longeron – complete
           •   Offset – ECD 12/08
     •   Backbone attachment pull-off
           •   0° - complete
           •   20°- complete
     •   Backbone attachment shear ECD – 1/09
     •   Cruciform - complete
•   Component
     •   SM/ALAS simplified interface (flat panel)
           •   Non-potted core – complete
           •   Potted core - complete

                                                   Engineering Excellence
                                This briefing is for status only and may not represent complete engineering information

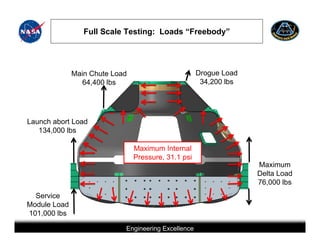

Full Scale Testing: Loads “Freebody”

              Main Chute Load                                                           Drogue Load
                 64,400 lbs                                                              34,200 lbs

Launch abort Load
   134,000 lbs

                                             Maximum Internal
                                             Pressure, 31.1 psi
                                                                                                               Maximum
                                                                                                               Delta Load
                                                                                                               76,000 lbs
  Service
Module Load
101,000 lbs

                                        Engineering Excellence
                     This briefing is for status only and may not represent complete engineering information

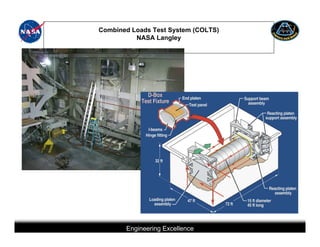

Combined Loads Test System (COLTS)
          NASA Langley

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

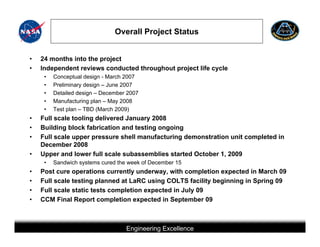

Overall Project Status

•   24 months into the project
•   Independent reviews conducted throughout project life cycle
     •   Conceptual design - March 2007
     •   Preliminary design – June 2007
     •   Detailed design – December 2007
     •   Manufacturing plan – May 2008
     •   Test plan – TBD (March 2009)
•   Full scale tooling delivered January 2008
•   Building block fabrication and testing ongoing
•   Full scale upper pressure shell manufacturing demonstration unit completed in
    December 2008
•   Upper and lower full scale subassemblies started October 1, 2009
     •   Sandwich systems cured the week of December 15
•   Post cure operations currently underway, with completion expected in March 09
•   Full scale testing planned at LaRC using COLTS facility beginning in Spring 09
•   Full scale static tests completion expected in July 09
•   CCM Final Report completion expected in September 09

                                            Engineering Excellence
                         This briefing is for status only and may not represent complete engineering information
Composite Crew Module

                   Engineering Excellence
This briefing is for status only and may not represent complete engineering information

Kirsch.mike

  • 1.
    Broad-Based Teams Case Study#1 - Composite Crew Module (CCM) Project Management Challenge 2009 Daytona Beach, Florida February 24-25, 2009 Mike Kirsch, CCM Project Manager NASA Engineering and Safety Center Principal Engineer Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 2.
    NESC Overview Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 3.
    NESC Overview • In 2003, the NASA Engineering & Safety Center (NESC) was formed as a response to a Columbia Accident Investigation Board observation • The NESC mission is to provide the Agency’s Programs and Projects with rigorous independent technical perspectives on their most critical technical issues Five years later – The NESC remains independent: • Centrally managed and funded through the Office of Chief Engineer • Small staff of senior leaders and technical experts to lead broad based engineering teams in “tiger team” fashion • Unaffiliated with and unbiased by any specific NASA Program or Center • Has an independent engineering chain of command to assure an avenue for consideration of all points of view • Facilitating hands-on design and development experience Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 4.
    NESC Background NESC emphasis is to create broad-based teams to enable networks that discourage silos • Recruit team membership • Facilitate inter-Center from a broad community collaboration • Increase inter-Center • Encourage inter-Center knowledge and information relationships and flow communities of practice Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 5.
    NESC Composite CrewModule Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 6.
    January 2007 NASAAdministrator chartered the NESC to form an agency team to… • design and build a composite crew module, • gain hands-on design, build, and test experience, • in anticipation that future exploration system may be made of composite materials. Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 7.
    Composite Crew ModuleOverview Upper Pressure Shell Splice Joint Lower Pressure Shell Pressure Module = Upper Pressure Shell + Splice Joint + Lower Pressure Shell Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 8.
    System Dimensions Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 9.
    Project Attributes • Broad NASA Center representation • ARC, DFRC, GRC, GSFC, JPL, JSC, KSC, LaRC, MSFC • Aerospace structures and composites industry collaborative participation • Alcore – Honeycomb core • ATK – Design, Tooling, Manufacturing • Bally Ribbon Mills – 3D woven structures • Collier Industries – Hypersizer structural analysis software • Genesis Engineering - Design • Janicki Industries - Tooling • Lockheed Martin – Design, Tooling, Manufacturing • Northrop Grumman – Design, Tooling, Manufacturing • Industry partners within each discipline and across all of the disciplines • 18 months from vision to delivery of testable full scale hardware • Production slow down May 2008 – September 2008 (NESC Budget realignment) Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 10.
    Project Management Project Manager Mike Kirsch LARC Deputy Project Mgr--Technical Integration Jeff Stewart GSFC Deputy Project Mgr--Technology Dev. Paul Roberts LARC Administrative Assistant Terri Derby ATK (Swales) Support Advisors Resource Analyst Pamela Throckmorton LARC Advisor Damodar Ambur LARC Pro-E & IT Admin Mike Mongilio ATK (Swales) Advisor Tom Modlin JSC Program Support Steve Summit ATK (Iuka) Advisor Joe Pellicciotti GSFC Advisor Tod Palm NGC Testing Materials Analysis Design Engineering Manufacturing NDE Lead Lead Lead Lead Lead Lead Sotiris Kellas Dan Polis Jim Jeans Jeff Stewart Larry Pelham Ken Hodges LARC GSFC Genesis Engineering GSFC MSFC JSC Chip McCann Wade Jackson David Sleight Craig Collier Ian Fernandez Dawson Vincent Randy Sparks Tristan Curry JSC LARC LARC Collier Research Corp ARC NGC (MSFC) ATK (Clearfield) UAH John Thesken Ben Rodini Jonathan Bartley-Cho Phil Yarrington Dave Paddock Mike Western Tom McCabe Elliott Cramer GRC SGT Northrop Grumman Corp Collier Research Corp LARC Janicki ATK (Iuka) LARC Donny Wang Ron Schmidt Eric Schleicher Jerry Stuart Steve Rickman NGC Eric Friesen Chip Henderson Brad Parker NGC LMC ATK (Swales) GSFC JSC Janicki ATK (Iuka) Marc Dinardo Luis Santos Perry Wagner Laurie Carrillo Robert Boscia Fred Hall Jeff Stone LMC GSFC ATK (Swales) JSC Alcore ATK (Iuka) ATK (Iuka) Dan Richardson Wayne Sawyer Charles Kaprielian Sam Russell Angel Alvarez- ATK (Swales) Terry Graham Touch (ATK) AS&M ATK (Swales) MSFC Hernandez ATK (MSFC) Stephen Williams Bill Kelly Jared Schoenly JSC Rance Jones James Walker Brett Bednarcyk ATK (Swales) Mike Abel AMA Cindy Sowards MSFC GRC Ed Fasanella ATK Doug Lenhardt Danny Lambert LaRC Andrew Johnson Steven Johnson KSC Jerry Gray ATK (Iuka) Al Tabiei Craig Bowser Phil Thompson MPSE ATK Swales Scott Ragasa UAH Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 11.
    Virtual Engineering Enablers • Goal – Create a virtual environment that promotes communications as if the team were in the same room • Nearly 100% dedicated team • Drives proactive rather than reactive behaviors • Extensive co-locations - 18 of 52 weeks with contractor partners and vendors during the first 12 months • 7 of the first 9 weeks co-located – long hours through the weekend • Understanding individuals and building relationships • Used weekly bowling as a team social (fun for all abilities) • Co located approximately 2 weeks every 2 months, thereafter • Web based calendar for managing personal and professional schedules • When dispersed we used daily virtual design sessions through Secure Meetings/WebEx • Windchill Web-based file management • Electronic drawing and model review, approval, and configuration control • Instant Messaging (Chat) • Desktop sharing (2 clicks) • Smart Boards/tablets Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 12.
    Co-location Floor Plan Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 13.
    Materials Selection • Prepreg - IM7/977-2 tape and 4-harness satin fabric • High strength fiber • Toughened epoxy resin • Extensive data available for determining material properties. • 3D woven Pi preforms - IM7/MTM45-1 • Extensive data on IM7 woven Pi preform joints (CAI and JSF database). • MTM45-1 resin was formulated for out-of-autoclave cure, providing manufacturing flexibility. • Core Selection - aluminum non-perforated core. • Non-perforated core provides some level of pressure containment redundancy. • Adhesives • FM 300 M film adhesive - high shear strength and high toughness • EA 9394 paste adhesive - high strength room temperature cure • FM 410-1 foaming adhesive - core splice adhesive • EY-3010/Lord 4688 - potting compounds - low density, low CTE, RT cure Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 14.
    Lower Shell Loading • Backbone carries pressure load – no ring frame (~100 lbs savings) • Membrane pressure head lobe shapes (~50 lbs savings) • Leverages and enhances SM/ALAS reinforcements • Backbone connection allows load Internal Pressure sharing with Heat Shield (~1000 lbs heat shield savings) 50% load sharing on backbone Water Landing Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 15.
    New Technology -Cobonded Joints - Air Force CAI • Replaces bonded or bolted joints • 3D-woven “Pi” shape preform • Cobonded Pi preforms comprise majority of connections • Lobe core tapers out before Pi • Also used to bond Gussets to upper shell Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 16.
    Pi Preform Comparison HST's Super Lightweight Interchangeable Program NESC Composite Crew Module Carrier Joint type traditional back-to-back L-clips pi preform technology Geometry Pre-cured part 5 pre-cured details: 2 pre-cured details: count web, skin, closeout, two L-clips web and skin Bonding process 2 step paste bond 1 step cobond Tension ~900 lb/in ~2000 lb/in Capability Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 17.
    Upper Pressure ShellTooling • Use Temperature: 400F • Use Pressure: 100psi • CTE: Chop Carbon laminate • Slight elevation in CTE contributed to ease of part de-mold • Dimensional Accuracy: • Critical Zones +/- .010” • Non-critical Zones +/- 030” • Durability: 30 cycles (300+ hours) • Schedule: 12-16 weeks • Cost: $375K Tool nickname: “Big Plunger” Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 18.
    Upper Pressure ShellTool Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 19.
    Upper IML Processing Autoclave cure Layup IML Bag Part Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 20.
    Shell Core Installation Film Adhesive Install Core Outer Skins Debagging Tacked Ceiling Core Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 21.
    Automatic Ultrasonic Inspection Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 22.
    Upper Manufacturing DemonstrationUnit Complete! Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 23.
    Lower Shell Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 24.
    Upper IML andOML Layup • Between 4 and 39 plies thick • Approximately 400 ply segments per skin • Manage ply orientation, 0, 90, +45, -45 degrees • Manage wrinkles over complex curvature and core tapers • Manage ply segment overlaps .75” – 1.25” • Manage material yield • Manage material “out time” < 30 days Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 25.
    Upper IML Plies Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 26.
    1 IML PlySegment Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 27.
    1 ply segment Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 28.
    Flat Patterns • Integrated electronic process flow exists • Design, Manufacturing, and Inspection via • CAD, NASTRAN, FiberSIM, flat patterns, laser projection, layup, inspection Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 29.
    Civil Servant “HandsOn” Experience Ian Fernandez, Design Engineer ARC Dave Sleight, Structural Analyst LaRC Cecilia Larrosa, Aerospace engineering intern ARC Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 30.
    T&V Objectives • Show, through destructive testing, that allowable material properties are conservative • For given worst-case load environments, obtain structural test responses to correlate with analysis models • Verify structural design robustness, and understand failure modes Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 31.
    Critical Test Locations LIDS/Tunnel Main Parachute Drogue Parachute Attachment Attachment Splice Backbone Attachment Crucifom Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 32.
    Building Block ApproachTests • Coupon • Sandwich flatwise tension - complete • Edgewise compression - complete • Pi preform (1/8” clevis) • pull off - complete • shear - complete • Visual impact study tests – on hold • Permeability tests – before and after impact – in work • Element • LIDS/tunnel double lap joint - complete • Splice • Acreage - complete • Longeron – complete • Offset – ECD 12/08 • Backbone attachment pull-off • 0° - complete • 20°- complete • Backbone attachment shear ECD – 1/09 • Cruciform - complete • Component • SM/ALAS simplified interface (flat panel) • Non-potted core – complete • Potted core - complete Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 33.
    Full Scale Testing:Loads “Freebody” Main Chute Load Drogue Load 64,400 lbs 34,200 lbs Launch abort Load 134,000 lbs Maximum Internal Pressure, 31.1 psi Maximum Delta Load 76,000 lbs Service Module Load 101,000 lbs Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 34.
    Combined Loads TestSystem (COLTS) NASA Langley Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 35.
    Overall Project Status • 24 months into the project • Independent reviews conducted throughout project life cycle • Conceptual design - March 2007 • Preliminary design – June 2007 • Detailed design – December 2007 • Manufacturing plan – May 2008 • Test plan – TBD (March 2009) • Full scale tooling delivered January 2008 • Building block fabrication and testing ongoing • Full scale upper pressure shell manufacturing demonstration unit completed in December 2008 • Upper and lower full scale subassemblies started October 1, 2009 • Sandwich systems cured the week of December 15 • Post cure operations currently underway, with completion expected in March 09 • Full scale testing planned at LaRC using COLTS facility beginning in Spring 09 • Full scale static tests completion expected in July 09 • CCM Final Report completion expected in September 09 Engineering Excellence This briefing is for status only and may not represent complete engineering information
  • 36.
    Composite Crew Module Engineering Excellence This briefing is for status only and may not represent complete engineering information
