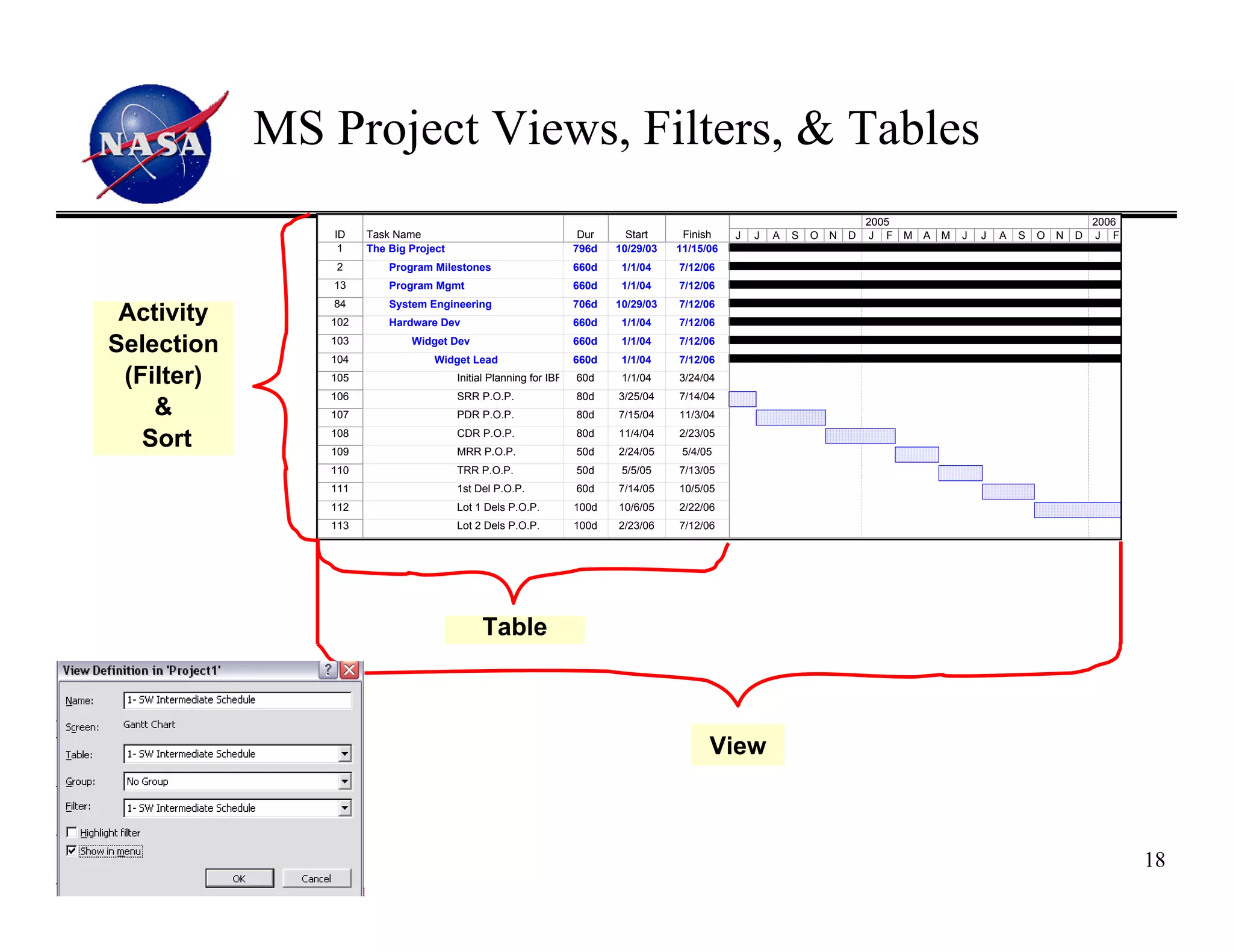

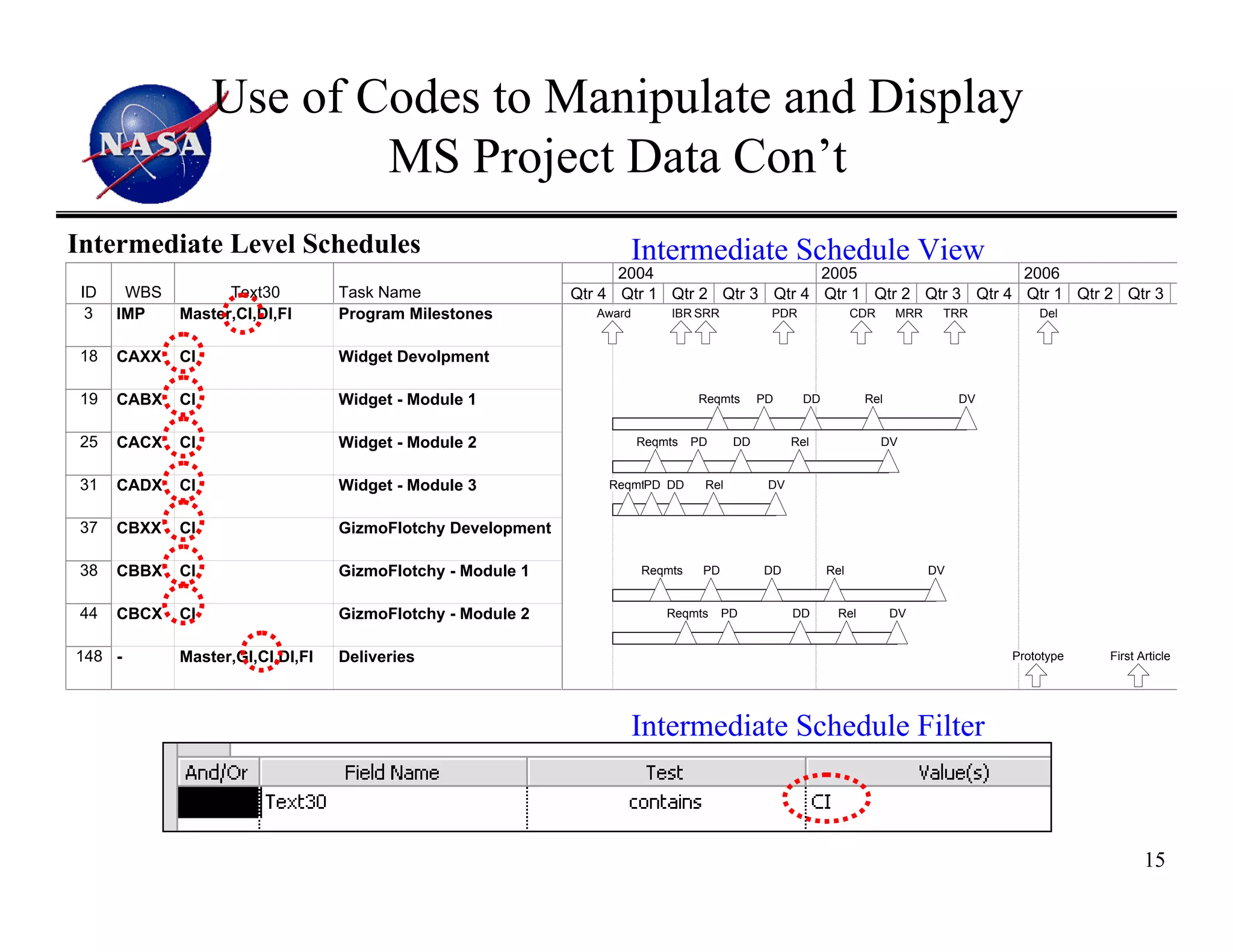

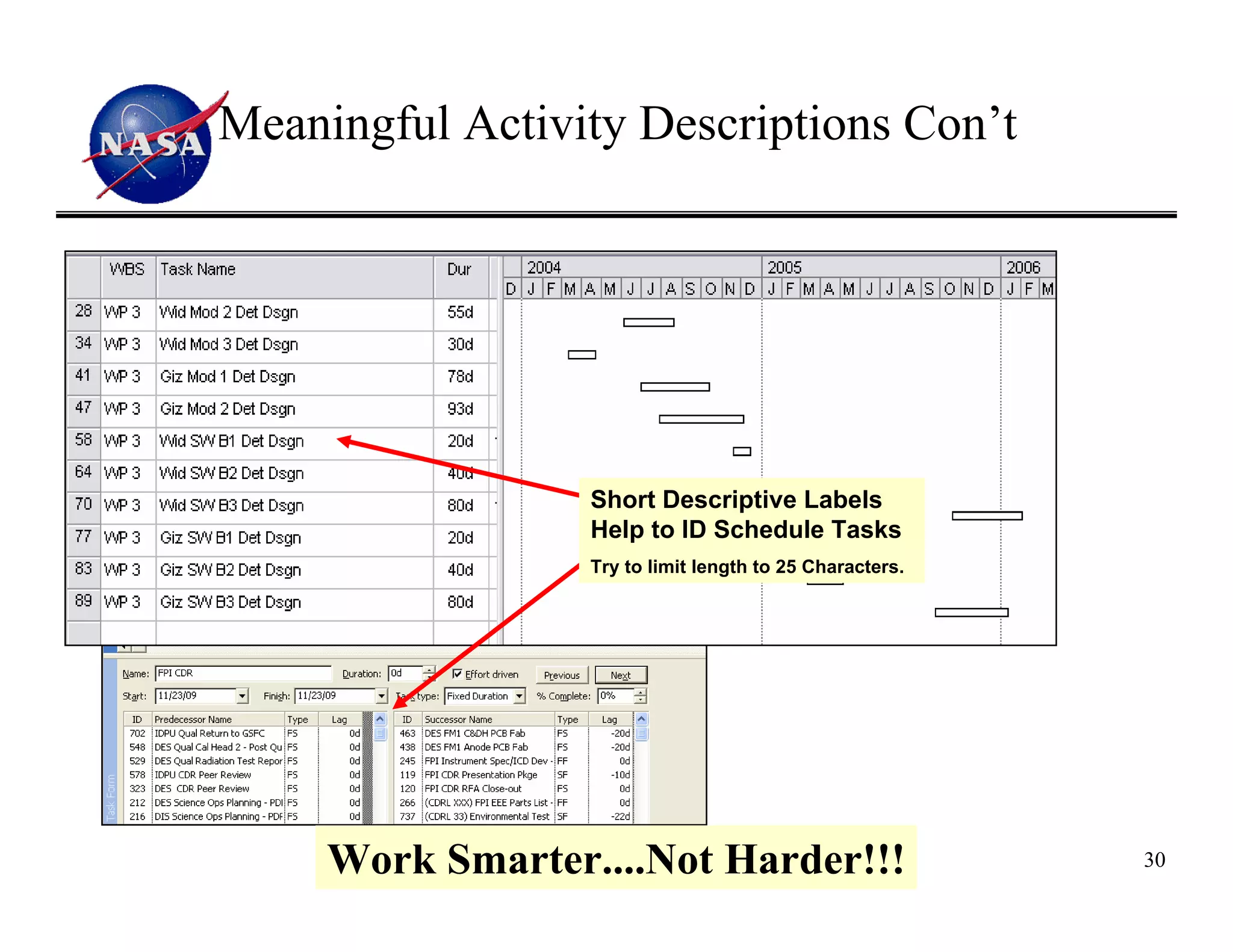

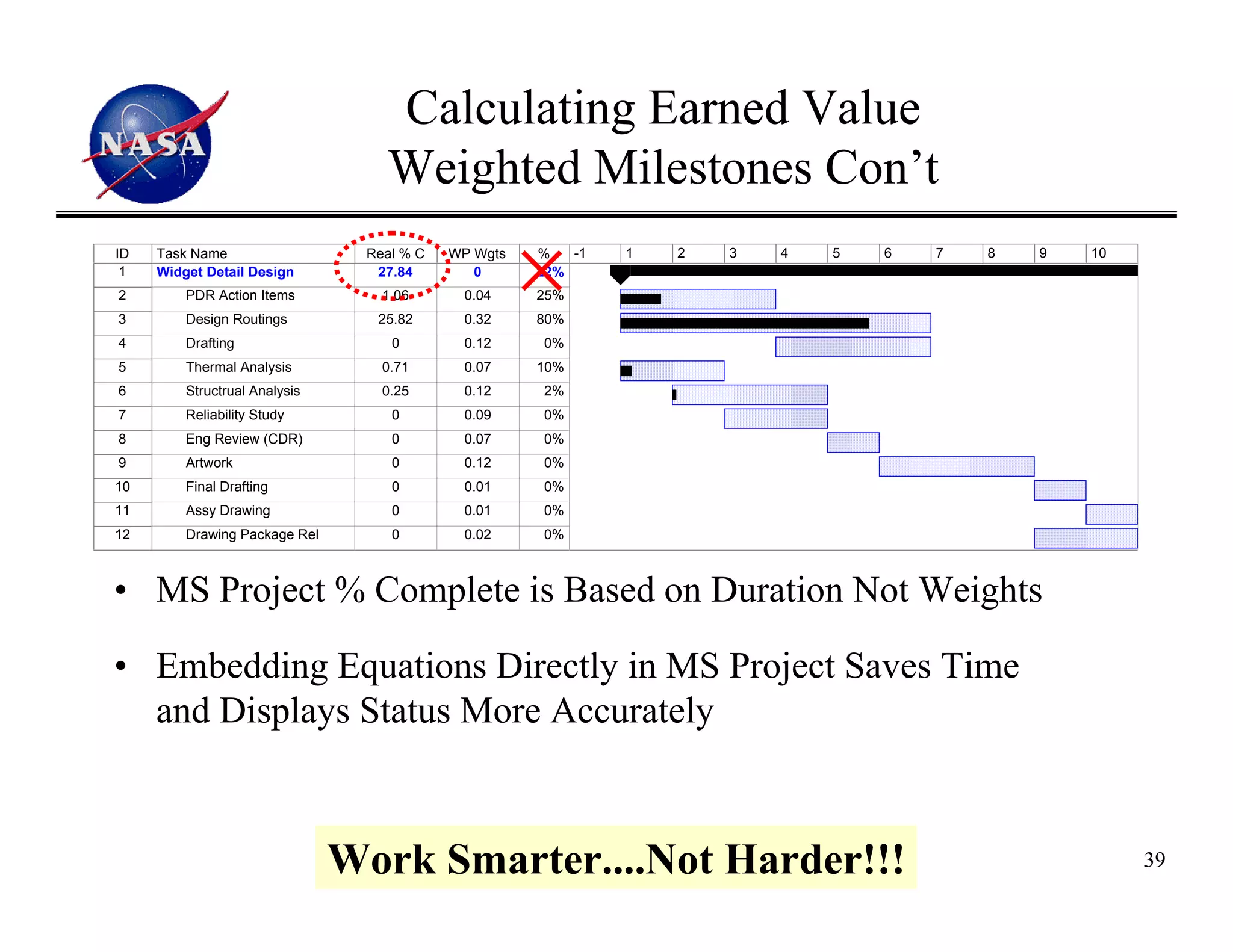

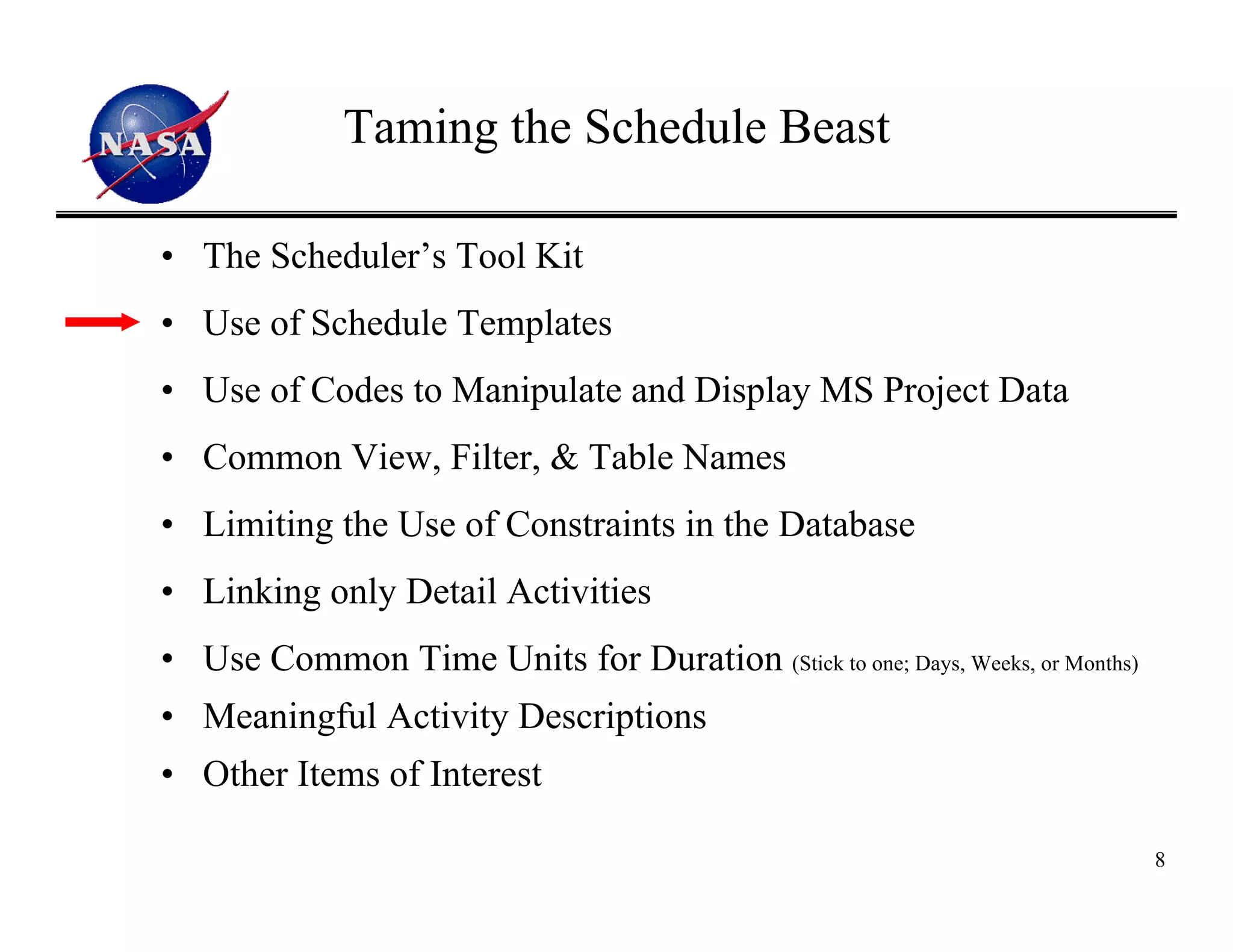

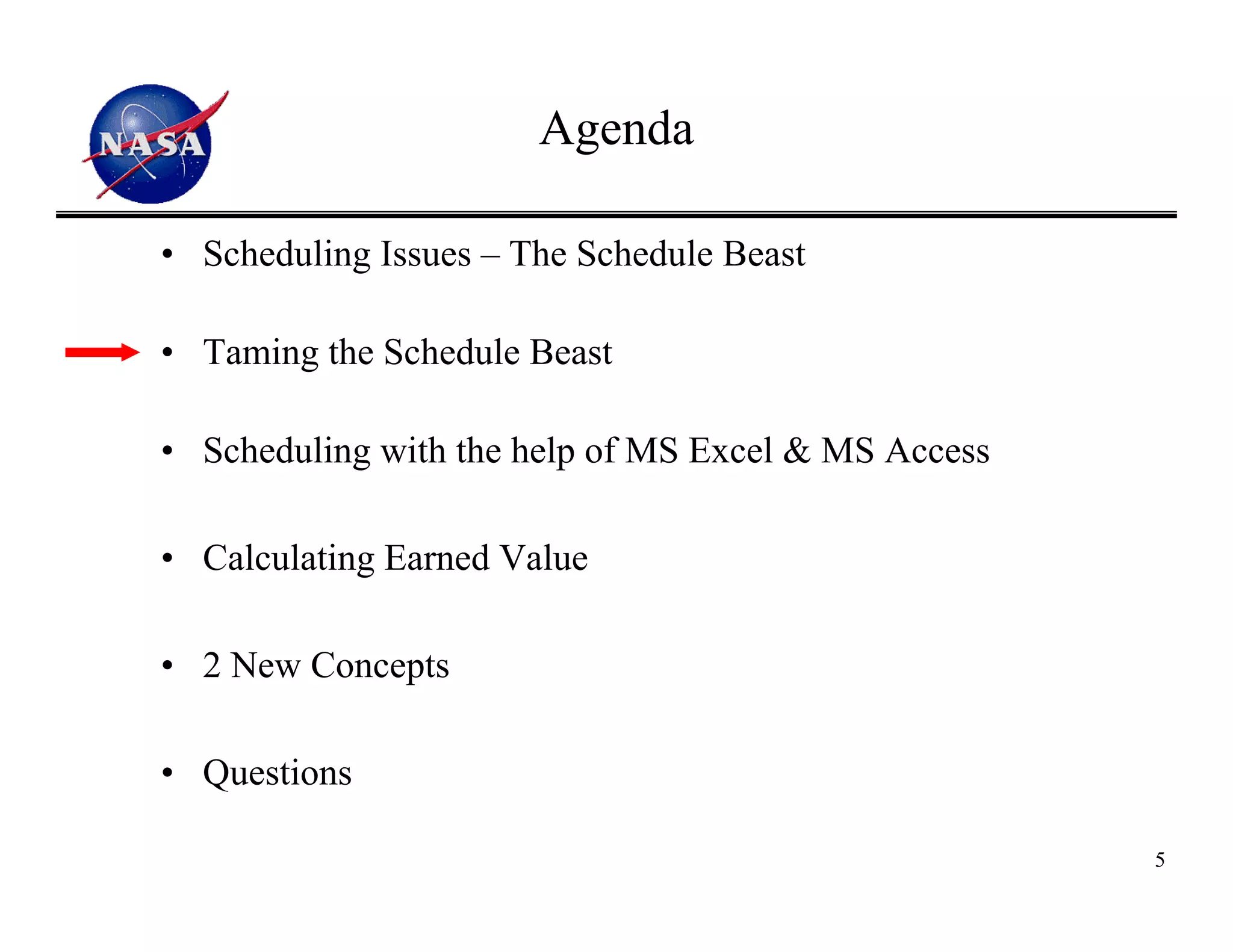

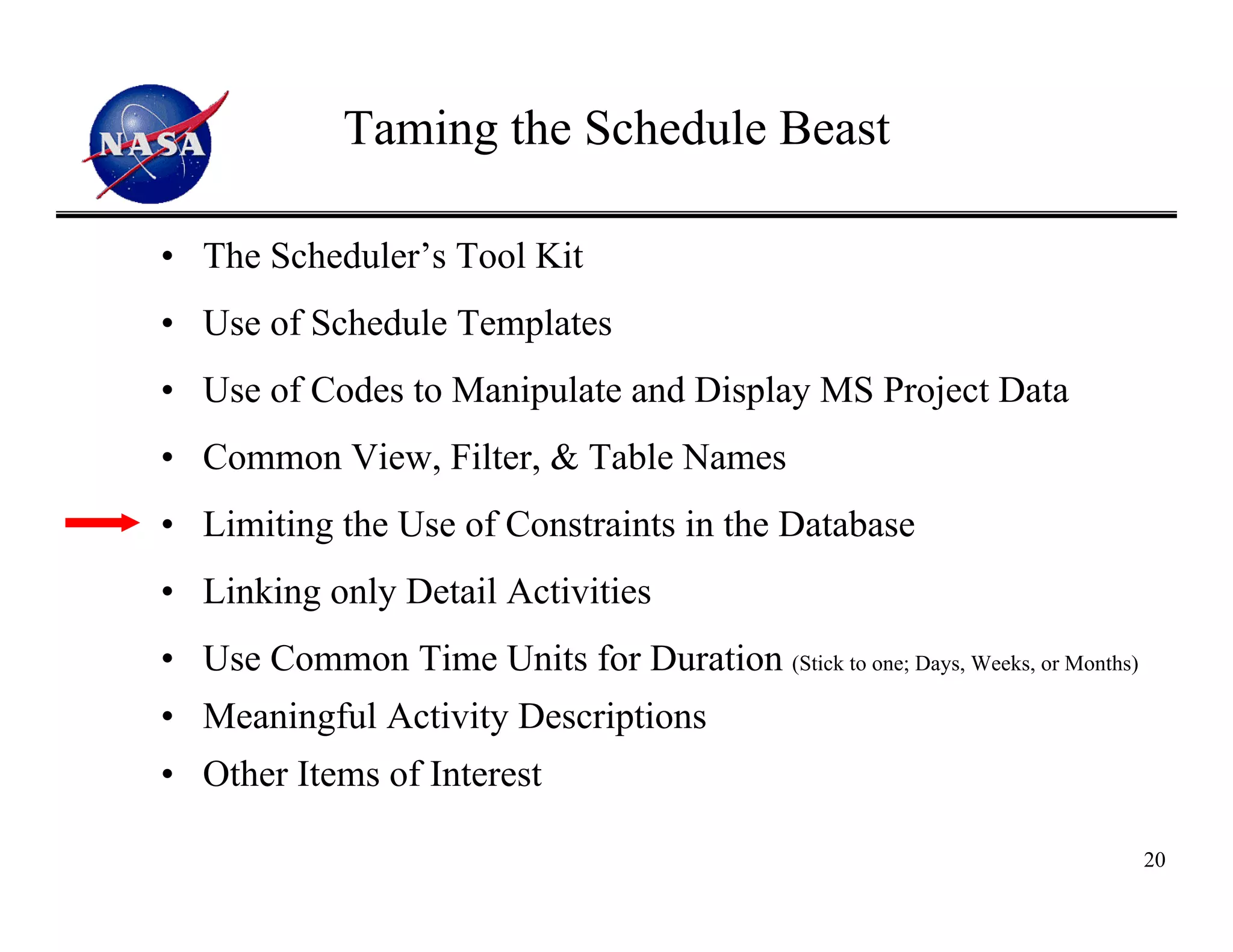

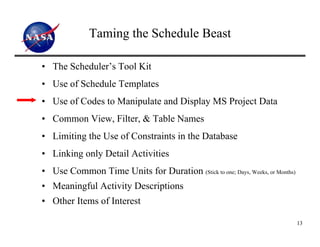

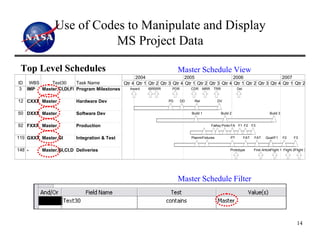

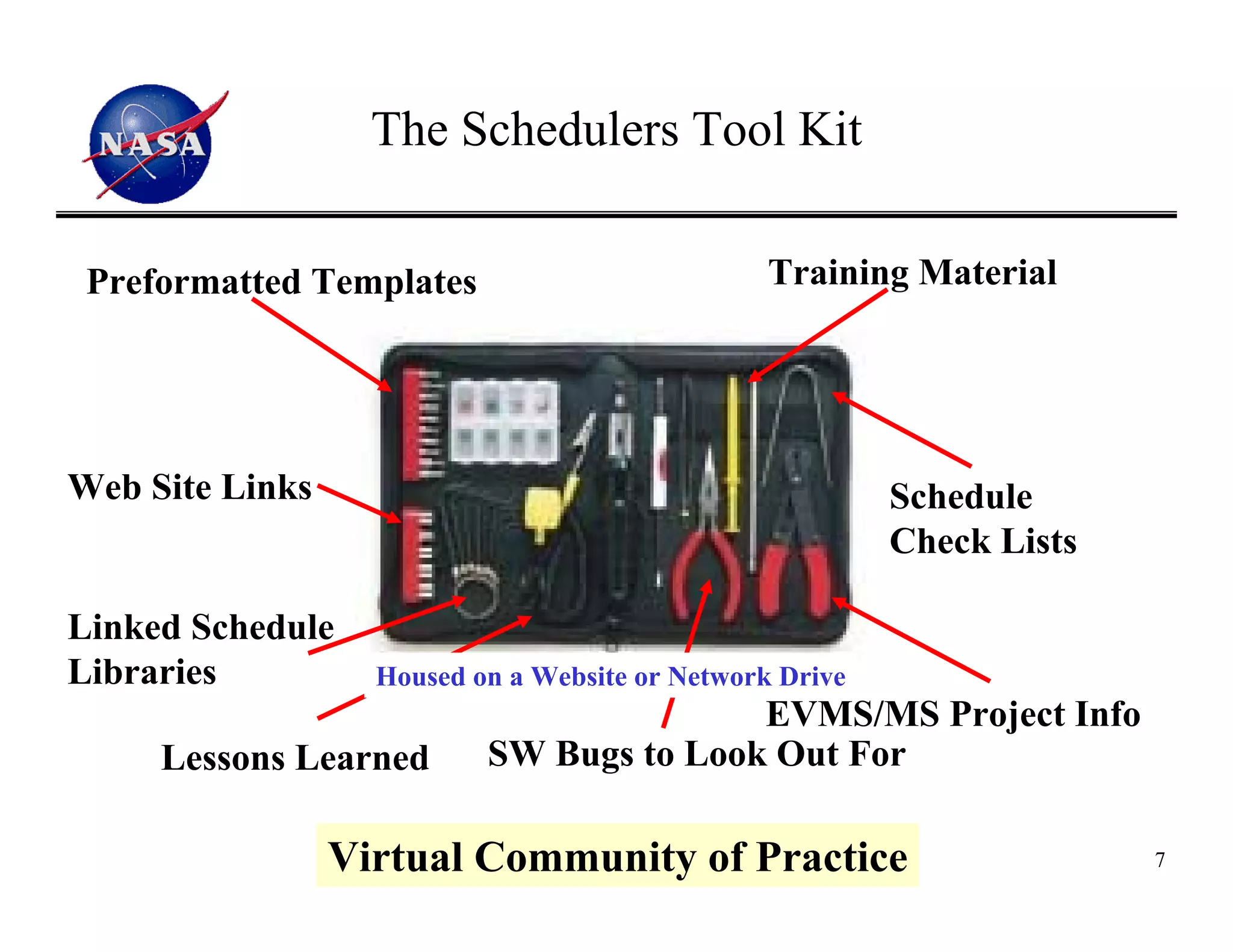

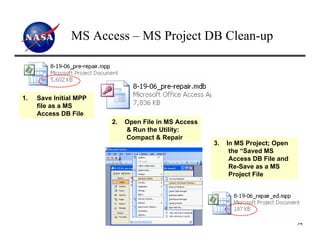

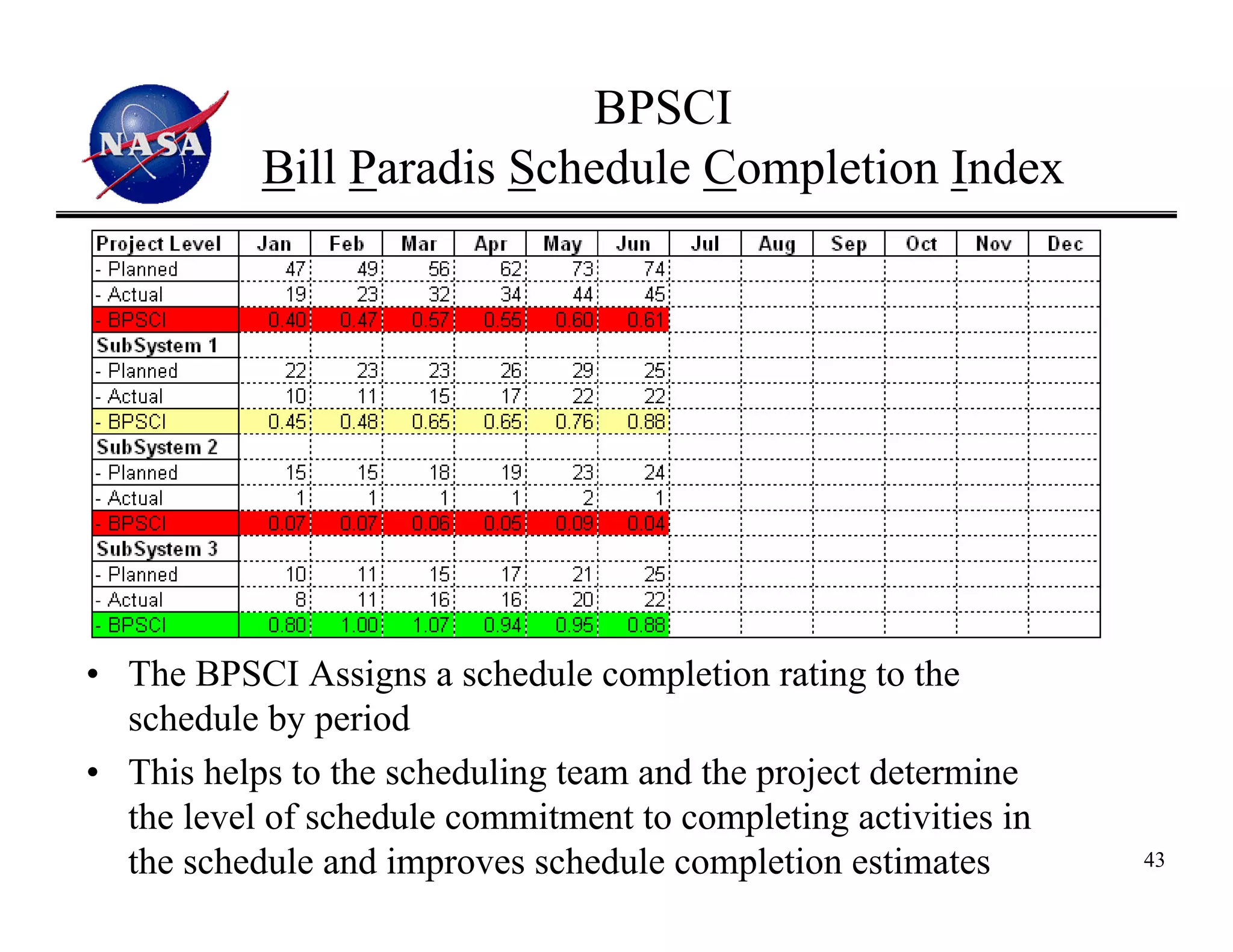

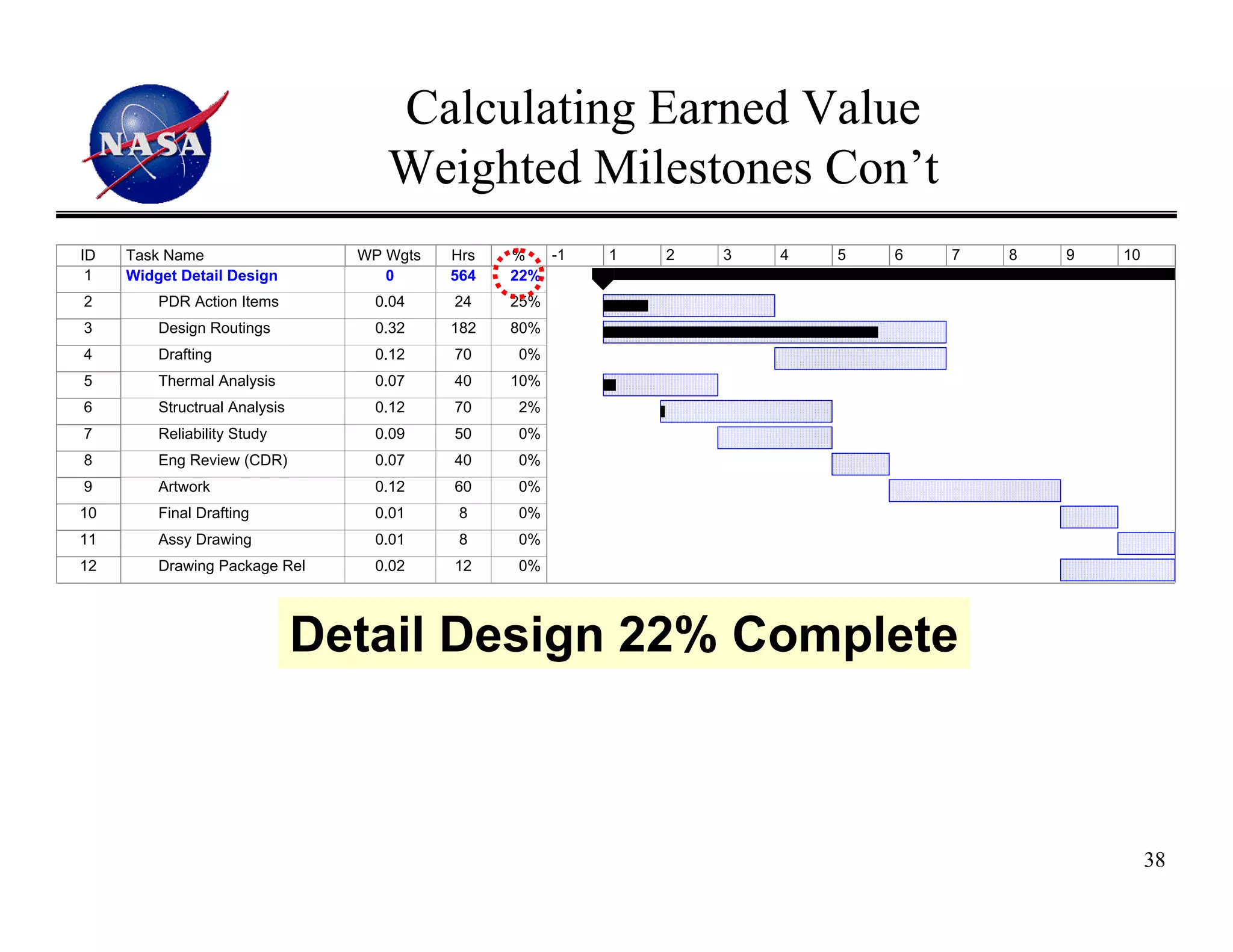

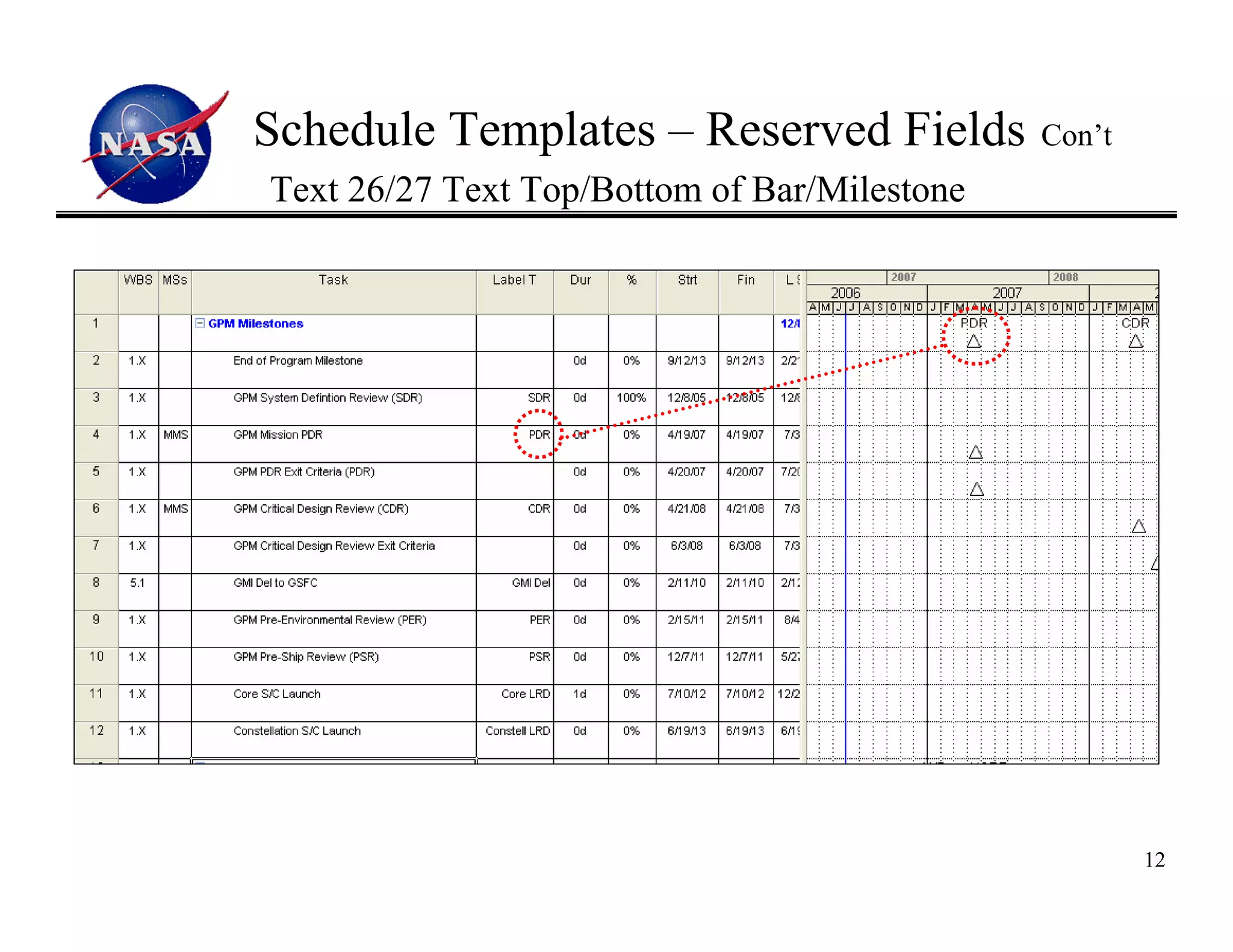

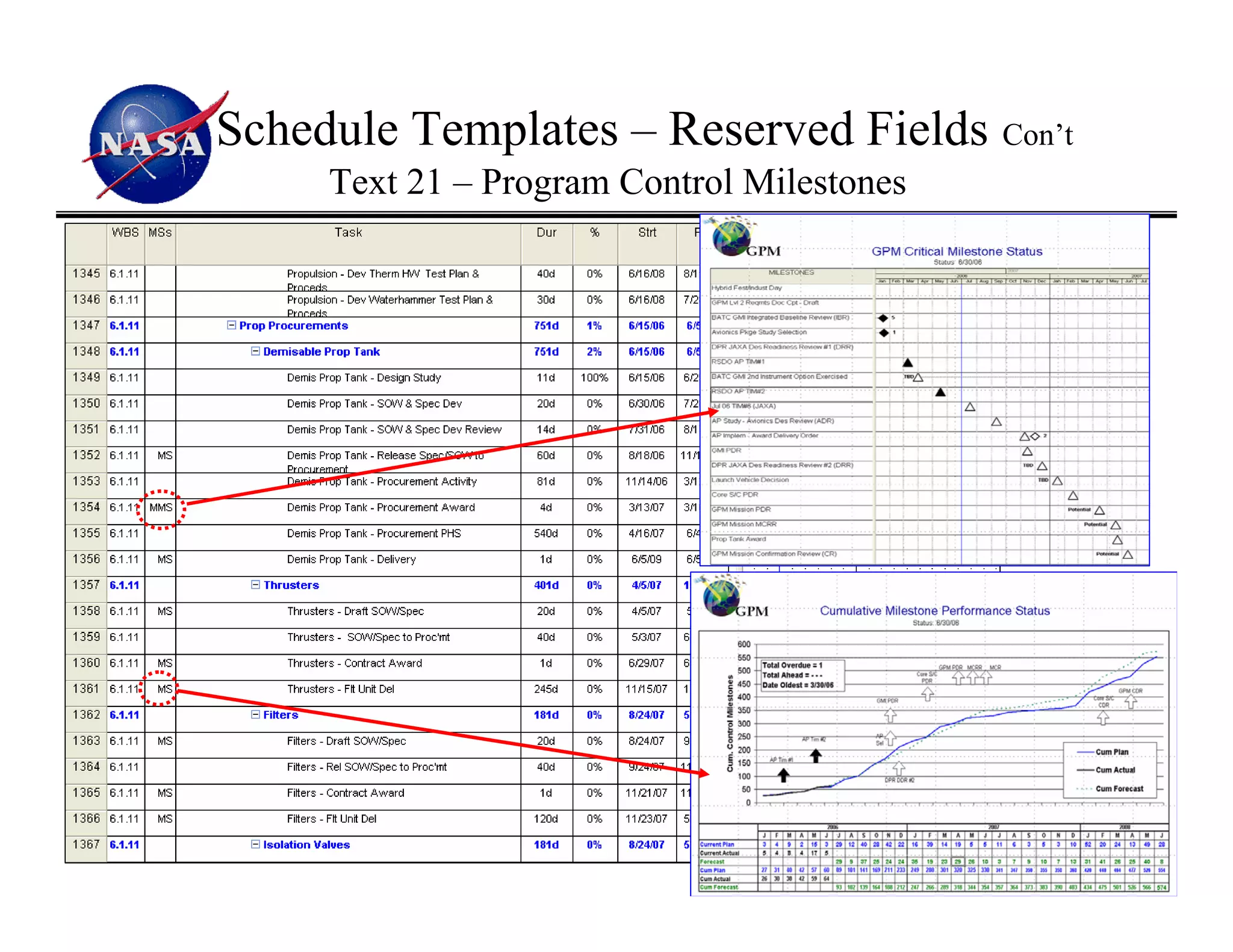

This document discusses leveraging scheduling productivity with practical scheduling techniques. It addresses scheduling issues such as unwieldy schedule databases and faulty logic. It then discusses taming the schedule beast through using a scheduler's toolkit, schedule templates, codes to manipulate MS Project data, common views/filters/tables, limiting constraints, and other best practices. The document provides examples of using codes and custom views/filters to effectively organize and display schedule information.
