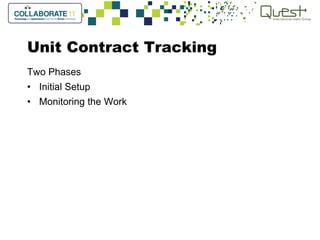

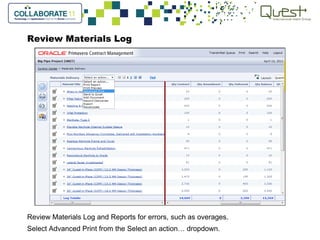

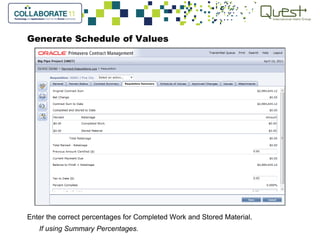

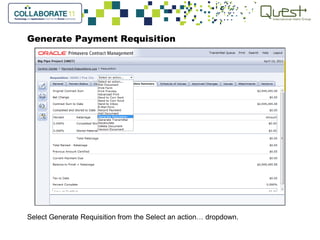

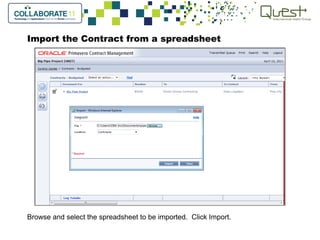

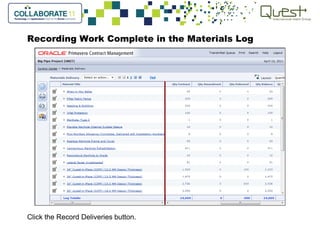

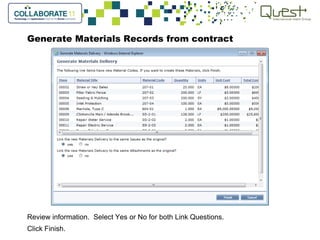

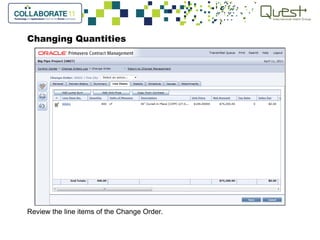

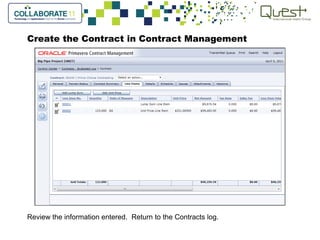

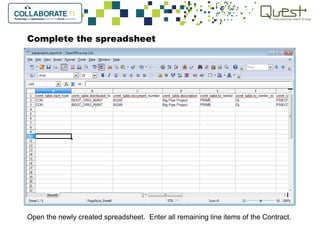

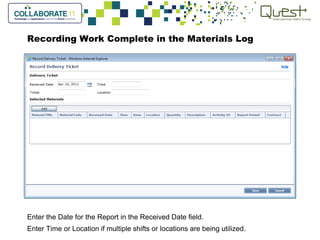

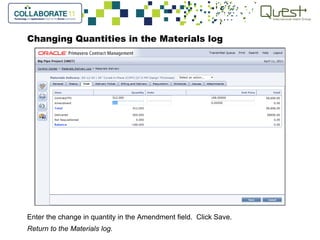

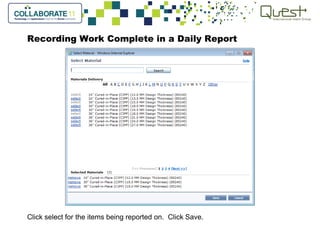

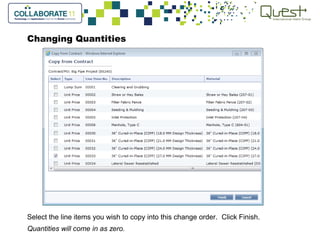

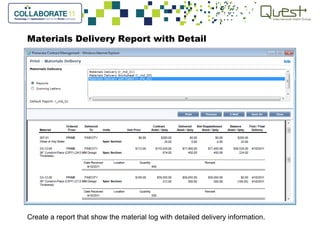

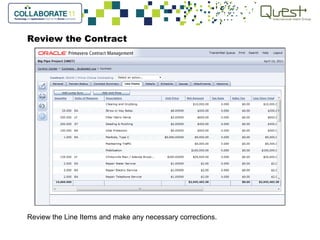

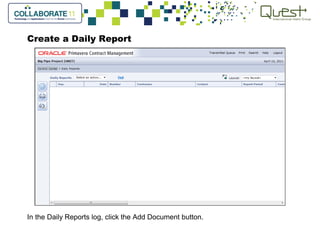

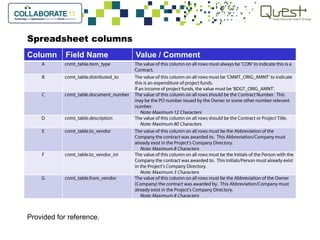

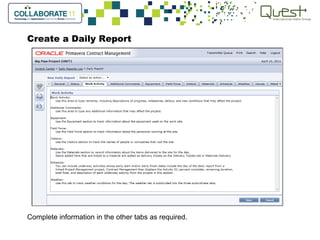

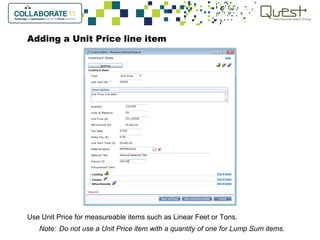

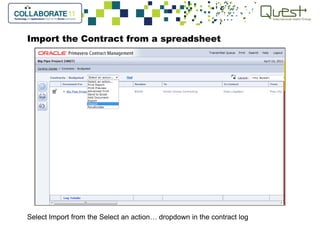

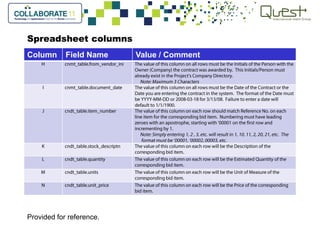

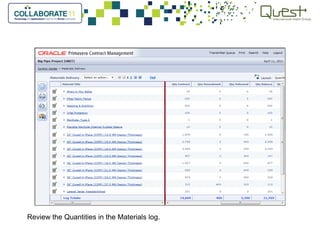

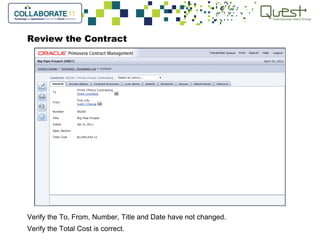

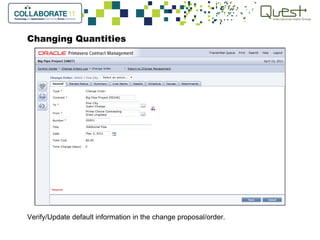

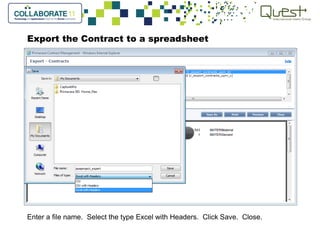

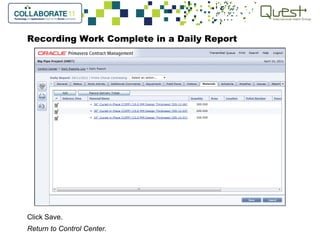

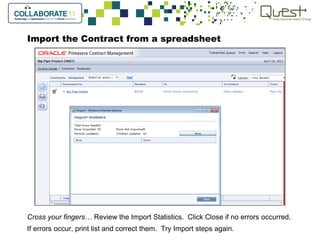

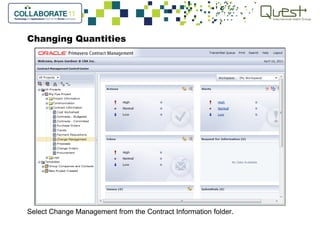

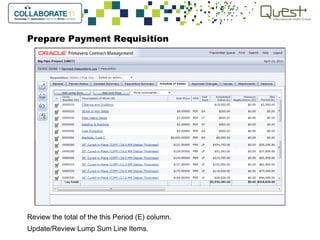

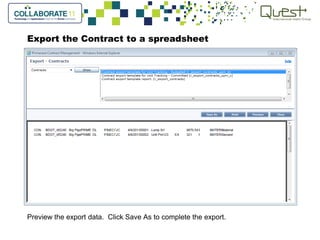

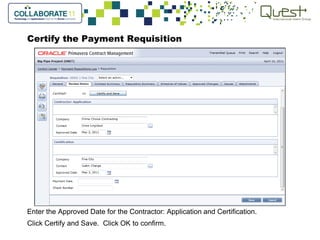

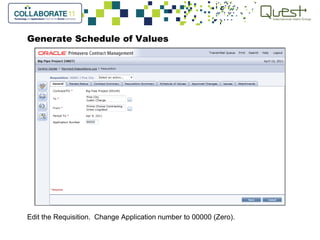

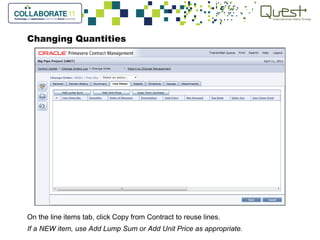

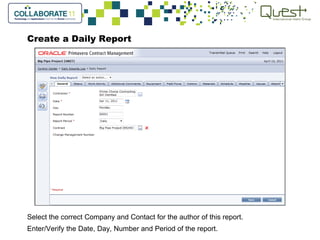

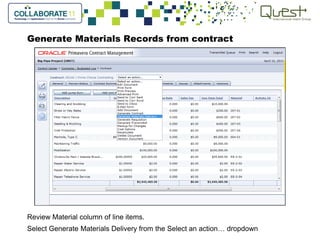

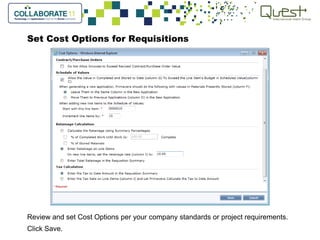

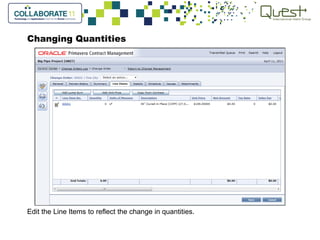

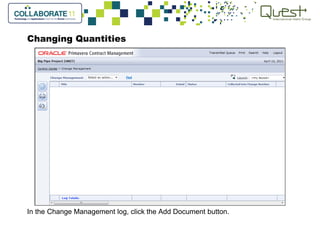

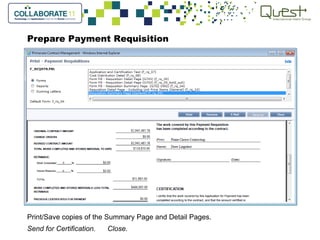

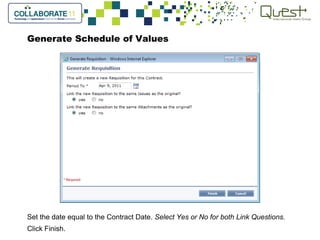

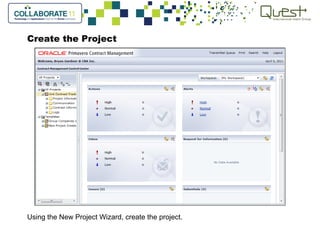

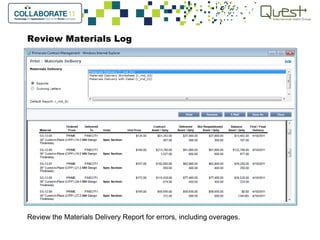

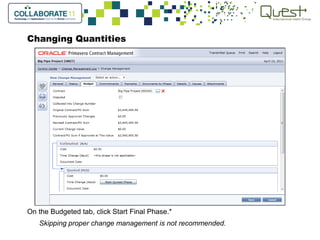

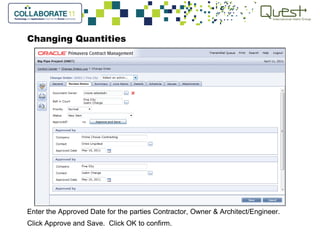

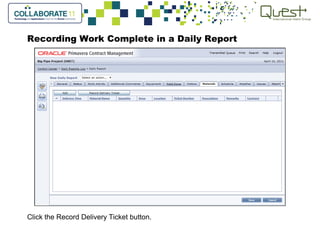

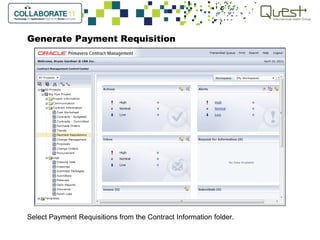

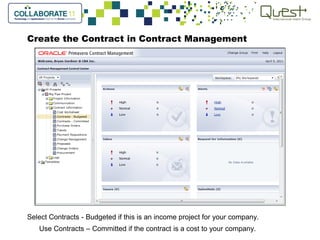

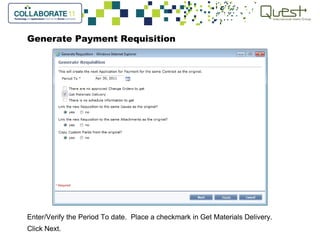

This document provides instructions for tracking unit-based construction contracts using Primavera Contract Management software. It outlines setting up the initial contract, materials, daily reports and payment requisitions. Key steps include creating the project and contract, exporting the contract to a spreadsheet to add line items, importing the updated spreadsheet, generating materials records and an initial payment schedule. It then describes monitoring the work by creating daily reports, recording completed work, reviewing materials and generating payment requisitions until the contract is complete.
