Presented at the 2012 Construction CPM Conference, this presentation walks through the challenges of owner/contractor and JV disputes and reviews solutions and prevention techniques using Fuse.
4. 4

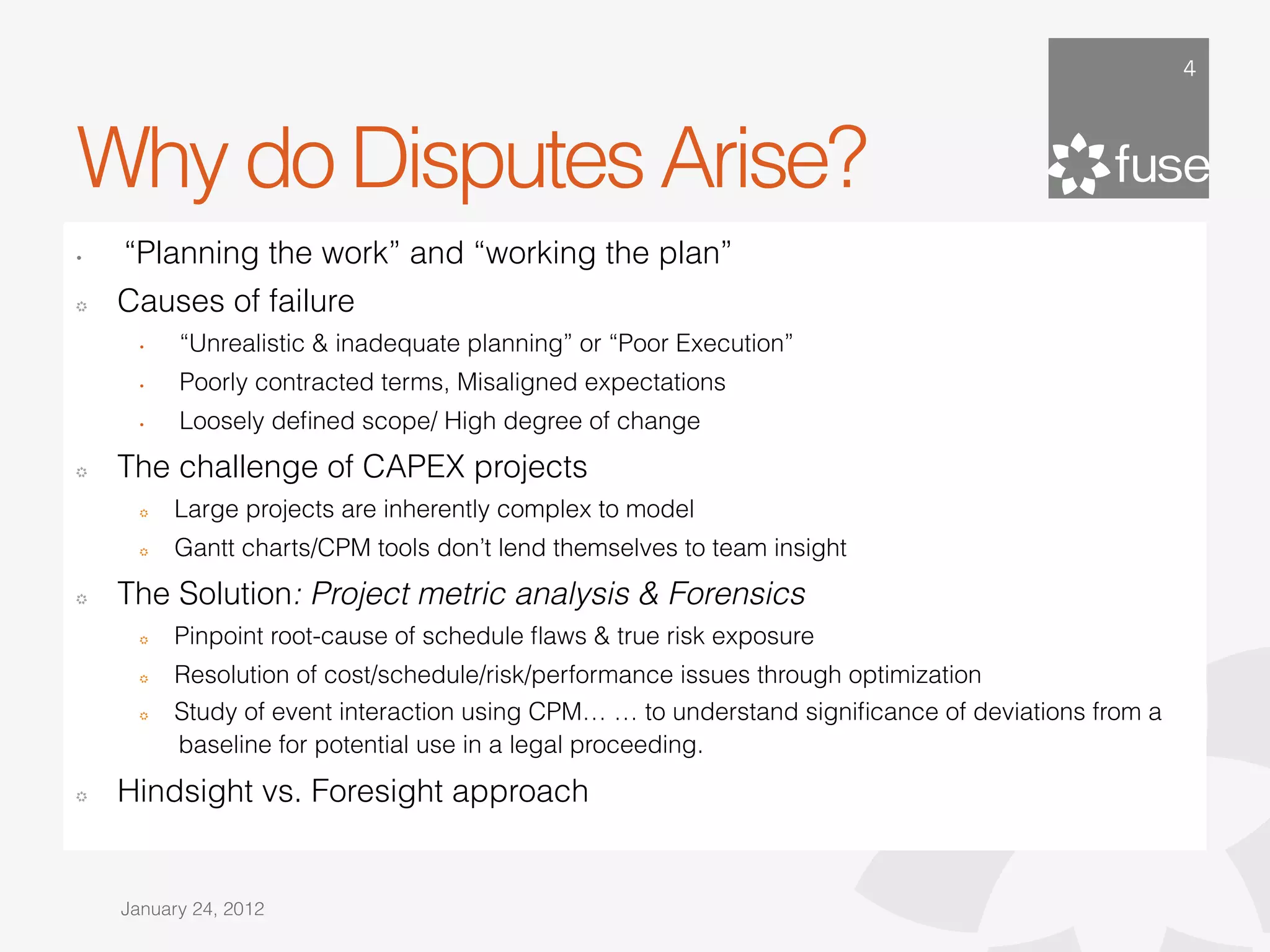

Why do Disputes Arise?
• “Planning the work” and “working the plan”
! Causes of failure
• “Unrealistic & inadequate planning” or “Poor Execution”
• Poorly contracted terms, Misaligned expectations
• Loosely defined scope/ High degree of change
! The challenge of CAPEX projects
! Large projects are inherently complex to model
! Gantt charts/CPM tools don’t lend themselves to team insight
! The Solution: Project metric analysis & Forensics
! Pinpoint root-cause of schedule flaws & true risk exposure
! Resolution of cost/schedule/risk/performance issues through optimization
! Study of event interaction using CPM… … to understand significance of deviations from a
baseline for potential use in a legal proceeding.
! Hindsight vs. Foresight approach
January 24, 2012
5. 5

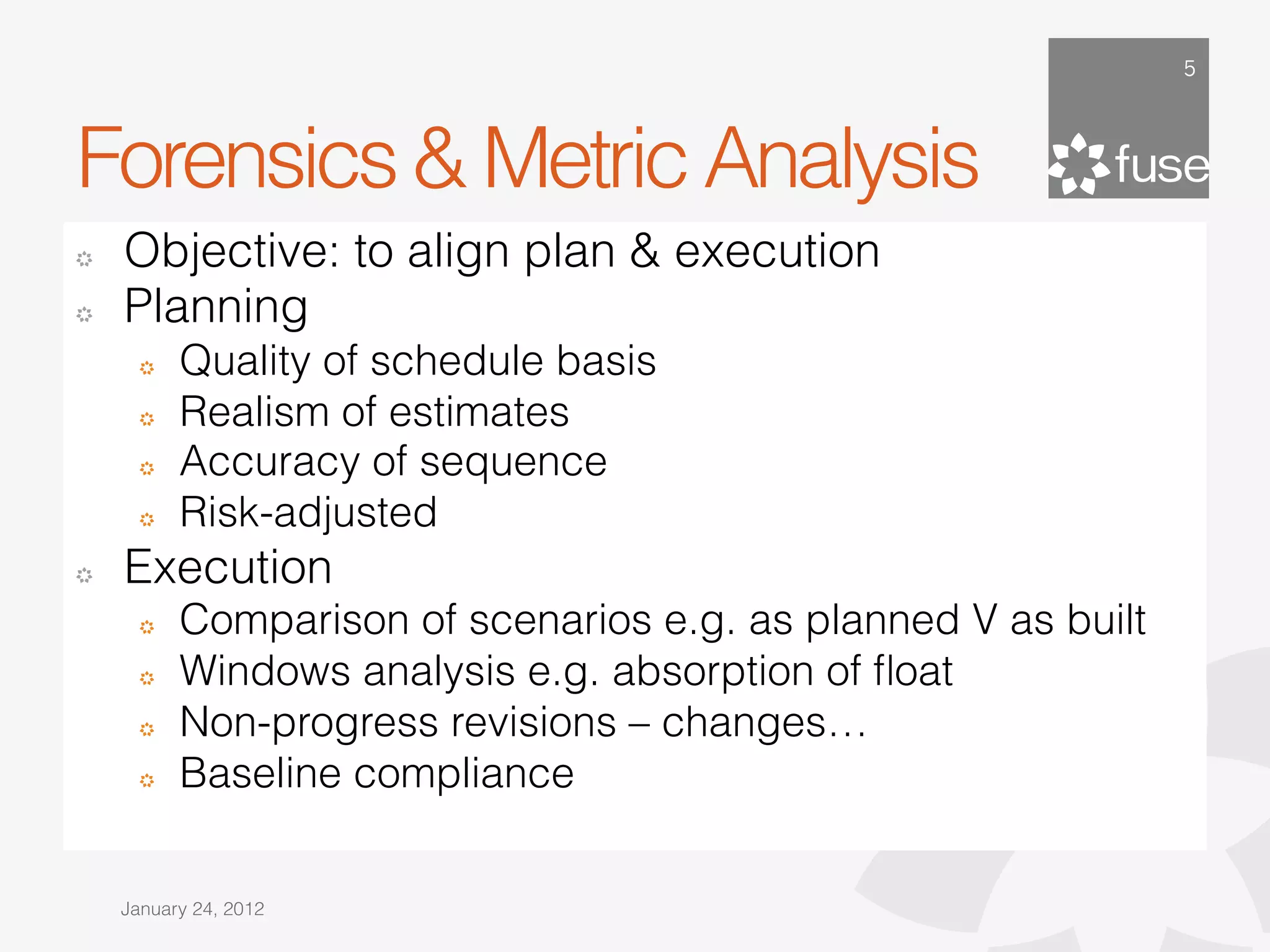

Forensics & Metric Analysis
! Objective: to align plan & execution
! Planning
! Quality of schedule basis
! Realism of estimates
! Accuracy of sequence
! Risk-adjusted
! Execution
! Comparison of scenarios e.g. as planned V as built
! Windows analysis e.g. absorption of float
! Non-progress revisions – changes…
! Baseline compliance
January 24, 2012

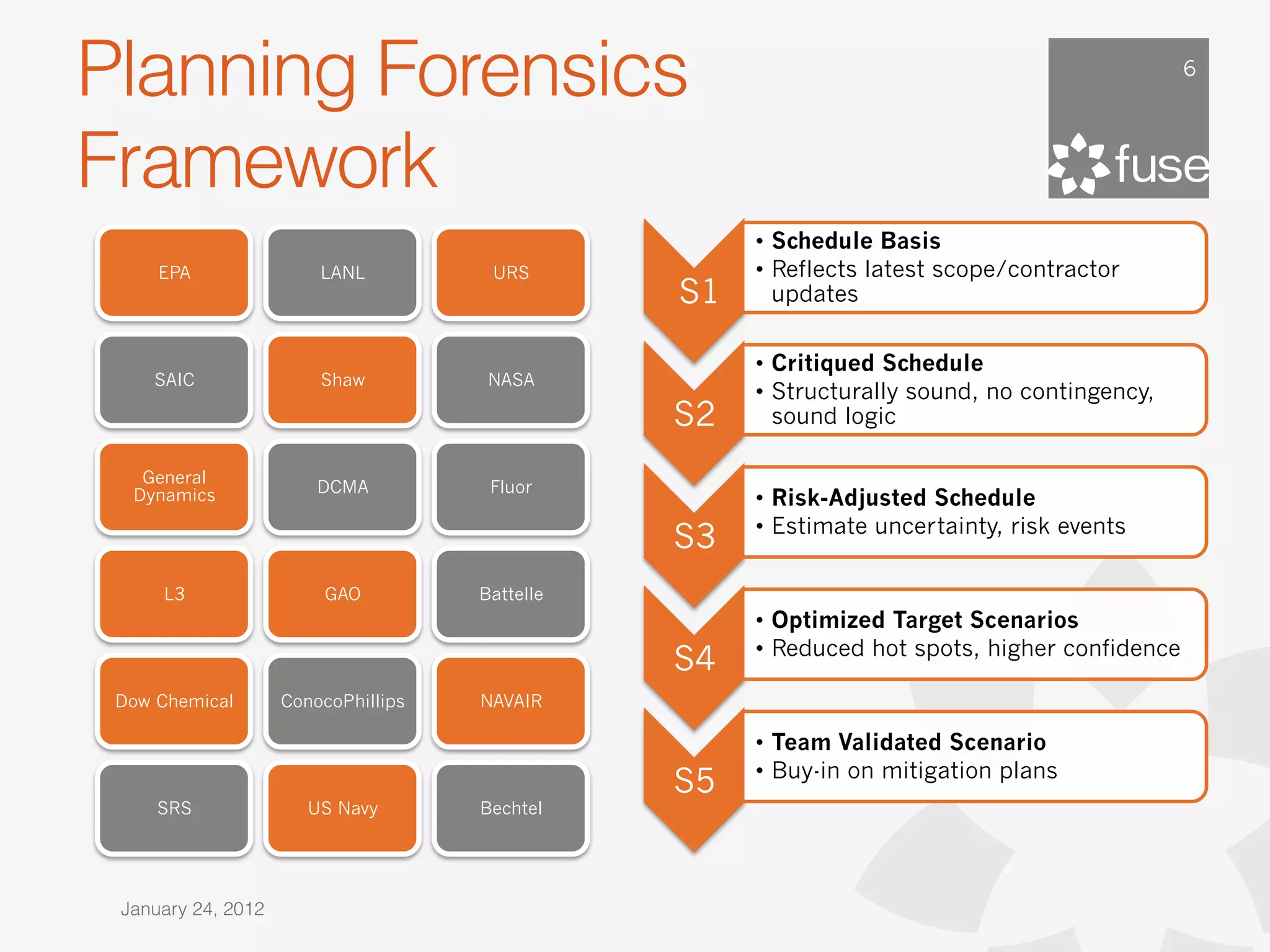

6. Planning Forensics 6
Framework
• Schedule Basis
EPA LANL URS • Reflects latest scope/contractor
S1 updates
• Critiqued Schedule
SAIC Shaw NASA
• Structurally sound, no contingency,
S2 sound logic
General
DCMA Fluor
Dynamics • Risk-Adjusted Schedule
• Estimate uncertainty, risk events
S3
L3 GAO Battelle
• Optimized Target Scenarios
• Reduced hot spots, higher confidence
S4
Dow Chemical ConocoPhillips NAVAIR
• Team Validated Scenario
• Buy-in on mitigation plans
S5
SRS US Navy Bechtel
January 24, 2012
12. 12

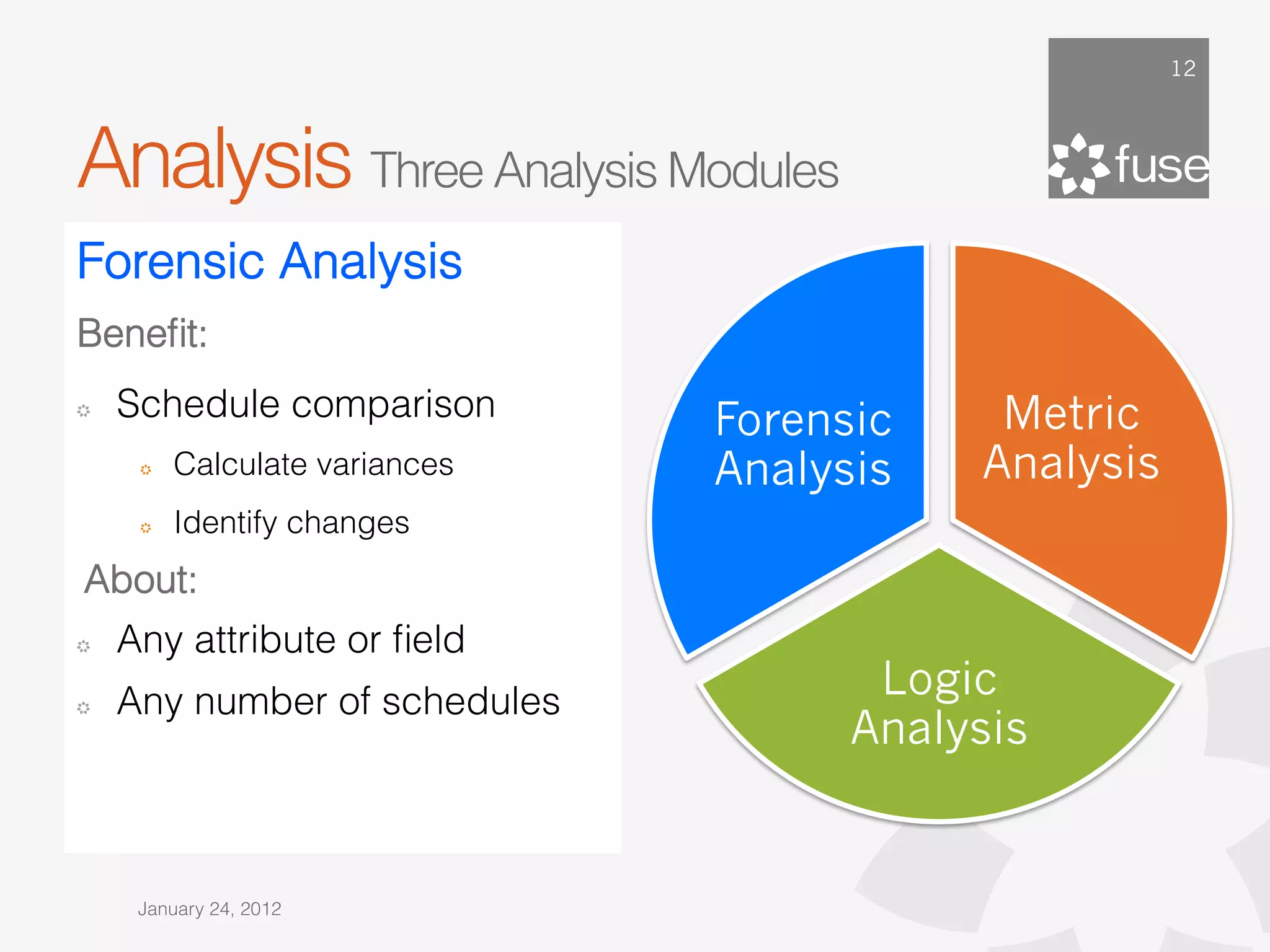

Analysis Three Analysis Modules
Forensic Analysis
Benefit:
! Schedule comparison Forensic Metric
! Calculate variances Analysis Analysis
! Identify changes
About:
! Any attribute or field
Any number of schedules

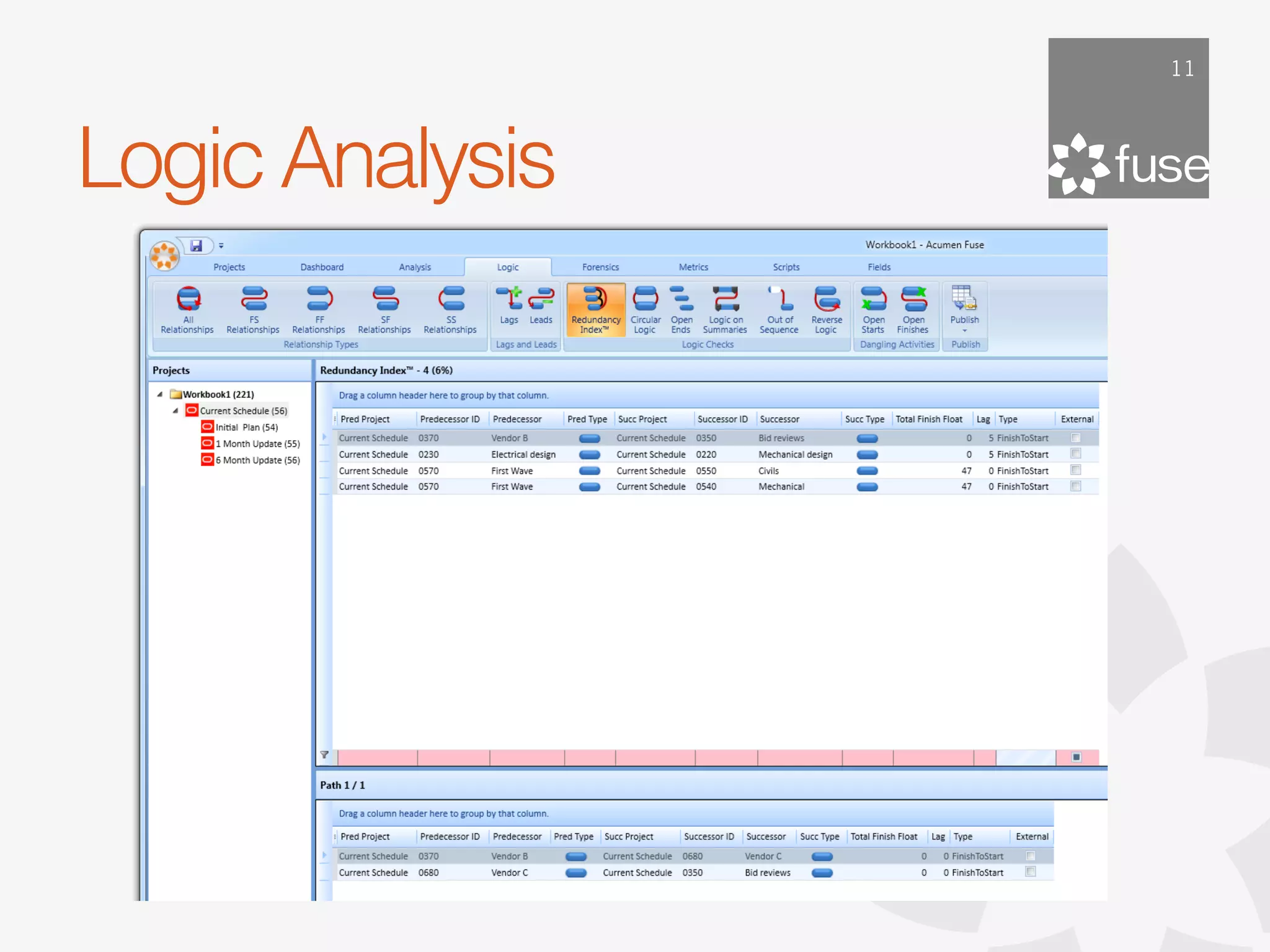

Logic
Analysis
!
January 24, 2012

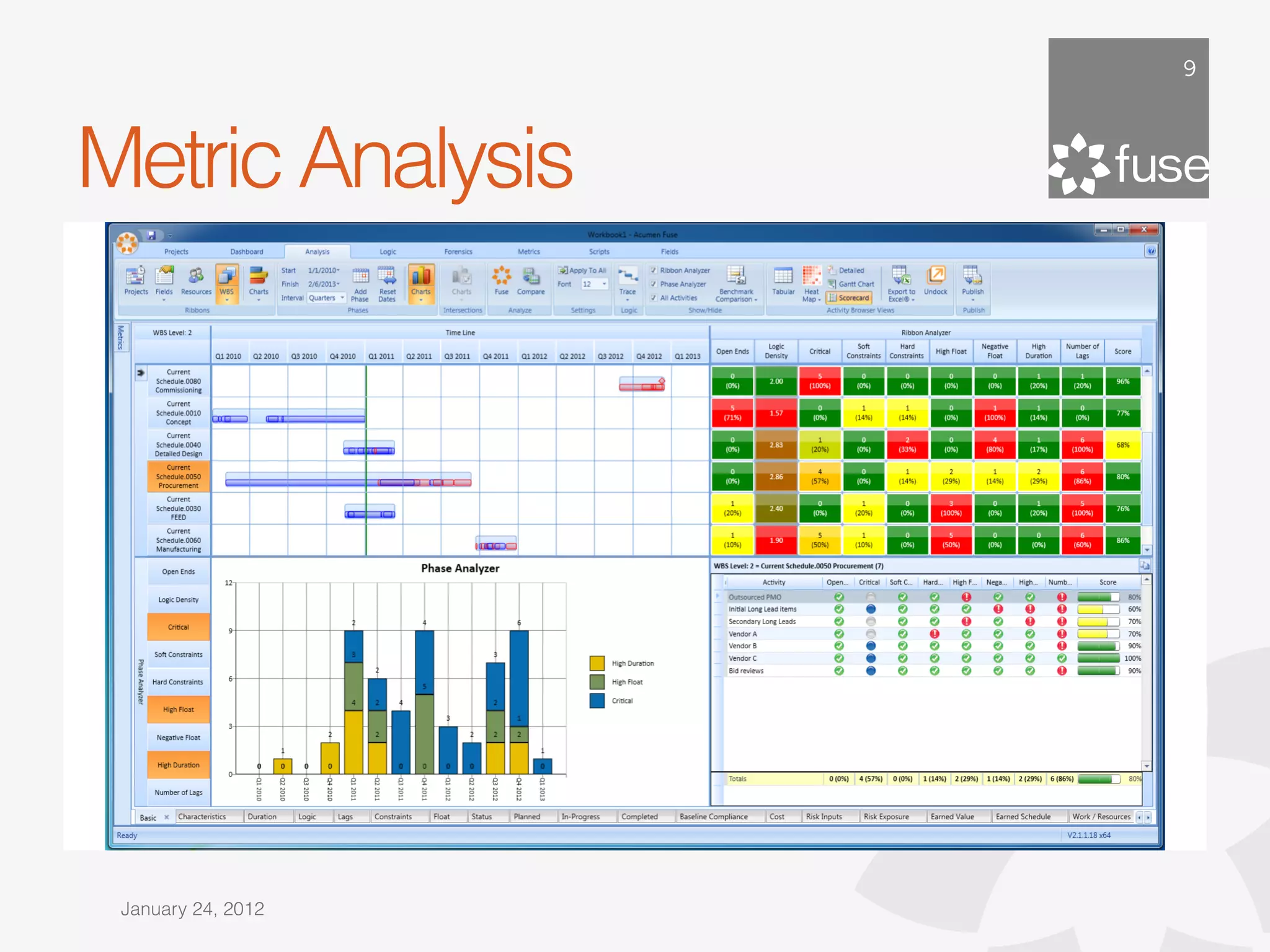

13. 13

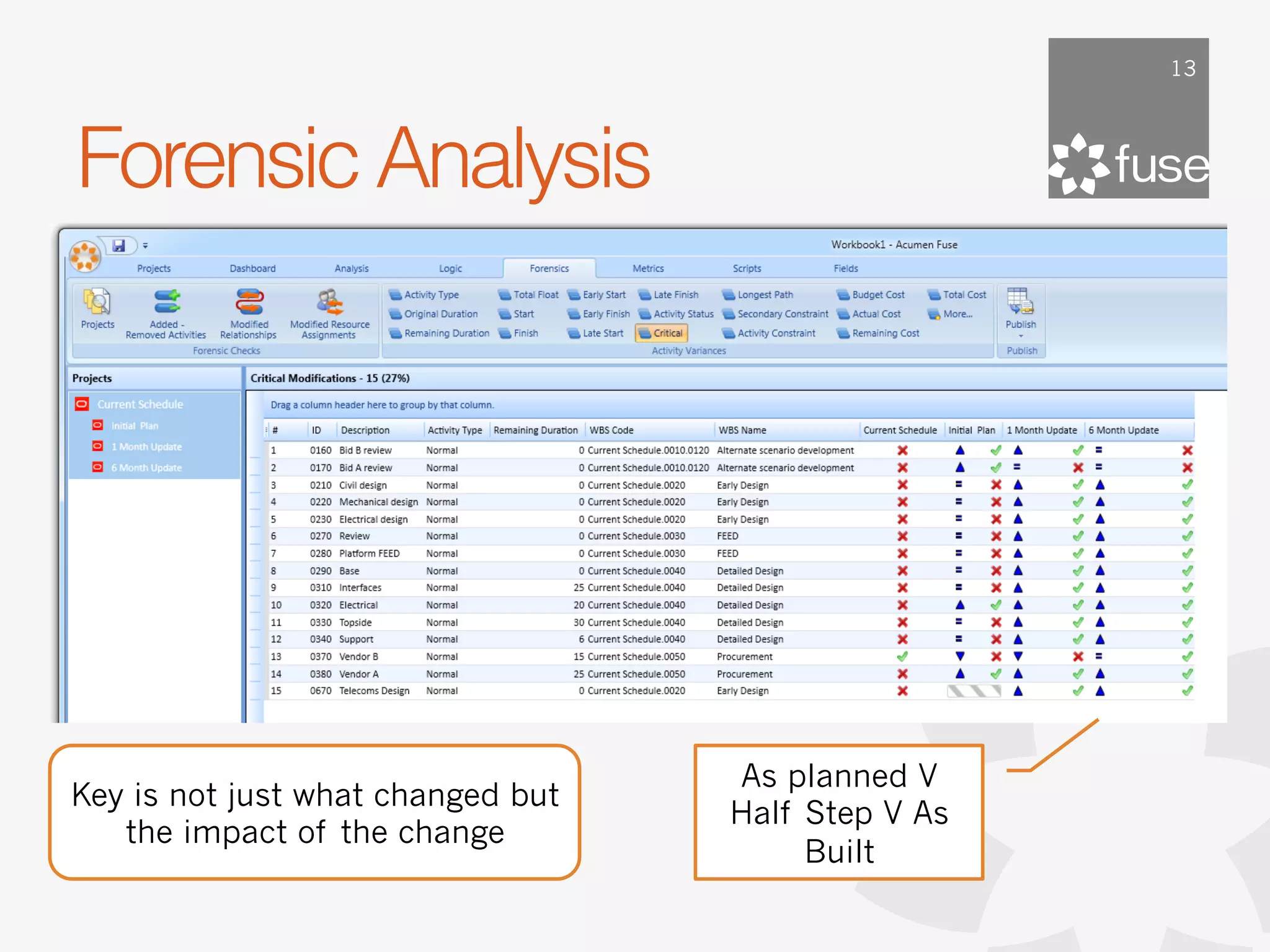

Forensic Analysis
As planned V
Key is not just what changed but
Half Step V As
the impact of the change
Built

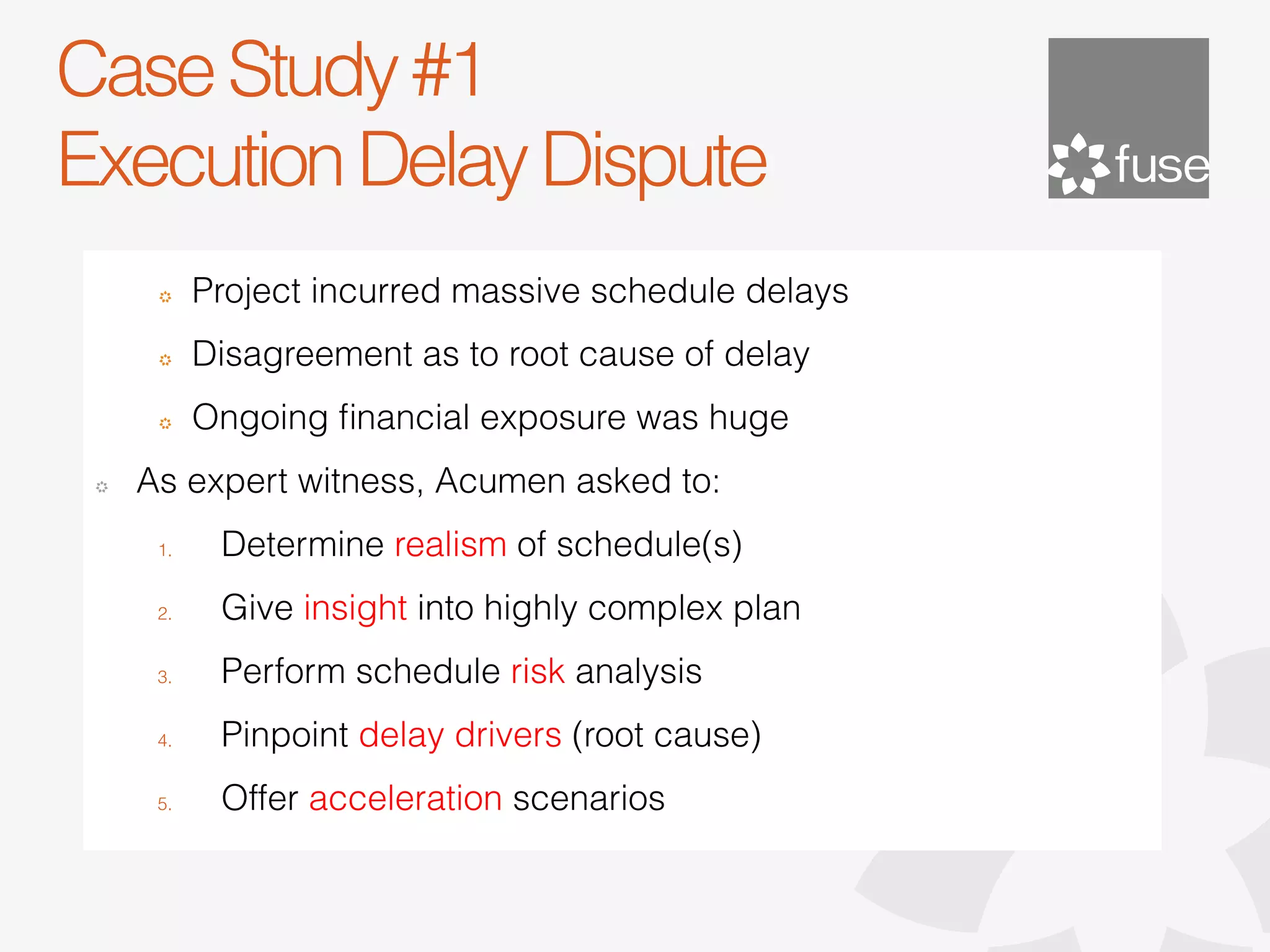

14. Case Study #1
Execution Delay Dispute
! Project incurred massive schedule delays
! Disagreement as to root cause of delay
! Ongoing financial exposure was huge
! As expert witness, Acumen asked to:
1. Determine realism of schedule(s)
2. Give insight into highly complex plan
3. Perform schedule risk analysis
4. Pinpoint delay drivers (root cause)
5. Offer acceleration scenarios

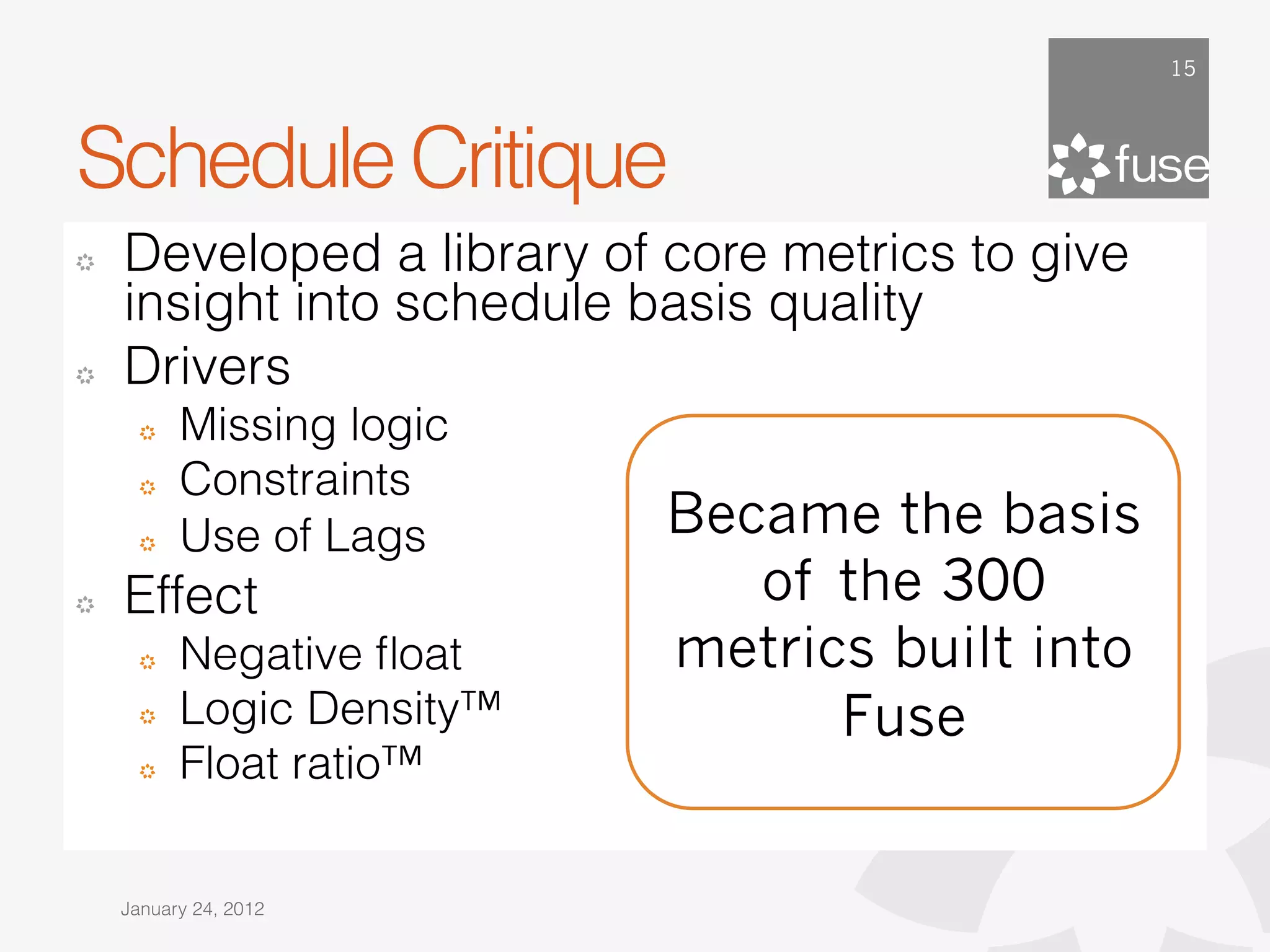

15. 15
Schedule Critique
! Developed a library of core metrics to give
insight into schedule basis quality
! Drivers
! Missing logic
! Constraints
! Use of Lags Became the basis
! Effect of the 300
! Negative float metrics built into
! Logic Density™ Fuse
! Float ratio™
January 24, 2012

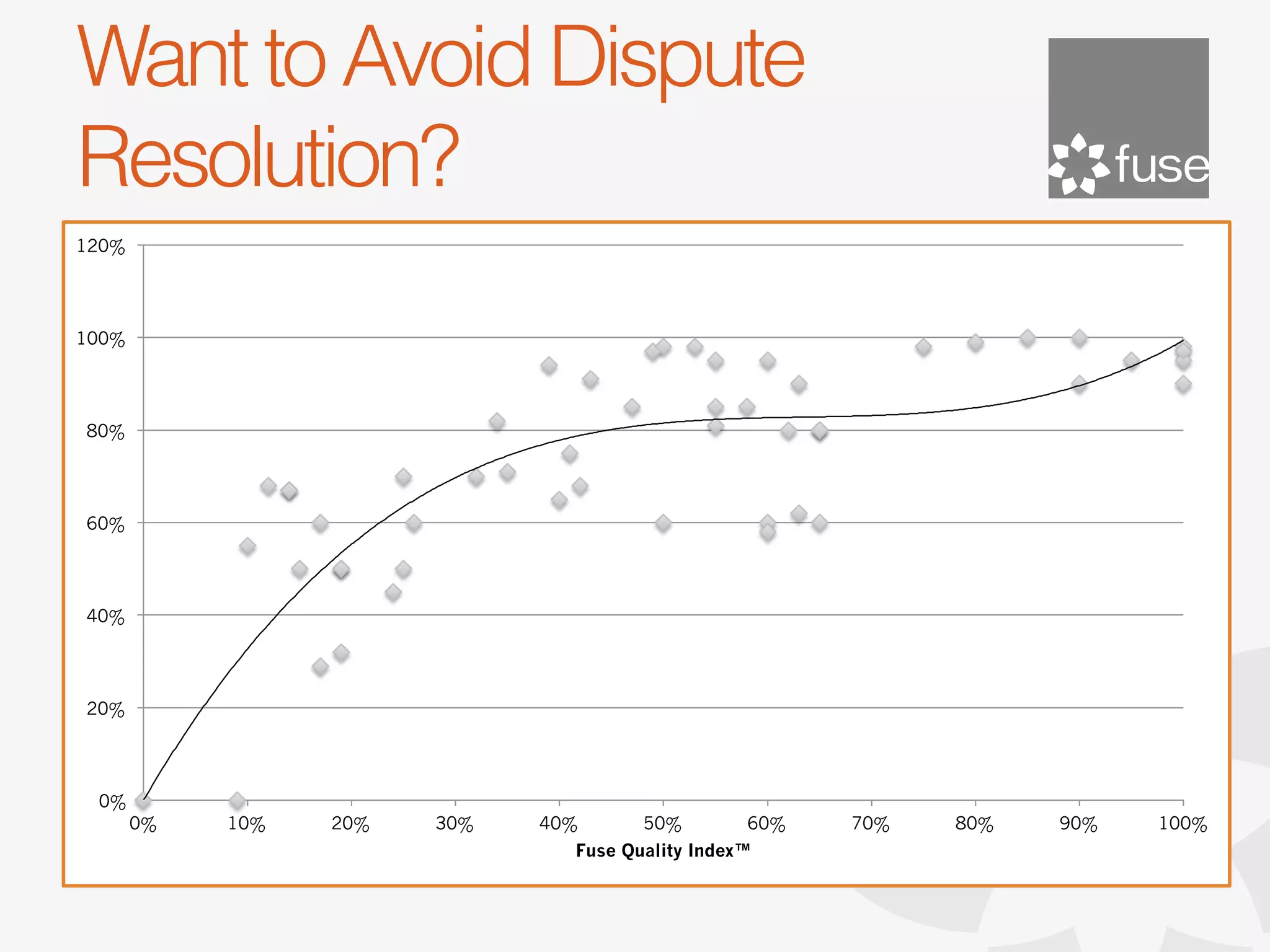

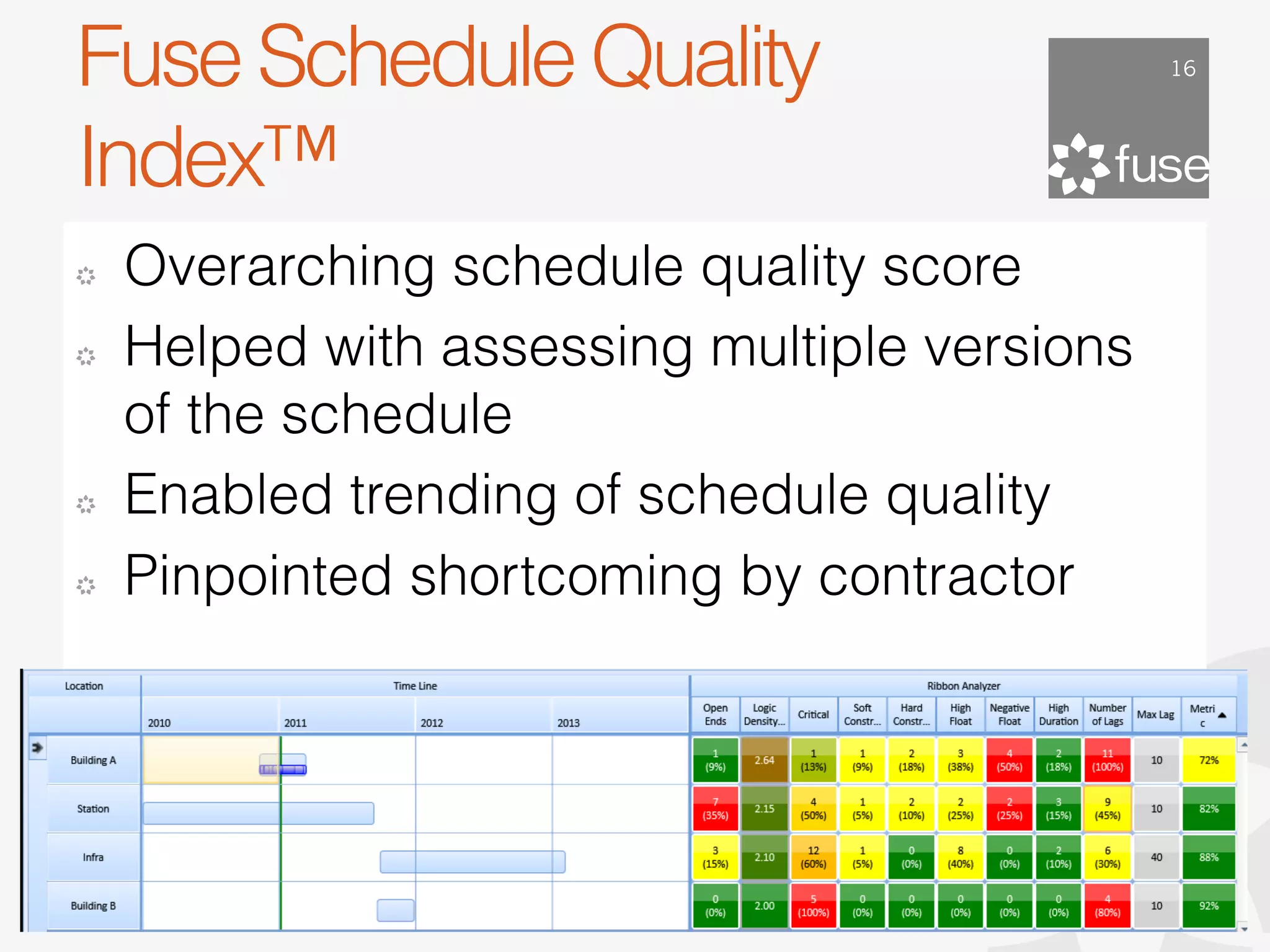

16. Fuse Schedule Quality 16
Index™
! Overarching schedule quality score
! Helped with assessing multiple versions
of the schedule
! Enabled trending of schedule quality
! Pinpointed shortcoming by contractor
January 24, 2012
17. 17

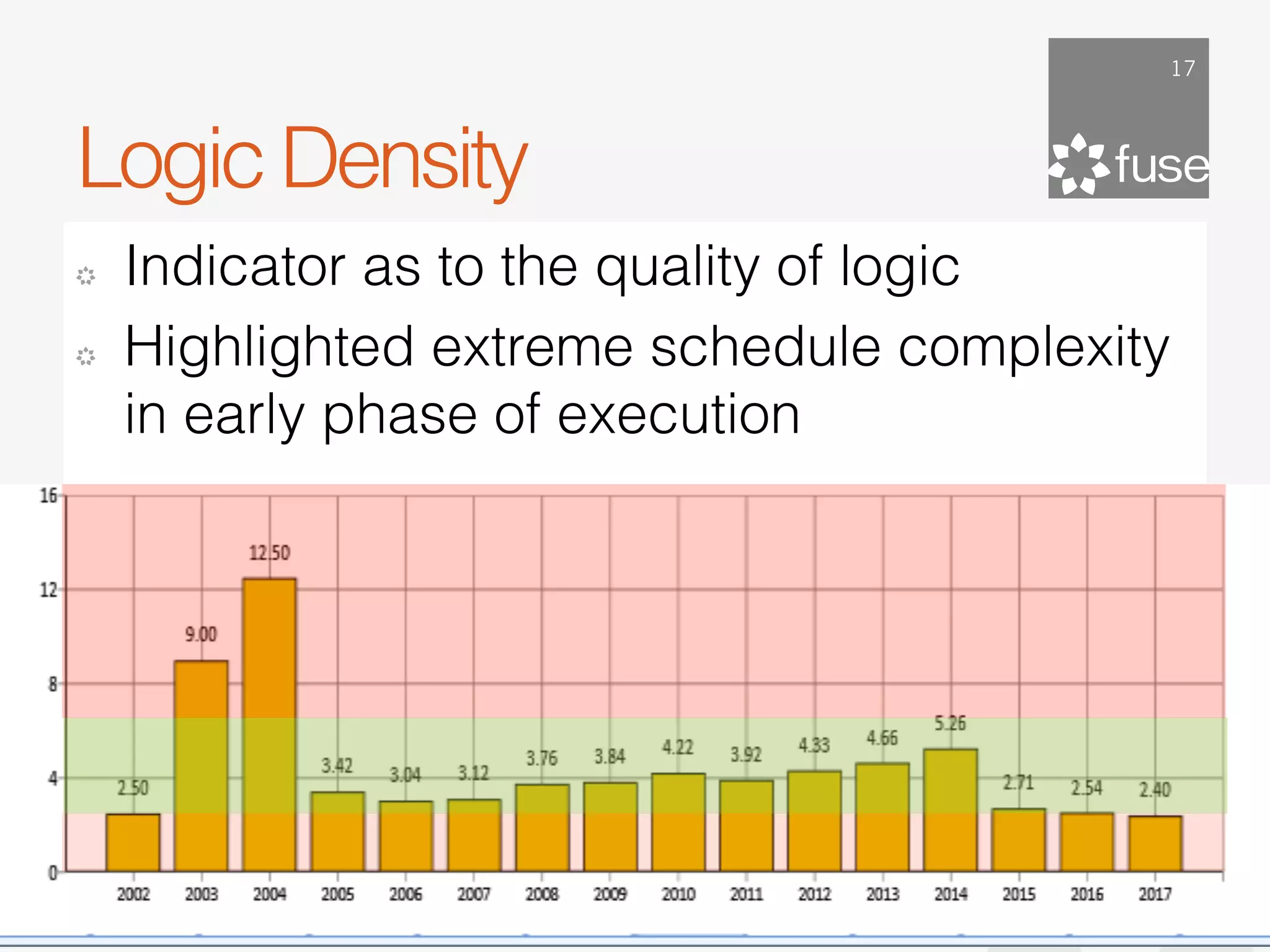

Logic Density
! Indicator as to the quality of logic
! Highlighted extreme schedule complexity
in early phase of execution
18. 18

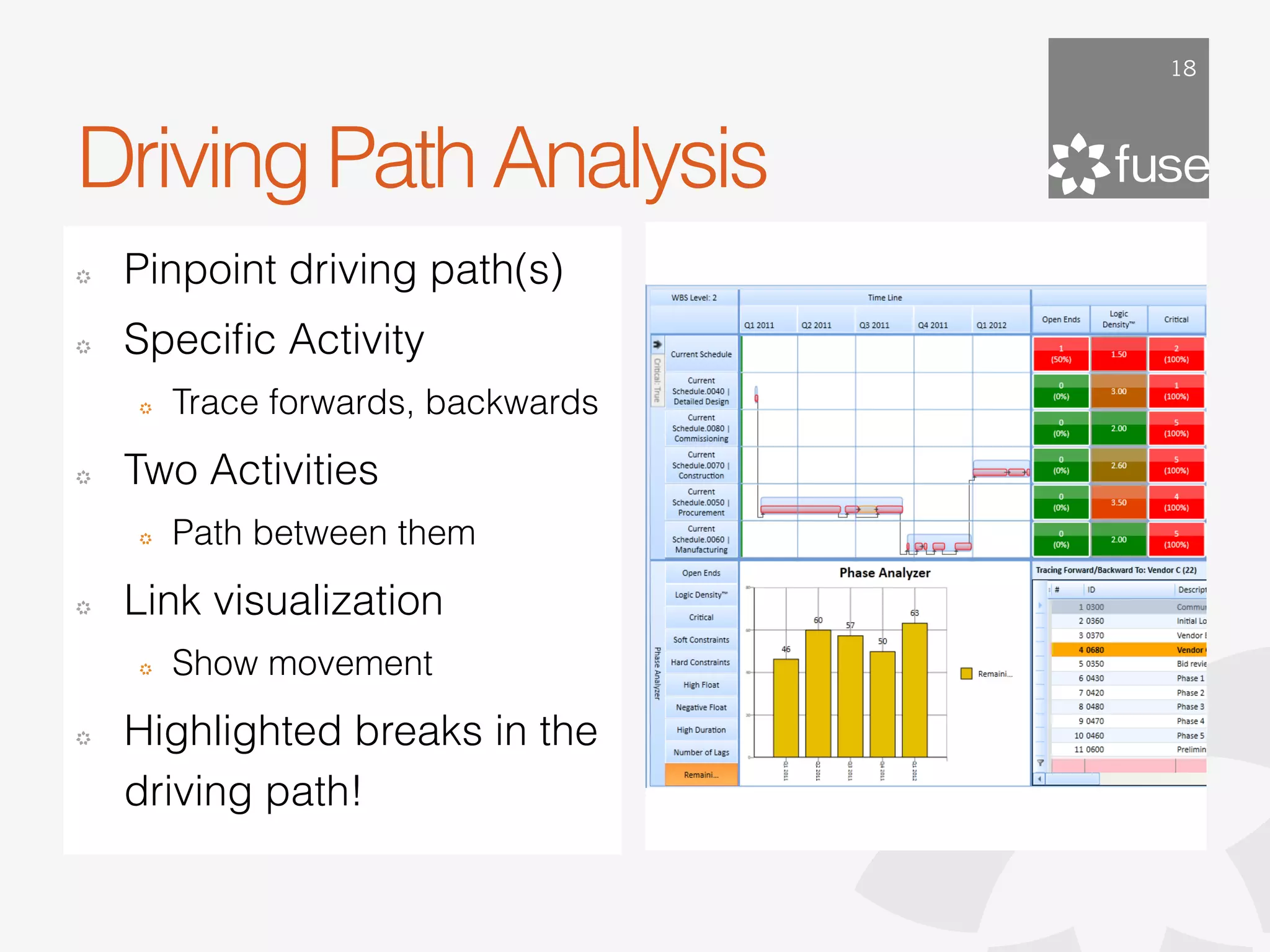

Driving Path Analysis
! Pinpoint driving path(s)
! Specific Activity
! Trace forwards, backwards
! Two Activities
! Path between them
! Link visualization
! Show movement
! Highlighted breaks in the
driving path!
20. 20

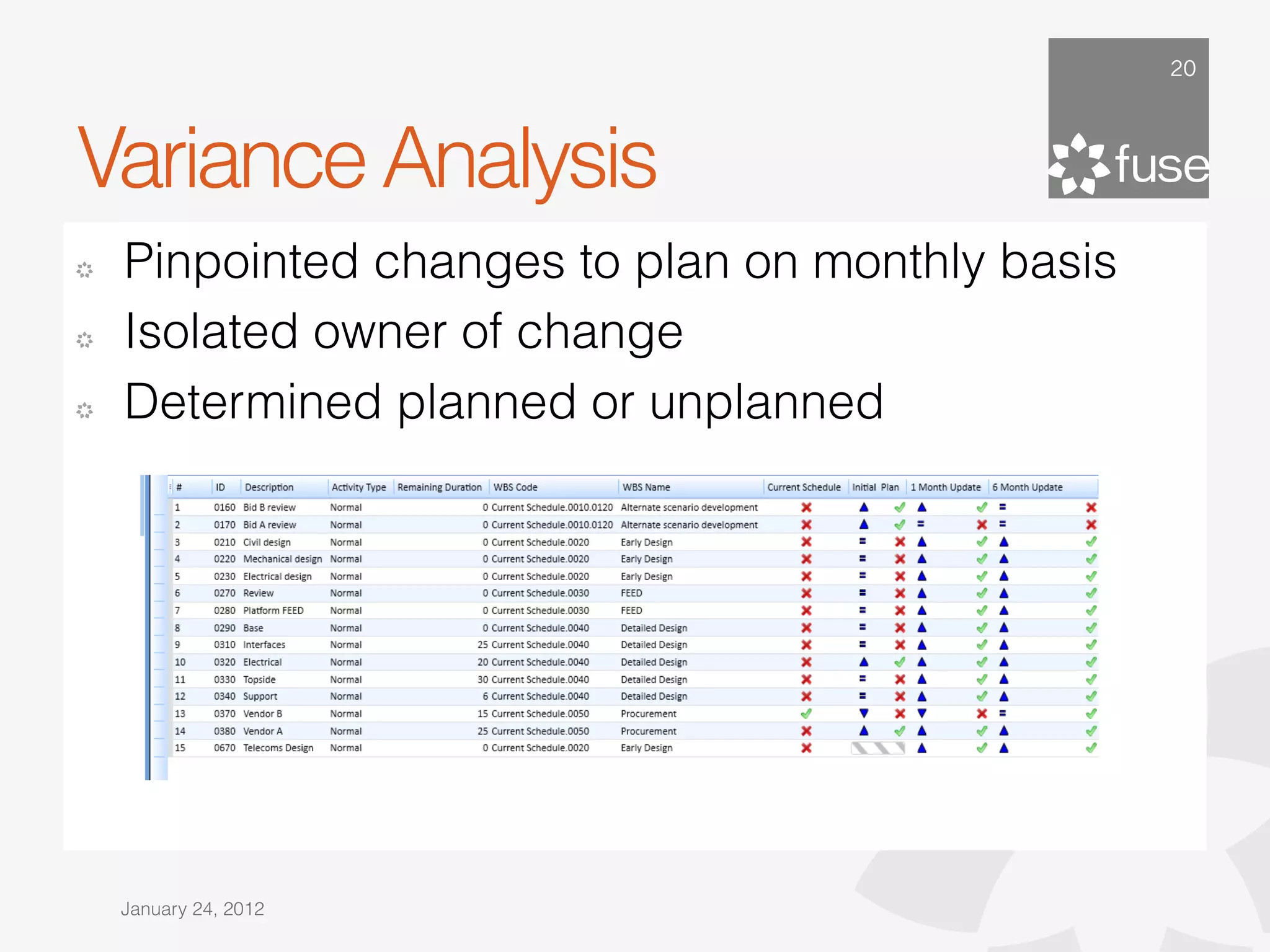

Variance Analysis
! Pinpointed changes to plan on monthly basis
! Isolated owner of change
! Determined planned or unplanned
January 24, 2012

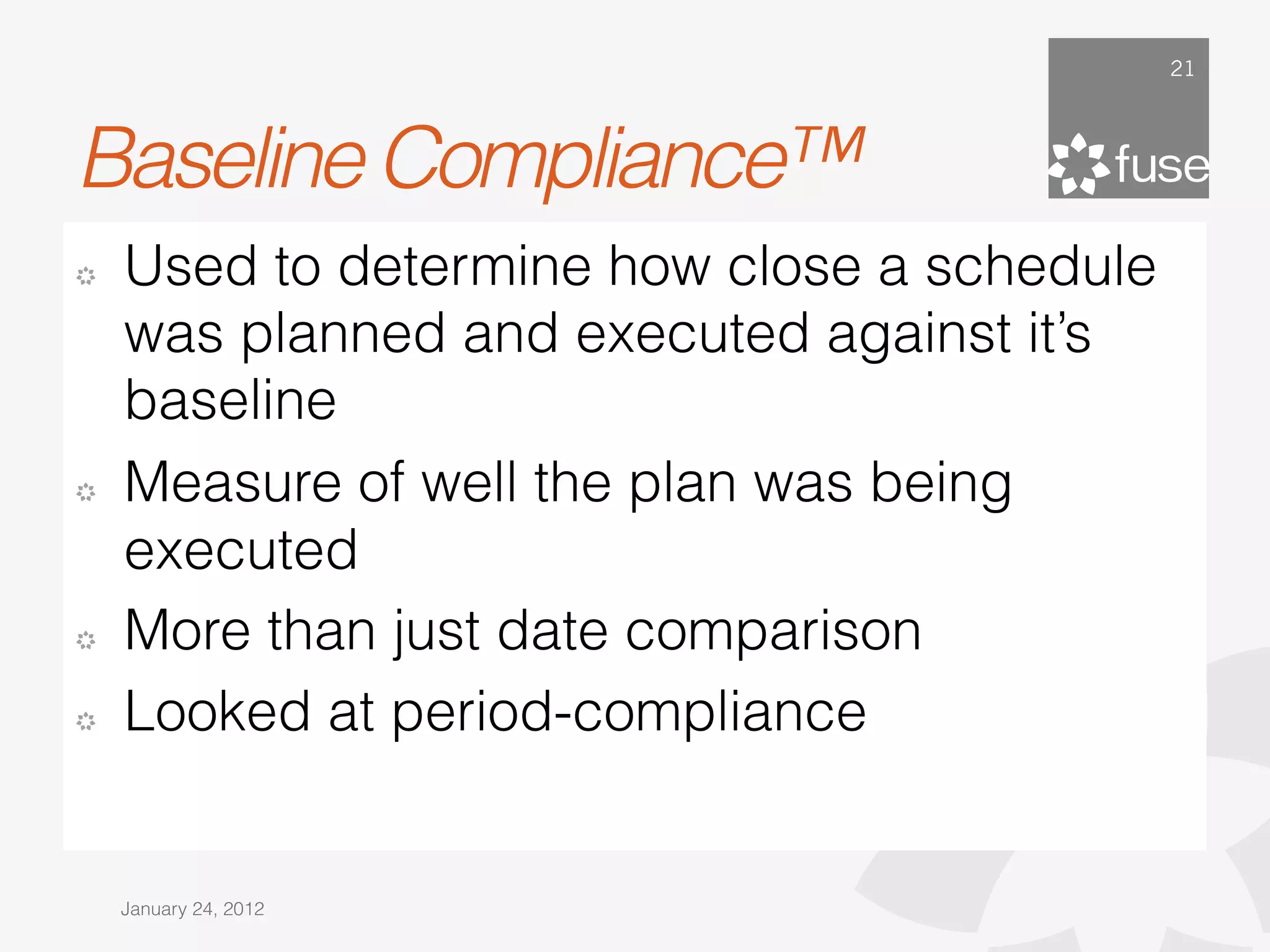

21. 21
Baseline Compliance™
! Used to determine how close a schedule
was planned and executed against it’s
baseline
! Measure of well the plan was being
executed
! More than just date comparison
! Looked at period-compliance
January 24, 2012

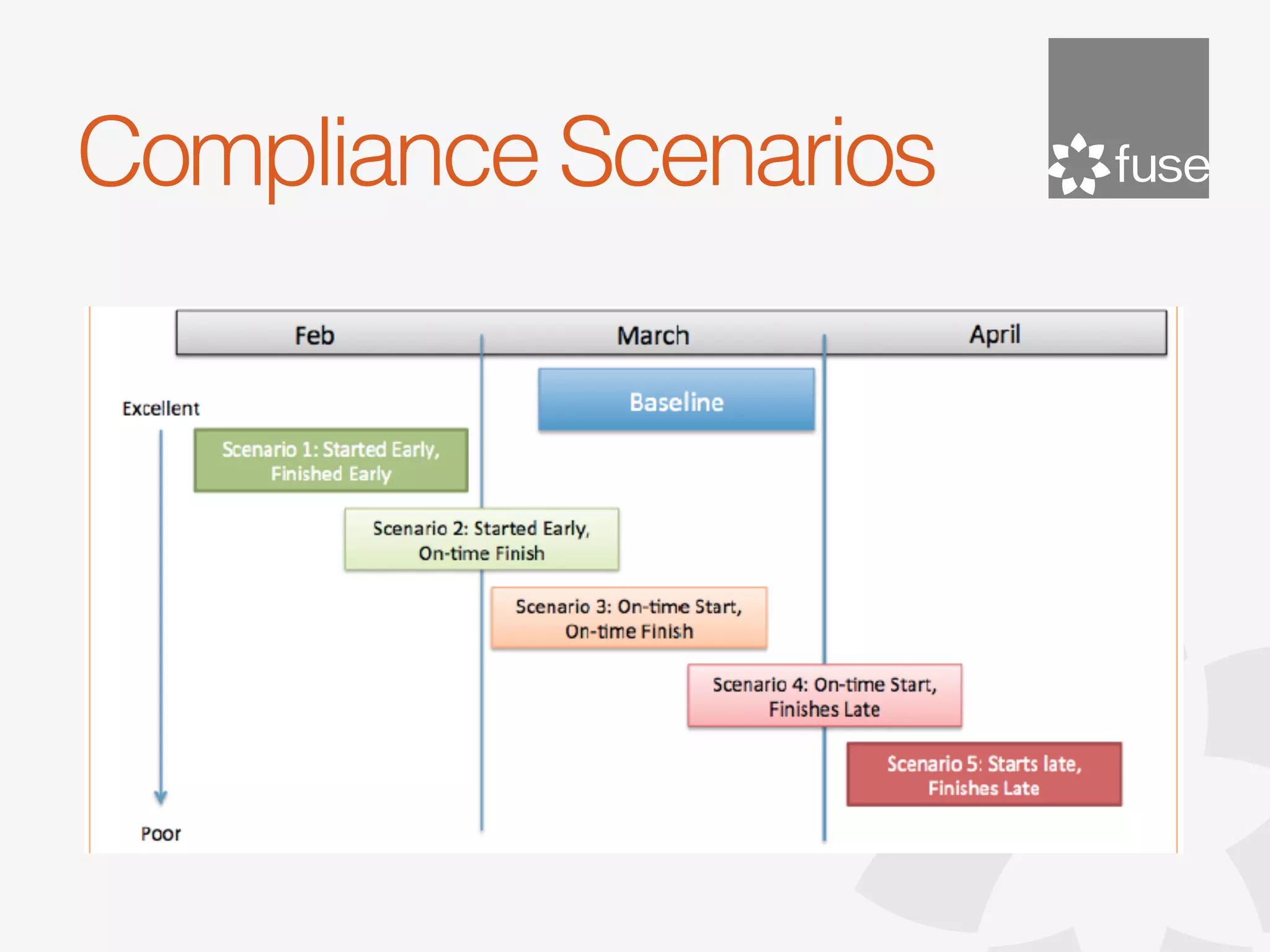

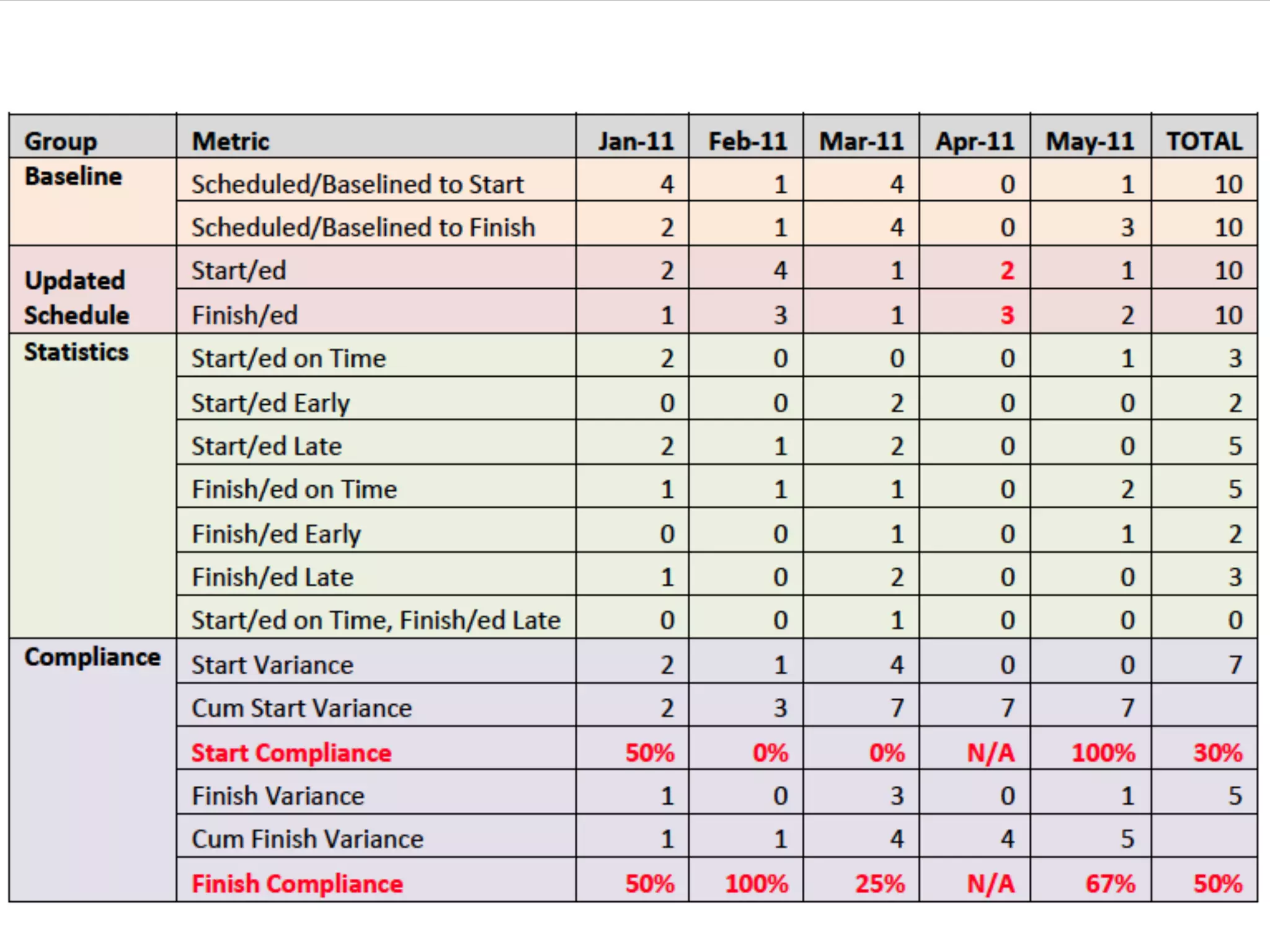

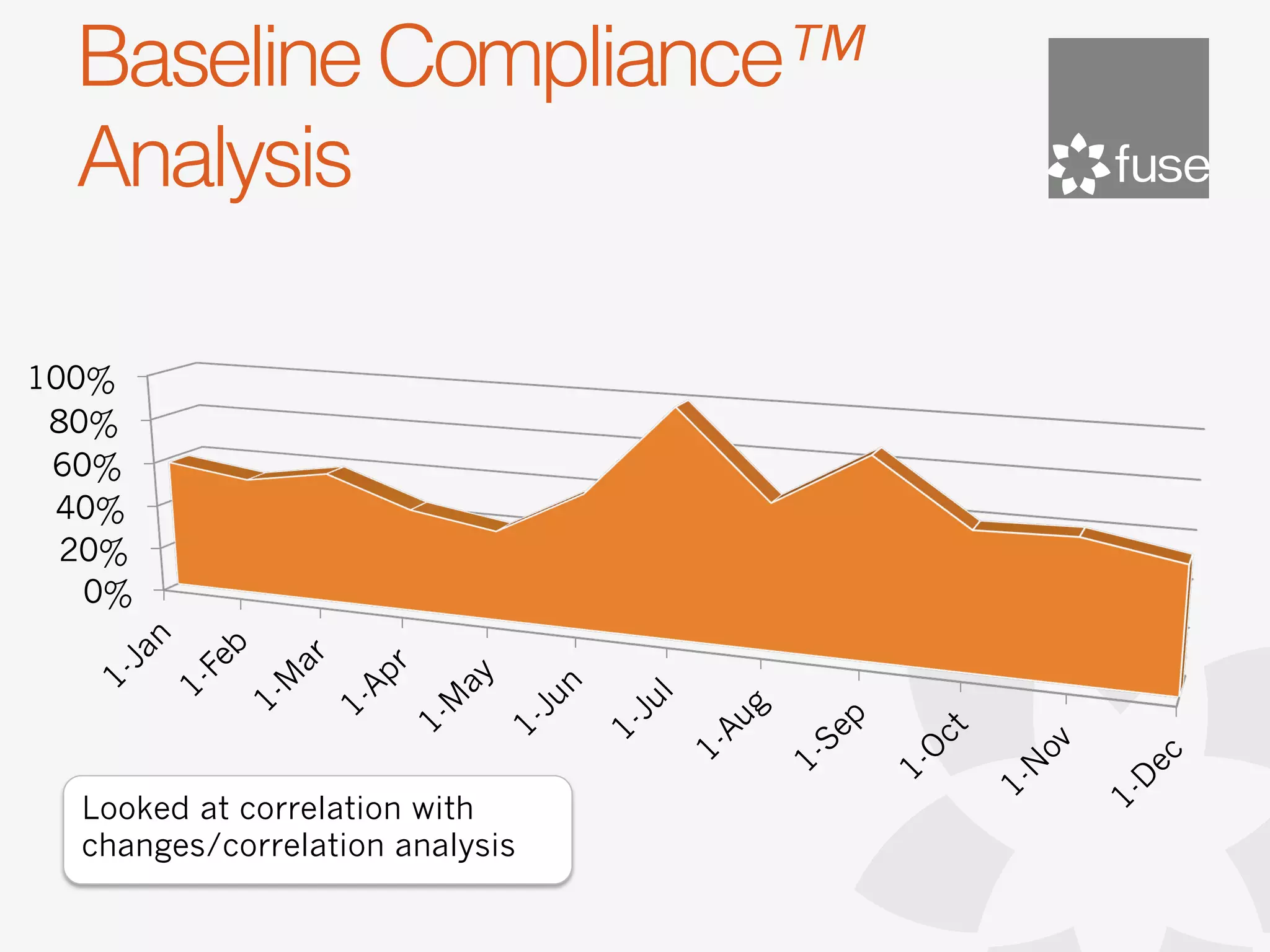

24. Baseline Compliance™
Analysis
100%
80%
60%
40%
20%
0%
Looked at correlation with
changes/correlation analysis
25. 25

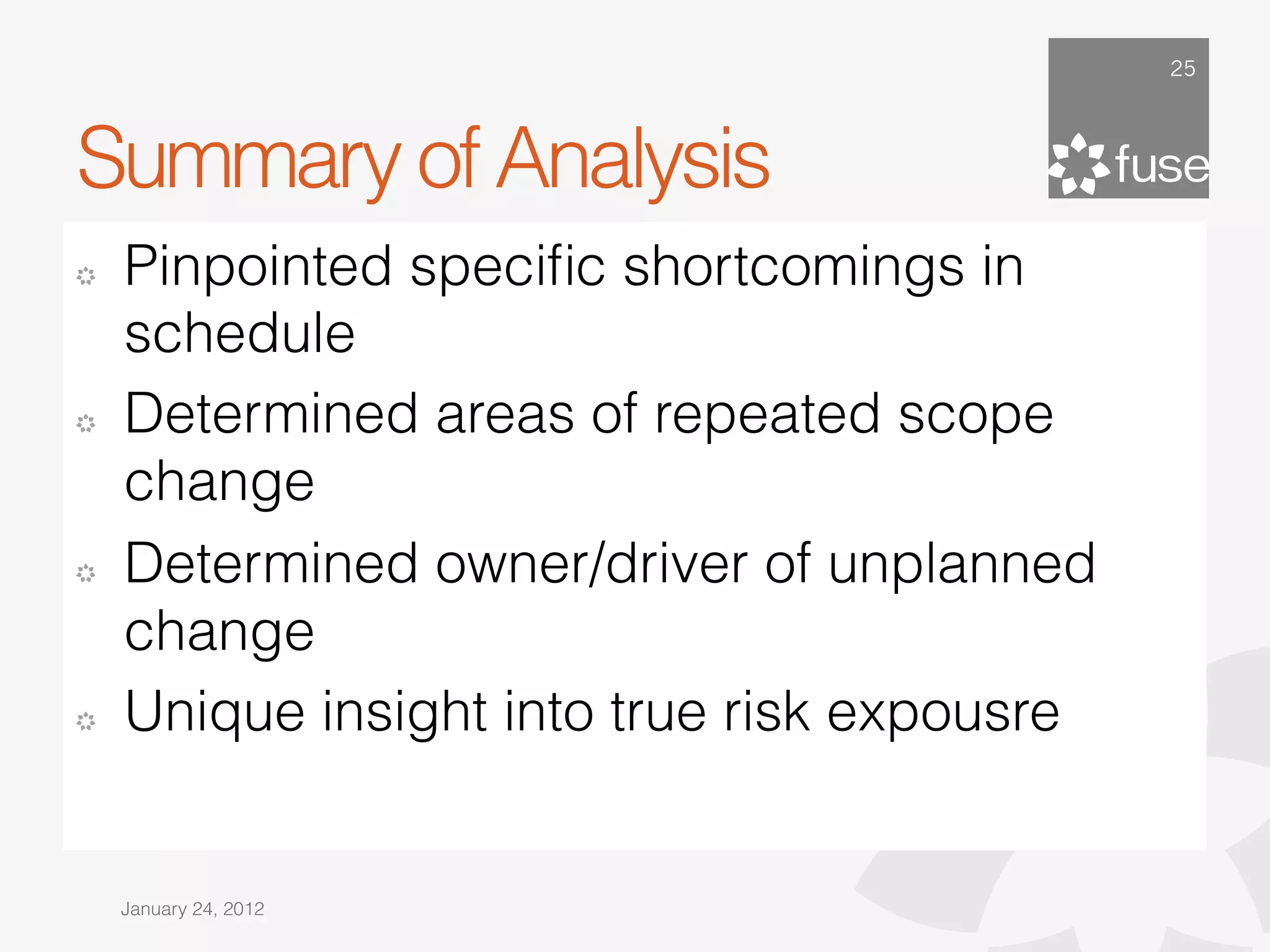

Summary of Analysis
! Pinpointed specific shortcomings in
schedule
! Determined areas of repeated scope
change
! Determined owner/driver of unplanned
change
! Unique insight into true risk expousre
January 24, 2012
26. Case Study #2
Joint Venture Dispute
• Oil & gas CAPEX project
• Completion Nov 2018 (year later than JV board willing to sanction)
• Pre-FEED already slipped by 6 months
• Determine true first production date
• Understand & agree P50/P75 risk exposure
• Identify scenario to get project back to original target completion
Risk exposure Acceleration
Realism (S2)
(S3) (S4)
27. 27

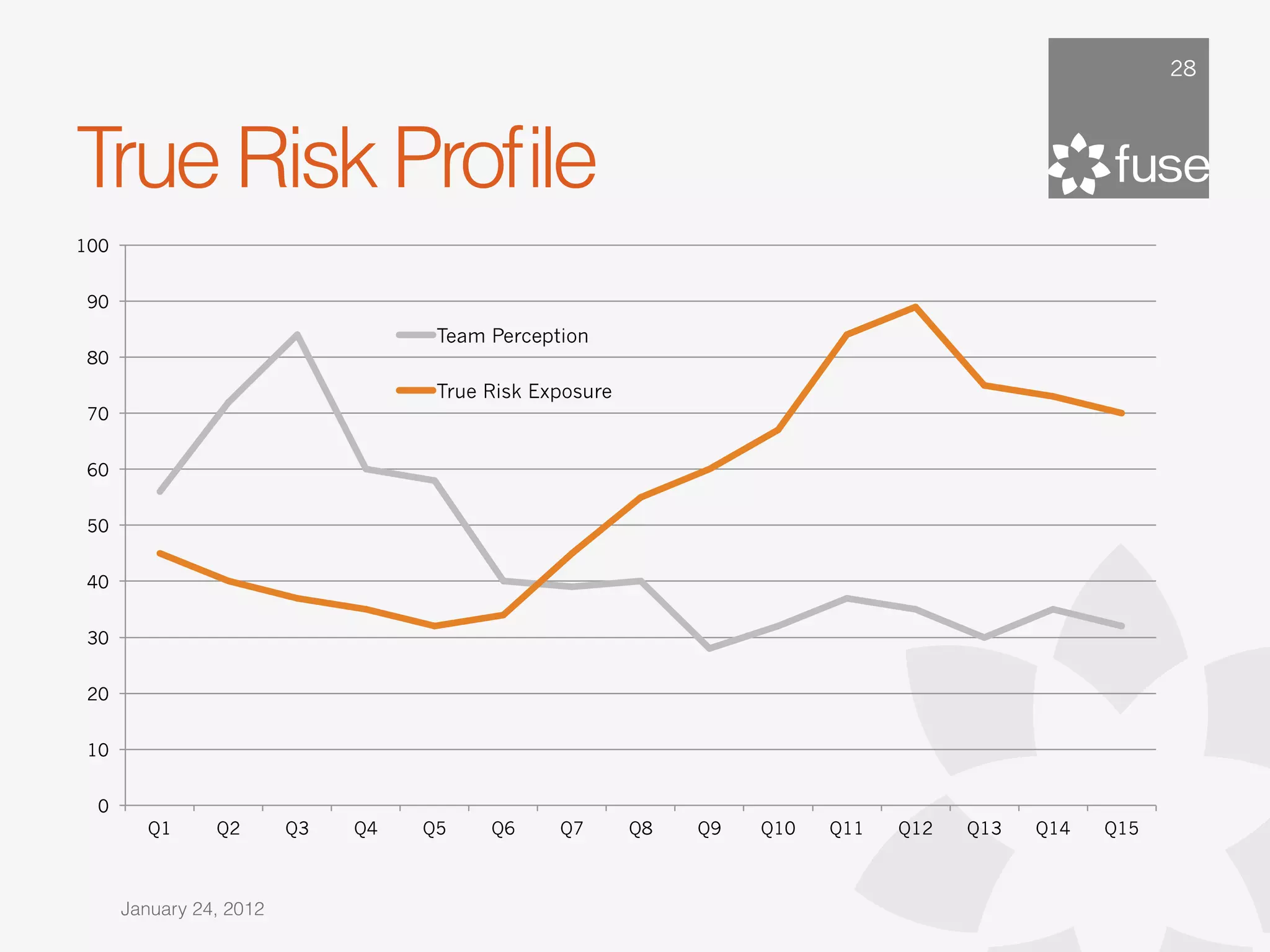

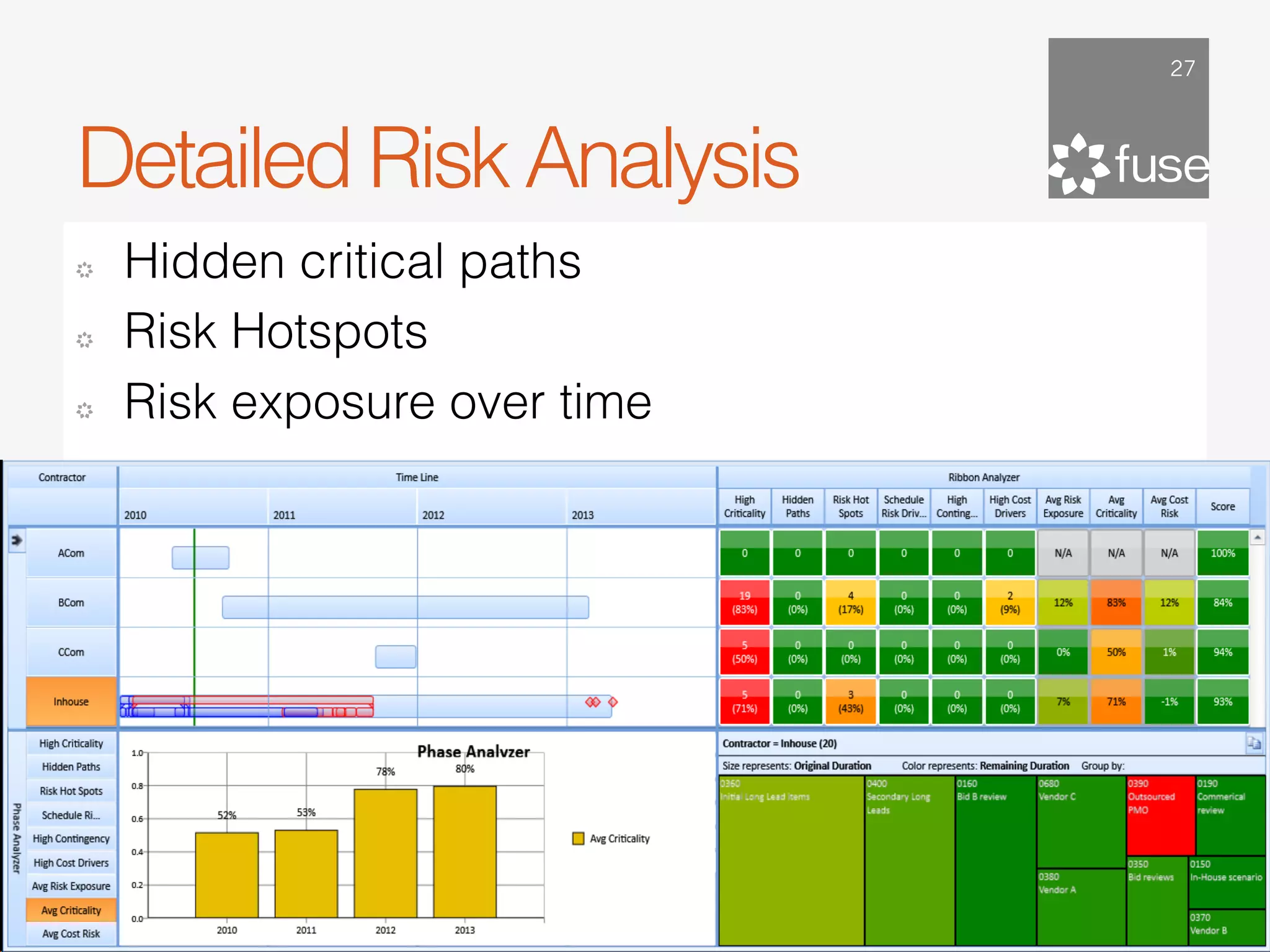

Detailed Risk Analysis
! Hidden critical paths
! Risk Hotspots
! Risk exposure over time
January 24, 2012
32. Schedule 32

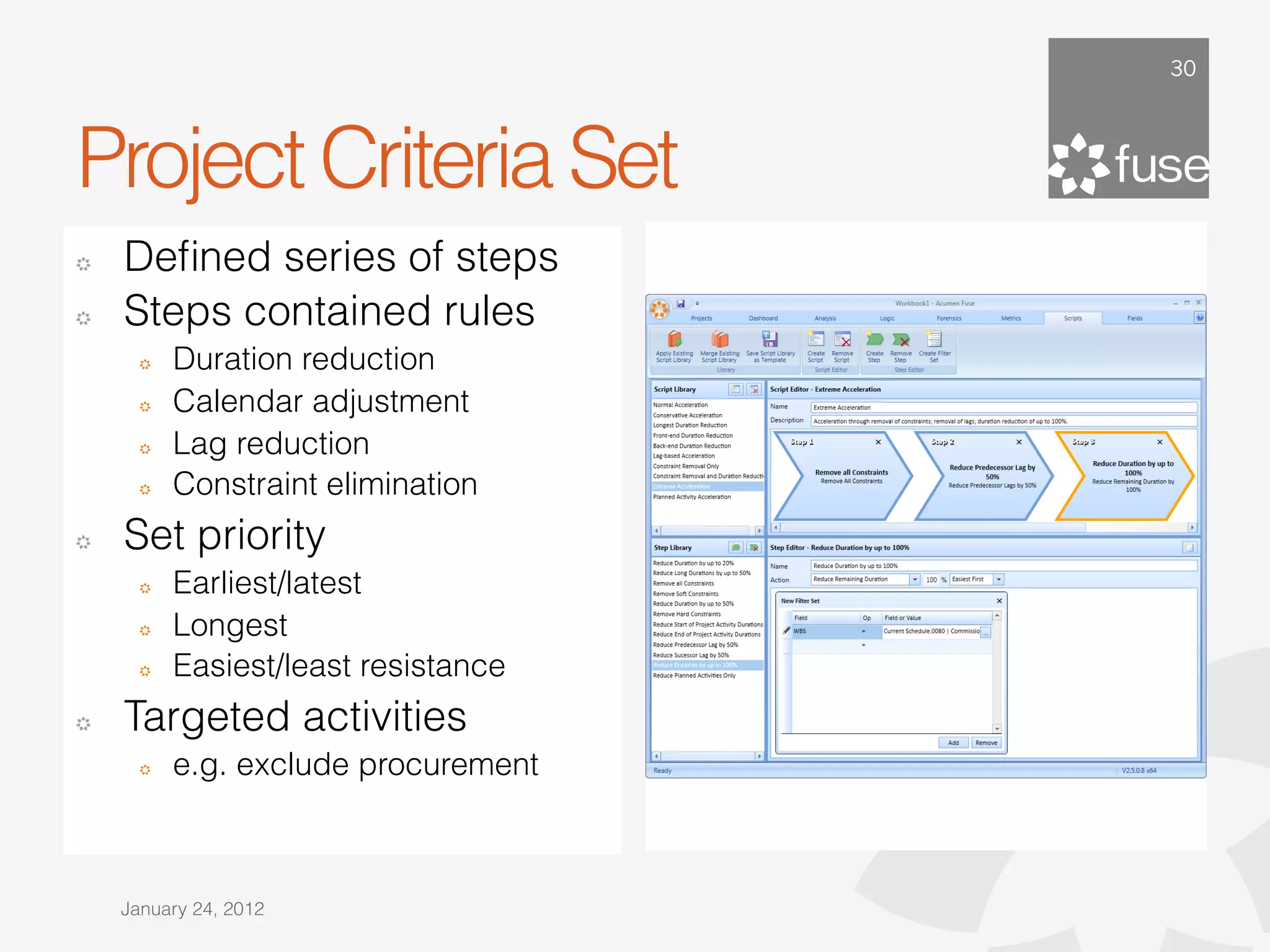

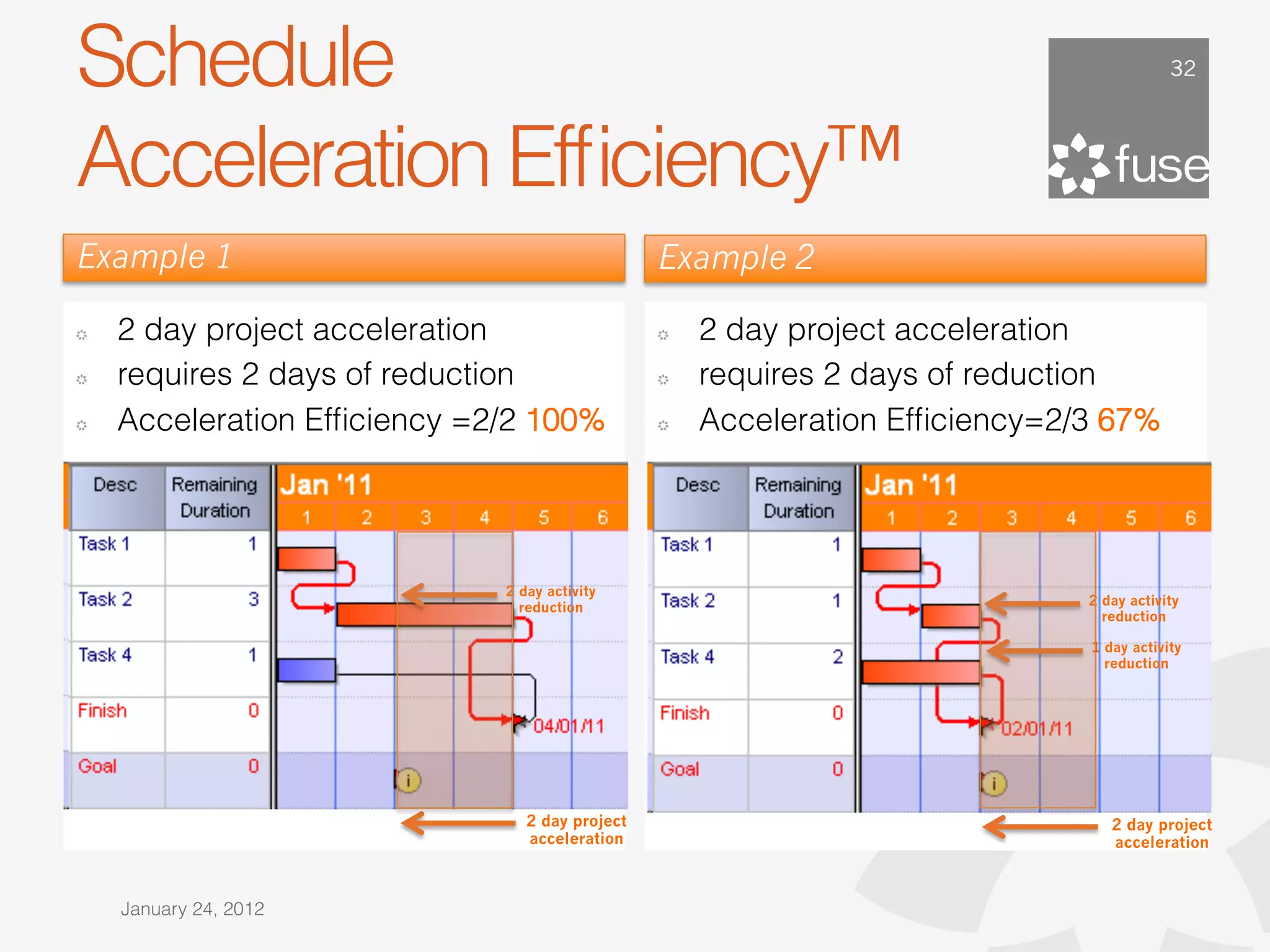

Acceleration Efficiency™
Example 1 Example 2
! 2 day project acceleration ! 2 day project acceleration
! requires 2 days of reduction ! requires 2 days of reduction
! Acceleration Efficiency =2/2 100% ! Acceleration Efficiency=2/3 67%
2 day activity
reduction 2 day activity
reduction
1 day activity
reduction
2 day project 2 day project
acceleration acceleration
January 24, 2012
33. 33

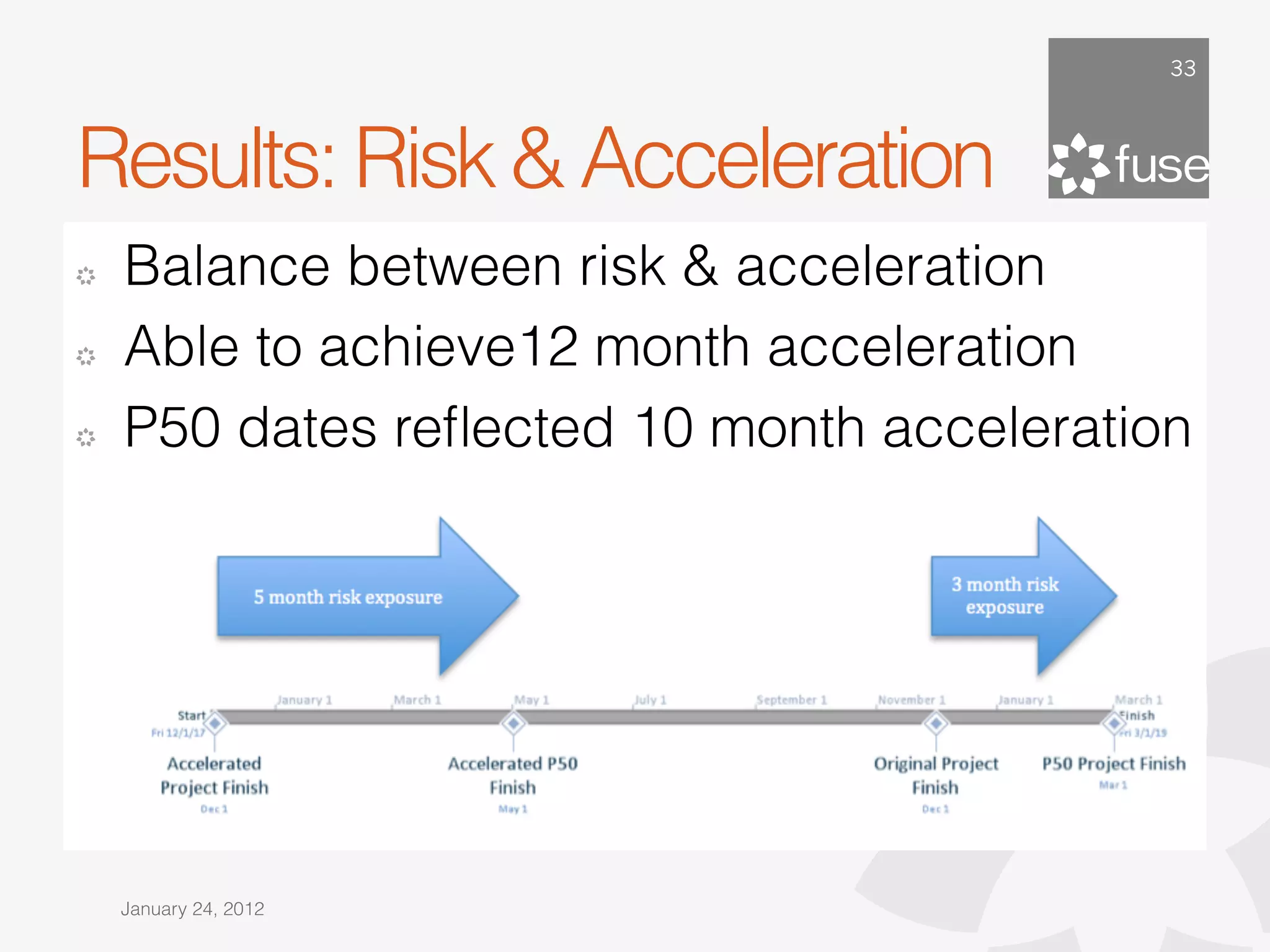

Results: Risk & Acceleration
! Balance between risk & acceleration
! Able to achieve12 month acceleration
! P50 dates reflected 10 month acceleration
January 24, 2012
