Meet or Exceed Schedule Expectations through
                        //
Intelligent Acceleration
                         Dr. Dan Patterson PMP// CEO Acumen
                                                  May 7 2012
  //

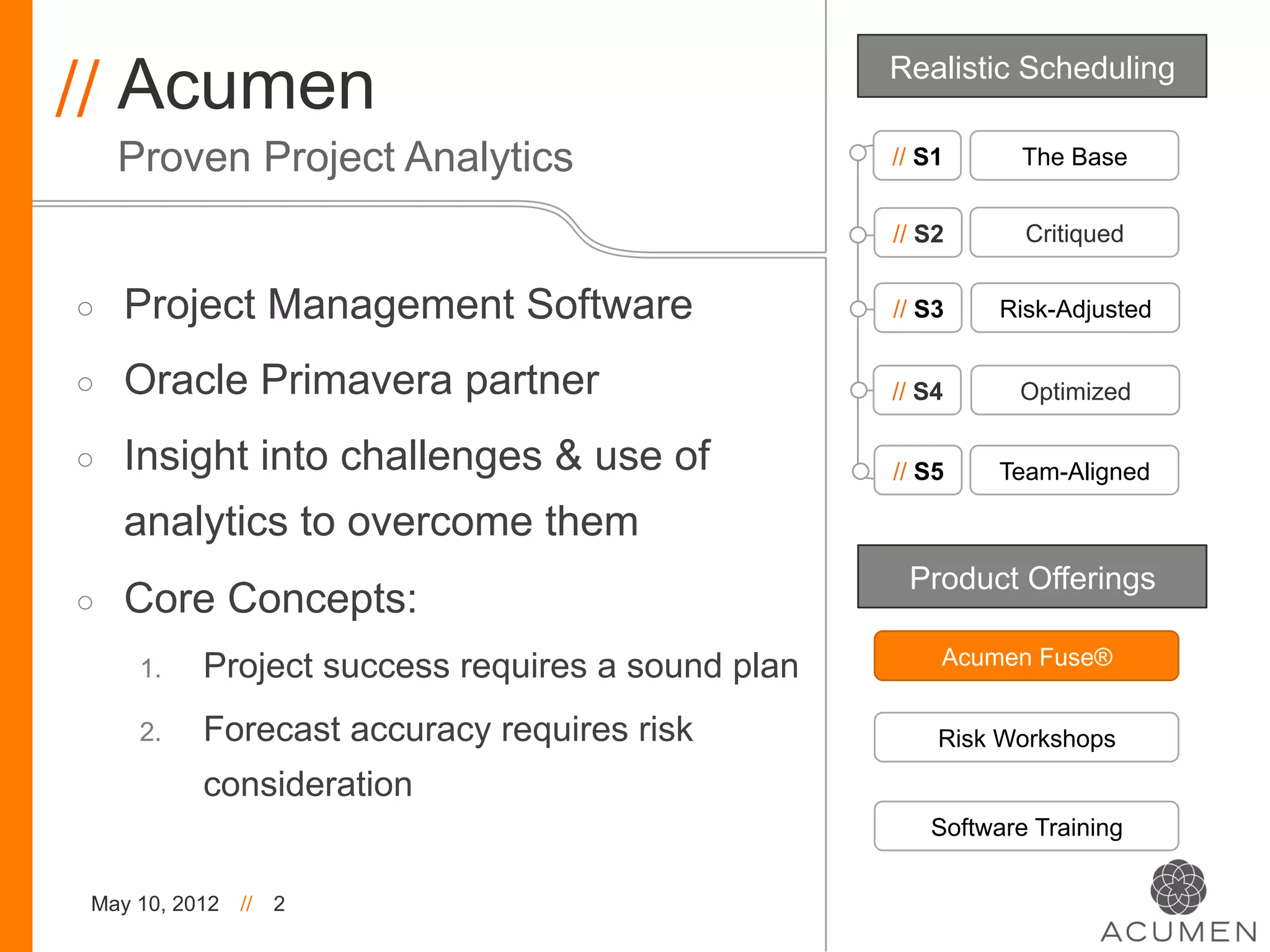

// Acumen                                           Realistic Scheduling

     Proven Project Analytics                       // S1      The Base

                                                    // S2      Critiqued

◦    Project Management Software                    // S3    Risk-Adjusted

◦    Oracle Primavera partner                       // S4     Optimized

◦    Insight into challenges & use of               // S5    Team-Aligned

     analytics to overcome them
                                                     Product Offerings
◦    Core Concepts:
      1.    Project success requires a sound plan       Acumen Fuse®

      2.    Forecast accuracy requires risk             Risk Workshops
            consideration
                                                       Software Training

 May 10, 2012   //   2

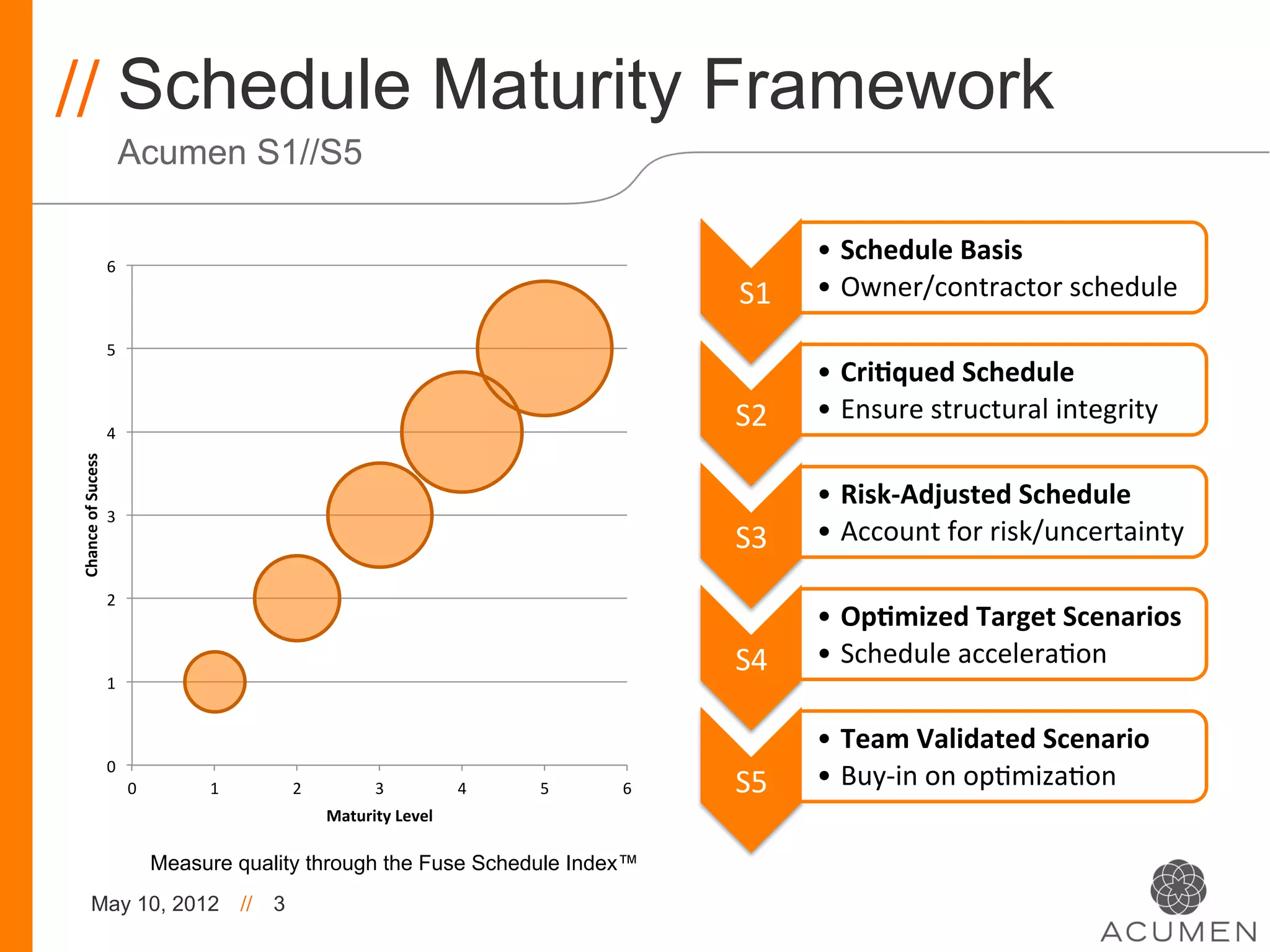

// Schedule Maturity Framework
                                 Acumen S1//S5

                             6

                                                                                                                                        •  Schedule
  Basis

  S1
     •  Owner/contractor
  schedule

                             5

                                                                                                                                        •  Cri/qued
  Schedule

                                                                                                                           S2
         •  Ensure
  structural
  integrity

                             4

Chance
  of
  Sucess

                                                                                                                                        •  Risk-­‐Adjusted
  Schedule

                             3

                                                                                                                           S3
         •  Account
  for
  risk/uncertainty

                             2

                                                                                                                                        •  Op/mized
  Target
  Scenarios

                                                                                                                           S4
         •  Schedule
  accelera>on

                             1

                                                                                                                                        •  Team
  Validated
  Scenario

                             0

                                     0
          1
              2
              3
            4
     5
     6
     S5
         •  Buy-­‐in
  on
  op>miza>on

                                                                           Maturity
  Level

                                             Measure quality through the Fuse Schedule Index™
            May 10, 2012                                  //   3

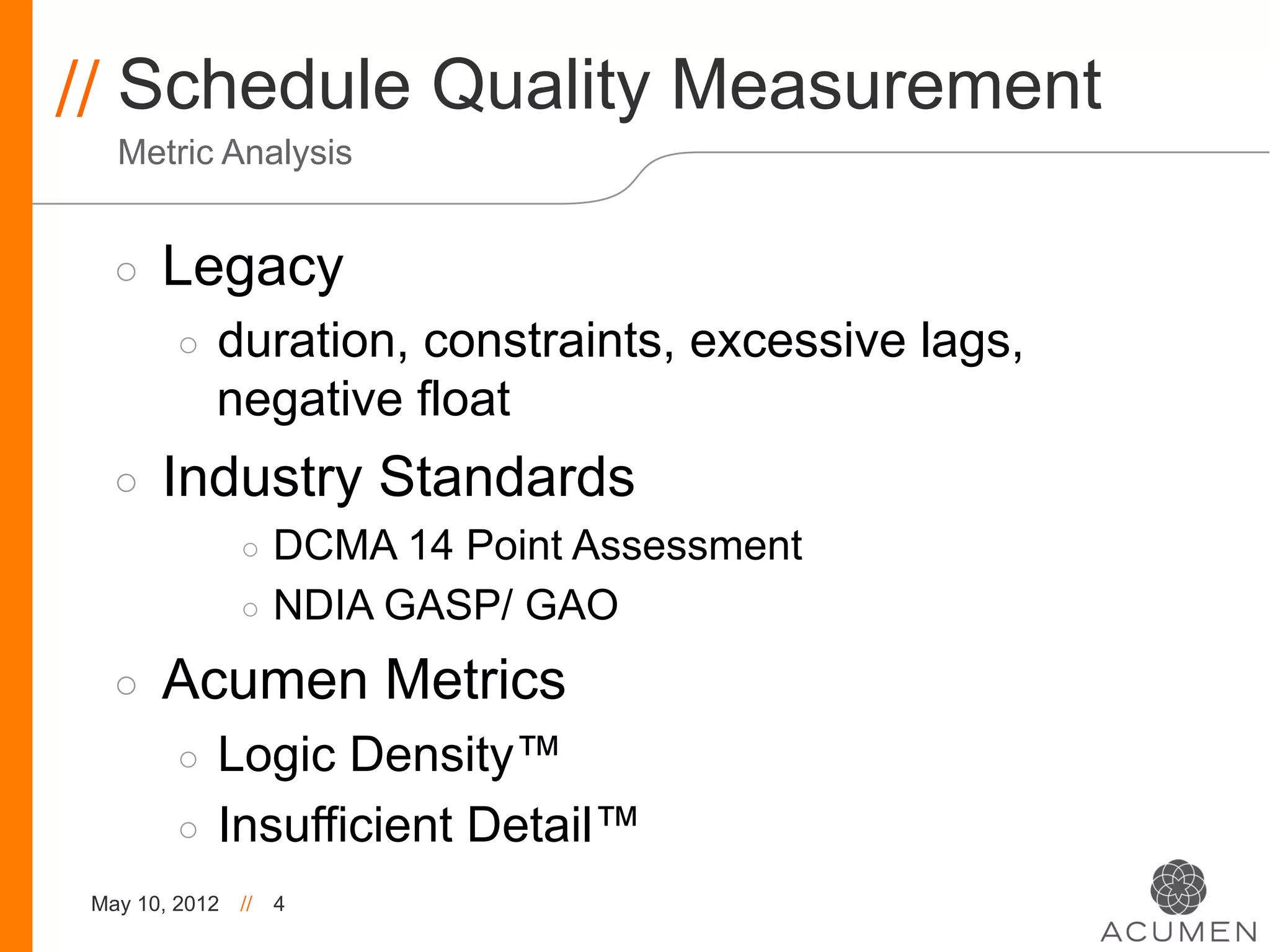

// Schedule Quality Measurement
   Metric Analysis

   ◦    Legacy
         ◦    duration, constraints, excessive lags,
              negative float
   ◦    Industry Standards
                ◦  DCMA 14 Point Assessment
                ◦  NDIA GASP/ GAO

   ◦    Acumen Metrics
         ◦  Logic Density™
         ◦  Insufficient Detail™
 May 10, 2012   //   4

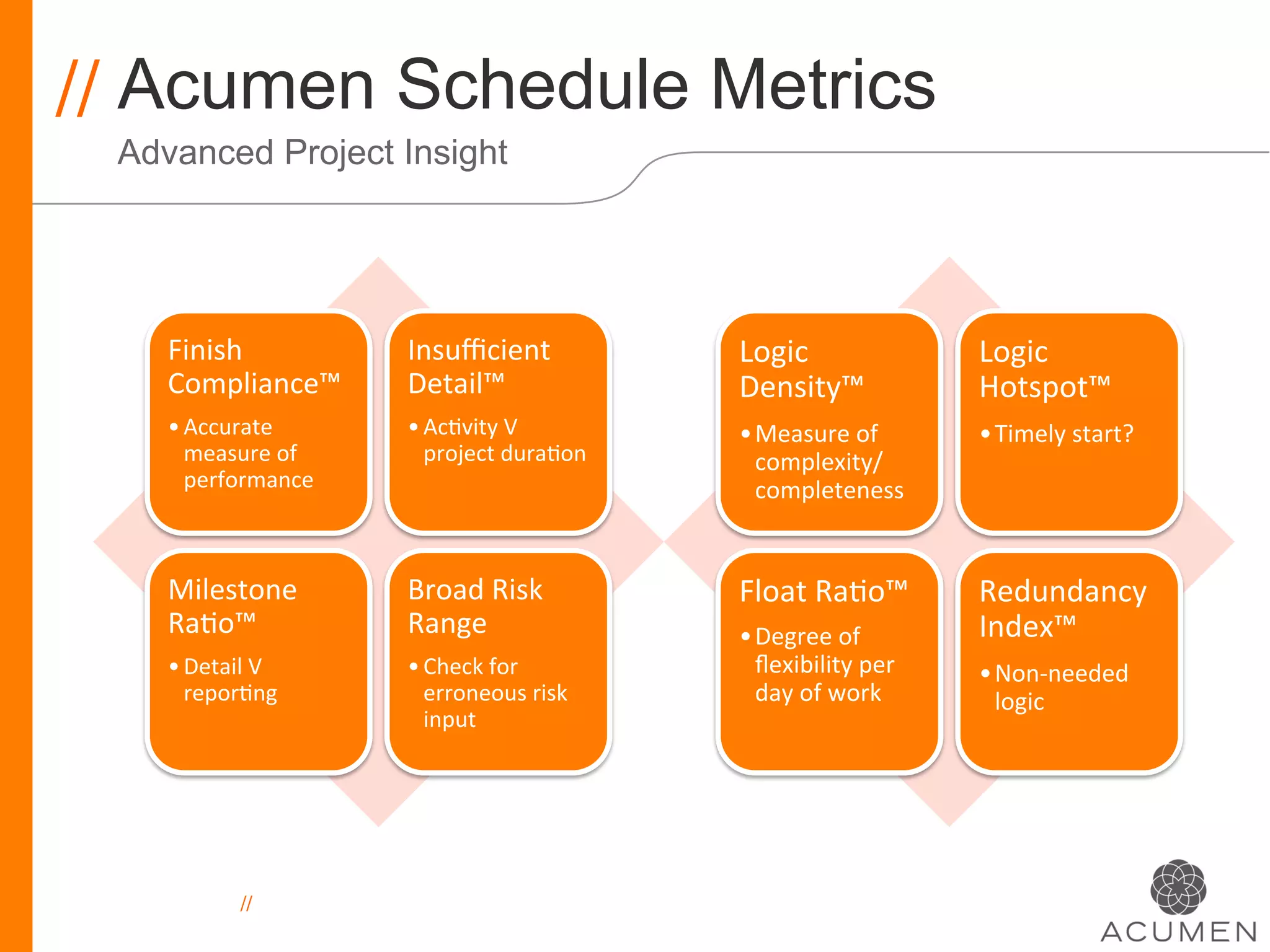

// Acumen Schedule Metrics
 Advanced Project Insight

    Finish
              Insufficient
               Logic
                   Logic

    Compliance™
         Detail™
                  Density™
                Hotspot™

    • Accurate
          • Ac>vity
  V
           • Measure
  of
         • Timely
  start?

      measure
  of
       project
  dura>on
       complexity/
      performance
                                    completeness

    Milestone
           Broad
  Risk
            Float
  Ra>o™
          Redundancy

    Ra>o™
               Range
                    • Degree
  of
          Index™

    • Detail
  V
       • Check
  for
             flexibility
  per
     • Non-­‐needed

      repor>ng
            erroneous
  risk
        day
  of
  work
       logic

                            input

              //

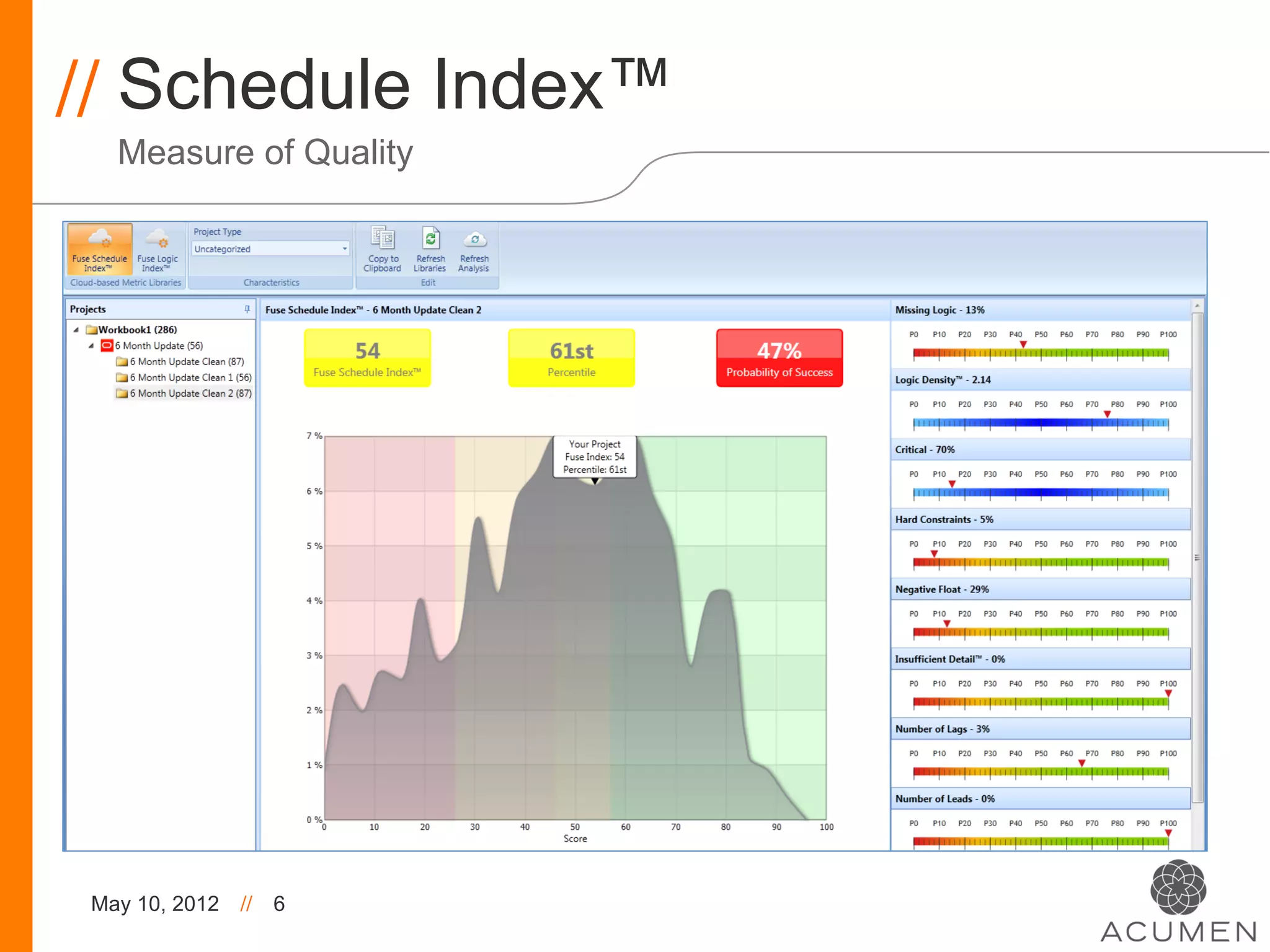

// Schedule Index™
   Measure of Quality

 May 10, 2012   //   6

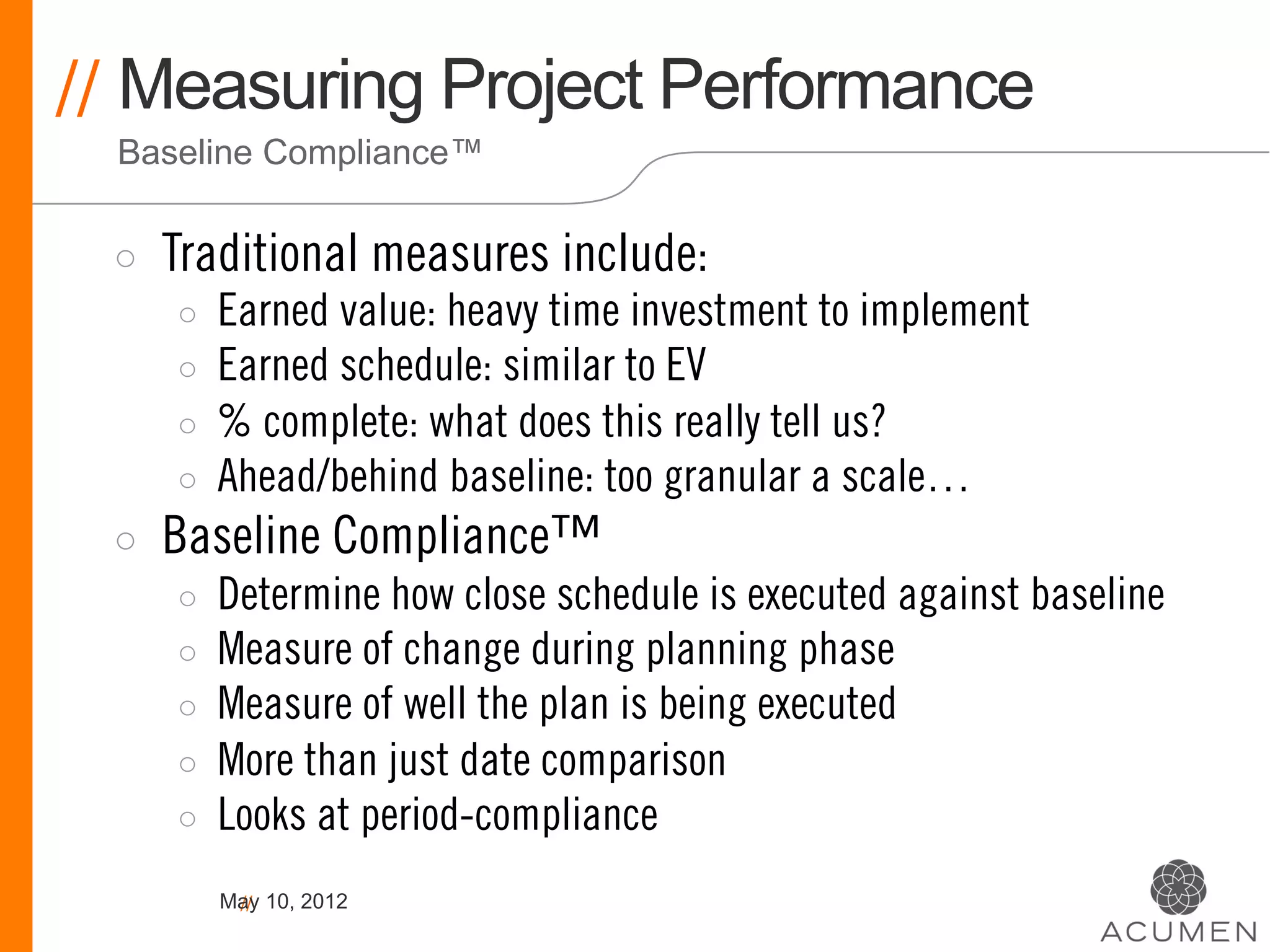

// Measuring Project Performance
  Baseline Compliance™

 ◦    Traditional measures include:
      ◦    Earned value: heavy time investment to implement
      ◦    Earned schedule: similar to EV
      ◦    % complete: what does this really tell us?
      ◦    Ahead/behind baseline: too granular a scale…
 ◦    Baseline Compliance™
      ◦    Determine how close schedule is executed against baseline
      ◦    Measure of change during planning phase
      ◦    Measure of well the plan is being executed
      ◦    More than just date comparison
      ◦    Looks at period-compliance
           May 10, 2012
            //

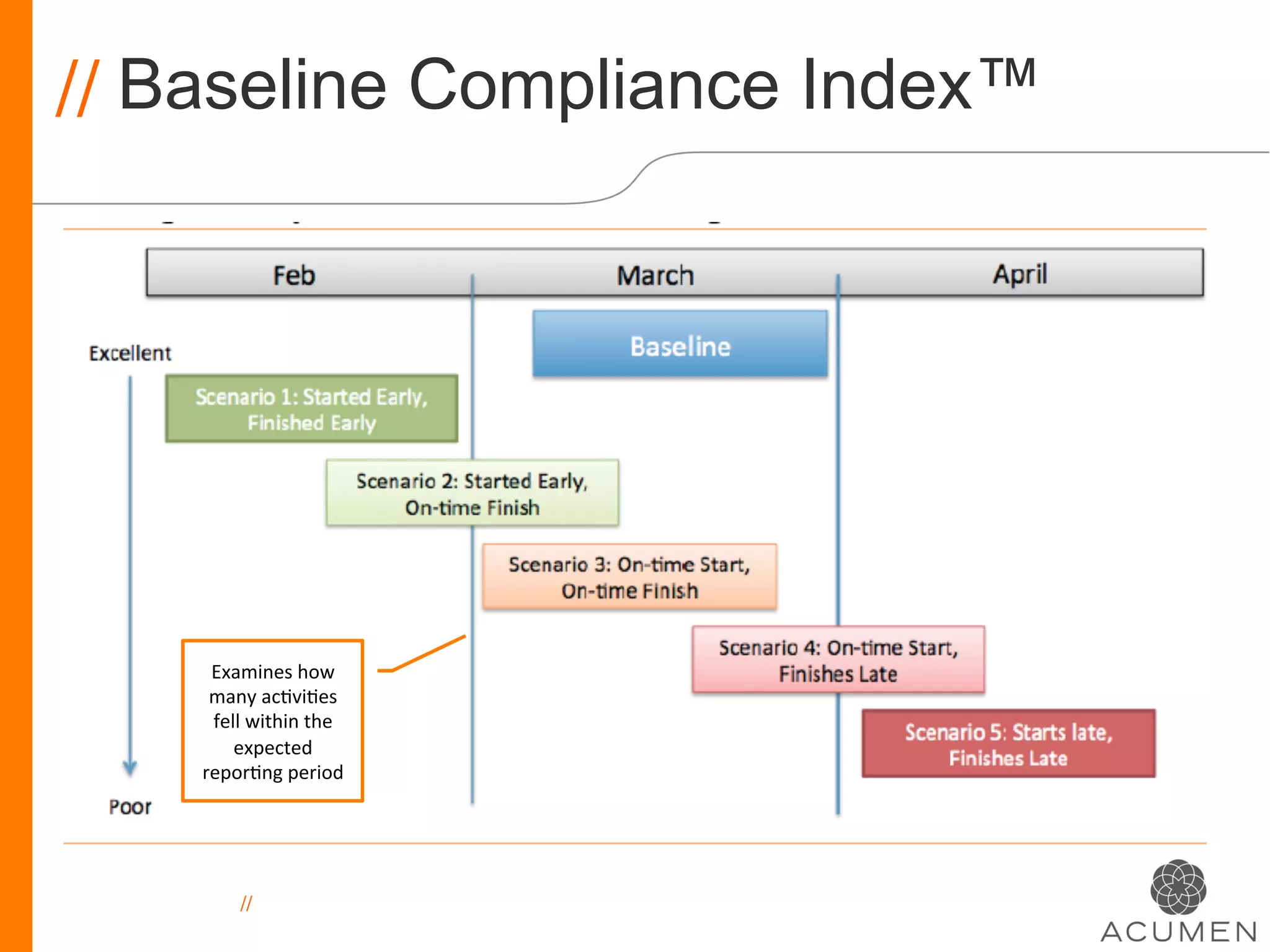

// Baseline Compliance Index™

     Examines
  how

     many
  ac>vi>es

     fell
  within
  the

        expected

    repor>ng
  period

          //

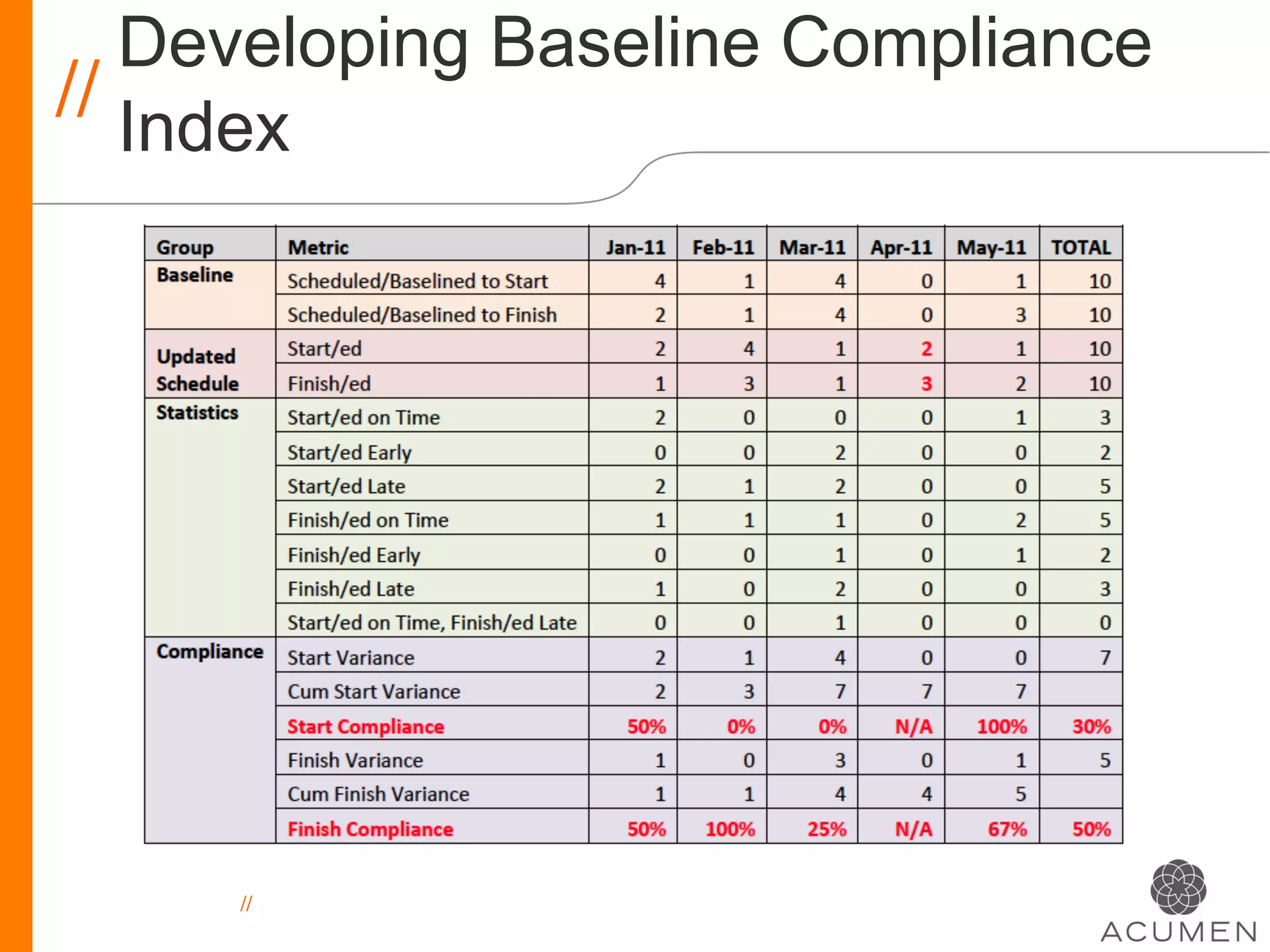

Developing Baseline Compliance
// Index

     //

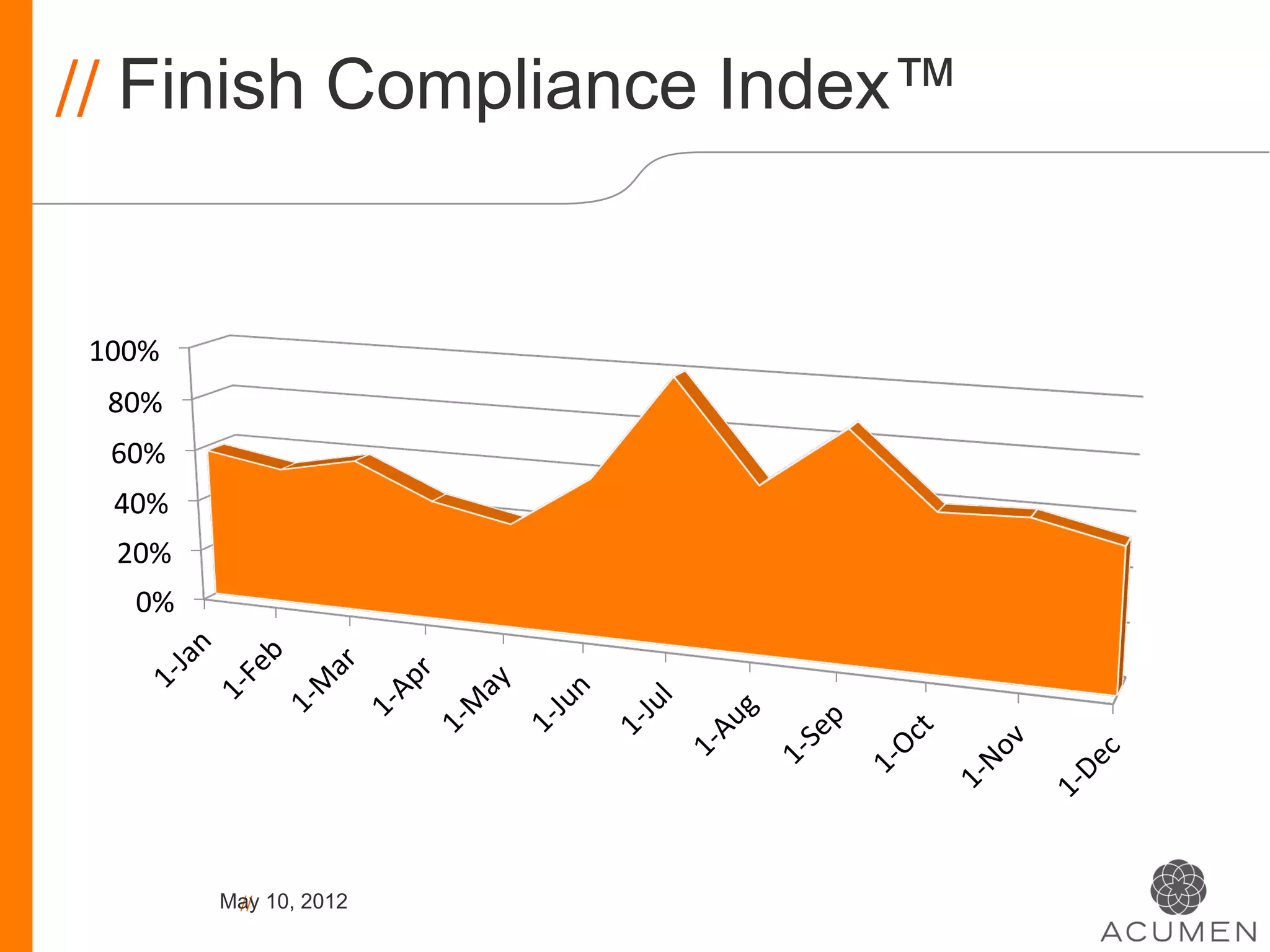

// Finish Compliance Index™

100%

 80%

  60%

  40%

  20%

    0%

             May 10, 2012
              //
//

     //

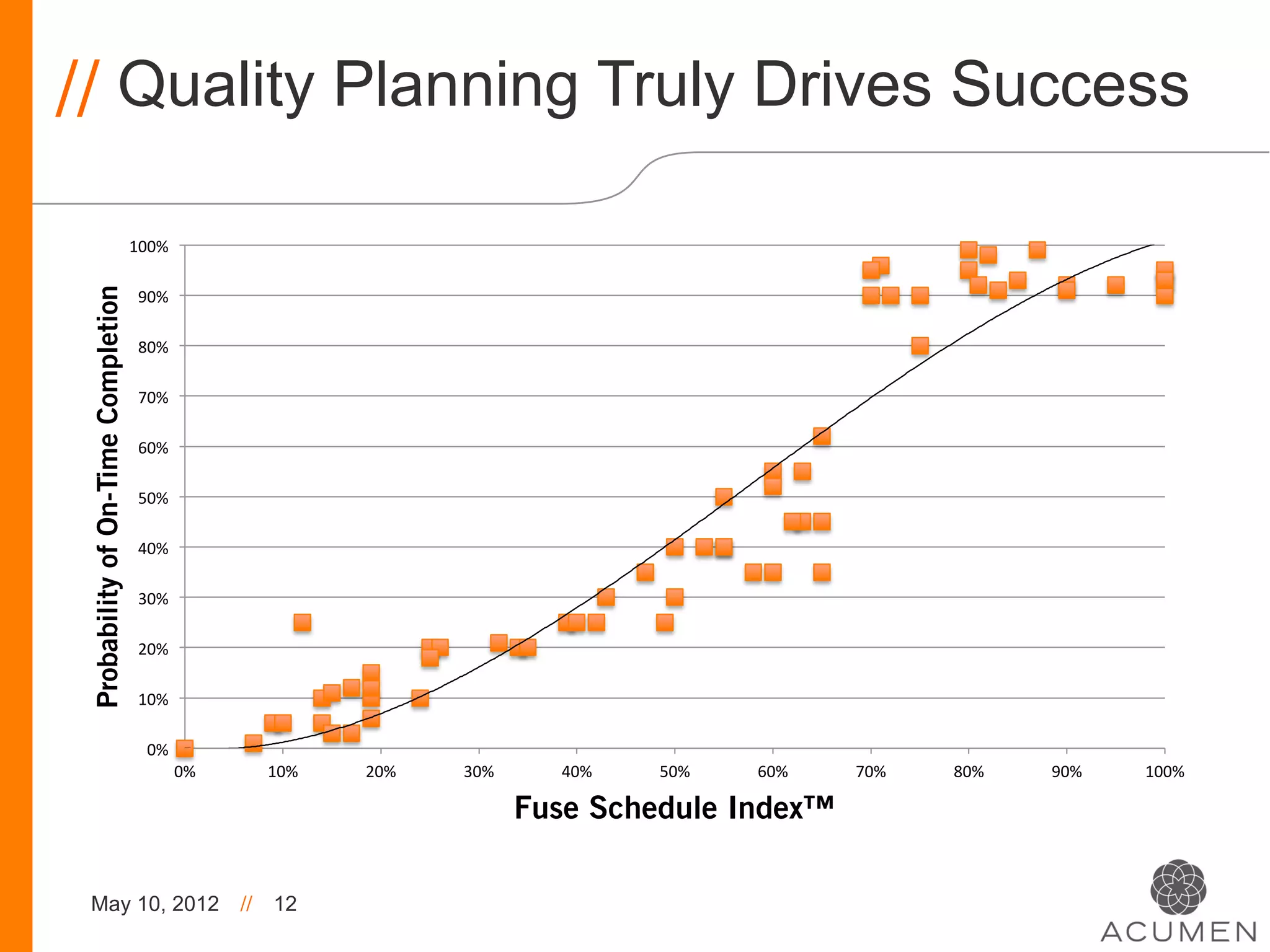

// Quality Planning Truly Drives Success
                                     100%

 Probability of On-Time Completion

                                      90%

                                      80%

                                      70%

                                      60%

                                      50%

                                      40%

                                      30%

                                      20%

                                      10%

                                        0%

                                                 0%
          10%
     20%
     30%
       40%
     50%
     60%
     70%
     80%
     90%
     100%

                                                                                             Fuse Schedule Index™

 May 10, 2012                                             //    12

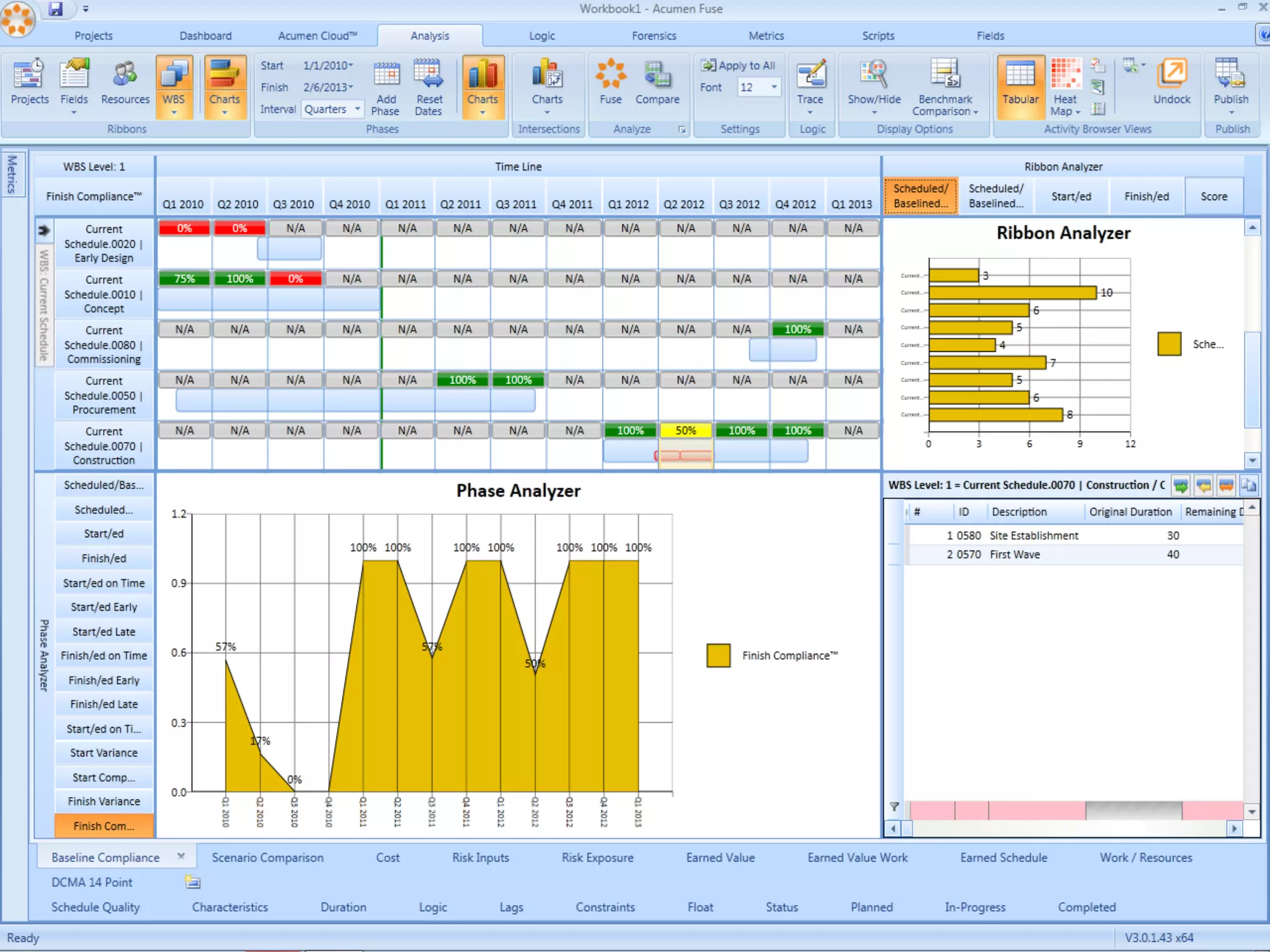

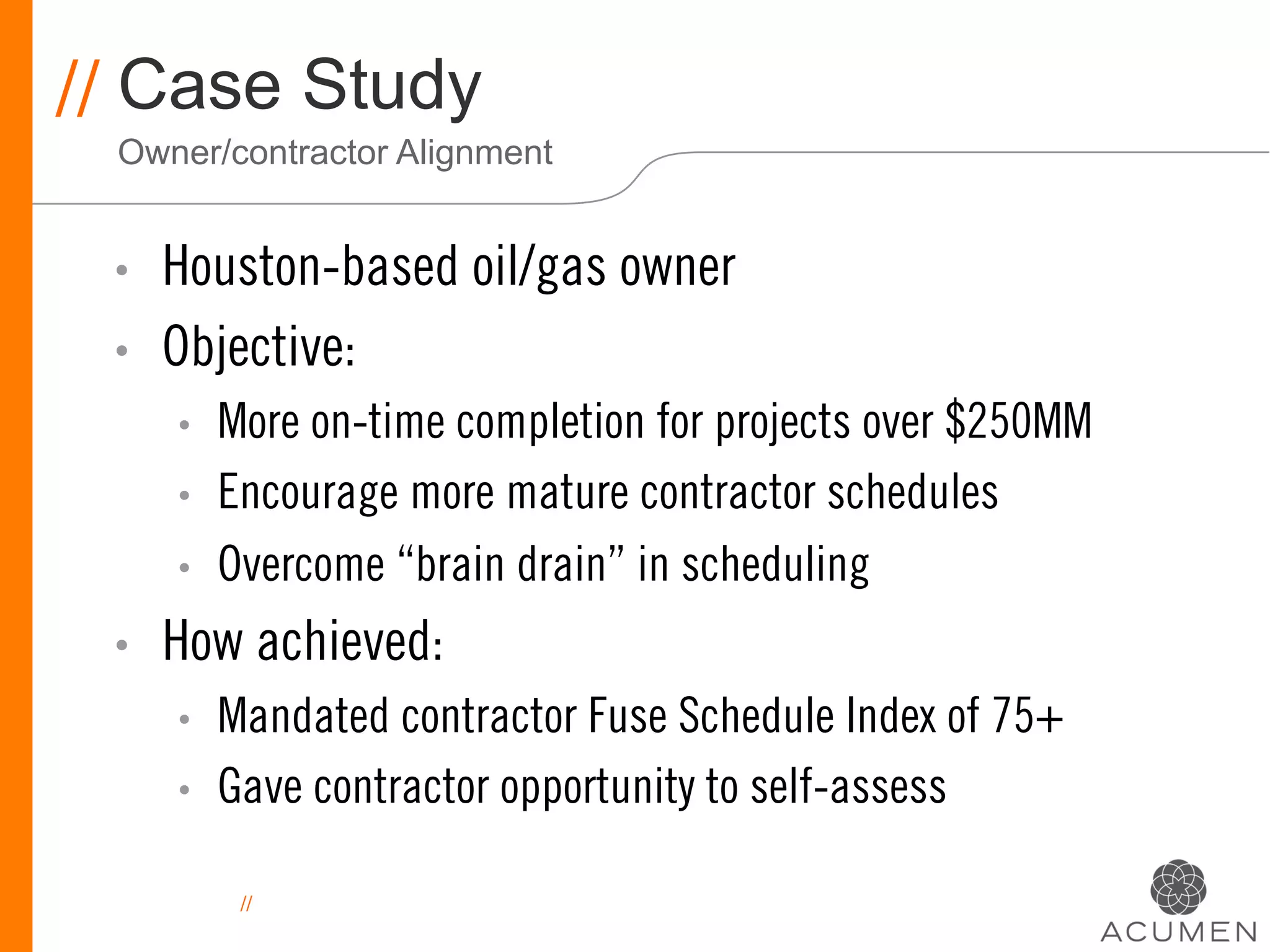

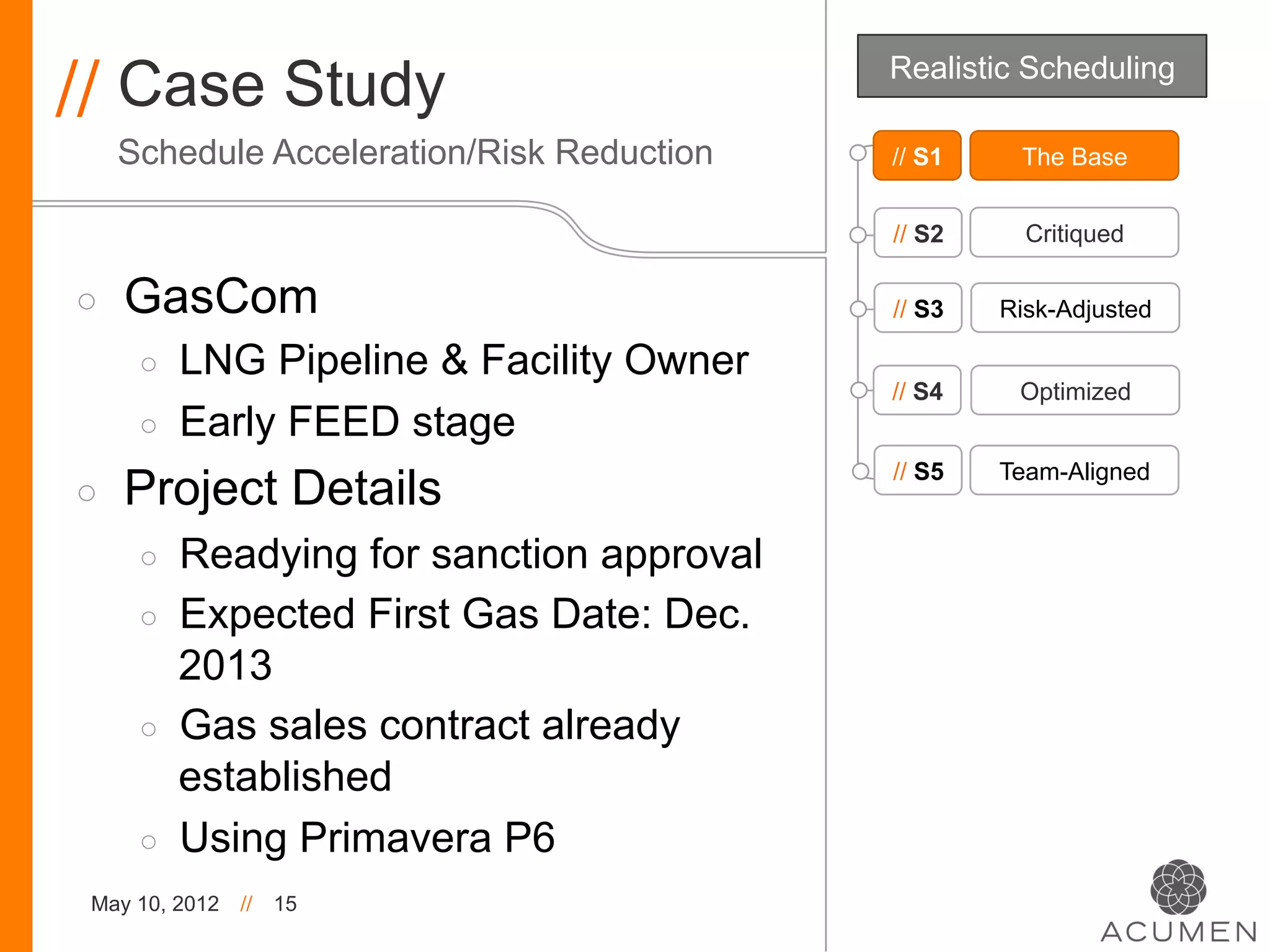

Case Study
// Acumen Fuse® Software Demonstration

        //
// Case Study
 Owner/contractor Alignment

 •    Houston-based oil/gas owner
 •    Objective:
      •    More on-time completion for projects over $250MM
      •    Encourage more mature contractor schedules
      •    Overcome “brain drain” in scheduling
 •    How achieved:
      •    Mandated contractor Fuse Schedule Index of 75+
      •    Gave contractor opportunity to self-assess

            //
// Case Study                               Realistic Scheduling

     Schedule Acceleration/Risk Reduction   // S1    The Base

                                            // S2     Critiqued

◦    GasCom                                 // S3   Risk-Adjusted

      ◦    LNG Pipeline & Facility Owner
                                            // S4    Optimized
      ◦    Early FEED stage
                                            // S5   Team-Aligned
◦    Project Details
      ◦    Readying for sanction approval
      ◦    Expected First Gas Date: Dec.
           2013
      ◦    Gas sales contract already
           established
      ◦    Using Primavera P6
 May 10, 2012   //   15

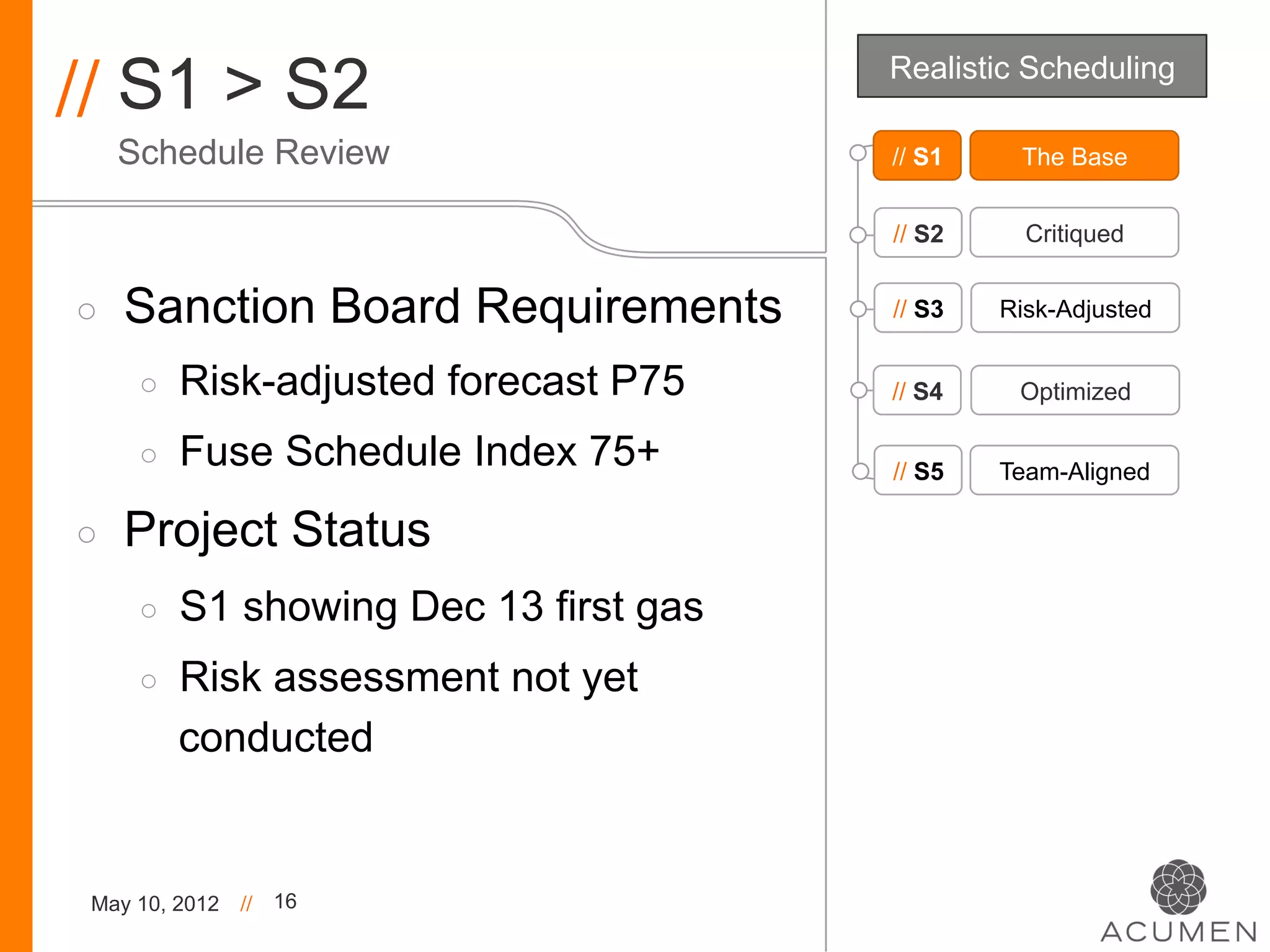

// S1 > S2                               Realistic Scheduling

     Schedule Review                     // S1    The Base

                                         // S2     Critiqued

◦    Sanction Board Requirements         // S3   Risk-Adjusted

      ◦    Risk-adjusted forecast P75    // S4    Optimized

      ◦    Fuse Schedule Index 75+       // S5   Team-Aligned

◦    Project Status
      ◦    S1 showing Dec 13 first gas
      ◦    Risk assessment not yet
           conducted

 May 10, 2012   //   16

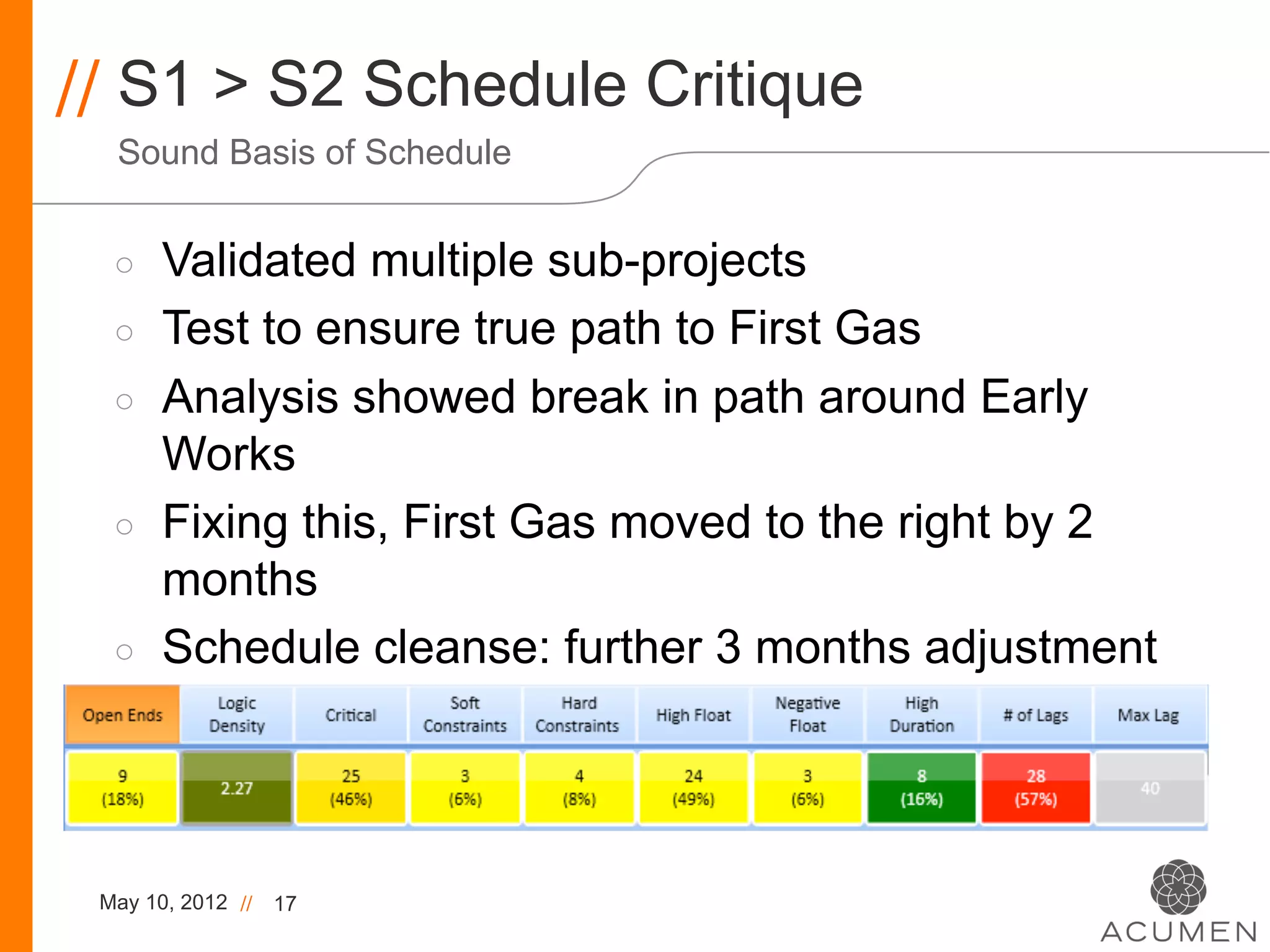

// S1 > S2 Schedule Critique
  Sound Basis of Schedule

  ◦    Validated multiple sub-projects
  ◦    Test to ensure true path to First Gas
  ◦    Analysis showed break in path around Early
       Works
  ◦    Fixing this, First Gas moved to the right by 2
       months
  ◦    Schedule cleanse: further 3 months adjustment

 May 10, 2012 //   17

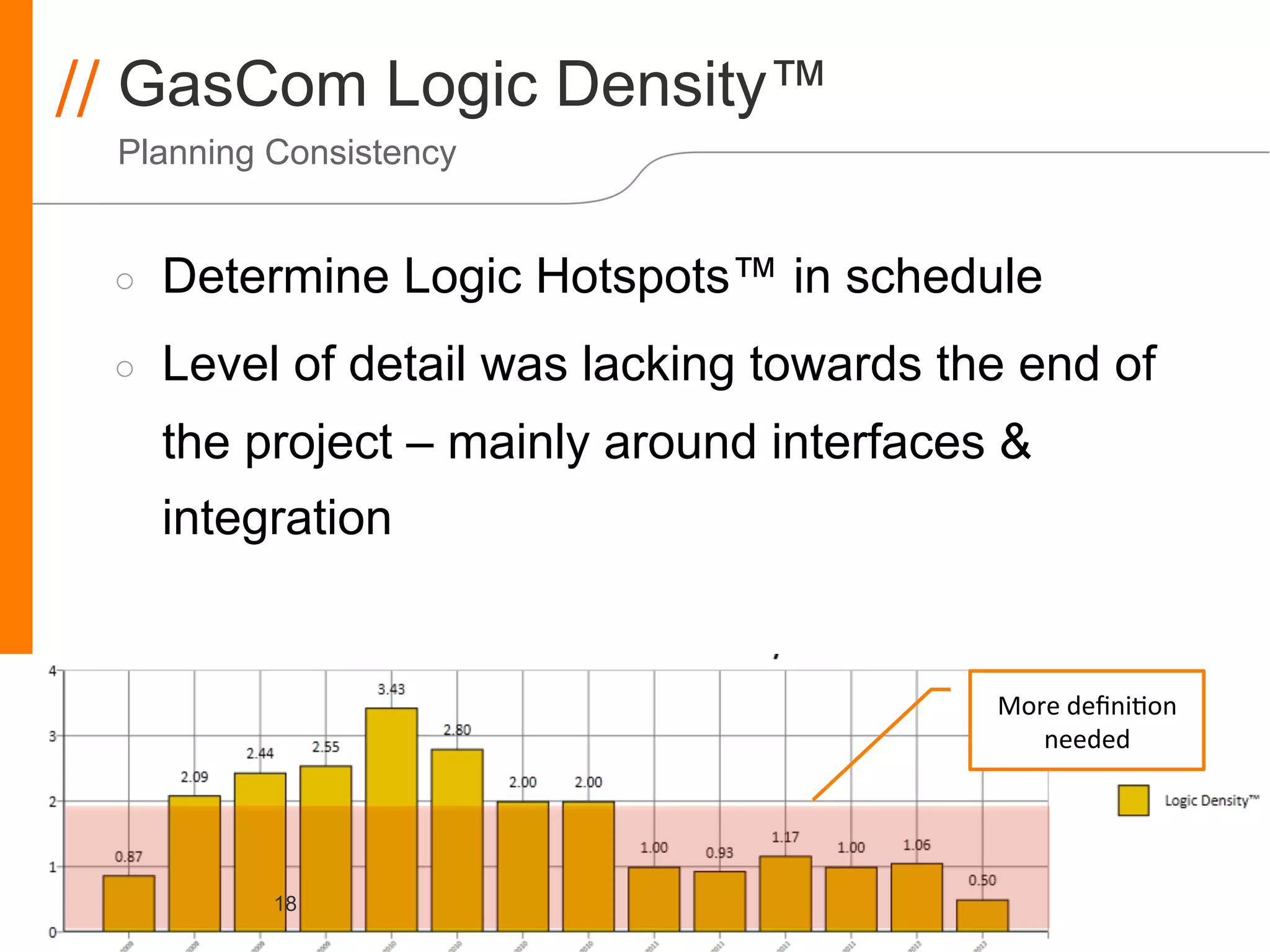

// GasCom Logic Density™
 Planning Consistency

 ◦    Determine Logic Hotspots™ in schedule
 ◦    Level of detail was lacking towards the end of
      the project – mainly around interfaces &
      integration

                                            More
  defini>on

                                               needed

        May 10, 2012
         // 18

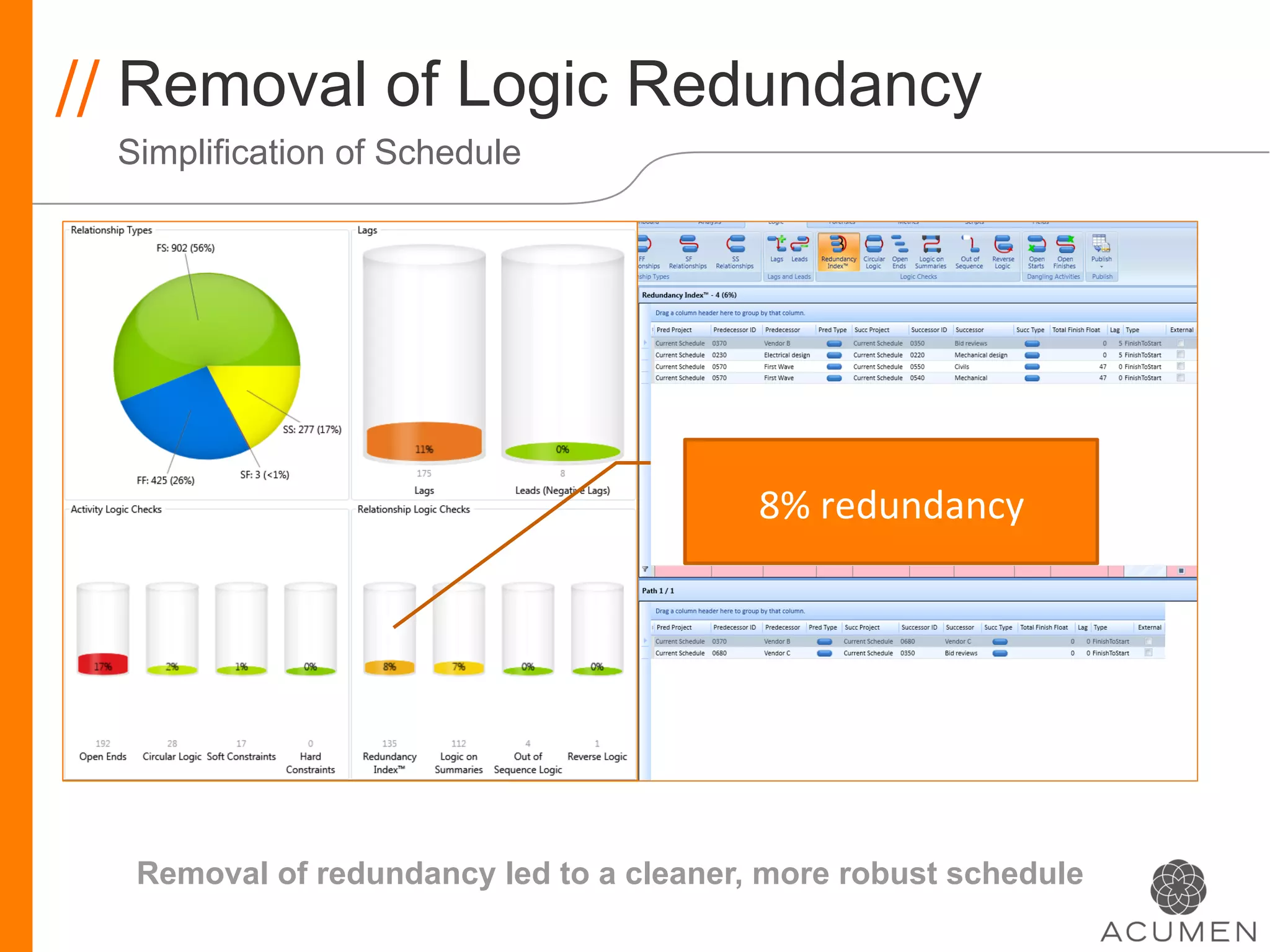

// Removal of Logic Redundancy
 Simplification of Schedule

                                         8%
  redundancy

  Removal of redundancy led to a cleaner, more robust schedule
        //

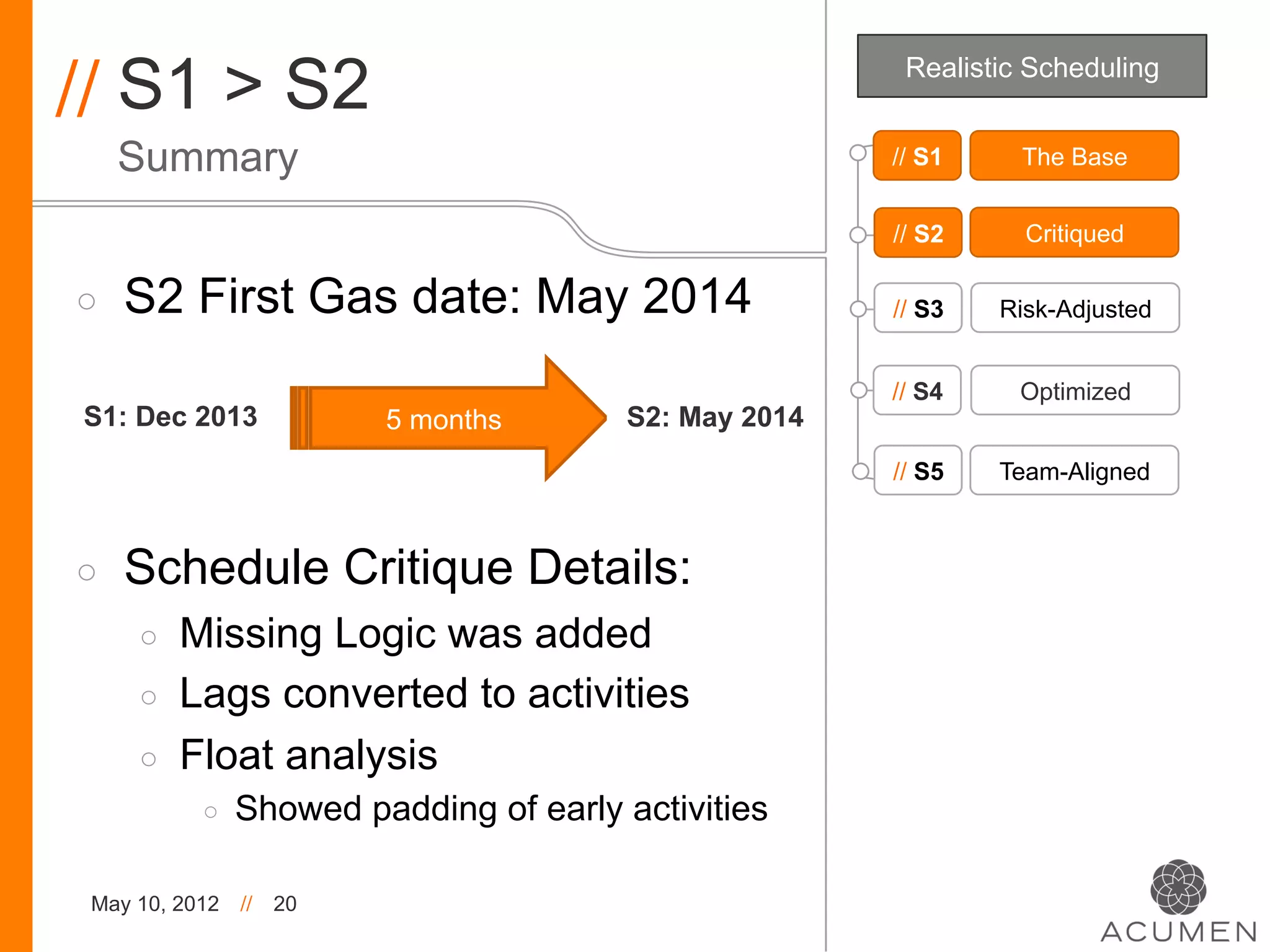

// S1 > S2
                                                        Realistic Scheduling

     Summary                                           // S1     The Base

                                                       // S2     Critiqued

◦    S2 First Gas date: May 2014                       // S3   Risk-Adjusted

                                                       // S4     Optimized
S1: Dec 2013              5 months      S2: May 2014
                                                       // S5   Team-Aligned

◦    Schedule Critique Details:
     ◦    Missing Logic was added
     ◦    Lags converted to activities
     ◦    Float analysis
           ◦    Showed padding of early activities

 May 10, 2012   //   20

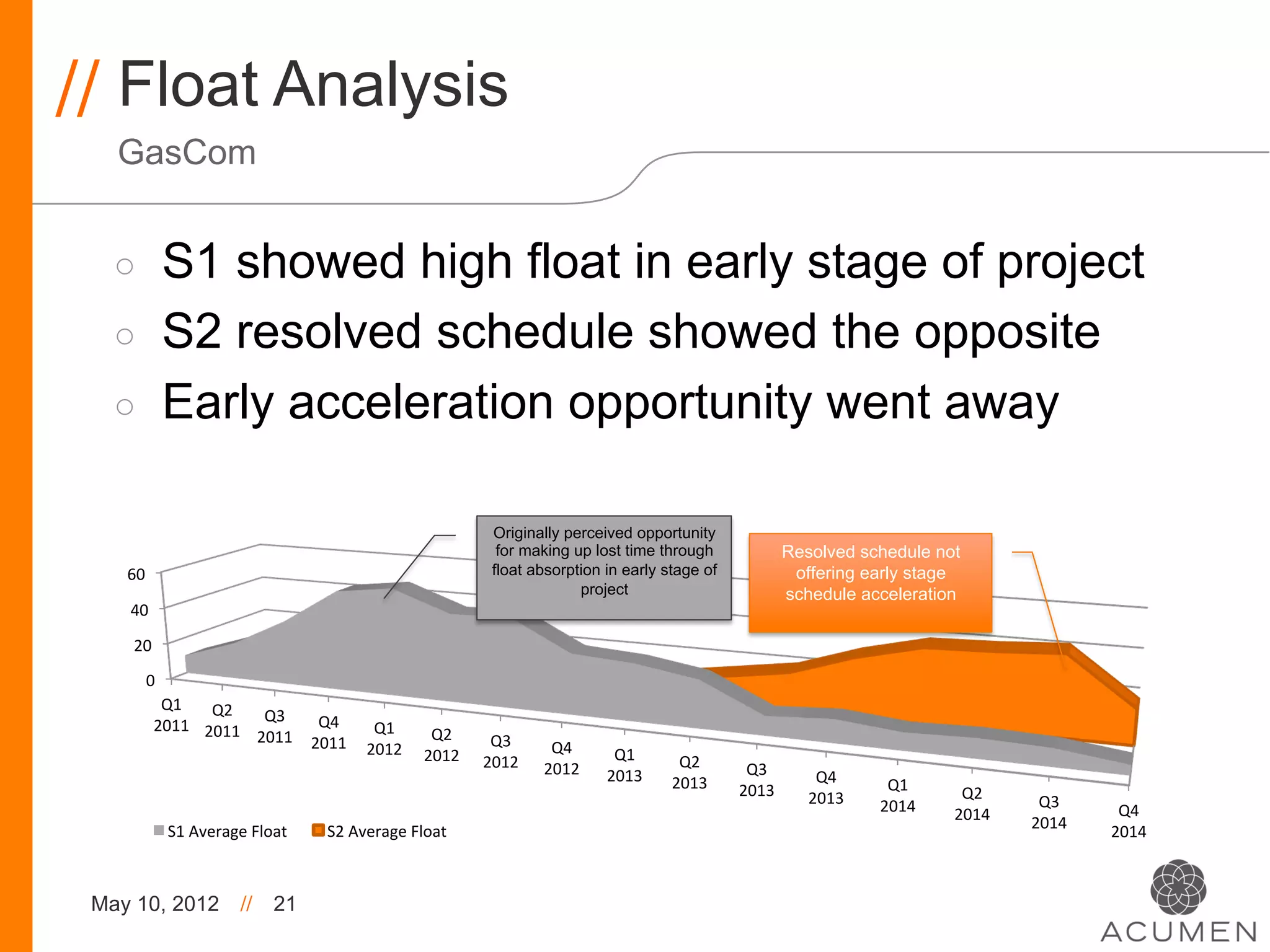

// Float Analysis
   GasCom

   ◦             S1 showed high float in early stage of project
   ◦             S2 resolved schedule showed the opposite
   ◦             Early acceleration opportunity went away

                                                                            Originally perceived opportunity
                                                                             for making up lost time through                      Resolved schedule not
    60
                                                                    float absorption in early stage of                     offering early stage
                                                                                         project                                  schedule acceleration
    40

     20

         0

              Q1
   Q2

                                Q3
     Q4

             2011
   2011
                      Q1
     Q2

                               2011
   2011
                              Q3

                                                 2012
   2012
                       Q4
       Q1

                                                                           2012
     2012
                 Q2
       Q3

                                                                                                 2013
     2013
                    Q4

                                                                                                                       2013
                    Q1
       Q2

                                                                                                                                     2013
     2014
                 Q3

                                                                                                                                                           2014
                 Q4

                 S1
  Average
  Float
     S2
  Average
  Float
                                                                                                2014

                                                                                                                                                                                 2014

 May 10, 2012                   //     21

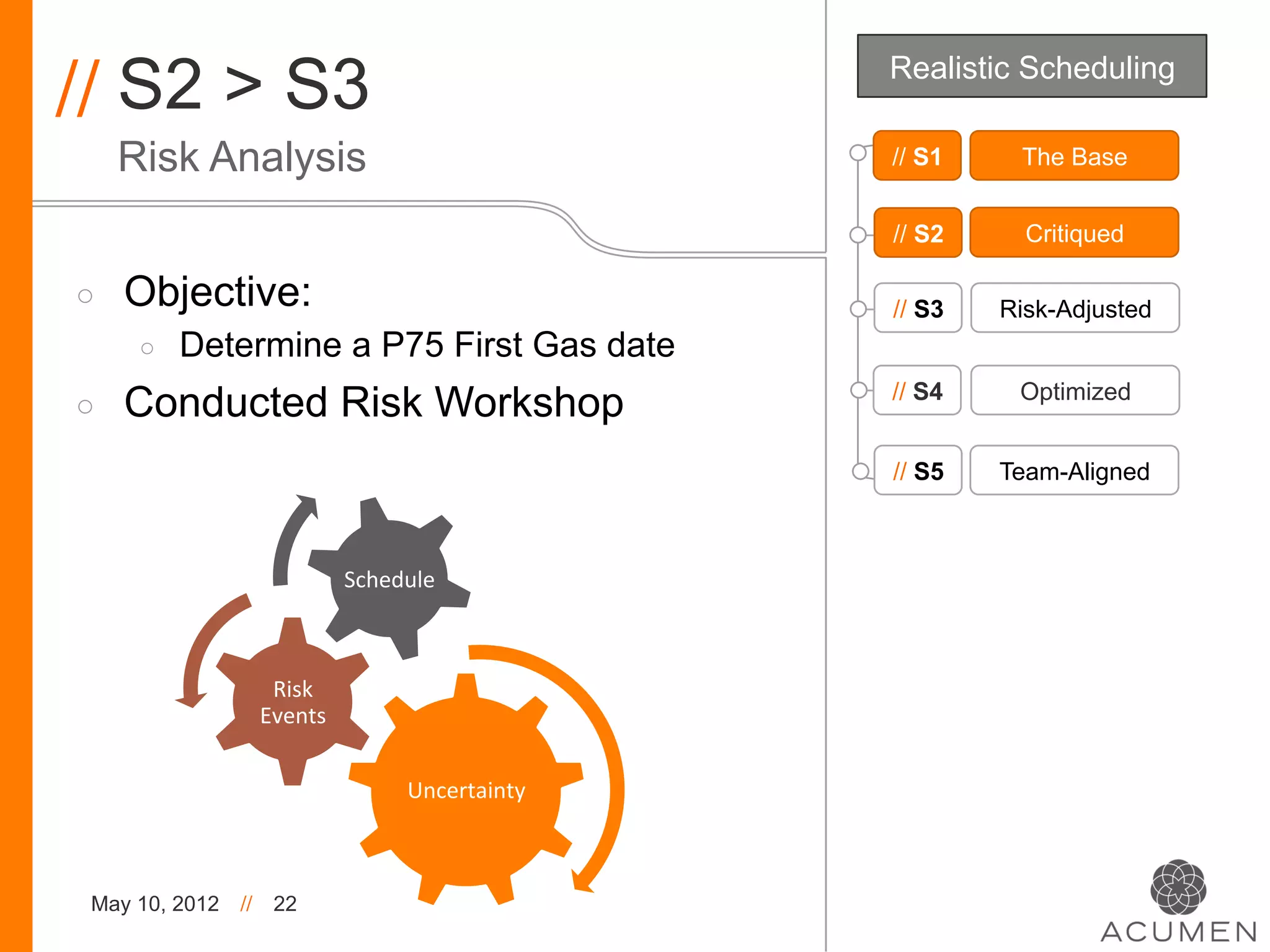

// S2 > S3                                                 Realistic Scheduling

     Risk Analysis                                         // S1    The Base

                                                           // S2     Critiqued

◦    Objective:                                            // S3   Risk-Adjusted
      ◦    Determine a P75 First Gas date
                                                           // S4    Optimized
◦    Conducted Risk Workshop
                                                           // S5   Team-Aligned

                                  Schedule

                      Risk

                     Events

                                         Uncertainty

 May 10, 2012   //    22

// GasCom Perception of Risk Exposure
    Risk Inputs & Outputs

 Uncertainty Factor         Best Case (Optimistic)                 Worst Case (Pessimistic)
 Very Conservative                    50%                                   100%
 Conservative                         75%                                   105%
 Realistic                            90%                                   110%
 Aggressive                           95%                                   125%
 Very Aggressive                     100%                                   150%

 70%

 60%
                            Team
  Percep>on

 50%
                            Actual
  Risk
  Hotspots

 40%

 30%

 20%

 10%

  0%

 May 10, 2012   //   23
//

 May 10, 2012   //   24

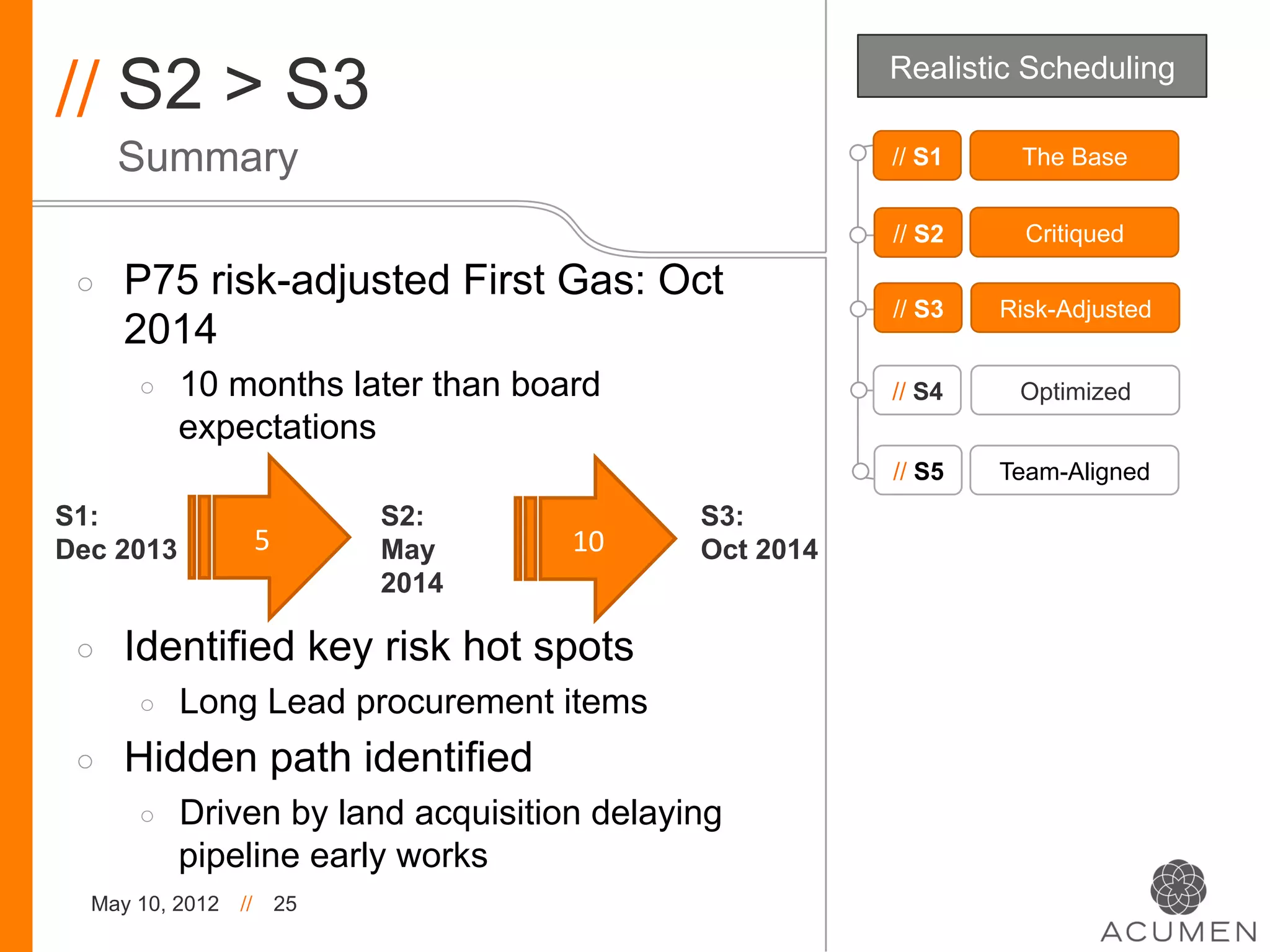

// S2 > S3                                                Realistic Scheduling

      Summary                                             // S1    The Base

                                                          // S2     Critiqued

 ◦    P75 risk-adjusted First Gas: Oct
                                                          // S3   Risk-Adjusted
      2014
      ◦    10 months later than board                     // S4    Optimized
           expectations
                                                          // S5   Team-Aligned
S1:                            S2:             S3:
Dec 2013              5
      May    10
     Oct 2014
                               2014

 ◦    Identified key risk hot spots
      ◦    Long Lead procurement items
 ◦    Hidden path identified
      ◦    Driven by land acquisition delaying
           pipeline early works
  May 10, 2012   //       25

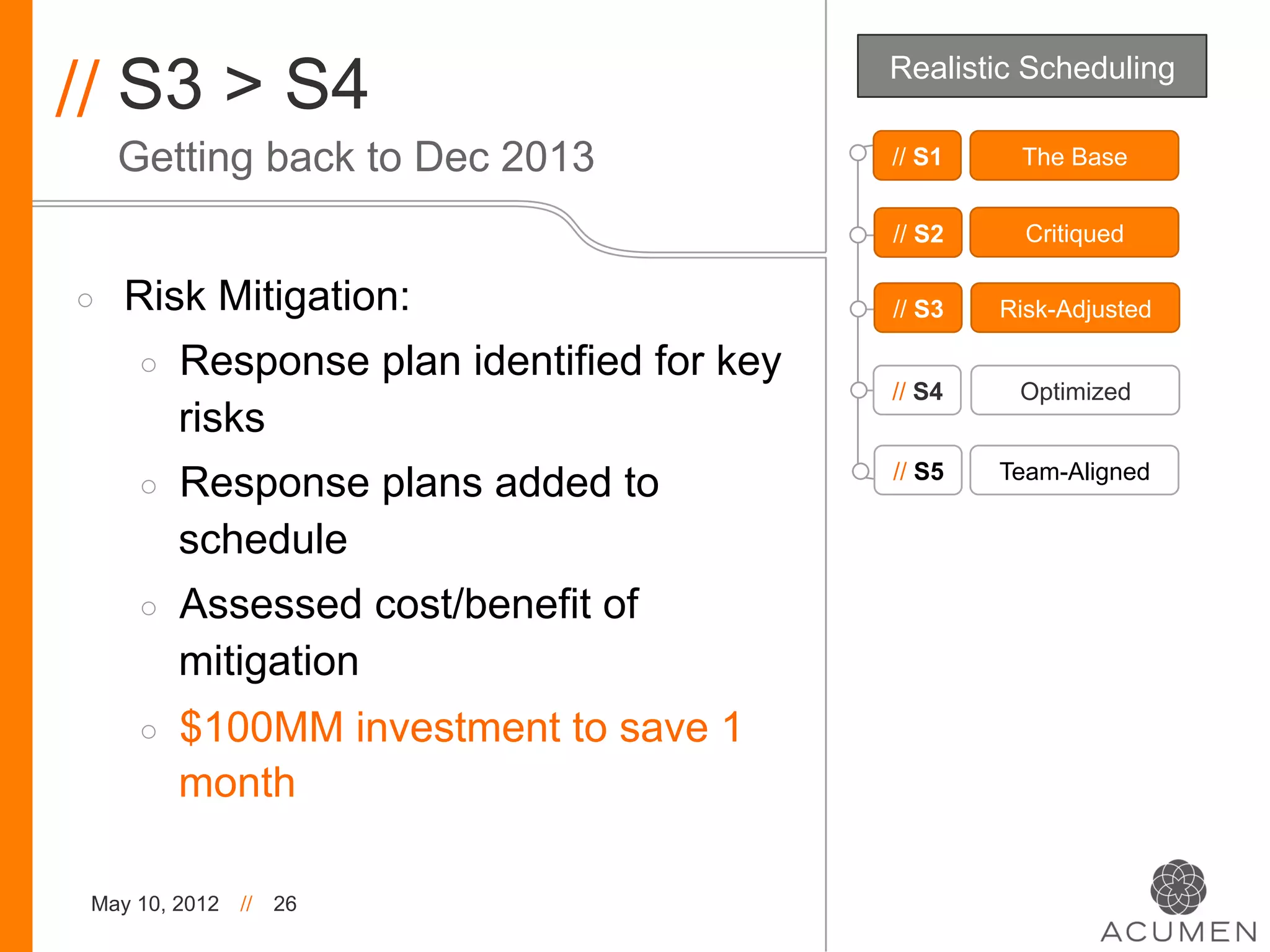

// S3 > S4                                    Realistic Scheduling

     Getting back to Dec 2013                 // S1    The Base

                                              // S2     Critiqued

◦    Risk Mitigation:                         // S3   Risk-Adjusted

      ◦    Response plan identified for key
                                              // S4    Optimized
           risks
                                              // S5   Team-Aligned
      ◦    Response plans added to
           schedule
      ◦    Assessed cost/benefit of
           mitigation
      ◦    $100MM investment to save 1
           month

 May 10, 2012   //   26

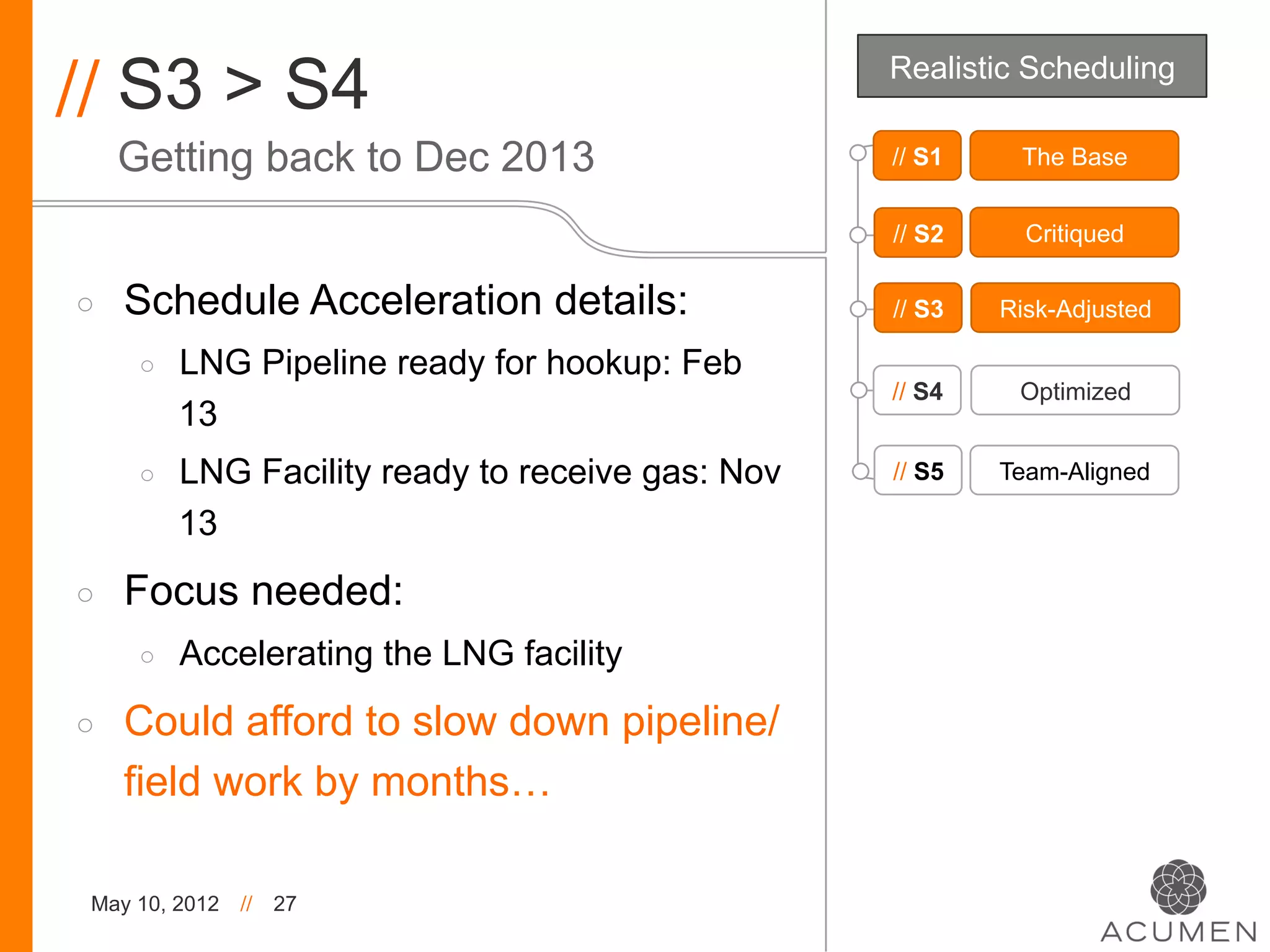

// S3 > S4                                          Realistic Scheduling

     Getting back to Dec 2013                       // S1    The Base

                                                    // S2     Critiqued

◦    Schedule Acceleration details:                 // S3   Risk-Adjusted

      ◦    LNG Pipeline ready for hookup: Feb
                                                    // S4    Optimized
           13
      ◦    LNG Facility ready to receive gas: Nov   // S5   Team-Aligned

           13
◦    Focus needed:
      ◦    Accelerating the LNG facility
◦    Could afford to slow down pipeline/
     field work by months…

 May 10, 2012   //   27

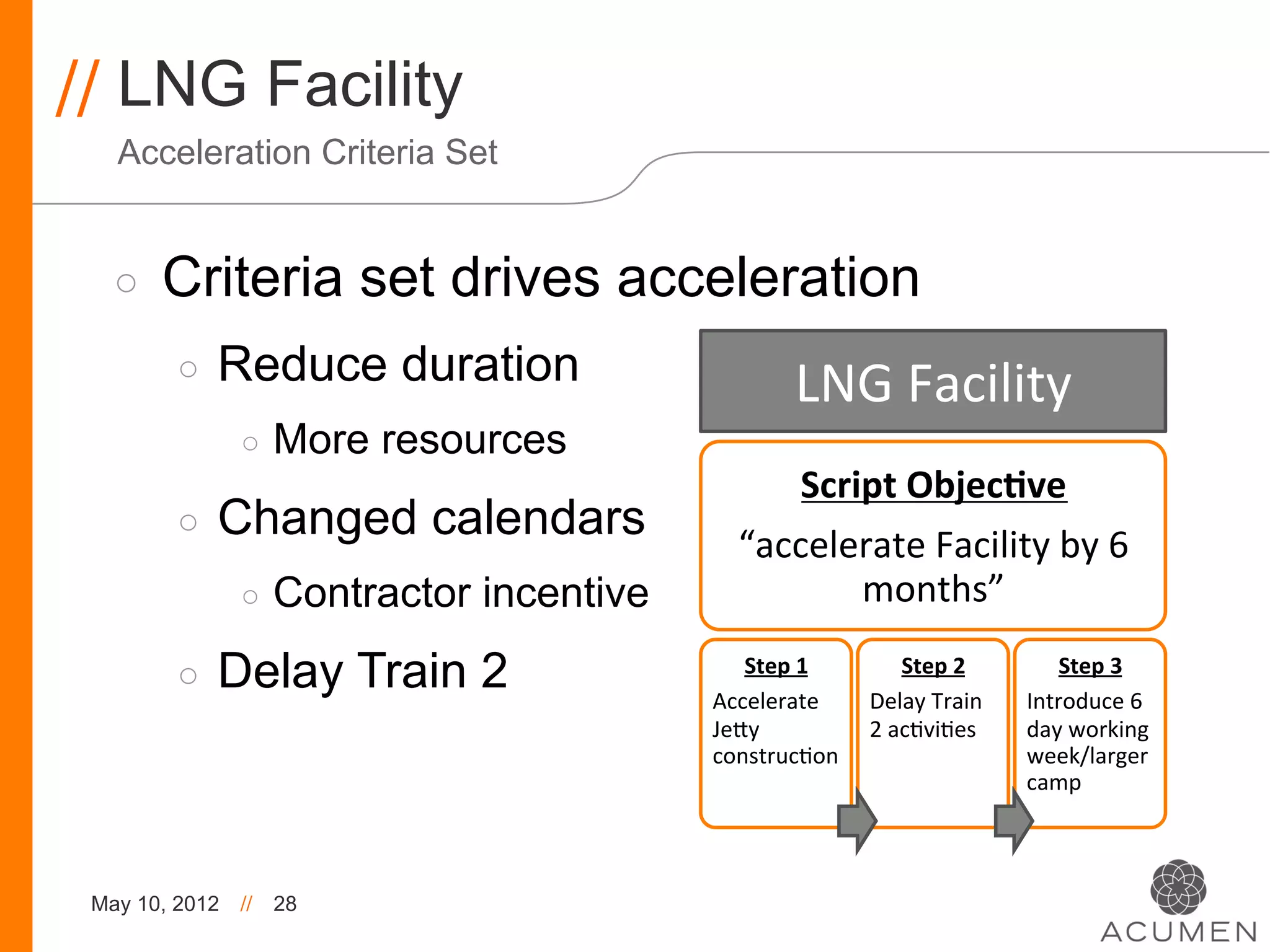

// LNG Facility
   Acceleration Criteria Set

   ◦    Criteria set drives acceleration
         ◦    Reduce duration                         LNG
  Facility

                ◦  More   resources
                                                   Script
  Objec/ve

         ◦    Changed calendars                “accelerate
  Facility
  by
  6

                ◦  Contractor   incentive              months”

         ◦    Delay Train 2                    Step
  1

                                            Accelerate

                                                                     Step
  2

                                                               Delay
  Train

                                                                                         Step
  3

                                                                                     Introduce
  6

                                            Jefy
             2
  ac>vi>es
       day
  working

                                            construc>on
                            week/larger

                                                                                     camp

 May 10, 2012   //   28

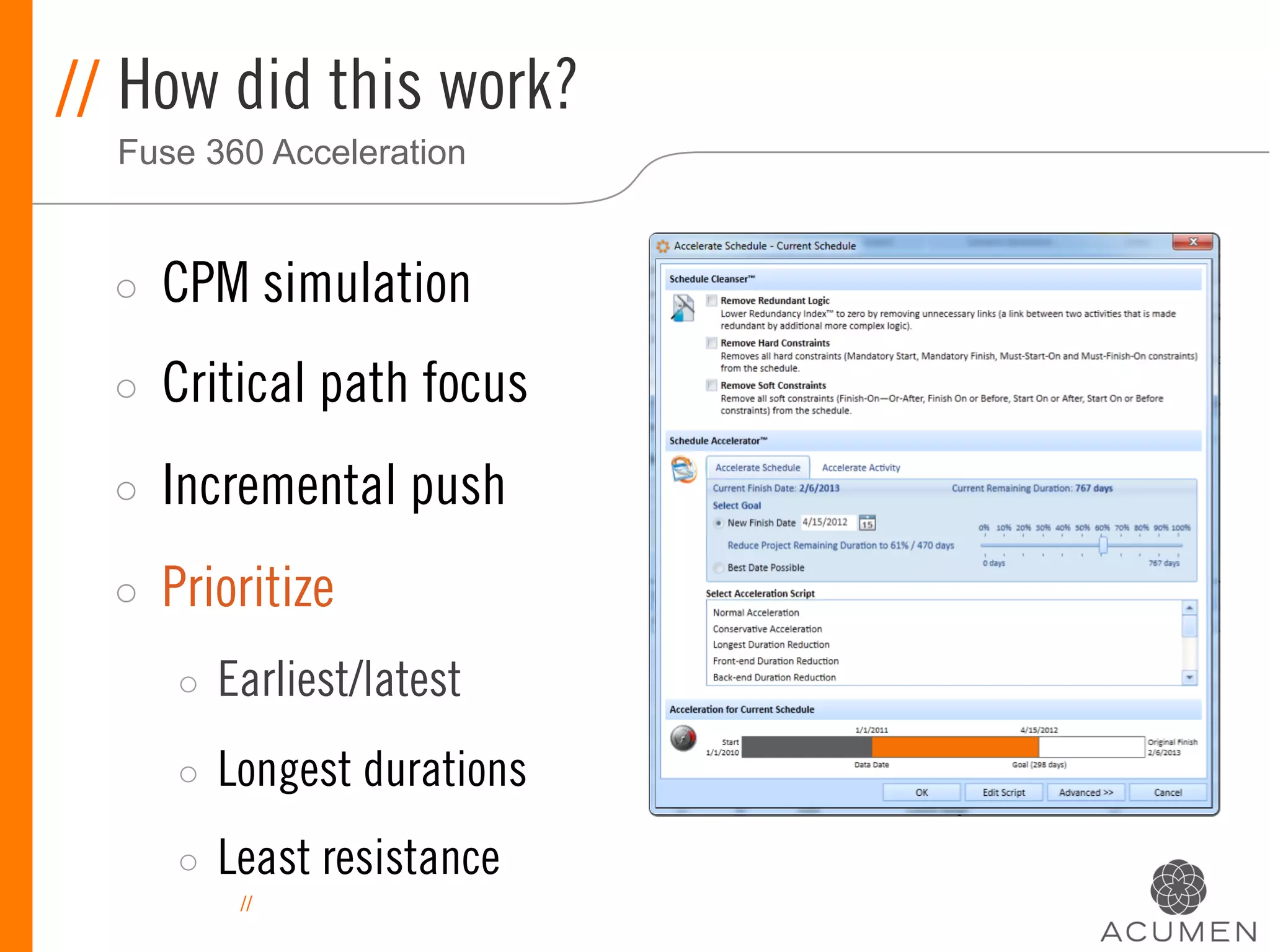

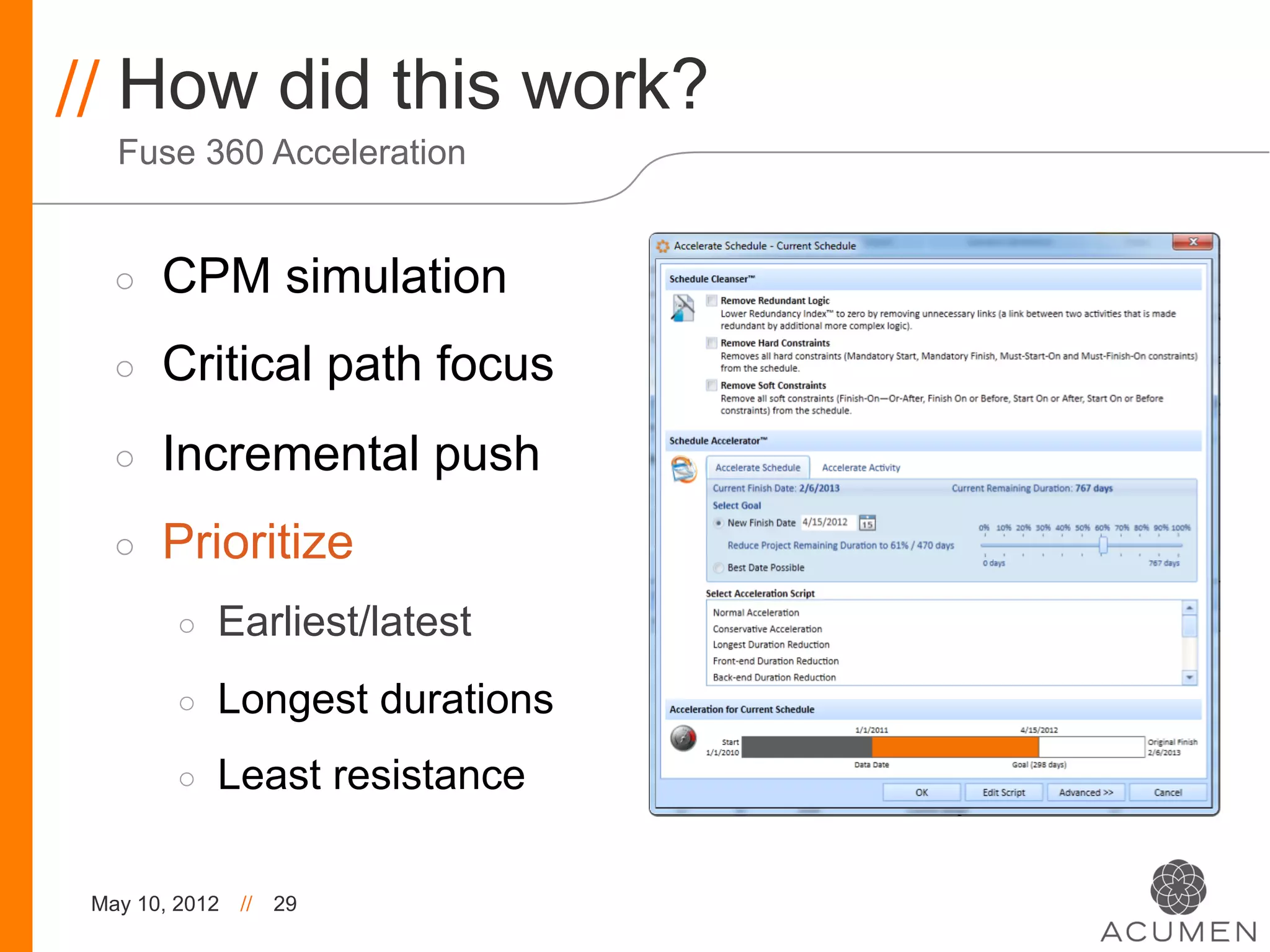

// How did this work?
   Fuse 360 Acceleration

   ◦    CPM simulation
   ◦    Critical path focus
   ◦    Incremental push
   ◦    Prioritize
         ◦    Earliest/latest
         ◦    Longest durations
         ◦    Least resistance

 May 10, 2012   //   29

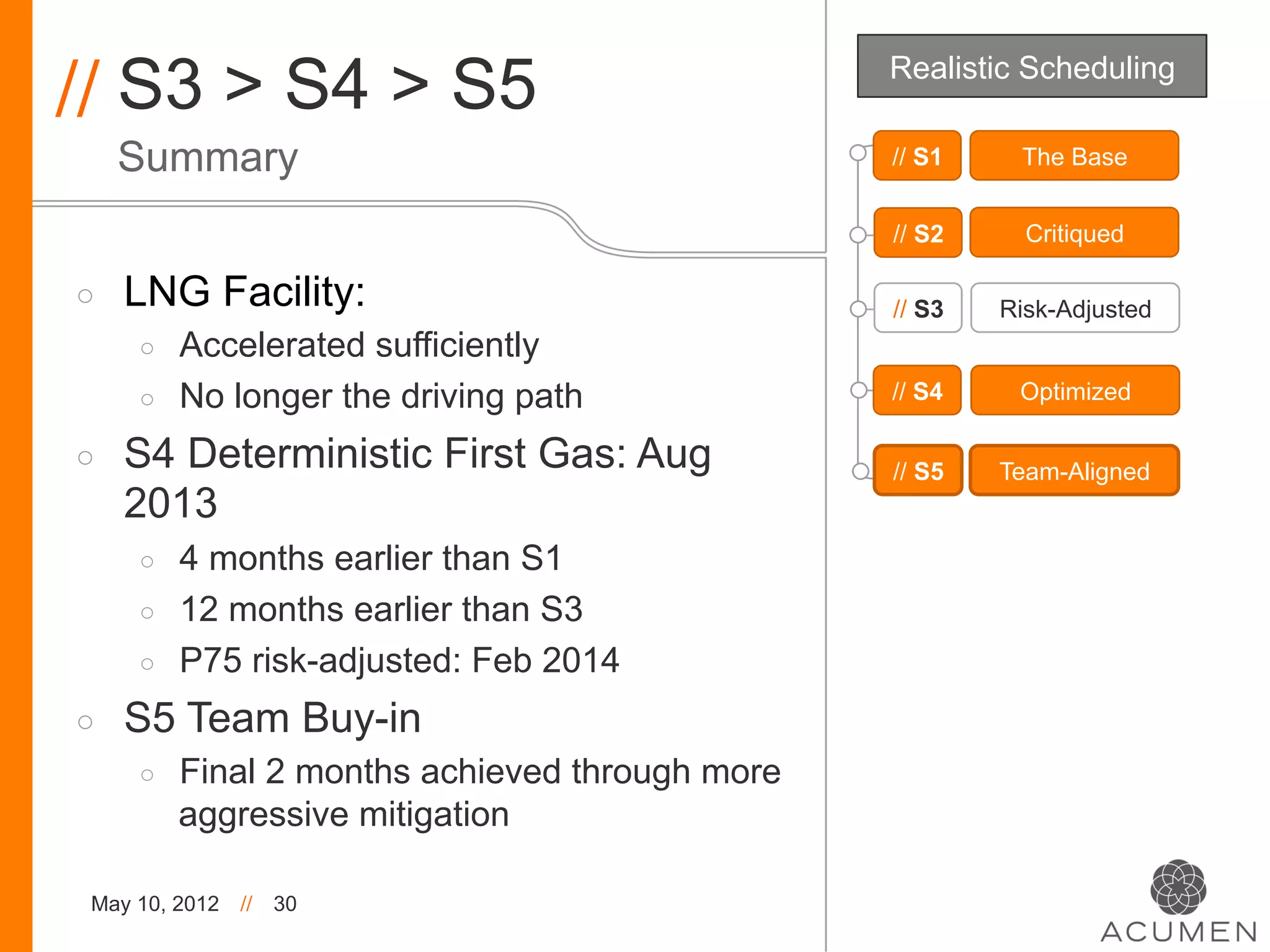

// S3 > S4 > S5                                  Realistic Scheduling

     Summary                                     // S1    The Base

                                                 // S2     Critiqued

◦    LNG Facility:                               // S3   Risk-Adjusted
     ◦    Accelerated sufficiently
     ◦    No longer the driving path             // S4    Optimized

◦    S4 Deterministic First Gas: Aug             // S5   Team-Aligned
     2013
     ◦    4 months earlier than S1
     ◦    12 months earlier than S3
     ◦    P75 risk-adjusted: Feb 2014
◦    S5 Team Buy-in
     ◦    Final 2 months achieved through more
          aggressive mitigation

 May 10, 2012   //   30

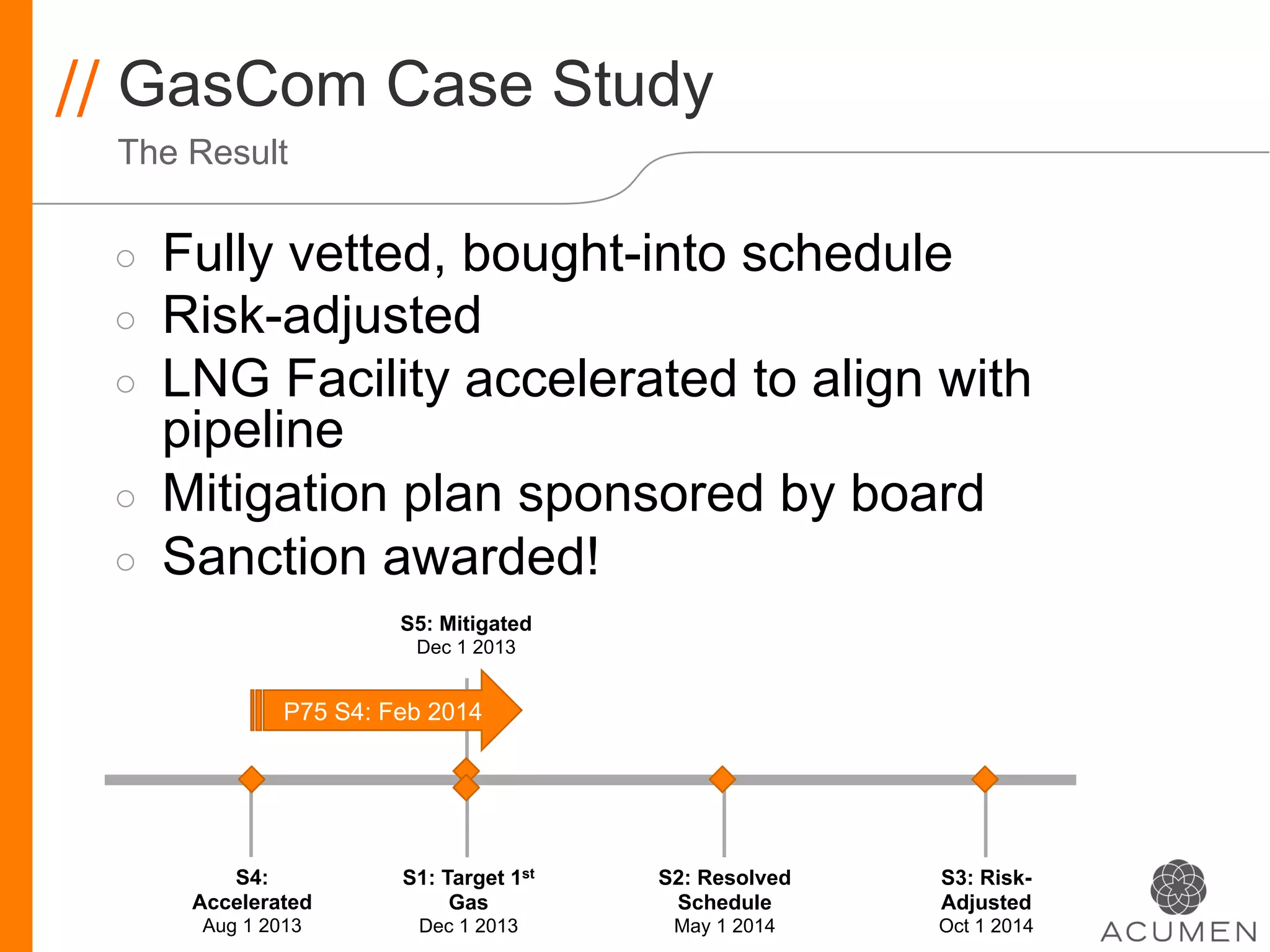

// GasCom Case Study
 The Result

 ◦    Fully vetted, bought-into schedule
 ◦    Risk-adjusted
 ◦    LNG Facility accelerated to align with
      pipeline
 ◦    Mitigation plan sponsored by board
 ◦    Sanction awarded!
                        S5: Mitigated
                         Dec 1 2013

               P75 S4: Feb 2014

          S4:           S1: Target 1st   S2: Resolved   S3: Risk-
       Accelerated
           //                Gas          Schedule      Adjusted
       Aug 1 2013        Dec 1 2013       May 1 2014    Oct 1 2014
// How did this work?
  Fuse 360 Acceleration

  ◦    CPM simulation
  ◦    Critical path focus
  ◦    Incremental push
  ◦    Prioritize
       ◦    Earliest/latest
       ◦    Longest durations
       ◦    Least resistance
             //
// Acceleration Efficiency™
  Measure of Acceleration Effort

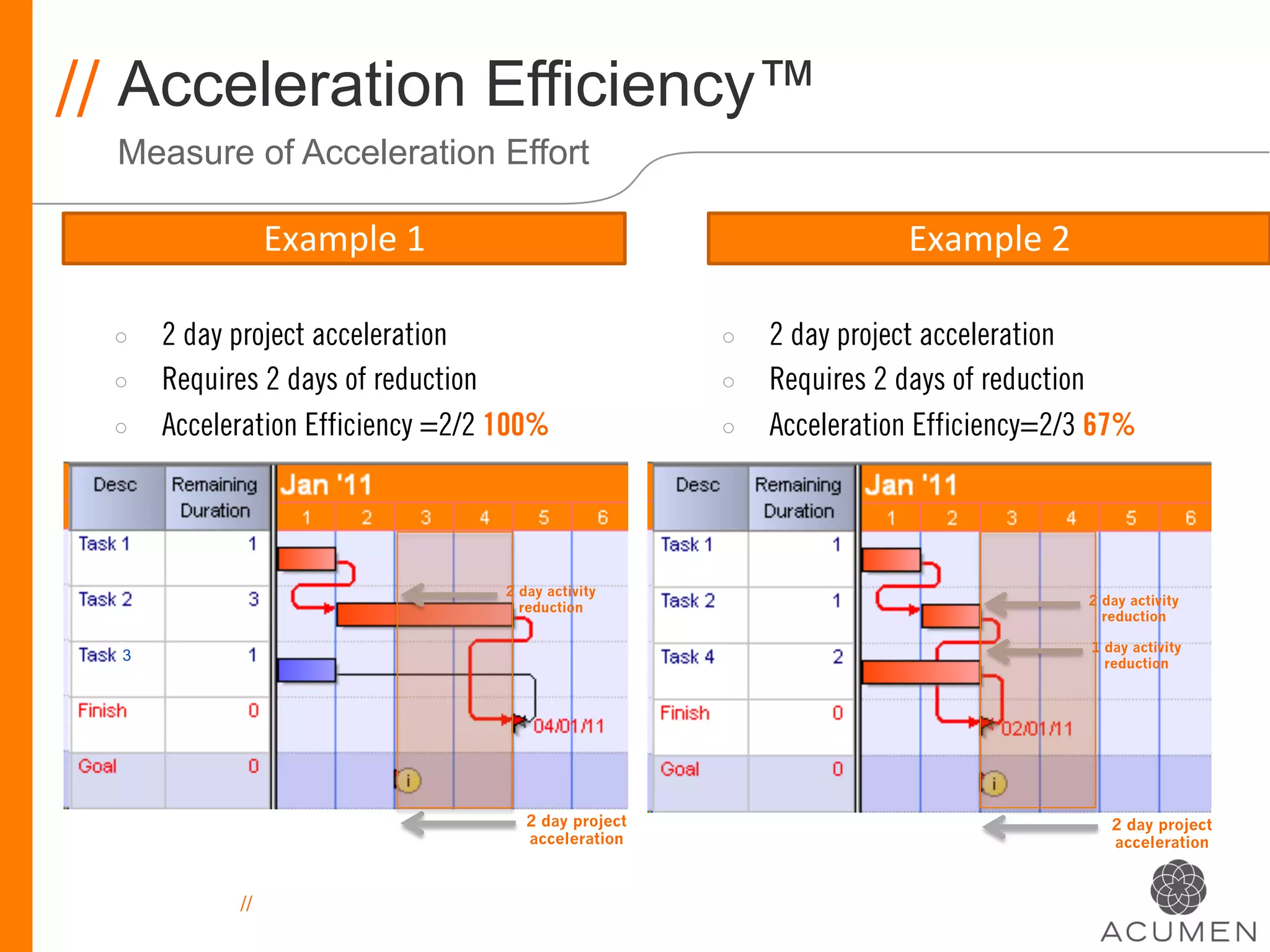

                  Example
  1
                                        Example
  2

  ◦    2 day project acceleration                       ◦    2 day project acceleration
  ◦    Requires 2 days of reduction                     ◦    Requires 2 days of reduction
  ◦    Acceleration Efficiency =2/2 100%                ◦    Acceleration Efficiency=2/3 67%

                                     2 day activity
                                       reduction                                           2 day activity
                                                                                             reduction

                                                                                           1 day activity
  3                                                                                          reduction

                                        2 day project                                         2 day project
                                        acceleration                                          acceleration

             //
// Q&A

     //
More information:
     White papers: www.projectacumen.com
     Software Trial: www.projectacumen.com/trial
//   Twitter: @projectacumen
     Email: info@projectacumen.com

           //

Meet or Exceed Schedule Expectations through Intelligent Acceleration

  • 1.
    Meet or ExceedSchedule Expectations through // Intelligent Acceleration Dr. Dan Patterson PMP// CEO Acumen May 7 2012 //
  • 2.
    // Acumen Realistic Scheduling Proven Project Analytics // S1 The Base // S2 Critiqued ◦  Project Management Software // S3 Risk-Adjusted ◦  Oracle Primavera partner // S4 Optimized ◦  Insight into challenges & use of // S5 Team-Aligned analytics to overcome them Product Offerings ◦  Core Concepts: 1.  Project success requires a sound plan Acumen Fuse® 2.  Forecast accuracy requires risk Risk Workshops consideration Software Training May 10, 2012 // 2
  • 3.
    // Schedule MaturityFramework Acumen S1//S5 6   •  Schedule  Basis    S1   •  Owner/contractor  schedule   5   •  Cri/qued  Schedule   S2   •  Ensure  structural  integrity   4   Chance  of  Sucess   •  Risk-­‐Adjusted  Schedule   3   S3   •  Account  for  risk/uncertainty   2   •  Op/mized  Target  Scenarios   S4   •  Schedule  accelera>on   1   •  Team  Validated  Scenario   0   0   1   2   3   4   5   6   S5   •  Buy-­‐in  on  op>miza>on   Maturity  Level   Measure quality through the Fuse Schedule Index™ May 10, 2012 // 3
  • 4.
    // Schedule QualityMeasurement Metric Analysis ◦  Legacy ◦  duration, constraints, excessive lags, negative float ◦  Industry Standards ◦  DCMA 14 Point Assessment ◦  NDIA GASP/ GAO ◦  Acumen Metrics ◦  Logic Density™ ◦  Insufficient Detail™ May 10, 2012 // 4
  • 5.
    // Acumen ScheduleMetrics Advanced Project Insight Finish   Insufficient   Logic   Logic   Compliance™   Detail™   Density™   Hotspot™   • Accurate   • Ac>vity  V   • Measure  of   • Timely  start?   measure  of   project  dura>on   complexity/ performance   completeness   Milestone   Broad  Risk   Float  Ra>o™   Redundancy   Ra>o™   Range   • Degree  of   Index™   • Detail  V   • Check  for   flexibility  per   • Non-­‐needed   repor>ng   erroneous  risk   day  of  work   logic   input   //
  • 6.
    // Schedule Index™ Measure of Quality May 10, 2012 // 6
  • 7.
    // Measuring ProjectPerformance Baseline Compliance™ ◦  Traditional measures include: ◦  Earned value: heavy time investment to implement ◦  Earned schedule: similar to EV ◦  % complete: what does this really tell us? ◦  Ahead/behind baseline: too granular a scale… ◦  Baseline Compliance™ ◦  Determine how close schedule is executed against baseline ◦  Measure of change during planning phase ◦  Measure of well the plan is being executed ◦  More than just date comparison ◦  Looks at period-compliance May 10, 2012 //
  • 8.
    // Baseline ComplianceIndex™ Examines  how   many  ac>vi>es   fell  within  the   expected   repor>ng  period   //
  • 9.
  • 10.
    // Finish ComplianceIndex™ 100%   80%   60%   40%   20%   0%   May 10, 2012 //
  • 11.
    // //
  • 12.
    // Quality PlanningTruly Drives Success 100%   Probability of On-Time Completion 90%   80%   70%   60%   50%   40%   30%   20%   10%   0%   0%   10%   20%   30%   40%   50%   60%   70%   80%   90%   100%   Fuse Schedule Index™ May 10, 2012 // 12
  • 13.
    Case Study // AcumenFuse® Software Demonstration //
  • 14.
    // Case Study Owner/contractor Alignment •  Houston-based oil/gas owner •  Objective: •  More on-time completion for projects over $250MM •  Encourage more mature contractor schedules •  Overcome “brain drain” in scheduling •  How achieved: •  Mandated contractor Fuse Schedule Index of 75+ •  Gave contractor opportunity to self-assess //
  • 15.
    // Case Study Realistic Scheduling Schedule Acceleration/Risk Reduction // S1 The Base // S2 Critiqued ◦  GasCom // S3 Risk-Adjusted ◦  LNG Pipeline & Facility Owner // S4 Optimized ◦  Early FEED stage // S5 Team-Aligned ◦  Project Details ◦  Readying for sanction approval ◦  Expected First Gas Date: Dec. 2013 ◦  Gas sales contract already established ◦  Using Primavera P6 May 10, 2012 // 15
  • 16.
    // S1 >S2 Realistic Scheduling Schedule Review // S1 The Base // S2 Critiqued ◦  Sanction Board Requirements // S3 Risk-Adjusted ◦  Risk-adjusted forecast P75 // S4 Optimized ◦  Fuse Schedule Index 75+ // S5 Team-Aligned ◦  Project Status ◦  S1 showing Dec 13 first gas ◦  Risk assessment not yet conducted May 10, 2012 // 16
  • 17.
    // S1 >S2 Schedule Critique Sound Basis of Schedule ◦  Validated multiple sub-projects ◦  Test to ensure true path to First Gas ◦  Analysis showed break in path around Early Works ◦  Fixing this, First Gas moved to the right by 2 months ◦  Schedule cleanse: further 3 months adjustment May 10, 2012 // 17
  • 18.
    // GasCom LogicDensity™ Planning Consistency ◦  Determine Logic Hotspots™ in schedule ◦  Level of detail was lacking towards the end of the project – mainly around interfaces & integration More  defini>on   needed   May 10, 2012 // 18
  • 19.
    // Removal ofLogic Redundancy Simplification of Schedule 8%  redundancy   Removal of redundancy led to a cleaner, more robust schedule //
  • 20.
    // S1 >S2 Realistic Scheduling Summary // S1 The Base // S2 Critiqued ◦  S2 First Gas date: May 2014 // S3 Risk-Adjusted // S4 Optimized S1: Dec 2013 5 months S2: May 2014 // S5 Team-Aligned ◦  Schedule Critique Details: ◦  Missing Logic was added ◦  Lags converted to activities ◦  Float analysis ◦  Showed padding of early activities May 10, 2012 // 20
  • 21.
    // Float Analysis GasCom ◦  S1 showed high float in early stage of project ◦  S2 resolved schedule showed the opposite ◦  Early acceleration opportunity went away Originally perceived opportunity for making up lost time through Resolved schedule not 60   float absorption in early stage of offering early stage project schedule acceleration 40   20   0   Q1   Q2   Q3   Q4   2011   2011   Q1   Q2   2011   2011   Q3   2012   2012   Q4   Q1   2012   2012   Q2   Q3   2013   2013   Q4   2013   Q1   Q2   2013   2014   Q3   2014   Q4   S1  Average  Float   S2  Average  Float   2014   2014   May 10, 2012 // 21
  • 22.
    // S2 >S3 Realistic Scheduling Risk Analysis // S1 The Base // S2 Critiqued ◦  Objective: // S3 Risk-Adjusted ◦  Determine a P75 First Gas date // S4 Optimized ◦  Conducted Risk Workshop // S5 Team-Aligned Schedule   Risk   Events   Uncertainty   May 10, 2012 // 22
  • 23.
    // GasCom Perceptionof Risk Exposure Risk Inputs & Outputs Uncertainty Factor Best Case (Optimistic) Worst Case (Pessimistic) Very Conservative 50% 100% Conservative 75% 105% Realistic 90% 110% Aggressive 95% 125% Very Aggressive 100% 150% 70%   60%   Team  Percep>on   50%   Actual  Risk  Hotspots   40%   30%   20%   10%   0%   May 10, 2012 // 23
  • 24.
    // May 10,2012 // 24
  • 25.
    // S2 >S3 Realistic Scheduling Summary // S1 The Base // S2 Critiqued ◦  P75 risk-adjusted First Gas: Oct // S3 Risk-Adjusted 2014 ◦  10 months later than board // S4 Optimized expectations // S5 Team-Aligned S1: S2: S3: Dec 2013 5   May 10   Oct 2014 2014 ◦  Identified key risk hot spots ◦  Long Lead procurement items ◦  Hidden path identified ◦  Driven by land acquisition delaying pipeline early works May 10, 2012 // 25
  • 26.
    // S3 >S4 Realistic Scheduling Getting back to Dec 2013 // S1 The Base // S2 Critiqued ◦  Risk Mitigation: // S3 Risk-Adjusted ◦  Response plan identified for key // S4 Optimized risks // S5 Team-Aligned ◦  Response plans added to schedule ◦  Assessed cost/benefit of mitigation ◦  $100MM investment to save 1 month May 10, 2012 // 26
  • 27.
    // S3 >S4 Realistic Scheduling Getting back to Dec 2013 // S1 The Base // S2 Critiqued ◦  Schedule Acceleration details: // S3 Risk-Adjusted ◦  LNG Pipeline ready for hookup: Feb // S4 Optimized 13 ◦  LNG Facility ready to receive gas: Nov // S5 Team-Aligned 13 ◦  Focus needed: ◦  Accelerating the LNG facility ◦  Could afford to slow down pipeline/ field work by months… May 10, 2012 // 27
  • 28.
    // LNG Facility Acceleration Criteria Set ◦  Criteria set drives acceleration ◦  Reduce duration LNG  Facility   ◦  More resources Script  Objec/ve   ◦  Changed calendars “accelerate  Facility  by  6   ◦  Contractor incentive months”   ◦  Delay Train 2 Step  1   Accelerate   Step  2   Delay  Train   Step  3   Introduce  6   Jefy   2  ac>vi>es   day  working   construc>on   week/larger   camp   May 10, 2012 // 28
  • 29.
    // How didthis work? Fuse 360 Acceleration ◦  CPM simulation ◦  Critical path focus ◦  Incremental push ◦  Prioritize ◦  Earliest/latest ◦  Longest durations ◦  Least resistance May 10, 2012 // 29
  • 30.
    // S3 >S4 > S5 Realistic Scheduling Summary // S1 The Base // S2 Critiqued ◦  LNG Facility: // S3 Risk-Adjusted ◦  Accelerated sufficiently ◦  No longer the driving path // S4 Optimized ◦  S4 Deterministic First Gas: Aug // S5 Team-Aligned 2013 ◦  4 months earlier than S1 ◦  12 months earlier than S3 ◦  P75 risk-adjusted: Feb 2014 ◦  S5 Team Buy-in ◦  Final 2 months achieved through more aggressive mitigation May 10, 2012 // 30
  • 31.
    // GasCom CaseStudy The Result ◦  Fully vetted, bought-into schedule ◦  Risk-adjusted ◦  LNG Facility accelerated to align with pipeline ◦  Mitigation plan sponsored by board ◦  Sanction awarded! S5: Mitigated Dec 1 2013 P75 S4: Feb 2014 S4: S1: Target 1st S2: Resolved S3: Risk- Accelerated // Gas Schedule Adjusted Aug 1 2013 Dec 1 2013 May 1 2014 Oct 1 2014
  • 32.
    // How didthis work? Fuse 360 Acceleration ◦  CPM simulation ◦  Critical path focus ◦  Incremental push ◦  Prioritize ◦  Earliest/latest ◦  Longest durations ◦  Least resistance //
  • 33.
    // Acceleration Efficiency™ Measure of Acceleration Effort Example  1   Example  2   ◦  2 day project acceleration ◦  2 day project acceleration ◦  Requires 2 days of reduction ◦  Requires 2 days of reduction ◦  Acceleration Efficiency =2/2 100% ◦  Acceleration Efficiency=2/3 67% 2 day activity reduction 2 day activity reduction 1 day activity 3 reduction 2 day project 2 day project acceleration acceleration //
  • 34.
  • 35.
    More information: White papers: www.projectacumen.com Software Trial: www.projectacumen.com/trial // Twitter: @projectacumen Email: info@projectacumen.com //
