Improvements for
           Chowgule & Co. Ltd. – Shipbuilding
                       Division

Ambattuparambil Gopi Nikhil – 09NA1008

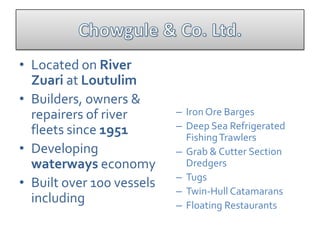

• Located on River
  Zuari at Loutulim
• Builders, owners &
  repairers of river       – Iron Ore Barges
  fleets since 1951        – Deep Sea Refrigerated
                             Fishing Trawlers
• Developing               – Grab & Cutter Section
  waterways economy          Dredgers
                           – Tugs
• Built over 100 vessels
                           – Twin-Hull Catamarans
  including                – Floating Restaurants
GOA




      River Zuari
• Construction Bays on either side of Slipway
• Main yard near Outfitting Jetty
• Ample amount of Skids for module assembly
  but scattered
• Distance between Stockyard & Main yard
• Space between Gate & Main Yard unutilized
  (trees?)

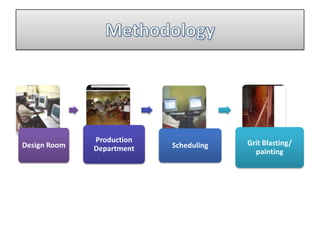

Production                Grit Blasting/
Design Room   Department   Scheduling
                                          painting

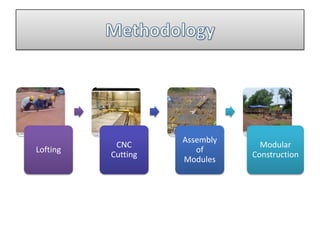

Assembly
           CNC                   Modular
Lofting                of
          Cutting              Construction
                    Modules
Survey   Movement   Launching   Sea Trials

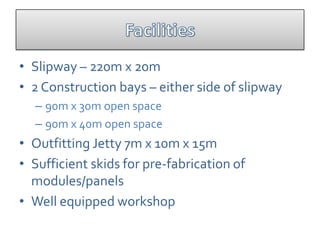

• Slipway – 220m x 20m
• 2 Construction bays – either side of slipway
  – 90m x 30m open space
  – 90m x 40m open space
• Outfitting Jetty 7m x 10m x 15m
• Sufficient skids for pre-fabrication of
  modules/panels
• Well equipped workshop

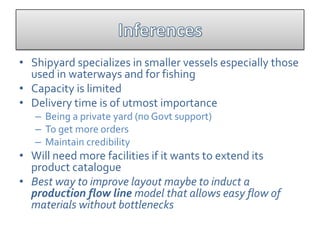

• Shipyard specializes in smaller vessels especially those
  used in waterways and for fishing
• Capacity is limited
• Delivery time is of utmost importance
   – Being a private yard (no Govt support)
   – To get more orders
   – Maintain credibility
• Will need more facilities if it wants to extend its
  product catalogue
• Best way to improve layout maybe to induct a
  production flow line model that allows easy flow of
  materials without bottlenecks

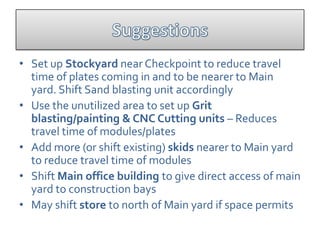

• Set up Stockyard near Checkpoint to reduce travel
  time of plates coming in and to be nearer to Main
  yard. Shift Sand blasting unit accordingly
• Use the unutilized area to set up Grit
  blasting/painting & CNC Cutting units – Reduces
  travel time of modules/plates
• Add more (or shift existing) skids nearer to Main yard
  to reduce travel time of modules
• Shift Main office building to give direct access of main
  yard to construction bays
• May shift store to north of Main yard if space permits
•   Faster production line
•   Lesser delivery time  more orders
•   Lower man-time requirement
•   Use of lifting equipment freed for better
    purposes (due to lower amount of shifting of
    modules & panels)
• Cannot increase production too much due to
  space constraints
• Lack of dry dock reduces capability for
  advanced outfitting
09NA1008
