Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control

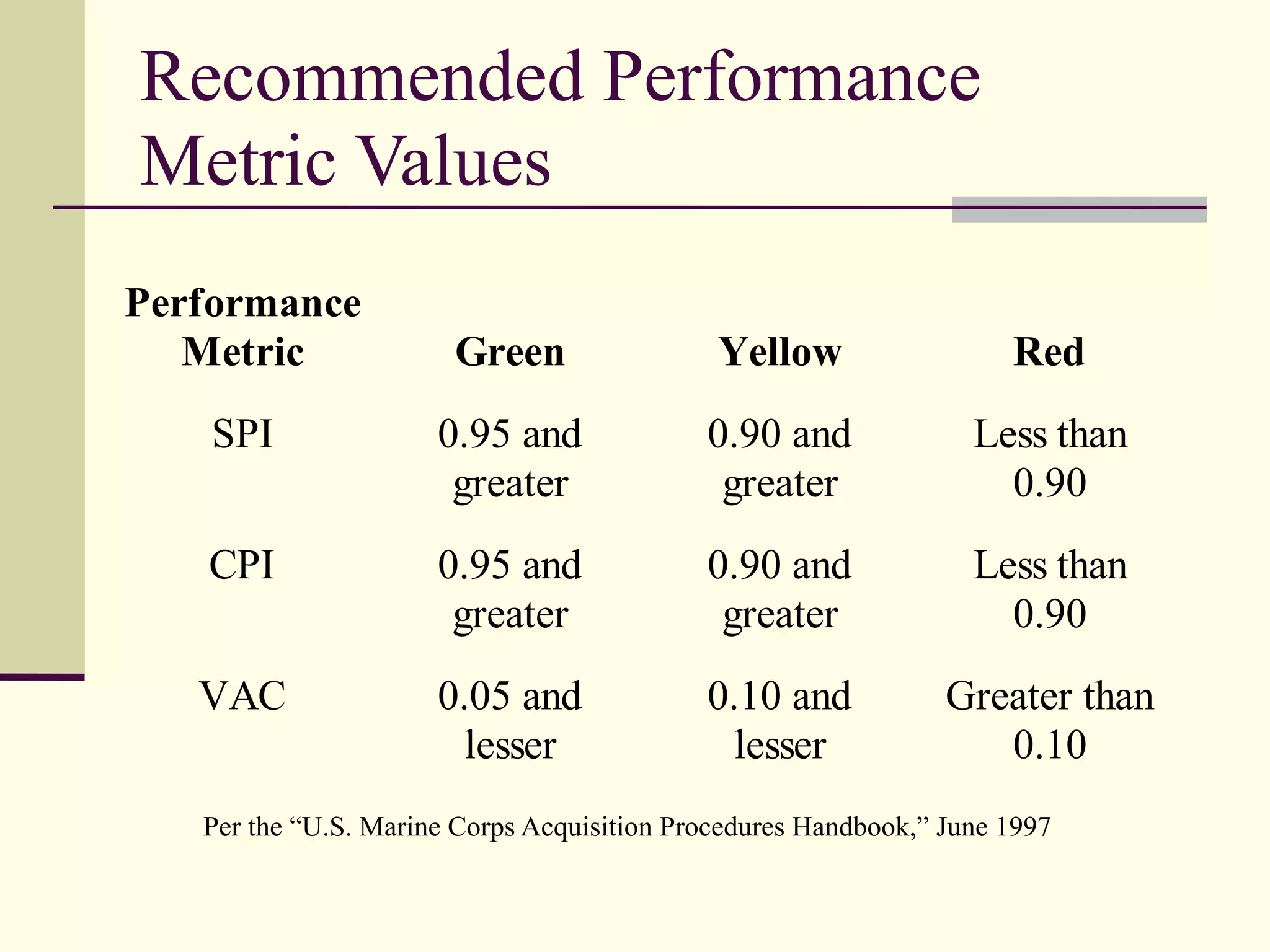

Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control
Project Monitoring and Control

Editor's Notes

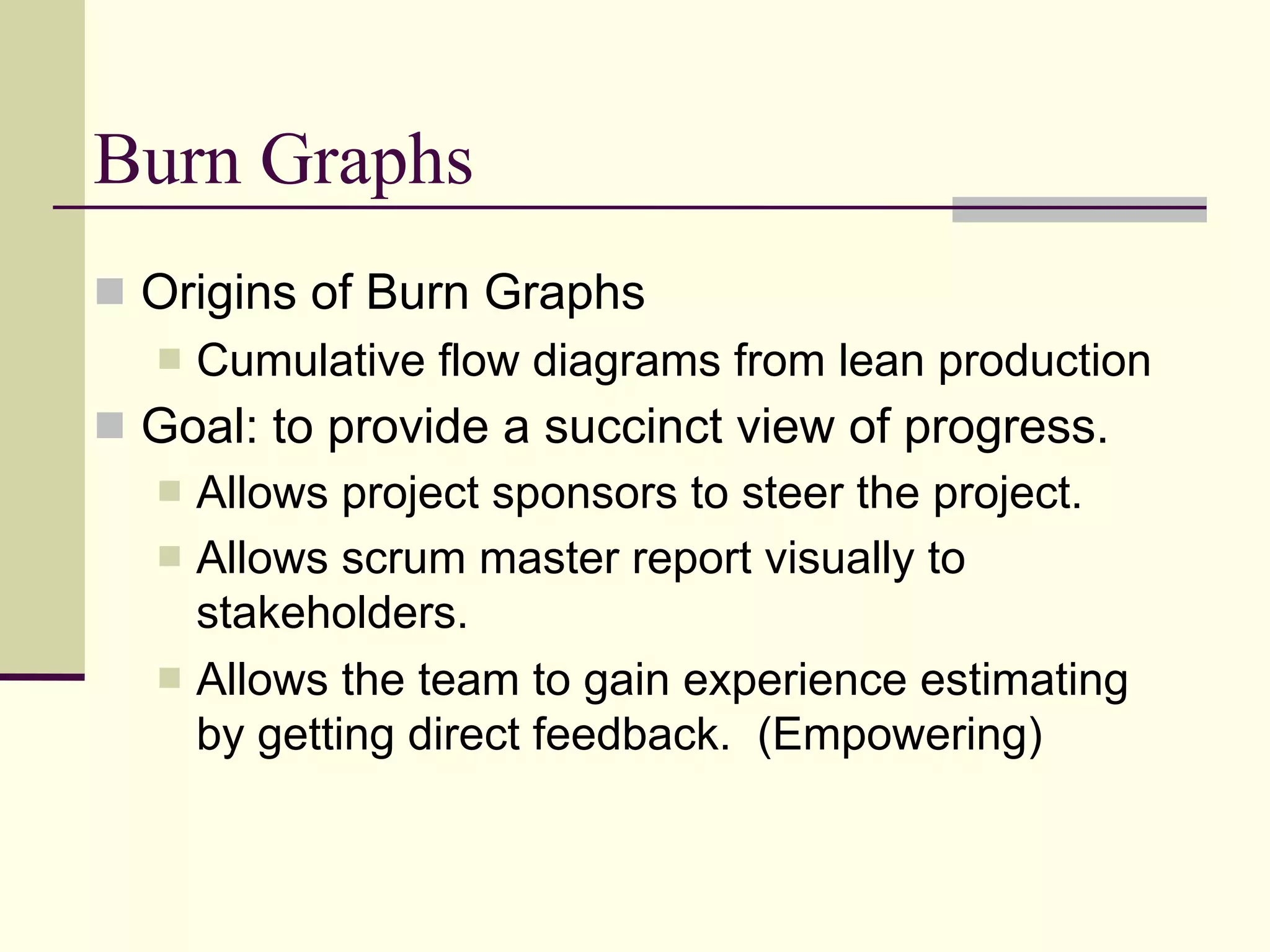

  • #29 Lean production is a manufacturing process developed at Toyota. Focuses on responding to change to minimize inefficiency. Does not center on long-term planning. (1970s and 1980s) There is a “Lean Software Development” process

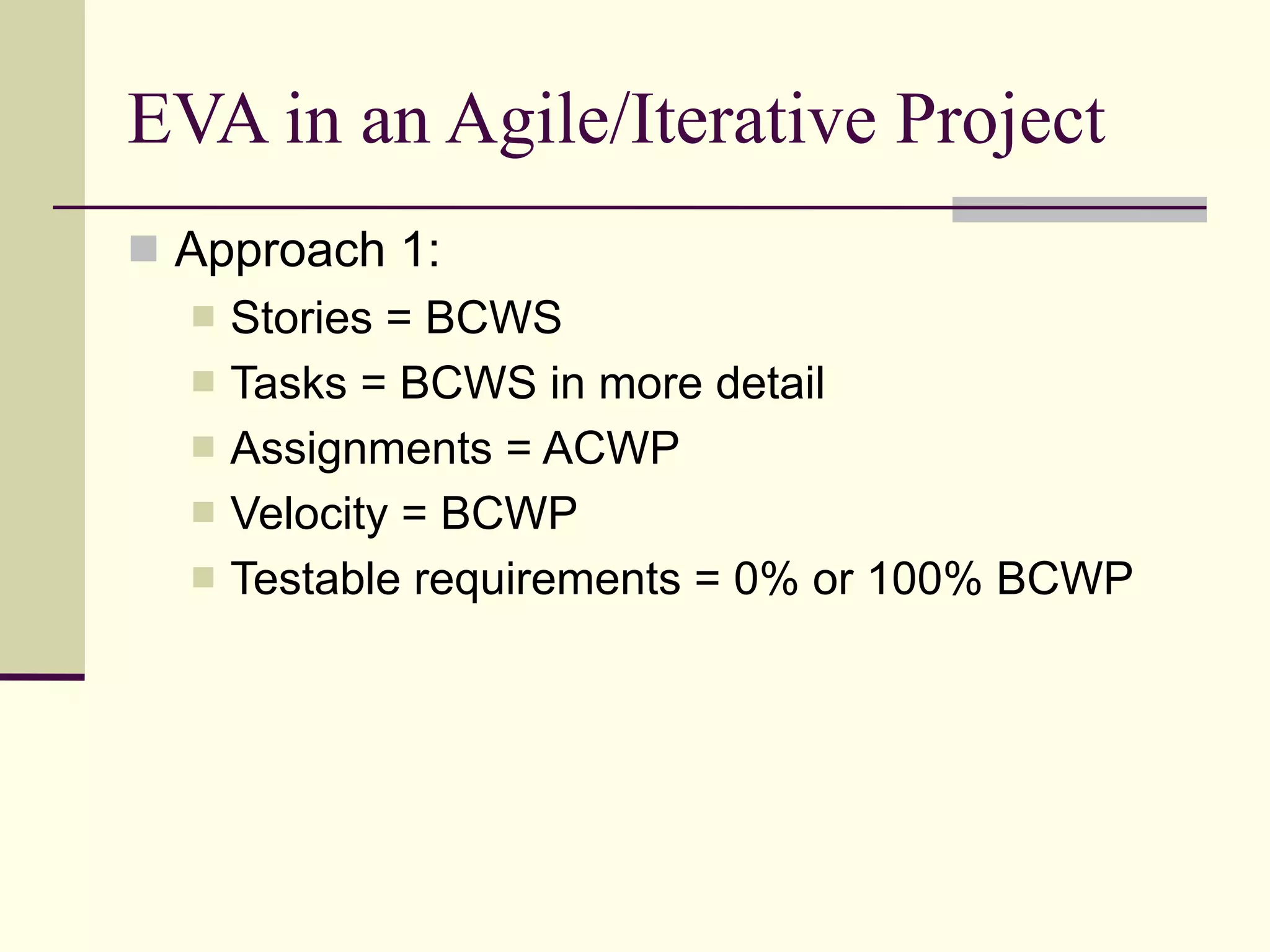

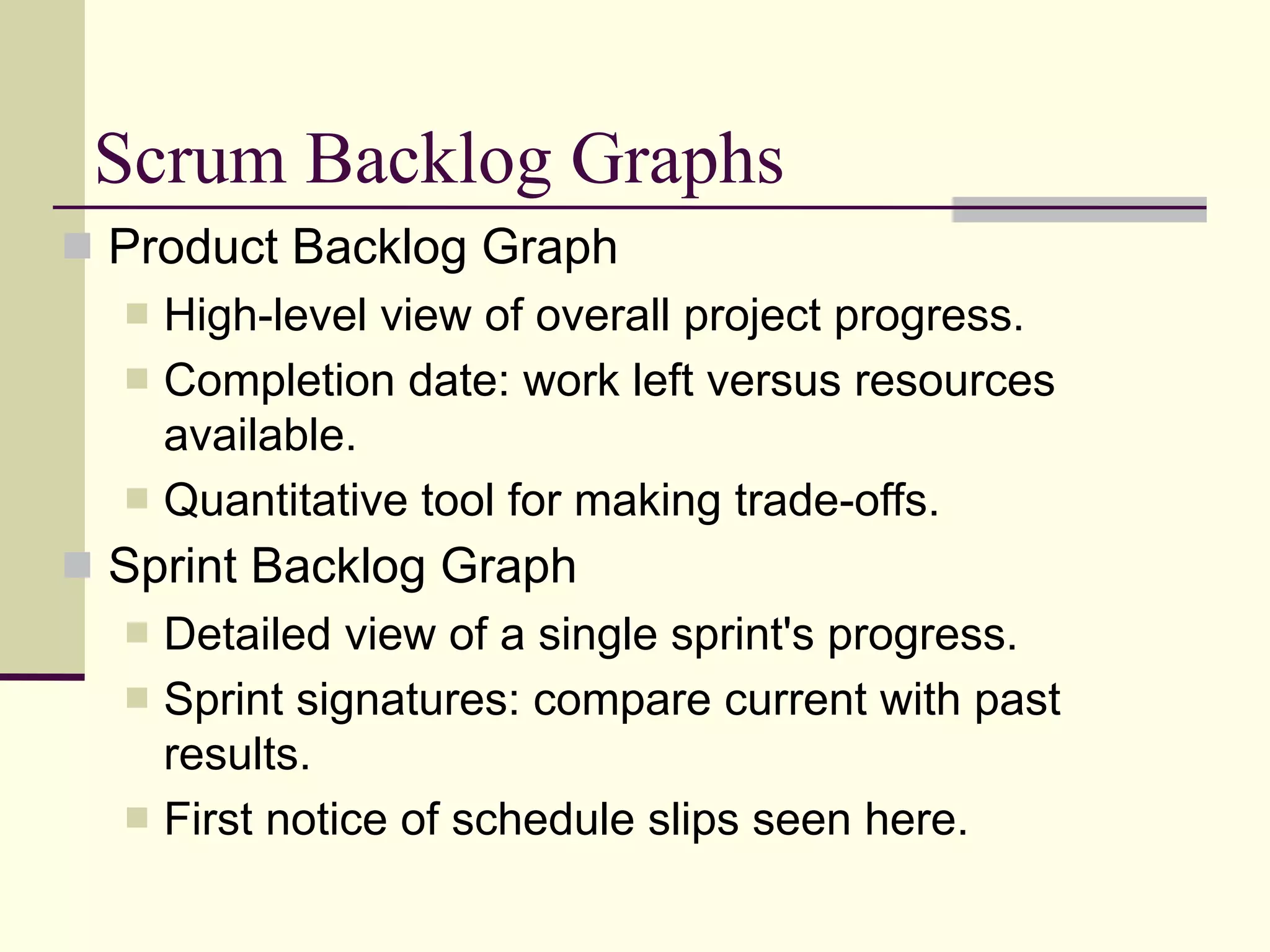

  • #30 Used heavily in Scrum as the primary project progress metric. Levels of abstraction: Task Request (user story, requirement, use case) Milestone (sprint backlog) Overall project (product backlog) For higher levels, must take into account the project velocity (team member availability)
  • #31 Product Backlog: Tradeoffs between cost, time, functionality, and quality (four pillars) Stress that by repeatedly updating and displaying the product backlog graph, management sees the effects of their choices. They can alter priorities with some understanding of the impact. Allows them to steer the project. Sprint Backlog: Allows team to see the impact of their estimates Each team will develop a signature Watch out for deviations from normal practice...

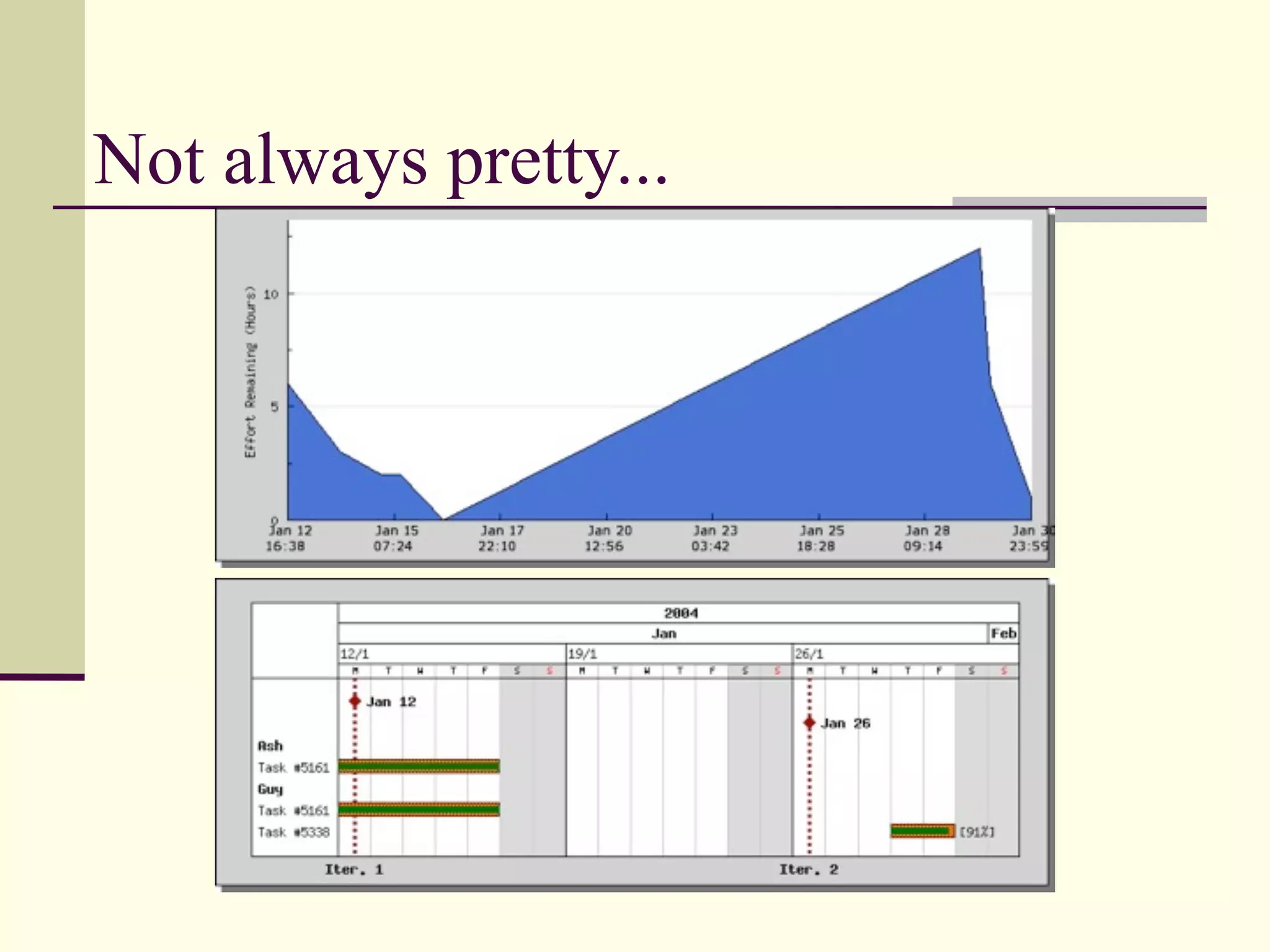

  • #32 Just want to show that you don't always get a pretty sloped graph in the real world. This is the burn-down graph of a request I was handling at work. It looked complete after iteration #1, but we found an ambiguity in the requirements that required we revisit it. That's why there are two tasks. Gantt chart is just to elaborate the progress changes.

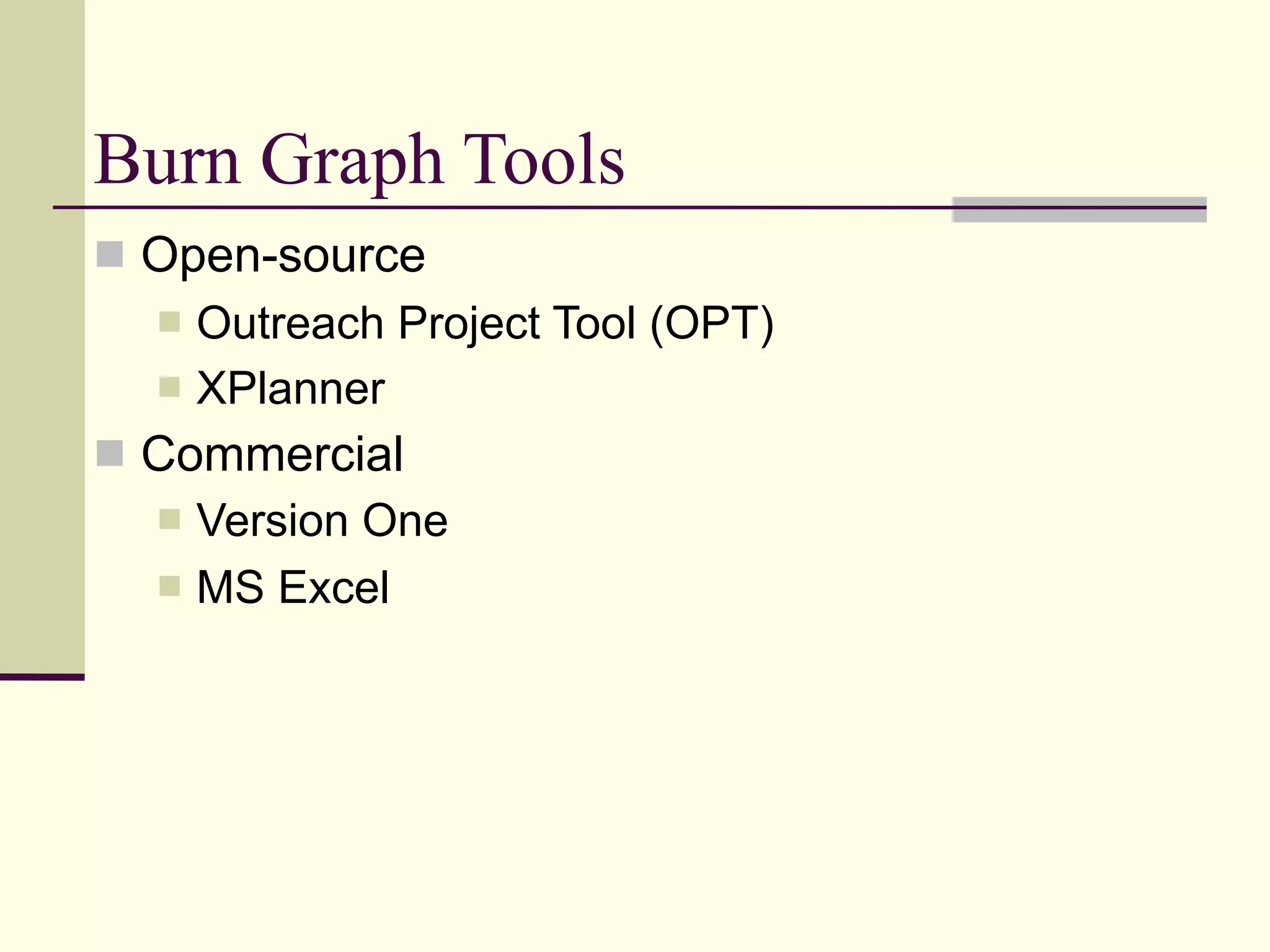

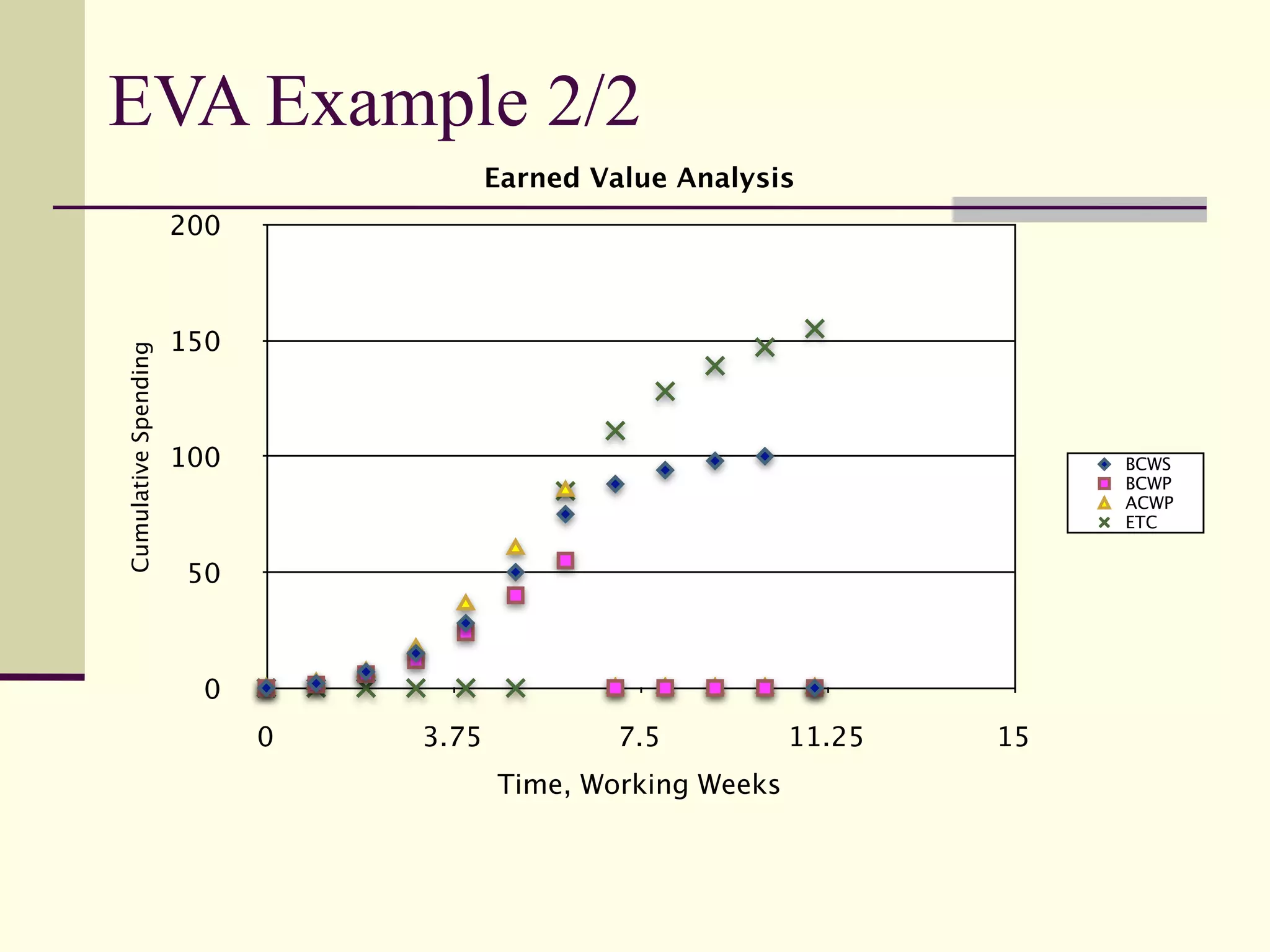

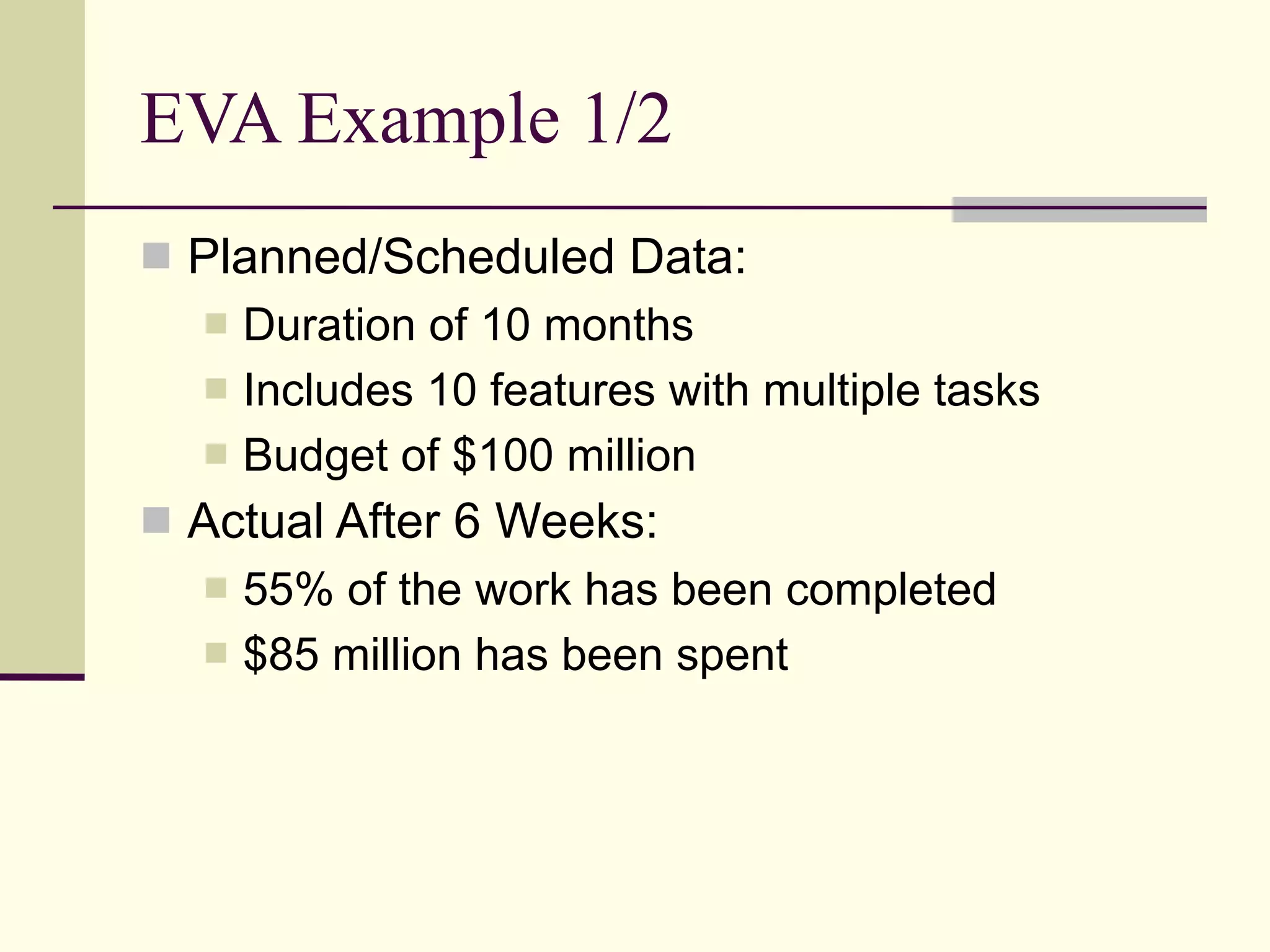

  • #33 Need to find some sources about these as I'm basically just making assumptions!

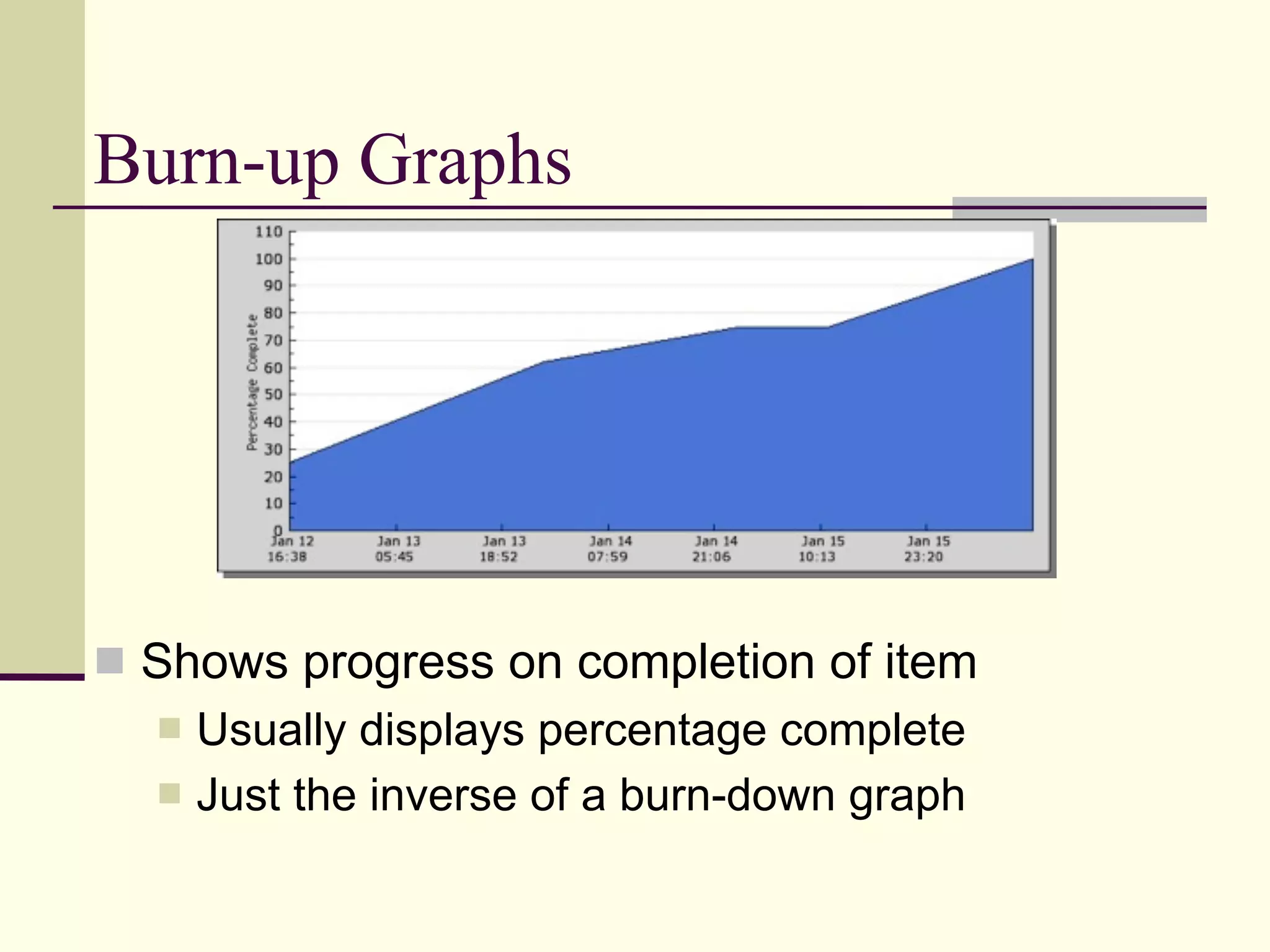

  • #34 Just a burn-up graph... Better than milestone % complete as this graph suffers from “false reporting” problem. People say they're 90% finished forever. Better than features complete graph as this ignores work-in progress.
  • #36 Note: I'd like to give a demonstration of OPT if we have time. I can have it on my laptop or off my server via an PC with a web-browser.
