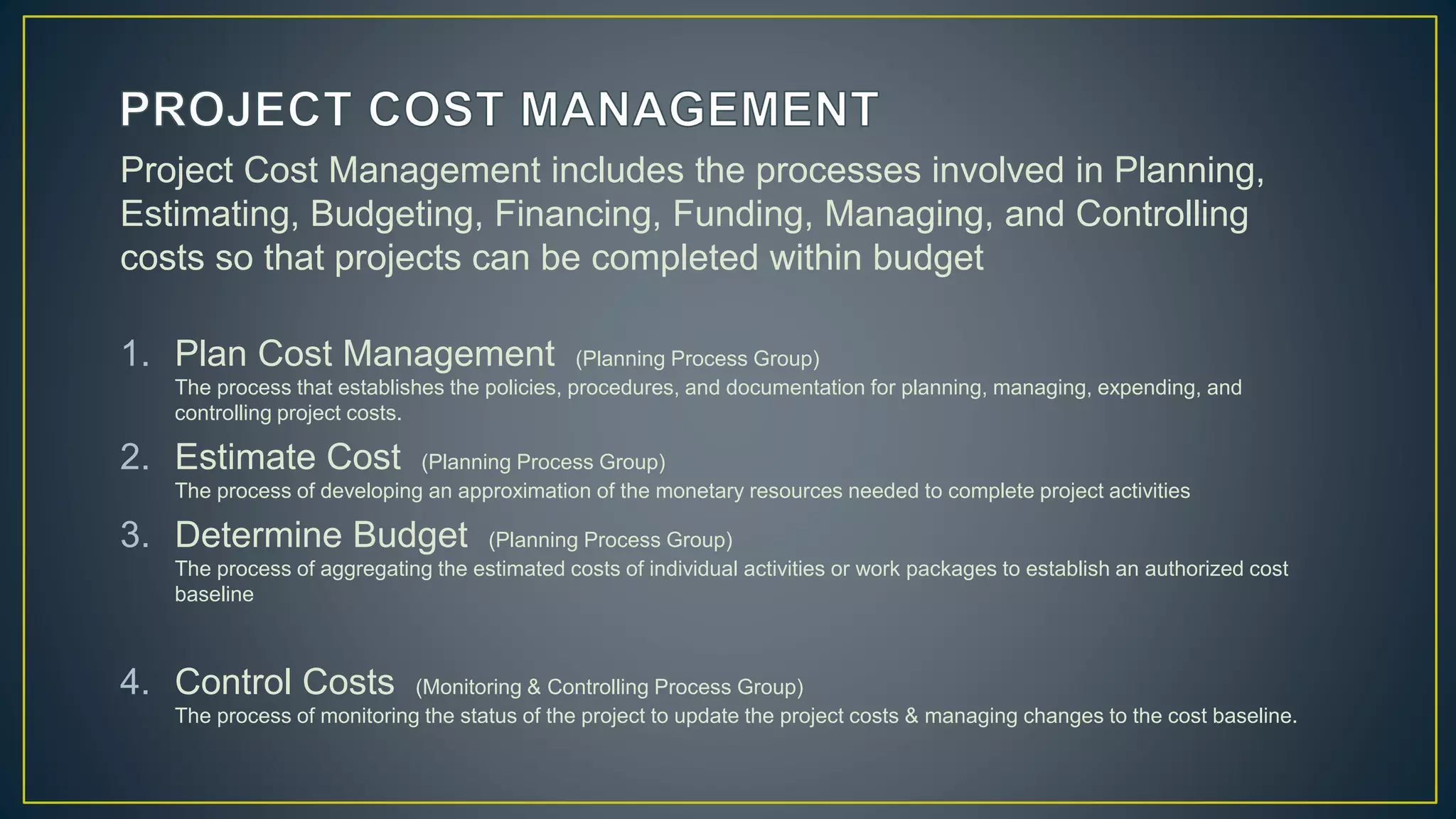

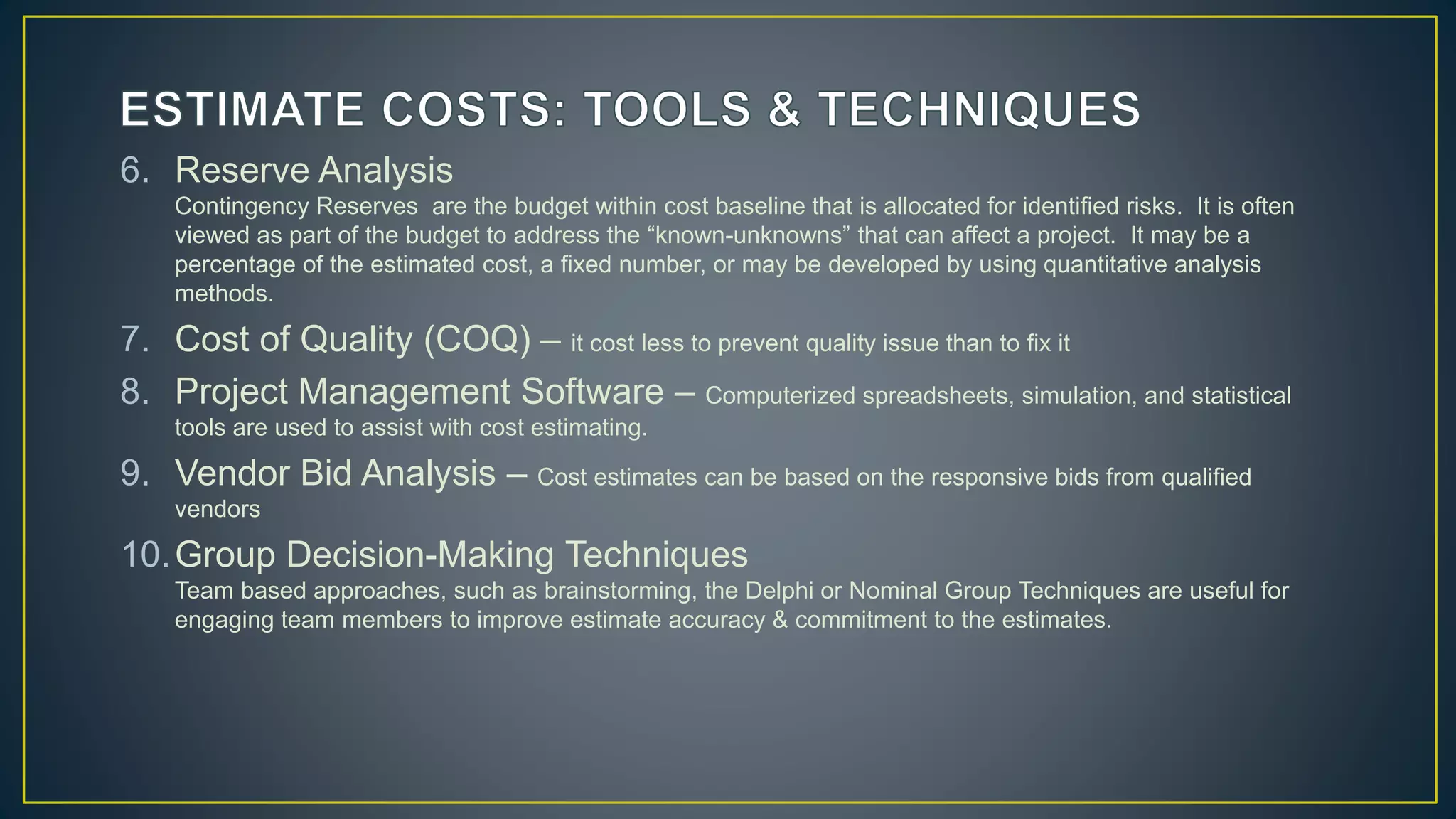

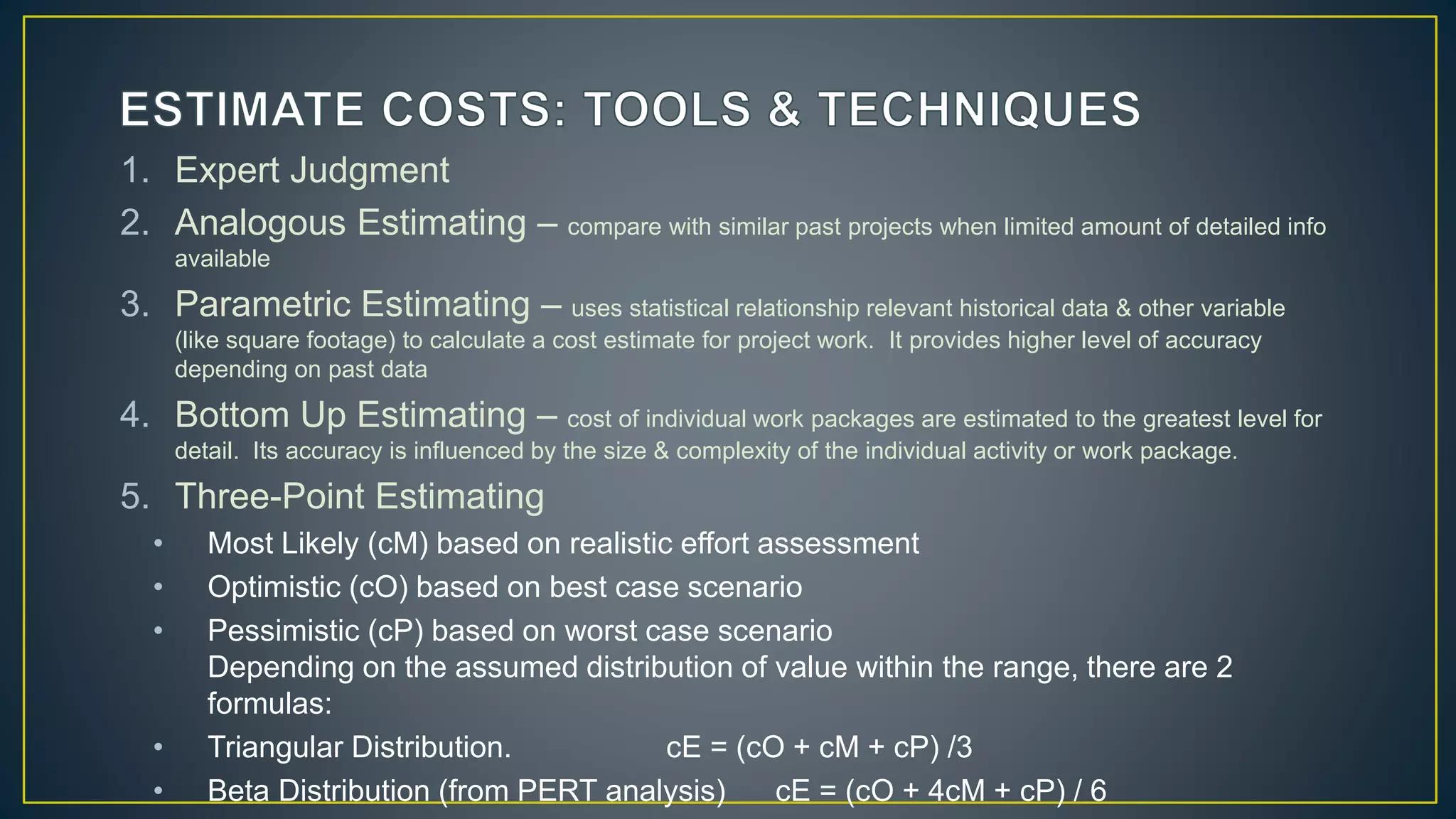

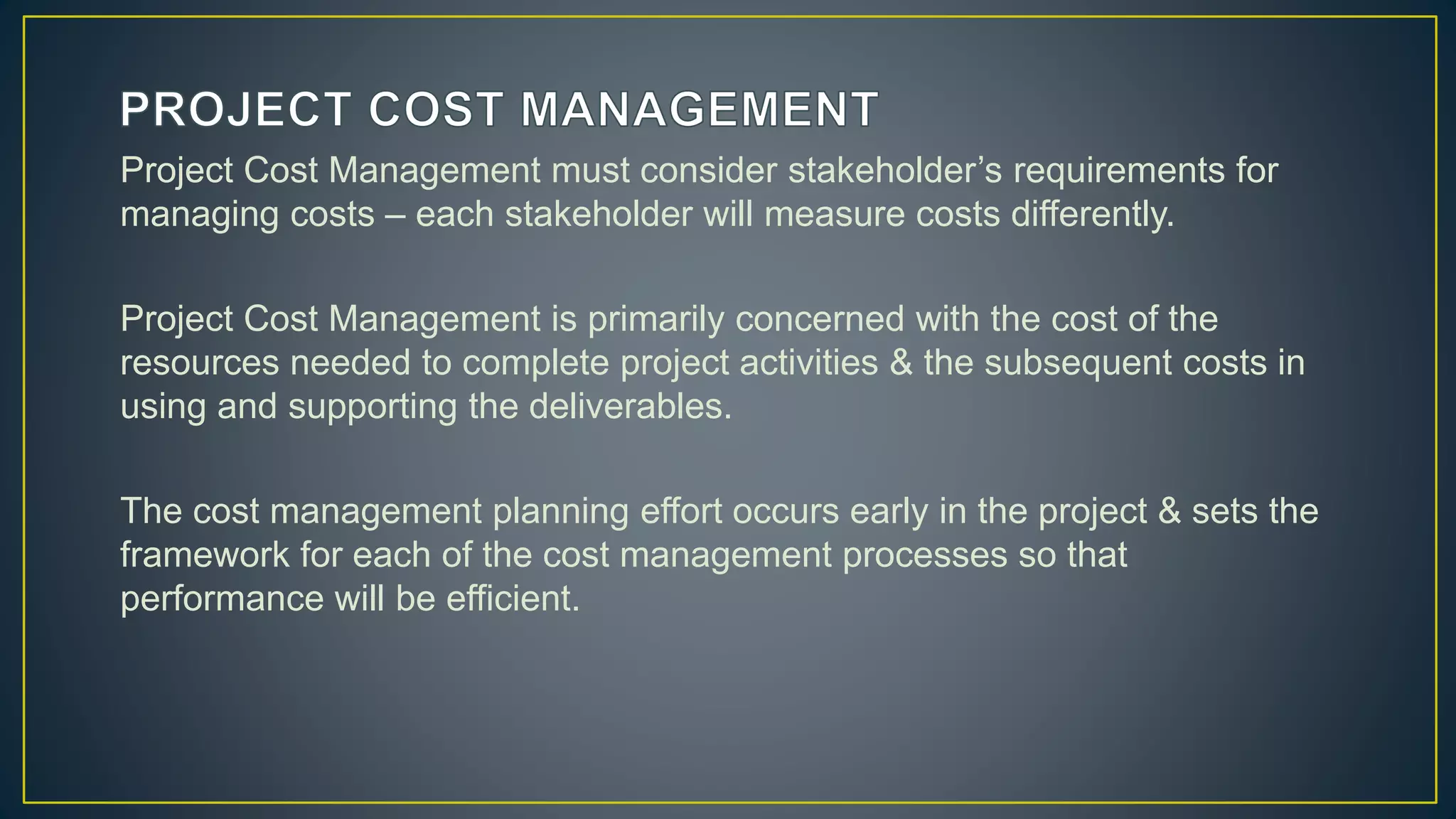

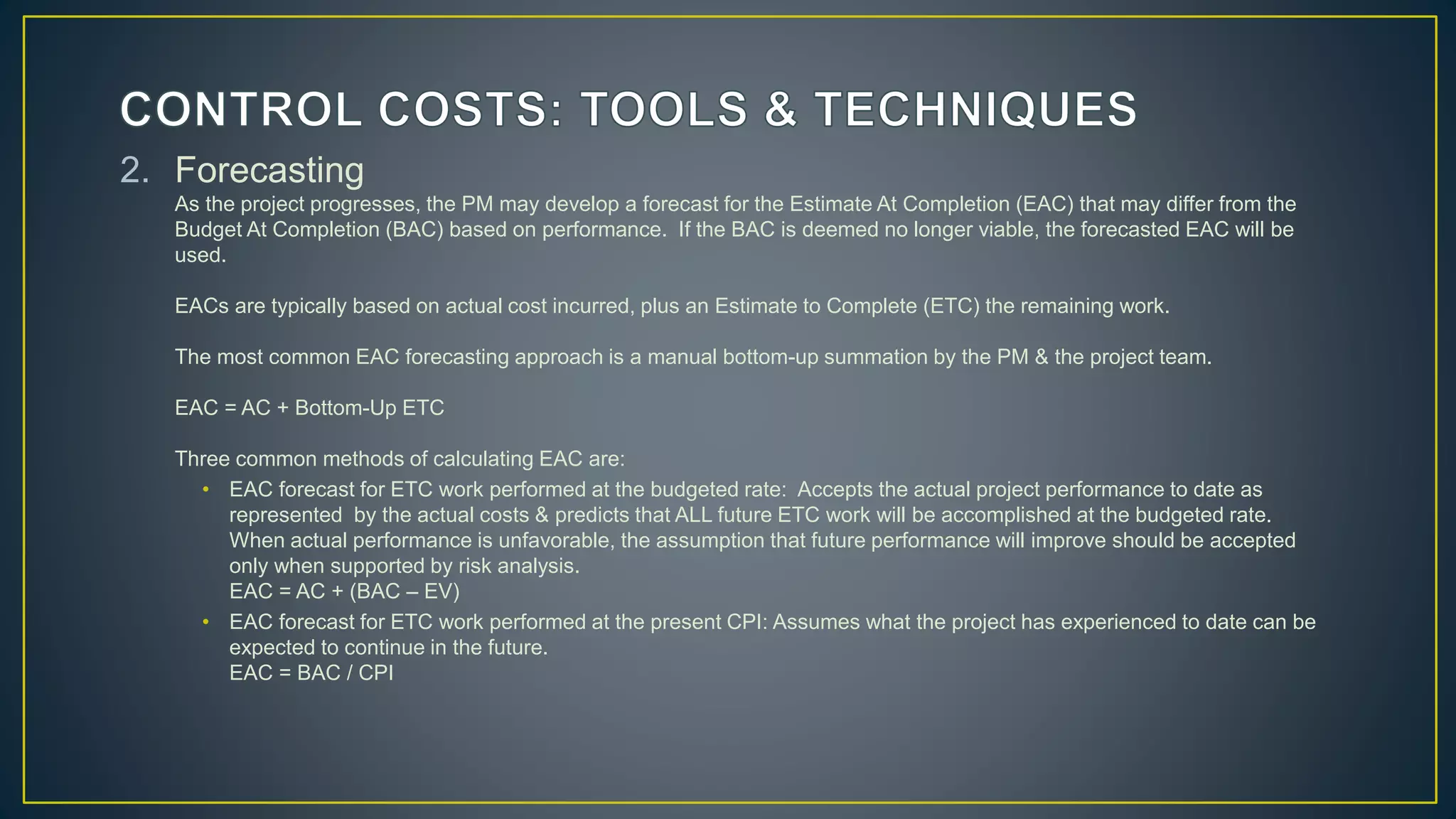

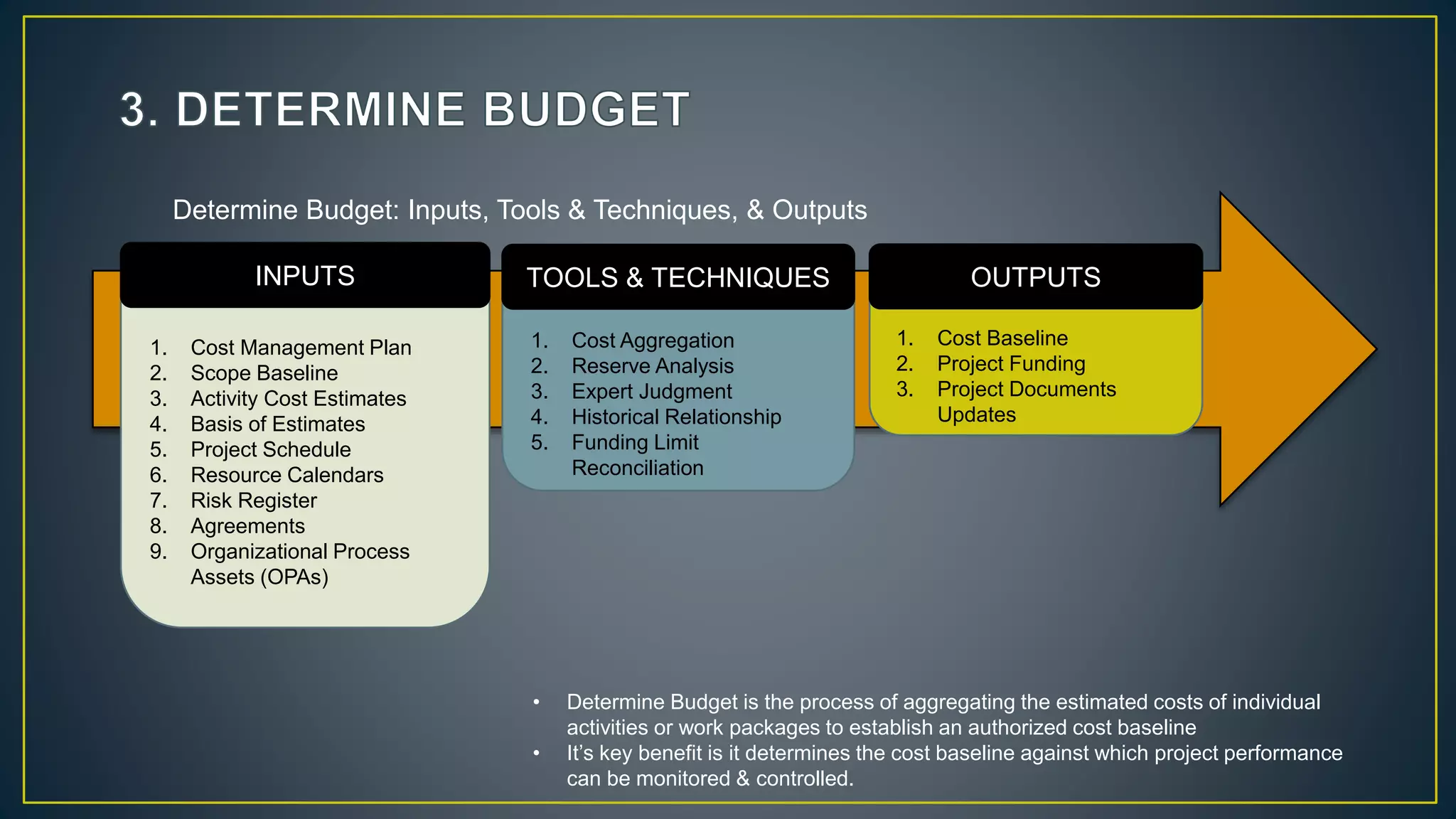

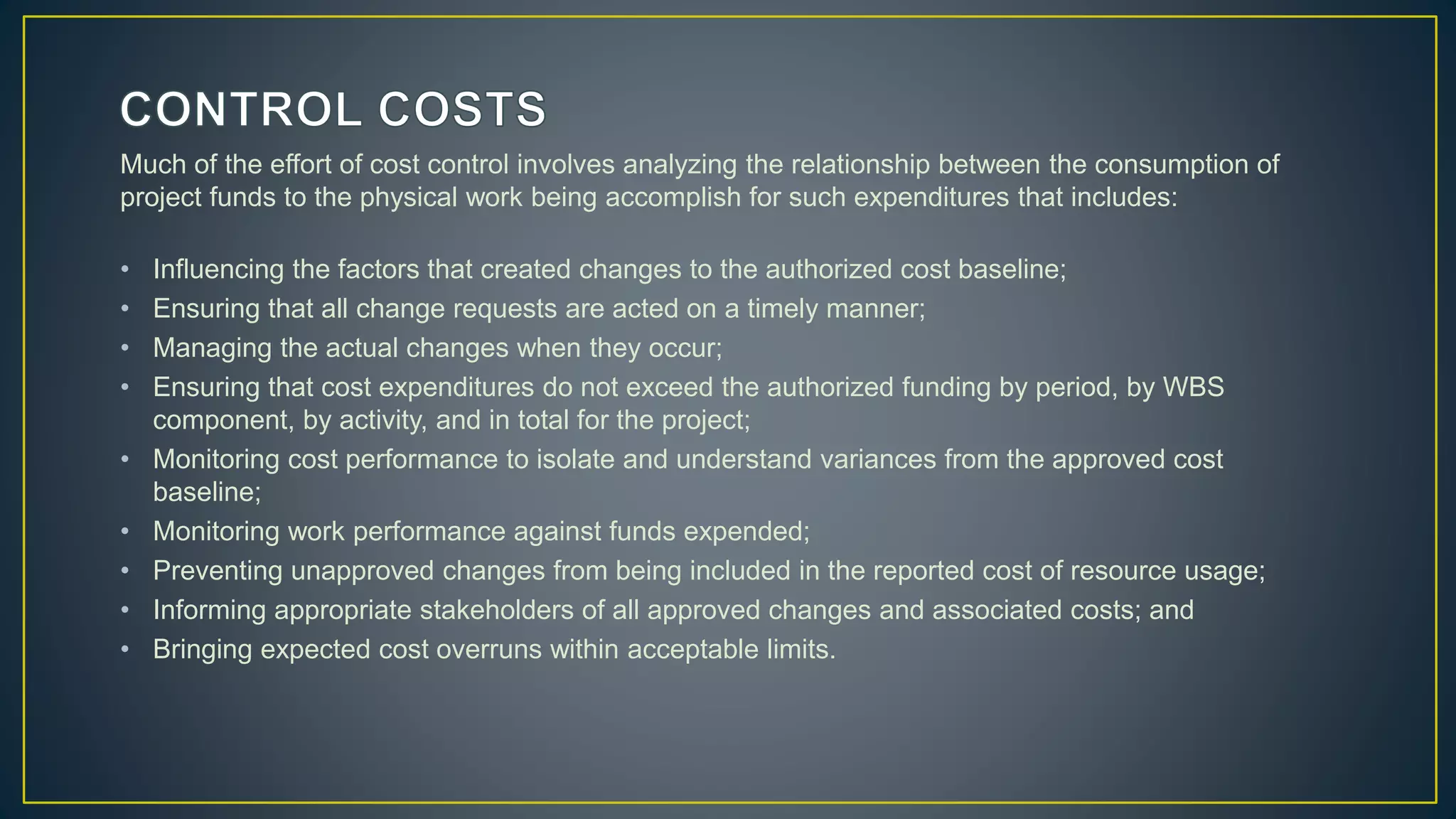

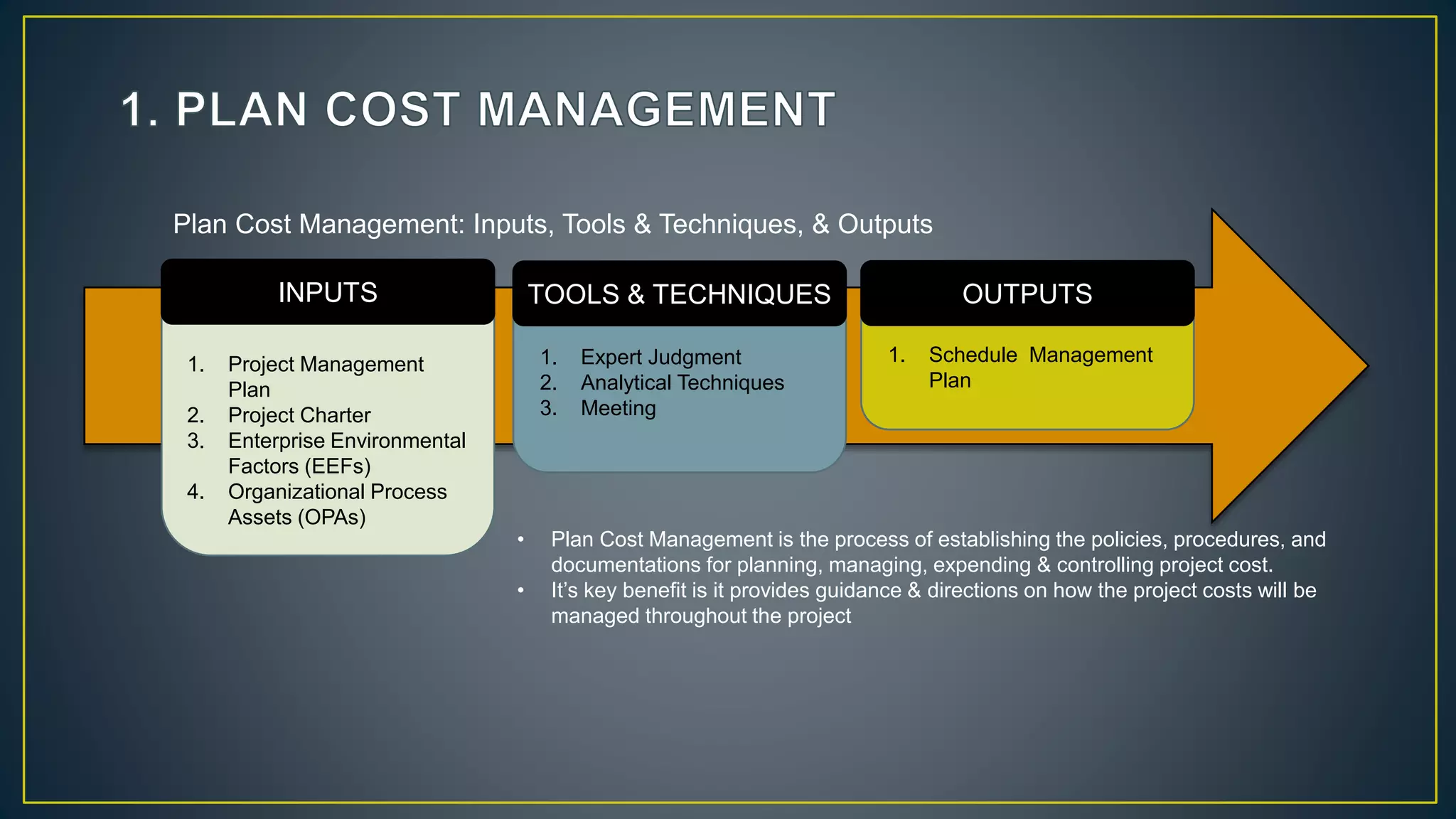

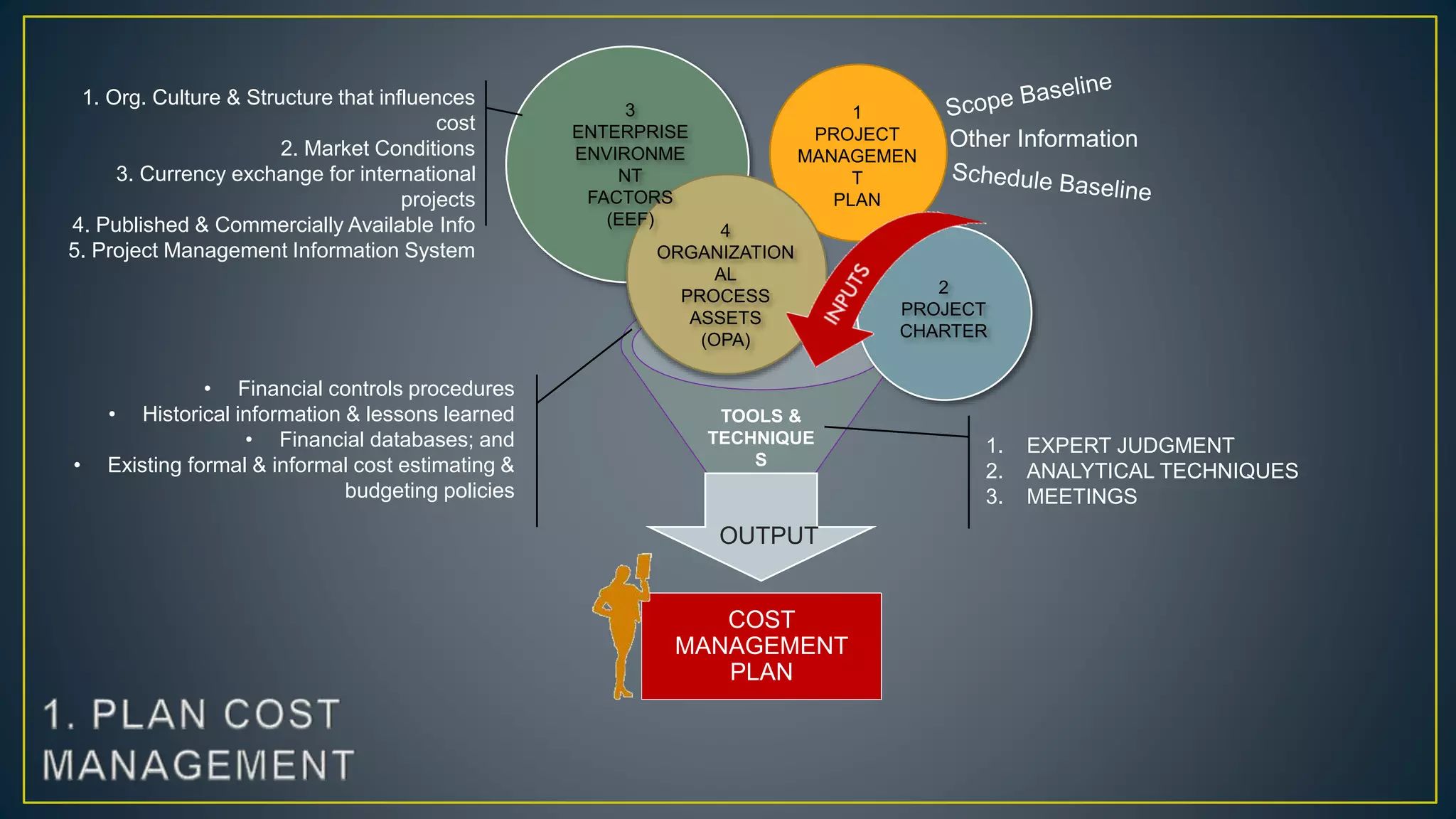

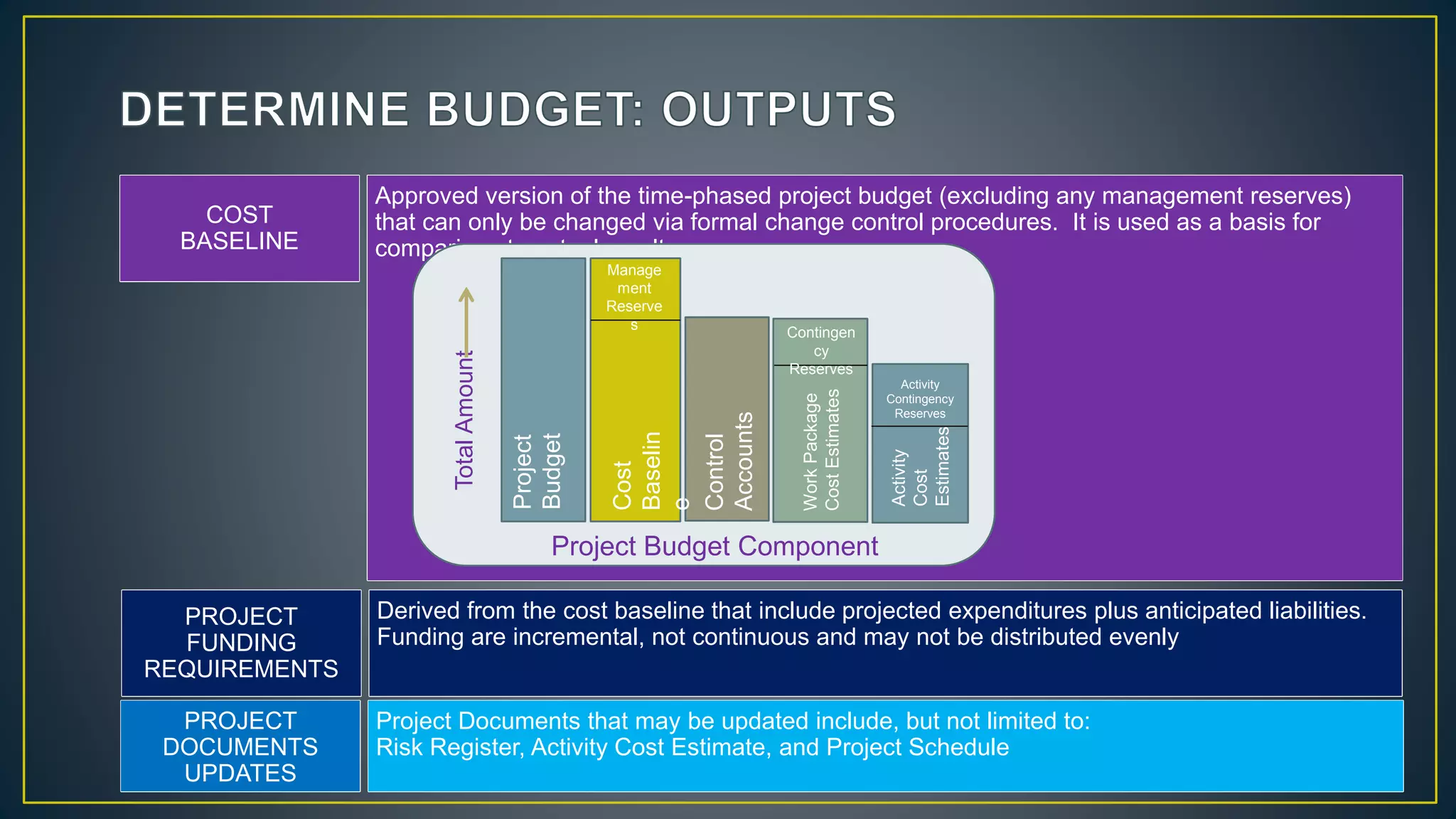

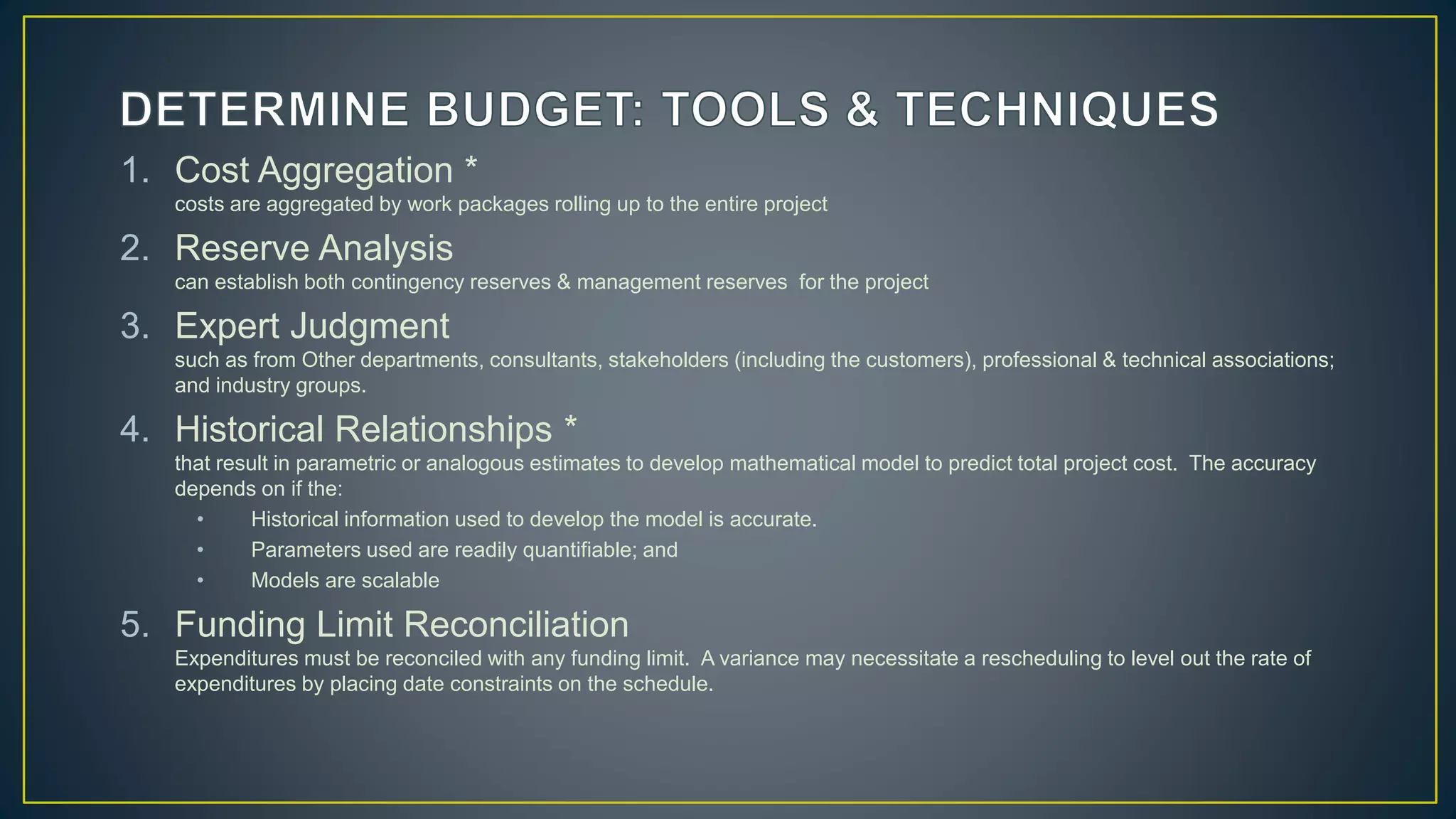

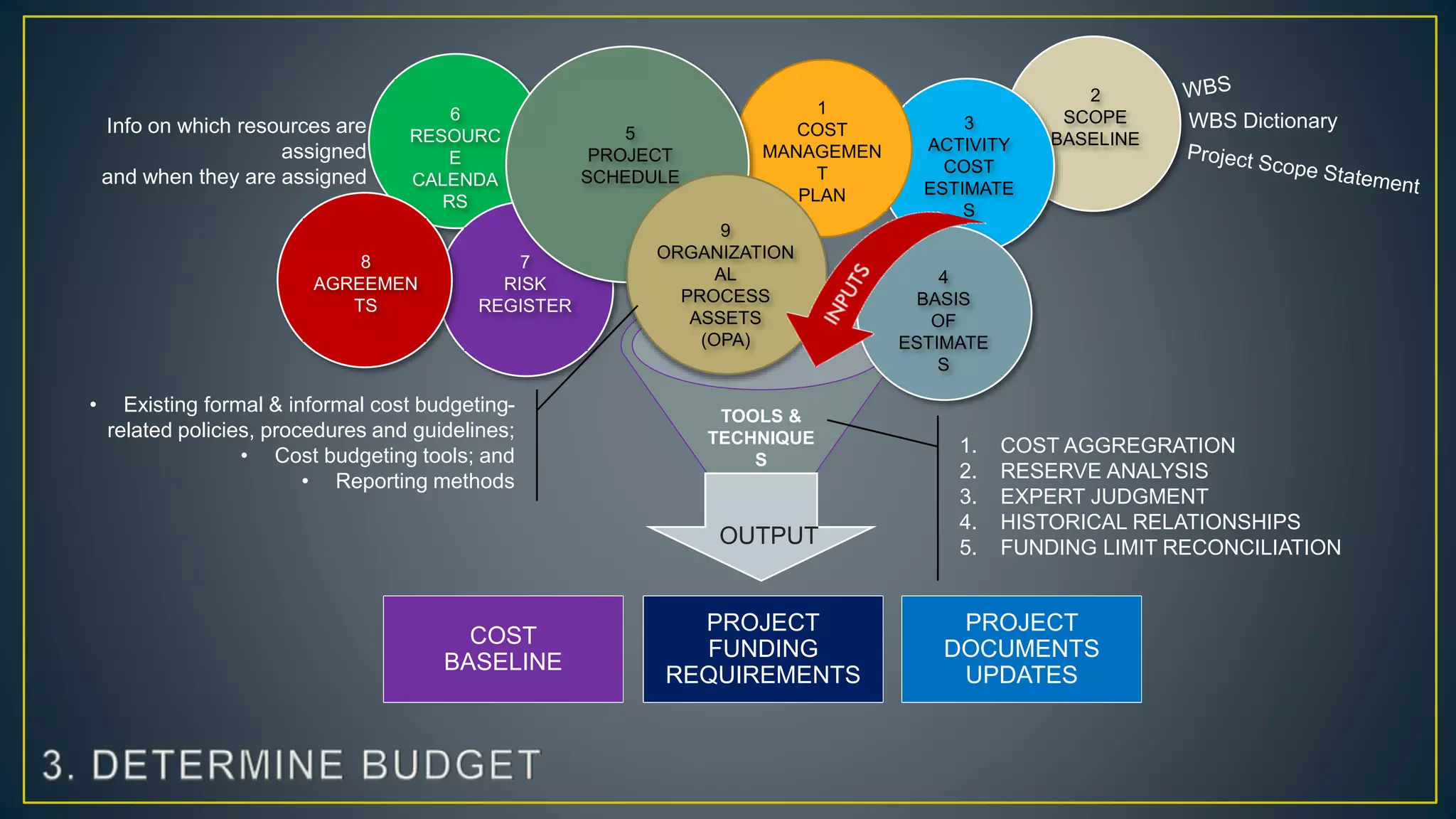

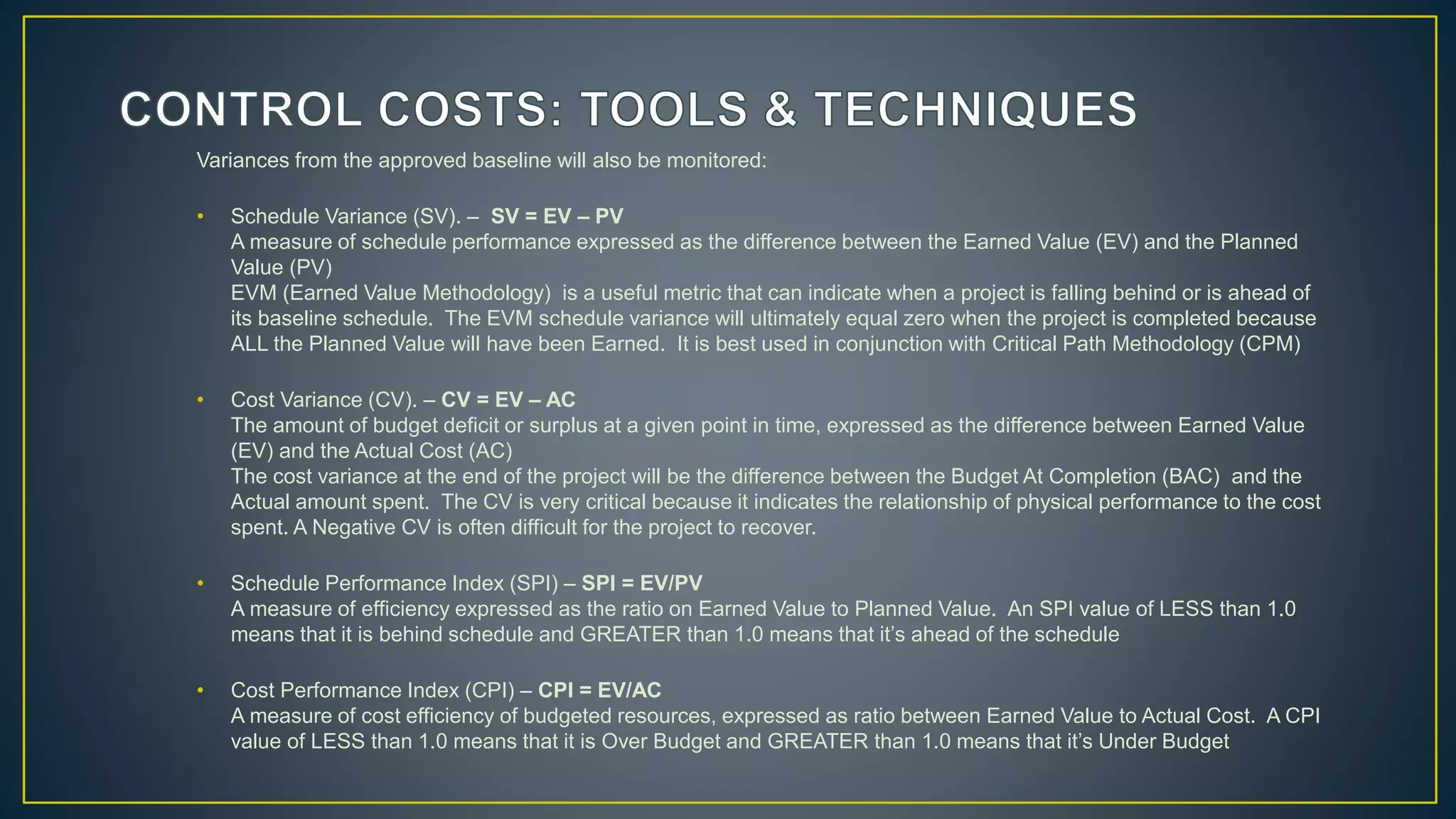

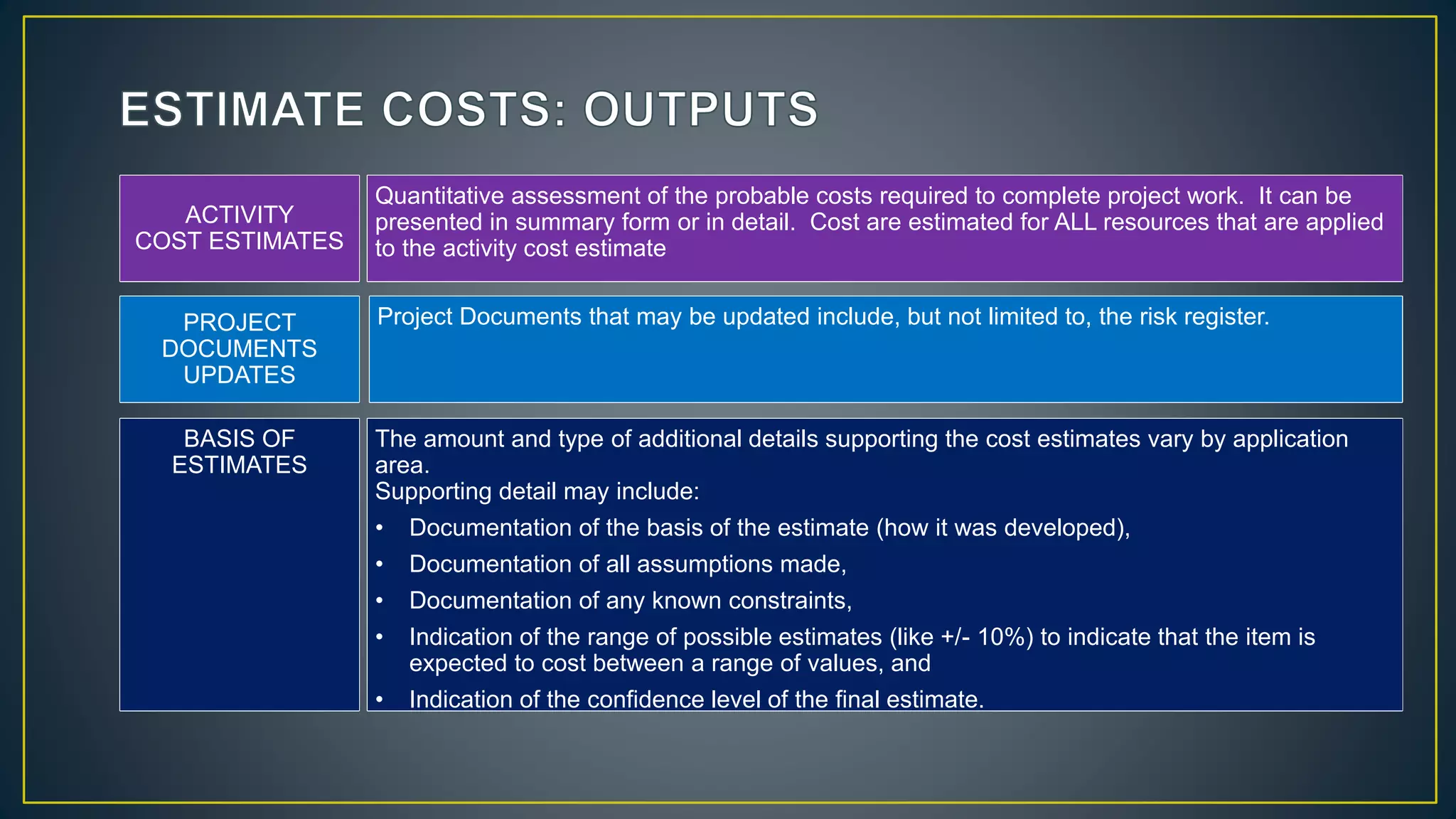

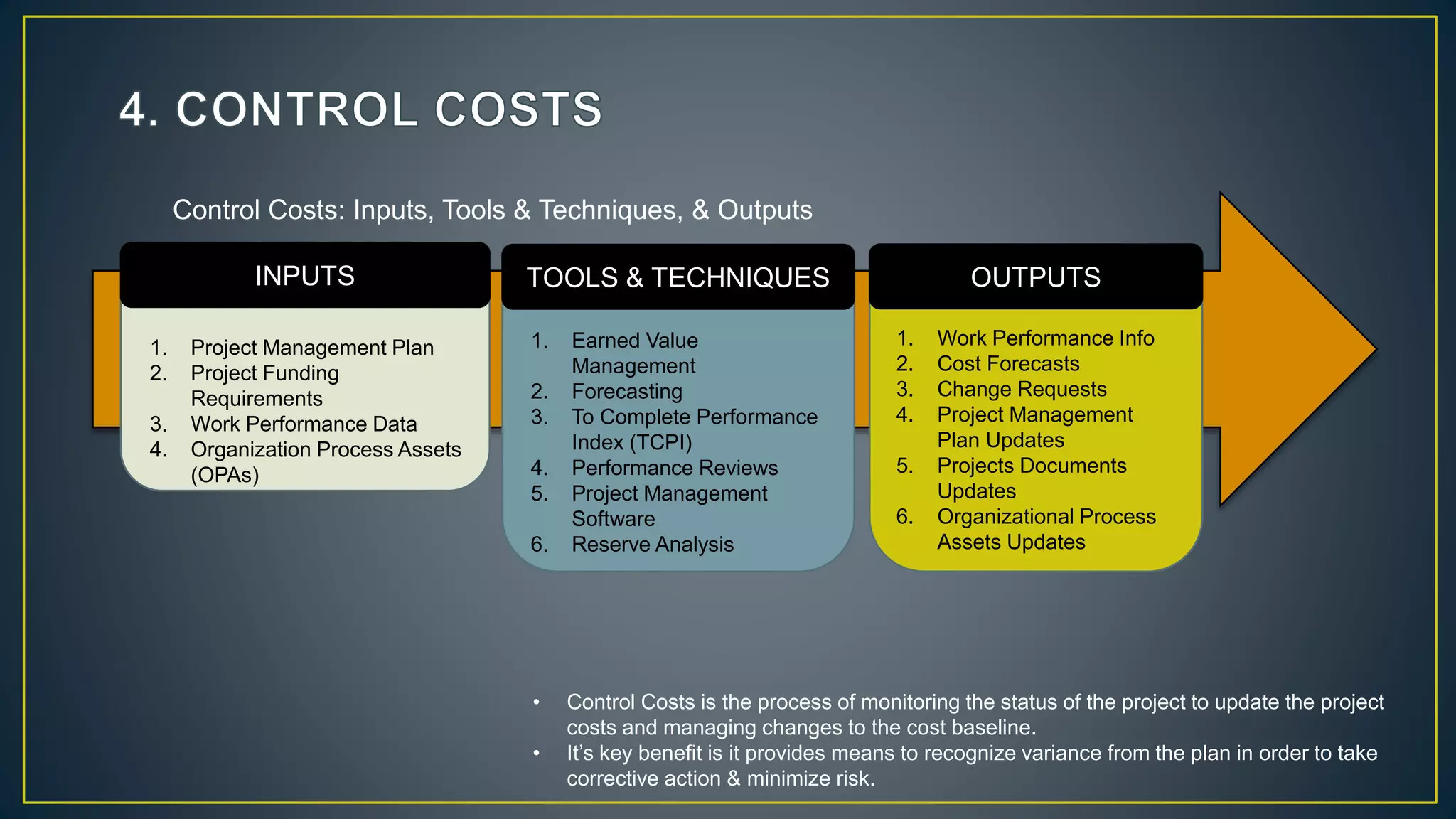

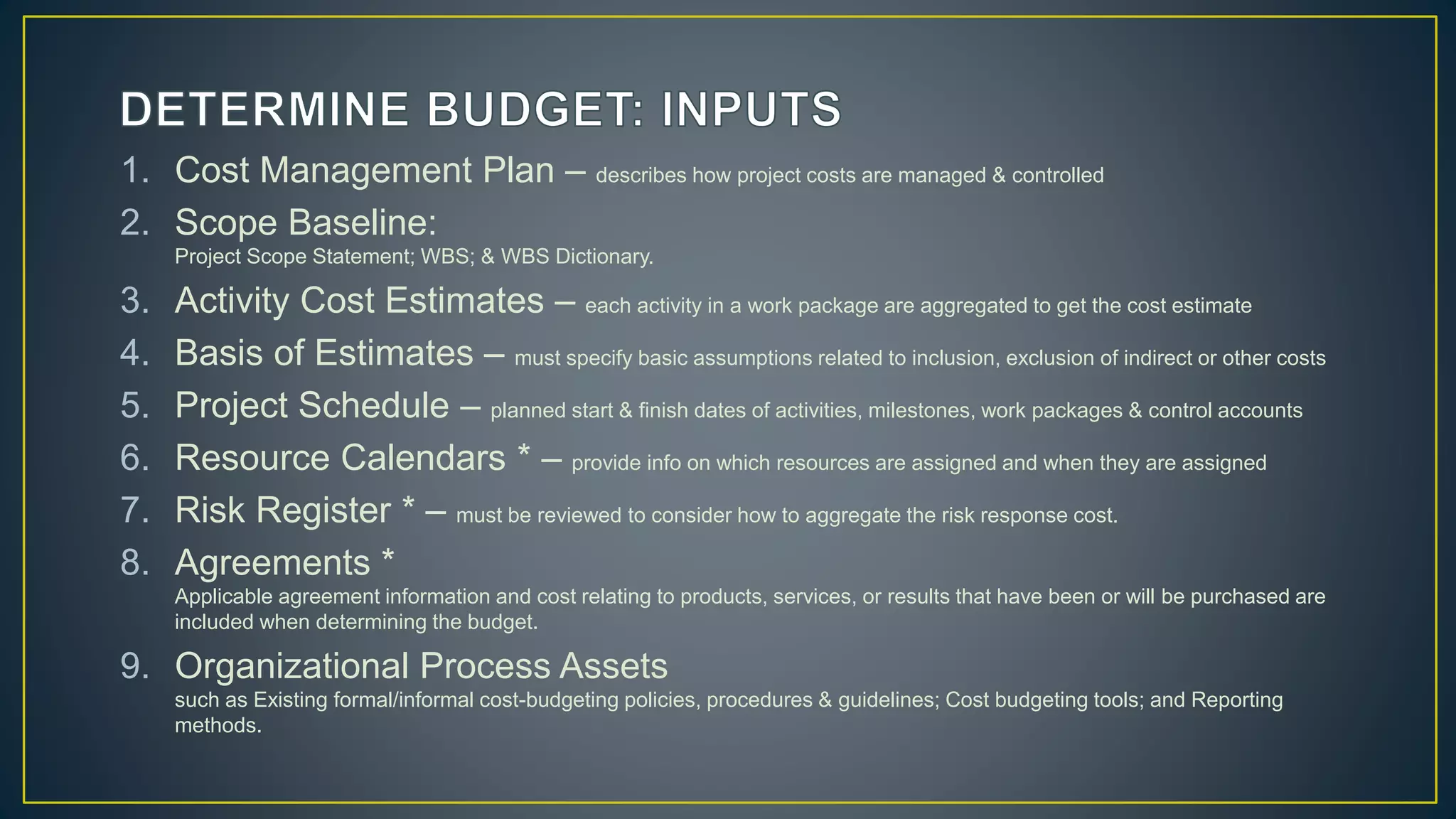

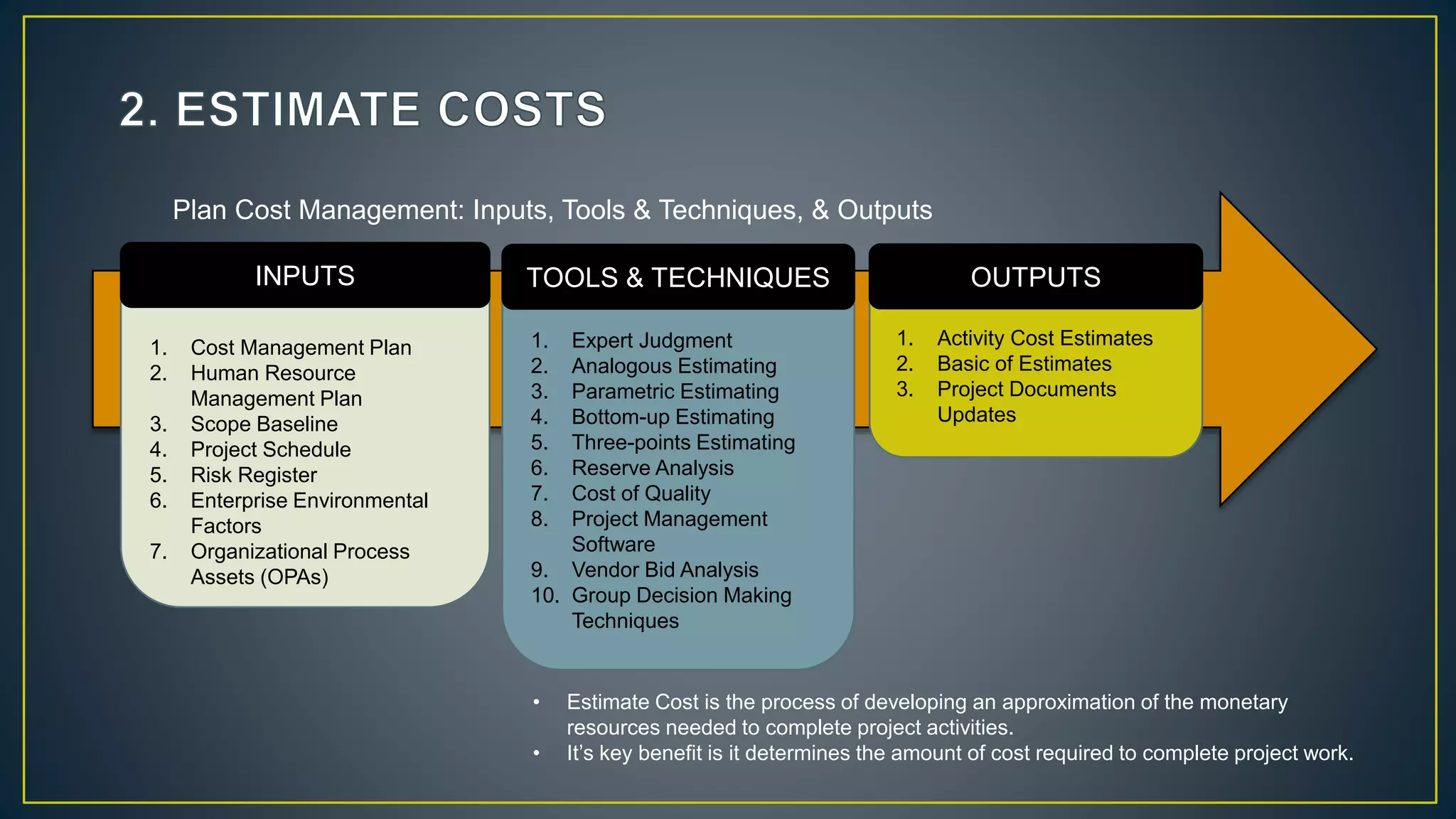

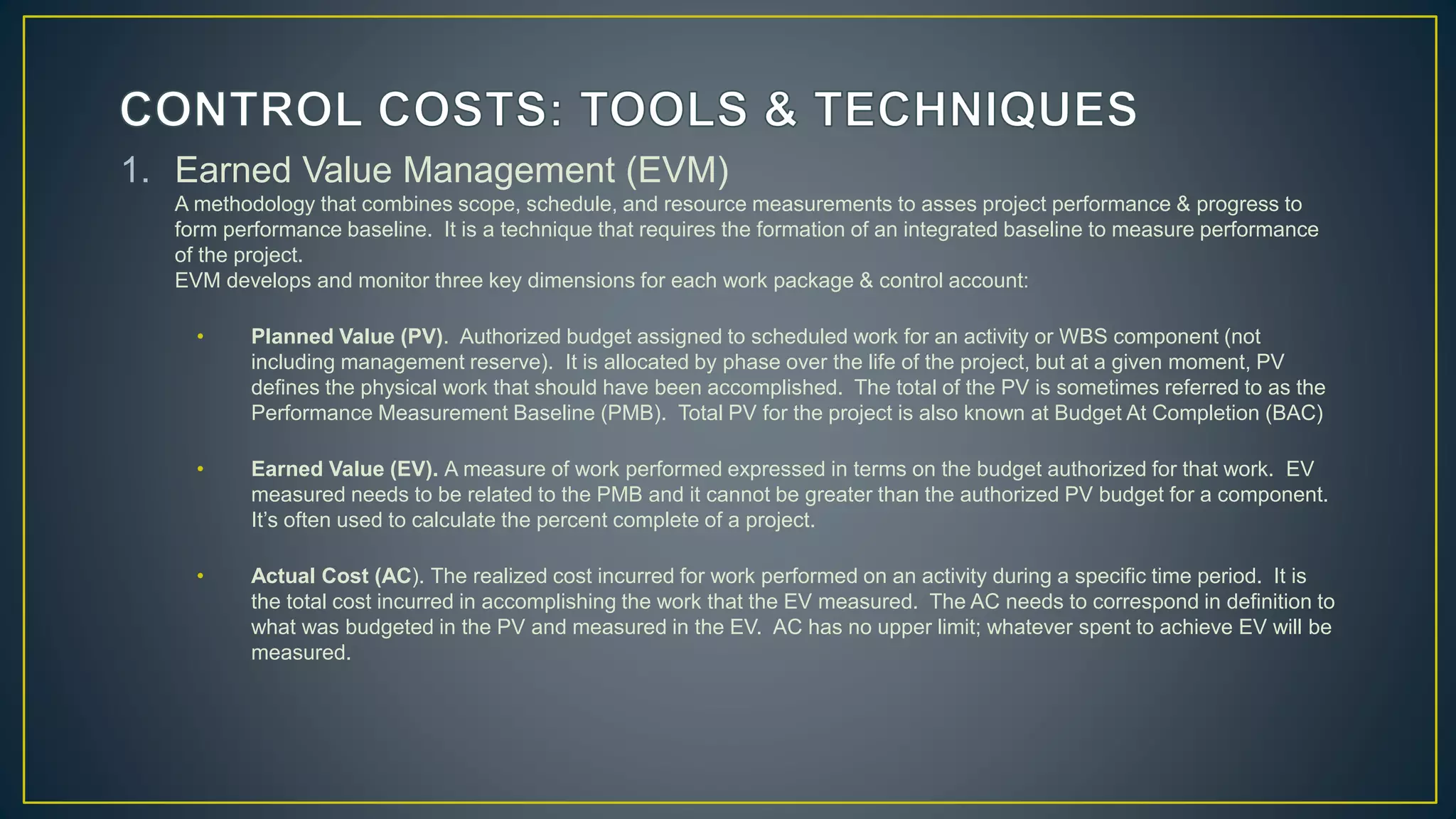

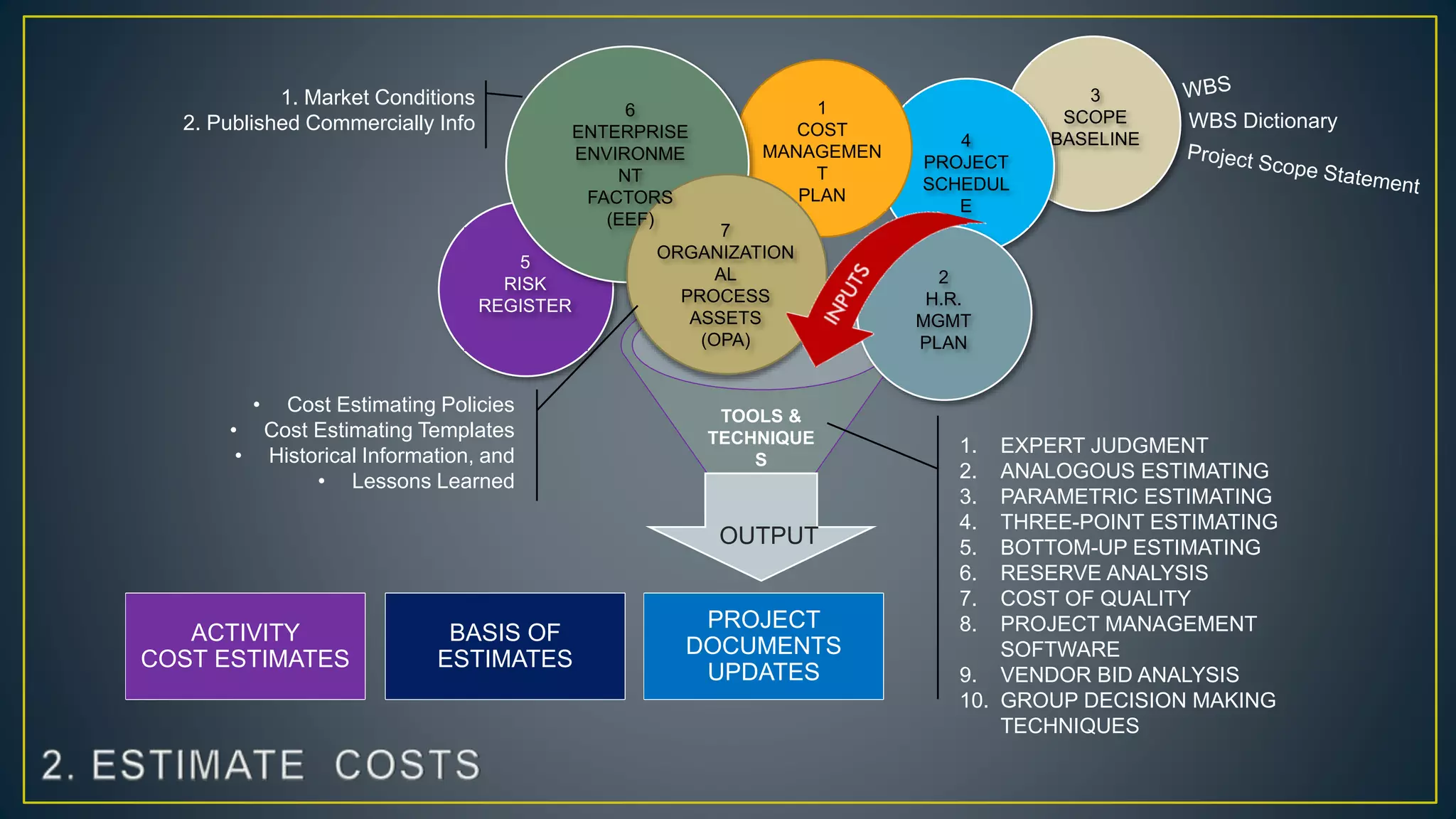

Plan Cost Management establishes the policies, procedures, and documentation for planning, managing, expending, and controlling project costs. It provides guidance on how project costs will be managed throughout the project. Estimate Cost develops an approximation of the monetary resources needed to complete project activities using techniques like expert judgment, analogous estimating, and three-point estimating. Determine Budget aggregates the estimated costs of activities to establish an authorized cost baseline against which performance can be monitored. Control Costs monitors project costs and manages changes to the cost baseline using earned value management, forecasting, and performance reviews to recognize variances and take corrective action.
