Network Optimization as next step in Spare Parts Cost and Service Optimization How to create Value?
Paolo Galli
European Logistics EMA-EMEA Ops
E: paolo.galli@electrolux.it
T: +39 0434 394408
Carlo Peters
Supply Chain Strategy Consultant
E: carlo.peters@bciglobal.com
T: +31 622 917 254
Stockholm, February 7, 2013
 Buck Consultants International, 2013
1

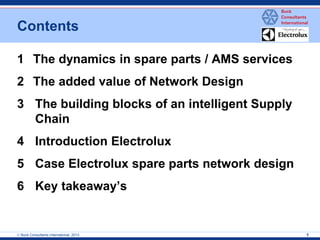

Contents
1 The dynamics in spare parts / AMS services
2 The added value of Network Design
3The building blocks of an intelligent Supply Chain
4Introduction Electrolux
5Case Electrolux spare parts network design
6Key takeaway’s
 Buck Consultants International, 2013
2

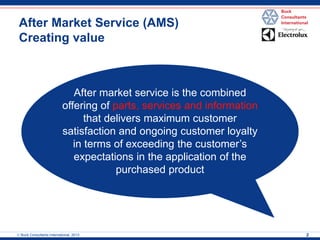

After Market Service (AMS) Creating value
After market service is the combined offering of parts, services and information that delivers maximum customer satisfaction and ongoing customer loyalty in terms of exceeding the customer’s expectations in the application of the purchased product
 Buck Consultants International, 2013
3

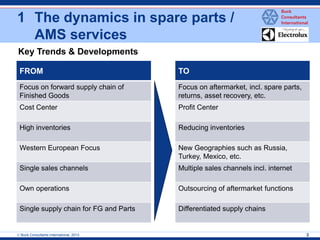

1 The dynamics in spare parts / AMS services
FROM
Focus on forward supply chain of Finished Goods
Cost Center
High inventories
Western European Focus
Single sales channels
Own operations
Single supply chain for FG and Parts
TO
Focus on aftermarket, incl. spare parts, returns, asset recovery, etc.
Profit Center
Reducing inventories
New Geographies such as Russia, Turkey, Mexico, etc.
Multiple sales channels incl. internet
Outsourcing of aftermarket functions
Differentiated supply chains
Key Trends & Developments
 Buck Consultants International, 2013
4

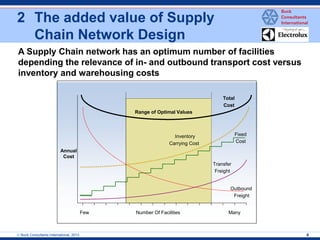

2 The added value of Supply Chain Network Design
Range of Optimal Values
Annual
Cost
Transfer
Freight
Fixed
Cost
Outbound
Freight
Number Of Facilities
Few
Many
Total
Cost
Inventory
Carrying Cost

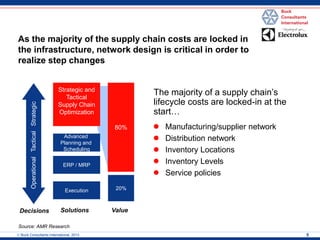

A Supply Chain network has an optimum number of facilities depending the relevance of in- and outbound transport cost versus inventory and warehousing costs
The majority of a supply chain’s lifecycle costs are locked-in at the start…
Decisions
Solutions
Value
Advanced
Planning and
Scheduling
ERP / MRP
Execution
Strategic and Tactical Supply Chain Optimization
80%
20%
Operational Tactical Strategic
Source: AMR Research
Manufacturing/supplier network
Distribution network
Inventory Locations
Inventory Levels
Service policies
As the majority of the supply chain costs are locked in
the infrastructure, network design is critical in order to
realize step changes
 Buck Consultants International, 2013
5
Operational Tactical Strategic
Supply chain configuration
Inventory deployment
Service level /Safety stock targets
Allocation
Capacitated scheduling
Available-to-promise
Purchase order management
Transaction management
Bill-of-materials management
Performance monitoring
Event/alert management
Connectivity
Network footprint design
Transport lanes
Facility numbers/locations
Strategic network design is directly linked to Inventory Policies; where to start?
 Buck Consultants International, 2013
6
Network Design
Inventory Policy
Advanced Planning and Scheduling
MRP / ERP
Execution
 Buck Consultants International, 2013
7

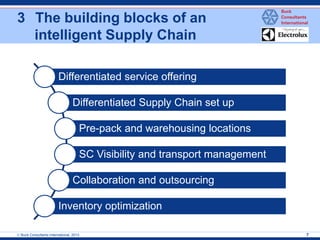

3The building blocks of an intelligent Supply Chain
Differentiated service offering
Differentiated Supply Chain set up
Pre-pack and warehousing locations
SC Visibility and transport management
Collaboration and outsourcing
Inventory optimization
8

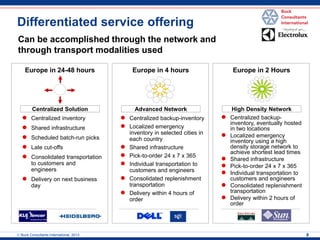

Europe in 4 hours
Advanced Network
●Centralized backup-inventory
●Localized emergency inventory in selected cities in each country
●Shared infrastructure
●Pick-to-order 24 x 7 x 365
●Individual transportation to customers and engineers
●Consolidated replenishment transportation
●Delivery within 4 hours of order
Europe in 24-48 hours
Centralized Solution
●Centralized inventory
●Shared infrastructure
●Scheduled batch-run picks
●Late cut-offs
●Consolidated transportation to customers and engineers
●Delivery on next business day
Europe in 2 Hours
High Density Network
●Centralized backup- inventory, eventually hosted in two locations
●Localized emergency inventory using a high density storage network to achieve shortest lead times
●Shared infrastructure
●Pick-to-order 24 x 7 x 365
●Individual transportation to customers and engineers
●Consolidated replenishment transportation
●Delivery within 2 hours of order
 Buck Consultants International, 2013
Differentiated service offering
Can be accomplished through the network and
through transport modalities used
 Buck Consultants International, 2013
9

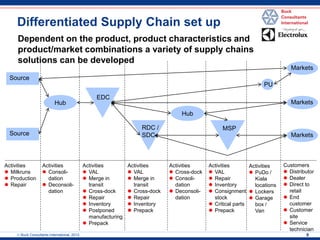

Customers
Distributor
Dealer
Direct to retail
End customer
Customer site
Service technician
Dependent on the product, product characteristics and
product/market combinations a variety of supply chains
solutions can be developed
Source
Source
Hub
EDC
RDC / SDC
Hub
MSP
Activities
Milkruns
Production
Repair
Activities
Consoli- dation
Deconsoli- dation
Activities
VAL
Merge in transit
Cross-dock
Repair
Inventory
Postponed manufacturing
Prepack
Activities
VAL
Merge in transit
Cross-dock
Repair
Inventory
Prepack
Activities
Cross-dock
Consoli- dation
Deconsoli- dation
Activities
VAL
Repair
Inventory
Consignment stock
Critical parts
Prepack
PU
Activities
PuDo / Kiala locations
Lockers
Garage box / Van
Markets
Markets
Markets
Differentiated Supply Chain set up
 Buck Consultants International, 2013
10

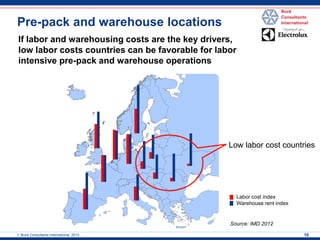

Pre-pack and warehouse locations
If labor and warehousing costs are the key drivers, low labor costs countries can be favorable for labor intensive pre-pack and warehouse operations
Low labor cost countries
Labor cost index Warehouse rent index
Source: IMD 2012
Inbound
Logistics
Suppliers
Receiving
Customer
Manufacturer
Customer
Channels
Outbound
Logistics
Return
Management

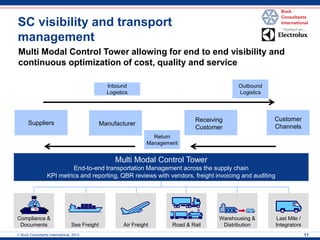

Multi Modal Control Tower
End-to-end transportation Management across the supply chain
KPI metrics and reporting, QBR reviews with vendors, freight invoicing and auditing
Sea Freight Air Freight
Warehousing &
Distribution
Last Mile /
Road & Rail Integrators
Compliance &
Documents
SC visibility and transport
management
Multi Modal Control Tower allowing for end to end visibility and
continuous optimization of cost, quality and service
 Buck Consultants International, 2013 11
Several collaboration initiatives have emerged; some are outsourced, other are managed amongst brand owners
Collaboration and Outsourcing
 Buck Consultants International, 2013
12

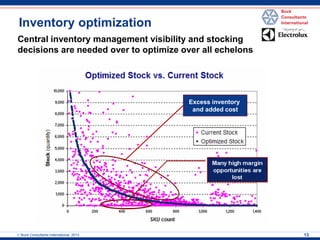

Inventory optimization
Excess inventory and added cost
Central inventory management visibility and stocking decisions are needed over to optimize over all echelons
 Buck Consultants International, 2013
13
 Buck Consultants International, 2013
14

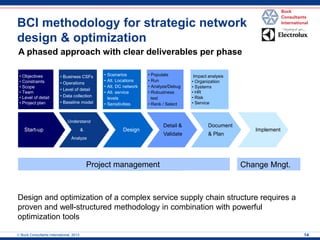

BCI methodology for strategic network design & optimization
Design and optimization of a complex service supply chain structure requires a proven and well-structured methodology in combination with powerful optimization tools
Start-up
Understand
&
Analyze
Design
Detail &
Validate
Document
& Plan
Implement
Project management
• Objectives
• Constraints
• Scope
• Team
• Level of detail
• Project plan
• Business CSFs
• Operations
• Level of detail
• Data collection
• Baseline model
•Scenarios
•Alt. Locations
•Alt. DC network
•Alt. service levels
•Sensitivities
• Populate
• Run
• Analyze/Debug
• Robustness test
• Rank / Select
Impact analysis
• Organization
• Systems
• HR
• Risk
• Service
Change Mngt.
A phased approach with clear deliverables per phase
15

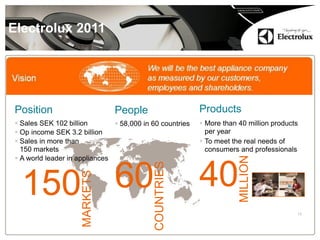

Electrolux 2011
Position
Sales SEK 102 billion
Op income SEK 3.2 billion
Sales in more than 150 markets
A world leader in appliances
Products
More than 40 million products per year
To meet the real needs of consumers and professionals
40
MILLION
150
MARKETS
People
58,000 in 60 countries
60
COUNTRIES
16

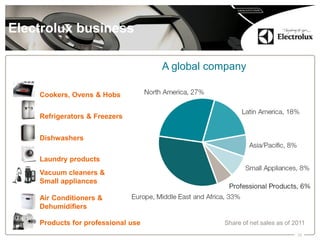

Electrolux business
A global company
Cookers, Ovens & Hobs
Refrigerators & Freezers
Dishwashers
Laundry products
Vacuum cleaners &
Small appliances
Air Conditioners &
Dehumidifiers
Products for professional use
Share of net sales as of 2011
 Buck Consultants International, 2013
17

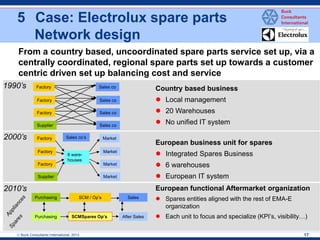

From a country based, uncoordinated spare parts service set up, via a centrally coordinated, regional spare parts set up towards a customer centric driven set up balancing cost and service
Sales co
Sales co
Sales co
Sales co
Factory
Supplier
Factory
Factory
Country based business
Local management
20 Warehouses
No unified IT system
European business unit for spares
Integrated Spares Business
6 warehouses
European IT system
Market
Market
Market
Market
6 ware- houses
Factory
Supplier
Factory
Factory
Sales co’s
European functional Aftermarket organization
Spares entities aligned with the rest of EMA-E organization
Each unit to focus and specialize (KPI’s, visibility…)
Purchasing
Purchasing
SCM / Op’s
SCMSpares Op’s
Sales
After Sales
1990’s
2000’s
2010’s
5Case: Electrolux spare parts Network design
 Buck Consultants International, 2013
18
Jönköping
Newcastle
Madrid
Maniago
Rothenburg
Zurich
6 regional distribution centers keeping (almost) all spare codes
Prepacking at each DC
Total headcount > 350FTE
35.000 customer order lines daily
>300.000 active spare codes
160.000 spare codes in stock
100 new spare parts introduced every day
Less than 4% of spare codes represent > 75% of sales volume
>80% of spare codes represent less than 4% of sales volume
The current supply chain set-up provides high customer service in terms of product availability (>97% on order line level) and short order lead times
DELIVERY
 Buck Consultants International, 2013
19

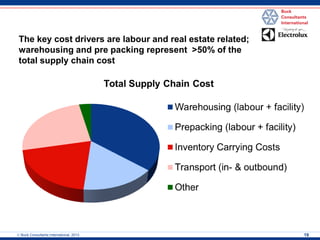

The key cost drivers are labour and real estate related; warehousing and pre packing represent >50% of the total supply chain cost

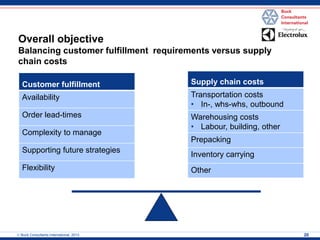

Overall objective Balancing customer fulfillment requirements versus supply chain costs
 Buck Consultants International, 2013
20
Customer fulfillment
Availability
Order lead-times
Complexity to manage
Supporting future strategies
Flexibility
Supply chain costs
Transportation costs
•In-, whs-whs, outbound
Warehousing costs
•Labour, building, other
Prepacking
Inventory carrying
Other

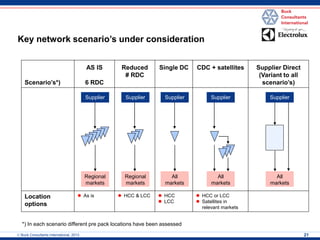

Scenario’s*)
AS IS
6 RDC
Reduced
# RDC
Single DC
CDC + satellites
Supplier Direct
(Variant to all scenario’s)
Location options
As is
HCC & LCC
HCC
LCC
HCC or LCC
Satellites in relevant markets
Key network scenario’s under consideration
*) In each scenario different pre pack locations have been assessed
Supplier
Supplier
Supplier
Supplier
Supplier
Regional markets
Regional markets
All markets
All markets
All
markets
 Buck Consultants International, 2013
21

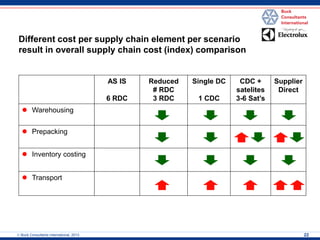

Different cost per supply chain element per scenario result in overall supply chain cost (index) comparison
AS IS
6 RDC
Reduced
# RDC
3 RDC
Single DC
1 CDC
CDC + satelites
3-6 Sat’s
Supplier Direct
Warehousing
Prepacking
Inventory costing
Transport
22
 Buck Consultants International, 2013
 Buck Consultants International, 2013
23

Weighed scores of Customer- and Internal Facing aspects result in comparison of scenarios on quality / service elements
Qualitative aspect
Weight
As ls
Single DC
RDC set up (less RDC)
CDC + Sat
Order Lead Time
x%
Immediate availability
x%
Ease of inventory management
x%
Ease of transport management
x%
Ease of Pre-Pack operations and management
x%
TOTAL Quality score
100%
Depending the relevance (weight) of each aspect
Low score
High score
Customer
facing
Internal
facing
24
Weighted quality scores
2.5
4.5
3
4
3.5
Theoretic optimum
AS IS
The project specific cost – quality matrix to support strategic decisions for balancing cost and service / quality
High quality
Low Cost
High Cost
Low quality
More DCs (10)
CDC+SAT’s
Central DC
3 RDCs
CDC East Europe
Cost Index
 Buck Consultants International, 2013
30%
 Buck Consultants International, 2013
25

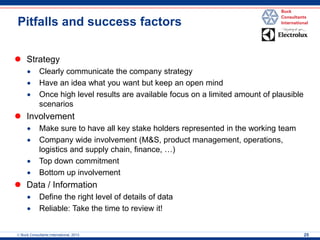

Pitfalls and success factors
Strategy
Clearly communicate the company strategy
Have an idea what you want but keep an open mind
Once high level results are available focus on a limited amount of plausible scenarios
Involvement
Make sure to have all key stake holders represented in the working team
Company wide involvement (M&S, product management, operations, logistics and supply chain, finance, …)
Top down commitment
Bottom up involvement
Data / Information
Define the right level of details of data
Reliable: Take the time to review it!
 Buck Consultants International, 2013
26
Final conclusion
Road map coming 3 years
Implement the plan
Harvest the benefits
Next steps
 Buck Consultants International, 2013
27
5 Key takeaways
Strategic network design adds value
There are various building blocks to optimize
Priorities alongside the axles of cost or service drive the preferred network solution
A structured approach, involving company wide stakeholders, is key to success
28
Questions?
 Buck Consultants International, 2013
 Buck Consultants International, 2013
Buck Consultants International in a nutshell
Areas of activity
Development of European Business Strategies
Global Supply Chain Optimization
Real estate strategy / location advice
From Strategy to realization
Profile
Established in Nijmegen, the Netherlands in 1985
Employs 65 full-time professionals
Performed studies in more than 50 countries in 5 continents
Milan
Madrid
Frankfurt
Paris
London
Brussels
The Hague
Nijmegen HQ
Chicago, IL
Office locations
Partners in
US :
Far East :
Russia :
29
30
Buck Consultants International supply chain services offering
Supply Chain strategy
development
Supply chain optimization (network analyses)
Distribution centre and manufacturing facility operations audit and design
Location selection for DC or
manufacturing site
Logistics outsourcing (3PL selection processes)
Transport & carrier
optimization
Inventory analysis and
optimization
 Buck Consultants International, 2013
31
Manufacturing /
Aftermarket Other references
Sample BCI references
 Buck Consultants International, 2013

Paolo Gallibci, Electrolux presentation at Spare Parts 2013

  • 1.
    Network Optimization asnext step in Spare Parts Cost and Service Optimization How to create Value? Paolo Galli European Logistics EMA-EMEA Ops E: paolo.galli@electrolux.it T: +39 0434 394408 Carlo Peters Supply Chain Strategy Consultant E: carlo.peters@bciglobal.com T: +31 622 917 254 Stockholm, February 7, 2013
  • 2.
     Buck ConsultantsInternational, 2013 1 Contents 1 The dynamics in spare parts / AMS services 2 The added value of Network Design 3The building blocks of an intelligent Supply Chain 4Introduction Electrolux 5Case Electrolux spare parts network design 6Key takeaway’s
  • 3.
     Buck ConsultantsInternational, 2013 2 After Market Service (AMS) Creating value After market service is the combined offering of parts, services and information that delivers maximum customer satisfaction and ongoing customer loyalty in terms of exceeding the customer’s expectations in the application of the purchased product
  • 4.
     Buck ConsultantsInternational, 2013 3 1 The dynamics in spare parts / AMS services FROM Focus on forward supply chain of Finished Goods Cost Center High inventories Western European Focus Single sales channels Own operations Single supply chain for FG and Parts TO Focus on aftermarket, incl. spare parts, returns, asset recovery, etc. Profit Center Reducing inventories New Geographies such as Russia, Turkey, Mexico, etc. Multiple sales channels incl. internet Outsourcing of aftermarket functions Differentiated supply chains Key Trends & Developments
  • 5.
     Buck ConsultantsInternational, 2013 4 2 The added value of Supply Chain Network Design Range of Optimal Values Annual Cost Transfer Freight Fixed Cost Outbound Freight Number Of Facilities Few Many Total Cost Inventory Carrying Cost A Supply Chain network has an optimum number of facilities depending the relevance of in- and outbound transport cost versus inventory and warehousing costs
  • 6.
    The majority ofa supply chain’s lifecycle costs are locked-in at the start… Decisions Solutions Value Advanced Planning and Scheduling ERP / MRP Execution Strategic and Tactical Supply Chain Optimization 80% 20% Operational Tactical Strategic Source: AMR Research Manufacturing/supplier network Distribution network Inventory Locations Inventory Levels Service policies As the majority of the supply chain costs are locked in the infrastructure, network design is critical in order to realize step changes  Buck Consultants International, 2013 5
  • 7.
    Operational Tactical Strategic Supply chain configuration Inventory deployment Service level /Safety stock targets Allocation Capacitated scheduling Available-to-promise Purchase order management Transaction management Bill-of-materials management Performance monitoring Event/alert management Connectivity Network footprint design Transport lanes Facility numbers/locations Strategic network design is directly linked to Inventory Policies; where to start?  Buck Consultants International, 2013 6 Network Design Inventory Policy Advanced Planning and Scheduling MRP / ERP Execution
  • 8.
     Buck ConsultantsInternational, 2013 7 3The building blocks of an intelligent Supply Chain Differentiated service offering Differentiated Supply Chain set up Pre-pack and warehousing locations SC Visibility and transport management Collaboration and outsourcing Inventory optimization
  • 9.
    8 Europe in4 hours Advanced Network ●Centralized backup-inventory ●Localized emergency inventory in selected cities in each country ●Shared infrastructure ●Pick-to-order 24 x 7 x 365 ●Individual transportation to customers and engineers ●Consolidated replenishment transportation ●Delivery within 4 hours of order Europe in 24-48 hours Centralized Solution ●Centralized inventory ●Shared infrastructure ●Scheduled batch-run picks ●Late cut-offs ●Consolidated transportation to customers and engineers ●Delivery on next business day Europe in 2 Hours High Density Network ●Centralized backup- inventory, eventually hosted in two locations ●Localized emergency inventory using a high density storage network to achieve shortest lead times ●Shared infrastructure ●Pick-to-order 24 x 7 x 365 ●Individual transportation to customers and engineers ●Consolidated replenishment transportation ●Delivery within 2 hours of order  Buck Consultants International, 2013 Differentiated service offering Can be accomplished through the network and through transport modalities used
  • 10.
     Buck ConsultantsInternational, 2013 9 Customers Distributor Dealer Direct to retail End customer Customer site Service technician Dependent on the product, product characteristics and product/market combinations a variety of supply chains solutions can be developed Source Source Hub EDC RDC / SDC Hub MSP Activities Milkruns Production Repair Activities Consoli- dation Deconsoli- dation Activities VAL Merge in transit Cross-dock Repair Inventory Postponed manufacturing Prepack Activities VAL Merge in transit Cross-dock Repair Inventory Prepack Activities Cross-dock Consoli- dation Deconsoli- dation Activities VAL Repair Inventory Consignment stock Critical parts Prepack PU Activities PuDo / Kiala locations Lockers Garage box / Van Markets Markets Markets Differentiated Supply Chain set up
  • 11.
     Buck ConsultantsInternational, 2013 10 Pre-pack and warehouse locations If labor and warehousing costs are the key drivers, low labor costs countries can be favorable for labor intensive pre-pack and warehouse operations Low labor cost countries Labor cost index Warehouse rent index Source: IMD 2012
  • 12.
    Inbound Logistics Suppliers Receiving Customer Manufacturer Customer Channels Outbound Logistics Return Management Multi Modal Control Tower End-to-end transportation Management across the supply chain KPI metrics and reporting, QBR reviews with vendors, freight invoicing and auditing Sea Freight Air Freight Warehousing & Distribution Last Mile / Road & Rail Integrators Compliance & Documents SC visibility and transport management Multi Modal Control Tower allowing for end to end visibility and continuous optimization of cost, quality and service  Buck Consultants International, 2013 11
  • 13.
    Several collaboration initiativeshave emerged; some are outsourced, other are managed amongst brand owners Collaboration and Outsourcing  Buck Consultants International, 2013 12
  • 14.
    Inventory optimization Excessinventory and added cost Central inventory management visibility and stocking decisions are needed over to optimize over all echelons  Buck Consultants International, 2013 13
  • 15.
     Buck ConsultantsInternational, 2013 14 BCI methodology for strategic network design & optimization Design and optimization of a complex service supply chain structure requires a proven and well-structured methodology in combination with powerful optimization tools Start-up Understand & Analyze Design Detail & Validate Document & Plan Implement Project management • Objectives • Constraints • Scope • Team • Level of detail • Project plan • Business CSFs • Operations • Level of detail • Data collection • Baseline model •Scenarios •Alt. Locations •Alt. DC network •Alt. service levels •Sensitivities • Populate • Run • Analyze/Debug • Robustness test • Rank / Select Impact analysis • Organization • Systems • HR • Risk • Service Change Mngt. A phased approach with clear deliverables per phase
  • 16.
    15 Electrolux 2011 Position Sales SEK 102 billion Op income SEK 3.2 billion Sales in more than 150 markets A world leader in appliances Products More than 40 million products per year To meet the real needs of consumers and professionals 40 MILLION 150 MARKETS People 58,000 in 60 countries 60 COUNTRIES
  • 17.
    16 Electrolux business A global company Cookers, Ovens & Hobs Refrigerators & Freezers Dishwashers Laundry products Vacuum cleaners & Small appliances Air Conditioners & Dehumidifiers Products for professional use Share of net sales as of 2011
  • 18.
     Buck ConsultantsInternational, 2013 17 From a country based, uncoordinated spare parts service set up, via a centrally coordinated, regional spare parts set up towards a customer centric driven set up balancing cost and service Sales co Sales co Sales co Sales co Factory Supplier Factory Factory Country based business Local management 20 Warehouses No unified IT system European business unit for spares Integrated Spares Business 6 warehouses European IT system Market Market Market Market 6 ware- houses Factory Supplier Factory Factory Sales co’s European functional Aftermarket organization Spares entities aligned with the rest of EMA-E organization Each unit to focus and specialize (KPI’s, visibility…) Purchasing Purchasing SCM / Op’s SCMSpares Op’s Sales After Sales 1990’s 2000’s 2010’s 5Case: Electrolux spare parts Network design
  • 19.
     Buck ConsultantsInternational, 2013 18 Jönköping Newcastle Madrid Maniago Rothenburg Zurich 6 regional distribution centers keeping (almost) all spare codes Prepacking at each DC Total headcount > 350FTE 35.000 customer order lines daily >300.000 active spare codes 160.000 spare codes in stock 100 new spare parts introduced every day Less than 4% of spare codes represent > 75% of sales volume >80% of spare codes represent less than 4% of sales volume The current supply chain set-up provides high customer service in terms of product availability (>97% on order line level) and short order lead times DELIVERY
  • 20.
     Buck ConsultantsInternational, 2013 19 The key cost drivers are labour and real estate related; warehousing and pre packing represent >50% of the total supply chain cost
  • 21.
    Overall objective Balancingcustomer fulfillment requirements versus supply chain costs  Buck Consultants International, 2013 20 Customer fulfillment Availability Order lead-times Complexity to manage Supporting future strategies Flexibility Supply chain costs Transportation costs •In-, whs-whs, outbound Warehousing costs •Labour, building, other Prepacking Inventory carrying Other
  • 22.
    Scenario’s*) AS IS 6 RDC Reduced # RDC Single DC CDC + satellites Supplier Direct (Variant to all scenario’s) Location options As is HCC & LCC HCC LCC HCC or LCC Satellites in relevant markets Key network scenario’s under consideration *) In each scenario different pre pack locations have been assessed Supplier Supplier Supplier Supplier Supplier Regional markets Regional markets All markets All markets All markets  Buck Consultants International, 2013 21
  • 23.
    Different cost persupply chain element per scenario result in overall supply chain cost (index) comparison AS IS 6 RDC Reduced # RDC 3 RDC Single DC 1 CDC CDC + satelites 3-6 Sat’s Supplier Direct Warehousing Prepacking Inventory costing Transport 22  Buck Consultants International, 2013
  • 24.
     Buck ConsultantsInternational, 2013 23 Weighed scores of Customer- and Internal Facing aspects result in comparison of scenarios on quality / service elements Qualitative aspect Weight As ls Single DC RDC set up (less RDC) CDC + Sat Order Lead Time x% Immediate availability x% Ease of inventory management x% Ease of transport management x% Ease of Pre-Pack operations and management x% TOTAL Quality score 100% Depending the relevance (weight) of each aspect Low score High score Customer facing Internal facing
  • 25.
    24 Weighted qualityscores 2.5 4.5 3 4 3.5 Theoretic optimum AS IS The project specific cost – quality matrix to support strategic decisions for balancing cost and service / quality High quality Low Cost High Cost Low quality More DCs (10) CDC+SAT’s Central DC 3 RDCs CDC East Europe Cost Index  Buck Consultants International, 2013 30%
  • 26.
     Buck ConsultantsInternational, 2013 25 Pitfalls and success factors Strategy Clearly communicate the company strategy Have an idea what you want but keep an open mind Once high level results are available focus on a limited amount of plausible scenarios Involvement Make sure to have all key stake holders represented in the working team Company wide involvement (M&S, product management, operations, logistics and supply chain, finance, …) Top down commitment Bottom up involvement Data / Information Define the right level of details of data Reliable: Take the time to review it!
  • 27.
     Buck ConsultantsInternational, 2013 26 Final conclusion Road map coming 3 years Implement the plan Harvest the benefits Next steps
  • 28.
     Buck ConsultantsInternational, 2013 27 5 Key takeaways Strategic network design adds value There are various building blocks to optimize Priorities alongside the axles of cost or service drive the preferred network solution A structured approach, involving company wide stakeholders, is key to success
  • 29.
    28 Questions? Buck Consultants International, 2013
  • 30.
     Buck ConsultantsInternational, 2013 Buck Consultants International in a nutshell Areas of activity Development of European Business Strategies Global Supply Chain Optimization Real estate strategy / location advice From Strategy to realization Profile Established in Nijmegen, the Netherlands in 1985 Employs 65 full-time professionals Performed studies in more than 50 countries in 5 continents Milan Madrid Frankfurt Paris London Brussels The Hague Nijmegen HQ Chicago, IL Office locations Partners in US : Far East : Russia : 29
  • 31.
    30 Buck ConsultantsInternational supply chain services offering Supply Chain strategy development Supply chain optimization (network analyses) Distribution centre and manufacturing facility operations audit and design Location selection for DC or manufacturing site Logistics outsourcing (3PL selection processes) Transport & carrier optimization Inventory analysis and optimization  Buck Consultants International, 2013
  • 32.
    31 Manufacturing / Aftermarket Other references Sample BCI references  Buck Consultants International, 2013
