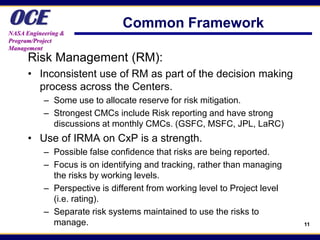

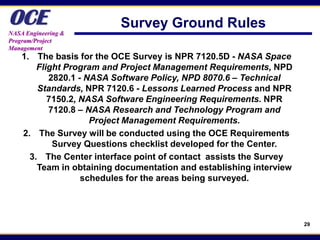

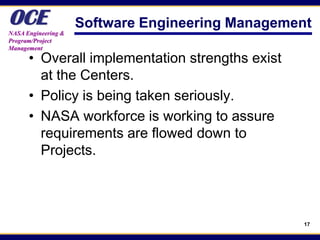

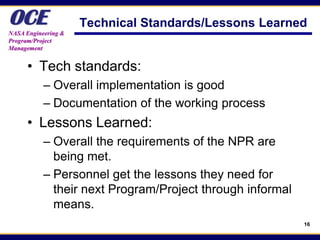

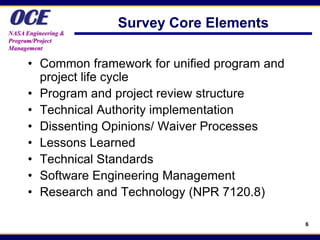

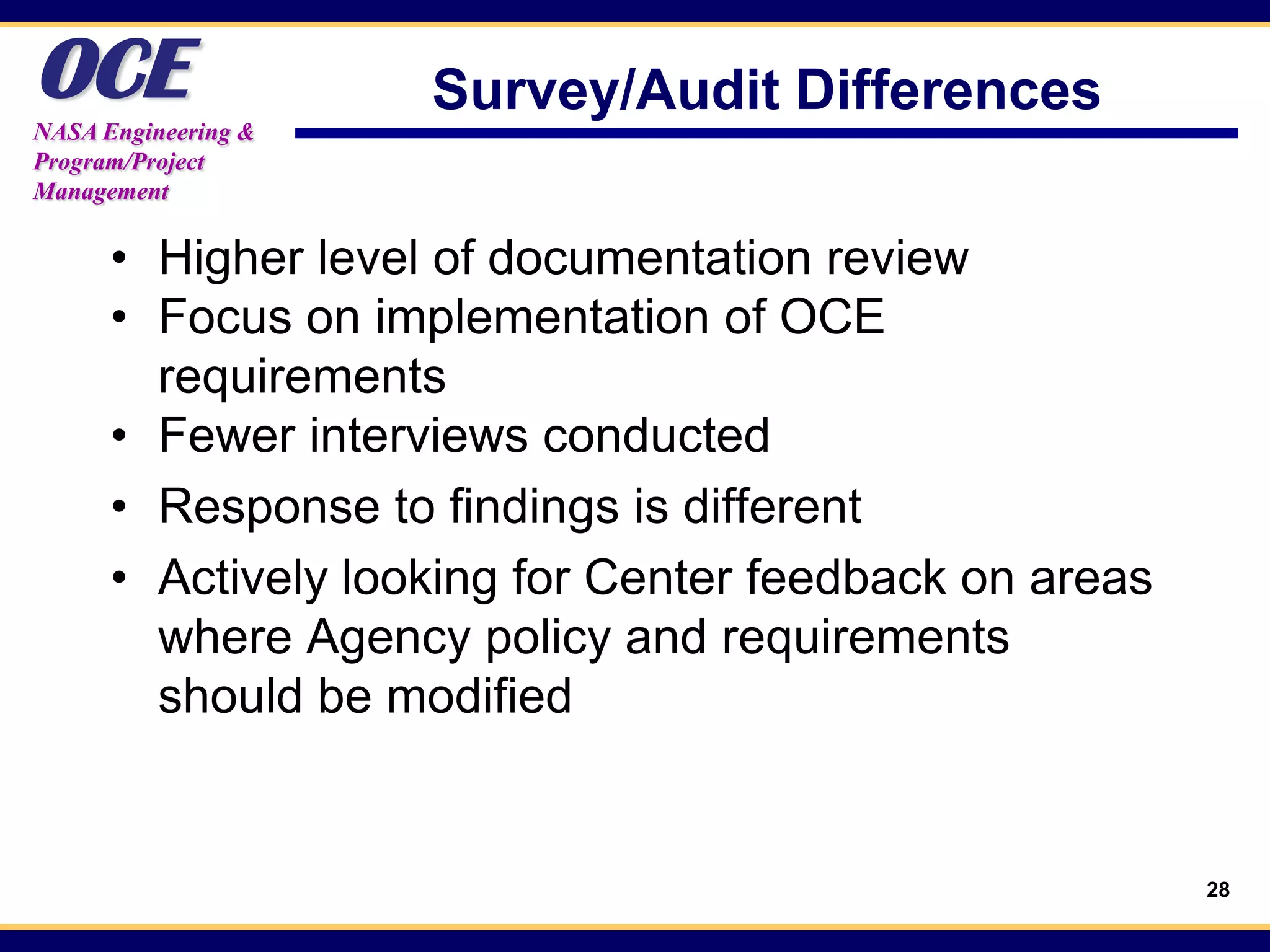

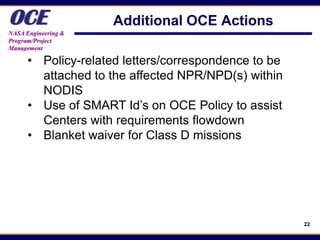

This document summarizes the findings of a NASA survey of various centers regarding compliance with Office of the Chief Engineer (OCE) policy. It describes the survey objectives, methodology, elements reviewed, and schedule. Some key findings included inconsistent implementation of configuration management, risk management, and technical authority across centers. Strengths identified included lessons learned processes and software engineering at JPL. Opportunities for improvement included updating directives, validating Earned Value Management Systems, and clarifying the roles of technical authority and systems engineering.
