NASA’s Next Generation Facilities

     William Tippin, DM, CMC
     June A. Grant, AIA, LEED AP
     Edward Weaver, AIA, LEED AP

    Academy of Program / Project &
    Engineering Leadership
    Project Management Challenge 2010

     February 2010

Used with Permission

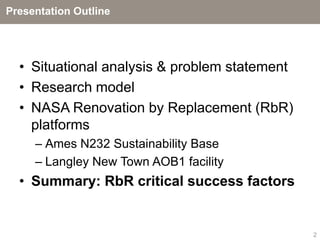

Presentation Outline

  • Situational analysis & problem statement
  • Research model
  • NASA Renovation by Replacement (RbR)
    platforms
     – Ames N232 Sustainability Base
     – Langley New Town AOB1 facility
  • Summary: RbR critical success factors

                                               2

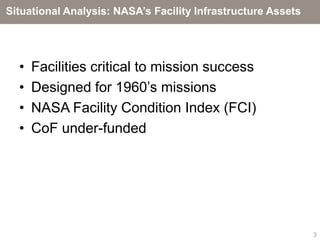

Situational Analysis: NASA’s Facility Infrastructure Assets

  •   Facilities critical to mission success
  •   Designed for 1960’s missions
  •   NASA Facility Condition Index (FCI)
  •   CoF under-funded

                                                              3
Situational Analysis: NASA’s Facility Infrastructure Assets

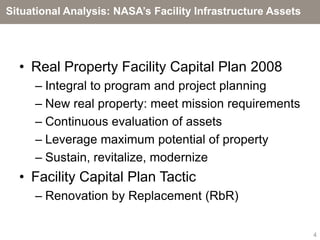

  • Real Property Facility Capital Plan 2008
     – Integral to program and project planning
     – New real property: meet mission requirements
     – Continuous evaluation of assets
     – Leverage maximum potential of property
     – Sustain, revitalize, modernize
  • Facility Capital Plan Tactic
     – Renovation by Replacement (RbR)

                                                              4

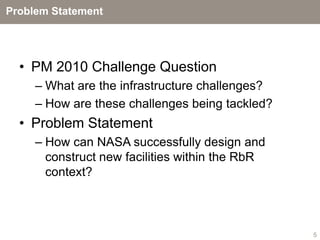

Problem Statement

  • PM 2010 Challenge Question
     – What are the infrastructure challenges?
     – How are these challenges being tackled?
  • Problem Statement
     – How can NASA successfully design and
       construct new facilities within the RbR
       context?

                                                 5
Research Model: Platform Methodology

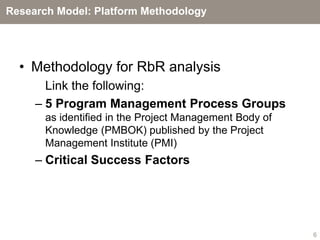

  • Methodology for RbR analysis
       Link the following:
     – 5 Program Management Process Groups
       as identified in the Project Management Body of
       Knowledge (PMBOK) published by the Project
       Management Institute (PMI)
     – Critical Success Factors

                                                         6
Project Management Group Process

                        Planning

                                     Close -
          Initiation   Execution
                                      Out

                       Monitoring
                           &          Final Result
                       Controlling

                                                     7

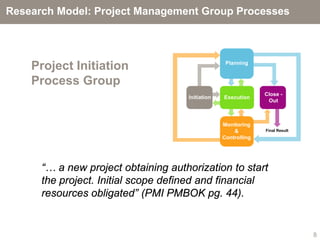

Research Model: Project Management Group Processes

    Project Initiation                             Planning

    Process Group
                                                                Close -
                                     Initiation   Execution
                                                                 Out

                                                  Monitoring
                                                      &         Final Result
                                                  Controlling

      “… a new project obtaining authorization to start
      the project. Initial scope defined and financial
      resources obligated” (PMI PMBOK pg. 44).

                                                                               8
Research Model: Project Management Group Processes

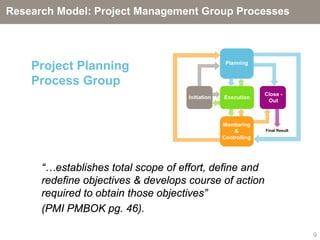

    Project Planning                               Planning

    Process Group
                                                                Close -
                                     Initiation   Execution
                                                                 Out

                                                  Monitoring
                                                      &         Final Result
                                                  Controlling

      “…establishes total scope of effort, define and
      redefine objectives & develops course of action
      required to obtain those objectives”
      (PMI PMBOK pg. 46).

                                                                               9
Research Model: Project Management Group Processes

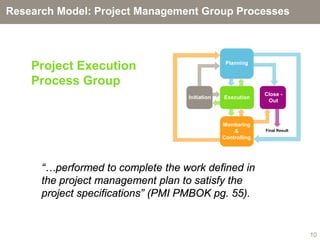

    Project Execution                            Planning

    Process Group
                                                              Close -
                                   Initiation   Execution
                                                               Out

                                                Monitoring
                                                    &         Final Result
                                                Controlling

      “…performed to complete the work defined in
      the project management plan to satisfy the
      project specifications” (PMI PMBOK pg. 55).

                                                                             10
Research Model: Project Management Group Processes

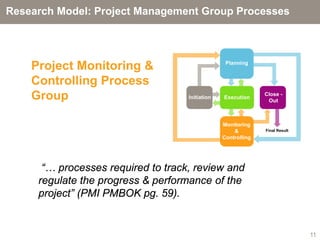

    Project Monitoring &                          Planning

    Controlling Process
    Group                           Initiation   Execution
                                                               Close -
                                                                Out

                                                 Monitoring
                                                     &         Final Result
                                                 Controlling

      “… processes required to track, review and
     regulate the progress & performance of the
     project” (PMI PMBOK pg. 59).

                                                                              11
Research Model: Project Management Group Processes

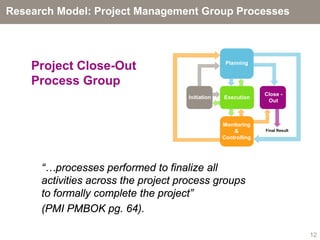

    Project Close-Out                              Planning

    Process Group
                                                                Close -
                                     Initiation   Execution
                                                                 Out

                                                  Monitoring
                                                      &         Final Result
                                                  Controlling

      “…processes performed to finalize all
      activities across the project process groups
      to formally complete the project”
      (PMI PMBOK pg. 64).

                                                                               12
Technology Strategy Program Management
Implementation Model
                                                 

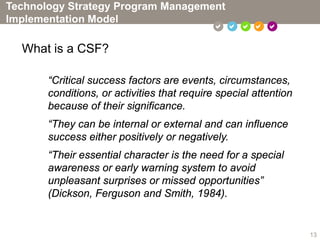

  What is a CSF?

       “Critical success factors are events, circumstances,
       conditions, or activities that require special attention
       because of their significance.
       “They can be internal or external and can influence
       success either positively or negatively.
       “Their essential character is the need for a special
       awareness or early warning system to avoid
       unpleasant surprises or missed opportunities”
       (Dickson, Ferguson and Smith, 1984).

                                                                  13

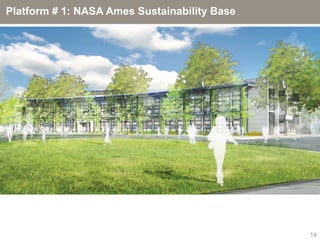

Platform # 1: NASA Ames Sustainability Base

                                              14

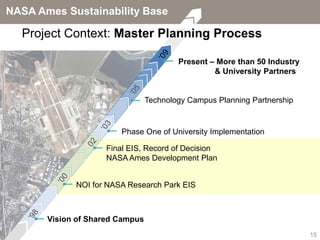

NASA Ames Sustainability Base

  Project Context: Master Planning Process

                                         Present – More than 50 Industry
                                                  & University Partners

                                 Technology Campus Planning Partnership

                        Phase One of University Implementation

                     Final EIS, Record of Decision
                     NASA Ames Development Plan

             NOI for NASA Research Park EIS

       Vision of Shared Campus
                                                                           15
NASA Ames Sustainability Base

  Project Context: Renovation by Replacement
  Outdated Facilities
  Demolition completed after FY08
  Age of Facilities for Completed Demolition Projects
  (post FY08)
  Building     Built     Age
                                               Planned RBR 2
  079          1944       65
                                               Facility (N268)
  083          1944       65
  093          1946       63
  113          1944       65
                                               Facilities to be
  118          1944       65                   demolished
  119          1944       65
  346          1950       59
  347          1942       67
  350          1950       59
  351          1950       59
  367          1948       61
  470          1933       76
  472          1961       48              RBR 1
  539          1972       37              Sustainability Base
  540          1972       37              (N232)
      Average Age:       59.4

  The average age of facilities demolished - over
  59 years.
  Total Demolished Facilities - 75,815 SF

                                                                  16

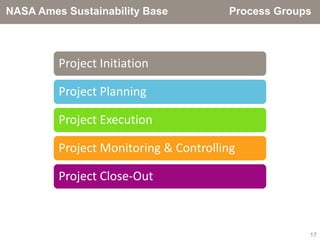

NASA Ames Sustainability Base          Process Groups

         Project Initiation

         Project Planning

         Project Execution

         Project Monitoring & Controlling

         Project Close-Out

                                                    17
NASA Ames Sustainability Base               Process Group
                                                Initiation

  Four Governing Principles
     – Create a Compelling Business Case
     – Realize a High-Performance Building
     – Incorporate NASA Technologies and
       Engineering Approaches
     – Meet Budget and Schedule Delivery Date:
        • $26m / July 1, 2009 (9-month design schedule vs.
          typical 18-months for same size and type)

                                                             18

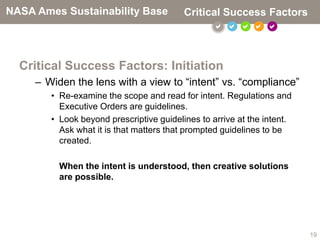

NASA Ames Sustainability Base             Critical Success Factors
                                                     

  Critical Success Factors: Initiation
     – Widen the lens with a view to “intent” vs. “compliance”
        • Re-examine the scope and read for intent. Regulations and
          Executive Orders are guidelines.
        • Look beyond prescriptive guidelines to arrive at the intent.
          Ask what it is that matters that prompted guidelines to be
          created.

          When the intent is understood, then creative solutions
          are possible.

                                                                         19
NASA Ames Sustainability Base          Process Group
                                          Planning

  The Eco-Framework
    –   Principles: unchanging
        values
    –   Goals: achievable objectives
    –   Strategies: means and
        methods
    –   Measureable Targets:
        quantifiable outcomes
    –   Verification & Update:
        metrics used to assess
        effectiveness of applied
        strategies

                                                       20
NASA Ames Sustainability Base           Critical Success Factors
                                                    

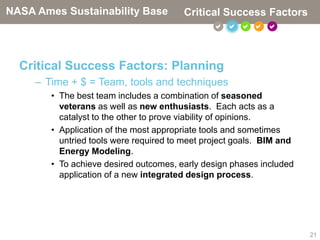

  Critical Success Factors: Planning
     – Time + $ = Team, tools and techniques
        • The best team includes a combination of seasoned
          veterans as well as new enthusiasts. Each acts as a
          catalyst to the other to prove viability of opinions.
        • Application of the most appropriate tools and sometimes
          untried tools were required to meet project goals. BIM and
          Energy Modeling.
        • To achieve desired outcomes, early design phases included
          application of a new integrated design process.

                                                                       21

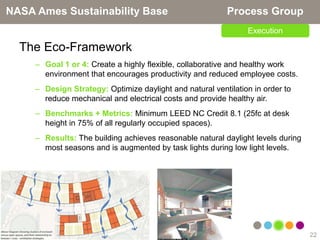

NASA Ames Sustainability Base                              Process Group
                                                                Execution

  The Eco-Framework
     – Goal 1 or 4: Create a highly flexible, collaborative and healthy work
       environment that encourages productivity and reduced employee costs.
     – Design Strategy: Optimize daylight and natural ventilation in order to
       reduce mechanical and electrical costs and provide healthy air.
     – Benchmarks + Metrics: Minimum LEED NC Credit 8.1 (25fc at desk
       height in 75% of all regularly occupied spaces).
     – Results: The building achieves reasonable natural daylight levels during
       most seasons and is augmented by task lights during low light levels.

                                                                                  22
NASA Ames Sustainability Base            Critical Success Factors
                                                     

  Critical Success Factors: Execution
     – Executive level support in times of “Black Swan”
       events
        • All projects will encounter unexpected events.
        • Events outside the Project Manager’s authority are “Black
          Swans.” Without support at the Executive Level, “Black
          Swans” can threaten the potential to achieve project goals.

                                                                        23

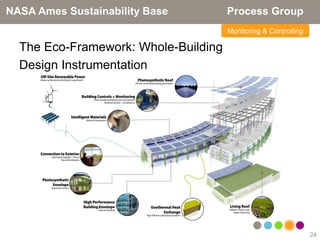

NASA Ames Sustainability Base         Process Group
                                      Monitoring & Controlling

  The Eco-Framework: Whole-Building
  Design Instrumentation

                                                                 24

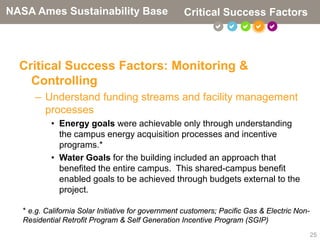

NASA Ames Sustainability Base                       Critical Success Factors
                                                                 

  Critical Success Factors: Monitoring &
    Controlling
      – Understand funding streams and facility management
        processes
           • Energy goals were achievable only through understanding
             the campus energy acquisition processes and incentive
             programs.*
           • Water Goals for the building included an approach that
             benefited the entire campus. This shared-campus benefit
             enabled goals to be achieved through budgets external to the
             project.

   * e.g. California Solar Initiative for government customers; Pacific Gas & Electric Non-
   Residential Retrofit Program & Self Generation Incentive Program (SGIP)
                                                                                              25

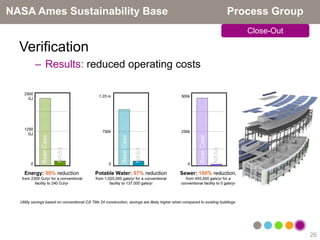

NASA Ames Sustainability Base             Process Group
                                             Close-Out

  Verification
     – Results: reduced operating costs

                                                          26
NASA Ames Sustainability Base             Critical Success Factors
                                                      

  Critical Success Factors: Close-Out
     – Real-time BIM model facilitates rapid response during
       bid process
        • The bid process is a very active period. However, with the
          BIM Model, disciplines were able to clarify, update,
          coordinate and re-issue complete drawings quickly.
        • While not technically a success factor, an added benefit to
          date of the BIM model has been the ability to go straight to
          computer-aided manufacturing (CAD/CAM).
        • The model being updated during construction and is
          scheduled to be the ‘as-built’ 3D record for Facilities
          Management use once the construction is complete.

                                                                         27
NASA Ames Sustainability Base         Critical Success Factors
                                               

  Create a Compelling Business Case

  Critical Success Factors Per Phase
     – Initiation: Widen the lens with a view to “intent” vs.
       “compliance”
     – Planning: Team, tools and techniques
     – Execution: Executive level support in times of “black
       swan” events
     – Monitoring & Controlling: Understanding funding
       streams and facility management processes
     – Close-Out: Real-time BIM model facilitates rapid
       response turn-around time during bid process

                                                                 28

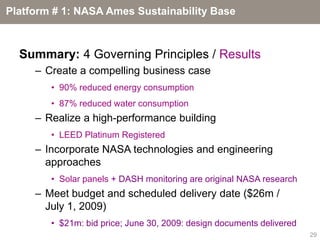

Platform # 1: NASA Ames Sustainability Base

  Summary: 4 Governing Principles / Results
     – Create a compelling business case
        • 90% reduced energy consumption
        • 87% reduced water consumption
     – Realize a high-performance building
        • LEED Platinum Registered
     – Incorporate NASA technologies and engineering
       approaches
        • Solar panels + DASH monitoring are original NASA research
     – Meet budget and scheduled delivery date ($26m /
       July 1, 2009)
        • $21m: bid price; June 30, 2009: design documents delivered
                                                                       29

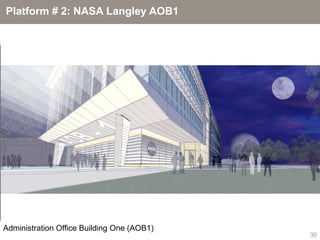

Platform # 2: NASA Langley AOB1

Administration Office Building One (AOB1)
                                            30

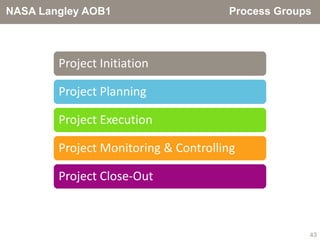

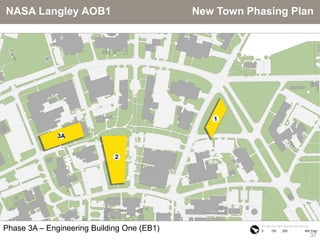

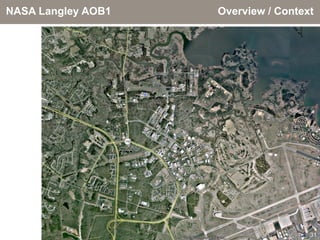

NASA Langley AOB1   Overview / Context

                                     31

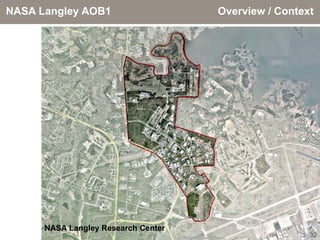

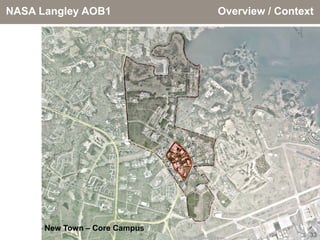

NASA Langley AOB1                    Overview / Context

      NASA Langley Research Center
                                                      32
NASA Langley AOB1              Overview / Context

      New Town – Core Campus
                                                33

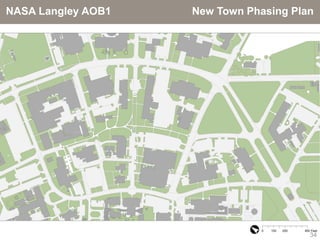

NASA Langley AOB1   New Town Phasing Plan

                                        34

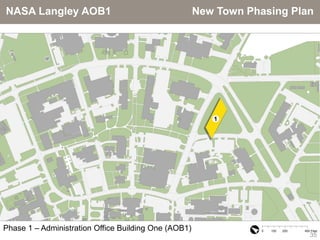

NASA Langley AOB1                                     New Town Phasing Plan

Phase 1 – Administration Office Building One (AOB1)
                                                                          35
NASA Langley AOB1                                  New Town Phasing Plan

Phase 2 – Integrated Engineering Services Building (IESB)
                                                                       36
NASA Langley AOB1                           New Town Phasing Plan

Phase 3A – Engineering Building One (EB1)
                                                                37
NASA Langley AOB1                           New Town Phasing Plan

Phase 3B – Engineering Building Two (EB2)
                                                                38

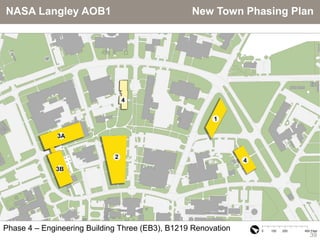

NASA Langley AOB1                                New Town Phasing Plan

Phase 4 – Engineering Building Three (EB3), B1219 Renovation
                                                                     39
NASA Langley AOB1                                 New Town Phasing Plan

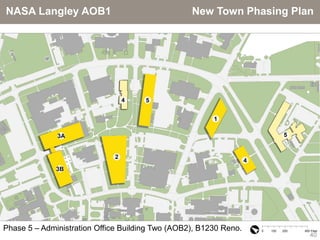

Phase 5 – Administration Office Building Two (AOB2), B1230 Reno.
                                                                      40

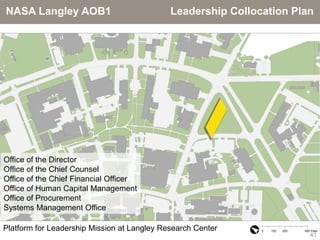

NASA Langley AOB1                            Leadership Collocation Plan

Office of the Director
Office of the Chief Counsel
Office of the Chief Financial Officer
Office of Human Capital Management
Office of Procurement
Systems Management Office

Platform for Leadership Mission at Langley Research Center
                                                                       41

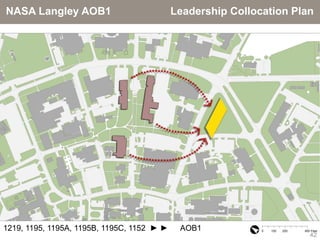

NASA Langley AOB1                           Leadership Collocation Plan

1219, 1195, 1195A, 1195B, 1195C, 1152 ► ►    AOB1
                                                                      42
NASA Langley AOB1                     Process Groups

        Project Initiation

        Project Planning

        Project Execution

        Project Monitoring & Controlling

        Project Close-Out

                                                   43

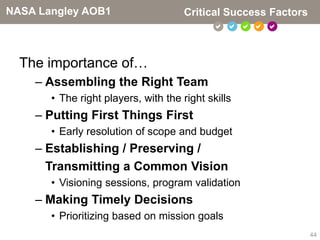

NASA Langley AOB1                     Critical Success Factors
                                                

  The importance of…
    – Assembling the Right Team
       • The right players, with the right skills
    – Putting First Things First
       • Early resolution of scope and budget
    – Establishing / Preserving /
      Transmitting a Common Vision
       • Visioning sessions, program validation
    – Making Timely Decisions
       • Prioritizing based on mission goals
                                                                 44
NASA Langley AOB1   Process Group
                        Initiation

                    Selecting
                    partners with
                    the expertise
                    and experience
                    required for the
                    program/project

                    Preparing in
                    advance by
                    doing your
                    homework

                                       45
NASA Langley AOB1   Process Group

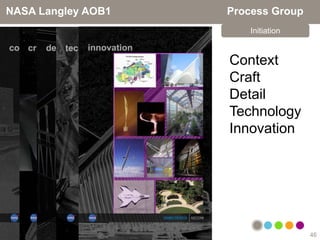

                       Initiation

                    Context
                    Craft
                    Detail
                    Technology
                    Innovation

                                    46
NASA Langley AOB1                  Critical Success Factors
                                            

  Critical Success Factors: Initiation
    – Assembling the right team
    – Putting first things first

                                                              47
NASA Langley AOB1   Process Group

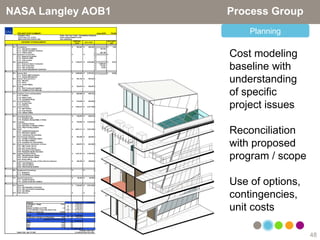

                        Planning

                    Cost modeling
                    baseline with
                    understanding
                    of specific
                    project issues

                    Reconciliation
                    with proposed
                    program / scope

                    Use of options,
                    contingencies,
                    unit costs

                                      48
NASA Langley AOB1                        Process Group
                                            Planning

  Visioning Session
    – Building Image
    – Organization & Culture
    – Space Solutions
    – Technology / Sustainability
    – Site Opportunities & Constraints

                                                         49
NASA Langley AOB1   Process Group
                       Planning

                    Asking
                    the Right
                    Questions

                    Listening
                    to the
                    Answers

                                    50
NASA Langley AOB1   Process Group

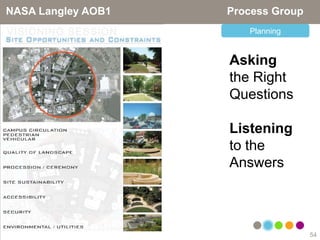

                       Planning

                    Asking
                    the Right
                    Questions

                    Listening
                    to the
                    Answers

                                    51
NASA Langley AOB1   Process Group
                       Planning

                    Asking
                    the Right
                    Questions

                    Listening
                    to the
                    Answers

                                    52
NASA Langley AOB1   Process Group
                       Planning

                    Asking
                    the Right
                    Questions

                    Listening
                    to the
                    Answers

                                    53
NASA Langley AOB1   Process Group
                       Planning

                    Asking
                    the Right
                    Questions

                    Listening
                    to the
                    Answers

                                    54
NASA Langley AOB1                              Process Group
                                                    Planning

  Key Project Drivers
    – Sustainability
       • Reduced O&M costs, energy efficiency, low
         environmental impact, occupant comfort, LEED
    – Interior Environment
       • Operational efficiency, functionality, daylighting
    – Pedestrian Orientation
       • Support goal of a pedestrian-focused campus core
    – Presence
       • Set the tone for a revitalized LaRC

                                                               55
NASA Langley AOB1   Process Group
                        Planning

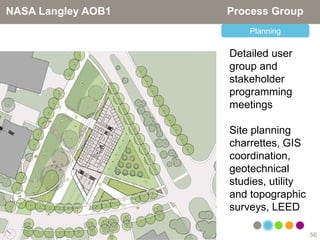

                    Detailed user
                    group and
                    stakeholder
                    programming
                    meetings

                    Site planning
                    charrettes, GIS
                    coordination,
                    geotechnical
                    studies, utility
                    and topographic
                    surveys, LEED

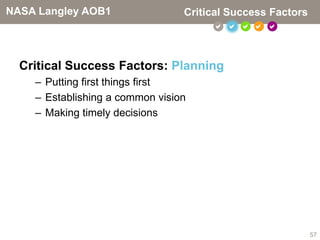

                                       56
NASA Langley AOB1                Critical Success Factors
                                          

  Critical Success Factors: Planning
    – Putting first things first
    – Establishing a common vision
    – Making timely decisions

                                                            57
NASA Langley AOB1   Process Group

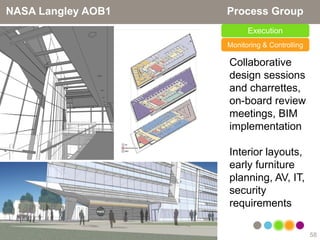

                          Execution
                    Monitoring & Controlling

                    Collaborative
                    design sessions
                    and charrettes,
                    on-board review
                    meetings, BIM
                    implementation

                    Interior layouts,
                    early furniture
                    planning, AV, IT,
                    security
                    requirements

                                               58
NASA Langley AOB1                  Critical Success Factors
                                            

  Critical Success Factors: Execution and
    Monitoring & Controlling
    – Putting first things first
    – Preserving a common vision
    – Making timely decisions

                                                              59
NASA Langley AOB1   Process Group

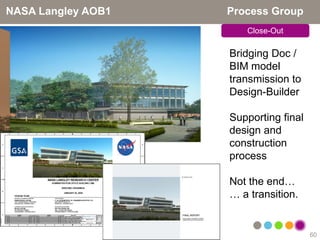

                       Close-Out

                    Bridging Doc /
                    BIM model
                    transmission to
                    Design-Builder

                    Supporting final
                    design and
                    construction
                    process

                    Not the end…
                    … a transition.

                                       60
NASA Langley AOB1                Critical Success Factors
                                          

  Critical Success Factors: Close-Out
    – Transmitting a common vision
    – Making timely decisions

                                                            61

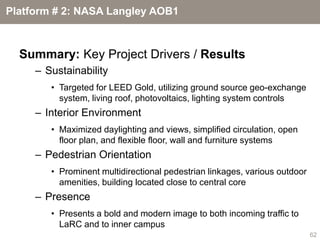

Platform # 2: NASA Langley AOB1

  Summary: Key Project Drivers / Results
     – Sustainability
        • Targeted for LEED Gold, utilizing ground source geo-exchange
          system, living roof, photovoltaics, lighting system controls
     – Interior Environment
        • Maximized daylighting and views, simplified circulation, open
          floor plan, and flexible floor, wall and furniture systems
     – Pedestrian Orientation
        • Prominent multidirectional pedestrian linkages, various outdoor
          amenities, building located close to central core
     – Presence
        • Presents a bold and modern image to both incoming traffic to
          LaRC and to inner campus
                                                                            62
Project Management Group Processes
                         Process

                        Planning

                                     Close -
          Initiation   Execution
                                      Out

                       Monitoring
                           &          Final Result
                       Controlling

                                                     63
Questions & Answers
     ?   ?   ?   ?   ?

                         64

William.tippin.update

  • 1.
    NASA’s Next GenerationFacilities William Tippin, DM, CMC June A. Grant, AIA, LEED AP Edward Weaver, AIA, LEED AP Academy of Program / Project & Engineering Leadership Project Management Challenge 2010 February 2010 Used with Permission
  • 2.
    Presentation Outline • Situational analysis & problem statement • Research model • NASA Renovation by Replacement (RbR) platforms – Ames N232 Sustainability Base – Langley New Town AOB1 facility • Summary: RbR critical success factors 2
  • 3.
    Situational Analysis: NASA’sFacility Infrastructure Assets • Facilities critical to mission success • Designed for 1960’s missions • NASA Facility Condition Index (FCI) • CoF under-funded 3
  • 4.
    Situational Analysis: NASA’sFacility Infrastructure Assets • Real Property Facility Capital Plan 2008 – Integral to program and project planning – New real property: meet mission requirements – Continuous evaluation of assets – Leverage maximum potential of property – Sustain, revitalize, modernize • Facility Capital Plan Tactic – Renovation by Replacement (RbR) 4
  • 5.
    Problem Statement • PM 2010 Challenge Question – What are the infrastructure challenges? – How are these challenges being tackled? • Problem Statement – How can NASA successfully design and construct new facilities within the RbR context? 5
  • 6.
    Research Model: PlatformMethodology • Methodology for RbR analysis Link the following: – 5 Program Management Process Groups as identified in the Project Management Body of Knowledge (PMBOK) published by the Project Management Institute (PMI) – Critical Success Factors 6
  • 7.
    Project Management GroupProcess Planning Close - Initiation Execution Out Monitoring & Final Result Controlling 7
  • 8.
    Research Model: ProjectManagement Group Processes Project Initiation Planning Process Group Close - Initiation Execution Out Monitoring & Final Result Controlling “… a new project obtaining authorization to start the project. Initial scope defined and financial resources obligated” (PMI PMBOK pg. 44). 8
  • 9.
    Research Model: ProjectManagement Group Processes Project Planning Planning Process Group Close - Initiation Execution Out Monitoring & Final Result Controlling “…establishes total scope of effort, define and redefine objectives & develops course of action required to obtain those objectives” (PMI PMBOK pg. 46). 9
  • 10.
    Research Model: ProjectManagement Group Processes Project Execution Planning Process Group Close - Initiation Execution Out Monitoring & Final Result Controlling “…performed to complete the work defined in the project management plan to satisfy the project specifications” (PMI PMBOK pg. 55). 10
  • 11.
    Research Model: ProjectManagement Group Processes Project Monitoring & Planning Controlling Process Group Initiation Execution Close - Out Monitoring & Final Result Controlling “… processes required to track, review and regulate the progress & performance of the project” (PMI PMBOK pg. 59). 11
  • 12.
    Research Model: ProjectManagement Group Processes Project Close-Out Planning Process Group Close - Initiation Execution Out Monitoring & Final Result Controlling “…processes performed to finalize all activities across the project process groups to formally complete the project” (PMI PMBOK pg. 64). 12
  • 13.
    Technology Strategy ProgramManagement Implementation Model      What is a CSF? “Critical success factors are events, circumstances, conditions, or activities that require special attention because of their significance. “They can be internal or external and can influence success either positively or negatively. “Their essential character is the need for a special awareness or early warning system to avoid unpleasant surprises or missed opportunities” (Dickson, Ferguson and Smith, 1984). 13
  • 14.
    Platform # 1:NASA Ames Sustainability Base 14
  • 15.
    NASA Ames SustainabilityBase Project Context: Master Planning Process Present – More than 50 Industry & University Partners Technology Campus Planning Partnership Phase One of University Implementation Final EIS, Record of Decision NASA Ames Development Plan NOI for NASA Research Park EIS Vision of Shared Campus 15
  • 16.
    NASA Ames SustainabilityBase Project Context: Renovation by Replacement Outdated Facilities Demolition completed after FY08 Age of Facilities for Completed Demolition Projects (post FY08) Building Built Age Planned RBR 2 079 1944 65 Facility (N268) 083 1944 65 093 1946 63 113 1944 65 Facilities to be 118 1944 65 demolished 119 1944 65 346 1950 59 347 1942 67 350 1950 59 351 1950 59 367 1948 61 470 1933 76 472 1961 48 RBR 1 539 1972 37 Sustainability Base 540 1972 37 (N232) Average Age: 59.4 The average age of facilities demolished - over 59 years. Total Demolished Facilities - 75,815 SF 16
  • 17.
    NASA Ames SustainabilityBase Process Groups Project Initiation Project Planning Project Execution Project Monitoring & Controlling Project Close-Out 17
  • 18.
    NASA Ames SustainabilityBase Process Group Initiation Four Governing Principles – Create a Compelling Business Case – Realize a High-Performance Building – Incorporate NASA Technologies and Engineering Approaches – Meet Budget and Schedule Delivery Date: • $26m / July 1, 2009 (9-month design schedule vs. typical 18-months for same size and type) 18
  • 19.
    NASA Ames SustainabilityBase Critical Success Factors      Critical Success Factors: Initiation – Widen the lens with a view to “intent” vs. “compliance” • Re-examine the scope and read for intent. Regulations and Executive Orders are guidelines. • Look beyond prescriptive guidelines to arrive at the intent. Ask what it is that matters that prompted guidelines to be created. When the intent is understood, then creative solutions are possible. 19
  • 20.
    NASA Ames SustainabilityBase Process Group Planning The Eco-Framework – Principles: unchanging values – Goals: achievable objectives – Strategies: means and methods – Measureable Targets: quantifiable outcomes – Verification & Update: metrics used to assess effectiveness of applied strategies 20
  • 21.
    NASA Ames SustainabilityBase Critical Success Factors      Critical Success Factors: Planning – Time + $ = Team, tools and techniques • The best team includes a combination of seasoned veterans as well as new enthusiasts. Each acts as a catalyst to the other to prove viability of opinions. • Application of the most appropriate tools and sometimes untried tools were required to meet project goals. BIM and Energy Modeling. • To achieve desired outcomes, early design phases included application of a new integrated design process. 21
  • 22.
    NASA Ames SustainabilityBase Process Group Execution The Eco-Framework – Goal 1 or 4: Create a highly flexible, collaborative and healthy work environment that encourages productivity and reduced employee costs. – Design Strategy: Optimize daylight and natural ventilation in order to reduce mechanical and electrical costs and provide healthy air. – Benchmarks + Metrics: Minimum LEED NC Credit 8.1 (25fc at desk height in 75% of all regularly occupied spaces). – Results: The building achieves reasonable natural daylight levels during most seasons and is augmented by task lights during low light levels. 22
  • 23.
    NASA Ames SustainabilityBase Critical Success Factors      Critical Success Factors: Execution – Executive level support in times of “Black Swan” events • All projects will encounter unexpected events. • Events outside the Project Manager’s authority are “Black Swans.” Without support at the Executive Level, “Black Swans” can threaten the potential to achieve project goals. 23
  • 24.
    NASA Ames SustainabilityBase Process Group Monitoring & Controlling The Eco-Framework: Whole-Building Design Instrumentation 24
  • 25.
    NASA Ames SustainabilityBase Critical Success Factors      Critical Success Factors: Monitoring & Controlling – Understand funding streams and facility management processes • Energy goals were achievable only through understanding the campus energy acquisition processes and incentive programs.* • Water Goals for the building included an approach that benefited the entire campus. This shared-campus benefit enabled goals to be achieved through budgets external to the project. * e.g. California Solar Initiative for government customers; Pacific Gas & Electric Non- Residential Retrofit Program & Self Generation Incentive Program (SGIP) 25
  • 26.
    NASA Ames SustainabilityBase Process Group Close-Out Verification – Results: reduced operating costs 26
  • 27.
    NASA Ames SustainabilityBase Critical Success Factors      Critical Success Factors: Close-Out – Real-time BIM model facilitates rapid response during bid process • The bid process is a very active period. However, with the BIM Model, disciplines were able to clarify, update, coordinate and re-issue complete drawings quickly. • While not technically a success factor, an added benefit to date of the BIM model has been the ability to go straight to computer-aided manufacturing (CAD/CAM). • The model being updated during construction and is scheduled to be the ‘as-built’ 3D record for Facilities Management use once the construction is complete. 27
  • 28.
    NASA Ames SustainabilityBase Critical Success Factors      Create a Compelling Business Case Critical Success Factors Per Phase – Initiation: Widen the lens with a view to “intent” vs. “compliance” – Planning: Team, tools and techniques – Execution: Executive level support in times of “black swan” events – Monitoring & Controlling: Understanding funding streams and facility management processes – Close-Out: Real-time BIM model facilitates rapid response turn-around time during bid process 28
  • 29.
    Platform # 1:NASA Ames Sustainability Base Summary: 4 Governing Principles / Results – Create a compelling business case • 90% reduced energy consumption • 87% reduced water consumption – Realize a high-performance building • LEED Platinum Registered – Incorporate NASA technologies and engineering approaches • Solar panels + DASH monitoring are original NASA research – Meet budget and scheduled delivery date ($26m / July 1, 2009) • $21m: bid price; June 30, 2009: design documents delivered 29
  • 30.
    Platform # 2:NASA Langley AOB1 Administration Office Building One (AOB1) 30
  • 31.
    NASA Langley AOB1 Overview / Context 31
  • 32.
    NASA Langley AOB1 Overview / Context NASA Langley Research Center 32
  • 33.
    NASA Langley AOB1 Overview / Context New Town – Core Campus 33
  • 34.
    NASA Langley AOB1 New Town Phasing Plan 34
  • 35.
    NASA Langley AOB1 New Town Phasing Plan Phase 1 – Administration Office Building One (AOB1) 35
  • 36.
    NASA Langley AOB1 New Town Phasing Plan Phase 2 – Integrated Engineering Services Building (IESB) 36
  • 37.
    NASA Langley AOB1 New Town Phasing Plan Phase 3A – Engineering Building One (EB1) 37
  • 38.
    NASA Langley AOB1 New Town Phasing Plan Phase 3B – Engineering Building Two (EB2) 38
  • 39.
    NASA Langley AOB1 New Town Phasing Plan Phase 4 – Engineering Building Three (EB3), B1219 Renovation 39
  • 40.
    NASA Langley AOB1 New Town Phasing Plan Phase 5 – Administration Office Building Two (AOB2), B1230 Reno. 40
  • 41.
    NASA Langley AOB1 Leadership Collocation Plan Office of the Director Office of the Chief Counsel Office of the Chief Financial Officer Office of Human Capital Management Office of Procurement Systems Management Office Platform for Leadership Mission at Langley Research Center 41
  • 42.
    NASA Langley AOB1 Leadership Collocation Plan 1219, 1195, 1195A, 1195B, 1195C, 1152 ► ► AOB1 42
  • 43.
    NASA Langley AOB1 Process Groups Project Initiation Project Planning Project Execution Project Monitoring & Controlling Project Close-Out 43
  • 44.
    NASA Langley AOB1 Critical Success Factors      The importance of… – Assembling the Right Team • The right players, with the right skills – Putting First Things First • Early resolution of scope and budget – Establishing / Preserving / Transmitting a Common Vision • Visioning sessions, program validation – Making Timely Decisions • Prioritizing based on mission goals 44
  • 45.
    NASA Langley AOB1 Process Group Initiation Selecting partners with the expertise and experience required for the program/project Preparing in advance by doing your homework 45
  • 46.
    NASA Langley AOB1 Process Group Initiation Context Craft Detail Technology Innovation 46
  • 47.
    NASA Langley AOB1 Critical Success Factors      Critical Success Factors: Initiation – Assembling the right team – Putting first things first 47
  • 48.
    NASA Langley AOB1 Process Group Planning Cost modeling baseline with understanding of specific project issues Reconciliation with proposed program / scope Use of options, contingencies, unit costs 48
  • 49.
    NASA Langley AOB1 Process Group Planning Visioning Session – Building Image – Organization & Culture – Space Solutions – Technology / Sustainability – Site Opportunities & Constraints 49
  • 50.
    NASA Langley AOB1 Process Group Planning Asking the Right Questions Listening to the Answers 50
  • 51.
    NASA Langley AOB1 Process Group Planning Asking the Right Questions Listening to the Answers 51
  • 52.
    NASA Langley AOB1 Process Group Planning Asking the Right Questions Listening to the Answers 52
  • 53.
    NASA Langley AOB1 Process Group Planning Asking the Right Questions Listening to the Answers 53
  • 54.
    NASA Langley AOB1 Process Group Planning Asking the Right Questions Listening to the Answers 54
  • 55.
    NASA Langley AOB1 Process Group Planning Key Project Drivers – Sustainability • Reduced O&M costs, energy efficiency, low environmental impact, occupant comfort, LEED – Interior Environment • Operational efficiency, functionality, daylighting – Pedestrian Orientation • Support goal of a pedestrian-focused campus core – Presence • Set the tone for a revitalized LaRC 55
  • 56.
    NASA Langley AOB1 Process Group Planning Detailed user group and stakeholder programming meetings Site planning charrettes, GIS coordination, geotechnical studies, utility and topographic surveys, LEED 56
  • 57.
    NASA Langley AOB1 Critical Success Factors      Critical Success Factors: Planning – Putting first things first – Establishing a common vision – Making timely decisions 57
  • 58.
    NASA Langley AOB1 Process Group Execution Monitoring & Controlling Collaborative design sessions and charrettes, on-board review meetings, BIM implementation Interior layouts, early furniture planning, AV, IT, security requirements 58
  • 59.
    NASA Langley AOB1 Critical Success Factors      Critical Success Factors: Execution and Monitoring & Controlling – Putting first things first – Preserving a common vision – Making timely decisions 59
  • 60.
    NASA Langley AOB1 Process Group Close-Out Bridging Doc / BIM model transmission to Design-Builder Supporting final design and construction process Not the end… … a transition. 60
  • 61.
    NASA Langley AOB1 Critical Success Factors      Critical Success Factors: Close-Out – Transmitting a common vision – Making timely decisions 61
  • 62.
    Platform # 2:NASA Langley AOB1 Summary: Key Project Drivers / Results – Sustainability • Targeted for LEED Gold, utilizing ground source geo-exchange system, living roof, photovoltaics, lighting system controls – Interior Environment • Maximized daylighting and views, simplified circulation, open floor plan, and flexible floor, wall and furniture systems – Pedestrian Orientation • Prominent multidirectional pedestrian linkages, various outdoor amenities, building located close to central core – Presence • Presents a bold and modern image to both incoming traffic to LaRC and to inner campus 62
  • 63.
    Project Management GroupProcesses Process Planning Close - Initiation Execution Out Monitoring & Final Result Controlling 63
  • 64.
