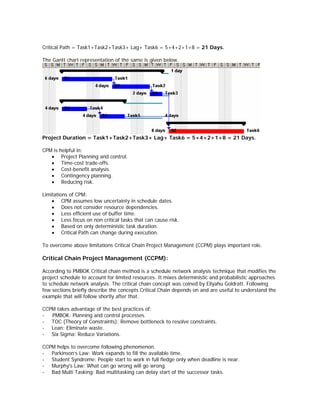

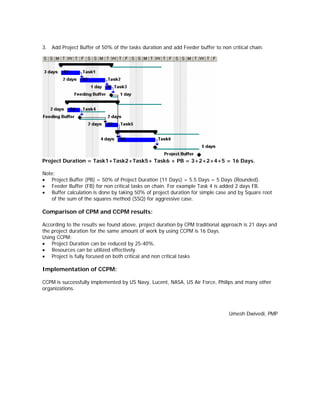

The document provides an overview of Critical Path Method (CPM) and Critical Chain Project Management (CCPM). CPM is a scheduling technique that identifies the critical path or longest path of tasks in a project network. It helps plan the project schedule but has limitations around uncertainty and resource constraints. CCPM modifies the CPM approach to better account for limited resources and uncertainties. It removes buffer times, identifies the critical chain of tasks, and adds buffers at the end of the project and after non-critical tasks. When applied to an example project, CCPM reduces the project duration from 21 to 16 days compared to the traditional CPM.
