1. Critical Path Method
(CPM)
2. Program Evaluation
Review Technique
(PERT)
1
Chapter Five: Scheduling
CPM and PERT
 Critical Path is one of the two ways or tools to
identify the paths through your project
 PERT stands for program evaluation review
technique
 CPM stands for critical path method
 CPM uses one time estimate, whereas PERT
uses three time estimates
 CPM is used when you are sure about the
duration of each activity
 PERT is used in more uncertain situations

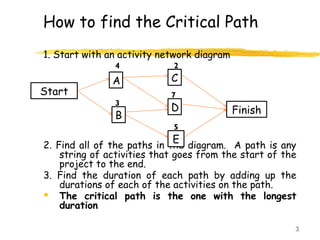

How to find the Critical Path
1. Start with an activity network diagram
2. Find all of the paths in the diagram. A path is any
string of activities that goes from the start of the
project to the end.
3. Find the duration of each path by adding up the
durations of each of the activities on the path.
 The critical path is the one with the longest
duration
Start
A
B
C
D
E
Finish
4
7
2
5
3
3

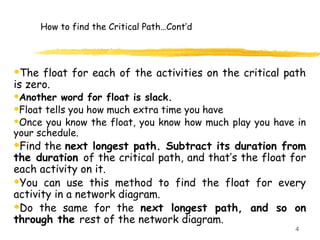

How to find the Critical Path…Cont’d
The float for each of the activities on the critical path
is zero.
Another word for float is slack.
Float tells you how much extra time you have
Once you know the float, you know how much play you have in
your schedule.
Find the next longest path. Subtract its duration from
the duration of the critical path, and that’s the float for
each activity on it.
You can use this method to find the float for every
activity in a network diagram.
Do the same for the next longest path, and so on
through the rest of the network diagram.
4

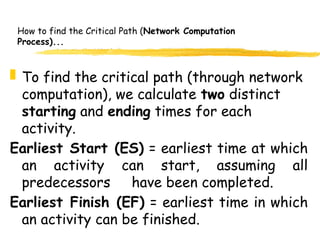

How to find the Critical Path (Network Computation
Process)...
 To find the critical path (through network
computation), we calculate two distinct
starting and ending times for each
activity.
Earliest Start (ES) = earliest time at which
an activity can start, assuming all
predecessors have been completed.
Earliest Finish (EF) = earliest time in which
an activity can be finished.
5

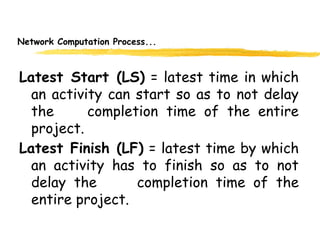

Network Computation Process...
Latest Start (LS) = latest time in which
an activity can start so as to not delay
the completion time of the entire
project.
Latest Finish (LF) = latest time by which
an activity has to finish so as to not
delay the completion time of the
entire project.
6

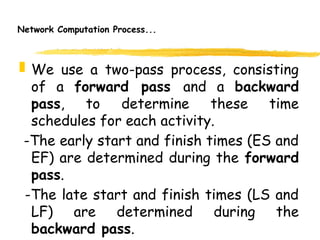

Network Computation Process...
 We use a two-pass process, consisting
of a forward pass and a backward
pass, to determine these time
schedules for each activity.
-The early start and finish times (ES and
EF) are determined during the forward
pass.
-The late start and finish times (LS and
LF) are determined during the
backward pass. 7

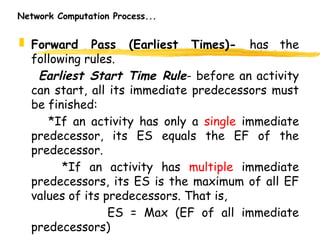

Network Computation Process...
 Forward Pass (Earliest Times)- has the
following rules.
Earliest Start Time Rule- before an activity
can start, all its immediate predecessors must
be finished:
*If an activity has only a single immediate
predecessor, its ES equals the EF of the
predecessor.
*If an activity has multiple immediate
predecessors, its ES is the maximum of all EF
values of its predecessors. That is,
ES = Max (EF of all immediate
predecessors) 8
Network Computation Process...

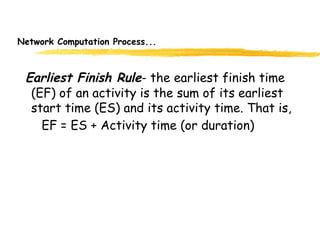

Earliest Finish Rule- the earliest finish time
(EF) of an activity is the sum of its earliest
start time (ES) and its activity time. That is,
EF = ES + Activity time (or duration)
9
Network Computation Process...

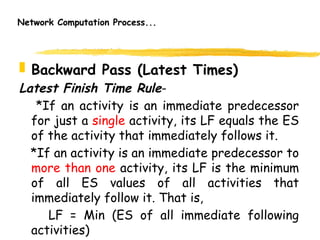

 Backward Pass (Latest Times)
Latest Finish Time Rule-
*If an activity is an immediate predecessor
for just a single activity, its LF equals the ES
of the activity that immediately follows it.
*If an activity is an immediate predecessor to
more than one activity, its LF is the minimum
of all ES values of all activities that
immediately follow it. That is,
LF = Min (ES of all immediate following
activities) 10
Network Computation Process...

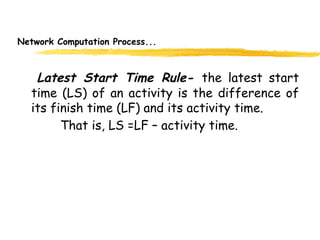

Latest Start Time Rule- the latest start
time (LS) of an activity is the difference of
its finish time (LF) and its activity time.
That is, LS =LF – activity time.
11

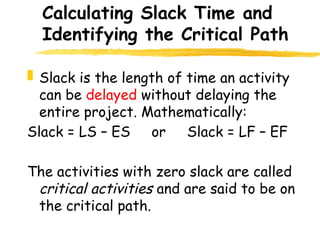

Calculating Slack Time and
Identifying the Critical Path
 Slack is the length of time an activity
can be delayed without delaying the
entire project. Mathematically:
Slack = LS – ES or Slack = LF – EF
The activities with zero slack are called
critical activities and are said to be on
the critical path.
12
Calculating Slack Time and Identifying the Critical Path…..
 The critical path is a continuous path
through the project network that:
Starts at the first activity in the project.
Terminates at the last activity in the
project.
Includes only critical activities (i.e.,
activities with zero slack time).
13
Network Computation Process...

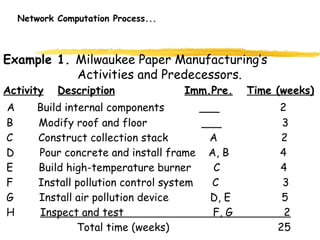

Example 1. Milwaukee Paper Manufacturing’s
Activities and Predecessors.
Activity Description Imm.Pre. Time (weeks)
A Build internal components ___ 2
B Modify roof and floor ___ 3
C Construct collection stack A 2
D Pour concrete and install frame A, B 4
E Build high-temperature burner C 4
F Install pollution control system C 3
G Install air pollution device D, E 5
H Inspect and test F, G 2
Total time (weeks) 25
Network Computation Process...
Required:
1. Draw AON networks for Milwaukee Papers.
2. Determine the earliest and latest times for
the activities.
3. Calculate the slack time and identify the
critical path.
15

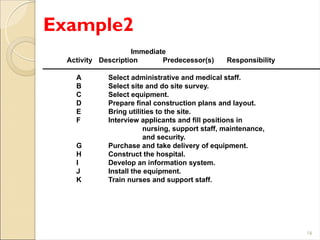

Example2
16
Immediate
Activity Description Predecessor(s) Responsibility
A Select administrative and medical staff.
B Select site and do site survey.
C Select equipment.
D Prepare final construction plans and layout.
E Bring utilities to the site.
F Interview applicants and fill positions in
nursing, support staff, maintenance,
and security.
G Purchase and take delivery of equipment.
H Construct the hospital.
I Develop an information system.
J Install the equipment.
K Train nurses and support staff.
Example
17

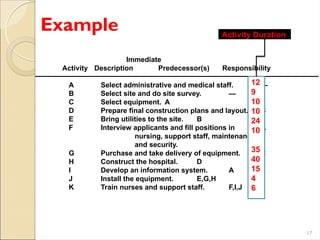

Immediate
Activity Description Predecessor(s) Responsibility
A Select administrative and medical staff. —
B Select site and do site survey. —
C Select equipment. A
D Prepare final construction plans and layout. B
E Bring utilities to the site. B
F Interview applicants and fill positions in A
nursing, support staff, maintenance,
and security.
G Purchase and take delivery of equipment. C
H Construct the hospital. D
I Develop an information system. A
J Install the equipment. E,G,H
K Train nurses and support staff. F,I,J
12
9
10
10
24
10
35
40
15
4
6
Activity Duration

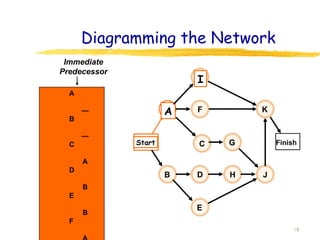

Diagramming the Network
18
Finish
Start
A
B
C
D
E
F
G
H
I
J
K
A
—
B
—
C
A
D
B
E
B
F
Immediate
Predecessor
Cont’d…
19
Finish
Start
A
B
C
D
E
F
G
H
I
J
K
Path Time
(wks)
A-I-K 33
A-F-K 28
A-C-G-J-K 67
B-D-H-J-K 69

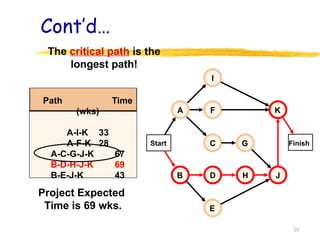

B-E-J-K 43

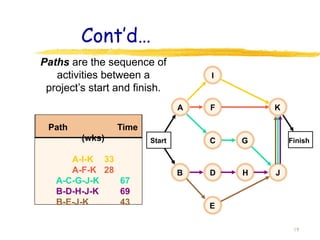

Paths are the sequence of
activities between a
project’s start and finish.
Cont’d…
20
Finish
Start
A
B
C
D
E
F
G
H
I
J
K
Path Time
(wks)
A-I-K 33
A-F-K 28
A-C-G-J-K 67
B-D-H-J-K 69
B-E-J-K 43
Project Expected
Time is 69 wks.
The critical path is the
longest path!
2. Program Evaluation and Review
Technique (PERT)
22

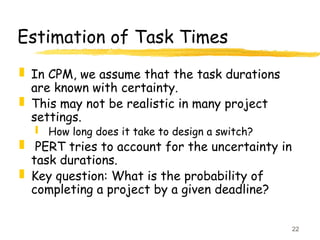

Estimation of Task Times
 In CPM, we assume that the task durations
are known with certainty.
 This may not be realistic in many project
settings.
 How long does it take to design a switch?
 PERT tries to account for the uncertainty in
task durations.
 Key question: What is the probability of
completing a project by a given deadline?
23

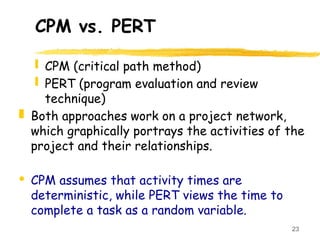

CPM vs. PERT
 CPM (critical path method)
 PERT (program evaluation and review
technique)
 Both approaches work on a project network,
which graphically portrays the activities of the
project and their relationships.
· CPM assumes that activity times are
deterministic, while PERT views the time to
complete a task as a random variable.
24

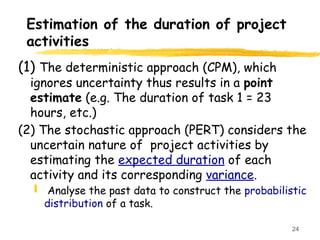

Estimation of the duration of project
activities
(1) The deterministic approach (CPM), which
ignores uncertainty thus results in a point
estimate (e.g. The duration of task 1 = 23
hours, etc.)
(2) The stochastic approach (PERT) considers the
uncertain nature of project activities by
estimating the expected duration of each
activity and its corresponding variance.
 Analyse the past data to construct the probabilistic
distribution of a task.
25

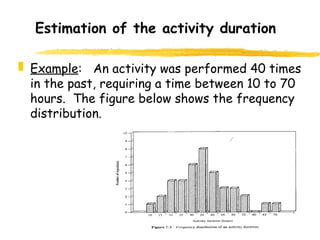

Estimation of the activity duration
 Example: An activity was performed 40 times
in the past, requiring a time between 10 to 70
hours. The figure below shows the frequency
distribution.
26
Estimation of the activity duration
 The probability distribution of the
activity is approximated by a probability
frequency distribution.
27
Estimation of the activity duration
 In project scheduling, we usually use a
beta distribution to represent the time
needed for each activity.
28

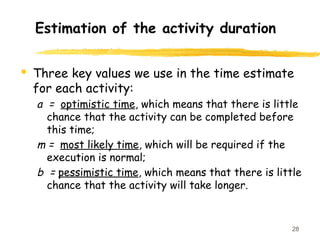

Estimation of the activity duration
· Three key values we use in the time estimate
for each activity:
a = optimistic time, which means that there is little
chance that the activity can be completed before
this time;
m = most likely time, which will be required if the
execution is normal;
b = pessimistic time, which means that there is little
chance that the activity will take longer.
29

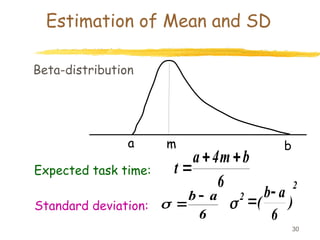

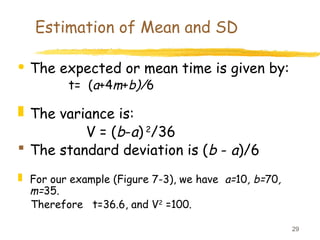

Estimation of Mean and SD
· The expected or mean time is given by:
t= (a+4m+b)/6
 The variance is:
V = (b-a) 2
/36
 The standard deviation is (b - a)/6
 For our example (Figure 7-3), we have a=10, b=70,
m=35.
Therefore t=36.6, and V2
=100.
30
Estimation of Mean and SD
Expected task time:
6
b
m
4
a
t



Standard deviation:
6
a
b 

 )
6
a
b
(
2
2 


m b
Beta-distribution
a
31

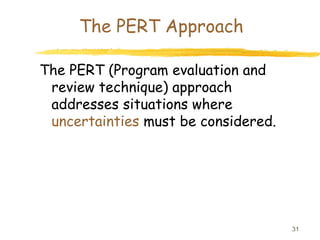

The PERT Approach
The PERT (Program evaluation and
review technique) approach
addresses situations where
uncertainties must be considered.
32

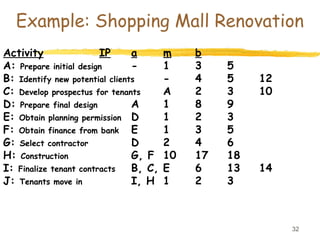

Example: Shopping Mall Renovation
Activity IP a m b
A: Prepare initial design - 1 3 5
B: Identify new potential clients - 4 5 12
C: Develop prospectus for tenants A 2 3 10
D: Prepare final design A 1 8 9
E: Obtain planning permission D 1 2 3
F: Obtain finance from bank E 1 3 5
G: Select contractor D 2 4 6
H: Construction G, F 10 17 18
I: Finalize tenant contracts B, C, E 6 13 14
J: Tenants move in I, H 1 2 3
33
Example: Issues to Address
1. Schedule the project.
2. What is the probability of completing the
project in 36 weeks?
34
Expected Activity Time and SD

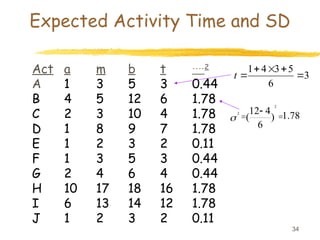

Act a m b t 2
A 1 3 5 3 0.44
B 4 5 12 6 1.78
C 2 3 10 4 1.78
D 1 8 9 7 1.78
E 1 2 3 2 0.11
F 1 3 5 3 0.44
G 2 4 6 4 0.44
H 10 17 18 16 1.78
I 6 13 14 12 1.78
J 1 2 3 2 0.11
3
6
5
3
4
1





t
78
.
1
)
6
4
12
(
2
2




35
CPM with Expected Activity Times
1
A,3 D,7
E,2
H,16
J,2
I,12
End
B,6
C,4
F,3
G,4
36

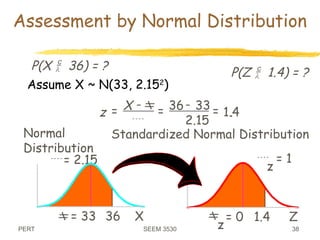

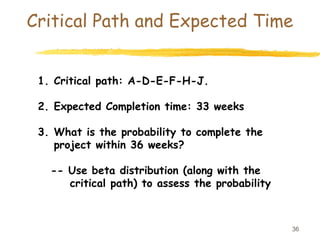

Critical Path and Expected Time

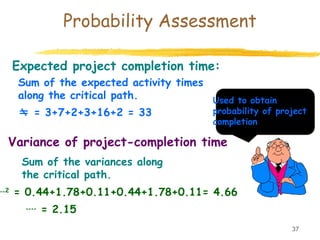

1. Critical path: A-D-E-F-H-J.
2. Expected Completion time: 33 weeks
3. What is the probability to complete the
project within 36 weeks?
-- Use beta distribution (along with the
critical path) to assess the probability
37
Probability Assessment
Expected project completion time:
Sum of the expected activity times
along the critical path.
 = 3+7+2+3+16+2 = 33
Variance of project-completion time
Sum of the variances along
the critical path.
2
= 0.44+1.78+0.11+0.44+1.78+0.11= 4.66
 = 2.15
Used to obtain
probability of project
completion
PERT SEEM 3530 38
Assessment by Normal Distribution
Assume X ~ N(33, 2.152
)
P(X  36) = ?
 = 33
 = 2.15
36 X
Normal
Distribution
z
X 
=
-
=
-
=

36 33
2.15
1.4
.

z
= 0

z
= 1
Z
1.4
Standardized Normal Distribution
P(Z  1.4) = ?
PERT SEEM 3530 39
Obtain the Probability
z=0
z=1
z
1.4
Z .00 .01 .02
0.0.5000
.5040.5080
: : : :
1.4.9192
.9207.9222
1.5.9332
.9345.9357
Standardized Normal Probability Table (Portion)
P( 0 < Z < 1.4 )
.9192
P(Z<1.4) = 0.9192
40

Chapter 5 Sceduling CPT and PERT programming.pptx

  • 1.
    1. Critical PathMethod (CPM) 2. Program Evaluation Review Technique (PERT) 1 Chapter Five: Scheduling
  • 2.
    CPM and PERT Critical Path is one of the two ways or tools to identify the paths through your project  PERT stands for program evaluation review technique  CPM stands for critical path method  CPM uses one time estimate, whereas PERT uses three time estimates  CPM is used when you are sure about the duration of each activity  PERT is used in more uncertain situations
  • 3.
    How to findthe Critical Path 1. Start with an activity network diagram 2. Find all of the paths in the diagram. A path is any string of activities that goes from the start of the project to the end. 3. Find the duration of each path by adding up the durations of each of the activities on the path.  The critical path is the one with the longest duration Start A B C D E Finish 4 7 2 5 3 3
  • 4.
    How to findthe Critical Path…Cont’d The float for each of the activities on the critical path is zero. Another word for float is slack. Float tells you how much extra time you have Once you know the float, you know how much play you have in your schedule. Find the next longest path. Subtract its duration from the duration of the critical path, and that’s the float for each activity on it. You can use this method to find the float for every activity in a network diagram. Do the same for the next longest path, and so on through the rest of the network diagram. 4
  • 5.
    How to findthe Critical Path (Network Computation Process)...  To find the critical path (through network computation), we calculate two distinct starting and ending times for each activity. Earliest Start (ES) = earliest time at which an activity can start, assuming all predecessors have been completed. Earliest Finish (EF) = earliest time in which an activity can be finished. 5
  • 6.
    Network Computation Process... LatestStart (LS) = latest time in which an activity can start so as to not delay the completion time of the entire project. Latest Finish (LF) = latest time by which an activity has to finish so as to not delay the completion time of the entire project. 6
  • 7.
    Network Computation Process... We use a two-pass process, consisting of a forward pass and a backward pass, to determine these time schedules for each activity. -The early start and finish times (ES and EF) are determined during the forward pass. -The late start and finish times (LS and LF) are determined during the backward pass. 7
  • 8.
    Network Computation Process... Forward Pass (Earliest Times)- has the following rules. Earliest Start Time Rule- before an activity can start, all its immediate predecessors must be finished: *If an activity has only a single immediate predecessor, its ES equals the EF of the predecessor. *If an activity has multiple immediate predecessors, its ES is the maximum of all EF values of its predecessors. That is, ES = Max (EF of all immediate predecessors) 8
  • 9.
    Network Computation Process... EarliestFinish Rule- the earliest finish time (EF) of an activity is the sum of its earliest start time (ES) and its activity time. That is, EF = ES + Activity time (or duration) 9
  • 10.
    Network Computation Process... Backward Pass (Latest Times) Latest Finish Time Rule- *If an activity is an immediate predecessor for just a single activity, its LF equals the ES of the activity that immediately follows it. *If an activity is an immediate predecessor to more than one activity, its LF is the minimum of all ES values of all activities that immediately follow it. That is, LF = Min (ES of all immediate following activities) 10
  • 11.
    Network Computation Process... LatestStart Time Rule- the latest start time (LS) of an activity is the difference of its finish time (LF) and its activity time. That is, LS =LF – activity time. 11
  • 12.
    Calculating Slack Timeand Identifying the Critical Path  Slack is the length of time an activity can be delayed without delaying the entire project. Mathematically: Slack = LS – ES or Slack = LF – EF The activities with zero slack are called critical activities and are said to be on the critical path. 12
  • 13.
    Calculating Slack Timeand Identifying the Critical Path…..  The critical path is a continuous path through the project network that: Starts at the first activity in the project. Terminates at the last activity in the project. Includes only critical activities (i.e., activities with zero slack time). 13
  • 14.
    Network Computation Process... Example1. Milwaukee Paper Manufacturing’s Activities and Predecessors. Activity Description Imm.Pre. Time (weeks) A Build internal components ___ 2 B Modify roof and floor ___ 3 C Construct collection stack A 2 D Pour concrete and install frame A, B 4 E Build high-temperature burner C 4 F Install pollution control system C 3 G Install air pollution device D, E 5 H Inspect and test F, G 2 Total time (weeks) 25
  • 15.
    Network Computation Process... Required: 1.Draw AON networks for Milwaukee Papers. 2. Determine the earliest and latest times for the activities. 3. Calculate the slack time and identify the critical path. 15
  • 16.
    Example2 16 Immediate Activity Description Predecessor(s)Responsibility A Select administrative and medical staff. B Select site and do site survey. C Select equipment. D Prepare final construction plans and layout. E Bring utilities to the site. F Interview applicants and fill positions in nursing, support staff, maintenance, and security. G Purchase and take delivery of equipment. H Construct the hospital. I Develop an information system. J Install the equipment. K Train nurses and support staff.
  • 17.
    Example 17 Immediate Activity Description Predecessor(s)Responsibility A Select administrative and medical staff. — B Select site and do site survey. — C Select equipment. A D Prepare final construction plans and layout. B E Bring utilities to the site. B F Interview applicants and fill positions in A nursing, support staff, maintenance, and security. G Purchase and take delivery of equipment. C H Construct the hospital. D I Develop an information system. A J Install the equipment. E,G,H K Train nurses and support staff. F,I,J 12 9 10 10 24 10 35 40 15 4 6 Activity Duration
  • 18.
  • 19.
    Cont’d… 19 Finish Start A B C D E F G H I J K Path Time (wks) A-I-K 33 A-F-K28 A-C-G-J-K 67 B-D-H-J-K 69 B-E-J-K 43 Paths are the sequence of activities between a project’s start and finish.
  • 20.
    Cont’d… 20 Finish Start A B C D E F G H I J K Path Time (wks) A-I-K 33 A-F-K28 A-C-G-J-K 67 B-D-H-J-K 69 B-E-J-K 43 Project Expected Time is 69 wks. The critical path is the longest path!
  • 21.
    2. Program Evaluationand Review Technique (PERT)
  • 22.
    22 Estimation of TaskTimes  In CPM, we assume that the task durations are known with certainty.  This may not be realistic in many project settings.  How long does it take to design a switch?  PERT tries to account for the uncertainty in task durations.  Key question: What is the probability of completing a project by a given deadline?
  • 23.
    23 CPM vs. PERT CPM (critical path method)  PERT (program evaluation and review technique)  Both approaches work on a project network, which graphically portrays the activities of the project and their relationships. · CPM assumes that activity times are deterministic, while PERT views the time to complete a task as a random variable.
  • 24.
    24 Estimation of theduration of project activities (1) The deterministic approach (CPM), which ignores uncertainty thus results in a point estimate (e.g. The duration of task 1 = 23 hours, etc.) (2) The stochastic approach (PERT) considers the uncertain nature of project activities by estimating the expected duration of each activity and its corresponding variance.  Analyse the past data to construct the probabilistic distribution of a task.
  • 25.
    25 Estimation of theactivity duration  Example: An activity was performed 40 times in the past, requiring a time between 10 to 70 hours. The figure below shows the frequency distribution.
  • 26.
    26 Estimation of theactivity duration  The probability distribution of the activity is approximated by a probability frequency distribution.
  • 27.
    27 Estimation of theactivity duration  In project scheduling, we usually use a beta distribution to represent the time needed for each activity.
  • 28.
    28 Estimation of theactivity duration · Three key values we use in the time estimate for each activity: a = optimistic time, which means that there is little chance that the activity can be completed before this time; m = most likely time, which will be required if the execution is normal; b = pessimistic time, which means that there is little chance that the activity will take longer.
  • 29.
    29 Estimation of Meanand SD · The expected or mean time is given by: t= (a+4m+b)/6  The variance is: V = (b-a) 2 /36  The standard deviation is (b - a)/6  For our example (Figure 7-3), we have a=10, b=70, m=35. Therefore t=36.6, and V2 =100.
  • 30.
    30 Estimation of Meanand SD Expected task time: 6 b m 4 a t    Standard deviation: 6 a b    ) 6 a b ( 2 2    m b Beta-distribution a
  • 31.
    31 The PERT Approach ThePERT (Program evaluation and review technique) approach addresses situations where uncertainties must be considered.
  • 32.
    32 Example: Shopping MallRenovation Activity IP a m b A: Prepare initial design - 1 3 5 B: Identify new potential clients - 4 5 12 C: Develop prospectus for tenants A 2 3 10 D: Prepare final design A 1 8 9 E: Obtain planning permission D 1 2 3 F: Obtain finance from bank E 1 3 5 G: Select contractor D 2 4 6 H: Construction G, F 10 17 18 I: Finalize tenant contracts B, C, E 6 13 14 J: Tenants move in I, H 1 2 3
  • 33.
    33 Example: Issues toAddress 1. Schedule the project. 2. What is the probability of completing the project in 36 weeks?
  • 34.
    34 Expected Activity Timeand SD Act a m b t 2 A 1 3 5 3 0.44 B 4 5 12 6 1.78 C 2 3 10 4 1.78 D 1 8 9 7 1.78 E 1 2 3 2 0.11 F 1 3 5 3 0.44 G 2 4 6 4 0.44 H 10 17 18 16 1.78 I 6 13 14 12 1.78 J 1 2 3 2 0.11 3 6 5 3 4 1      t 78 . 1 ) 6 4 12 ( 2 2    
  • 35.
    35 CPM with ExpectedActivity Times 1 A,3 D,7 E,2 H,16 J,2 I,12 End B,6 C,4 F,3 G,4
  • 36.
    36 Critical Path andExpected Time 1. Critical path: A-D-E-F-H-J. 2. Expected Completion time: 33 weeks 3. What is the probability to complete the project within 36 weeks? -- Use beta distribution (along with the critical path) to assess the probability
  • 37.
    37 Probability Assessment Expected projectcompletion time: Sum of the expected activity times along the critical path.  = 3+7+2+3+16+2 = 33 Variance of project-completion time Sum of the variances along the critical path. 2 = 0.44+1.78+0.11+0.44+1.78+0.11= 4.66  = 2.15 Used to obtain probability of project completion
  • 38.
    PERT SEEM 353038 Assessment by Normal Distribution Assume X ~ N(33, 2.152 ) P(X  36) = ?  = 33  = 2.15 36 X Normal Distribution z X  = - = - =  36 33 2.15 1.4 .  z = 0  z = 1 Z 1.4 Standardized Normal Distribution P(Z  1.4) = ?
  • 39.

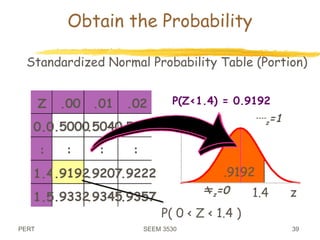

    PERT SEEM 353039 Obtain the Probability z=0 z=1 z 1.4 Z .00 .01 .02 0.0.5000 .5040.5080 : : : : 1.4.9192 .9207.9222 1.5.9332 .9345.9357 Standardized Normal Probability Table (Portion) P( 0 < Z < 1.4 ) .9192 P(Z<1.4) = 0.9192
  • 40.

Editor's Notes

  • #32 Click to edit Master text styles Second level Third level Fourth level Fifth level
