Beyond Projects
Or The End of Projects
and what happens next
Allan Kelly
allan@softwarestrategy.co.uk
http://www.softwarestrategy.co.uk
Twitter: @allankelly.net
Skills Matter, London, March 2014
Allan Kelly…
Chapters in…
• Business Analysis and Leadership, Pullan & Archer
2013
• 97 Things Every Programmer Should Know, Henney,
2010
• Context Encapsulation in Pattern Languages of
Program Design, vol#5, 2006
 Consulting on software
development & strategy
 Training for Agile
Author
– Changing Software Development: Learning to be
Agile (2008, Wiley)
– Business Patterns for Software Developers (2012,
Wiley - ISBN: 978-1119999249)
– Xanpan: Reflections on agile (work in progress)
https://leanpub.com/xanpan
Audience participation
How many of you …
• Adequately identify & quantify project
benefits?
• Know someone who overstates the
benefits of a project to obtain
funding?
• Think project review & evaluation is
adequate?
• 70% believe they are failing to identify and
quantify the benefits adequately
• 38% openly admit they overstate the benefits in
order to obtain funding
• 80% report that the review and evaluation of
completed projects is also inadequate
• due to the focus on whether the project achieved cost,
time and quality objectives and not on whether the
intended benefits were realized.
Delivering value from IS and IT investments, John Ward,
Cranfield School of Management, 2006
http://www.som.cranfield.ac.uk/som/dinamic-
content/research/documents/deliveringvaluereport.pdf
Survey of 100 IT/IS &
Business managers in UK
and Benelux, 2006
Successful software doesn’t stop
• Successful software continues to change
• Only dead software has an end-date

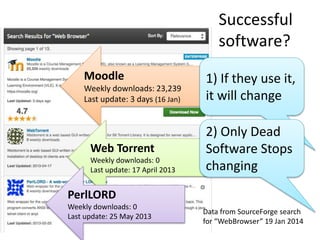

Successful
software?
Moodle
Weekly downloads: 23,239
Last update: 3 days (16 Jan)
Web Torrent
Weekly downloads: 0
Last update: 17 April 2013
PerlLORD
Weekly downloads: 0
Last update: 25 May 2013
1) If they use it,
it will change
2) Only Dead
Software Stops
changing
Data from SourceForge search
for “WebBrowser” 19 Jan 2014

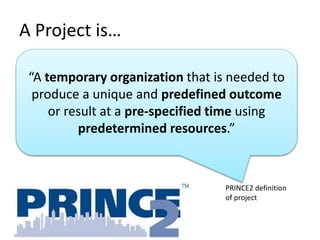

A Project is…
“A temporary organization that is needed to
produce a unique and predefined outcome
or result at a pre-specified time using
predetermined resources.”
PRINCE2 definition
of project
Temporary Organization?
• Storming
• Norming
• Forming
• Performing
• Destroying
}Takes time &
money!
Yes!
Why destroy performing teams?
Why spend that money?
Why loose knowledge?
• Stop killing performing teams
• Keep the team together
• Flow the work to the team
• The Team is the Capability
Corporate Psychopathy
Process by which corporations
disband performing teams and
release staff
Pre-determined resources?
• In the ideal world…
– You get the resources you ask for?
– They are dedicated to your project? And stay?
• Back in the real world…
– Resourcing allocation is politics
‘Nuff said
Pre-defined outcome?
• Requirements change
• The world changes
Compound to
~27% per annum
The observed rate of change
in the US is about 2% per
calendar month
Capers Jones, 2008
Pre-specified time?
• Pre-specified time is
not chosen rationally
• When does it start?
• When does it end?
– Last bug fixed?
– Last CR done?
– Thrown over last wall?
In the US more than half of
the large projects …
predetermined end date is
selected, and it is forced on
the project by arbitrary
decree.
Among the most difficult
… measurement of
project & task schedules.
The initial difficulty… is…
identifying the start point
of any given project!
Capers Jones, 2008

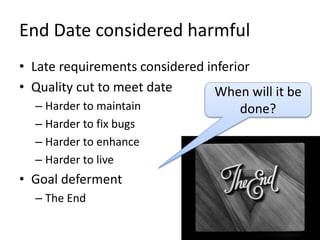

End Date considered harmful
• Late requirements considered inferior
• Quality cut to meet date
– Harder to maintain
– Harder to fix bugs
– Harder to enhance
– Harder to live
• Goal deferment
– The End
When will it be
done?
The End of Projects
• Projects are accounting codes
• Finished Software is Dead Software
– Living software changes
– Dead software doesn’t
– Living software doesn’t end
• Project thinking kills software

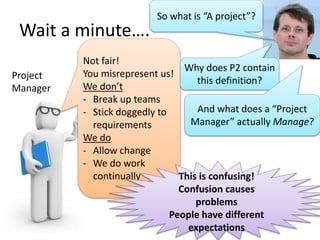

Wait a minute….
Project
Manager
Not fair!
You misrepresent us!
We don’t
- Break up teams
- Stick doggedly to
requirements
We do
- Allow change
- We do work
continually
So what is “A project”?
Why does P2 contain
this definition?
And what does a “Project
Manager” actually Manage?
This is confusing!
Confusion causes
problems
People have different
expectations
What next?
• Putting the jigsaw together
Work with no end
• Work to short term goal & deadline
– Human’s are good with deadlines
– (Very bad with estimation)
• Work to deliver value
• Work as if this is your last goal
– But: Work be ready for another round
• Do work you will be proud of
What to do about it…
• Keep teams together
• Flow work to the teams
• Work in the small
• Work continually
• Demonstrate value
Focus on Value not The End
Ask not, “When will the
software be done?”
But ask: “When will the
software deliver value next?”
Think: Stream of Value
(which might stop one day)
Not: An end date
Software development…
• Does NOT have economies of Scale
• Development has DISECONOMIES of scale
Therefore
• Stop thinking BIG
• Start thinking SMALL
Batch Size
Build this! Make lots of this!Deliver this!
Wait Wait
Feature Yes, Projects No
• Project = Set of Features
– Some features are very
valuable, some less so
– Some risky, some not
• Project -> All of this
– Or nothing
• Organize yourselves to do lots
of small features
Consider a large project
Against several small
projects
Project A: Risk = 30% Value at risk = £1m
Therefore risk weighted value = £300,000
Prj B: Risk = 15%
Value @ risk = £½m
Therefore … = £75,000
Prj C: Risk = 15%
Value @risk = £½m
Therefore … = £75,000
E: Risk = 6%
@risk = £200k
Therefore = £12k
F: Risk = 6%
@risk = £200k
Therefore = £12k
G: Risk = 6%
@risk = £200k
Therefore = £12k
H: Risk = 6%
@risk = £200k
Therefore = £12k
I: Risk = 6%
@risk = £200k
Therefore = £12k
J: Risk = 6%
@risk = £200k
Therefore = £12k
Ask not, “What is the end date?”
But ask: “When is the next
delivery?”
We have the Technology
Waterfall 2.0
Jonathon’s Run Fall, Pennsylvania by Hubert Stoffels (http://flickr.com/photos/22195940@N00)
Creative Commons License
Continuous Flow
Continuous flow
• Work in the small
• Get good at doing small things
– Deliver small increments of value
– And evaluate results
• Go fast
• Don’t stop
• Value seeking

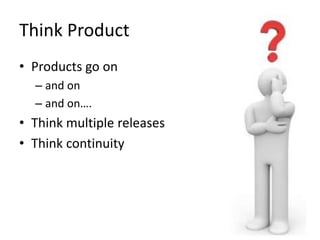

Think Product
• Products go on
– and on
– and on….
• Think multiple releases
• Think continuity
Constraints
31
Features
Resources
(People)
Time
Cost =
Resources x Time
Quality = free
Time boxedAll the action
Fixed over
short run
(Brooks Law)

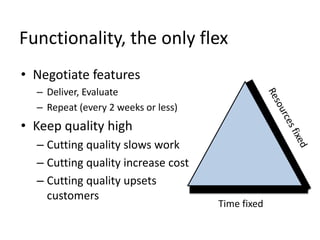

Functionality, the only flex
• Negotiate features
– Deliver, Evaluate
– Repeat (every 2 weeks or less)
• Keep quality high
– Cutting quality slows work
– Cutting quality increase cost
– Cutting quality upsets
customers
Time fixed
Change Governance
• Base Governance on actual
delivered benefits
– Not milestones completed
– Not documents
– Not budgets
• Align work with strategy
Picture from Picasa - Creative Commons License
http://commons.wikimedia.org/wiki/File:House_of_Parliment_6_201
What have
you delivered
for me lately?
Change the Start
• Start small
• Overlap discovery & development
– From Day-1
• Fail fast, Fail cheap
• Grow the successful
Active Portfolio Management
• Start, Stop, Shrink, Grow work teams/streams
• Balance risk/reward
• Sustaining/Innovative
• CLOSE UNDER PERFORMING WORK
Could this ever work?
• Governance by results?
• Fail fast, fail cheap
Seems to work
well for Sand
Hill Road
Venture
Capitalists….
The End of Project Management?
• Projects are for accountants
• Organize work by
– Work streams and/or
– Products
– Manage queues
• Aim for stable teams, continuity
– Occasional personnel changes
– Living, changing code bases
Management work to do
• “Manager” -> More authority to fix
• Dealing with fuzzy world
• Keep team running effectively
• Supplier / Client relationships
– Contracts to discuss & police
– Role shoot out
• Stuff
– Admin, reporting, Line Management

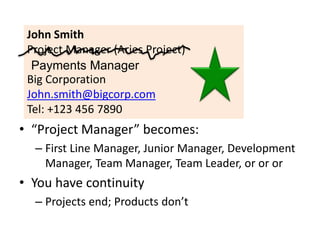

“they have an B
manager so we need
an B manager”
John Smith
Project Manager (Aries Project)
Big Corporation
John.smith@bigcorp.com
Tel: +123 456 7890
Payments Manager
• “Project Manager” becomes:
– First Line Manager, Junior Manager, Development
Manager, Team Manager, Team Leader, or or or
• You have continuity
– Projects end; Products don’t
http://leanpub.com/xanpan
Or half price till end of March@
http://leanpub.com/xanpan/c/SkillsMar2014
Remember
• It ain’t ever over
• BAU is not a dirty work
allan kelly
www.softwarestrategy.co.uk
www.allankelly.net
allan@allankelly.net
Twitter: @allankellynet

Beyond projects

  • 1.
    Beyond Projects Or TheEnd of Projects and what happens next Allan Kelly allan@softwarestrategy.co.uk http://www.softwarestrategy.co.uk Twitter: @allankelly.net Skills Matter, London, March 2014
  • 2.
    Allan Kelly… Chapters in… •Business Analysis and Leadership, Pullan & Archer 2013 • 97 Things Every Programmer Should Know, Henney, 2010 • Context Encapsulation in Pattern Languages of Program Design, vol#5, 2006  Consulting on software development & strategy  Training for Agile Author – Changing Software Development: Learning to be Agile (2008, Wiley) – Business Patterns for Software Developers (2012, Wiley - ISBN: 978-1119999249) – Xanpan: Reflections on agile (work in progress) https://leanpub.com/xanpan
  • 3.
    Audience participation How manyof you … • Adequately identify & quantify project benefits? • Know someone who overstates the benefits of a project to obtain funding? • Think project review & evaluation is adequate?
  • 4.
    • 70% believethey are failing to identify and quantify the benefits adequately • 38% openly admit they overstate the benefits in order to obtain funding • 80% report that the review and evaluation of completed projects is also inadequate • due to the focus on whether the project achieved cost, time and quality objectives and not on whether the intended benefits were realized. Delivering value from IS and IT investments, John Ward, Cranfield School of Management, 2006 http://www.som.cranfield.ac.uk/som/dinamic- content/research/documents/deliveringvaluereport.pdf Survey of 100 IT/IS & Business managers in UK and Benelux, 2006
  • 5.
    Successful software doesn’tstop • Successful software continues to change • Only dead software has an end-date
  • 6.
    Successful software? Moodle Weekly downloads: 23,239 Lastupdate: 3 days (16 Jan) Web Torrent Weekly downloads: 0 Last update: 17 April 2013 PerlLORD Weekly downloads: 0 Last update: 25 May 2013 1) If they use it, it will change 2) Only Dead Software Stops changing Data from SourceForge search for “WebBrowser” 19 Jan 2014
  • 7.
    A Project is… “Atemporary organization that is needed to produce a unique and predefined outcome or result at a pre-specified time using predetermined resources.” PRINCE2 definition of project
  • 8.
    Temporary Organization? • Storming •Norming • Forming • Performing • Destroying }Takes time & money! Yes! Why destroy performing teams? Why spend that money? Why loose knowledge?
  • 9.
    • Stop killingperforming teams • Keep the team together • Flow the work to the team • The Team is the Capability Corporate Psychopathy Process by which corporations disband performing teams and release staff
  • 10.
    Pre-determined resources? • Inthe ideal world… – You get the resources you ask for? – They are dedicated to your project? And stay? • Back in the real world… – Resourcing allocation is politics ‘Nuff said
  • 11.
    Pre-defined outcome? • Requirementschange • The world changes Compound to ~27% per annum The observed rate of change in the US is about 2% per calendar month Capers Jones, 2008
  • 12.
    Pre-specified time? • Pre-specifiedtime is not chosen rationally • When does it start? • When does it end? – Last bug fixed? – Last CR done? – Thrown over last wall? In the US more than half of the large projects … predetermined end date is selected, and it is forced on the project by arbitrary decree. Among the most difficult … measurement of project & task schedules. The initial difficulty… is… identifying the start point of any given project! Capers Jones, 2008
  • 13.
    End Date consideredharmful • Late requirements considered inferior • Quality cut to meet date – Harder to maintain – Harder to fix bugs – Harder to enhance – Harder to live • Goal deferment – The End When will it be done?
  • 14.
    The End ofProjects • Projects are accounting codes • Finished Software is Dead Software – Living software changes – Dead software doesn’t – Living software doesn’t end • Project thinking kills software
  • 15.
    Wait a minute…. Project Manager Notfair! You misrepresent us! We don’t - Break up teams - Stick doggedly to requirements We do - Allow change - We do work continually So what is “A project”? Why does P2 contain this definition? And what does a “Project Manager” actually Manage? This is confusing! Confusion causes problems People have different expectations
  • 16.
    What next? • Puttingthe jigsaw together
  • 17.
    Work with noend • Work to short term goal & deadline – Human’s are good with deadlines – (Very bad with estimation) • Work to deliver value • Work as if this is your last goal – But: Work be ready for another round • Do work you will be proud of
  • 18.
    What to doabout it… • Keep teams together • Flow work to the teams • Work in the small • Work continually • Demonstrate value
  • 19.
    Focus on Valuenot The End Ask not, “When will the software be done?” But ask: “When will the software deliver value next?” Think: Stream of Value (which might stop one day) Not: An end date
  • 20.
    Software development… • DoesNOT have economies of Scale • Development has DISECONOMIES of scale Therefore • Stop thinking BIG • Start thinking SMALL
  • 21.
    Batch Size Build this!Make lots of this!Deliver this! Wait Wait
  • 22.
    Feature Yes, ProjectsNo • Project = Set of Features – Some features are very valuable, some less so – Some risky, some not • Project -> All of this – Or nothing • Organize yourselves to do lots of small features
  • 24.
    Consider a largeproject Against several small projects Project A: Risk = 30% Value at risk = £1m Therefore risk weighted value = £300,000 Prj B: Risk = 15% Value @ risk = £½m Therefore … = £75,000 Prj C: Risk = 15% Value @risk = £½m Therefore … = £75,000 E: Risk = 6% @risk = £200k Therefore = £12k F: Risk = 6% @risk = £200k Therefore = £12k G: Risk = 6% @risk = £200k Therefore = £12k H: Risk = 6% @risk = £200k Therefore = £12k I: Risk = 6% @risk = £200k Therefore = £12k J: Risk = 6% @risk = £200k Therefore = £12k
  • 25.
    Ask not, “Whatis the end date?” But ask: “When is the next delivery?”
  • 26.
    We have theTechnology
  • 27.
    Waterfall 2.0 Jonathon’s RunFall, Pennsylvania by Hubert Stoffels (http://flickr.com/photos/22195940@N00) Creative Commons License Continuous Flow
  • 28.
    Continuous flow • Workin the small • Get good at doing small things – Deliver small increments of value – And evaluate results • Go fast • Don’t stop • Value seeking
  • 29.
    Think Product • Productsgo on – and on – and on…. • Think multiple releases • Think continuity
  • 30.
    Constraints 31 Features Resources (People) Time Cost = Resources xTime Quality = free Time boxedAll the action Fixed over short run (Brooks Law)
  • 31.
    Functionality, the onlyflex • Negotiate features – Deliver, Evaluate – Repeat (every 2 weeks or less) • Keep quality high – Cutting quality slows work – Cutting quality increase cost – Cutting quality upsets customers Time fixed
  • 32.
    Change Governance • BaseGovernance on actual delivered benefits – Not milestones completed – Not documents – Not budgets • Align work with strategy Picture from Picasa - Creative Commons License http://commons.wikimedia.org/wiki/File:House_of_Parliment_6_201 2-07-08.jpg What have you delivered for me lately?
  • 33.
    Change the Start •Start small • Overlap discovery & development – From Day-1 • Fail fast, Fail cheap • Grow the successful
  • 34.
    Active Portfolio Management •Start, Stop, Shrink, Grow work teams/streams • Balance risk/reward • Sustaining/Innovative • CLOSE UNDER PERFORMING WORK
  • 35.
    Could this everwork? • Governance by results? • Fail fast, fail cheap Seems to work well for Sand Hill Road Venture Capitalists….
  • 36.
    The End ofProject Management? • Projects are for accountants • Organize work by – Work streams and/or – Products – Manage queues • Aim for stable teams, continuity – Occasional personnel changes – Living, changing code bases
  • 37.
    Management work todo • “Manager” -> More authority to fix • Dealing with fuzzy world • Keep team running effectively • Supplier / Client relationships – Contracts to discuss & police – Role shoot out • Stuff – Admin, reporting, Line Management “they have an B manager so we need an B manager”
  • 38.
    John Smith Project Manager(Aries Project) Big Corporation John.smith@bigcorp.com Tel: +123 456 7890 Payments Manager • “Project Manager” becomes: – First Line Manager, Junior Manager, Development Manager, Team Manager, Team Leader, or or or • You have continuity – Projects end; Products don’t
  • 39.
    http://leanpub.com/xanpan Or half pricetill end of March@ http://leanpub.com/xanpan/c/SkillsMar2014 Remember • It ain’t ever over • BAU is not a dirty work allan kelly www.softwarestrategy.co.uk www.allankelly.net allan@allankelly.net Twitter: @allankellynet
