SlideShare a Scribd company logo
IT Project Delivery Approach
                                    and how you can avoid sinking

                  A training class prepared by the ITS PMO – June 2010

Special thanks to Jenny Greene (http://www.stellman-greene.com) for letting us borrow some of the concepts and graphics used within

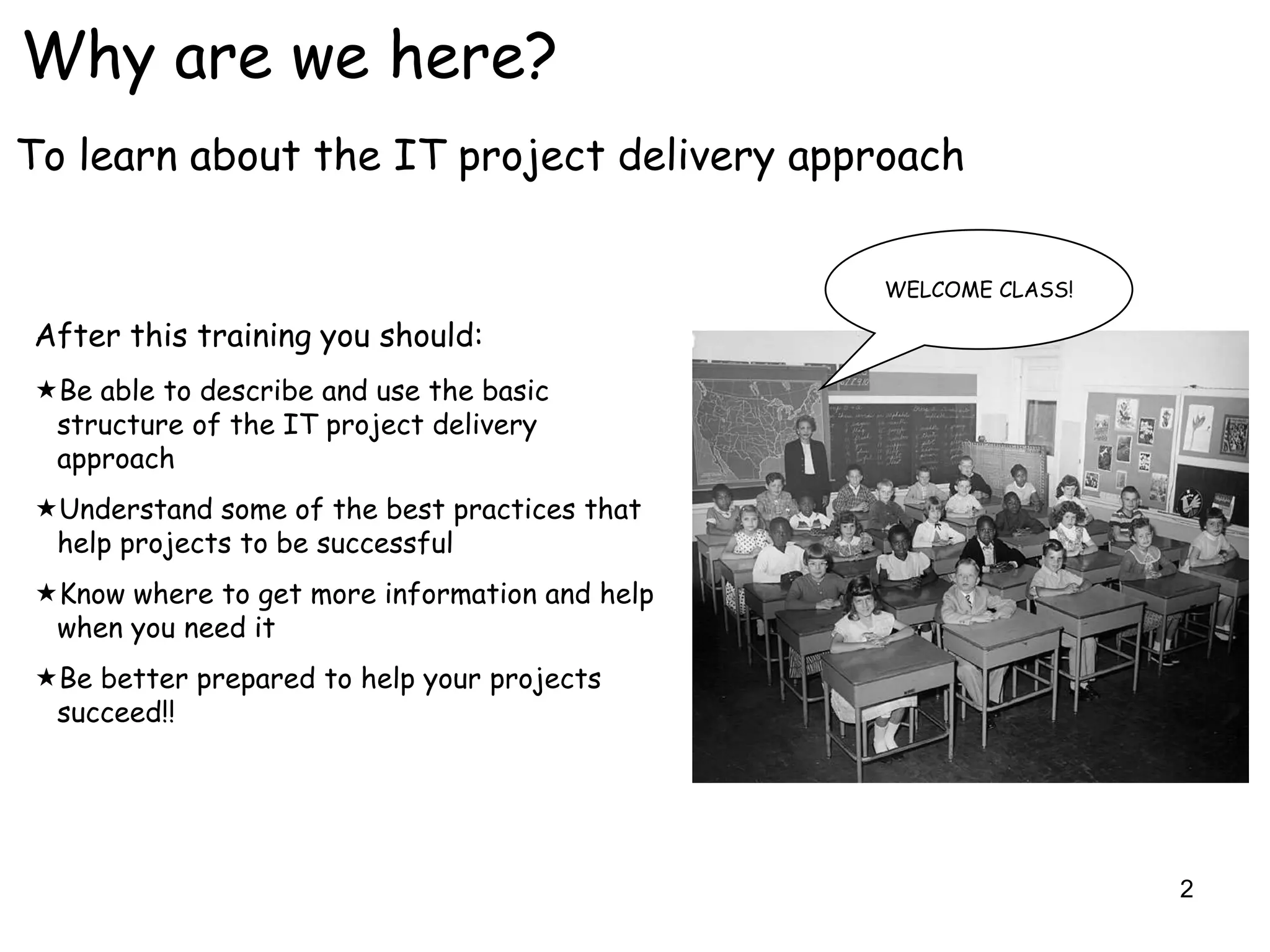

Why are we here?
To learn about the IT project delivery approach

                                               WELCOME CLASS!

After this training you should:
Be able to describe and use the basic
 structure of the IT project delivery
 approach
Understand some of the best practices that
 help projects to be successful
Know where to get more information and help
 when you need it
Be better prepared to help your projects
 succeed!!

                                                                2

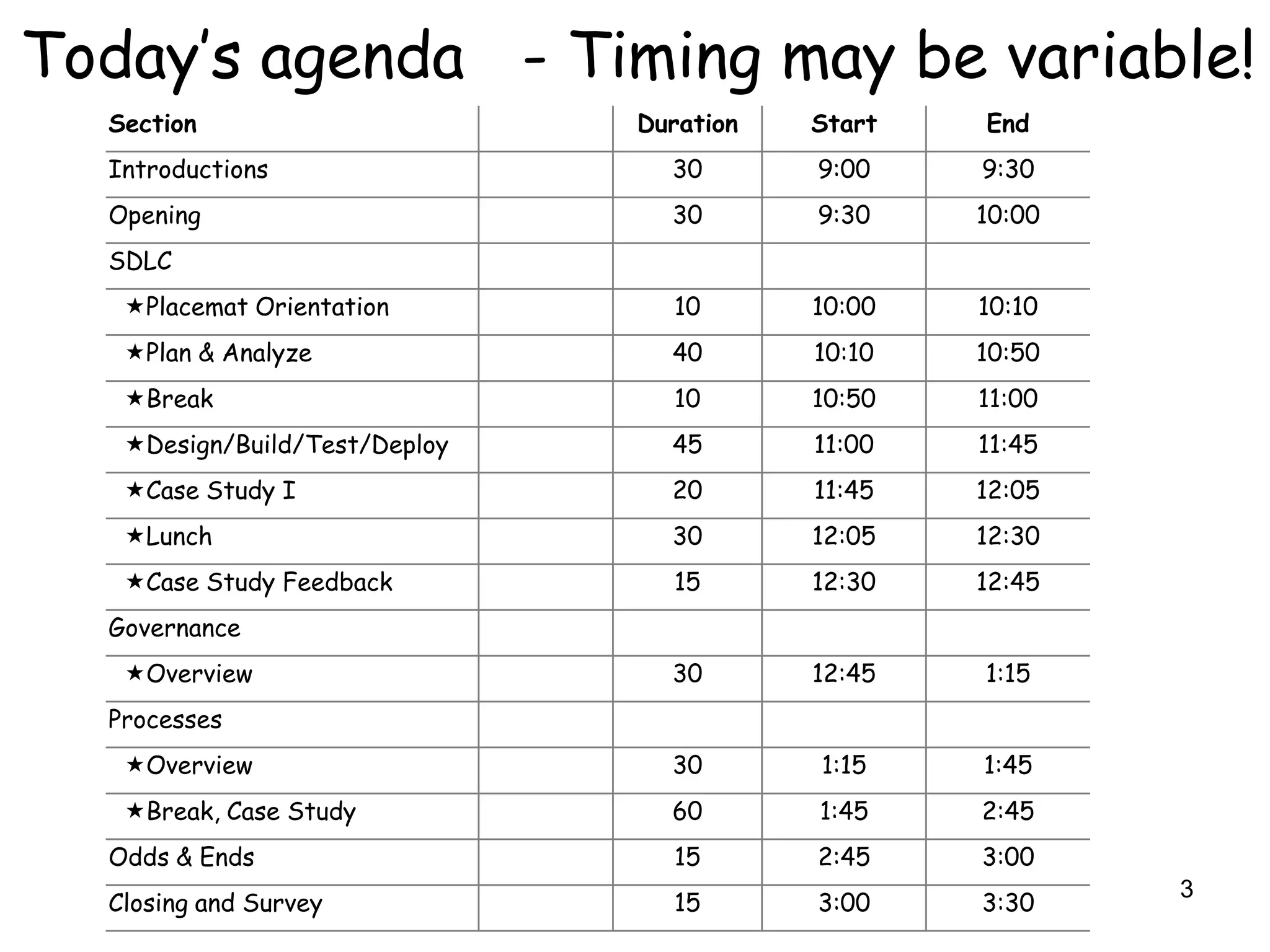

Today‟s agenda - Timing may be variable!
  Section                      Duration   Start   End
  Introductions                  30       9:00    9:30
  Opening                        30       9:30    10:00
  SDLC
   Placemat Orientation         10       10:00   10:10
   Plan & Analyze               40       10:10   10:50
   Break                        10       10:50   11:00
   Design/Build/Test/Deploy     45       11:00   11:45
   Case Study I                 20       11:45   12:05
   Lunch                        30       12:05   12:30
   Case Study Feedback          15       12:30   12:45
  Governance
   Overview                     30       12:45   1:15
  Processes
   Overview                     30       1:15    1:45
   Break, Case Study            60       1:45    2:45
  Odds & Ends                    15       2:45    3:00
                                                          3
  Closing and Survey             15       3:00    3:30

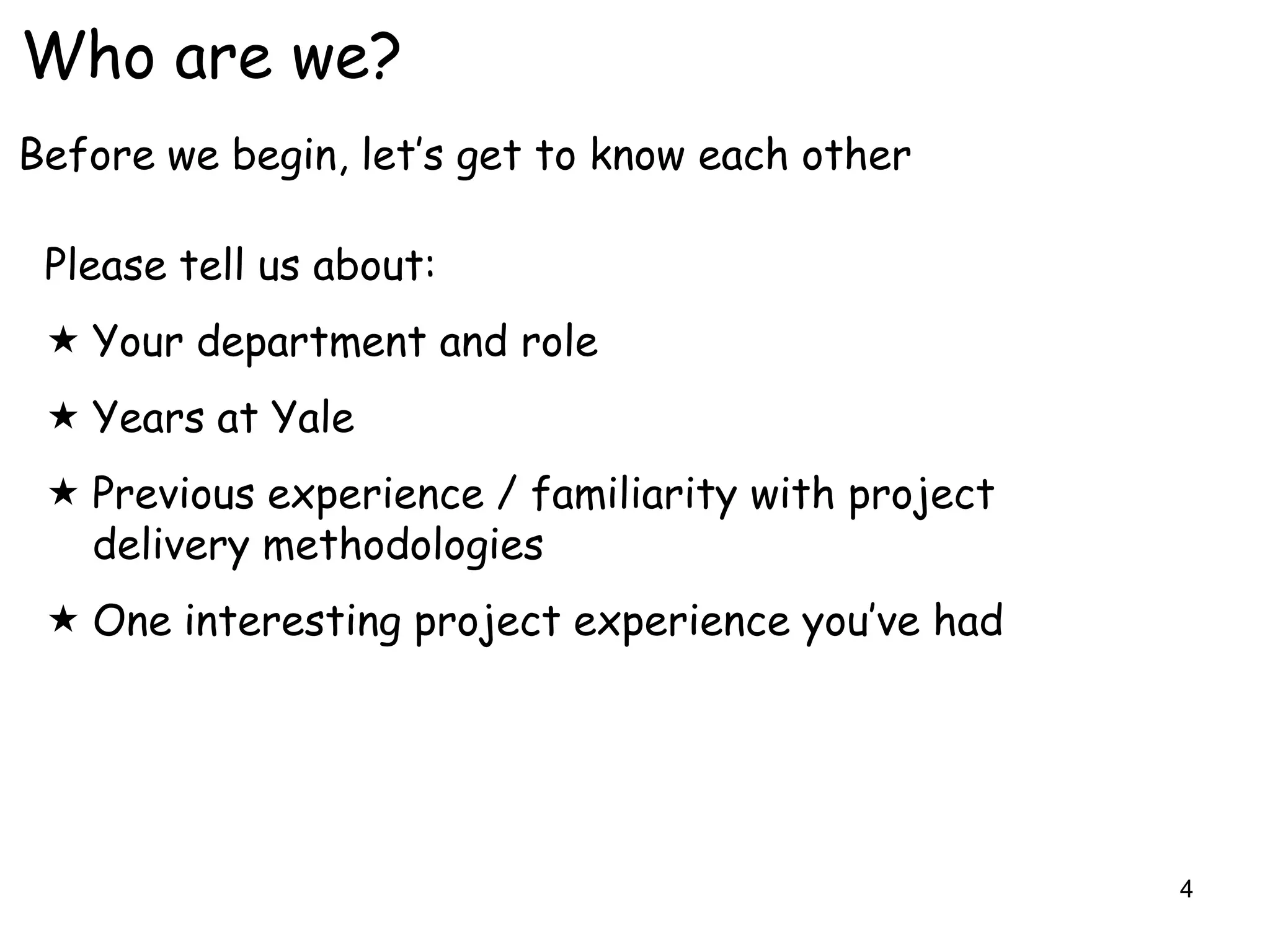

Who are we?
Before we begin, let‟s get to know each other

 Please tell us about:
  Your department and role
  Years at Yale
  Previous experience / familiarity with project
   delivery methodologies
  One interesting project experience you‟ve had

                                                    4

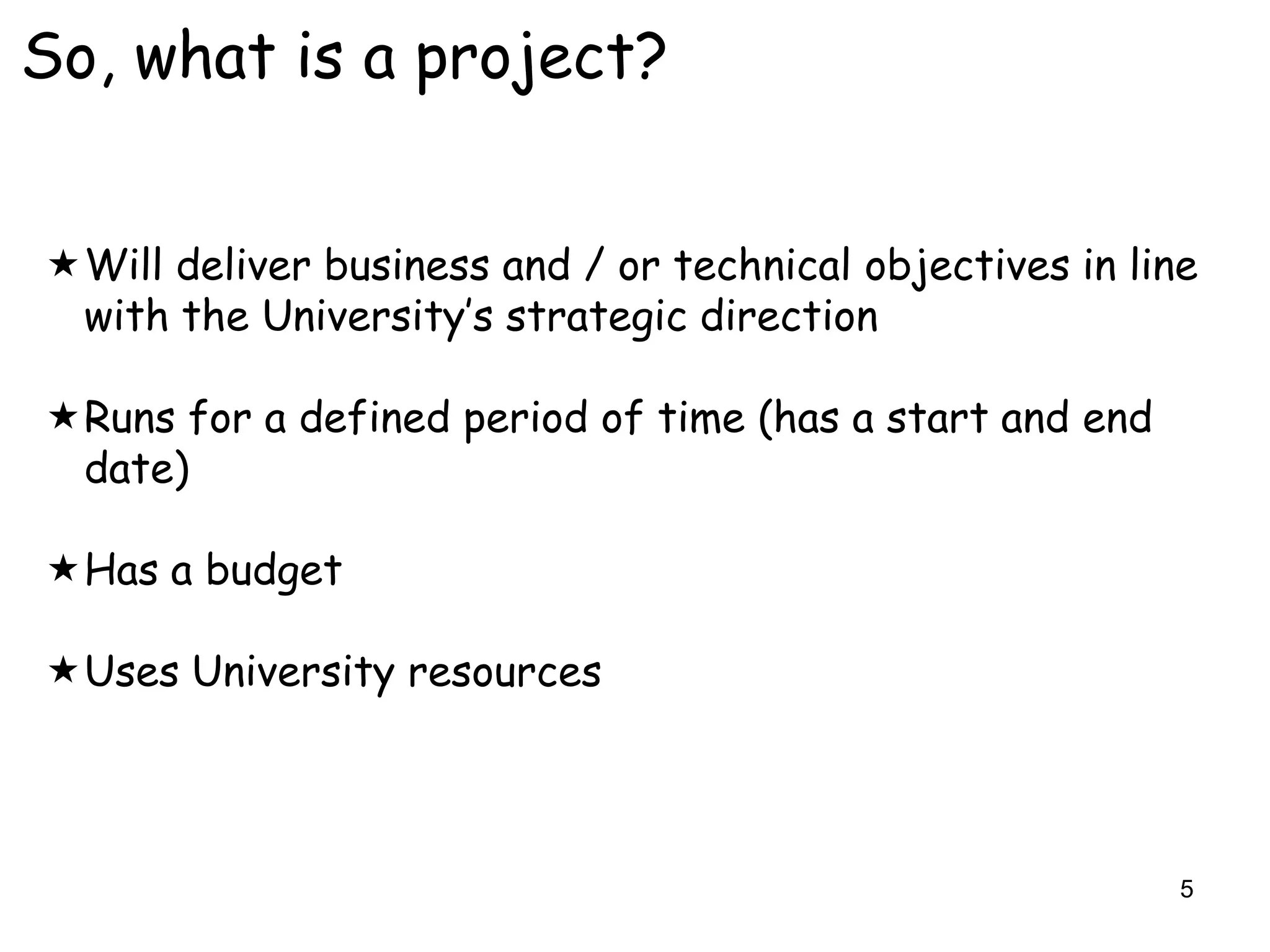

So, what is a project?

Will deliver business and / or technical objectives in line
 with the University‟s strategic direction

Runs for a defined period of time (has a start and end
 date)

Has a budget

Uses University resources

                                                           5

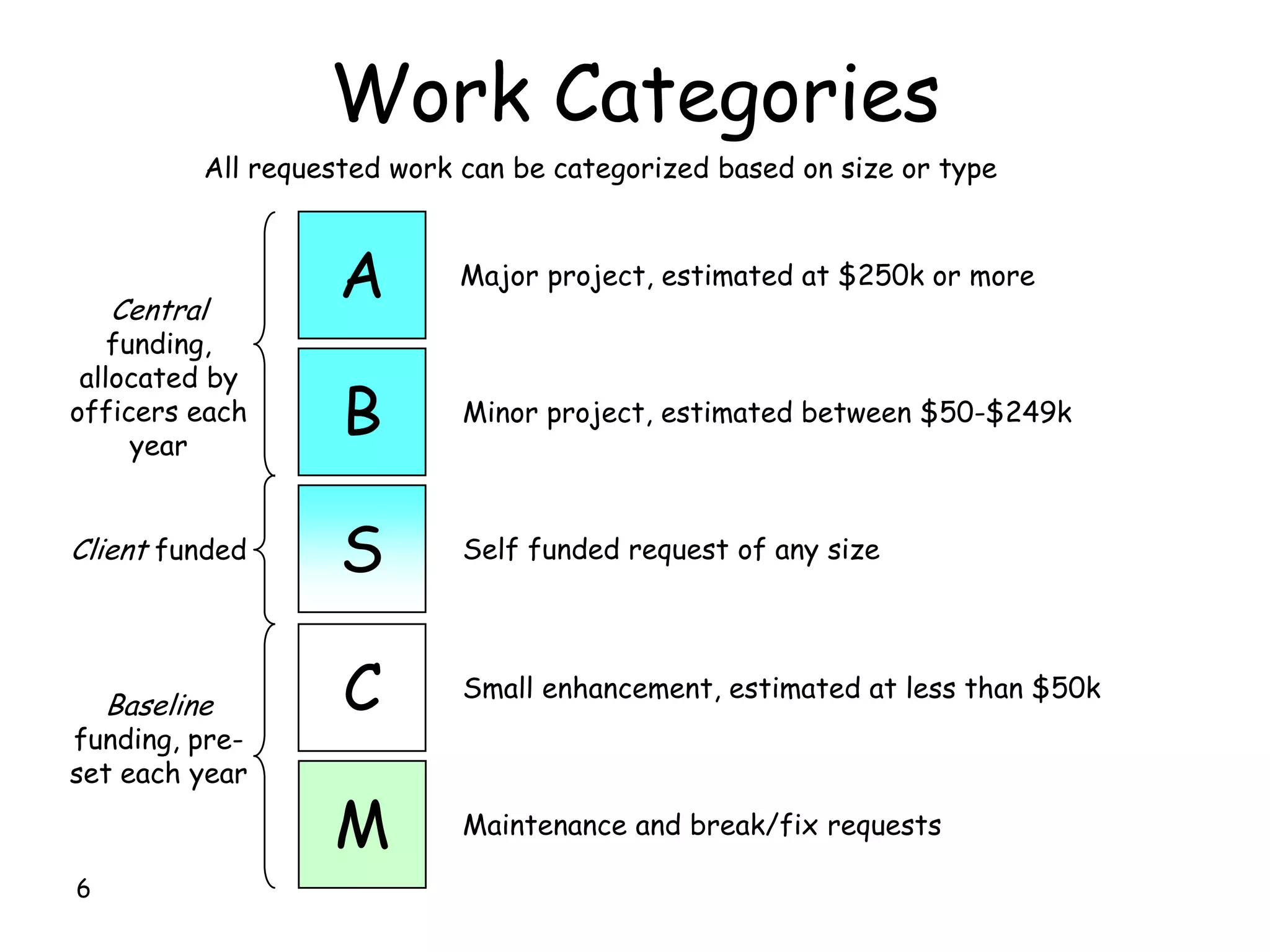

Work Categories
           All requested work can be categorized based on size or type

    Central
                     A        Major project, estimated at $250k or more

    funding,
 allocated by
officers each
      year
                     B        Minor project, estimated between $50-$249k

Client funded        S        Self funded request of any size

    Baseline         C        Small enhancement, estimated at less than $50k
funding, pre-
set each year

                    M         Maintenance and break/fix requests

6

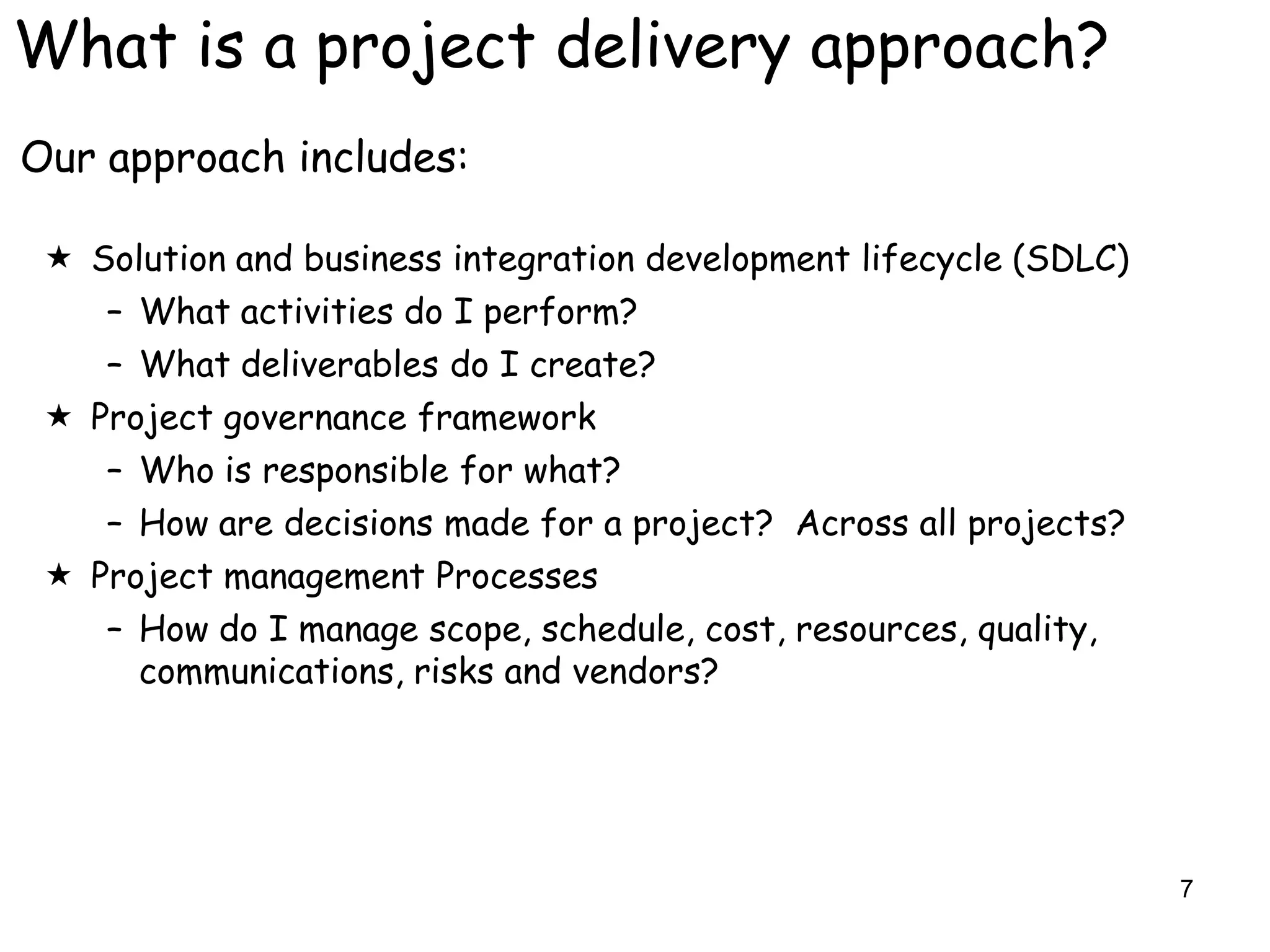

What is a project delivery approach?
Our approach includes:

  Solution and business integration development lifecycle (SDLC)
    – What activities do I perform?
    – What deliverables do I create?
  Project governance framework
    – Who is responsible for what?
    – How are decisions made for a project? Across all projects?
  Project management Processes
    – How do I manage scope, schedule, cost, resources, quality,
      communications, risks and vendors?

                                                                    7

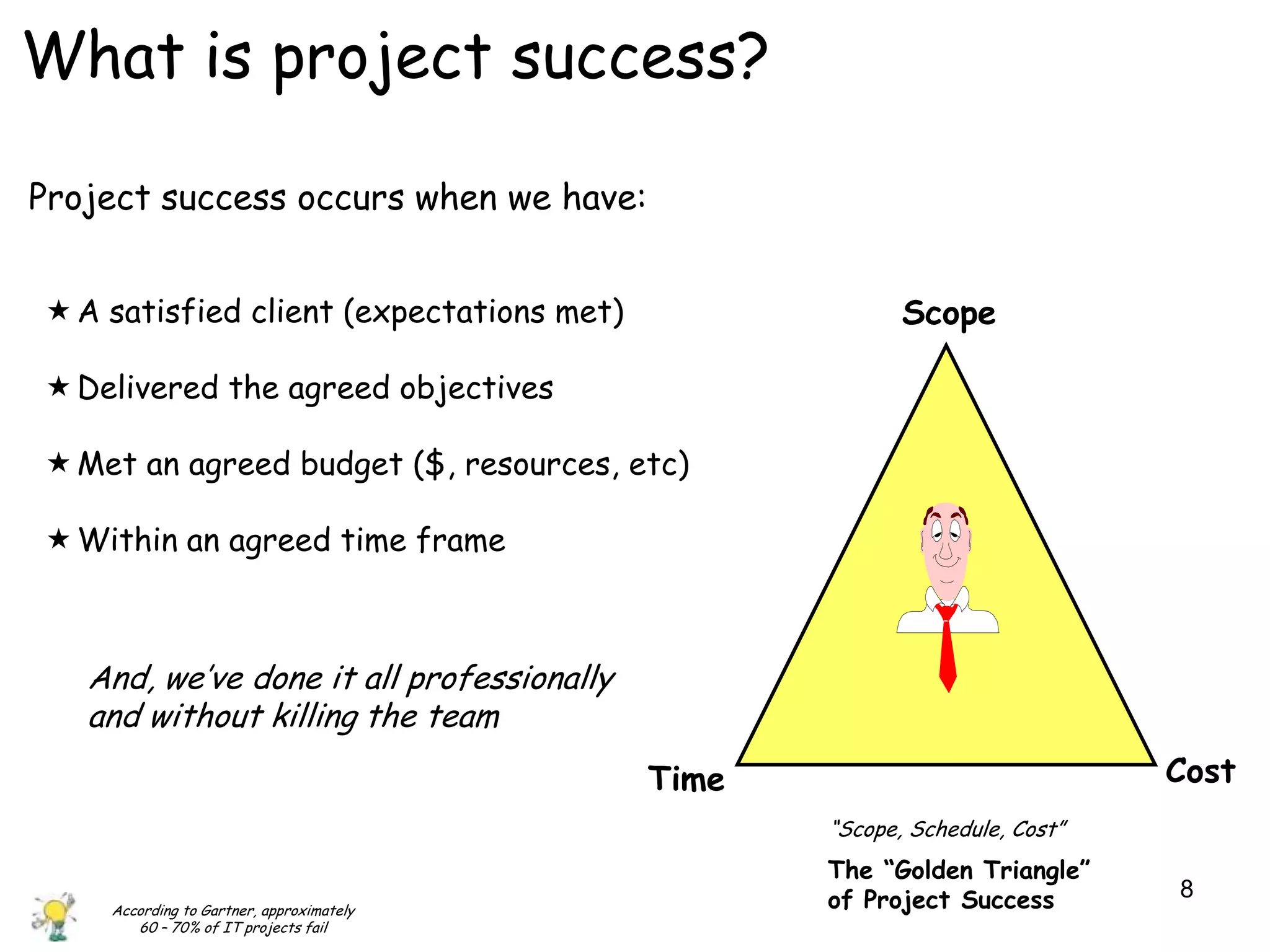

What is project success?

Project success occurs when we have:

 A satisfied client (expectations met)                  Scope

 Delivered the agreed objectives

 Met an agreed budget ($, resources, etc)

 Within an agreed time frame

   And, we‟ve done it all professionally
   and without killing the team
                                           Time                             Cost
                                                  “Scope, Schedule, Cost”
                                                  The “Golden Triangle”
                                                  of Project Success        8
    According to Gartner, approximately
       60 – 70% of IT projects fail
Simply put, success is a balancing act
                       YOU THINK THIS IS HARD?
                           IN MY LAST JOB I
                       MANAGED PROJECTS WITH
                       MULTIPLE STAKEHOLDERS
                          AND CONFLICTING
                              PRIORITIES

                                                 9

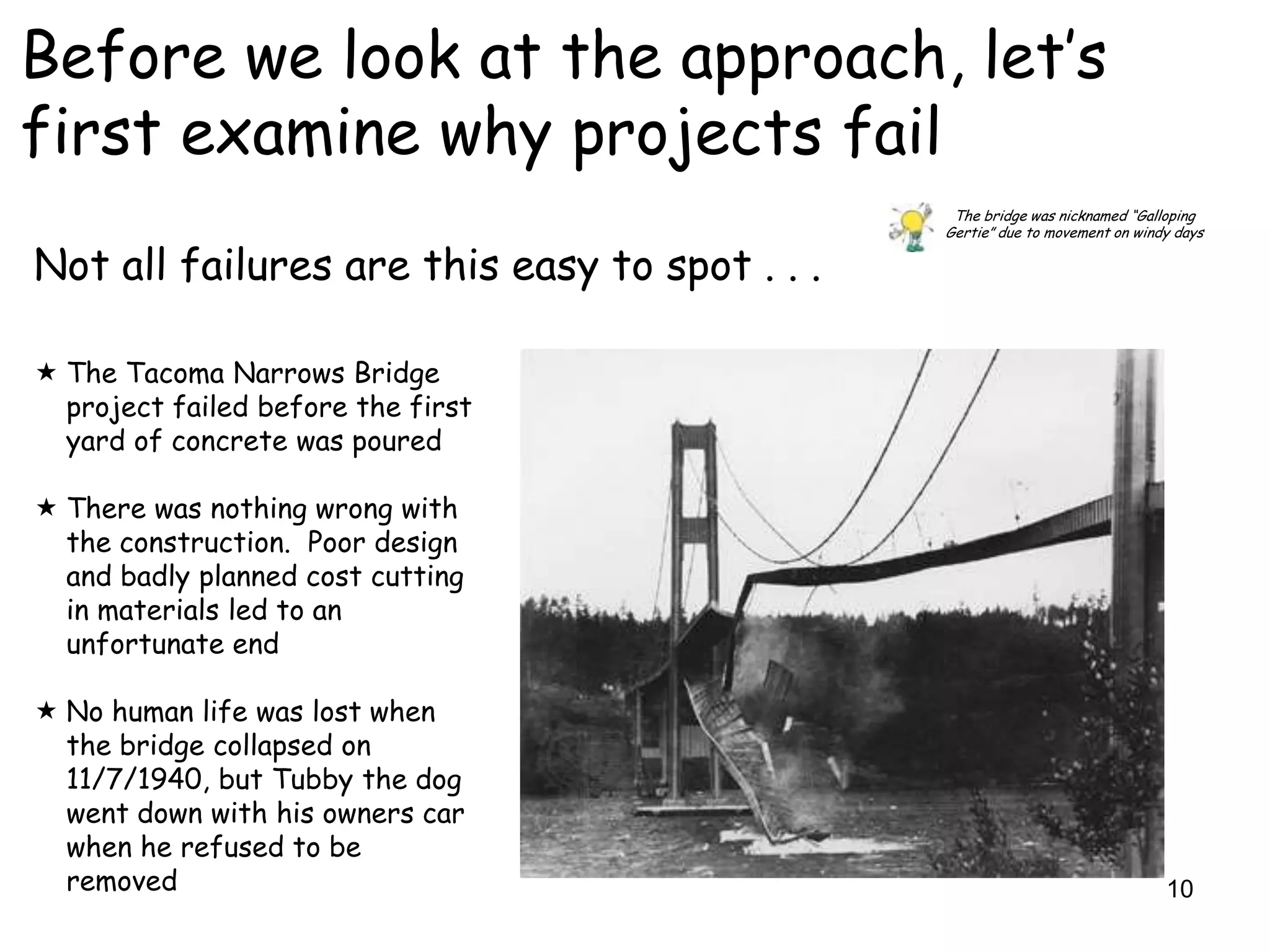

Before we look at the approach, let‟s
first examine why projects fail
                                                The bridge was nicknamed “Galloping
                                               Gertie” due to movement on windy days

Not all failures are this easy to spot . . .

 The Tacoma Narrows Bridge
  project failed before the first
  yard of concrete was poured

 There was nothing wrong with
  the construction. Poor design
  and badly planned cost cutting
  in materials led to an
  unfortunate end

 No human life was lost when
  the bridge collapsed on
  11/7/1940, but Tubby the dog
  went down with his owners car
  when he refused to be
  removed                                                                     10
“This time it‟s different”
There‟s an old saying about how there are a million
ways to fail, but only one way to be right. When it
comes to projects, nothing‟s further from the truth.
Projects fail the same few ways over and over again.

Don‟t go in the basement!
Technology projects are a lot like cheesy horror
movies. After you‟ve seen a few of them, you know that
the first guy to leave the group is going to get an axe in
his head. Projects are the same way. People keep
making the same mistakes over and over, and it keeps
getting their projects killed.

                                                             11

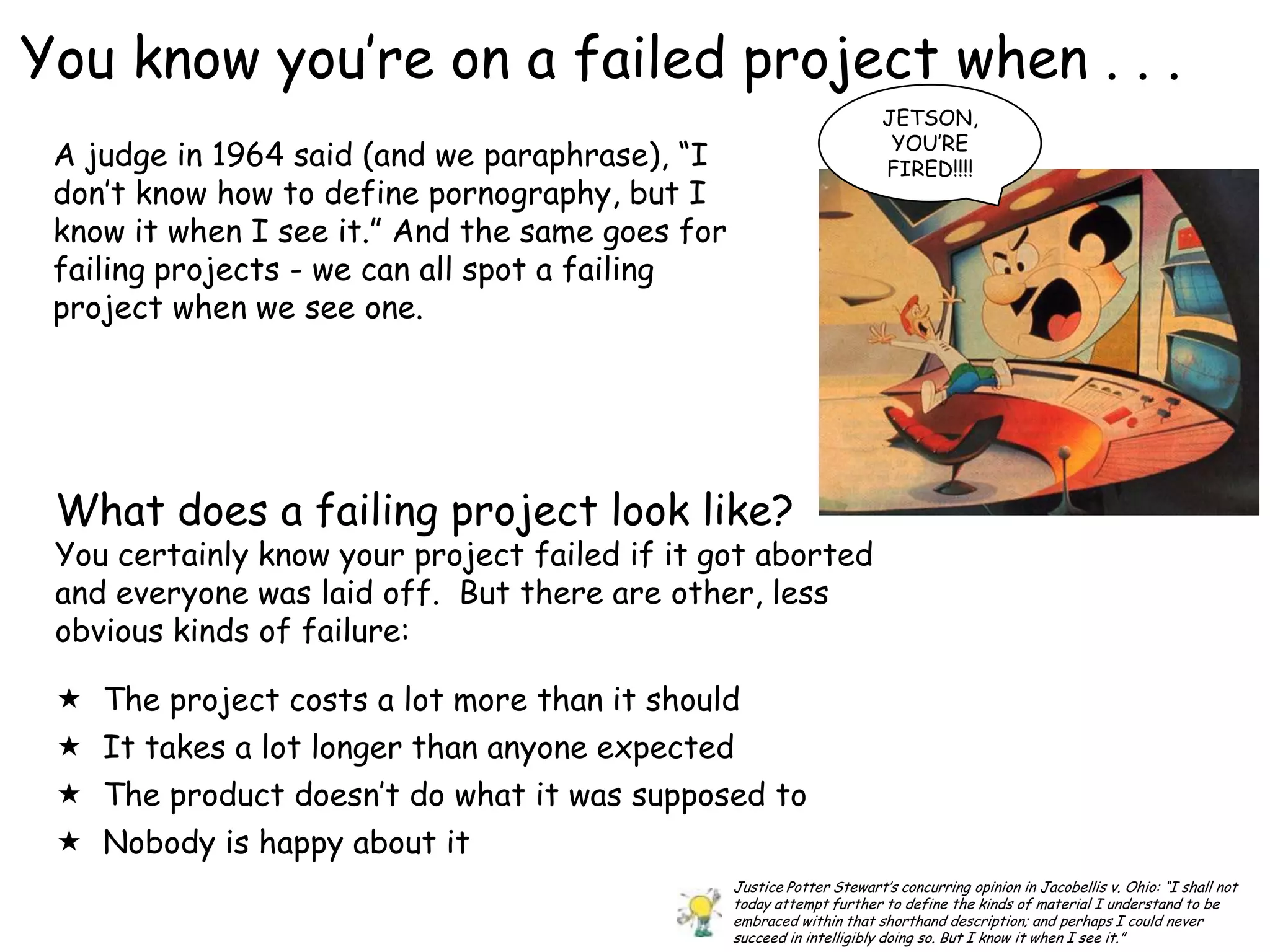

You know you‟re on a failed project when . . .
                                                                        JETSON,
                                                                         YOU‟RE
 A judge in 1964 said (and we paraphrase), “I                           FIRED!!!!
 don‟t know how to define pornography, but I
 know it when I see it.” And the same goes for
 failing projects - we can all spot a failing
 project when we see one.

 What does a failing project look like?
 You certainly know your project failed if it got aborted
 and everyone was laid off. But there are other, less
 obvious kinds of failure:

  The project costs a lot more than it should
  It takes a lot longer than anyone expected
  The product doesn‟t do what it was supposed to
  Nobody is happy about it
                                                 Justice Potter Stewart‟s concurring opinion in Jacobellis v. Ohio: “I shall not
                                                                                                                    12
                                                 today attempt further to define the kinds of material I understand to be
                                                 embraced within that shorthand description; and perhaps I could never
                                                 succeed in intelligibly doing so. But I know it when I see it.”
Sometimes failure seems normal
Nobody sets out to fail, but for some reason people
just accept that a lot of technology projects won‟t
deliver on time, on budget with the expected scope
intact. But talking about what causes failure makes
people uncomfortable, because nobody wants to give or
take that kind of criticism.

A show of hands, please…
We‟ve never met a single IT professional with more than
a few years of experience who hasn‟t been on at least
one failed project.

        Are there any here?

                                                          13

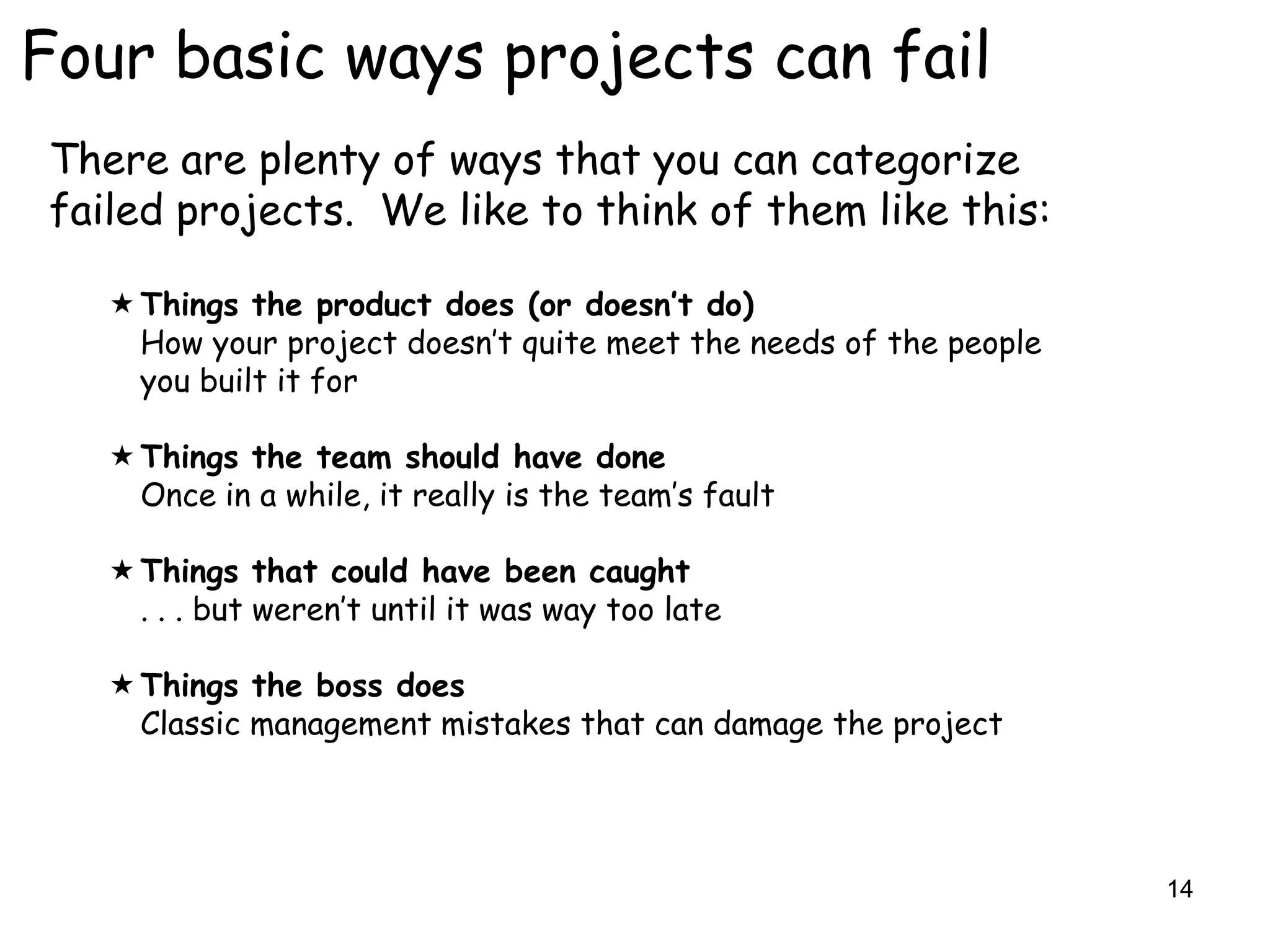

Four basic ways projects can fail
There are plenty of ways that you can categorize
failed projects. We like to think of them like this:

    Things the product does (or doesn’t do)
     How your project doesn‟t quite meet the needs of the people
     you built it for

    Things the team should have done
     Once in a while, it really is the team‟s fault

    Things that could have been caught
     . . . but weren‟t until it was way too late

    Things the boss does
     Classic management mistakes that can damage the project

                                                                   14

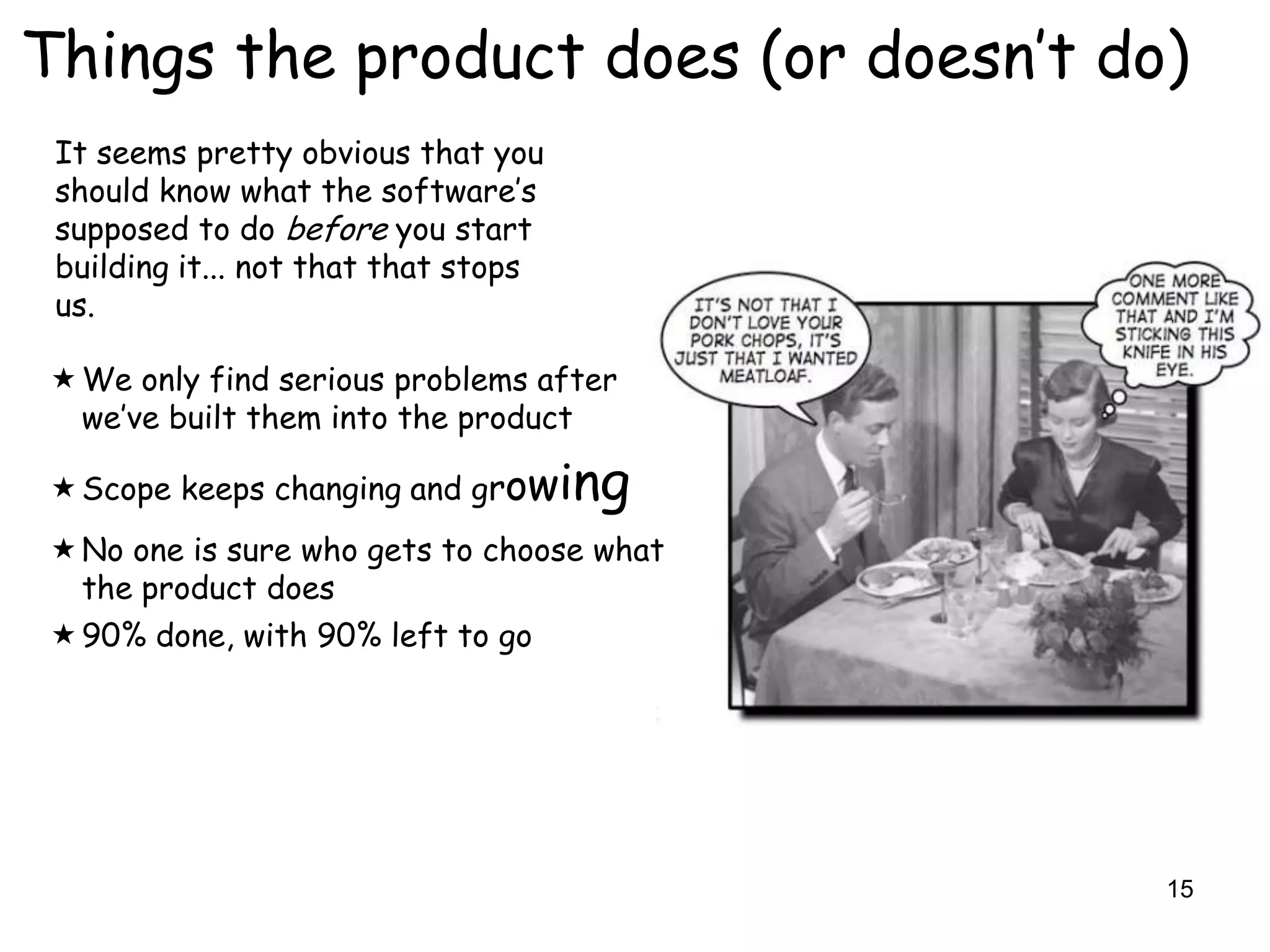

Things the product does (or doesn‟t do)
 It seems pretty obvious that you
 should know what the software‟s
 supposed to do before you start
 building it... not that that stops
 us.

 We only find serious problems after
  we‟ve built them into the product

 Scope keeps changing and growi      ng
 No one is sure who gets to choose what
  the product does
 90% done, with 90% left to go

                                           15

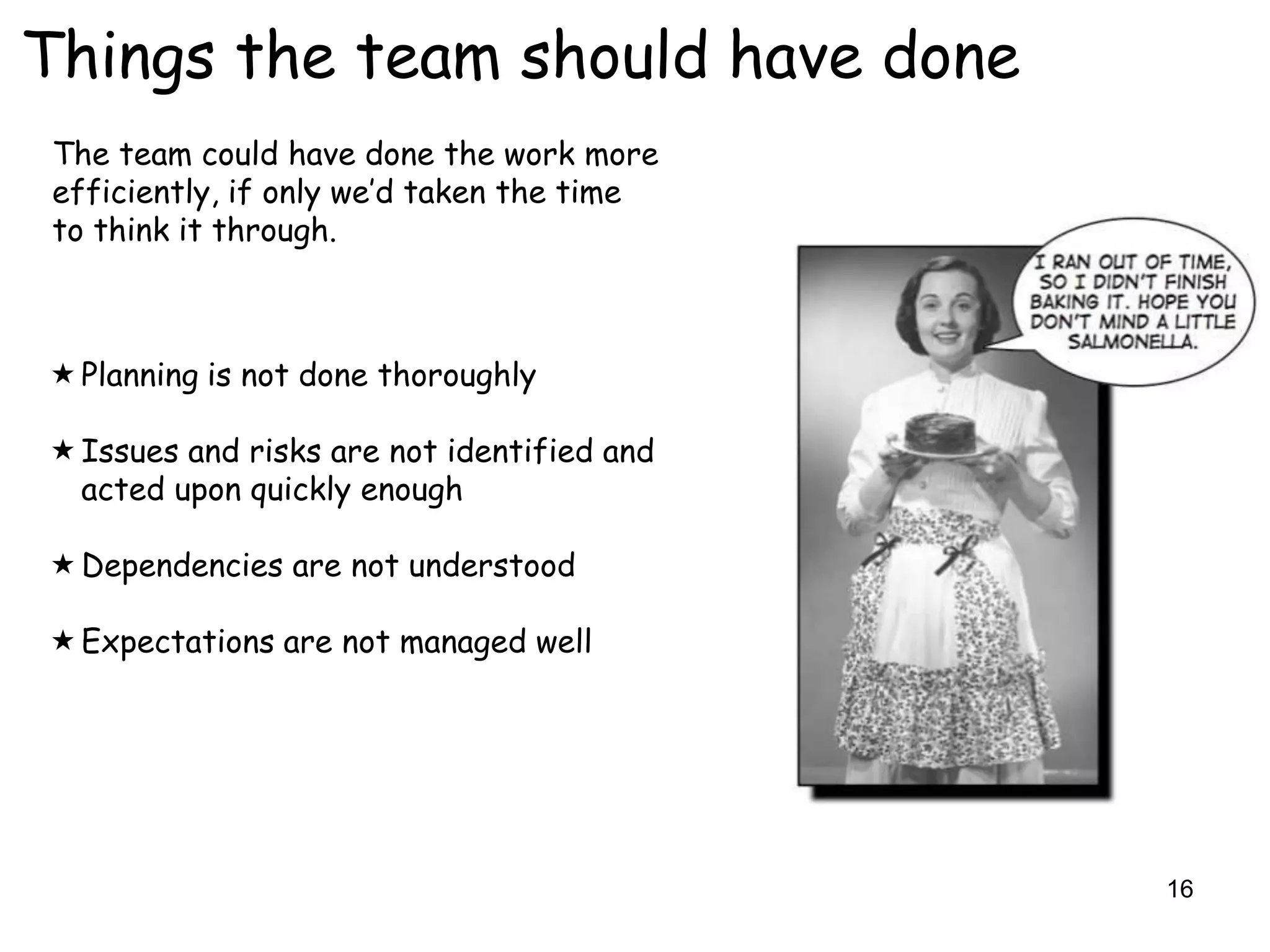

Things the team should have done
 The team could have done the work more
 efficiently, if only we‟d taken the time
 to think it through.

 Planning is not done thoroughly

 Issues and risks are not identified and
  acted upon quickly enough

 Dependencies are not understood

 Expectations are not managed well

                                            16

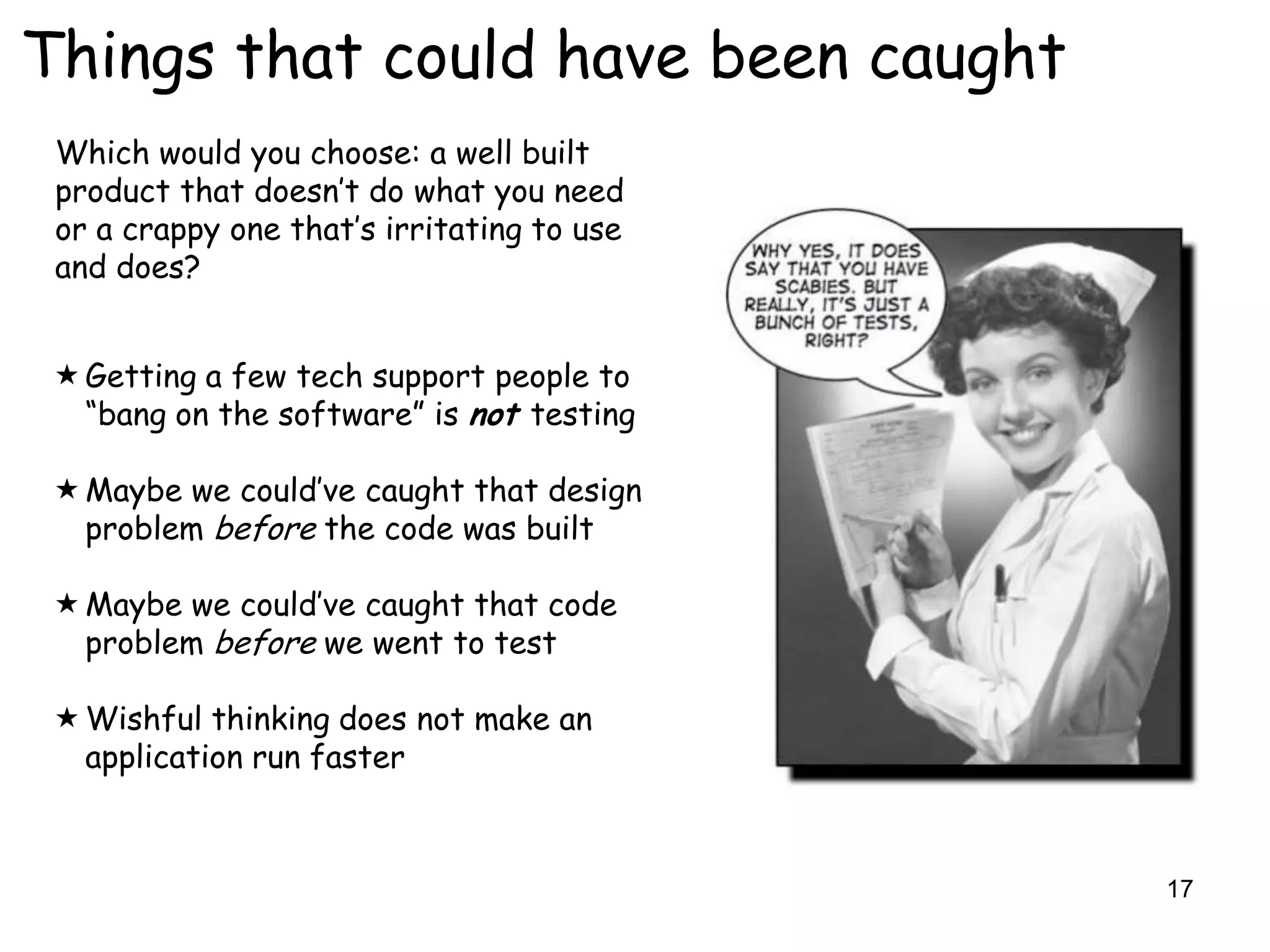

Things that could have been caught
 Which would you choose: a well built
 product that doesn‟t do what you need
 or a crappy one that‟s irritating to use
 and does?

  Getting a few tech support people to
   “bang on the software” is not testing

  Maybe we could‟ve caught that design
   problem before the code was built

  Maybe we could‟ve caught that code
   problem before we went to test

  Wishful thinking does not make an
   application run faster

                                            17
Things the boss does
Some problems start with senior
managers, others start with key
stakeholders, but they can all sink the
project.

  Over promising

  Ignoring issues and risks

  Artificial wall between the business
   and technology

  Over simplifying

                                          18
Brains are important too . ..
                                                                    HOW MANY TIMES
 A good approach is not a replacement                               DO I HAVE TO TELL
 for good judgment and sound skills. We                              YOU, IT‟S RIGHT
                                                                      TIGHTY, LEFTY
 could have the best tools in the world,                                 LOOSEY
 but most of us still could not fix the
 space shuttle or perform surgery.

  A sound approach is a good start, but
   we also need to be the owners of our
   own ability
  Understanding how to use the tools
   and your own personal development
   path is probably the most important
   thing we would like you to learn today
  The good news is that a standard,
   proven approach will help us to focus
   on the execution of the work and help
   us to better help each other

                                            Goober worked at Wally's Filling Station, which he   19
                                             eventually purchased and became the proprietor
The talent is there… the delivery management‟s not

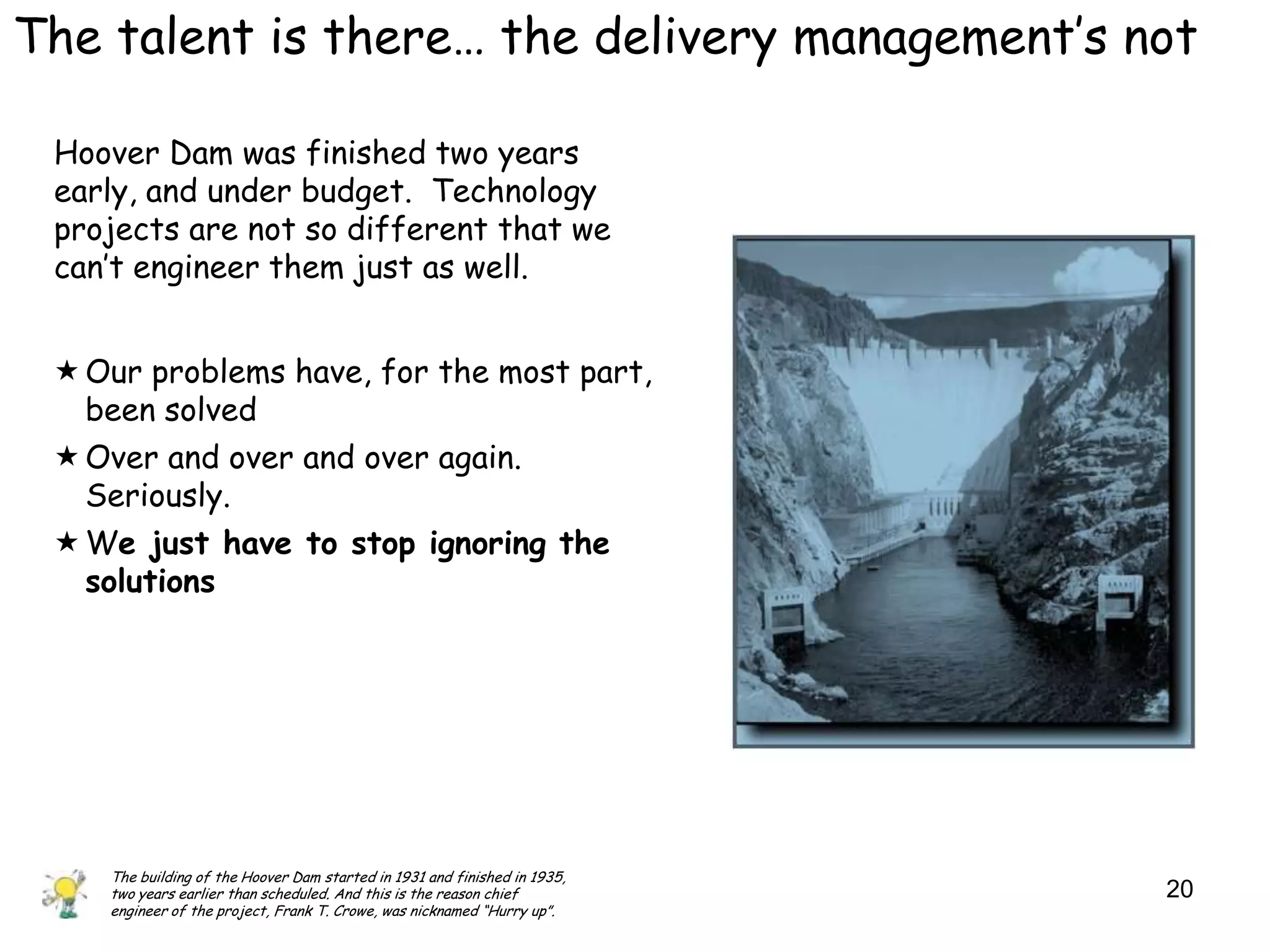

 Hoover Dam was finished two years
 early, and under budget. Technology
 projects are not so different that we
 can‟t engineer them just as well.

  Our problems have, for the most part,
   been solved
  Over and over and over again.
   Seriously.
  We just have to stop ignoring the
   solutions

    The building of the Hoover Dam started in 1931 and finished in 1935,
    two years earlier than scheduled. And this is the reason chief         20
    engineer of the project, Frank T. Crowe, was nicknamed “Hurry up”.

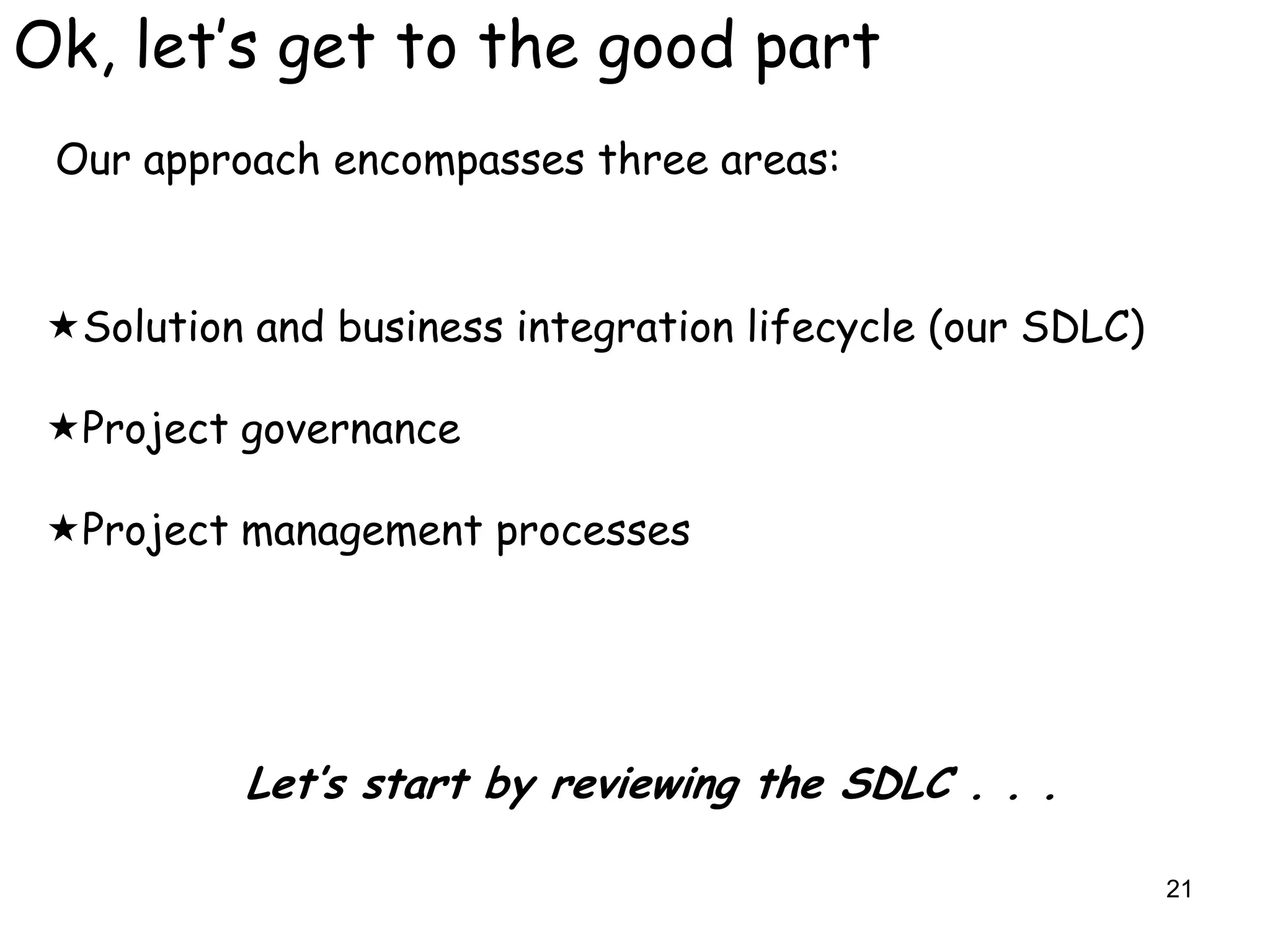

Ok, let‟s get to the good part

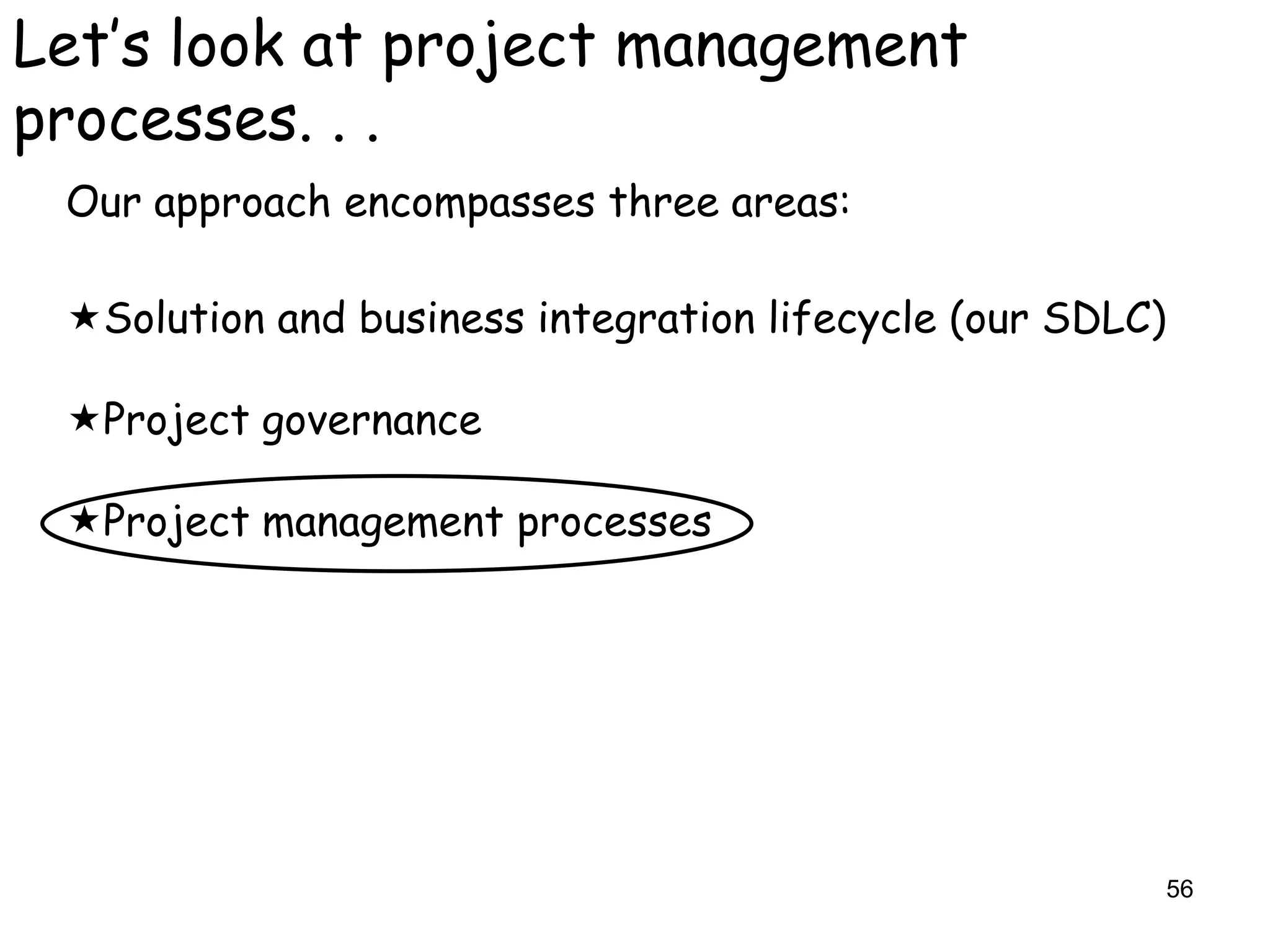

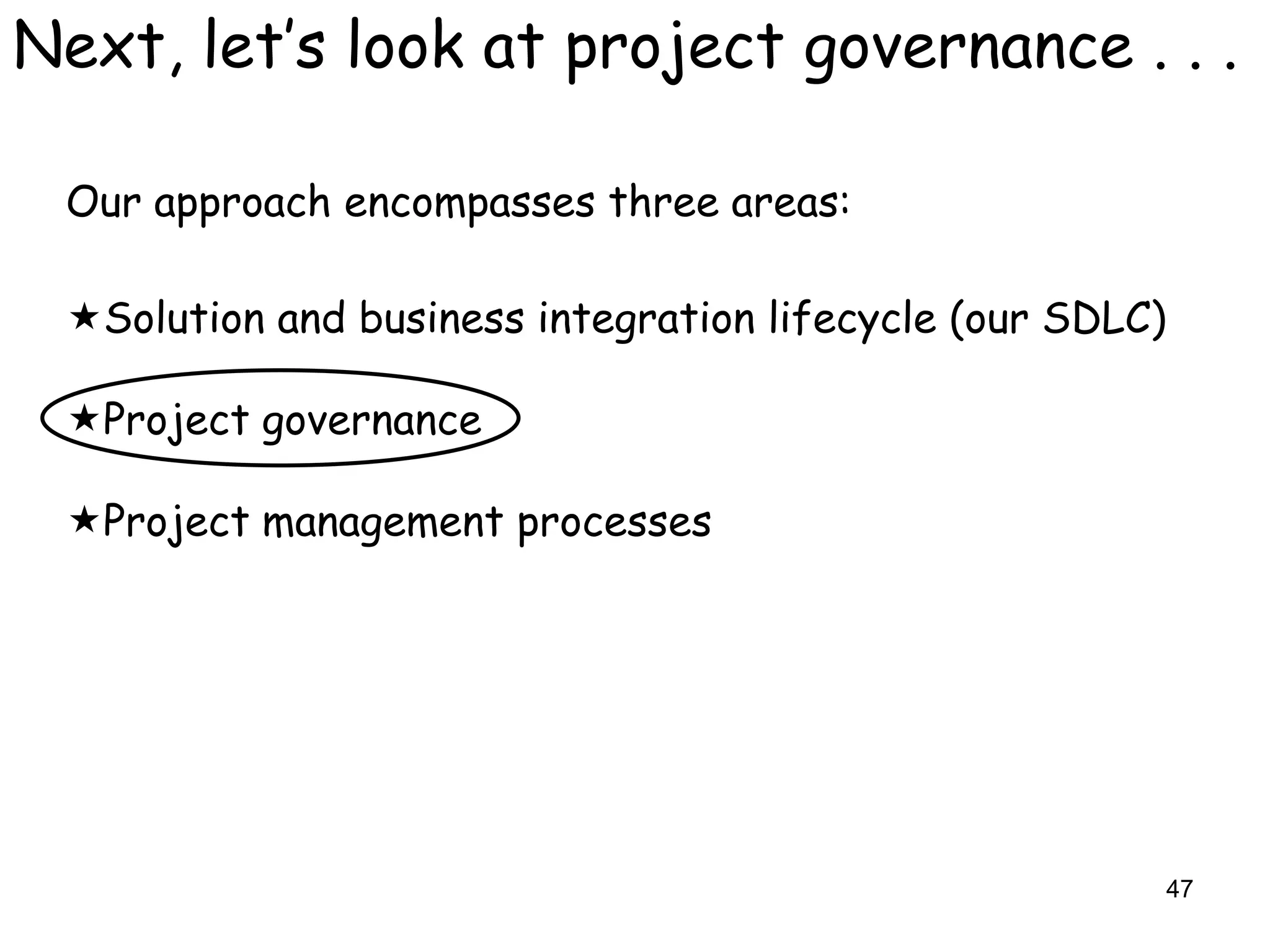

 Our approach encompasses three areas:

 Solution and business integration lifecycle (our SDLC)

 Project governance

 Project management processes

           Let’s start by reviewing the SDLC . . .

                                                           21

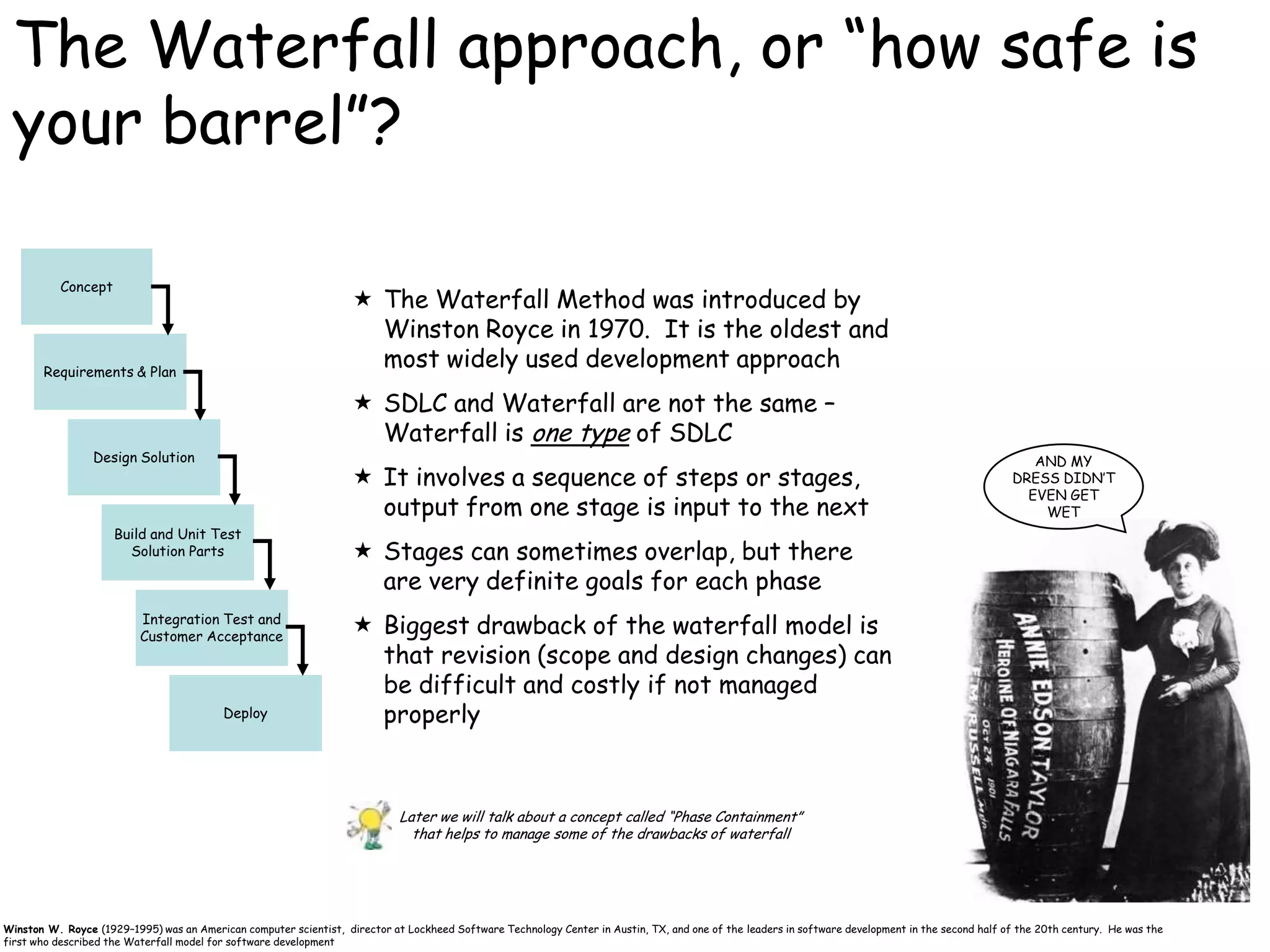

The Waterfall approach, or “how safe is
 your barrel”?

           Concept
                                                                    The Waterfall Method was introduced by
                                                                     Winston Royce in 1970. It is the oldest and
       Requirements & Plan
                                                                     most widely used development approach
                                                                    SDLC and Waterfall are not the same –
                                                                     Waterfall is one type of SDLC
                 Design Solution                                                                                                                                                                      AND MY
                                                                    It involves a sequence of steps or stages,                                                                                    DRESS DIDN‟T
                                                                                                                                                                                                     EVEN GET
                                                                     output from one stage is input to the next                                                                                        WET
                     Build and Unit Test
                       Solution Parts                               Stages can sometimes overlap, but there
                                                                     are very definite goals for each phase
                          Integration Test and
                          Customer Acceptance
                                                                    Biggest drawback of the waterfall model is
                                                                     that revision (scope and design changes) can
                                                                     be difficult and costly if not managed
                                          Deploy                     properly

                                                                            Later we will talk about a concept called “Phase Containment”
                                                                              that helps to manage some of the drawbacks of waterfall

                                                                                                                                                                                                                                    22
Winston W. Royce (1929–1995) was an American computer scientist, director at Lockheed Software Technology Center in Austin, TX, and one of the leaders in software development in the second half of the 20th century. He was the
first who described the Waterfall model for software development
Phases

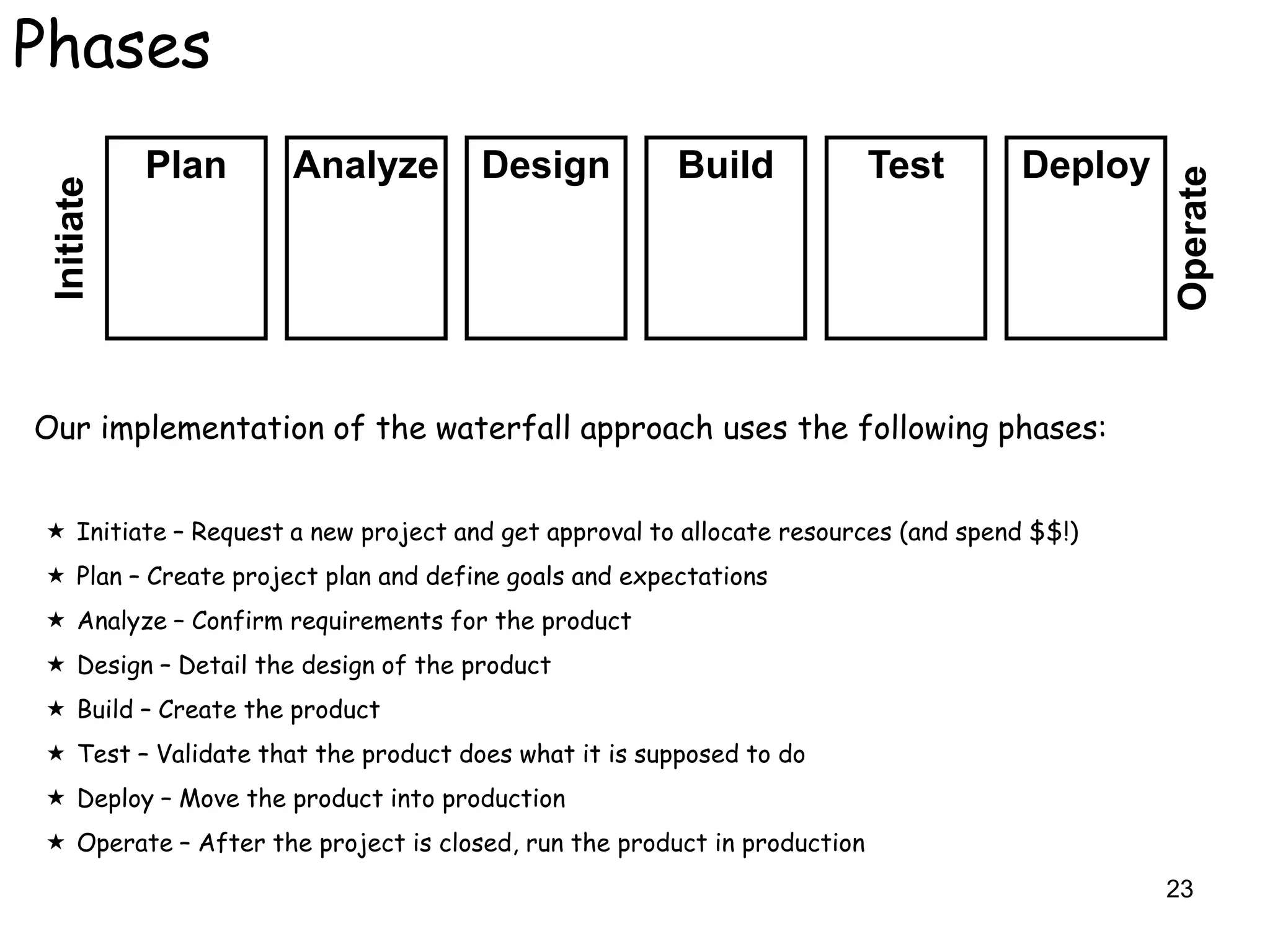

            Plan     Analyze         Design           Build              Test       Deploy

                                                                                             Operate
 Initiate

Our implementation of the waterfall approach uses the following phases:

 Initiate – Request a new project and get approval to allocate resources (and spend $$!)
 Plan – Create project plan and define goals and expectations
 Analyze – Confirm requirements for the product
 Design – Detail the design of the product
 Build – Create the product
 Test – Validate that the product does what it is supposed to do
 Deploy – Move the product into production
 Operate – After the project is closed, run the product in production
                                                                                             23

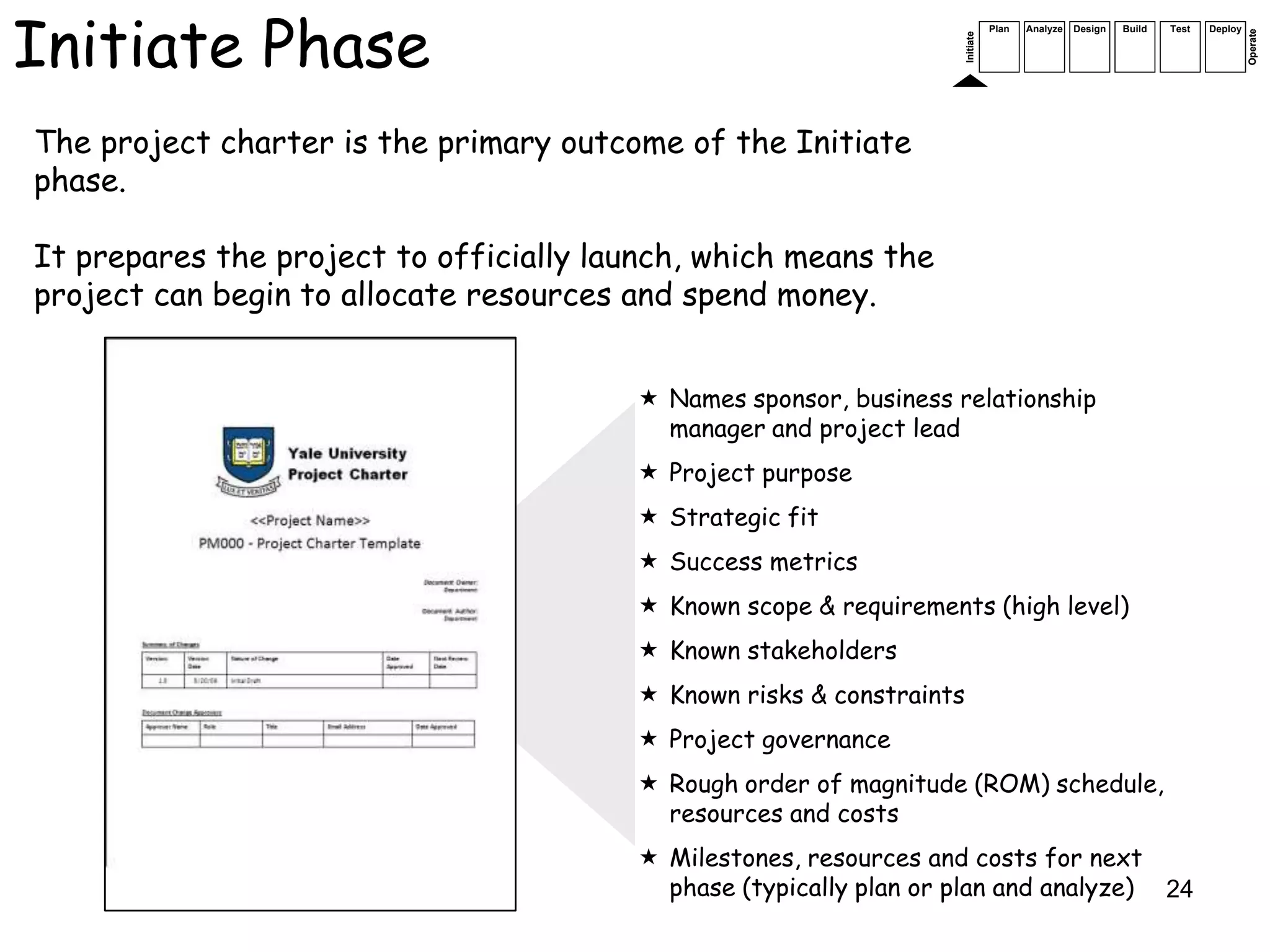

Initiate Phase
                                                                                 Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                   Operate
                                                                      Initiate
The project charter is the primary outcome of the Initiate
phase.

It prepares the project to officially launch, which means the
project can begin to allocate resources and spend money.

                                         Names sponsor, business relationship
                                          manager and project lead
                                         Project purpose
                                         Strategic fit
                                         Success metrics
                                         Known scope & requirements (high level)
                                         Known stakeholders
                                         Known risks & constraints
                                         Project governance
                                         Rough order of magnitude (ROM) schedule,
                                          resources and costs
                                         Milestones, resources and costs for next
                                          phase (typically plan or plan and analyze) 24

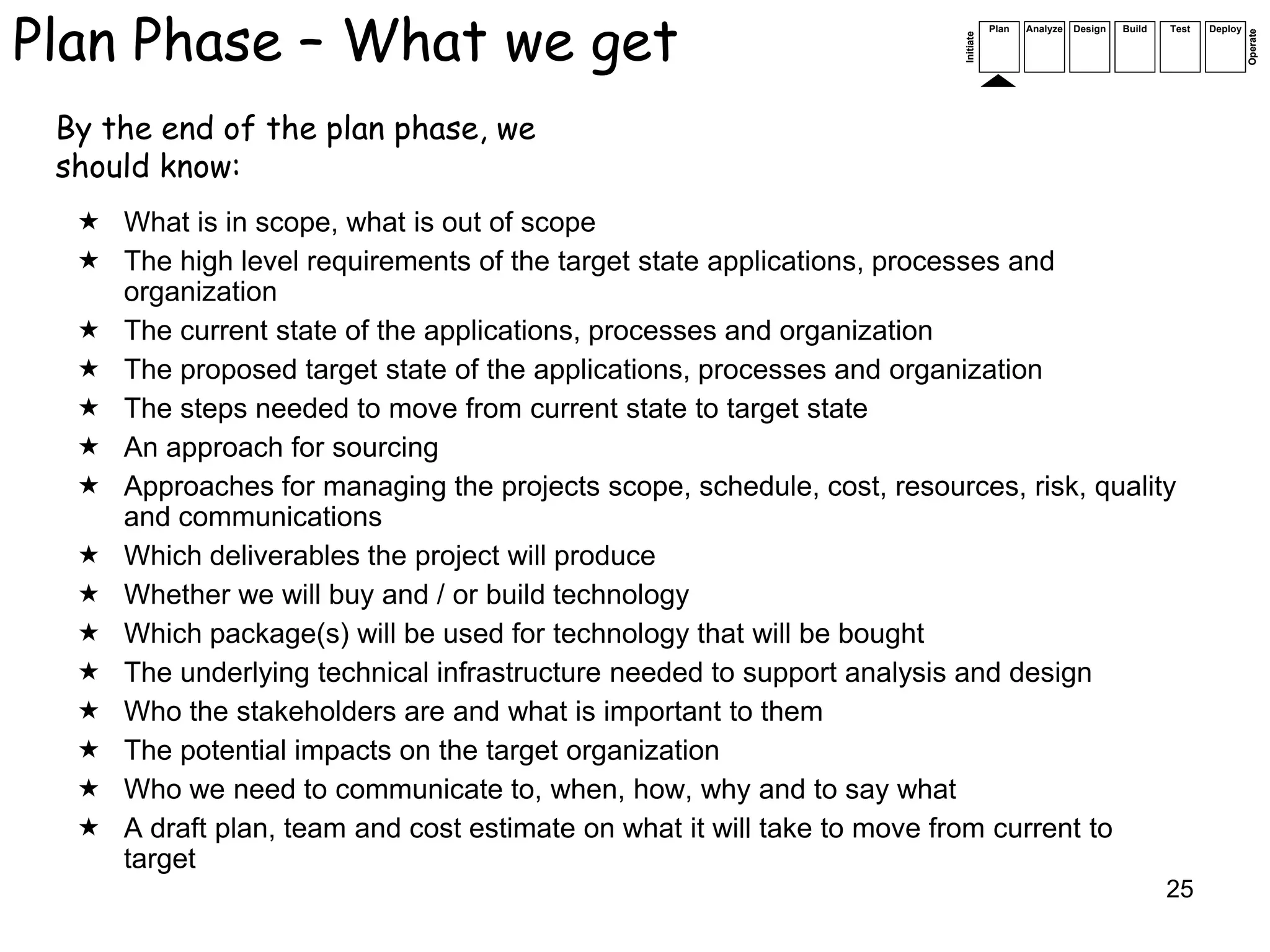

Plan Phase – What we get                                                          Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                    Operate
                                                                       Initiate
 By the end of the plan phase, we
 should know:
   What is in scope, what is out of scope
   The high level requirements of the target state applications, processes and
    organization
   The current state of the applications, processes and organization
   The proposed target state of the applications, processes and organization
   The steps needed to move from current state to target state
   An approach for sourcing
   Approaches for managing the projects scope, schedule, cost, resources, risk, quality
    and communications
   Which deliverables the project will produce
   Whether we will buy and / or build technology
   Which package(s) will be used for technology that will be bought
   The underlying technical infrastructure needed to support analysis and design
   Who the stakeholders are and what is important to them
   The potential impacts on the target organization
   Who we need to communicate to, when, how, why and to say what
   A draft plan, team and cost estimate on what it will take to move from current to
    target
                                                                                                                    25
Plan Phase – What we do                                                                   Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                            Operate
                                                                               Initiate
Formally establish the project. Staff initial team members,
   begin project meetings, establish steering committee,
               create project status reports

                                                                Document how the project will be organized and governed –
                                                                consider who is responsible for each aspect of the project,
                                                                how the team will be organized, what forums will be used to
                                                                       govern the project and who is on each forum

                                                                 Define the underlying technical architecture required to
                                                                       support the target application environment

                                                                    Define who needs to know what, when, how and why

 Assess the delivery approach and tailor it to the needs of
 the project. This includes phases, activities, deliverables,
gating, sourcing, usage of vendors and other 3rd parties, etc

                                                                                                                            26

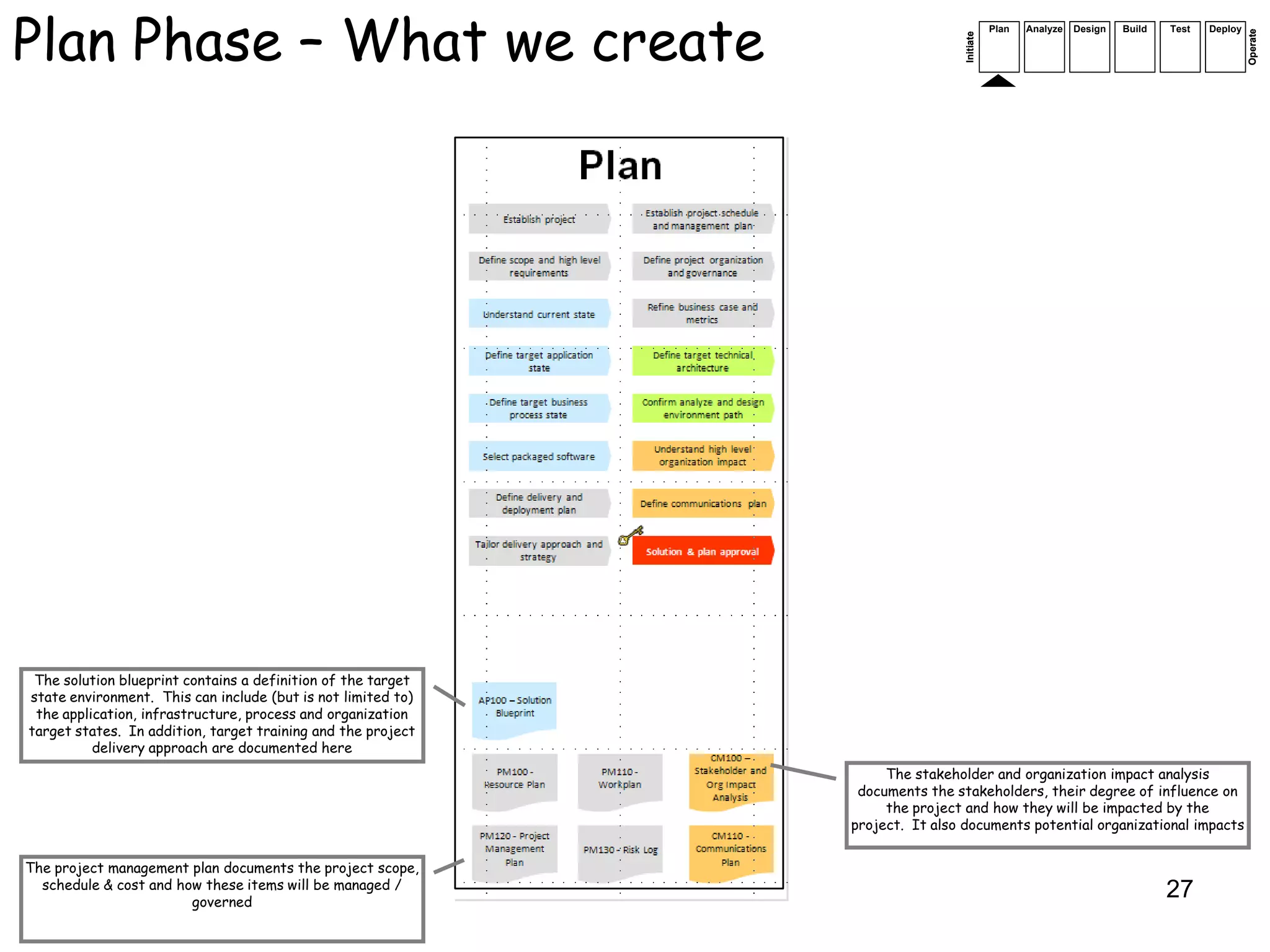

Plan Phase – What we create                                                               Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                            Operate
                                                                               Initiate
 The solution blueprint contains a definition of the target
state environment. This can include (but is not limited to)
 the application, infrastructure, process and organization
target states. In addition, target training and the project
          delivery approach are documented here
                                                                   The stakeholder and organization impact analysis
                                                               documents the stakeholders, their degree of influence on
                                                                   the project and how they will be impacted by the
                                                              project. It also documents potential organizational impacts

The project management plan documents the project scope,
  schedule & cost and how these items will be managed /
                        governed
                                                                                                                            27
Analyze Phase – What we get                                                         Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                      Operate
                                                                         Initiate
 By the end of the analyze phase, we
 should know:

     How the target state processes will work
     The detailed requirements that the target state must support
     Where there are gaps in how the vendor package(s) support the requirements
     General approach for filling the gaps (e.g., custom mod, drop requirement, etc)
     Use cases and the conceptual data model, for custom development
     Identification of the RICEFW widgets that will be designed and built (RICEFW =
      Reports, Interfaces, Conversions, Extensions, Forms, Workflows)
     High level designs to reflect how the requirements will be supported (where
      applicable and needed to determine RICEFW definition)
     The approach that will be used to test that the target solution meets the
      requirements and does not have a negative impact on other systems or
      processes
     The definition of, and the plan to build (where necessary) the technical
      infrastructure needed to support build, test and deploy
     The approach that will be used to train users and other impacted parties on the
      target solution
     Understanding of the current organization
     Understanding of the impact of new processes and technologies on the
      organization, including roles, jobs, teams and performance measures
     A baseline plan, team and cost estimate on what it will take to move from current
      to target                                                                                                       28

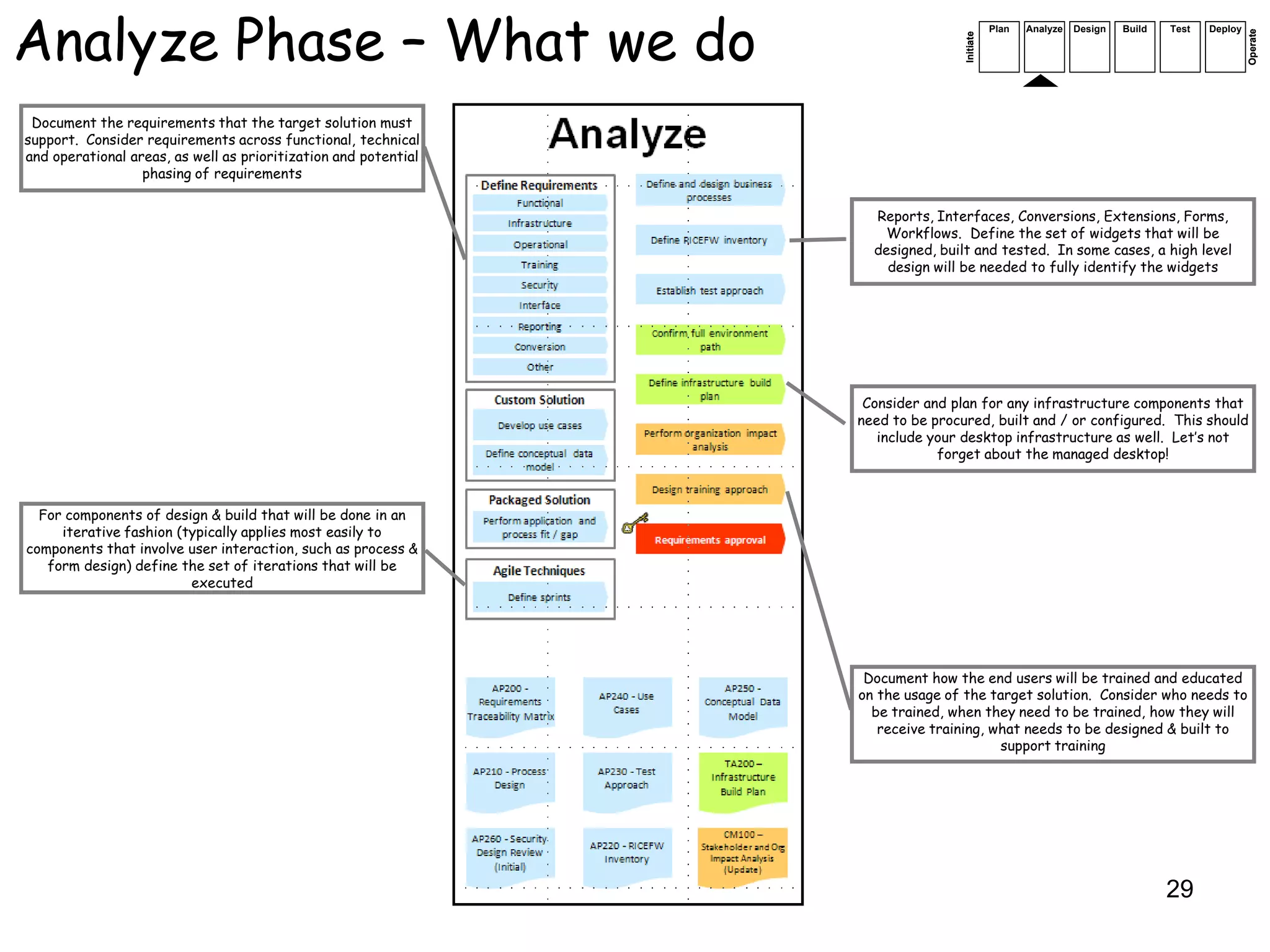

Analyze Phase – What we do                                                                  Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                              Operate
                                                                                 Initiate
 Document the requirements that the target solution must
support. Consider requirements across functional, technical
and operational areas, as well as prioritization and potential
                  phasing of requirements

                                                                   Reports, Interfaces, Conversions, Extensions, Forms,
                                                                     Workflows. Define the set of widgets that will be
                                                                   designed, built and tested. In some cases, a high level
                                                                     design will be needed to fully identify the widgets

                                                                  Consider and plan for any infrastructure components that
                                                                 need to be procured, built and / or configured. This should
                                                                    include your desktop infrastructure as well. Let‟s not
                                                                             forget about the managed desktop!

  For components of design & build that will be done in an
     iterative fashion (typically applies most easily to
components that involve user interaction, such as process &
   form design) define the set of iterations that will be
                         executed

                                                                  Document how the end users will be trained and educated
                                                                 on the usage of the target solution. Consider who needs to
                                                                   be trained, when they need to be trained, how they will
                                                                    receive training, what needs to be designed & built to
                                                                                       support training

                                                                                                                              29

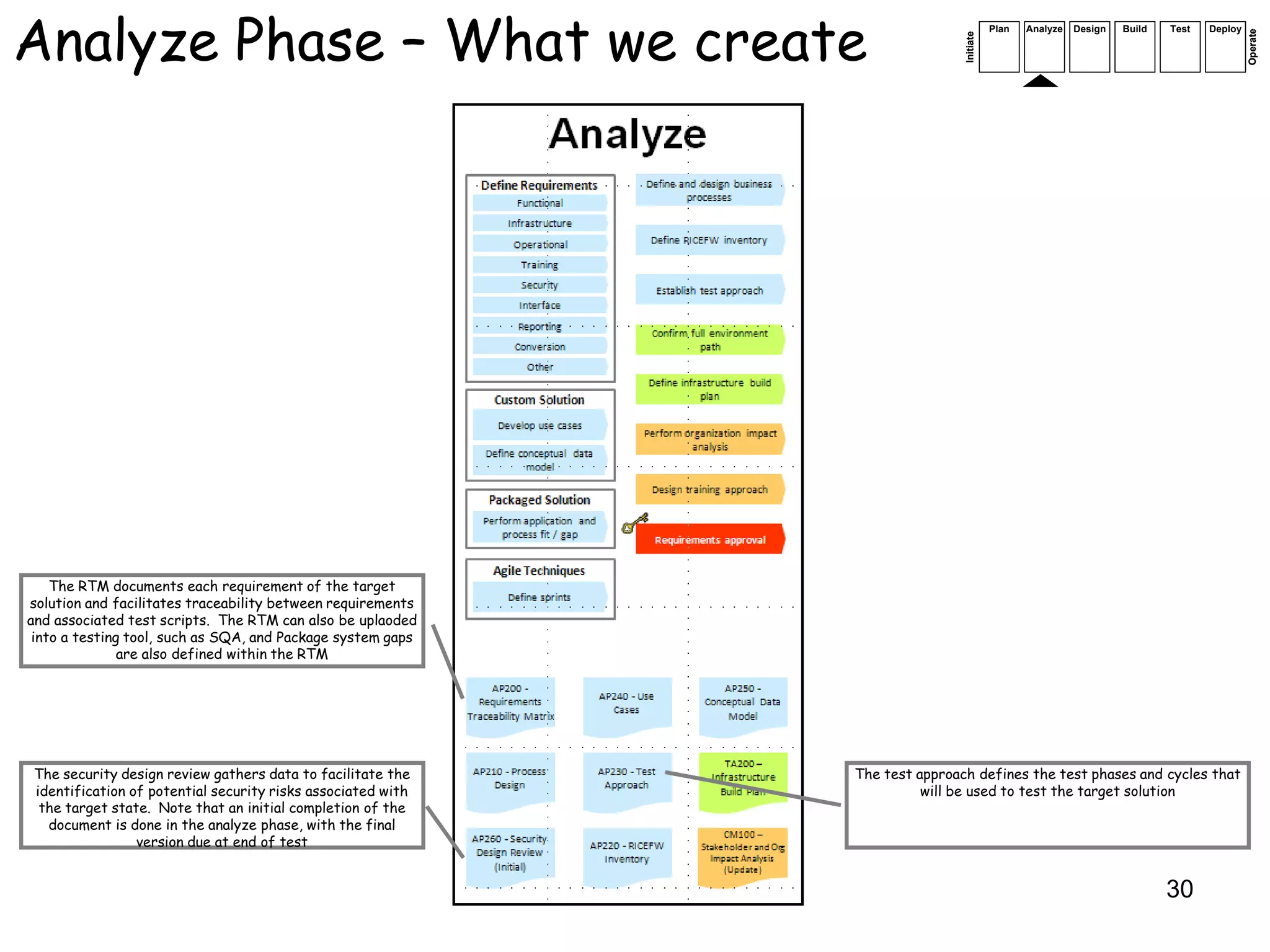

Analyze Phase – What we create                                                          Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                          Operate
                                                                             Initiate
    The RTM documents each requirement of the target
solution and facilitates traceability between requirements
and associated test scripts. The RTM can also be uplaoded
 into a testing tool, such as SQA, and Package system gaps
               are also defined within the RTM

The security design review gathers data to facilitate the    The test approach defines the test phases and cycles that
identification of potential security risks associated with             will be used to test the target solution
 the target state. Note that an initial completion of the
  document is done in the analyze phase, with the final
                version due at end of test

                                                                                                                          30

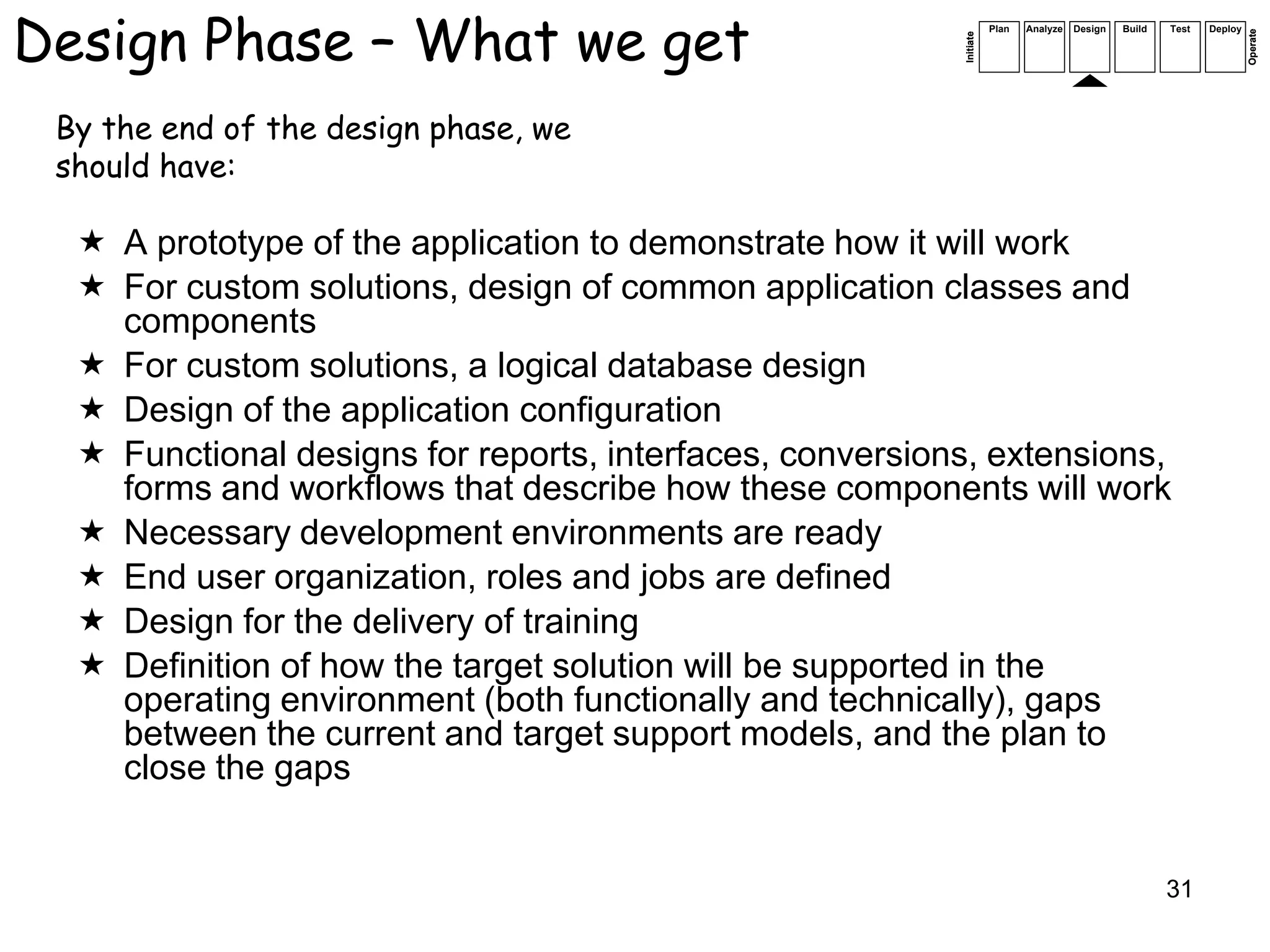

Design Phase – What we get                                           Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                       Operate
                                                          Initiate
 By the end of the design phase, we
 should have:

   A prototype of the application to demonstrate how it will work
   For custom solutions, design of common application classes and
    components
   For custom solutions, a logical database design
   Design of the application configuration
   Functional designs for reports, interfaces, conversions, extensions,
    forms and workflows that describe how these components will work
   Necessary development environments are ready
   End user organization, roles and jobs are defined
   Design for the delivery of training
   Definition of how the target solution will be supported in the
    operating environment (both functionally and technically), gaps
    between the current and target support models, and the plan to
    close the gaps

                                                                                                       31

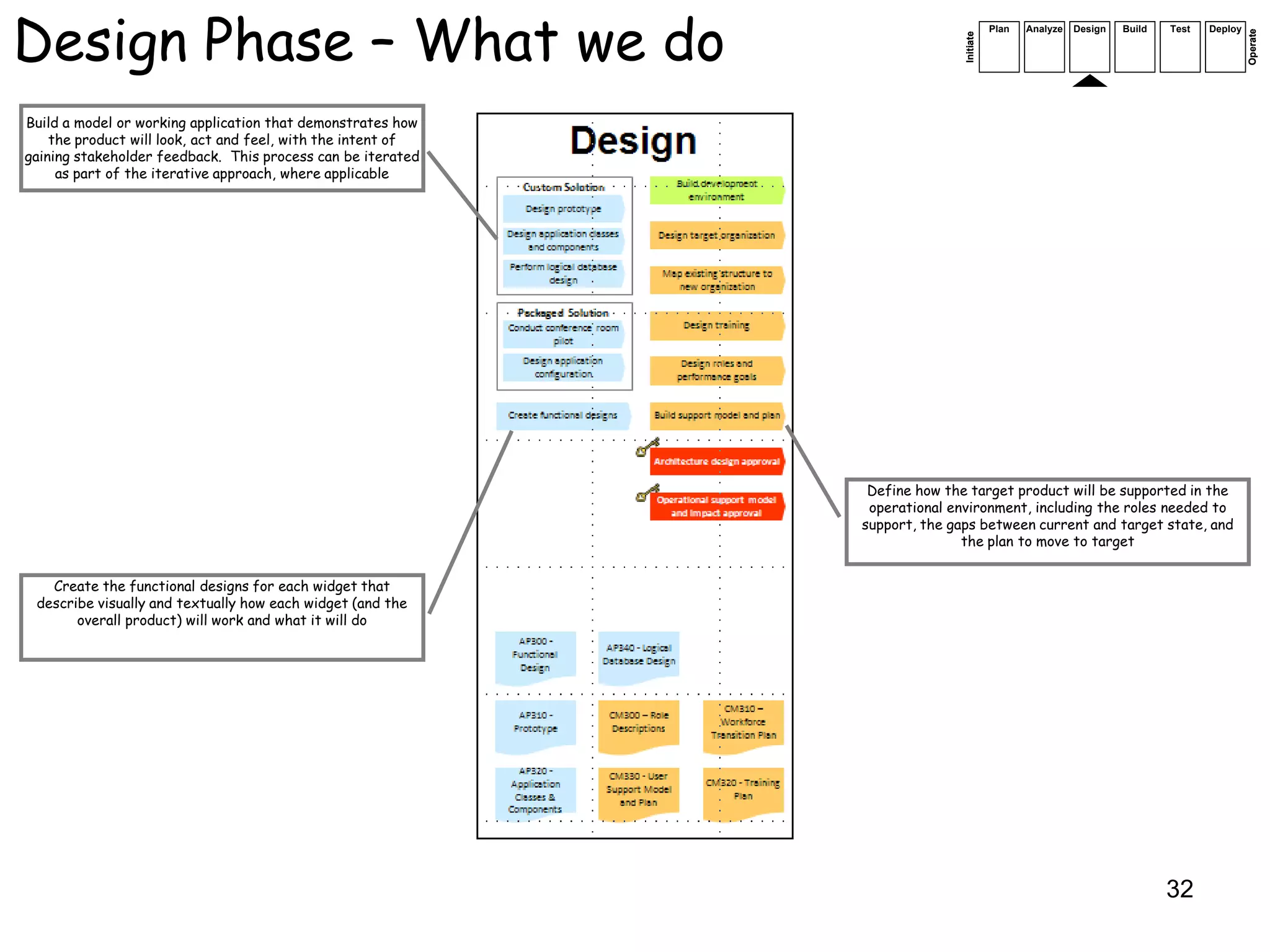

Design Phase – What we do                                                               Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                          Operate
                                                                             Initiate
Build a model or working application that demonstrates how
    the product will look, act and feel, with the intent of
gaining stakeholder feedback. This process can be iterated
     as part of the iterative approach, where applicable

                                                               Define how the target product will be supported in the
                                                               operational environment, including the roles needed to
                                                              support, the gaps between current and target state, and
                                                                             the plan to move to target

   Create the functional designs for each widget that
 describe visually and textually how each widget (and the
       overall product) will work and what it will do

                                                                                                                          32

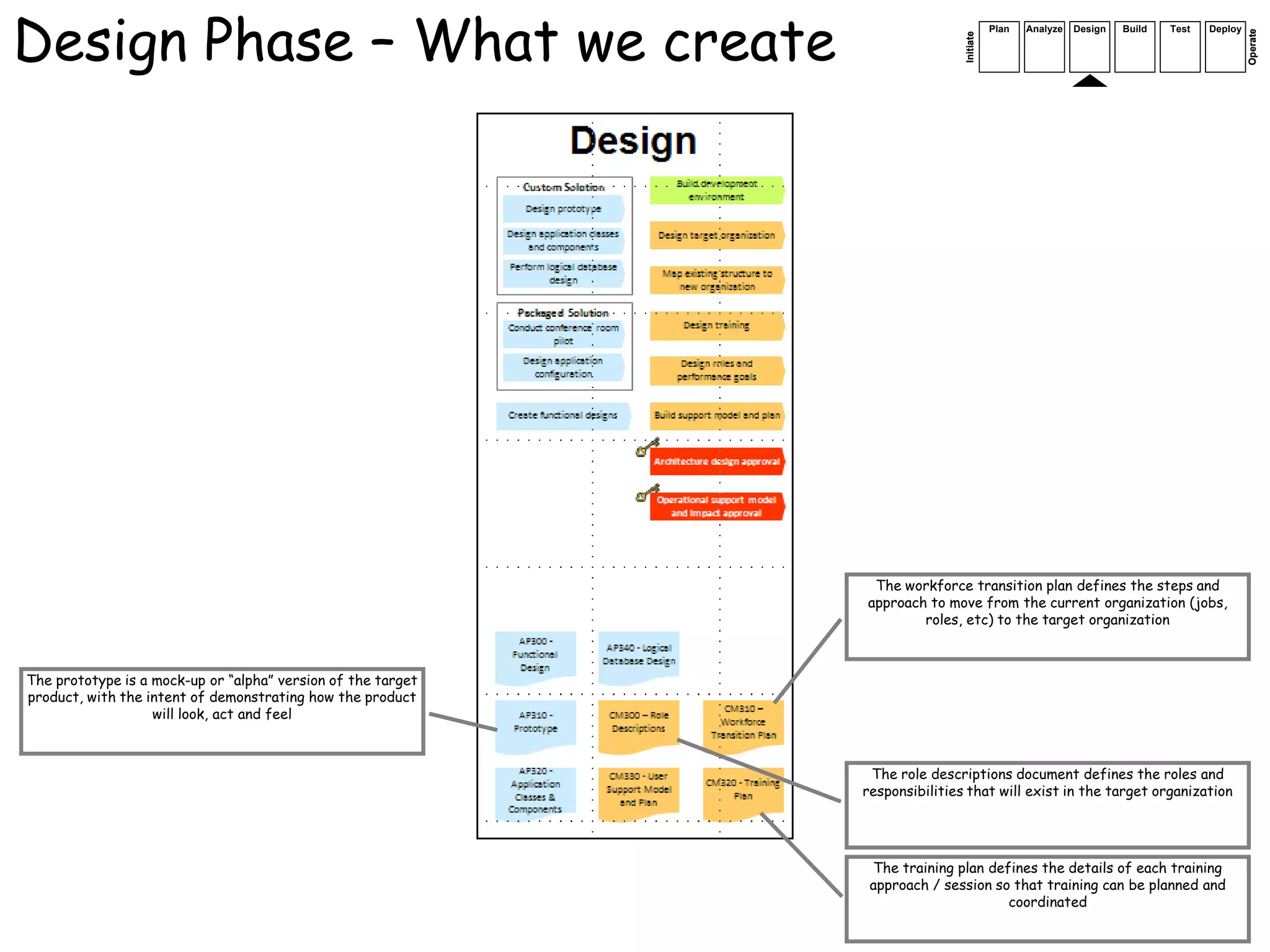

Design Phase – What we create                                                            Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                           Operate
                                                                              Initiate
                                                               The workforce transition plan defines the steps and
                                                              approach to move from the current organization (jobs,
                                                                      roles, etc) to the target organization

The prototype is a mock-up or “alpha” version of the target
product, with the intent of demonstrating how the product
                   will look, act and feel

                                                               The role descriptions document defines the roles and
                                                              responsibilities that will exist in the target organization

                                                               The training plan defines the details of each training
                                                               approach / session so that training can be planned and
                                                                                    coordinated
                                                                                                                           33

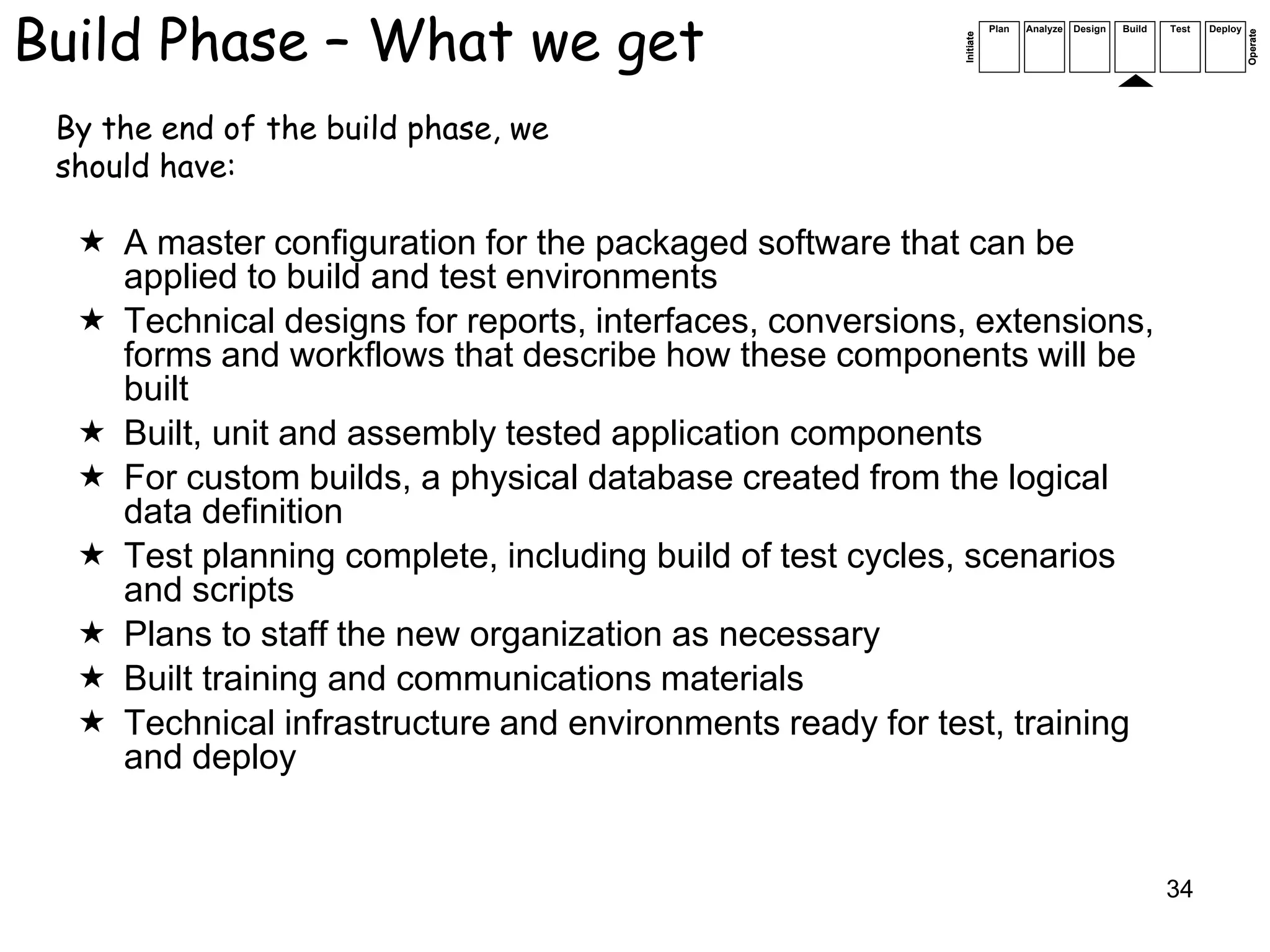

Build Phase – What we get                                            Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                       Operate
                                                          Initiate
 By the end of the build phase, we
 should have:

   A master configuration for the packaged software that can be
    applied to build and test environments
   Technical designs for reports, interfaces, conversions, extensions,
    forms and workflows that describe how these components will be
    built
   Built, unit and assembly tested application components
   For custom builds, a physical database created from the logical
    data definition
   Test planning complete, including build of test cycles, scenarios
    and scripts
   Plans to staff the new organization as necessary
   Built training and communications materials
   Technical infrastructure and environments ready for test, training
    and deploy

                                                                                                       34

Build Phase – What we do                                                                                           Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                                                     Operate
                                                                                                        Initiate
Create the detailed technical designs that describe how the
                target solution will be built
                                                              Create physical database

 Define the test cycles, scenarios and scripts that trace
                                                                                         Build the materials that will be used to support end user
back to each requirement to ensure that each requirement
                                                                                                                  training
                         is tested

Build the remaining environments that are needed for test
                 training and deployment                                                    Confirm that the build objects meet organizational
                                                                                         standards, and have been appropriately unit and assembly
                                                                                                                  tested

                                                                                                                                                     35

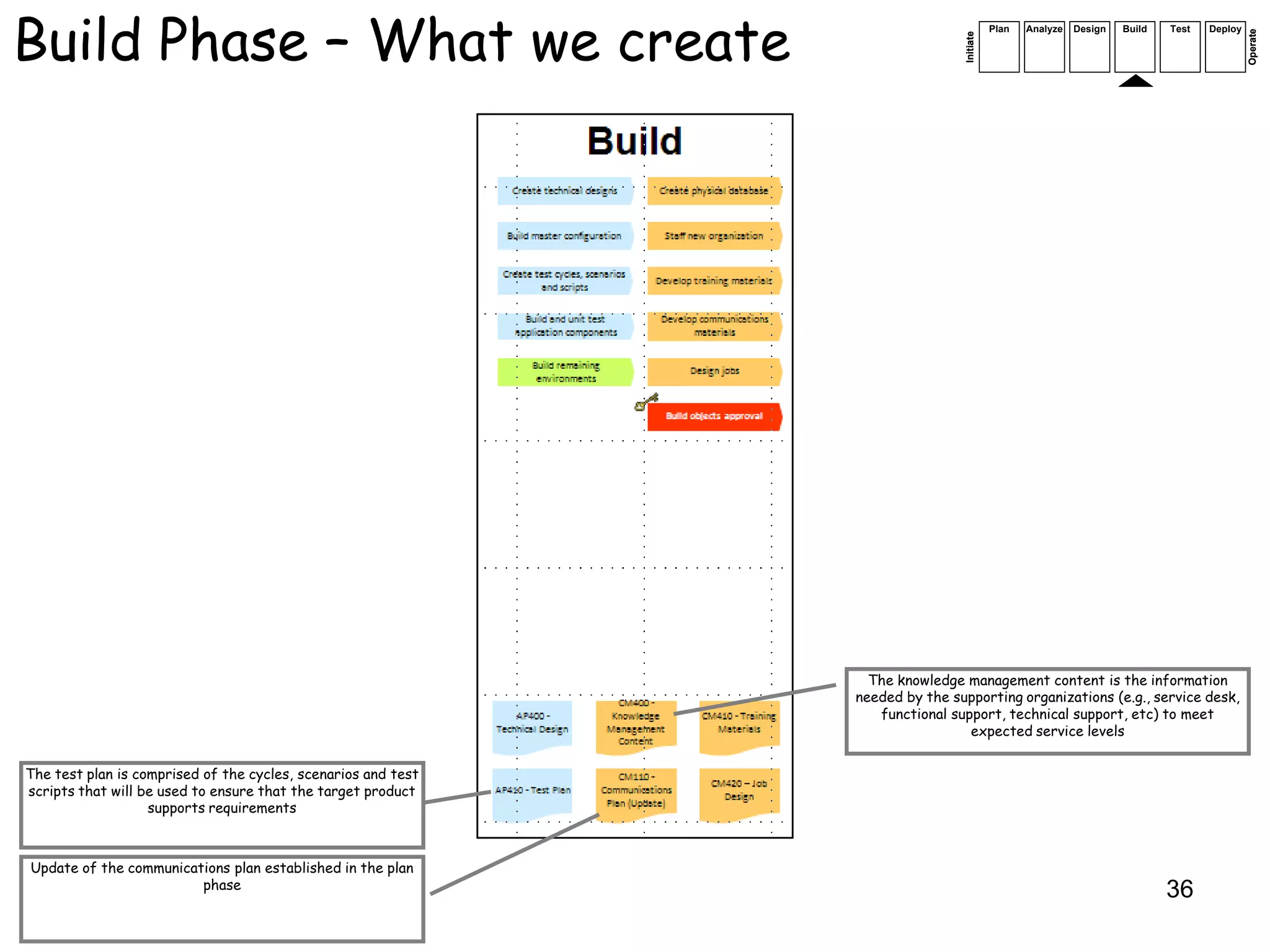

Build Phase – What we create                                                              Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                            Operate
                                                                               Initiate
                                                                 The knowledge management content is the information
                                                               needed by the supporting organizations (e.g., service desk,
                                                                  functional support, technical support, etc) to meet
                                                                                expected service levels

The test plan is comprised of the cycles, scenarios and test
scripts that will be used to ensure that the target product
                   supports requirements

Update of the communications plan established in the plan
                        phase
                                                                                                                            36

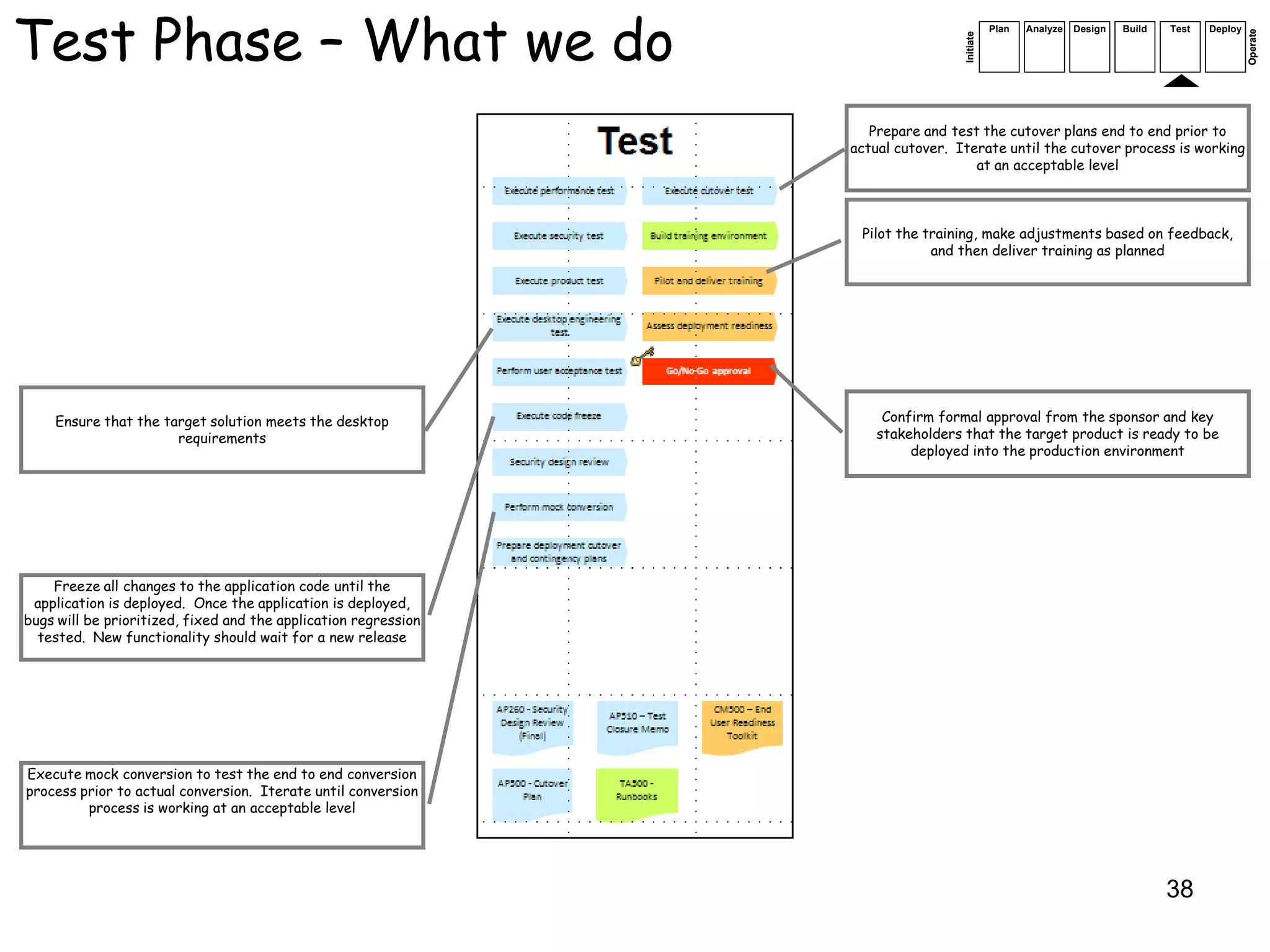

Test Phase – What we get                                           Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                     Operate
                                                        Initiate
 By the end of the test phase, we
 should have:

   A validated target product that meets performance, security,
    functional, desktop, and end user expectations
   An agreed to freeze on changes to application code
   Approved security design
   A conversion process that has been tested
   Completed runbooks
   Agreed to contingency plans
   Tested cutover plans
   Piloted training
   End users and stakeholders that are aware of the forthcoming
    changes, and prepared to accept them

                                                                                                     37
Test Phase – What we do                                                                      Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                               Operate
                                                                                  Initiate
                                                                    Prepare and test the cutover plans end to end prior to
                                                                 actual cutover. Iterate until the cutover process is working
                                                                                    at an acceptable level

                                                                  Pilot the training, make adjustments based on feedback,
                                                                             and then deliver training as planned

    Ensure that the target solution meets the desktop                Confirm formal approval from the sponsor and key
                      requirements                                  stakeholders that the target product is ready to be
                                                                         deployed into the production environment

    Freeze all changes to the application code until the
 application is deployed. Once the application is deployed,
bugs will be prioritized, fixed and the application regression
  tested. New functionality should wait for a new release

Execute mock conversion to test the end to end conversion
process prior to actual conversion. Iterate until conversion
         process is working at an acceptable level

                                                                                                                               38
Test Phase – What we create                                                            Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                         Operate
                                                                            Initiate
        Final version of security design review

 The cutover plan documents the steps, sequencing and        The runbooks are a handbook that describe the overall
timing of the activities needed to migrate from the test    technical architecture and operational considerations for
       environment to the production environment           an application, and are used by the technical support teams
                                                                                                                         39
Deploy Phase – What we get                                  Plan   Analyze   Design   Build   Test   Deploy

                                                                                                              Operate
                                                 Initiate
 At the end of the deploy phase, we
 should know:

   Data converted into production environments
   Application code migrated to production environments
   End users trained and communicated to
   Target state (organization, processes and application)
    rolled out as specified by requirements and delivery
    approach
   Critical and high priority post deployment issues resolved
    during warranty period
   Responsibility for operating and maintaining the target
    state is transferred to the operating teams
   Completed project closure report

                                                                                              40
Deploy Phase – What we do                                                Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                           Operate
                                                              Initiate
Move all involved application and technical components into
                the production environment

Execute user support model by providing launch support for
the end users and when appropriate move to the operational
user support model

Deliver the training and communications necessary to make
stakeholders aware of the target product, and enabled to
 operate successfully in the target environment, with the
                        target tools

     Identify, prioritize and resolve issues during the
    deployment period until the target environment has
          reached a pre-defined level of stability

Formally transfer operating and maintenance responsibility
  to the operating teams, disband the project team, stop
                      project funding

                                                                                                           41
Deploy Phase – What we create                                                          Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                                         Operate
                                                                            Initiate
                                                             The user feedback report documents the results of user
                                                               interviews, focus groups, usability tests, and other
                                                                 interactions with users throughout the project

 The project closure report provides an overall wrap-up of   The training evaluation summary records feedback from
the project. It documents key learnings, known open items,    end users on training, to help the team identify where
          overall project execution statistics, etc              training works, and where it would benefit from
                                                                                   improvement

                                                                                                                         42
Agile Techniques

                                                                                                                                                                                     Operate
                                                                                                                                     Plan   Analyze Design   Build   Test   Deploy

                                                                                                                          Initiate
                            Design                                                          Build
                                                      Agile Techniques – For each Sprint:
                                 Design UI, process                                          Review build
                                                        Review design                                        Customer
                 Confirm scope    flow, workflow,                          Do incremental   with customer
                                   output or data
                                                      with customer and                                     approval of
                   of sprint                            make changes            build         and make
                                       usage                                                                  sprint
                                                                                               changes

     Within the context of the waterfall approach, some functions may
      benefit from a more iterative design & build approach
     Common examples include application forms, configuration and
      reports, but can apply to any functions that can be mostly built and
      validated on a stand-alone basis
     These techniques are not a replacement for full Agile development.
      Agile is a different type of SDLC that is not covered in this training
     Beware that iterative development has it‟s own pitfalls, including
      potential for rework and cost and schedule over-runs

                                                                                                                                                                     43
Operate Phase
                                                                         Plan   Analyze   Design   Build   Test   Deploy

                                                                                                                           Operate
                                                              Initiate
Entry into the operate phase represents official closure of
the project

  Project funding ends

  Project team and governance disbands in favor or
   operating team and governance

  Project resources go onto other projects or activities

  The operational teams take ownership of the application
   and supporting processes

                                                                                                           44
SDLC Summary

    Waterfall approach, but iterate and overlap when reasonable and
     helpful

    Not just for software – considers business processes,
     organization and communication

    Toolbox approach, tailor, tailor, tailor

         Are there any questions on the SDLC?

                                                                       45

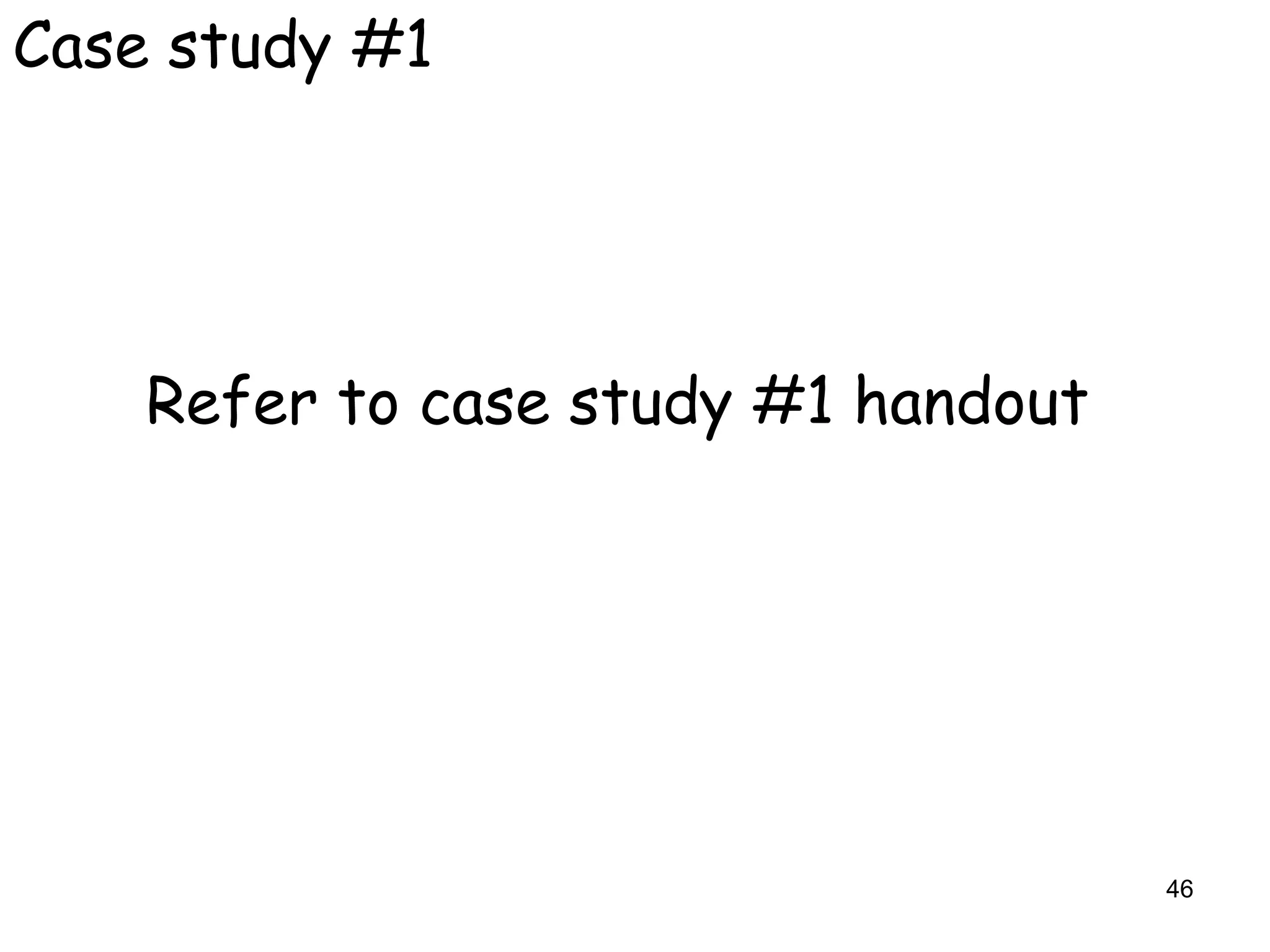

Case study #1

    Refer to case study #1 handout

                                     46
Next, let‟s look at project governance . . .

 Our approach encompasses three areas:

 Solution and business integration lifecycle (our SDLC)

 Project governance

 Project management processes

                                                           47
What is governance?
There are probably few terms that are used as freely,
but understood as poorly, as the term “governance”. We
                                                             LET „EM HANG
                                                                                 Judge Isaac Parker
                                                                            aka “The Hanging Judge”
will continue the trend by using it freely. However, we
will try to make some sense of what it is and why it is
important - mostly so that you can impress your friends
and neighbors, but also so that you can understand how
you can use it to help your projects to be more successful

 One definition of governance: “Specifying the
  decision rights and accountability framework to
  encourage desirable behavior in the use of IT”

 We can simplify it further: “Defining who is                       He has decision authority

  responsible for what and who can make which
                                                                            The unfortunate accused
  decisions”

                                                                                           48
                                                                        They are accountable
Levels of governance
Our approach considers governance at the project
level, and cross-project (or portfolio) level

               Portfolio                          Decisions that cross
                                                   projects, such as
                                                   funding, resources and
                                                   dependencies

                                                  Decisions that are local
 Project 1   Project 2   Project 3   Project n     to a project, such as
                                                   scope, design approach
                                                   and deliverable quality

                                                                        49
Project Roles                                                                                                     ACTION!

How are projects like movies? No, not the long hours and poor
reviews from the critics. Both rely on standard roles to help them
run smoothly. On any movie set everyone knows what the key grip
and gaffer are responsible for. Successful projects operate in the
same way, with standard roles and clear understanding of
responsibilities and decision making authority.

                                              Sponsor - Proposes and champions the project. Responsible for
                                               the project‟s success

                                              Relationship Manager - Responsible for translating business
                                               vision into solution, staffing, and delivering solution

                                              Project Lead – Responsible for delivery of project scope, on
                                               time and within budget

                                              Functional Lead – Responsible for delivery of the functional
                                               solution

                                              Technical Lead – Responsible for delivery of the technical
                                               solution

                                              Change Management Lead – Responsible for organizational and
                                               user adoption of the solution

                                                             Like Eddie Murphy in The Nutty Professor, an
                                                                                                                  50
                                                           individual can play more than one role on a project!

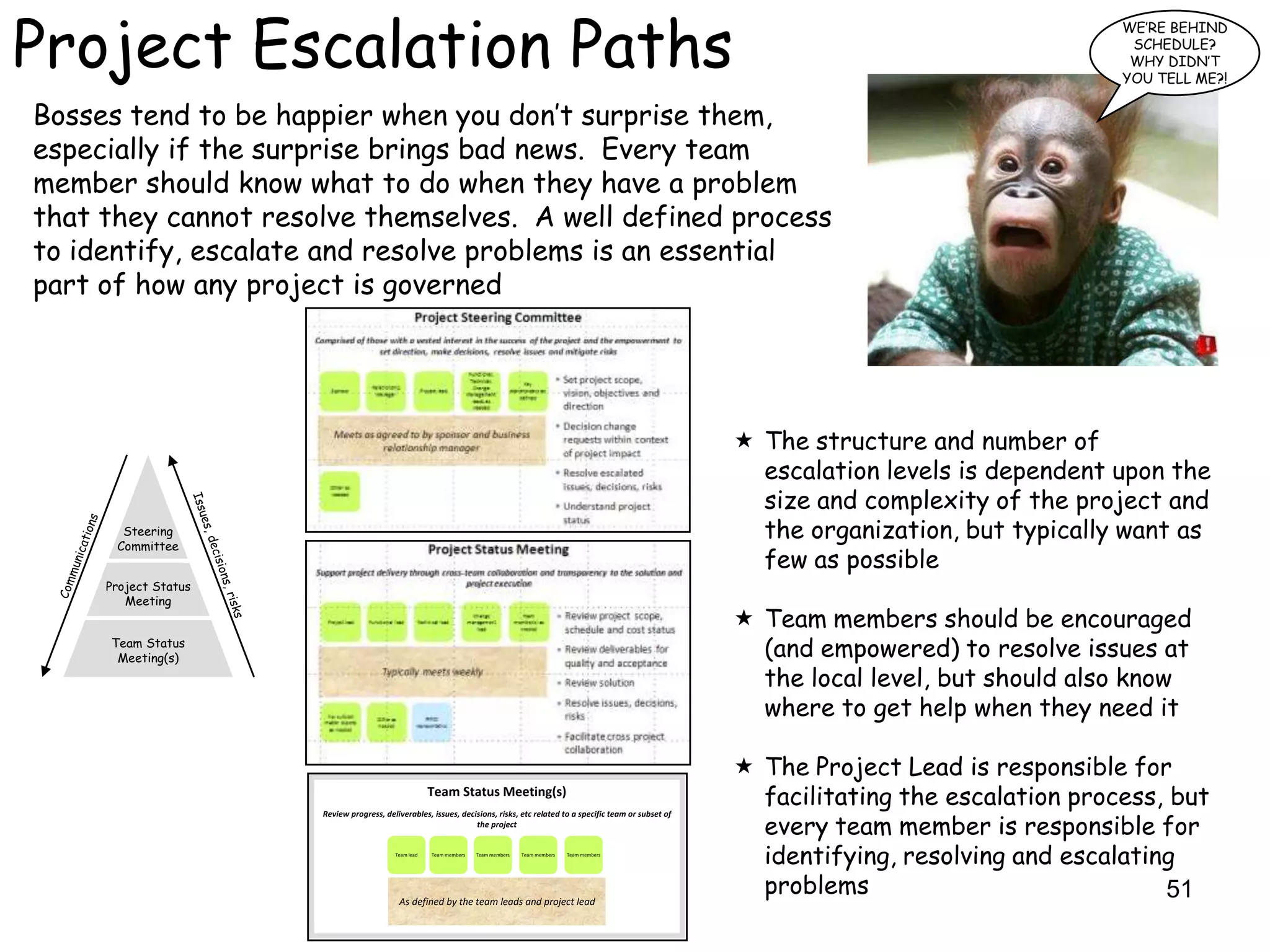

Project Escalation Paths
                                                                                                                                                               WE‟RE BEHIND
                                                                                                                                                                SCHEDULE?
                                                                                                                                                                WHY DIDN‟T
                                                                                                                                                               YOU TELL ME?!

Bosses tend to be happier when you don‟t surprise them,
especially if the surprise brings bad news. Every team
member should know what to do when they have a problem
that they cannot resolve themselves. A well defined process
to identify, escalate and resolve problems is an essential
part of how any project is governed

                                                                                                                              The structure and number of
                                                                                                                               escalation levels is dependent upon the
                                                                                                                               size and complexity of the project and
       Steering                                                                                                                the organization, but typically want as
      Committee
                                                                                                                               few as possible
     Project Status
        Meeting
                                                                                                                              Team members should be encouraged
     Team Status
      Meeting(s)                                                                                                               (and empowered) to resolve issues at
                                                                                                                               the local level, but should also know
                                                                                                                               where to get help when they need it

                                                                                                                              The Project Lead is responsible for
                                                      Team Status Meeting(s)
                                                                                                                               facilitating the escalation process, but
                                                                                                                               every team member is responsible for
                      Review progress, deliverables, issues, decisions, risks, etc related to a specific team or subset of
                                                                 the project

                                          Team lead   Team members   Team members   Team members   Team members
                                                                                                                               identifying, resolving and escalating
                                           As defined by the team leads and project lead
                                                                                                                               problems                            51

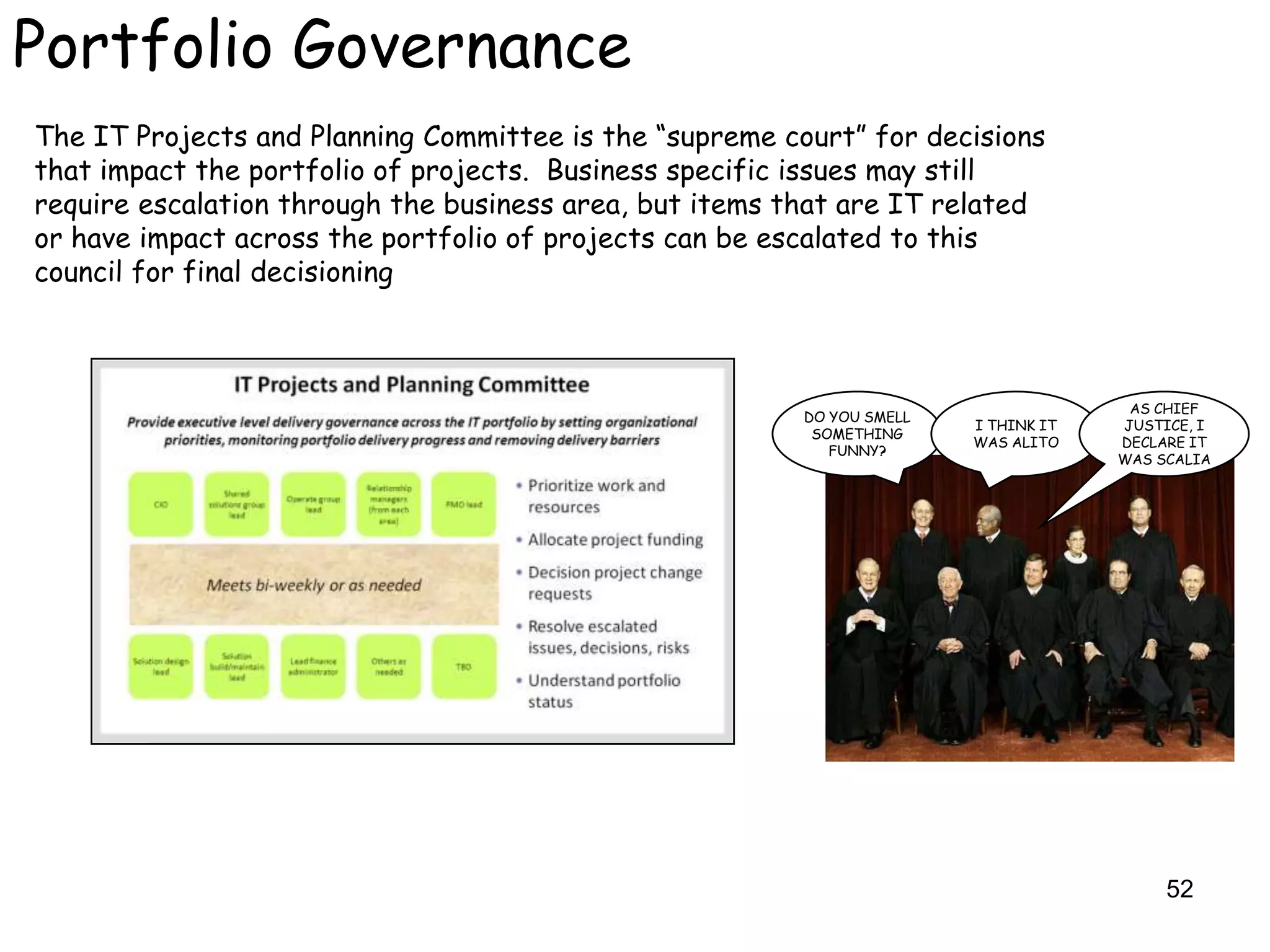

Portfolio Governance
The IT Projects and Planning Committee is the “supreme court” for decisions
that impact the portfolio of projects. Business specific issues may still
require escalation through the business area, but items that are IT related
or have impact across the portfolio of projects can be escalated to this
council for final decisioning

                                                                                      AS CHIEF
                                                         DO YOU SMELL
                                                                        I THINK IT   JUSTICE, I
                                                          SOMETHING
                                                                        WAS ALITO    DECLARE IT
                                                            FUNNY?
                                                                                     WAS SCALIA

                                                                                          52

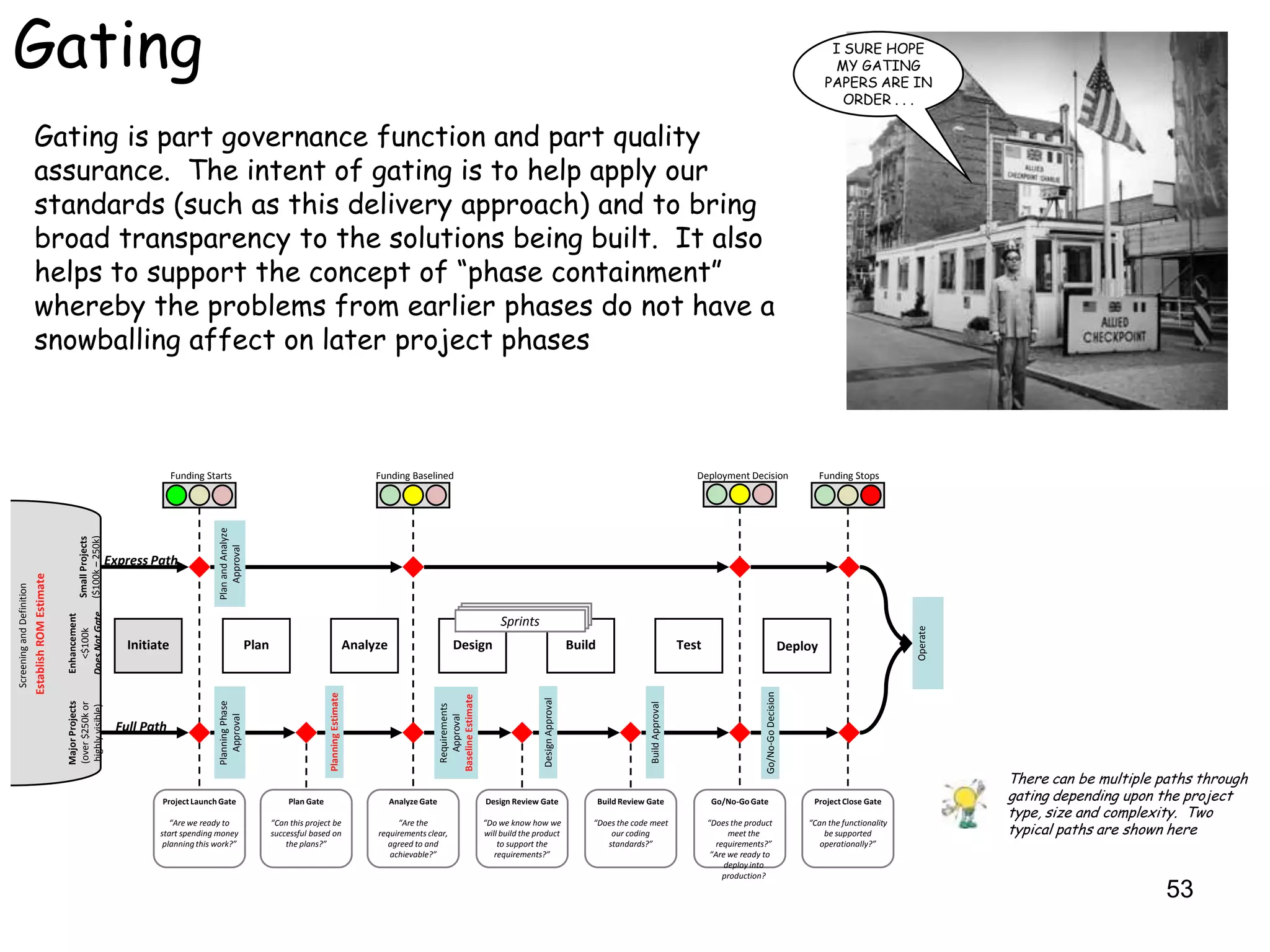

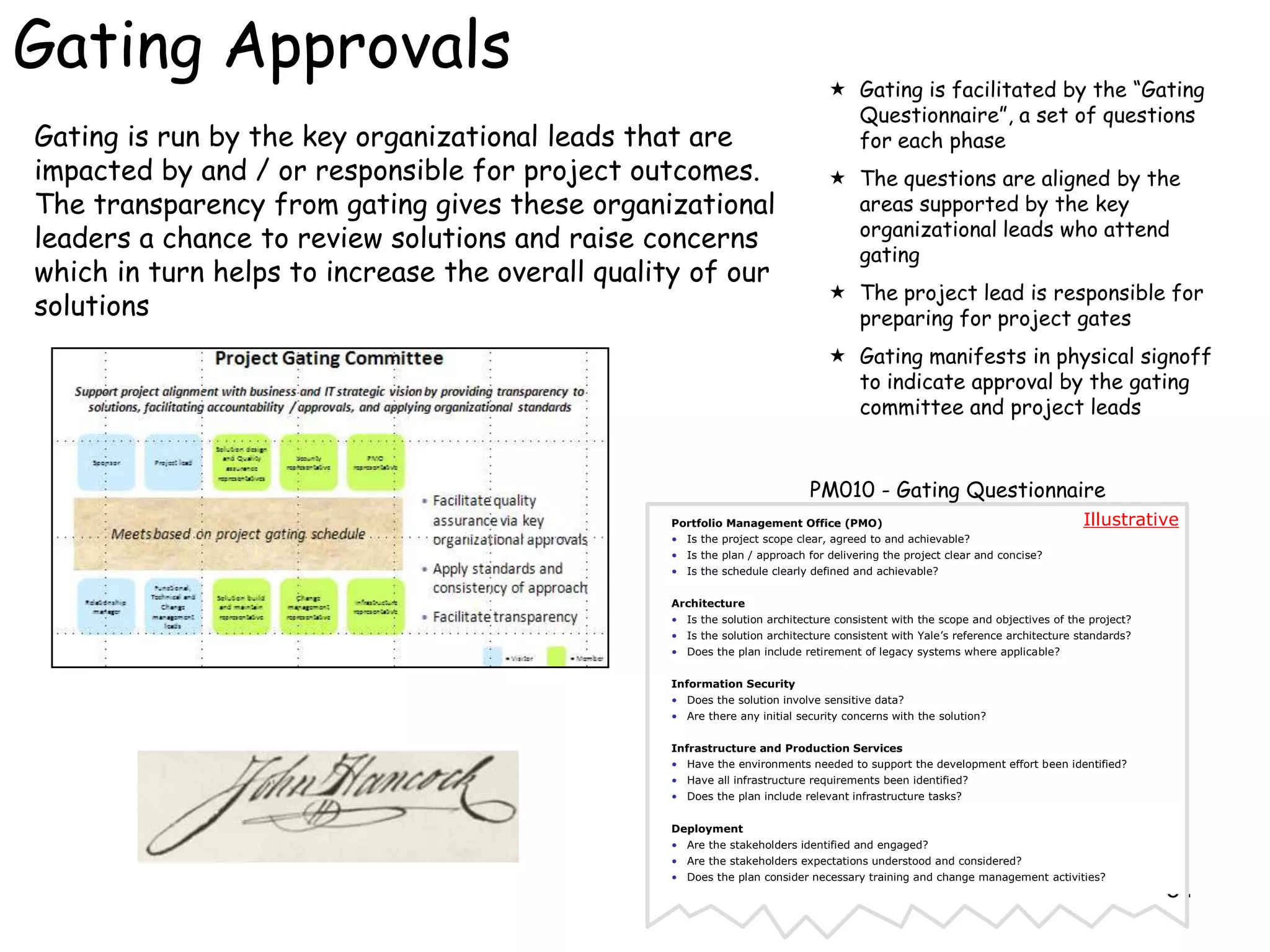

Gating                                                                                                                                                                                                                                                                                                                                      I SURE HOPE
                                                                                                                                                                                                                                                                                                                                            MY GATING
                                                                                                                                                                                                                                                                                                                                           PAPERS ARE IN
                                                                                                                                                                                                                                                                                                                                              ORDER . . .

                           Gating is part governance function and part quality
                           assurance. The intent of gating is to help apply our
                           standards (such as this delivery approach) and to bring
                           broad transparency to the solutions being built. It also
                           helps to support the concept of “phase containment”
                           whereby the problems from earlier phases do not have a
                           snowballing affect on later project phases

                                                                                       Funding Starts                                                                 Funding Baselined                                                                                                   Deployment Decision                             Funding Stops
                                                                                                  Plan and Analyze
                                                        ($100k – 250k)
                                                        Small Projects

                                                                                                      Approval

                                                                         Express Path
                           Establish ROM Estimate
Screening and Definition

                                                    Does Not Gate
                                                    Enhancement

                                                                                                                                                                                                                  Sprints

                                                                                                                                                                                                                                                                                                                                                              Operate
                                                       <$100k

                                                                            Initiate                                 Plan                                        Analyze                        Design                                           Build                                 Test                                      Deploy

                                                                                                                                                                                                                                                                                                             Go/No-Go Decision
                                                                                                                                             Planning Estimate

                                                                                                                                                                                          Baseline Estimate

                                                                                                                                                                                                                               Design Approval
                                                                                                  Planning Phase
                                                    Major Projects

                                                                                                                                                                                                                                                                      Build Approval
                                                    (over $250k or

                                                                                                                                                                                           Requirements
                                                     highly visible)

                                                                                                     Approval

                                                                                                                                                                                              Approval

                                                                          Full Path

                                                                                                                                                                                                                                                                                                                                                                        There can be multiple paths through
                                                                                  Project Launch Gate                            Plan Gate                                 Analyze Gate                       Design Review Gate                         Build Review Gate                     Go/No-Go Gate                          Project Close Gate                gating depending upon the project
                                                                                                                                                                                                                                                                                                                                                                        type, size and complexity. Two
                                                                                                                                                                                                                                                                                                                                                                        typical paths are shown here
                                                                                     “Are we ready to                       “Can this project be                           “Are the                           “Do we know how we                     “Does the code meet                      “Does the product                      “Can the functionality
                                                                                  start spending money                      successful based on                       requirements clear,                     will build the product                     our coding                                 meet the                             be supported
                                                                                   planning this work?”                         the plans?”                             agreed to and                             to support the                        standards?”                              requirements?”                         operationally?”
                                                                                                                                                                         achievable?”                            requirements?”                                                                “Are we ready to
                                                                                                                                                                                                                                                                                                   deploy into
                                                                                                                                                                                                                                                                                                   production?

                                                                                                                                                                                                                                                                                                                                                                                               53
Gating Approvals                                                               Gating is facilitated by the “Gating
                                                                                Questionnaire”, a set of questions
Gating is run by the key organizational leads that are                          for each phase
impacted by and / or responsible for project outcomes.                         The questions are aligned by the
The transparency from gating gives these organizational                         areas supported by the key
                                                                                organizational leads who attend
leaders a chance to review solutions and raise concerns
                                                                                gating
which in turn helps to increase the overall quality of our
                                                                               The project lead is responsible for
solutions                                                                       preparing for project gates
                                                                               Gating manifests in physical signoff
                                                                                to indicate approval by the gating
                                                                                committee and project leads

                                                                           PM010 - Gating Questionnaire
                                                 Portfolio Management Office (PMO)                                            Illustrative
                                                 • Is the project scope clear, agreed to and achievable?
                                                 • Is the plan / approach for delivering the project clear and concise?
                                                 • Is the schedule clearly defined and achievable?

                                                 Architecture
                                                 • Is the solution architecture consistent with the scope and objectives of the project?
                                                 • Is the solution architecture consistent with Yale’s reference architecture standards?
                                                 • Does the plan include retirement of legacy systems where applicable?

                                                 Information Security
                                                 • Does the solution involve sensitive data?
                                                 • Are there any initial security concerns with the solution?

                                                 Infrastructure and Production Services
                                                 • Have the environments needed to support the development effort been identified?
                                                 • Have all infrastructure requirements been identified?
                                                 • Does the plan include relevant infrastructure tasks?

                                                 Deployment
                                                 • Are the stakeholders identified and engaged?
                                                 • Are the stakeholders expectations understood and considered?
                                                 • Does the plan consider necessary training and change management activities?
                                                                                                                                           54
Governance Summary

    Project vs. portfolio governance

    Know who is responsible for what (team, roles, etc) and who can
     make what decisions

    Know how to escalate issues and to get senior level support for
     the project

    Gating

        Are there any questions on Governance?

                                                                       55
Let‟s look at project management
processes. . .
 Our approach encompasses three areas:

 Solution and business integration lifecycle (our SDLC)

 Project governance

 Project management processes

                                                           56
Think good project management skills
were important for this?
   I BELIEVE THAT THIS NATION
    SHOULD COMMIT ITSELF TO
   ACHIEVING THE GOAL, BEFORE
 THIS DECADE IS OUT, OF LANDING
     A MAN ON THE MOON AND
 RETURNING HIM SAFELY TO EARTH

                                  On May 25, 1961, President John F. Kennedy
                                   announced before a special joint session of
                                  Congress the dramatic and ambitious goal of
                                    sending an American to the Moon before
                                             the end of the decade
                                                                                                              ONE SMALL STEP
                                                                                                              FOR (A) MAN, ONE
                                                                                                               GIANT LEAP FOR
                                                                                                                  PROJECT
                                                                                                                MANAGEMENT

                                           On July 20, 1969, barely 8 years later,
                                           Neil Armstrong became the first man to
                                          set foot on the moon. Buzz Aldrin quickly
                                           followed, while Mike “Hard Luck” Collins
                                          waited patiently in the Command Module in
                                                         moon‟s orbit

                                       This is actually a picture of Buzz Aldrin, not Neil Armstrong, whose                      57
                                       famous quote we‟ve destroyed for our own selfish purpose. Do you
                                       know why there is not a clearer picture of Armstrong‟s first step?
PMBOK, or yet another silly acronym

                                                                     We‟ve already talked about the balancing act that is project
                                                                     management. The good news is that some very smart people
                                                                     (no, not us) have thought a lot about this and have documented
                                                                     (in ridiculous detail) just about everything you need to know
                                                                     about managing projects. This wealth of information is lovingly
                                                                     called the Project Management Body of Knowledge, or PMBOK
                                                                     for short.

                                                                     We will not attempt to reproduce PMBOK or try to make you all
                                                                     PMP certified. But we will attempt to draw your attention to
                                                                     some of the key concepts around PMBOK and how our delivery
                                                                     approach supports them.

                                                                     Even if you are not responsible for project or team
                                                                     management, the tools and techniques within can almost
                                                                     certainly help.

                                                                                           The Project Management Institute published the first Guide to Project Management
                                                                                           Body of Knowledge (PMBOK) as a white paper in 1987 in an attempt to document and
                                                                                           standardize generally accepted project management information and practice

PMBOK is an internationally recognized standard that provides the fundamentals of project management as they apply to a wide range                                      58
of projects (not specific to one industry or type of project) and is published by the Project Management Institute (PMI). PMI offers
a PMP (Project Management Professional) certification based on PMBOK. For more information, visit http://www.pmi.org
Project management knowledge areas
PMBOK thinks of the world in terms of “project management
processes” and “project management knowledge areas”. For our
purposes, we will focus on the following:

  Change control
  Issue and decision
   management
  Scope management
  Schedule management
  Cost management
  Quality management
  Resource management
  Communications management
  Risk management
  Vendor management
                                                               59

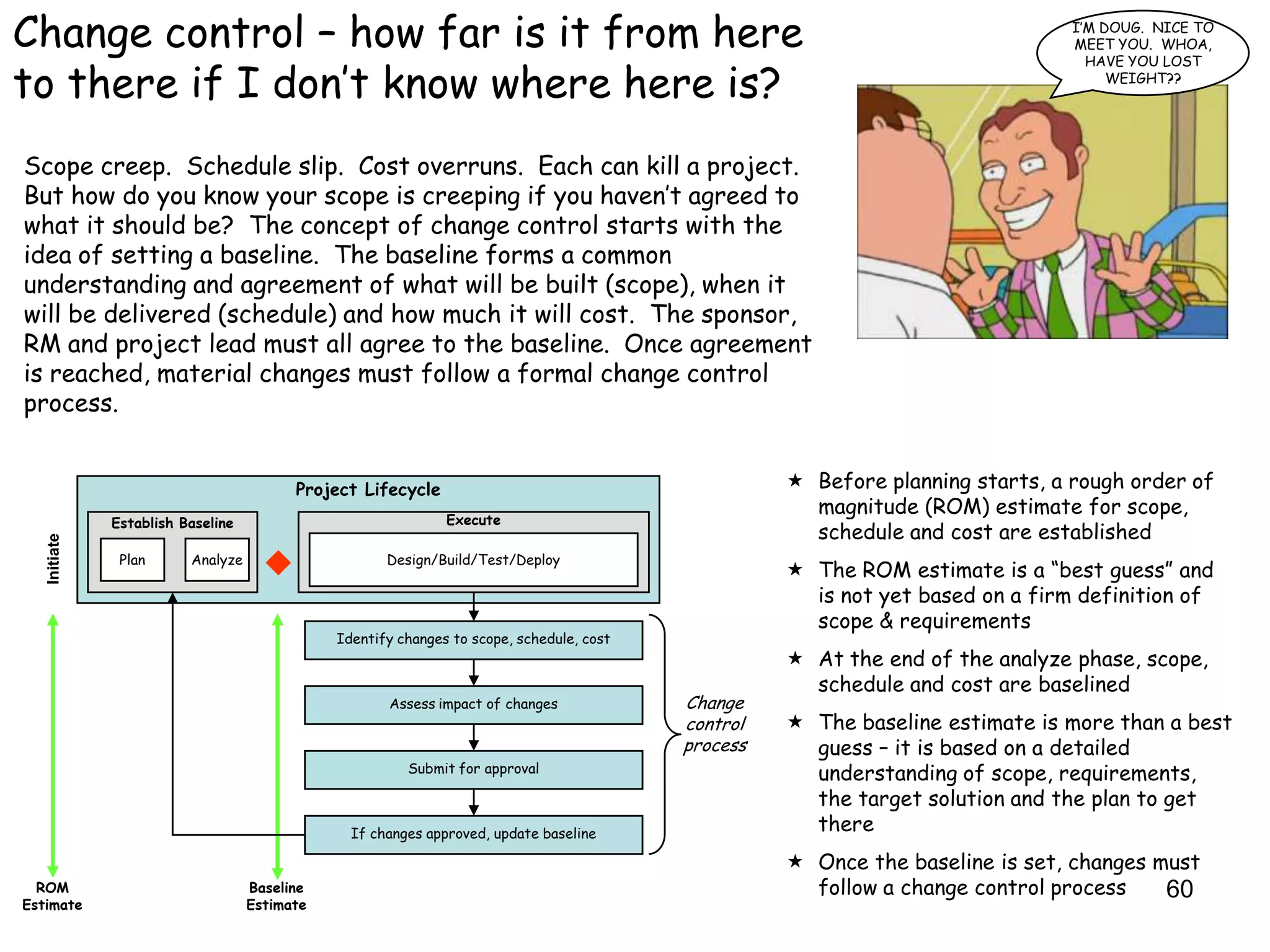

Change control – how far is it from here                                                                                        I‟M DOUG. NICE TO
                                                                                                                                MEET YOU. WHOA,
                                                                                                                                  HAVE YOU LOST

to there if I don‟t know where here is?                                                                                              WEIGHT??

Scope creep. Schedule slip. Cost overruns. Each can kill a project.
But how do you know your scope is creeping if you haven‟t agreed to
what it should be? The concept of change control starts with the
idea of setting a baseline. The baseline forms a common
understanding and agreement of what will be built (scope), when it
will be delivered (schedule) and how much it will cost. The sponsor,
RM and project lead must all agree to the baseline. Once agreement
is reached, material changes must follow a formal change control
process.

                                         Project Lifecycle                                           Before planning starts, a rough order of
                                                                                                      magnitude (ROM) estimate for scope,
              Establish Baseline                              Execute
                                                                                                      schedule and cost are established
   Initiate

               Plan      Analyze                     Design/Build/Test/Deploy
                                                                                                     The ROM estimate is a “best guess” and
                                                                                                      is not yet based on a firm definition of
                                                                                                      scope & requirements
                                              Identify changes to scope, schedule, cost
                                                                                                     At the end of the analyze phase, scope,
                                                                                                      schedule and cost are baselined
                                                     Assess impact of changes             Change
                                                                                          control    The baseline estimate is more than a best
                                                                                          process     guess – it is based on a detailed
                                                        Submit for approval                           understanding of scope, requirements,
                                                                                                      the target solution and the plan to get
                                                If changes approved, update baseline
                                                                                                      there
                                                                                                     Once the baseline is set, changes must
  ROM                              Baseline                                                           follow a change control process    60
Estimate                           Estimate
Issue and decision management, recognizing and removing
barriers
 Someone once said “difficult times make great leaders”, . . .
 or “difficult leaders make great times”, . . . or something like
 that. The point is, projects often face difficult times.
 Barriers to progress should be expected. The best projects
 know how to remove barriers or how to find creative ways
 around or through them.

  Actively identify and aggressively manage issues and decisions
  Establish and manage an issue / decision log
  Make sure all team members know how to escalate
  Communicate resolutions to those who need to know
  Document resolutions so that you will remember what was decided (or so that
   you don‟t need to keep resolving the same issues over and over again)
  Make it clear who is responsible for resolving each issue and decision, when a
   resolution is needed, and the impact of not resolving
  Involve steering committee early

                                                                                    61

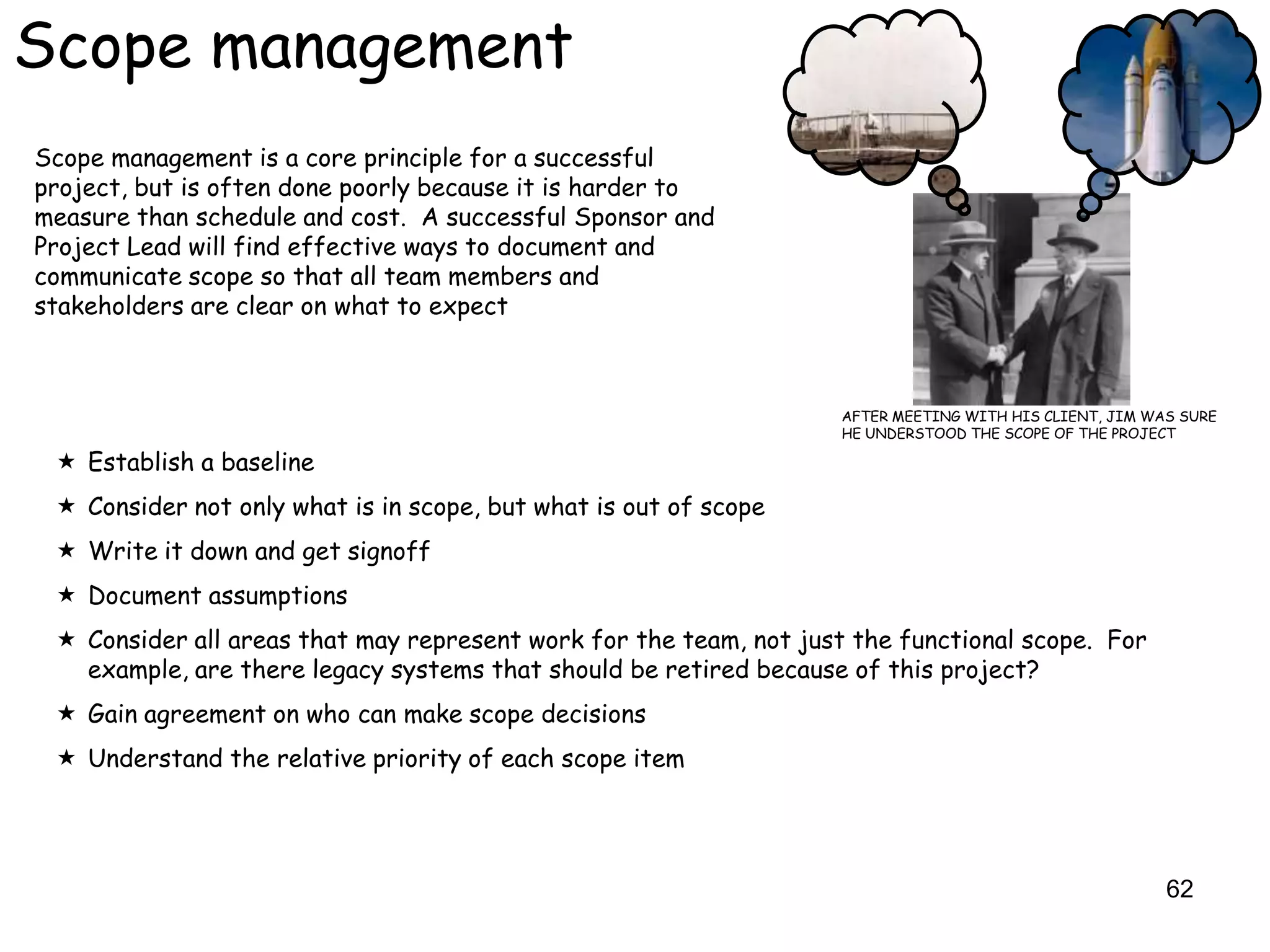

Scope management
Scope management is a core principle for a successful
project, but is often done poorly because it is harder to
measure than schedule and cost. A successful Sponsor and
Project Lead will find effective ways to document and
communicate scope so that all team members and
stakeholders are clear on what to expect

                                                                   AFTER MEETING WITH HIS CLIENT, JIM WAS SURE
                                                                   HE UNDERSTOOD THE SCOPE OF THE PROJECT

  Establish a baseline
  Consider not only what is in scope, but what is out of scope
  Write it down and get signoff
  Document assumptions
  Consider all areas that may represent work for the team, not just the functional scope. For
   example, are there legacy systems that should be retired because of this project?
  Gain agreement on who can make scope decisions
  Understand the relative priority of each scope item

                                                                                                        62
Schedule management

  Establish a baseline
  Start with the end in mind (define target state and get agreement from sponsor and
   stakeholders)
  Break large projects into phases
  Don‟t reinvent – look for packages or other working systems before starting to build from
   scratch
  Document assumptions
  Build schedule with involvement from the folks that will lead and do the work
  Understand dependencies (both within the project, and external to the project)
  Understand critical path
  Build in contingency plans
                                                                                               63
Cost management
Unless you are literally rolling in money (we‟re looking at you,
Scrooge McDuck) most projects operate within a budget.

  Establish a baseline

  Document assumptions

  Consider all costs – people, hardware, software, training, facilities, supplies, etc

  Understand who can make cost decisions

  Be clear as to whom is responsible for managing which costs

  Regularly review project financials, including planned vs. actual, estimate to complete and
   projected variance

                                                                                                 64
Quality management

                                           Which car is
                                          higher quality?

 It depends on what the requirements were. If the nice little electric car meets its planned requirements, but the
 ridiculously fast Bugatti Veyron does not meet the requirements for which it was intended (fuel efficiency,
 perhaps?) then the electric car is of higher quality.

 When it comes to projects, quality is not defined as “make it the best”. Quality is defined as meeting
 requirements. Simple as that. There is no extra credit for exceeding requirements. Sure, it would be nice if the
 shiny battery powered vehicle could top 250mph, but that is not what the Sponsor of this car has asked for, or
 agreed to pay for.

  Follow proven methodology (duh!)
  Active participation from sponsor and stakeholders
  Define in advance what success looks like
  Project gating and phase end reviews (which help to encourage phase containment to catch
   small problems before they become big)
  Be able to link requirements to testing

                                                                                                                65
Resource management
                                                                              I NEED      FRANKLY MY DEAR,
                                                                            RESOURCES     I HOPE YOU HAVE
                                                                              FOR MY        COMPLETED A
                                                                             PROJECT       RESOURCE PLAN

If you are on a project that only requires one resource, then
our approach probably doesn‟t apply to you. However, a
project of size or complexity will require involvement from
multiple people to play multiple roles. Identifying the roles
and the people to fill them, as well as establishing a “team
feel” is an important part for any successful project.

  Keep resource plans up to date

  Co-locate teams whenever possible

  Build and foster team spirit

  Cross train team members

  Stretch team members with challenging assignments and the opportunity to learn new things

  Consider the training required and train the team together whenever possible

  Consider all resources needed, including functional, subject matter expert (SME), testing, desktop
   technologists, including those who are part time.

  Gain agreement in advance from resource managers that the folks you need will be available when
   you need them to be available

  And be sure to plan for non-people resources, like development and test environments             66

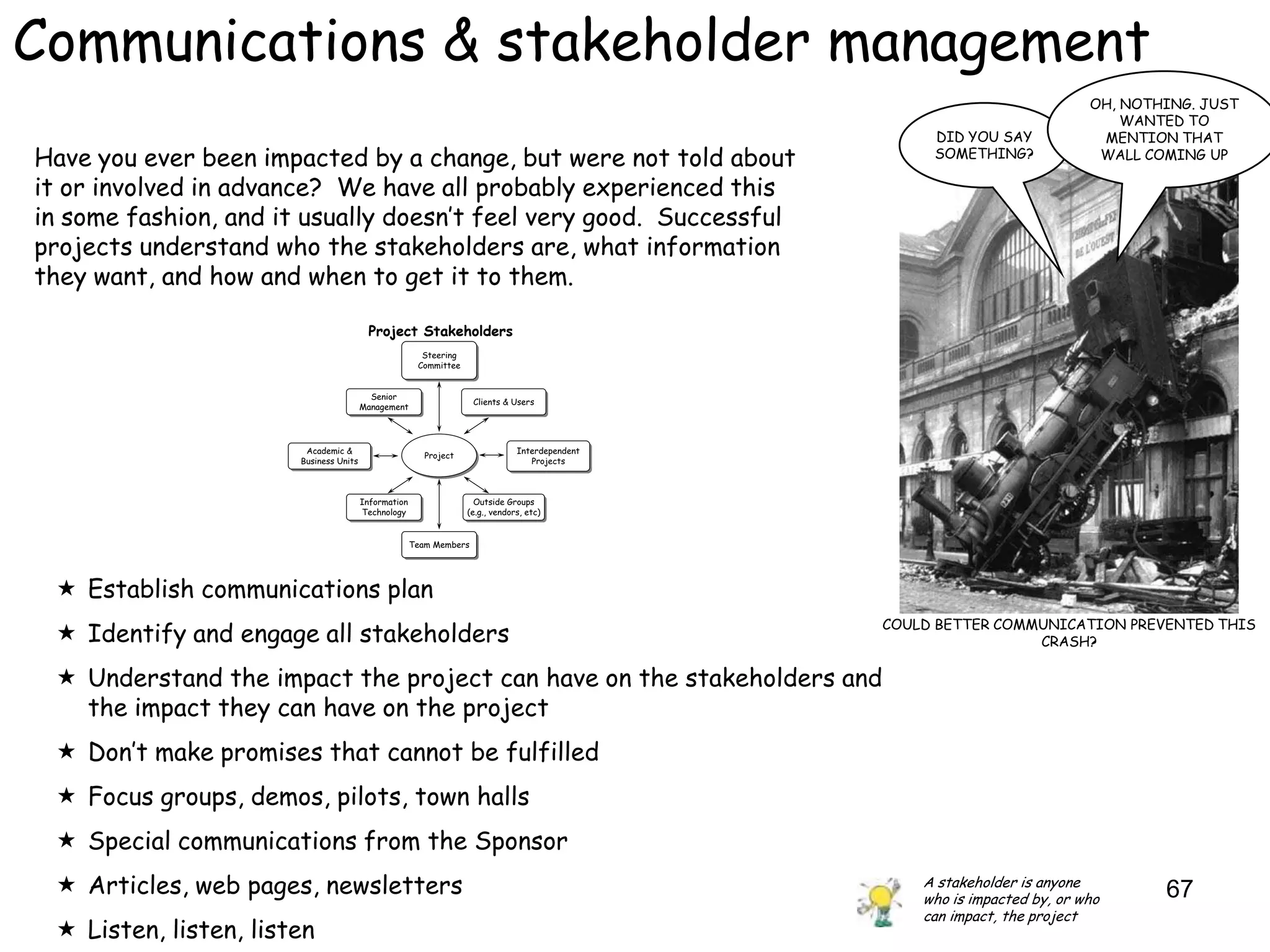

Communications & stakeholder management
                                                                                                                        OH, NOTHING. JUST
                                                                                                                            WANTED TO
                                                                                                 DID YOU SAY             MENTION THAT
Have you ever been impacted by a change, but were not told about                                 SOMETHING?              WALL COMING UP

it or involved in advance? We have all probably experienced this
in some fashion, and it usually doesn‟t feel very good. Successful
projects understand who the stakeholders are, what information
they want, and how and when to get it to them.

                                        Project Stakeholders
                                                   Steering
                                                   Steering
                                                  Committee
                                                  Committee

                                      Senior
                                      Senior                   Clients & Users
                                                               Clients & Users
                                    Management
                                    Management

                        Academic &
                         Academic &                                        Interdependent
                                                                           Interdependent
                                                   Project
                                                   Project
                       Business Units
                       Business Units                                         Projects
                                                                               Projects

                                    Information
                                    Information                 Outside Groups
                                                                 Outside Groups
                                    Technology
                                     Technology               (e.g., vendors, etc)
                                                               (e.g., vendors, etc)

                                              Team Members
                                              Team Members

  Establish communications plan
                                                                                            COULD BETTER COMMUNICATION PREVENTED THIS
  Identify and engage all stakeholders                                                                      CRASH?

  Understand the impact the project can have on the stakeholders and
   the impact they can have on the project
  Don‟t make promises that cannot be fulfilled
  Focus groups, demos, pilots, town halls
  Special communications from the Sponsor
  Articles, web pages, newsletters                                                             A stakeholder is anyone
                                                                                                who is impacted by, or who      67
                                                                                                can impact, the project
  Listen, listen, listen
But even with perfect communication . . .
Homer reacts to the news that Springfield is being split into
two area codes

                                                       DON‟T FORGET THE
                                 WHAT DO YOU MEAN?       LEAFLETS THEY
        WHAT REALLY BURNS ME
                                  THEY RAN THOSE TV    DROPPED FROM THE
        UP IS THEY DIDN‟T GIVE                                             NOT A SINGLE WORD OF
                                 COMMERCIALS ABOUT    SPACE SHUTTLE, AND
           US ONE WORD OF                                                      WARNING . . .
                                   IT, AND THAT BIG   THE TWO WEEKS WE
               WARNING
                                   RADIO CAMPAIGN      ALL SPENT AT AREA
                                                           CODE CAMP

. . . we cannot always guarantee the message
will be heard                               68

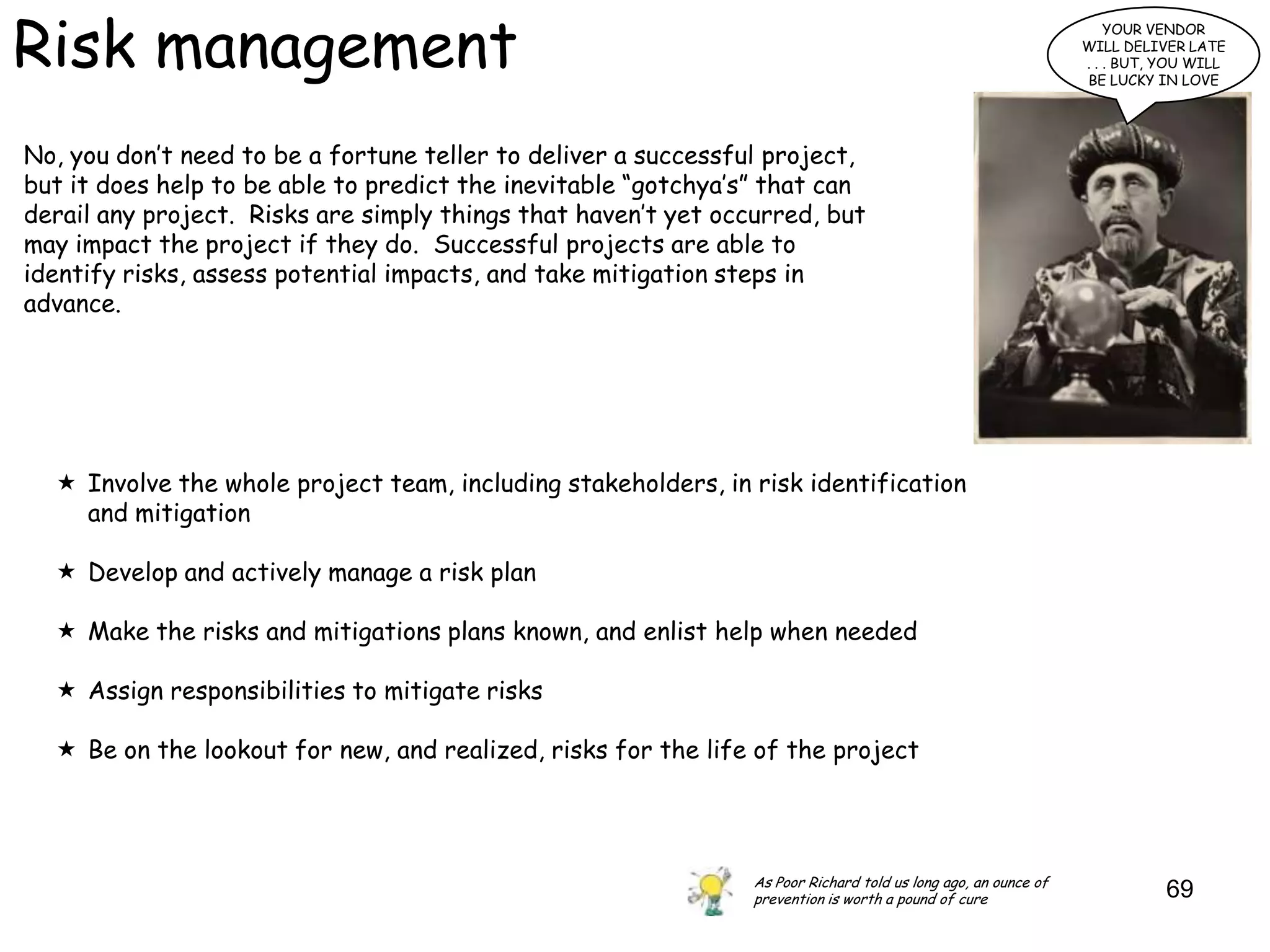

Risk management
                                                                                                                    YOUR VENDOR
                                                                                                                WILL DELIVER LATE
                                                                                                                . . . BUT, YOU WILL
                                                                                                                BE LUCKY IN LOVE

No, you don‟t need to be a fortune teller to deliver a successful project,
but it does help to be able to predict the inevitable “gotchya‟s” that can
derail any project. Risks are simply things that haven‟t yet occurred, but
may impact the project if they do. Successful projects are able to
identify risks, assess potential impacts, and take mitigation steps in
advance.

   Involve the whole project team, including stakeholders, in risk identification
    and mitigation

   Develop and actively manage a risk plan

   Make the risks and mitigations plans known, and enlist help when needed

   Assign responsibilities to mitigate risks

   Be on the lookout for new, and realized, risks for the life of the project

                                                                As Poor Richard told us long ago, an ounce of
                                                                prevention is worth a pound of cure                        69
Vendor management
Sometimes we work with a vendor because they sold us the product, other
times we need help or skills that we don‟t have available, and other times
we just want someone else to blame when things go wrong (oops, did we say
that one out loud?). Regardless of the reason for hiring a 3rd party to
assist, it is helpful to keep in mind some basic best practices.

   Plan early for knowledge transfer
   Form partnership – become one team with one goal and one plan
   Have vendor help to organize the team and plan
   Follow the same methodology
   Co-locate
   Understand and influence the contract
   Legal review of the contract
   Tie payments to acceptance when possible
   Look at fixed fee, but understand what it means to manage fixed fee work
   Have single point of contact
   Caveat emptor!                                                             70

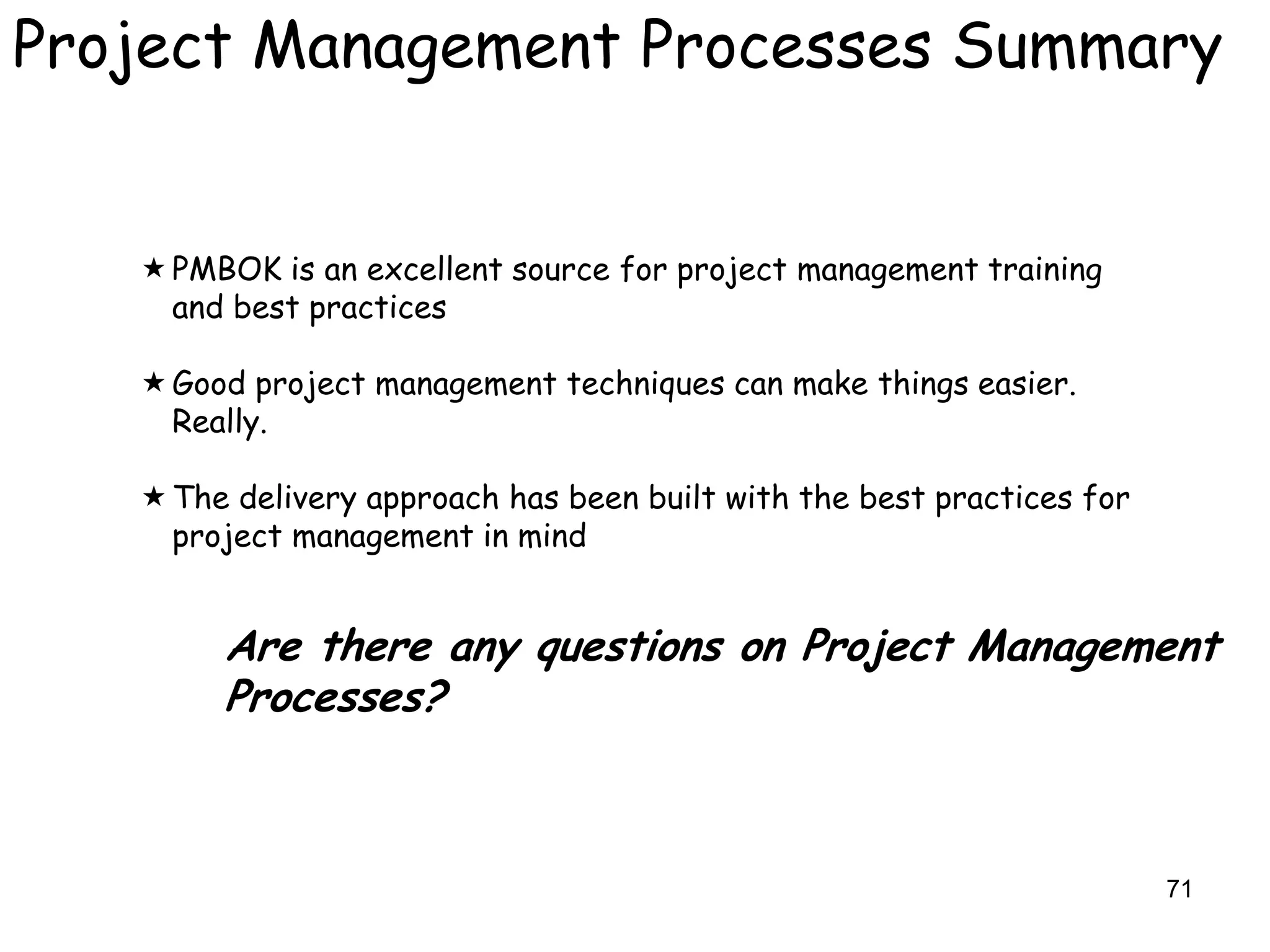

Project Management Processes Summary

    PMBOK is an excellent source for project management training
     and best practices

    Good project management techniques can make things easier.
     Really.

    The delivery approach has been built with the best practices for
     project management in mind

        Are there any questions on Project Management
        Processes?

                                                                        71
Case study #2

    Refer to case study #2 handout

                                     72
Odds and Ends

 PMO SharePoint

 Project SharePoint

 Status reporting

 Change controls

 Gating tracker

                       73

PMO SharePoint
The PMO sharepoint is your one-stop-shop for information regarding the
delivery approach and management of the overall portfolio of projects
being delivered. It is located at https://projects.yale.edu

                                                         Templates and sample deliverables
                                                         Gating calendar
                                                         Location for placing project status
                                                          reports
                                                         Delivery approach placemat
                                                         Helpful project management links
                                                         Links to portfolio project SharePoint
                                                          sites
                                                         Link to portfolio archive site
                                                         And more!

                                                                                           74
Project SharePoint Sites
Each project has it‟s own SharePoint site. The site is created by the PMO
and can then be administered and tailored by the project. At the close of
the project, the projects deliverables are posted to the project team
archive site, and the project site is shut down.

                                                         Each site starts with:
                                                          Location for project documents
                                                          Change log
                                                          Decision log
                                                          Issue log
                                                          Risk log
                                                          Task log
                                                          Team discussion
                                                          Place to record project lead roles
                                                          Links to deliverable templates the
                                                           project will use
                                                          Other useful links
                                                                                            75

Status Reporting and Project Reviews
Projects create a status report each week that helps to articulate the
overall status, remaining work, and barriers to progress.

                                                   Status is due by end of day each Thursday
                                                   Posted to the PMO SharePoint
                                                   Project leads report on the milestones, issues and
                                                    risks and provide graphics that are most relevant
                                                    to their project and their stakeholders
                                                   Friday the PMO consolidates and reviews the
                                                    status reports
                                                   Monday the IT Projects and Planning Committee
                                                    reviews the reports and acts on any prioritization
                                                    issues, cross project dependencies, or change
                                                    orders
                                                   The PMO may schedule project reviews with teams
                                                    that require assistance during the week
                                                      Mon        Tues      Wed        Thurs      Fri

                                                  IT Projects    Project   Project  Project      Status
                                                  and Planning   Reviews   Reviews Status Due   Reviewed
                                                   Committee                                      76
Yale waterfall delivery approach training deck
Yale waterfall delivery approach training deck
Yale waterfall delivery approach training deck
Yale waterfall delivery approach training deck
Yale waterfall delivery approach training deck

More Related Content

What's hot

T356 Asmi
T356 AsmiT356 Asmi
T356 Asmi
performanceweb

What You Need to Know Before Upgrading SharePoint 2010
What You Need to Know Before Upgrading SharePoint 2010What You Need to Know Before Upgrading SharePoint 2010
What You Need to Know Before Upgrading SharePoint 2010
Perficient, Inc.

Leverage Project 2010 with SharePoint 2010 for Project Management Success
Leverage Project 2010 with SharePoint 2010 for Project Management SuccessLeverage Project 2010 with SharePoint 2010 for Project Management Success
Leverage Project 2010 with SharePoint 2010 for Project Management Success
Dux Raymond Sy

Leverage Project 2010 w/ SharePoint 2010 for PM Success
Leverage Project 2010 w/ SharePoint 2010 for PM SuccessLeverage Project 2010 w/ SharePoint 2010 for PM Success
Leverage Project 2010 w/ SharePoint 2010 for PM Success
Dux Raymond Sy

7 Ways to Leverage SP2010 for PM Success #PMIWDC
7 Ways to Leverage SP2010 for PM Success #PMIWDC7 Ways to Leverage SP2010 for PM Success #PMIWDC
7 Ways to Leverage SP2010 for PM Success #PMIWDC
Dux Raymond Sy

B303
B303B303
Effectively Leverage Project 2010 w/ SharePoint 2010 for PM Success
Effectively Leverage Project 2010 w/ SharePoint 2010 for PM SuccessEffectively Leverage Project 2010 w/ SharePoint 2010 for PM Success
Effectively Leverage Project 2010 w/ SharePoint 2010 for PM Success
Dux Raymond Sy

How to Effectively Plan, Execute & Control SharePoint Projects
How to Effectively Plan, Execute & Control SharePoint ProjectsHow to Effectively Plan, Execute & Control SharePoint Projects
How to Effectively Plan, Execute & Control SharePoint Projects
Dux Raymond Sy

Leverage Project 2010 w/ SP2010 for PM Success @ SharePointFest Denver
Leverage Project 2010 w/ SP2010 for PM Success @ SharePointFest DenverLeverage Project 2010 w/ SP2010 for PM Success @ SharePointFest Denver
Leverage Project 2010 w/ SP2010 for PM Success @ SharePointFest Denver
Dux Raymond Sy

Delivering SharePoint Success: Why Collaboration is More Than Just Technology
Delivering SharePoint Success: Why Collaboration is More Than Just TechnologyDelivering SharePoint Success: Why Collaboration is More Than Just Technology
Delivering SharePoint Success: Why Collaboration is More Than Just Technology
Dux Raymond Sy

How to Best Manage SP Projects #SPSNOLA
How to Best Manage SP Projects #SPSNOLAHow to Best Manage SP Projects #SPSNOLA
How to Best Manage SP Projects #SPSNOLA
Dux Raymond Sy

How to setup EVM within a PMO
How to setup EVM within a PMOHow to setup EVM within a PMO
How to setup EVM within a PMO
Michael Gowlett PMP, Prince 2 Practitioner

How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012
How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012
How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012
TimCermak

B310
B310B310
7 Ways to Leverage SharePoint 2010 for Project Management Success
7 Ways to Leverage SharePoint 2010 for Project Management Success7 Ways to Leverage SharePoint 2010 for Project Management Success
7 Ways to Leverage SharePoint 2010 for Project Management Success
Dux Raymond Sy

Managing Enterprise Projects with Project Server 2010
Managing Enterprise Projects with Project Server 2010Managing Enterprise Projects with Project Server 2010
Managing Enterprise Projects with Project Server 2010
Dux Raymond Sy

OSPUG: How To Effectively Plan, Execute, Control SharePoint Projects
OSPUG: How To Effectively Plan, Execute, Control SharePoint ProjectsOSPUG: How To Effectively Plan, Execute, Control SharePoint Projects
OSPUG: How To Effectively Plan, Execute, Control SharePoint Projects
Dux Raymond Sy

SPSEMEA: Delivering SharePoint Success
SPSEMEA: Delivering SharePoint SuccessSPSEMEA: Delivering SharePoint Success
SPSEMEA: Delivering SharePoint Success
Dux Raymond Sy

T353 Web
T353 WebT353 Web
T353 Web
performanceweb

How To Best Develop SharePoint Requirements #SPSNOLA
How To Best Develop SharePoint Requirements #SPSNOLAHow To Best Develop SharePoint Requirements #SPSNOLA
How To Best Develop SharePoint Requirements #SPSNOLA
Dux Raymond Sy

What's hot (20)

T356 Asmi
T356 AsmiT356 Asmi
T356 Asmi

What You Need to Know Before Upgrading SharePoint 2010
What You Need to Know Before Upgrading SharePoint 2010What You Need to Know Before Upgrading SharePoint 2010
What You Need to Know Before Upgrading SharePoint 2010

Leverage Project 2010 with SharePoint 2010 for Project Management Success
Leverage Project 2010 with SharePoint 2010 for Project Management SuccessLeverage Project 2010 with SharePoint 2010 for Project Management Success
Leverage Project 2010 with SharePoint 2010 for Project Management Success

Leverage Project 2010 w/ SharePoint 2010 for PM Success
Leverage Project 2010 w/ SharePoint 2010 for PM SuccessLeverage Project 2010 w/ SharePoint 2010 for PM Success
Leverage Project 2010 w/ SharePoint 2010 for PM Success

7 Ways to Leverage SP2010 for PM Success #PMIWDC
7 Ways to Leverage SP2010 for PM Success #PMIWDC7 Ways to Leverage SP2010 for PM Success #PMIWDC
7 Ways to Leverage SP2010 for PM Success #PMIWDC

B303
B303B303
B303

Effectively Leverage Project 2010 w/ SharePoint 2010 for PM Success
Effectively Leverage Project 2010 w/ SharePoint 2010 for PM SuccessEffectively Leverage Project 2010 w/ SharePoint 2010 for PM Success
Effectively Leverage Project 2010 w/ SharePoint 2010 for PM Success

How to Effectively Plan, Execute & Control SharePoint Projects
How to Effectively Plan, Execute & Control SharePoint ProjectsHow to Effectively Plan, Execute & Control SharePoint Projects
How to Effectively Plan, Execute & Control SharePoint Projects

Leverage Project 2010 w/ SP2010 for PM Success @ SharePointFest Denver
Leverage Project 2010 w/ SP2010 for PM Success @ SharePointFest DenverLeverage Project 2010 w/ SP2010 for PM Success @ SharePointFest Denver
Leverage Project 2010 w/ SP2010 for PM Success @ SharePointFest Denver

Delivering SharePoint Success: Why Collaboration is More Than Just Technology
Delivering SharePoint Success: Why Collaboration is More Than Just TechnologyDelivering SharePoint Success: Why Collaboration is More Than Just Technology
Delivering SharePoint Success: Why Collaboration is More Than Just Technology

How to Best Manage SP Projects #SPSNOLA
How to Best Manage SP Projects #SPSNOLAHow to Best Manage SP Projects #SPSNOLA
How to Best Manage SP Projects #SPSNOLA

How to setup EVM within a PMO
How to setup EVM within a PMOHow to setup EVM within a PMO
How to setup EVM within a PMO

How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012
How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012
How to effectively utilize project 2010 with share point 2010 mpugsemi_feb2012

B310
B310B310
B310

7 Ways to Leverage SharePoint 2010 for Project Management Success
7 Ways to Leverage SharePoint 2010 for Project Management Success7 Ways to Leverage SharePoint 2010 for Project Management Success
7 Ways to Leverage SharePoint 2010 for Project Management Success

Managing Enterprise Projects with Project Server 2010
Managing Enterprise Projects with Project Server 2010Managing Enterprise Projects with Project Server 2010
Managing Enterprise Projects with Project Server 2010

OSPUG: How To Effectively Plan, Execute, Control SharePoint Projects
OSPUG: How To Effectively Plan, Execute, Control SharePoint ProjectsOSPUG: How To Effectively Plan, Execute, Control SharePoint Projects
OSPUG: How To Effectively Plan, Execute, Control SharePoint Projects

SPSEMEA: Delivering SharePoint Success
SPSEMEA: Delivering SharePoint SuccessSPSEMEA: Delivering SharePoint Success
SPSEMEA: Delivering SharePoint Success

T353 Web
T353 WebT353 Web
T353 Web

How To Best Develop SharePoint Requirements #SPSNOLA
How To Best Develop SharePoint Requirements #SPSNOLAHow To Best Develop SharePoint Requirements #SPSNOLA
How To Best Develop SharePoint Requirements #SPSNOLA

Viewers also liked

2013 SharePoint Fest DC - Build a SharePoint Intake/Request List
2013 SharePoint Fest DC - Build a SharePoint Intake/Request List2013 SharePoint Fest DC - Build a SharePoint Intake/Request List
2013 SharePoint Fest DC - Build a SharePoint Intake/Request List
Wes Preston

Challenging Aspects of Modern Project Management
Challenging Aspects of Modern Project ManagementChallenging Aspects of Modern Project Management
Challenging Aspects of Modern Project Management
Yamanta Raj Niroula, PMP

Recent ecm market developments from a share point of view q3
Recent ecm market developments from a share point of view   q3Recent ecm market developments from a share point of view   q3
Recent ecm market developments from a share point of view q3
Mike Alsup

Driving Business Value with Enterprise Social
Driving Business Value with Enterprise SocialDriving Business Value with Enterprise Social
Driving Business Value with Enterprise Social
Creative Sharepoint

Ms Dynamics Sure Step 2010
Ms Dynamics Sure Step 2010Ms Dynamics Sure Step 2010
Ms Dynamics Sure Step 2010
Mohamed Aamer

Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...
Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...
Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...
Optimus BT

Viewers also liked (6)

2013 SharePoint Fest DC - Build a SharePoint Intake/Request List
2013 SharePoint Fest DC - Build a SharePoint Intake/Request List2013 SharePoint Fest DC - Build a SharePoint Intake/Request List
2013 SharePoint Fest DC - Build a SharePoint Intake/Request List

Challenging Aspects of Modern Project Management
Challenging Aspects of Modern Project ManagementChallenging Aspects of Modern Project Management
Challenging Aspects of Modern Project Management

Recent ecm market developments from a share point of view q3
Recent ecm market developments from a share point of view   q3Recent ecm market developments from a share point of view   q3
Recent ecm market developments from a share point of view q3

Driving Business Value with Enterprise Social
Driving Business Value with Enterprise SocialDriving Business Value with Enterprise Social
Driving Business Value with Enterprise Social

Ms Dynamics Sure Step 2010
Ms Dynamics Sure Step 2010Ms Dynamics Sure Step 2010
Ms Dynamics Sure Step 2010

Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...
Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...
Purchasing, Procurement, Vendor, Contract and RFP Process Management with Sha...

Similar to Yale waterfall delivery approach training deck

Why projects fail
Why projects failWhy projects fail
Why projects fail
Ponto GP

Dropbox startup lessons learned 2011
Dropbox   startup lessons learned 2011Dropbox   startup lessons learned 2011
Dropbox startup lessons learned 2011
Eric Ries

Dealing with Estimation, Uncertainty, Risk, and Commitment
Dealing with Estimation, Uncertainty, Risk, and CommitmentDealing with Estimation, Uncertainty, Risk, and Commitment
Dealing with Estimation, Uncertainty, Risk, and Commitment
TechWell

How To (Not) Open Source - Javazone, Oslo 2014
How To (Not) Open Source - Javazone, Oslo 2014How To (Not) Open Source - Javazone, Oslo 2014
How To (Not) Open Source - Javazone, Oslo 2014
gdusbabek

Top 10 Things To Do If You Want To Get Fired Over A WordPress Project
Top 10 Things To Do If You Want To Get Fired Over A WordPress ProjectTop 10 Things To Do If You Want To Get Fired Over A WordPress Project
Top 10 Things To Do If You Want To Get Fired Over A WordPress Project
William Bergmann

Project Management in the Real World
Project Management in the Real WorldProject Management in the Real World
Project Management in the Real World
Kate Daly

10 bezcennych lekcji dla software developera stającego się szefem firmy
10 bezcennych lekcji dla software developera stającego się szefem firmy10 bezcennych lekcji dla software developera stającego się szefem firmy
10 bezcennych lekcji dla software developera stającego się szefem firmy
Wojciech Seliga

Ten lessons I painfully learnt while moving from software developer
to entrep...
Ten lessons I painfully learnt while moving from software developer
to entrep...Ten lessons I painfully learnt while moving from software developer
to entrep...
Ten lessons I painfully learnt while moving from software developer
to entrep...
Wojciech Seliga

PMO Book Club - May 2018
PMO Book Club - May 2018PMO Book Club - May 2018
PMO Book Club - May 2018
Lindsay Scott

Agile Development Overview (with a bit about builds)
Agile Development Overview (with a bit about builds)Agile Development Overview (with a bit about builds)
Agile Development Overview (with a bit about builds)
David Benjamin

(Why) Is A Project An Aircrash Sean Coughlan
(Why) Is A Project An Aircrash  Sean Coughlan(Why) Is A Project An Aircrash  Sean Coughlan
(Why) Is A Project An Aircrash Sean Coughlan
enableeast

Presentation PMO Fighter
Presentation PMO FighterPresentation PMO Fighter
Presentation PMO Fighter
pmopesopesado

What it Really Means to Be Agile
What it Really Means to Be AgileWhat it Really Means to Be Agile
What it Really Means to Be Agile
Kent McDonald

importance of resources allocation in formal method of software engineering ...
 importance of resources allocation in formal method of software engineering ... importance of resources allocation in formal method of software engineering ...
importance of resources allocation in formal method of software engineering ...
abdulrafaychaudhry

Project management
Project managementProject management
Project management
raghuraj_chaudhary

Agilelessons scanagile-final 2013
Agilelessons scanagile-final 2013Agilelessons scanagile-final 2013
Agilelessons scanagile-final 2013
lokori

L'illusione dell'ortogonalità
L'illusione dell'ortogonalitàL'illusione dell'ortogonalità
L'illusione dell'ortogonalità
Alberto Brandolini

Google Design sprint
Google Design sprintGoogle Design sprint
Google Design sprint
Bruno Mendes

Possible errors in projects and methods of avoiding and eliminating
Possible errors in projects and methods of avoiding and eliminatingPossible errors in projects and methods of avoiding and eliminating
Possible errors in projects and methods of avoiding and eliminating
SefaKOCAKALAY

Forget the A to Z of why it projects fail, here’s the S to L of successful!
Forget the A to Z of why it projects fail, here’s the S to L of successful!Forget the A to Z of why it projects fail, here’s the S to L of successful!
Forget the A to Z of why it projects fail, here’s the S to L of successful!
Stoneseed Ltd

Similar to Yale waterfall delivery approach training deck (20)

Why projects fail
Why projects failWhy projects fail
Why projects fail

Dropbox startup lessons learned 2011
Dropbox   startup lessons learned 2011Dropbox   startup lessons learned 2011
Dropbox startup lessons learned 2011

Dealing with Estimation, Uncertainty, Risk, and Commitment
Dealing with Estimation, Uncertainty, Risk, and CommitmentDealing with Estimation, Uncertainty, Risk, and Commitment
Dealing with Estimation, Uncertainty, Risk, and Commitment

How To (Not) Open Source - Javazone, Oslo 2014
How To (Not) Open Source - Javazone, Oslo 2014How To (Not) Open Source - Javazone, Oslo 2014
How To (Not) Open Source - Javazone, Oslo 2014

Top 10 Things To Do If You Want To Get Fired Over A WordPress Project
Top 10 Things To Do If You Want To Get Fired Over A WordPress ProjectTop 10 Things To Do If You Want To Get Fired Over A WordPress Project
Top 10 Things To Do If You Want To Get Fired Over A WordPress Project

Project Management in the Real World
Project Management in the Real WorldProject Management in the Real World
Project Management in the Real World

10 bezcennych lekcji dla software developera stającego się szefem firmy
10 bezcennych lekcji dla software developera stającego się szefem firmy10 bezcennych lekcji dla software developera stającego się szefem firmy
10 bezcennych lekcji dla software developera stającego się szefem firmy

Ten lessons I painfully learnt while moving from software developer
to entrep...
Ten lessons I painfully learnt while moving from software developer
to entrep...Ten lessons I painfully learnt while moving from software developer
to entrep...
Ten lessons I painfully learnt while moving from software developer
to entrep...

PMO Book Club - May 2018
PMO Book Club - May 2018PMO Book Club - May 2018
PMO Book Club - May 2018

Agile Development Overview (with a bit about builds)
Agile Development Overview (with a bit about builds)Agile Development Overview (with a bit about builds)
Agile Development Overview (with a bit about builds)

(Why) Is A Project An Aircrash Sean Coughlan
(Why) Is A Project An Aircrash  Sean Coughlan(Why) Is A Project An Aircrash  Sean Coughlan
(Why) Is A Project An Aircrash Sean Coughlan

Presentation PMO Fighter
Presentation PMO FighterPresentation PMO Fighter
Presentation PMO Fighter

What it Really Means to Be Agile
What it Really Means to Be AgileWhat it Really Means to Be Agile
What it Really Means to Be Agile

importance of resources allocation in formal method of software engineering ...
 importance of resources allocation in formal method of software engineering ... importance of resources allocation in formal method of software engineering ...
importance of resources allocation in formal method of software engineering ...

Project management
Project managementProject management
Project management

Agilelessons scanagile-final 2013
Agilelessons scanagile-final 2013Agilelessons scanagile-final 2013
Agilelessons scanagile-final 2013

L'illusione dell'ortogonalità
L'illusione dell'ortogonalitàL'illusione dell'ortogonalità
L'illusione dell'ortogonalità

Google Design sprint
Google Design sprintGoogle Design sprint
Google Design sprint

Possible errors in projects and methods of avoiding and eliminating
Possible errors in projects and methods of avoiding and eliminatingPossible errors in projects and methods of avoiding and eliminating
Possible errors in projects and methods of avoiding and eliminating

Forget the A to Z of why it projects fail, here’s the S to L of successful!
Forget the A to Z of why it projects fail, here’s the S to L of successful!Forget the A to Z of why it projects fail, here’s the S to L of successful!
Forget the A to Z of why it projects fail, here’s the S to L of successful!

More from Yale University Careers

Turn your skills into a career in IT
Turn your skills into a career in ITTurn your skills into a career in IT
Turn your skills into a career in IT
Yale University Careers

Using social media to increase organizational committment
Using social media to increase organizational committmentUsing social media to increase organizational committment
Using social media to increase organizational committment
Yale University Careers

Using Social Media for Departments and Programs at Yale
Using Social Media for Departments and Programs at YaleUsing Social Media for Departments and Programs at Yale
Using Social Media for Departments and Programs at Yale
Yale University Careers

Collaboration Landscape at Yale (C-level Executive presentation)
Collaboration Landscape at Yale (C-level Executive presentation)Collaboration Landscape at Yale (C-level Executive presentation)
Collaboration Landscape at Yale (C-level Executive presentation)
Yale University Careers

Pecha-Kucha 2 script March 2014
Pecha-Kucha 2 script March 2014Pecha-Kucha 2 script March 2014
Pecha-Kucha 2 script March 2014
Yale University Careers

Pecha-Kucha 2 Social Media Visibility- 20 slides-20 sec each
Pecha-Kucha 2 Social Media Visibility- 20 slides-20 sec eachPecha-Kucha 2 Social Media Visibility- 20 slides-20 sec each
Pecha-Kucha 2 Social Media Visibility- 20 slides-20 sec each
Yale University Careers

Service management roadmap fy14 fy16
Service management roadmap fy14   fy16Service management roadmap fy14   fy16
Service management roadmap fy14 fy16
Yale University Careers

Knowledge12 yale service management rapid maturity yale format
Knowledge12 yale service management rapid maturity   yale formatKnowledge12 yale service management rapid maturity   yale format
Knowledge12 yale service management rapid maturity yale format
Yale University Careers

Service lifecycle placemat v3
Service lifecycle placemat v3Service lifecycle placemat v3
Service lifecycle placemat v3
Yale University Careers

Wit for orientation
Wit for orientationWit for orientation
Wit for orientation
Yale University Careers

Knowledge hackathon
Knowledge hackathonKnowledge hackathon
Knowledge hackathon
Yale University Careers

Request management lunch and learn v3
Request management lunch and learn v3Request management lunch and learn v3
Request management lunch and learn v3
Yale University Careers

Itsm knowledge roadmap ar updates
Itsm knowledge roadmap ar updatesItsm knowledge roadmap ar updates
Itsm knowledge roadmap ar updates
Yale University Careers

Introduction to the itsm program at yale why are we doing this august 2011
Introduction to the itsm program at yale   why are we doing this august 2011Introduction to the itsm program at yale   why are we doing this august 2011
Introduction to the itsm program at yale why are we doing this august 2011
Yale University Careers

Users group meeting 2012 july yale presentation v2
Users group meeting 2012 july yale presentation v2Users group meeting 2012 july yale presentation v2
Users group meeting 2012 july yale presentation v2
Yale University Careers

Radcliffe rapid maturity through csi just yale slides
Radcliffe rapid maturity through csi just yale slidesRadcliffe rapid maturity through csi just yale slides
Radcliffe rapid maturity through csi just yale slides
Yale University Careers

More from Yale University Careers (16)

Turn your skills into a career in IT
Turn your skills into a career in ITTurn your skills into a career in IT
Turn your skills into a career in IT

Using social media to increase organizational committment
Using social media to increase organizational committmentUsing social media to increase organizational committment
Using social media to increase organizational committment

Using Social Media for Departments and Programs at Yale
Using Social Media for Departments and Programs at YaleUsing Social Media for Departments and Programs at Yale
Using Social Media for Departments and Programs at Yale

Collaboration Landscape at Yale (C-level Executive presentation)
Collaboration Landscape at Yale (C-level Executive presentation)Collaboration Landscape at Yale (C-level Executive presentation)
Collaboration Landscape at Yale (C-level Executive presentation)

Pecha-Kucha 2 script March 2014
Pecha-Kucha 2 script March 2014Pecha-Kucha 2 script March 2014
Pecha-Kucha 2 script March 2014

Pecha-Kucha 2 Social Media Visibility- 20 slides-20 sec each
Pecha-Kucha 2 Social Media Visibility- 20 slides-20 sec eachPecha-Kucha 2 Social Media Visibility- 20 slides-20 sec each
Pecha-Kucha 2 Social Media Visibility- 20 slides-20 sec each

Service management roadmap fy14 fy16
Service management roadmap fy14   fy16Service management roadmap fy14   fy16
Service management roadmap fy14 fy16

Knowledge12 yale service management rapid maturity yale format
Knowledge12 yale service management rapid maturity   yale formatKnowledge12 yale service management rapid maturity   yale format
Knowledge12 yale service management rapid maturity yale format

Service lifecycle placemat v3
Service lifecycle placemat v3Service lifecycle placemat v3
Service lifecycle placemat v3

Wit for orientation
Wit for orientationWit for orientation
Wit for orientation

Knowledge hackathon
Knowledge hackathonKnowledge hackathon
Knowledge hackathon

Request management lunch and learn v3
Request management lunch and learn v3Request management lunch and learn v3
Request management lunch and learn v3

Itsm knowledge roadmap ar updates
Itsm knowledge roadmap ar updatesItsm knowledge roadmap ar updates
Itsm knowledge roadmap ar updates

Introduction to the itsm program at yale why are we doing this august 2011
Introduction to the itsm program at yale   why are we doing this august 2011Introduction to the itsm program at yale   why are we doing this august 2011
Introduction to the itsm program at yale why are we doing this august 2011

Users group meeting 2012 july yale presentation v2
Users group meeting 2012 july yale presentation v2Users group meeting 2012 july yale presentation v2
Users group meeting 2012 july yale presentation v2

Radcliffe rapid maturity through csi just yale slides
Radcliffe rapid maturity through csi just yale slidesRadcliffe rapid maturity through csi just yale slides
Radcliffe rapid maturity through csi just yale slides

Recently uploaded

Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...
Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...
Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...
Neil Horowitz

Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.
Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.
Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.
AnnySerafinaLove

3 Simple Steps To Buy Verified Payoneer Account In 2024
3 Simple Steps To Buy Verified Payoneer Account In 20243 Simple Steps To Buy Verified Payoneer Account In 2024
3 Simple Steps To Buy Verified Payoneer Account In 2024
SEOSMMEARTH

Best Forex Brokers Comparison in INDIA 2024
Best Forex Brokers Comparison in INDIA 2024Best Forex Brokers Comparison in INDIA 2024
Best Forex Brokers Comparison in INDIA 2024
Top Forex Brokers Review

Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
my Pandit

Part 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 SlowdownPart 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 Slowdown
jeffkluth1

The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
Stephen Cashman

The Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac SignThe Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac Sign
my Pandit

Digital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital ExcellenceDigital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital Excellence
Operational Excellence Consulting

Innovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & InnovationInnovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & Innovation
Operational Excellence Consulting

Lundin Gold Corporate Presentation - June 2024
Lundin Gold Corporate Presentation - June 2024Lundin Gold Corporate Presentation - June 2024
Lundin Gold Corporate Presentation - June 2024
Adnet Communications

HOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdf
HOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdfHOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdf
HOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdf
46adnanshahzad

Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...
Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...
Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...
➒➌➎➏➑➐➋➑➐➐Dpboss Matka Guessing Satta Matka Kalyan Chart Indian Matka

How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
Lacey Max

Digital Marketing with a Focus on Sustainability
Digital Marketing with a Focus on SustainabilityDigital Marketing with a Focus on Sustainability
Digital Marketing with a Focus on Sustainability
sssourabhsharma

一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理
一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理
一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理
taqyea

Best practices for project execution and delivery
Best practices for project execution and deliveryBest practices for project execution and delivery
Best practices for project execution and delivery
CLIVE MINCHIN

The latest Heat Pump Manual from Newentide
The latest Heat Pump Manual from NewentideThe latest Heat Pump Manual from Newentide
The latest Heat Pump Manual from Newentide
JoeYangGreatMachiner

list of states and organizations .pdf
list of  states  and  organizations .pdflist of  states  and  organizations .pdf
list of states and organizations .pdf
Rbc Rbcua

Profiles of Iconic Fashion Personalities.pdf
Profiles of Iconic Fashion Personalities.pdfProfiles of Iconic Fashion Personalities.pdf
Profiles of Iconic Fashion Personalities.pdf
TTop Threads

Recently uploaded (20)

Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...
Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...
Brian Fitzsimmons on the Business Strategy and Content Flywheel of Barstool S...

Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.
Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.
Anny Serafina Love - Letter of Recommendation by Kellen Harkins, MS.

3 Simple Steps To Buy Verified Payoneer Account In 2024
3 Simple Steps To Buy Verified Payoneer Account In 20243 Simple Steps To Buy Verified Payoneer Account In 2024
3 Simple Steps To Buy Verified Payoneer Account In 2024

Best Forex Brokers Comparison in INDIA 2024
Best Forex Brokers Comparison in INDIA 2024Best Forex Brokers Comparison in INDIA 2024
Best Forex Brokers Comparison in INDIA 2024

Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...

Part 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 SlowdownPart 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 Slowdown

The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...
The Heart of Leadership_ How Emotional Intelligence Drives Business Success B...

The Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac SignThe Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac Sign

Digital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital ExcellenceDigital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital Excellence

Innovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & InnovationInnovation Management Frameworks: Your Guide to Creativity & Innovation
Innovation Management Frameworks: Your Guide to Creativity & Innovation

Lundin Gold Corporate Presentation - June 2024
Lundin Gold Corporate Presentation - June 2024Lundin Gold Corporate Presentation - June 2024
Lundin Gold Corporate Presentation - June 2024

HOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdf
HOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdfHOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdf
HOW TO START UP A COMPANY A STEP-BY-STEP GUIDE.pdf

Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...
Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...
Dpboss Matka Guessing Satta Matta Matka Kalyan panel Chart Indian Matka Dpbos...

How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....

Digital Marketing with a Focus on Sustainability
Digital Marketing with a Focus on SustainabilityDigital Marketing with a Focus on Sustainability
Digital Marketing with a Focus on Sustainability

一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理
一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理
一比一原版新西兰奥塔哥大学毕业证(otago毕业证)如何办理

Best practices for project execution and delivery
Best practices for project execution and deliveryBest practices for project execution and delivery
Best practices for project execution and delivery

The latest Heat Pump Manual from Newentide
The latest Heat Pump Manual from NewentideThe latest Heat Pump Manual from Newentide
The latest Heat Pump Manual from Newentide

list of states and organizations .pdf
list of  states  and  organizations .pdflist of  states  and  organizations .pdf
list of states and organizations .pdf

Profiles of Iconic Fashion Personalities.pdf
Profiles of Iconic Fashion Personalities.pdfProfiles of Iconic Fashion Personalities.pdf
Profiles of Iconic Fashion Personalities.pdf

Yale waterfall delivery approach training deck

  • 1. IT Project Delivery Approach and how you can avoid sinking A training class prepared by the ITS PMO – June 2010 Special thanks to Jenny Greene (http://www.stellman-greene.com) for letting us borrow some of the concepts and graphics used within
  • 2. Why are we here? To learn about the IT project delivery approach WELCOME CLASS! After this training you should: Be able to describe and use the basic structure of the IT project delivery approach Understand some of the best practices that help projects to be successful Know where to get more information and help when you need it Be better prepared to help your projects succeed!! 2
  • 3. Today‟s agenda - Timing may be variable! Section Duration Start End Introductions 30 9:00 9:30 Opening 30 9:30 10:00 SDLC Placemat Orientation 10 10:00 10:10 Plan & Analyze 40 10:10 10:50 Break 10 10:50 11:00 Design/Build/Test/Deploy 45 11:00 11:45 Case Study I 20 11:45 12:05 Lunch 30 12:05 12:30 Case Study Feedback 15 12:30 12:45 Governance Overview 30 12:45 1:15 Processes Overview 30 1:15 1:45 Break, Case Study 60 1:45 2:45 Odds & Ends 15 2:45 3:00 3 Closing and Survey 15 3:00 3:30
  • 4. Who are we? Before we begin, let‟s get to know each other Please tell us about:  Your department and role  Years at Yale  Previous experience / familiarity with project delivery methodologies  One interesting project experience you‟ve had 4
  • 5. So, what is a project? Will deliver business and / or technical objectives in line with the University‟s strategic direction Runs for a defined period of time (has a start and end date) Has a budget Uses University resources 5
  • 6. Work Categories All requested work can be categorized based on size or type Central A Major project, estimated at $250k or more funding, allocated by officers each year B Minor project, estimated between $50-$249k Client funded S Self funded request of any size Baseline C Small enhancement, estimated at less than $50k funding, pre- set each year M Maintenance and break/fix requests 6
  • 7. What is a project delivery approach? Our approach includes:  Solution and business integration development lifecycle (SDLC) – What activities do I perform? – What deliverables do I create?  Project governance framework – Who is responsible for what? – How are decisions made for a project? Across all projects?  Project management Processes – How do I manage scope, schedule, cost, resources, quality, communications, risks and vendors? 7
  • 8. What is project success? Project success occurs when we have:  A satisfied client (expectations met) Scope  Delivered the agreed objectives  Met an agreed budget ($, resources, etc)  Within an agreed time frame And, we‟ve done it all professionally and without killing the team Time Cost “Scope, Schedule, Cost” The “Golden Triangle” of Project Success 8 According to Gartner, approximately 60 – 70% of IT projects fail
  • 9. Simply put, success is a balancing act YOU THINK THIS IS HARD? IN MY LAST JOB I MANAGED PROJECTS WITH MULTIPLE STAKEHOLDERS AND CONFLICTING PRIORITIES 9
  • 10. Before we look at the approach, let‟s first examine why projects fail The bridge was nicknamed “Galloping Gertie” due to movement on windy days Not all failures are this easy to spot . . .  The Tacoma Narrows Bridge project failed before the first yard of concrete was poured  There was nothing wrong with the construction. Poor design and badly planned cost cutting in materials led to an unfortunate end  No human life was lost when the bridge collapsed on 11/7/1940, but Tubby the dog went down with his owners car when he refused to be removed 10
  • 11. “This time it‟s different” There‟s an old saying about how there are a million ways to fail, but only one way to be right. When it comes to projects, nothing‟s further from the truth. Projects fail the same few ways over and over again. Don‟t go in the basement! Technology projects are a lot like cheesy horror movies. After you‟ve seen a few of them, you know that the first guy to leave the group is going to get an axe in his head. Projects are the same way. People keep making the same mistakes over and over, and it keeps getting their projects killed. 11
  • 12. You know you‟re on a failed project when . . . JETSON, YOU‟RE A judge in 1964 said (and we paraphrase), “I FIRED!!!! don‟t know how to define pornography, but I know it when I see it.” And the same goes for failing projects - we can all spot a failing project when we see one. What does a failing project look like? You certainly know your project failed if it got aborted and everyone was laid off. But there are other, less obvious kinds of failure:  The project costs a lot more than it should  It takes a lot longer than anyone expected  The product doesn‟t do what it was supposed to  Nobody is happy about it Justice Potter Stewart‟s concurring opinion in Jacobellis v. Ohio: “I shall not 12 today attempt further to define the kinds of material I understand to be embraced within that shorthand description; and perhaps I could never succeed in intelligibly doing so. But I know it when I see it.”
  • 13. Sometimes failure seems normal Nobody sets out to fail, but for some reason people just accept that a lot of technology projects won‟t deliver on time, on budget with the expected scope intact. But talking about what causes failure makes people uncomfortable, because nobody wants to give or take that kind of criticism. A show of hands, please… We‟ve never met a single IT professional with more than a few years of experience who hasn‟t been on at least one failed project. Are there any here? 13
  • 14. Four basic ways projects can fail There are plenty of ways that you can categorize failed projects. We like to think of them like this:  Things the product does (or doesn’t do) How your project doesn‟t quite meet the needs of the people you built it for  Things the team should have done Once in a while, it really is the team‟s fault  Things that could have been caught . . . but weren‟t until it was way too late  Things the boss does Classic management mistakes that can damage the project 14
  • 15. Things the product does (or doesn‟t do) It seems pretty obvious that you should know what the software‟s supposed to do before you start building it... not that that stops us.  We only find serious problems after we‟ve built them into the product  Scope keeps changing and growi ng  No one is sure who gets to choose what the product does  90% done, with 90% left to go 15
  • 16. Things the team should have done The team could have done the work more efficiently, if only we‟d taken the time to think it through.  Planning is not done thoroughly  Issues and risks are not identified and acted upon quickly enough  Dependencies are not understood  Expectations are not managed well 16
  • 17. Things that could have been caught Which would you choose: a well built product that doesn‟t do what you need or a crappy one that‟s irritating to use and does?  Getting a few tech support people to “bang on the software” is not testing  Maybe we could‟ve caught that design problem before the code was built  Maybe we could‟ve caught that code problem before we went to test  Wishful thinking does not make an application run faster 17
  • 18. Things the boss does Some problems start with senior managers, others start with key stakeholders, but they can all sink the project.  Over promising  Ignoring issues and risks  Artificial wall between the business and technology  Over simplifying 18
  • 19. Brains are important too . .. HOW MANY TIMES A good approach is not a replacement DO I HAVE TO TELL for good judgment and sound skills. We YOU, IT‟S RIGHT TIGHTY, LEFTY could have the best tools in the world, LOOSEY but most of us still could not fix the space shuttle or perform surgery.  A sound approach is a good start, but we also need to be the owners of our own ability  Understanding how to use the tools and your own personal development path is probably the most important thing we would like you to learn today  The good news is that a standard, proven approach will help us to focus on the execution of the work and help us to better help each other Goober worked at Wally's Filling Station, which he 19 eventually purchased and became the proprietor
  • 20. The talent is there… the delivery management‟s not Hoover Dam was finished two years early, and under budget. Technology projects are not so different that we can‟t engineer them just as well.  Our problems have, for the most part, been solved  Over and over and over again. Seriously.  We just have to stop ignoring the solutions The building of the Hoover Dam started in 1931 and finished in 1935, two years earlier than scheduled. And this is the reason chief 20 engineer of the project, Frank T. Crowe, was nicknamed “Hurry up”.
  • 21. Ok, let‟s get to the good part Our approach encompasses three areas: Solution and business integration lifecycle (our SDLC) Project governance Project management processes Let’s start by reviewing the SDLC . . . 21
  • 22. The Waterfall approach, or “how safe is your barrel”? Concept  The Waterfall Method was introduced by Winston Royce in 1970. It is the oldest and Requirements & Plan most widely used development approach  SDLC and Waterfall are not the same – Waterfall is one type of SDLC Design Solution AND MY  It involves a sequence of steps or stages, DRESS DIDN‟T EVEN GET output from one stage is input to the next WET Build and Unit Test Solution Parts  Stages can sometimes overlap, but there are very definite goals for each phase Integration Test and Customer Acceptance  Biggest drawback of the waterfall model is that revision (scope and design changes) can be difficult and costly if not managed Deploy properly Later we will talk about a concept called “Phase Containment” that helps to manage some of the drawbacks of waterfall 22 Winston W. Royce (1929–1995) was an American computer scientist, director at Lockheed Software Technology Center in Austin, TX, and one of the leaders in software development in the second half of the 20th century. He was the first who described the Waterfall model for software development
  • 23. Phases Plan Analyze Design Build Test Deploy Operate Initiate Our implementation of the waterfall approach uses the following phases:  Initiate – Request a new project and get approval to allocate resources (and spend $$!)  Plan – Create project plan and define goals and expectations  Analyze – Confirm requirements for the product  Design – Detail the design of the product  Build – Create the product  Test – Validate that the product does what it is supposed to do  Deploy – Move the product into production  Operate – After the project is closed, run the product in production 23
  • 24. Initiate Phase Plan Analyze Design Build Test Deploy Operate Initiate The project charter is the primary outcome of the Initiate phase. It prepares the project to officially launch, which means the project can begin to allocate resources and spend money.  Names sponsor, business relationship manager and project lead  Project purpose  Strategic fit  Success metrics  Known scope & requirements (high level)  Known stakeholders  Known risks & constraints  Project governance  Rough order of magnitude (ROM) schedule, resources and costs  Milestones, resources and costs for next phase (typically plan or plan and analyze) 24
  • 25. Plan Phase – What we get Plan Analyze Design Build Test Deploy Operate Initiate By the end of the plan phase, we should know:  What is in scope, what is out of scope  The high level requirements of the target state applications, processes and organization  The current state of the applications, processes and organization  The proposed target state of the applications, processes and organization  The steps needed to move from current state to target state  An approach for sourcing  Approaches for managing the projects scope, schedule, cost, resources, risk, quality and communications  Which deliverables the project will produce  Whether we will buy and / or build technology  Which package(s) will be used for technology that will be bought  The underlying technical infrastructure needed to support analysis and design  Who the stakeholders are and what is important to them  The potential impacts on the target organization  Who we need to communicate to, when, how, why and to say what  A draft plan, team and cost estimate on what it will take to move from current to target 25
  • 26. Plan Phase – What we do Plan Analyze Design Build Test Deploy Operate Initiate Formally establish the project. Staff initial team members, begin project meetings, establish steering committee, create project status reports Document how the project will be organized and governed – consider who is responsible for each aspect of the project, how the team will be organized, what forums will be used to govern the project and who is on each forum Define the underlying technical architecture required to support the target application environment Define who needs to know what, when, how and why Assess the delivery approach and tailor it to the needs of the project. This includes phases, activities, deliverables, gating, sourcing, usage of vendors and other 3rd parties, etc 26
  • 27. Plan Phase – What we create Plan Analyze Design Build Test Deploy Operate Initiate The solution blueprint contains a definition of the target state environment. This can include (but is not limited to) the application, infrastructure, process and organization target states. In addition, target training and the project delivery approach are documented here The stakeholder and organization impact analysis documents the stakeholders, their degree of influence on the project and how they will be impacted by the project. It also documents potential organizational impacts The project management plan documents the project scope, schedule & cost and how these items will be managed / governed 27
  • 28. Analyze Phase – What we get Plan Analyze Design Build Test Deploy Operate Initiate By the end of the analyze phase, we should know:  How the target state processes will work  The detailed requirements that the target state must support  Where there are gaps in how the vendor package(s) support the requirements  General approach for filling the gaps (e.g., custom mod, drop requirement, etc)  Use cases and the conceptual data model, for custom development  Identification of the RICEFW widgets that will be designed and built (RICEFW = Reports, Interfaces, Conversions, Extensions, Forms, Workflows)  High level designs to reflect how the requirements will be supported (where applicable and needed to determine RICEFW definition)  The approach that will be used to test that the target solution meets the requirements and does not have a negative impact on other systems or processes  The definition of, and the plan to build (where necessary) the technical infrastructure needed to support build, test and deploy  The approach that will be used to train users and other impacted parties on the target solution  Understanding of the current organization  Understanding of the impact of new processes and technologies on the organization, including roles, jobs, teams and performance measures  A baseline plan, team and cost estimate on what it will take to move from current to target 28
  • 29. Analyze Phase – What we do Plan Analyze Design Build Test Deploy Operate Initiate Document the requirements that the target solution must support. Consider requirements across functional, technical and operational areas, as well as prioritization and potential phasing of requirements Reports, Interfaces, Conversions, Extensions, Forms, Workflows. Define the set of widgets that will be designed, built and tested. In some cases, a high level design will be needed to fully identify the widgets Consider and plan for any infrastructure components that need to be procured, built and / or configured. This should include your desktop infrastructure as well. Let‟s not forget about the managed desktop! For components of design & build that will be done in an iterative fashion (typically applies most easily to components that involve user interaction, such as process & form design) define the set of iterations that will be executed Document how the end users will be trained and educated on the usage of the target solution. Consider who needs to be trained, when they need to be trained, how they will receive training, what needs to be designed & built to support training 29
  • 30. Analyze Phase – What we create Plan Analyze Design Build Test Deploy Operate Initiate The RTM documents each requirement of the target solution and facilitates traceability between requirements and associated test scripts. The RTM can also be uplaoded into a testing tool, such as SQA, and Package system gaps are also defined within the RTM The security design review gathers data to facilitate the The test approach defines the test phases and cycles that identification of potential security risks associated with will be used to test the target solution the target state. Note that an initial completion of the document is done in the analyze phase, with the final version due at end of test 30
  • 31. Design Phase – What we get Plan Analyze Design Build Test Deploy Operate Initiate By the end of the design phase, we should have:  A prototype of the application to demonstrate how it will work  For custom solutions, design of common application classes and components  For custom solutions, a logical database design  Design of the application configuration  Functional designs for reports, interfaces, conversions, extensions, forms and workflows that describe how these components will work  Necessary development environments are ready  End user organization, roles and jobs are defined  Design for the delivery of training  Definition of how the target solution will be supported in the operating environment (both functionally and technically), gaps between the current and target support models, and the plan to close the gaps 31
  • 32. Design Phase – What we do Plan Analyze Design Build Test Deploy Operate Initiate Build a model or working application that demonstrates how the product will look, act and feel, with the intent of gaining stakeholder feedback. This process can be iterated as part of the iterative approach, where applicable Define how the target product will be supported in the operational environment, including the roles needed to support, the gaps between current and target state, and the plan to move to target Create the functional designs for each widget that describe visually and textually how each widget (and the overall product) will work and what it will do 32
  • 33. Design Phase – What we create Plan Analyze Design Build Test Deploy Operate Initiate The workforce transition plan defines the steps and approach to move from the current organization (jobs, roles, etc) to the target organization The prototype is a mock-up or “alpha” version of the target product, with the intent of demonstrating how the product will look, act and feel The role descriptions document defines the roles and responsibilities that will exist in the target organization The training plan defines the details of each training approach / session so that training can be planned and coordinated 33
  • 34. Build Phase – What we get Plan Analyze Design Build Test Deploy Operate Initiate By the end of the build phase, we should have:  A master configuration for the packaged software that can be applied to build and test environments  Technical designs for reports, interfaces, conversions, extensions, forms and workflows that describe how these components will be built  Built, unit and assembly tested application components  For custom builds, a physical database created from the logical data definition  Test planning complete, including build of test cycles, scenarios and scripts  Plans to staff the new organization as necessary  Built training and communications materials  Technical infrastructure and environments ready for test, training and deploy 34
  • 35. Build Phase – What we do Plan Analyze Design Build Test Deploy Operate Initiate Create the detailed technical designs that describe how the target solution will be built Create physical database Define the test cycles, scenarios and scripts that trace Build the materials that will be used to support end user back to each requirement to ensure that each requirement training is tested Build the remaining environments that are needed for test training and deployment Confirm that the build objects meet organizational standards, and have been appropriately unit and assembly tested 35
  • 36. Build Phase – What we create Plan Analyze Design Build Test Deploy Operate Initiate The knowledge management content is the information needed by the supporting organizations (e.g., service desk, functional support, technical support, etc) to meet expected service levels The test plan is comprised of the cycles, scenarios and test scripts that will be used to ensure that the target product supports requirements Update of the communications plan established in the plan phase 36
  • 37. Test Phase – What we get Plan Analyze Design Build Test Deploy Operate Initiate By the end of the test phase, we should have:  A validated target product that meets performance, security, functional, desktop, and end user expectations  An agreed to freeze on changes to application code  Approved security design  A conversion process that has been tested  Completed runbooks  Agreed to contingency plans  Tested cutover plans  Piloted training  End users and stakeholders that are aware of the forthcoming changes, and prepared to accept them 37
  • 38. Test Phase – What we do Plan Analyze Design Build Test Deploy Operate Initiate Prepare and test the cutover plans end to end prior to actual cutover. Iterate until the cutover process is working at an acceptable level Pilot the training, make adjustments based on feedback, and then deliver training as planned Ensure that the target solution meets the desktop Confirm formal approval from the sponsor and key requirements stakeholders that the target product is ready to be deployed into the production environment Freeze all changes to the application code until the application is deployed. Once the application is deployed, bugs will be prioritized, fixed and the application regression tested. New functionality should wait for a new release Execute mock conversion to test the end to end conversion process prior to actual conversion. Iterate until conversion process is working at an acceptable level 38
  • 39. Test Phase – What we create Plan Analyze Design Build Test Deploy Operate Initiate Final version of security design review The cutover plan documents the steps, sequencing and The runbooks are a handbook that describe the overall timing of the activities needed to migrate from the test technical architecture and operational considerations for environment to the production environment an application, and are used by the technical support teams 39
  • 40. Deploy Phase – What we get Plan Analyze Design Build Test Deploy Operate Initiate At the end of the deploy phase, we should know:  Data converted into production environments  Application code migrated to production environments  End users trained and communicated to  Target state (organization, processes and application) rolled out as specified by requirements and delivery approach  Critical and high priority post deployment issues resolved during warranty period  Responsibility for operating and maintaining the target state is transferred to the operating teams  Completed project closure report 40
  • 41. Deploy Phase – What we do Plan Analyze Design Build Test Deploy Operate Initiate Move all involved application and technical components into the production environment Execute user support model by providing launch support for the end users and when appropriate move to the operational user support model Deliver the training and communications necessary to make stakeholders aware of the target product, and enabled to operate successfully in the target environment, with the target tools Identify, prioritize and resolve issues during the deployment period until the target environment has reached a pre-defined level of stability Formally transfer operating and maintenance responsibility to the operating teams, disband the project team, stop project funding 41

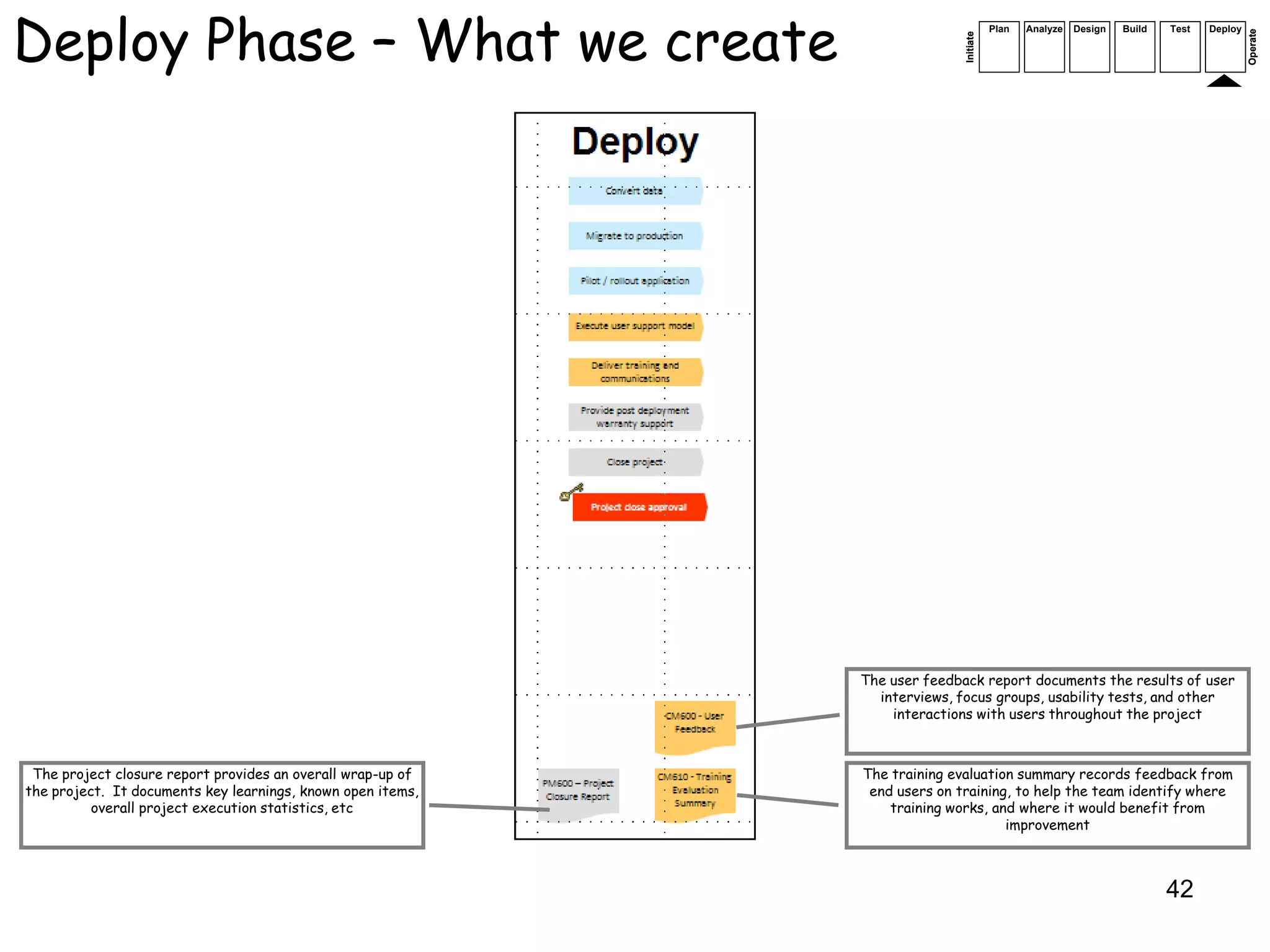

  • 42. Deploy Phase – What we create Plan Analyze Design Build Test Deploy Operate Initiate The user feedback report documents the results of user interviews, focus groups, usability tests, and other interactions with users throughout the project The project closure report provides an overall wrap-up of The training evaluation summary records feedback from the project. It documents key learnings, known open items, end users on training, to help the team identify where overall project execution statistics, etc training works, and where it would benefit from improvement 42
  • 43. Agile Techniques Operate Plan Analyze Design Build Test Deploy Initiate Design Build Agile Techniques – For each Sprint: Design UI, process Review build Review design Customer Confirm scope flow, workflow, Do incremental with customer output or data with customer and approval of of sprint make changes build and make usage sprint changes  Within the context of the waterfall approach, some functions may benefit from a more iterative design & build approach  Common examples include application forms, configuration and reports, but can apply to any functions that can be mostly built and validated on a stand-alone basis  These techniques are not a replacement for full Agile development. Agile is a different type of SDLC that is not covered in this training  Beware that iterative development has it‟s own pitfalls, including potential for rework and cost and schedule over-runs 43
  • 44. Operate Phase Plan Analyze Design Build Test Deploy Operate Initiate Entry into the operate phase represents official closure of the project  Project funding ends  Project team and governance disbands in favor or operating team and governance  Project resources go onto other projects or activities  The operational teams take ownership of the application and supporting processes 44
  • 45. SDLC Summary  Waterfall approach, but iterate and overlap when reasonable and helpful  Not just for software – considers business processes, organization and communication  Toolbox approach, tailor, tailor, tailor Are there any questions on the SDLC? 45
  • 46. Case study #1 Refer to case study #1 handout 46
  • 47. Next, let‟s look at project governance . . . Our approach encompasses three areas: Solution and business integration lifecycle (our SDLC) Project governance Project management processes 47
  • 48. What is governance? There are probably few terms that are used as freely, but understood as poorly, as the term “governance”. We LET „EM HANG Judge Isaac Parker aka “The Hanging Judge” will continue the trend by using it freely. However, we will try to make some sense of what it is and why it is important - mostly so that you can impress your friends and neighbors, but also so that you can understand how you can use it to help your projects to be more successful  One definition of governance: “Specifying the decision rights and accountability framework to encourage desirable behavior in the use of IT”  We can simplify it further: “Defining who is He has decision authority responsible for what and who can make which The unfortunate accused decisions” 48 They are accountable
  • 49. Levels of governance Our approach considers governance at the project level, and cross-project (or portfolio) level Portfolio  Decisions that cross projects, such as funding, resources and dependencies  Decisions that are local Project 1 Project 2 Project 3 Project n to a project, such as scope, design approach and deliverable quality 49
  • 50. Project Roles ACTION! How are projects like movies? No, not the long hours and poor reviews from the critics. Both rely on standard roles to help them run smoothly. On any movie set everyone knows what the key grip and gaffer are responsible for. Successful projects operate in the same way, with standard roles and clear understanding of responsibilities and decision making authority.  Sponsor - Proposes and champions the project. Responsible for the project‟s success  Relationship Manager - Responsible for translating business vision into solution, staffing, and delivering solution  Project Lead – Responsible for delivery of project scope, on time and within budget  Functional Lead – Responsible for delivery of the functional solution  Technical Lead – Responsible for delivery of the technical solution  Change Management Lead – Responsible for organizational and user adoption of the solution Like Eddie Murphy in The Nutty Professor, an 50 individual can play more than one role on a project!
  • 51. Project Escalation Paths WE‟RE BEHIND SCHEDULE? WHY DIDN‟T YOU TELL ME?! Bosses tend to be happier when you don‟t surprise them, especially if the surprise brings bad news. Every team member should know what to do when they have a problem that they cannot resolve themselves. A well defined process to identify, escalate and resolve problems is an essential part of how any project is governed  The structure and number of escalation levels is dependent upon the size and complexity of the project and Steering the organization, but typically want as Committee few as possible Project Status Meeting  Team members should be encouraged Team Status Meeting(s) (and empowered) to resolve issues at the local level, but should also know where to get help when they need it  The Project Lead is responsible for Team Status Meeting(s) facilitating the escalation process, but every team member is responsible for Review progress, deliverables, issues, decisions, risks, etc related to a specific team or subset of the project Team lead Team members Team members Team members Team members identifying, resolving and escalating As defined by the team leads and project lead problems 51
  • 52. Portfolio Governance The IT Projects and Planning Committee is the “supreme court” for decisions that impact the portfolio of projects. Business specific issues may still require escalation through the business area, but items that are IT related or have impact across the portfolio of projects can be escalated to this council for final decisioning AS CHIEF DO YOU SMELL I THINK IT JUSTICE, I SOMETHING WAS ALITO DECLARE IT FUNNY? WAS SCALIA 52
  • 53. Gating I SURE HOPE MY GATING PAPERS ARE IN ORDER . . . Gating is part governance function and part quality assurance. The intent of gating is to help apply our standards (such as this delivery approach) and to bring broad transparency to the solutions being built. It also helps to support the concept of “phase containment” whereby the problems from earlier phases do not have a snowballing affect on later project phases Funding Starts Funding Baselined Deployment Decision Funding Stops Plan and Analyze ($100k – 250k) Small Projects Approval Express Path Establish ROM Estimate Screening and Definition Does Not Gate Enhancement Sprints Operate <$100k Initiate Plan Analyze Design Build Test Deploy Go/No-Go Decision Planning Estimate Baseline Estimate Design Approval Planning Phase Major Projects Build Approval (over $250k or Requirements highly visible) Approval Approval Full Path There can be multiple paths through Project Launch Gate Plan Gate Analyze Gate Design Review Gate Build Review Gate Go/No-Go Gate Project Close Gate gating depending upon the project type, size and complexity. Two typical paths are shown here “Are we ready to “Can this project be “Are the “Do we know how we “Does the code meet “Does the product “Can the functionality start spending money successful based on requirements clear, will build the product our coding meet the be supported planning this work?” the plans?” agreed to and to support the standards?” requirements?” operationally?” achievable?” requirements?” “Are we ready to deploy into production? 53
  • 54. Gating Approvals  Gating is facilitated by the “Gating Questionnaire”, a set of questions Gating is run by the key organizational leads that are for each phase impacted by and / or responsible for project outcomes.  The questions are aligned by the The transparency from gating gives these organizational areas supported by the key organizational leads who attend leaders a chance to review solutions and raise concerns gating which in turn helps to increase the overall quality of our  The project lead is responsible for solutions preparing for project gates  Gating manifests in physical signoff to indicate approval by the gating committee and project leads PM010 - Gating Questionnaire Portfolio Management Office (PMO) Illustrative • Is the project scope clear, agreed to and achievable? • Is the plan / approach for delivering the project clear and concise? • Is the schedule clearly defined and achievable? Architecture • Is the solution architecture consistent with the scope and objectives of the project? • Is the solution architecture consistent with Yale’s reference architecture standards? • Does the plan include retirement of legacy systems where applicable? Information Security • Does the solution involve sensitive data? • Are there any initial security concerns with the solution? Infrastructure and Production Services • Have the environments needed to support the development effort been identified? • Have all infrastructure requirements been identified? • Does the plan include relevant infrastructure tasks? Deployment • Are the stakeholders identified and engaged? • Are the stakeholders expectations understood and considered? • Does the plan consider necessary training and change management activities? 54
  • 55. Governance Summary  Project vs. portfolio governance  Know who is responsible for what (team, roles, etc) and who can make what decisions  Know how to escalate issues and to get senior level support for the project  Gating Are there any questions on Governance? 55
  • 56. Let‟s look at project management processes. . . Our approach encompasses three areas: Solution and business integration lifecycle (our SDLC) Project governance Project management processes 56
  • 57. Think good project management skills were important for this? I BELIEVE THAT THIS NATION SHOULD COMMIT ITSELF TO ACHIEVING THE GOAL, BEFORE THIS DECADE IS OUT, OF LANDING A MAN ON THE MOON AND RETURNING HIM SAFELY TO EARTH On May 25, 1961, President John F. Kennedy announced before a special joint session of Congress the dramatic and ambitious goal of sending an American to the Moon before the end of the decade ONE SMALL STEP FOR (A) MAN, ONE GIANT LEAP FOR PROJECT MANAGEMENT On July 20, 1969, barely 8 years later, Neil Armstrong became the first man to set foot on the moon. Buzz Aldrin quickly followed, while Mike “Hard Luck” Collins waited patiently in the Command Module in moon‟s orbit This is actually a picture of Buzz Aldrin, not Neil Armstrong, whose 57 famous quote we‟ve destroyed for our own selfish purpose. Do you know why there is not a clearer picture of Armstrong‟s first step?
  • 58. PMBOK, or yet another silly acronym We‟ve already talked about the balancing act that is project management. The good news is that some very smart people (no, not us) have thought a lot about this and have documented (in ridiculous detail) just about everything you need to know about managing projects. This wealth of information is lovingly called the Project Management Body of Knowledge, or PMBOK for short. We will not attempt to reproduce PMBOK or try to make you all PMP certified. But we will attempt to draw your attention to some of the key concepts around PMBOK and how our delivery approach supports them. Even if you are not responsible for project or team management, the tools and techniques within can almost certainly help. The Project Management Institute published the first Guide to Project Management Body of Knowledge (PMBOK) as a white paper in 1987 in an attempt to document and standardize generally accepted project management information and practice PMBOK is an internationally recognized standard that provides the fundamentals of project management as they apply to a wide range 58 of projects (not specific to one industry or type of project) and is published by the Project Management Institute (PMI). PMI offers a PMP (Project Management Professional) certification based on PMBOK. For more information, visit http://www.pmi.org
  • 59. Project management knowledge areas PMBOK thinks of the world in terms of “project management processes” and “project management knowledge areas”. For our purposes, we will focus on the following:  Change control  Issue and decision management  Scope management  Schedule management  Cost management  Quality management  Resource management  Communications management  Risk management  Vendor management 59

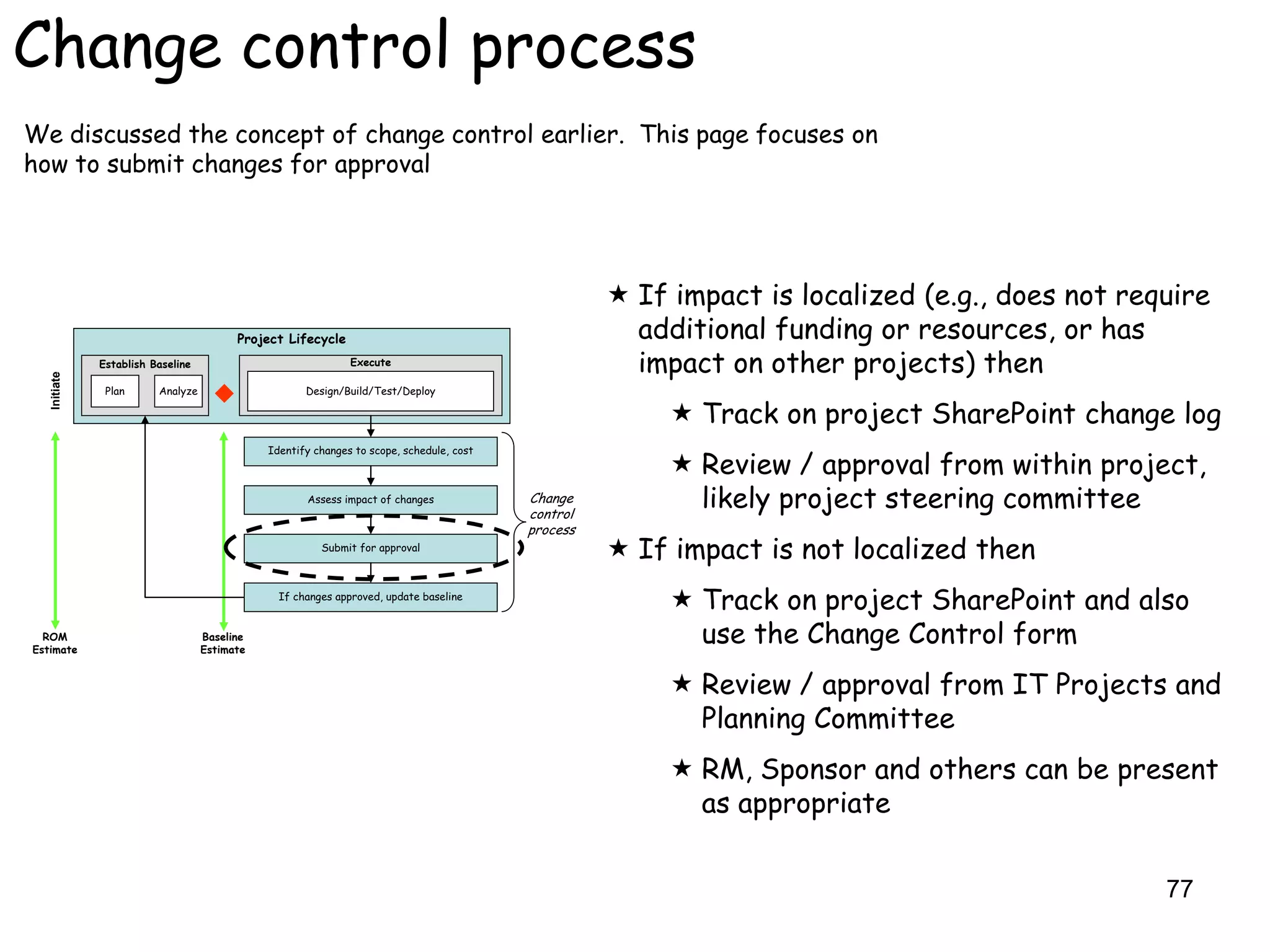

  • 60. Change control – how far is it from here I‟M DOUG. NICE TO MEET YOU. WHOA, HAVE YOU LOST to there if I don‟t know where here is? WEIGHT?? Scope creep. Schedule slip. Cost overruns. Each can kill a project. But how do you know your scope is creeping if you haven‟t agreed to what it should be? The concept of change control starts with the idea of setting a baseline. The baseline forms a common understanding and agreement of what will be built (scope), when it will be delivered (schedule) and how much it will cost. The sponsor, RM and project lead must all agree to the baseline. Once agreement is reached, material changes must follow a formal change control process. Project Lifecycle  Before planning starts, a rough order of magnitude (ROM) estimate for scope, Establish Baseline Execute schedule and cost are established Initiate Plan Analyze Design/Build/Test/Deploy  The ROM estimate is a “best guess” and is not yet based on a firm definition of scope & requirements Identify changes to scope, schedule, cost  At the end of the analyze phase, scope, schedule and cost are baselined Assess impact of changes Change control  The baseline estimate is more than a best process guess – it is based on a detailed Submit for approval understanding of scope, requirements, the target solution and the plan to get If changes approved, update baseline there  Once the baseline is set, changes must ROM Baseline follow a change control process 60 Estimate Estimate
  • 61. Issue and decision management, recognizing and removing barriers Someone once said “difficult times make great leaders”, . . . or “difficult leaders make great times”, . . . or something like that. The point is, projects often face difficult times. Barriers to progress should be expected. The best projects know how to remove barriers or how to find creative ways around or through them.  Actively identify and aggressively manage issues and decisions  Establish and manage an issue / decision log  Make sure all team members know how to escalate  Communicate resolutions to those who need to know  Document resolutions so that you will remember what was decided (or so that you don‟t need to keep resolving the same issues over and over again)  Make it clear who is responsible for resolving each issue and decision, when a resolution is needed, and the impact of not resolving  Involve steering committee early 61
  • 62. Scope management Scope management is a core principle for a successful project, but is often done poorly because it is harder to measure than schedule and cost. A successful Sponsor and Project Lead will find effective ways to document and communicate scope so that all team members and stakeholders are clear on what to expect AFTER MEETING WITH HIS CLIENT, JIM WAS SURE HE UNDERSTOOD THE SCOPE OF THE PROJECT  Establish a baseline  Consider not only what is in scope, but what is out of scope  Write it down and get signoff  Document assumptions  Consider all areas that may represent work for the team, not just the functional scope. For example, are there legacy systems that should be retired because of this project?  Gain agreement on who can make scope decisions  Understand the relative priority of each scope item 62
  • 63. Schedule management  Establish a baseline  Start with the end in mind (define target state and get agreement from sponsor and stakeholders)  Break large projects into phases  Don‟t reinvent – look for packages or other working systems before starting to build from scratch  Document assumptions  Build schedule with involvement from the folks that will lead and do the work  Understand dependencies (both within the project, and external to the project)  Understand critical path  Build in contingency plans 63
  • 64. Cost management Unless you are literally rolling in money (we‟re looking at you, Scrooge McDuck) most projects operate within a budget.  Establish a baseline  Document assumptions  Consider all costs – people, hardware, software, training, facilities, supplies, etc  Understand who can make cost decisions  Be clear as to whom is responsible for managing which costs  Regularly review project financials, including planned vs. actual, estimate to complete and projected variance 64
  • 65. Quality management Which car is higher quality? It depends on what the requirements were. If the nice little electric car meets its planned requirements, but the ridiculously fast Bugatti Veyron does not meet the requirements for which it was intended (fuel efficiency, perhaps?) then the electric car is of higher quality. When it comes to projects, quality is not defined as “make it the best”. Quality is defined as meeting requirements. Simple as that. There is no extra credit for exceeding requirements. Sure, it would be nice if the shiny battery powered vehicle could top 250mph, but that is not what the Sponsor of this car has asked for, or agreed to pay for.  Follow proven methodology (duh!)  Active participation from sponsor and stakeholders  Define in advance what success looks like  Project gating and phase end reviews (which help to encourage phase containment to catch small problems before they become big)  Be able to link requirements to testing 65
  • 66. Resource management I NEED FRANKLY MY DEAR, RESOURCES I HOPE YOU HAVE FOR MY COMPLETED A PROJECT RESOURCE PLAN If you are on a project that only requires one resource, then our approach probably doesn‟t apply to you. However, a project of size or complexity will require involvement from multiple people to play multiple roles. Identifying the roles and the people to fill them, as well as establishing a “team feel” is an important part for any successful project.  Keep resource plans up to date  Co-locate teams whenever possible  Build and foster team spirit  Cross train team members  Stretch team members with challenging assignments and the opportunity to learn new things  Consider the training required and train the team together whenever possible  Consider all resources needed, including functional, subject matter expert (SME), testing, desktop technologists, including those who are part time.  Gain agreement in advance from resource managers that the folks you need will be available when you need them to be available  And be sure to plan for non-people resources, like development and test environments 66
  • 67. Communications & stakeholder management OH, NOTHING. JUST WANTED TO DID YOU SAY MENTION THAT Have you ever been impacted by a change, but were not told about SOMETHING? WALL COMING UP it or involved in advance? We have all probably experienced this in some fashion, and it usually doesn‟t feel very good. Successful projects understand who the stakeholders are, what information they want, and how and when to get it to them. Project Stakeholders Steering Steering Committee Committee Senior Senior Clients & Users Clients & Users Management Management Academic & Academic & Interdependent Interdependent Project Project Business Units Business Units Projects Projects Information Information Outside Groups Outside Groups Technology Technology (e.g., vendors, etc) (e.g., vendors, etc) Team Members Team Members  Establish communications plan COULD BETTER COMMUNICATION PREVENTED THIS  Identify and engage all stakeholders CRASH?  Understand the impact the project can have on the stakeholders and the impact they can have on the project  Don‟t make promises that cannot be fulfilled  Focus groups, demos, pilots, town halls  Special communications from the Sponsor  Articles, web pages, newsletters A stakeholder is anyone who is impacted by, or who 67 can impact, the project  Listen, listen, listen
  • 68. But even with perfect communication . . . Homer reacts to the news that Springfield is being split into two area codes DON‟T FORGET THE WHAT DO YOU MEAN? LEAFLETS THEY WHAT REALLY BURNS ME THEY RAN THOSE TV DROPPED FROM THE UP IS THEY DIDN‟T GIVE NOT A SINGLE WORD OF COMMERCIALS ABOUT SPACE SHUTTLE, AND US ONE WORD OF WARNING . . . IT, AND THAT BIG THE TWO WEEKS WE WARNING RADIO CAMPAIGN ALL SPENT AT AREA CODE CAMP . . . we cannot always guarantee the message will be heard 68
  • 69. Risk management YOUR VENDOR WILL DELIVER LATE . . . BUT, YOU WILL BE LUCKY IN LOVE No, you don‟t need to be a fortune teller to deliver a successful project, but it does help to be able to predict the inevitable “gotchya‟s” that can derail any project. Risks are simply things that haven‟t yet occurred, but may impact the project if they do. Successful projects are able to identify risks, assess potential impacts, and take mitigation steps in advance.  Involve the whole project team, including stakeholders, in risk identification and mitigation  Develop and actively manage a risk plan  Make the risks and mitigations plans known, and enlist help when needed  Assign responsibilities to mitigate risks  Be on the lookout for new, and realized, risks for the life of the project As Poor Richard told us long ago, an ounce of prevention is worth a pound of cure 69
  • 70. Vendor management Sometimes we work with a vendor because they sold us the product, other times we need help or skills that we don‟t have available, and other times we just want someone else to blame when things go wrong (oops, did we say that one out loud?). Regardless of the reason for hiring a 3rd party to assist, it is helpful to keep in mind some basic best practices.  Plan early for knowledge transfer  Form partnership – become one team with one goal and one plan  Have vendor help to organize the team and plan  Follow the same methodology  Co-locate  Understand and influence the contract  Legal review of the contract  Tie payments to acceptance when possible  Look at fixed fee, but understand what it means to manage fixed fee work  Have single point of contact  Caveat emptor! 70
  • 71. Project Management Processes Summary  PMBOK is an excellent source for project management training and best practices  Good project management techniques can make things easier. Really.  The delivery approach has been built with the best practices for project management in mind Are there any questions on Project Management Processes? 71
  • 72. Case study #2 Refer to case study #2 handout 72

  • 73. Odds and Ends PMO SharePoint Project SharePoint Status reporting Change controls Gating tracker 73
  • 74. PMO SharePoint The PMO sharepoint is your one-stop-shop for information regarding the delivery approach and management of the overall portfolio of projects being delivered. It is located at https://projects.yale.edu  Templates and sample deliverables  Gating calendar  Location for placing project status reports  Delivery approach placemat  Helpful project management links  Links to portfolio project SharePoint sites  Link to portfolio archive site  And more! 74
  • 75. Project SharePoint Sites Each project has it‟s own SharePoint site. The site is created by the PMO and can then be administered and tailored by the project. At the close of the project, the projects deliverables are posted to the project team archive site, and the project site is shut down. Each site starts with:  Location for project documents  Change log  Decision log  Issue log  Risk log  Task log  Team discussion  Place to record project lead roles  Links to deliverable templates the project will use  Other useful links 75
  • 76. Status Reporting and Project Reviews Projects create a status report each week that helps to articulate the overall status, remaining work, and barriers to progress.  Status is due by end of day each Thursday  Posted to the PMO SharePoint  Project leads report on the milestones, issues and risks and provide graphics that are most relevant to their project and their stakeholders  Friday the PMO consolidates and reviews the status reports  Monday the IT Projects and Planning Committee reviews the reports and acts on any prioritization issues, cross project dependencies, or change orders  The PMO may schedule project reviews with teams that require assistance during the week Mon Tues Wed Thurs Fri IT Projects Project Project Project Status and Planning Reviews Reviews Status Due Reviewed Committee 76
