Evolving	#NoProjects	->	Con5nuous
Allan	Kelly	-	@allankellynet
allan@allankelly.net
Planning	for	Value
How	much?	When?
Agile on the Beach
July 2017
relax
Is	this	project	right	for	Agile?
Or	is	Waterfall	be>er	here?
Is	this	project	right	for	Kanban?
Or	is	Scrum	be>er	here?
Who	cares	about
right?
Which	will	make	more
money?
Agile	makes	more	$	£	€	because	it
delivers	something	sooner
Today’s	Lesson	#1
A	li>le	bit	Soon
is
Worth	more	than	a	lot
delivered	Later

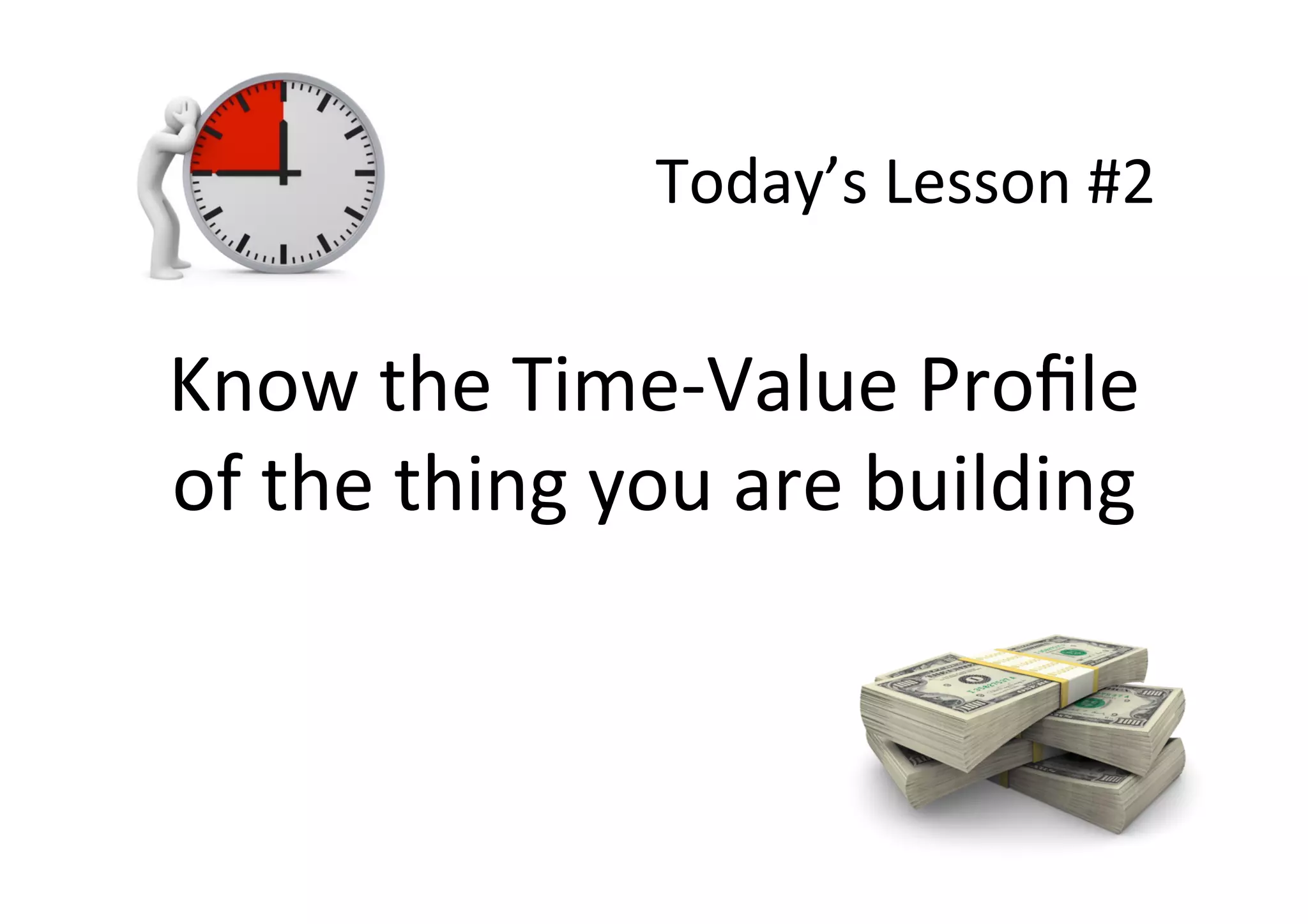

Today’s	Lesson	#2
Know	the	Time-Value	Profile
of	the	thing	you	are	building
Today’s	Lesson	#3
Deadlines	are	elasSc	by
value

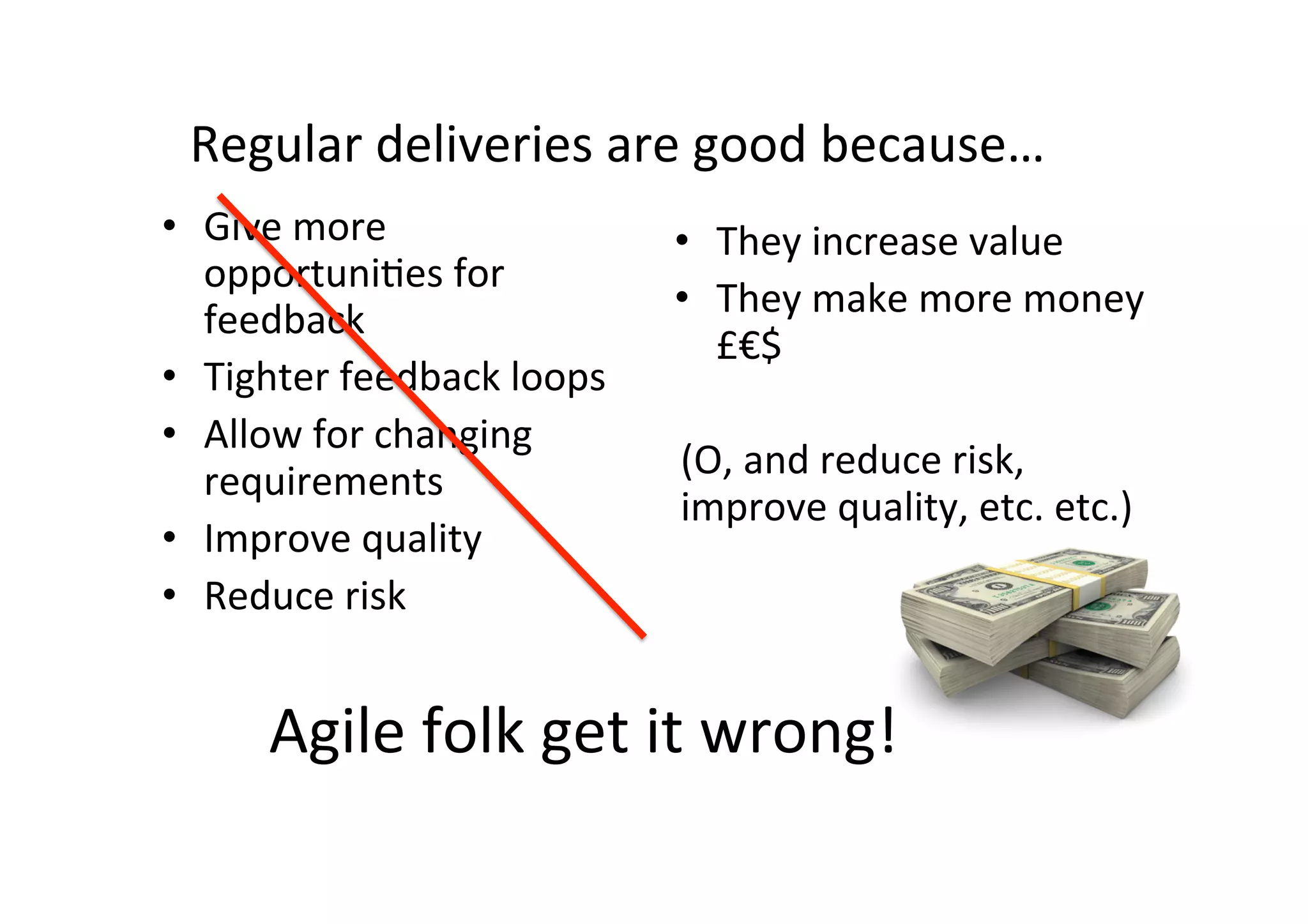

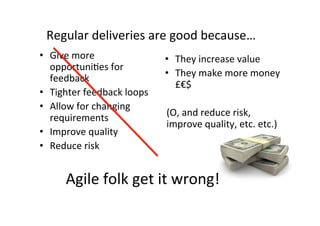

Agile	folk	get	it	wrong!
•  Give	more
opportuniSes	for
feedback
•  Tighter	feedback	loops
•  Allow	for	changing
requirements
•  Improve	quality
•  Reduce	risk
•  They	increase	value
•  They	make	more	money
£€$

(O,	and	reduce	risk,
improve	quality,	etc.	etc.)
Regular	deliveries	are	good	because…

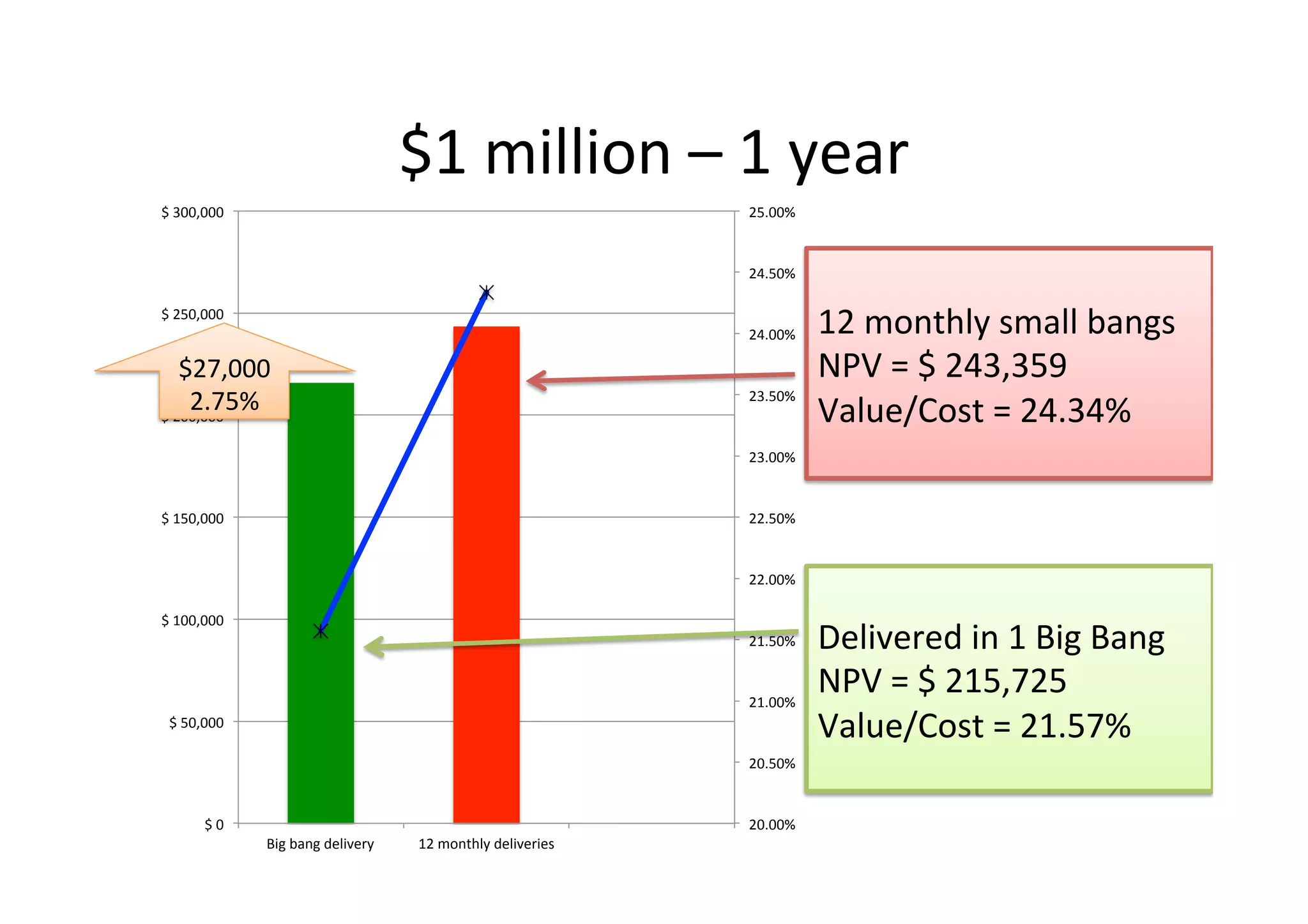

20.00%
20.50%
21.00%
21.50%
22.00%
22.50%
23.00%
23.50%
24.00%
24.50%
25.00%
$	0
$	50,000
$	100,000
$	150,000
$	200,000
$	250,000
$	300,000
Big	bang	delivery	 12	monthly	deliveries
Delivered	in	1	Big	Bang
NPV	=	$	215,725
Value/Cost	=	21.57%
12	monthly	small	bangs
NPV	=	$	243,359
Value/Cost	=	24.34%

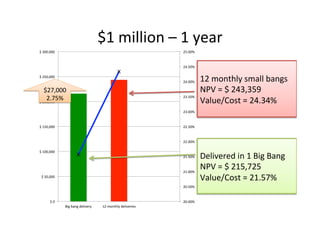

$27,000
2.75%
$1	million	–	1	year

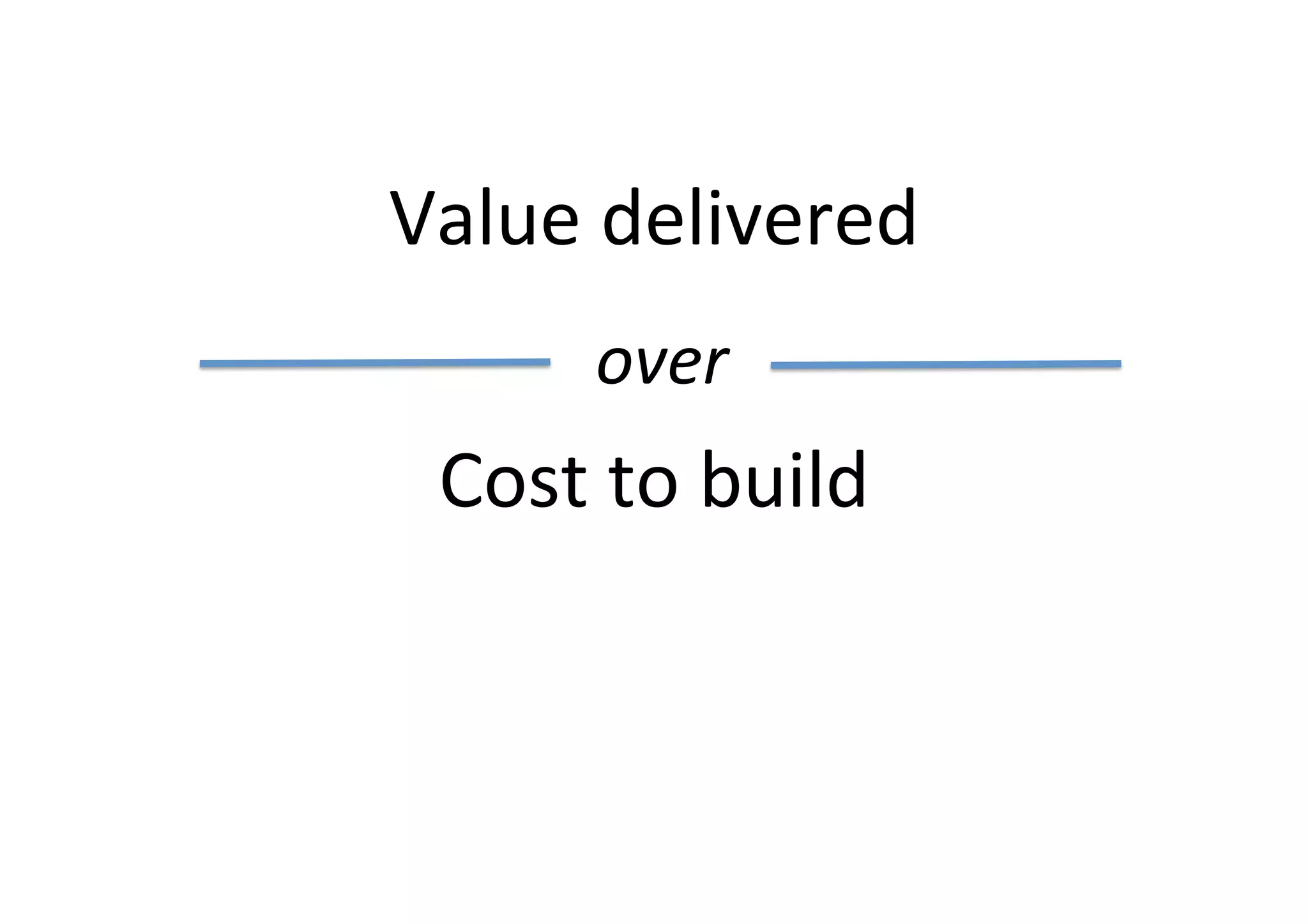

Value	delivered
Cost	to	build
over

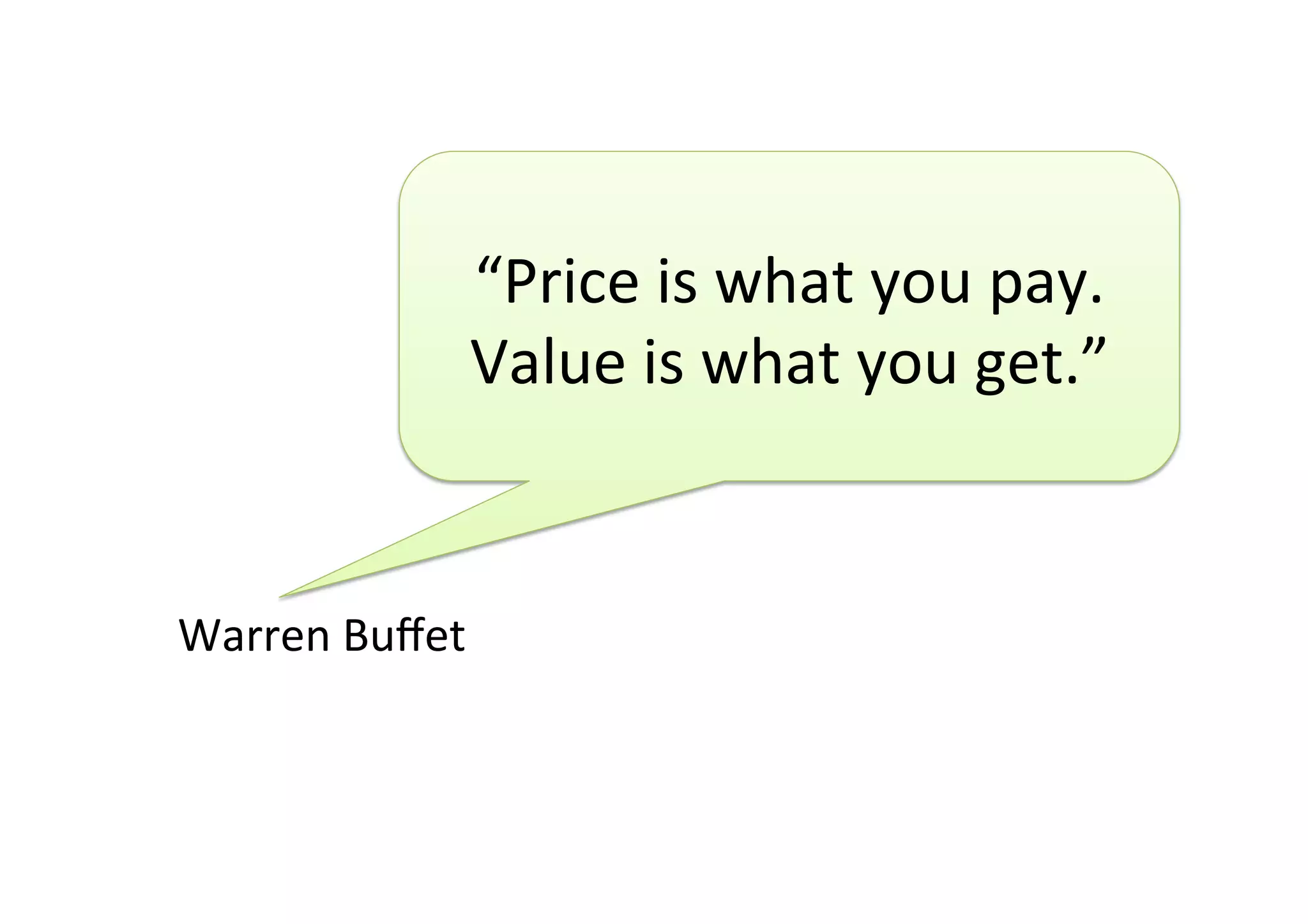

“Price	is	what	you	pay.
Value	is	what	you	get.”
Warren	Buffet

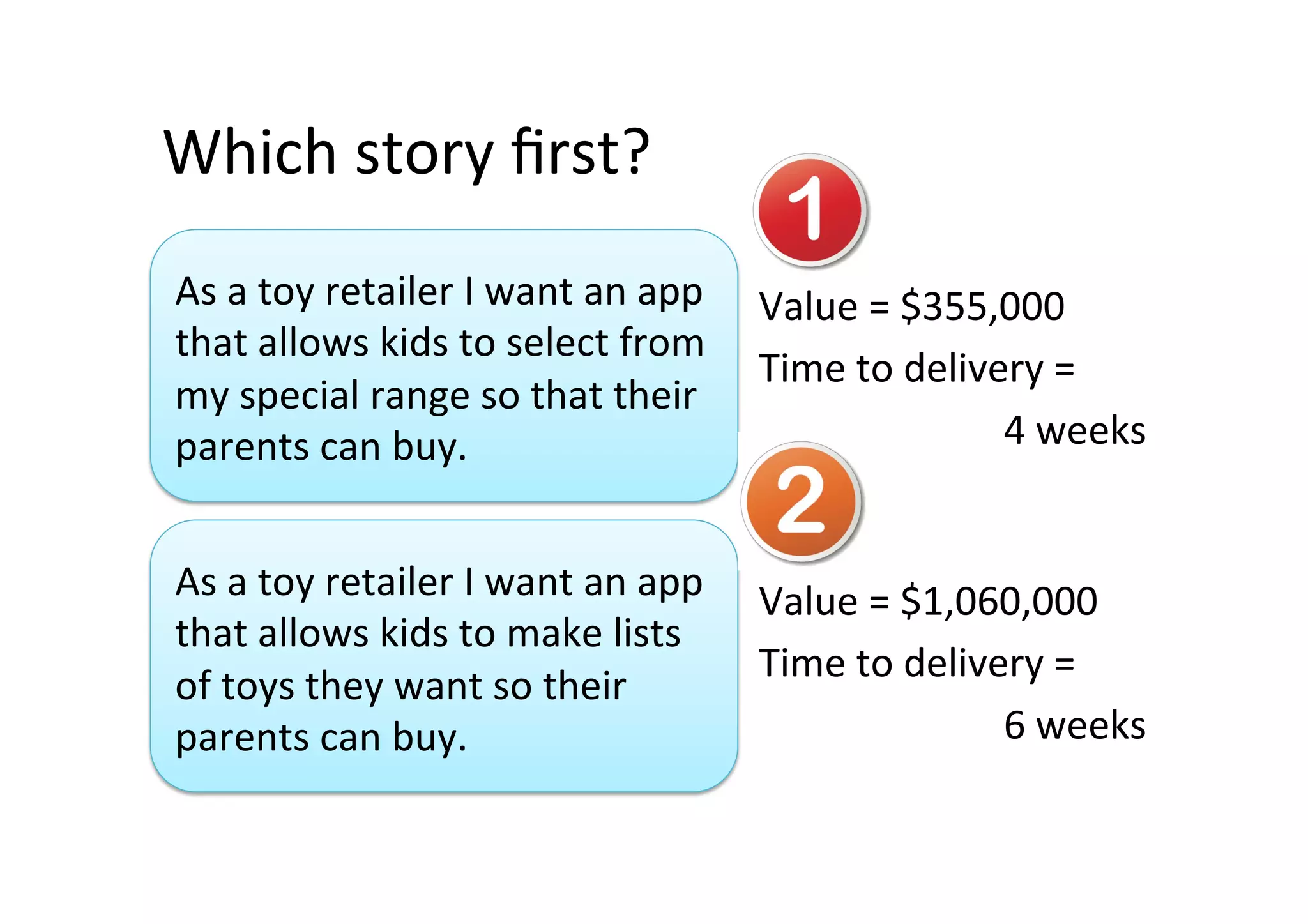

Which	story	first?
Value	=	$355,000
Time	to	delivery	=
4	weeks
Value	=	$1,060,000
Time	to	delivery	=
6	weeks
As	a	toy	retailer	I	want	an	app
that	allows	kids	to	select	from
my	special	range	so	that	their
parents	can	buy.
As	a	toy	retailer	I	want	an	app
that	allows	kids	to	make	lists
of	toys	they	want	so	their
parents	can	buy.

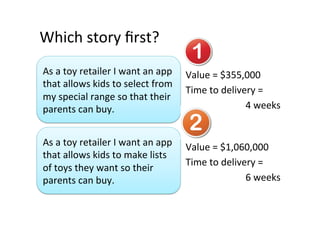

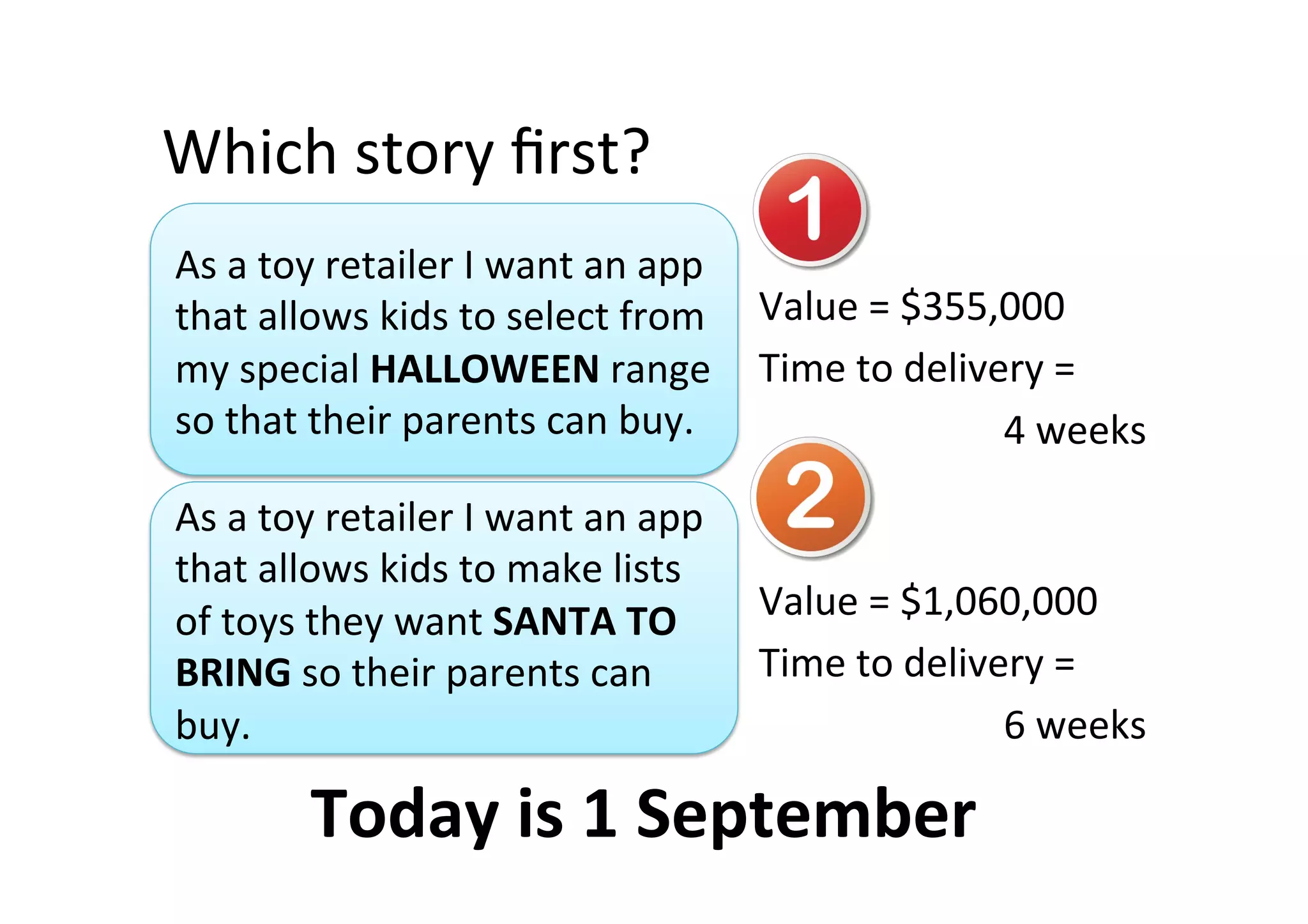

Which	story	first?
Value	=	$355,000
Time	to	delivery	=
4	weeks
Value	=	$1,060,000
Time	to	delivery	=
6	weeks
As	a	toy	retailer	I	want	an	app
that	allows	kids	to	select	from
my	special	HALLOWEEN	range
so	that	their	parents	can	buy.
As	a	toy	retailer	I	want	an	app
that	allows	kids	to	make	lists
of	toys	they	want	SANTA	TO
BRING	so	their	parents	can
buy.

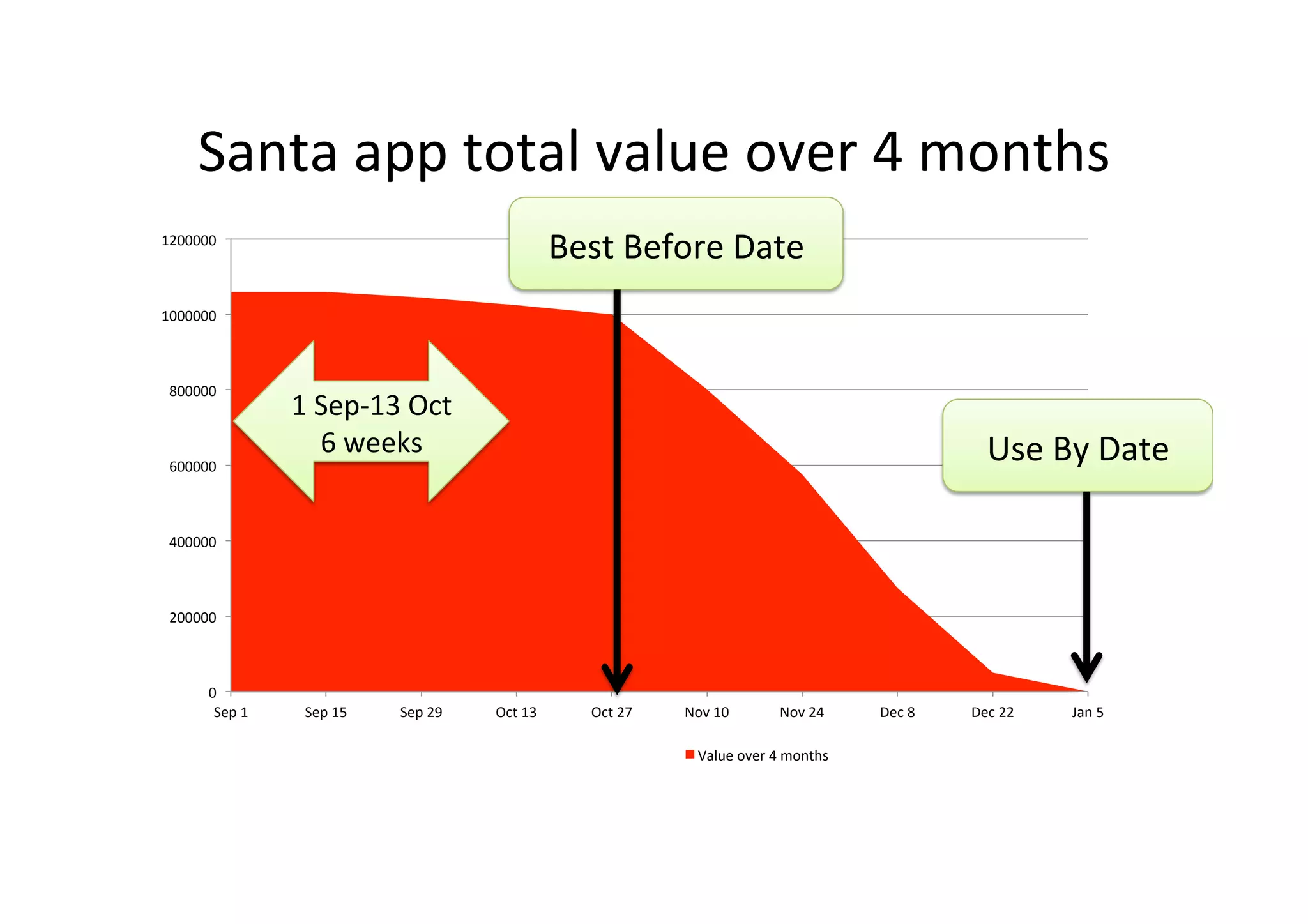

Today	is	1	September

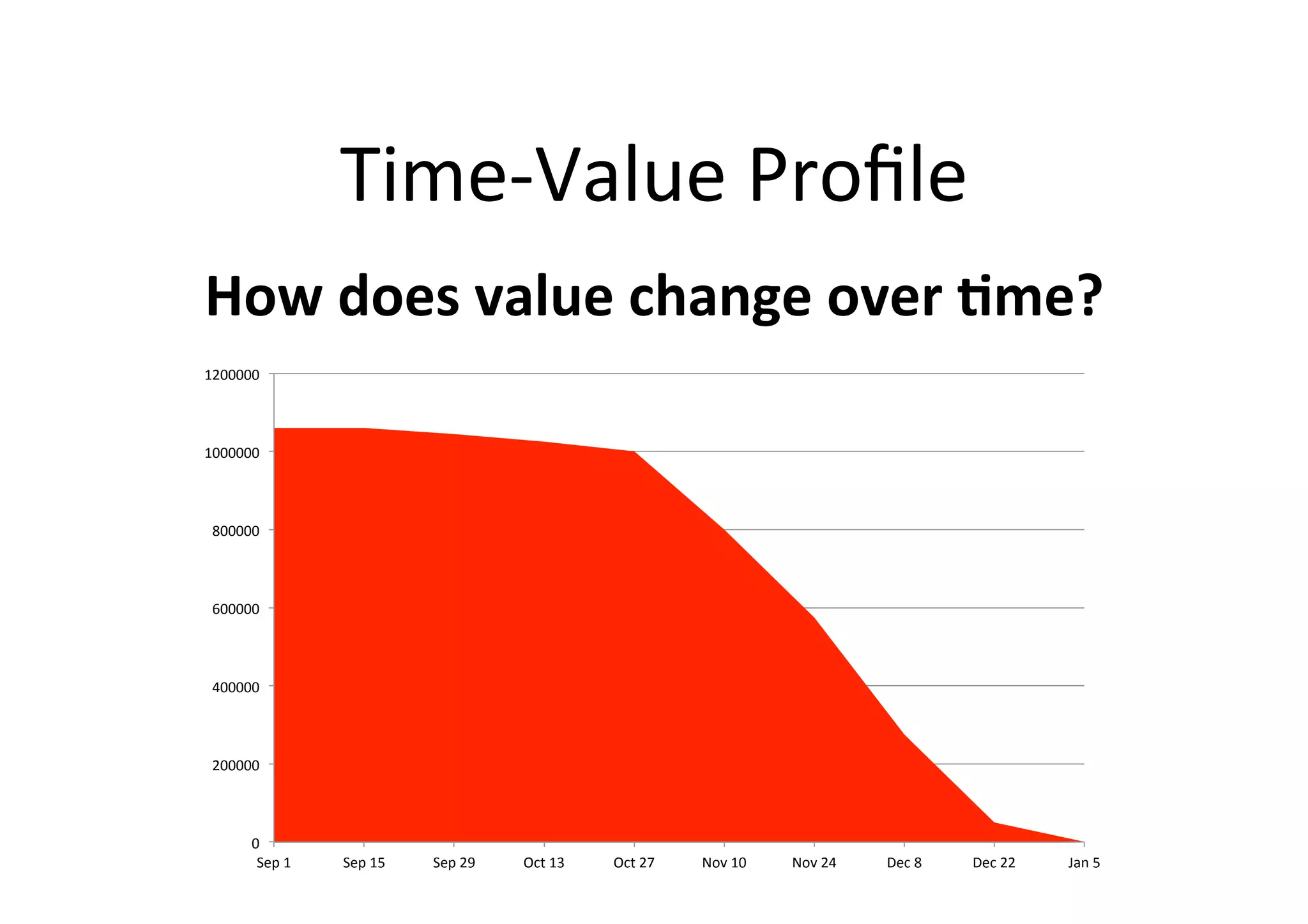

Time-Value	Profile

How	does	value	change	over	Ime?
0
200000
400000
600000
800000
1000000
1200000
Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5
0
200000
400000
600000
800000
1000000
1200000
Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5
Value	over	4	months
Santa	app	total	value	over	4	months
Delivery	date
Total	value	for	a
given	date
Total	value	starts	to	fall
aner	15	September
To	maximize	value
deliver	by	15	Sep	1	Sep-13	Oct
6	weeks
0
200000
400000
600000
800000
1000000
1200000
Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5
Value	over	4	months
Santa	app	total	value	over	4	months
1	Sep-13	Oct
6	weeks	 Use	By	Date
Best	Before	Date
0
50000
100000
150000
200000
250000
300000
350000
400000

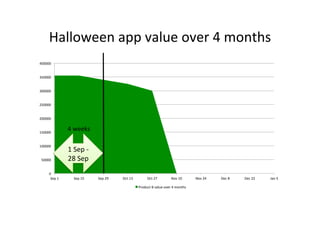

Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5

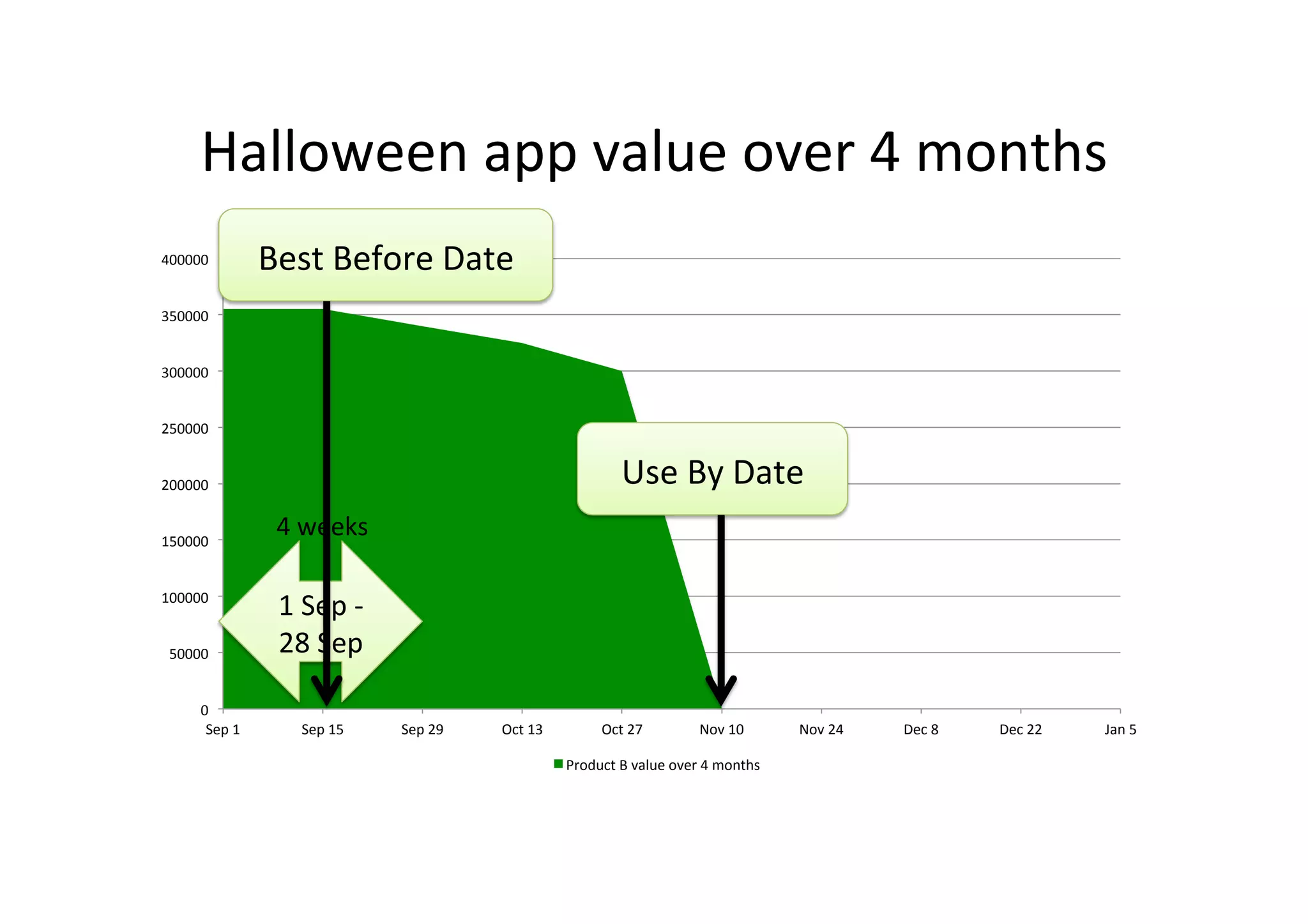

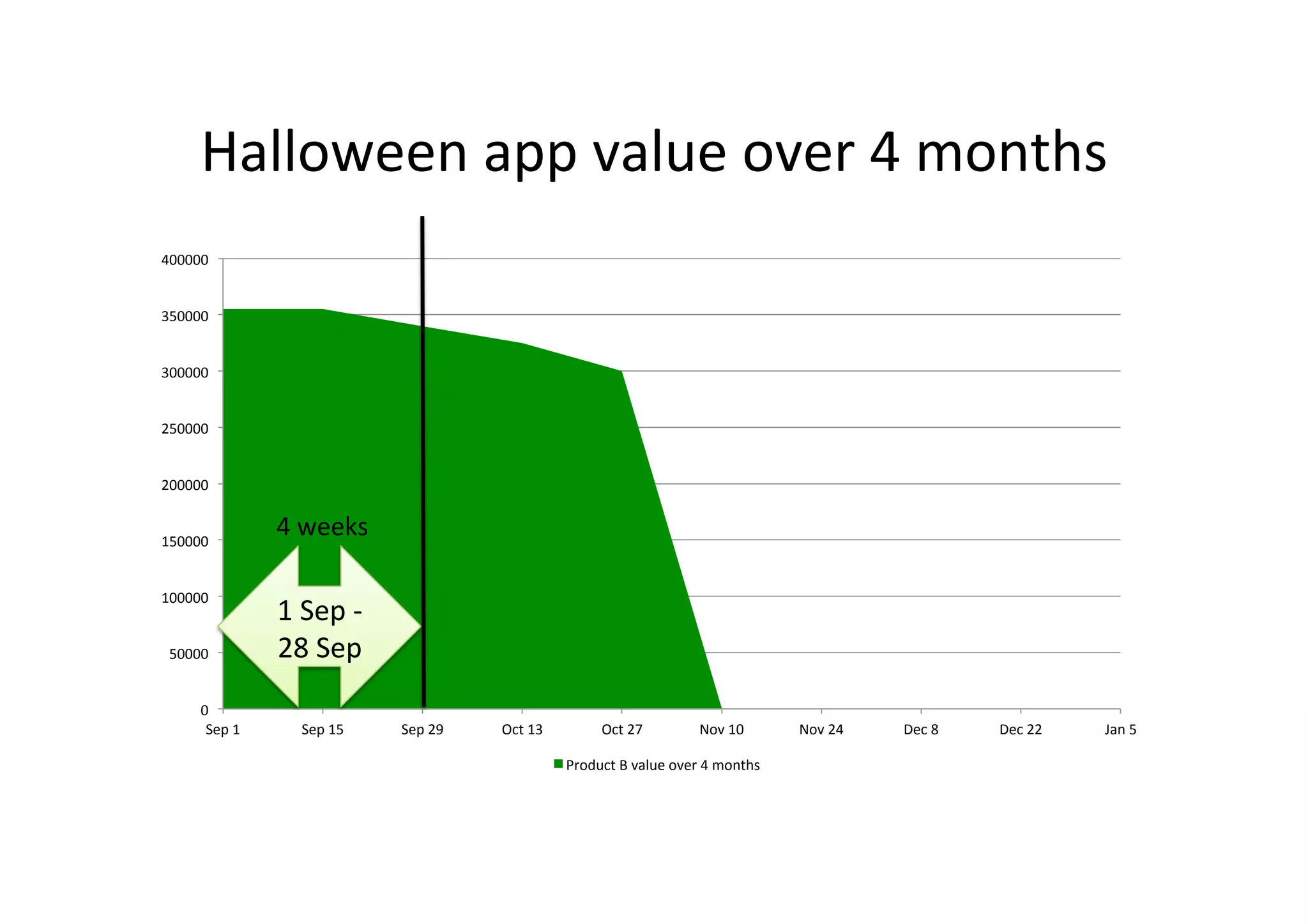

Product	B	value	over	4	months
Halloween	app	value	over	4	months
1	Sep	-
28	Sep
4	weeks
0
50000
100000
150000
200000
250000
300000
350000
400000
Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5
Product	B	value	over	4	months
Halloween	app	value	over	4	months
1	Sep	-
28	Sep
4	weeks
Use	By	Date
Best	Before	Date

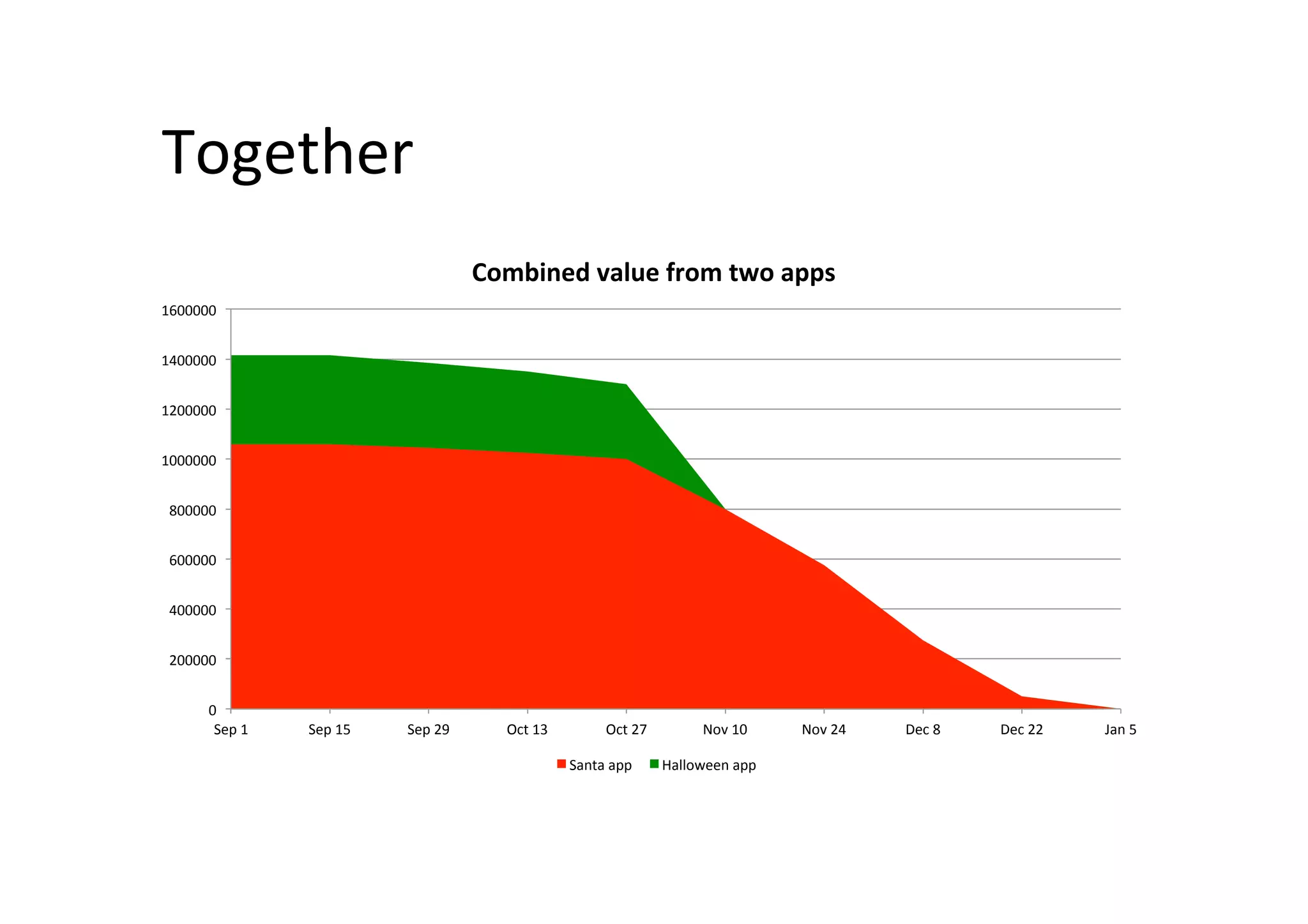

Together
0
200000
400000
600000
800000
1000000
1200000
1400000
1600000
Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5
Combined	value	from	two	apps
Santa	app	 Halloween	app
What	do	you	want	to	do?
A.  Do	Halloween	&	then	Santa
B.  Do	Santa	&	then	Halloween
C.  Do	Halloween	&	forget	Santa
D.  Do	Santa	&	forget	Halloween
E.  Change	the	esSmates
F.  Do	both	and	pray
G.  Add	more	people

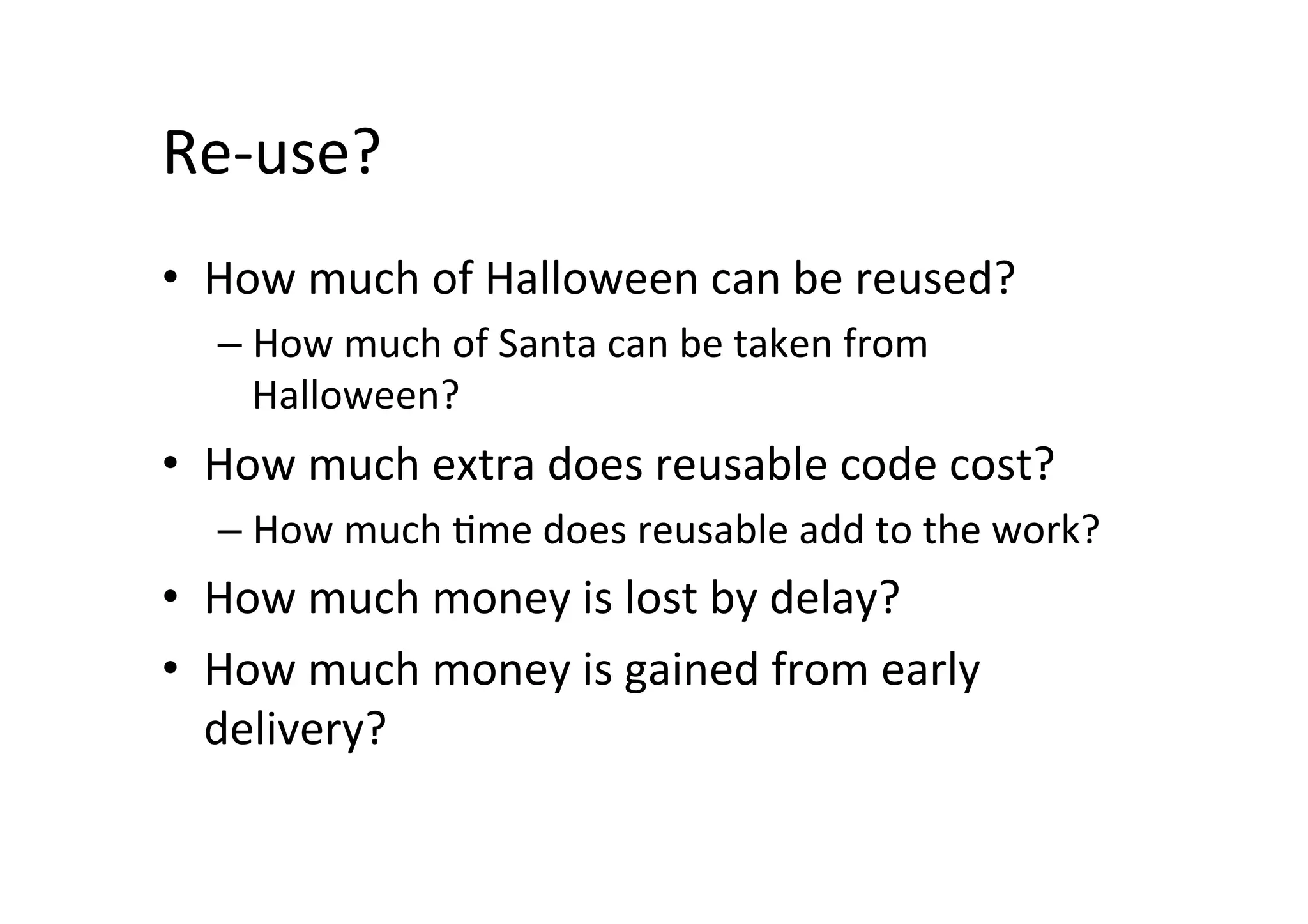

Re-use?
•  How	much	of	Halloween	can	be	reused?
– How	much	of	Santa	can	be	taken	from
Halloween?
•  How	much	extra	does	reusable	code	cost?
– How	much	Sme	does	reusable	add	to	the	work?
•  How	much	money	is	lost	by	delay?
•  How	much	money	is	gained	from	early
delivery?

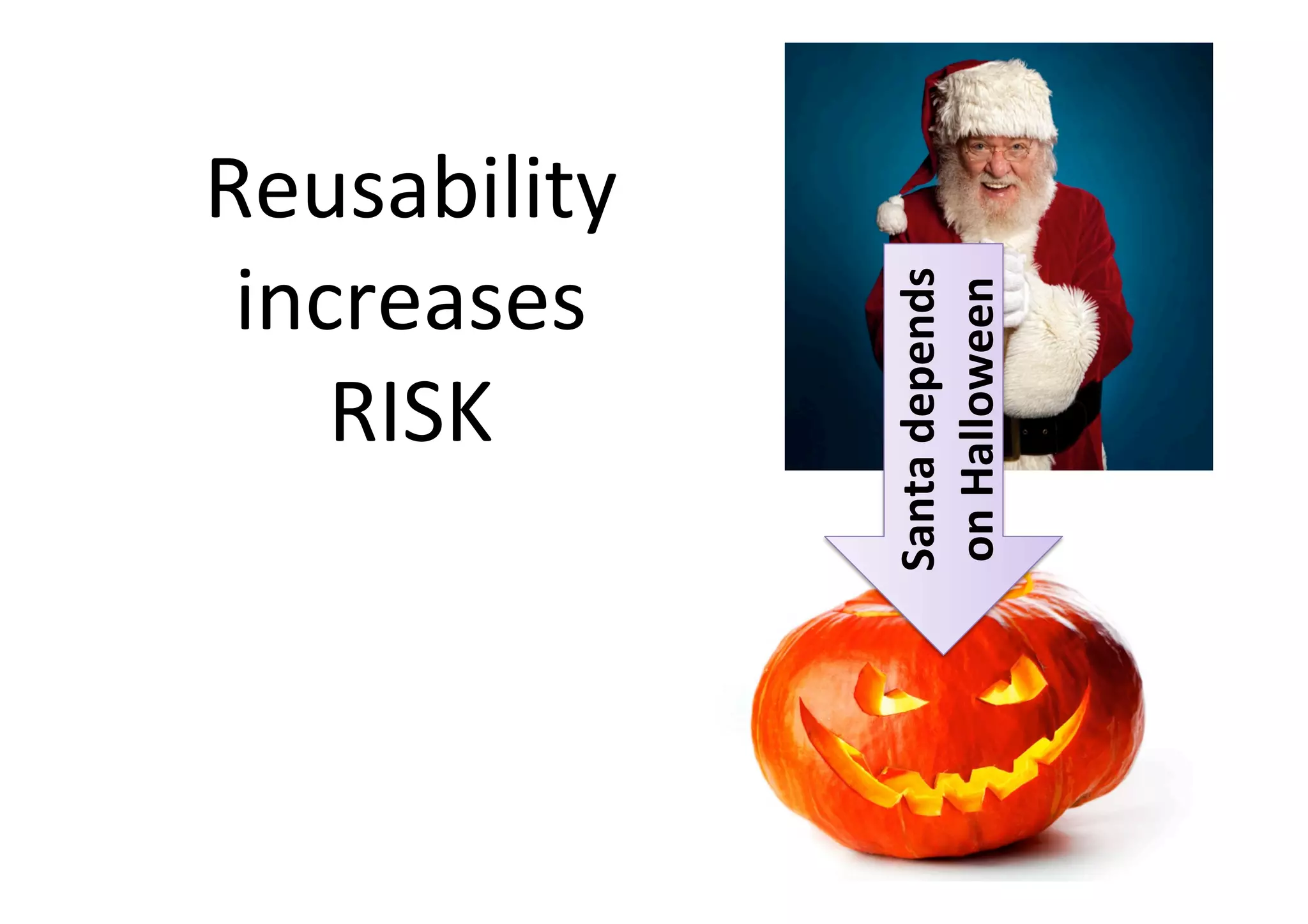

Reusability
increases
RISK
Santa	depends
on	Halloween

What	do	you	want	to	do?
A.  Do	Halloween	&	forget	Santa
B.  Do	Santa	&	forget	Halloween
C.  Do	Halloween	&	then	Santa
D.  Do	Santa	&	then	Halloween
E.  Change	the	esSmates
F.  Do	both	and	pray
G.  Add	more	people
H.  Reuse

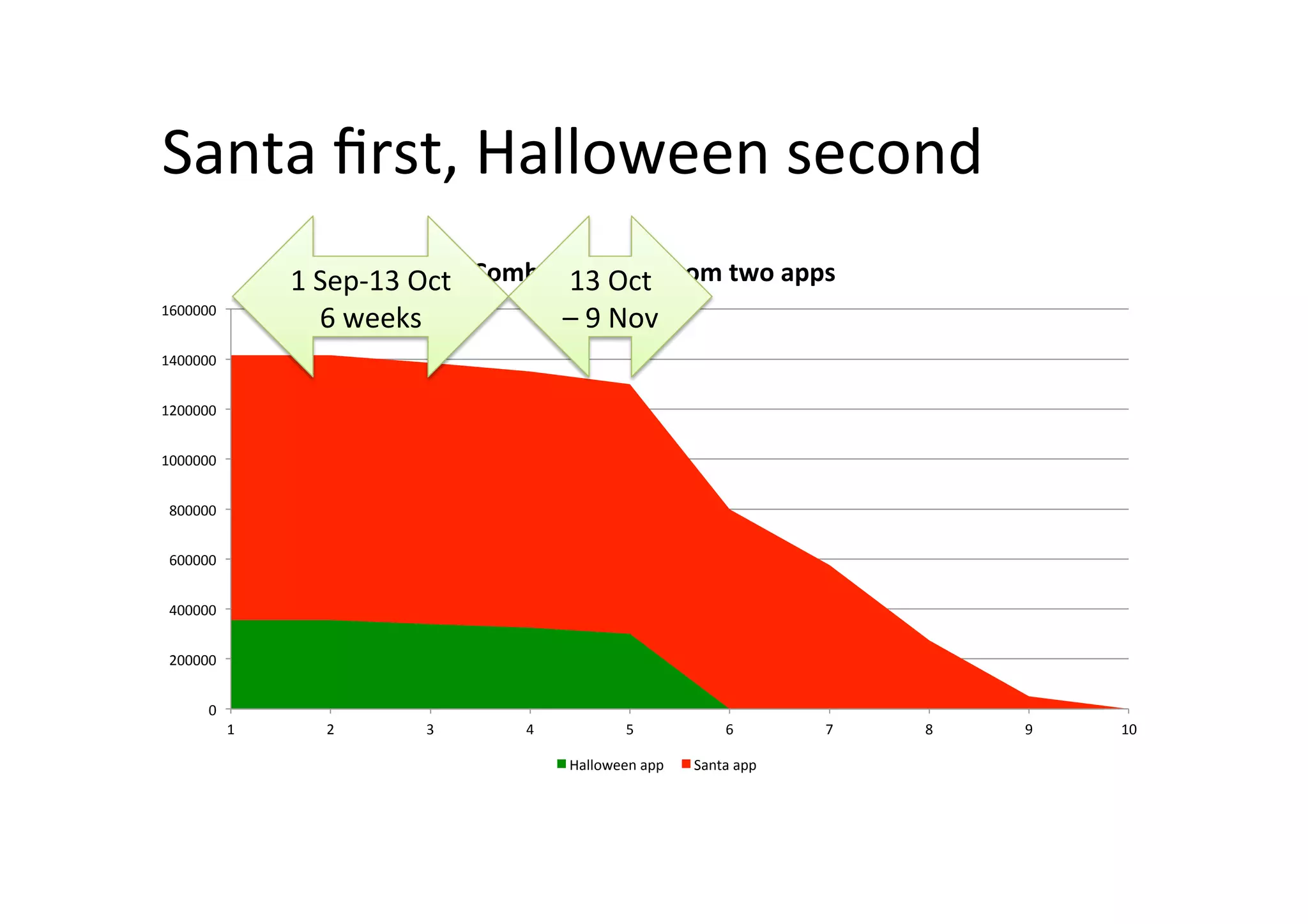

Santa	first,	Halloween	second
0
200000
400000
600000
800000
1000000
1200000
1400000
1600000

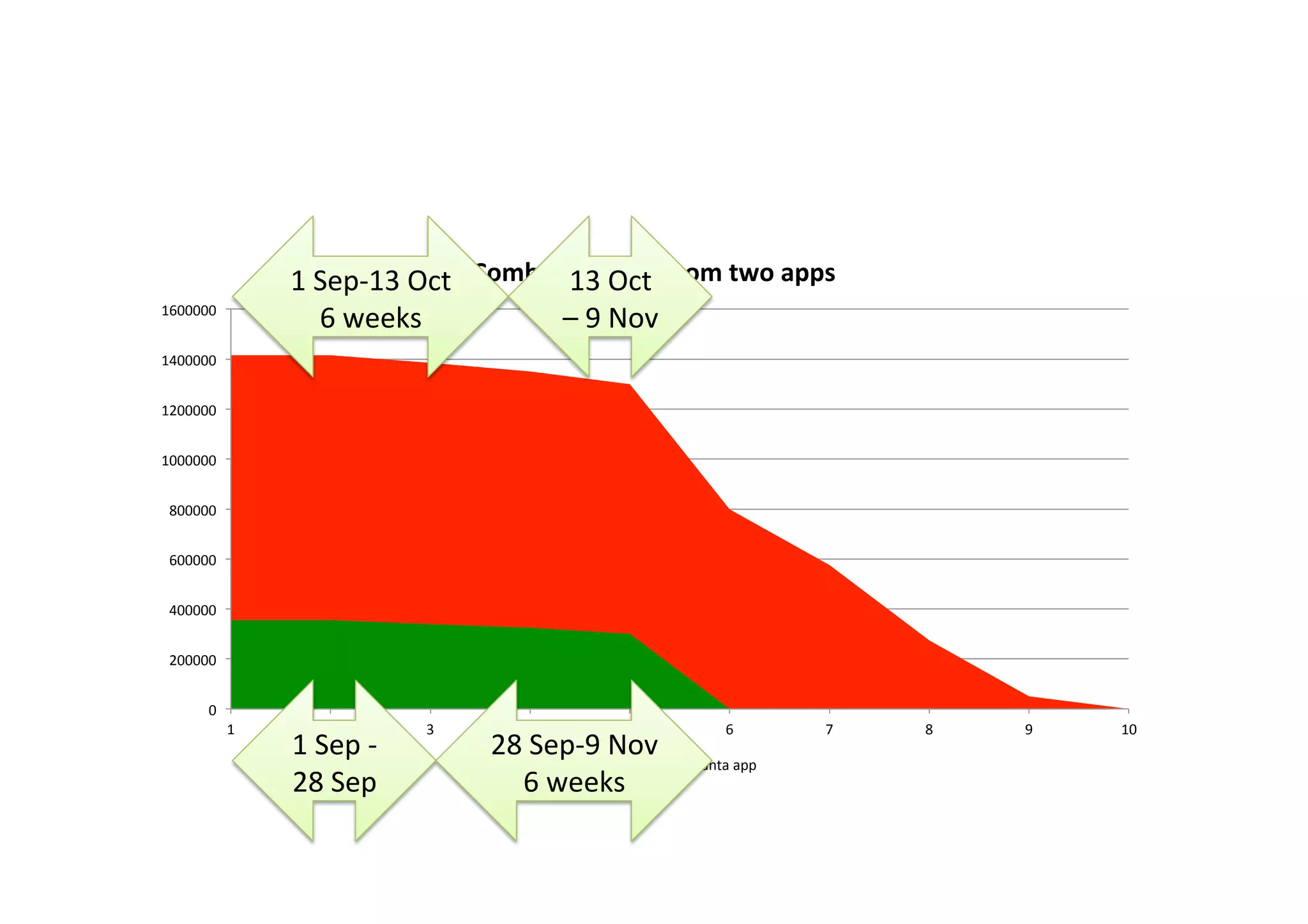

1	 2	 3	 4	 5	 6	 7	 8	 9	 10
Combined	value	from	two	apps
Halloween	app	 Santa	app
1	Sep-13	Oct
6	weeks
13	Oct
–	9	Nov

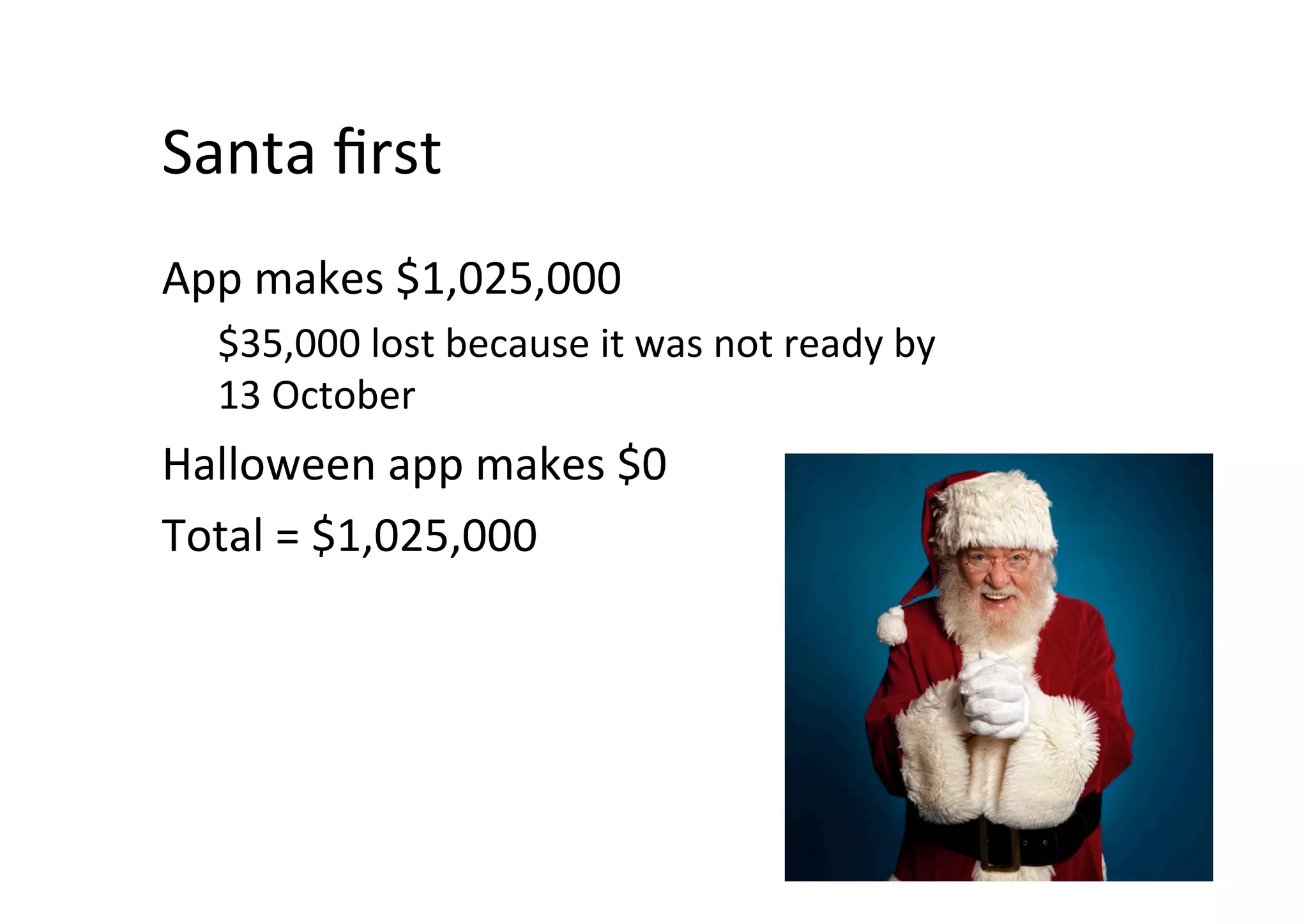

Santa	first
App	makes	$1,025,000
$35,000	lost	because	it	was	not	ready	by
13	October
Halloween	app	makes	$0
Total	=	$1,025,000

0
200000
400000
600000
800000
1000000
1200000
1400000
1600000
1	 2	 3	 4	 5	 6	 7	 8	 9	 10
Combined	value	from	two	apps
Halloween	app	 Santa	app
1	Sep	-
28	Sep
1	Sep-13	Oct
6	weeks
28	Sep-9	Nov
6	weeks
13	Oct
–	9	Nov
Halloween	makes	$340,000
$15,000	lost	because	not	ready
before	29	September
Santa	makes	$800,000
$225,000	lost	because	it	is	not	ready
unSl	10	November

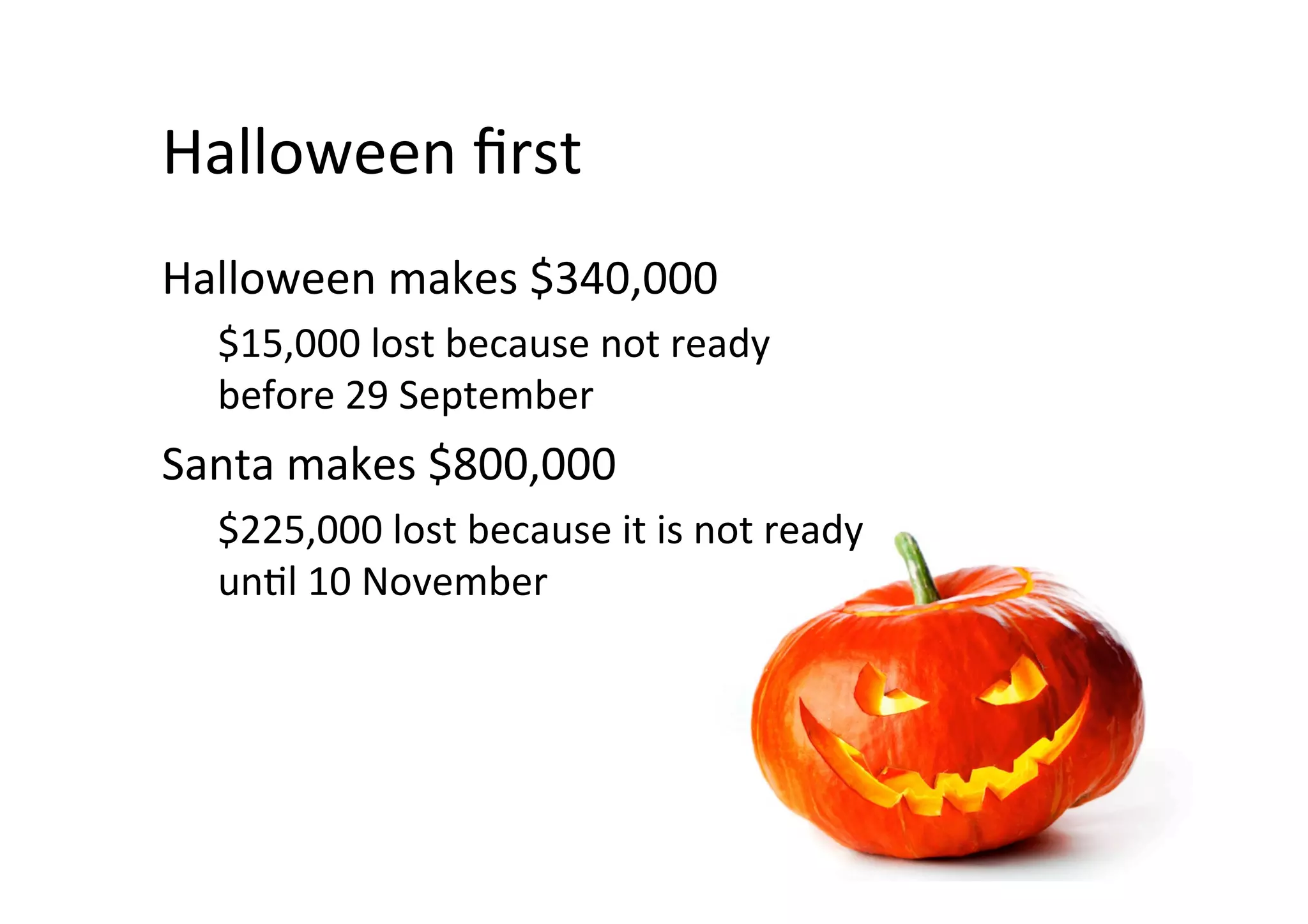

Halloween	first

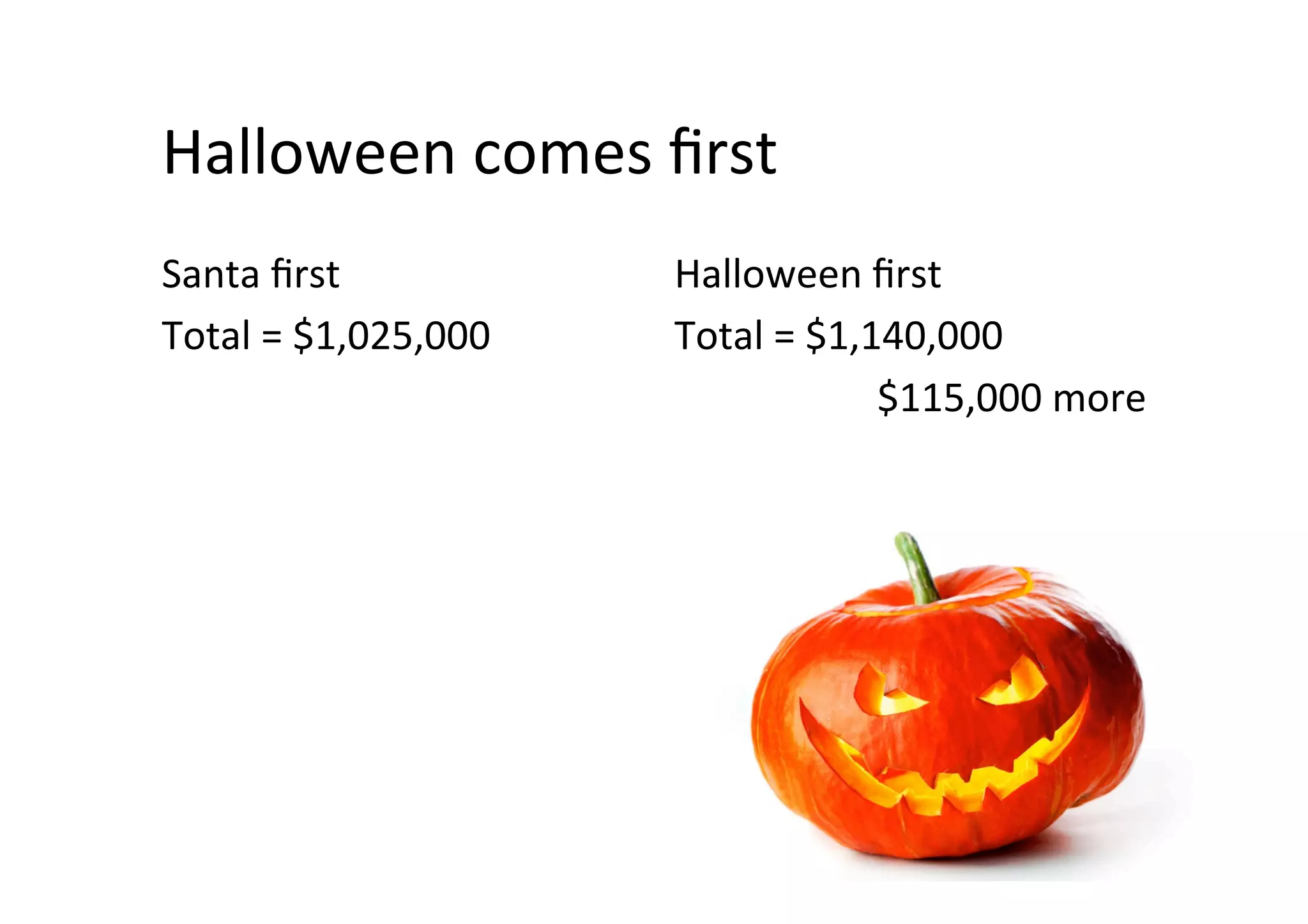

Halloween	comes	first
Santa	first
Total	=	$1,025,000
Halloween	first
Total	=	$1,140,000
$115,000	more

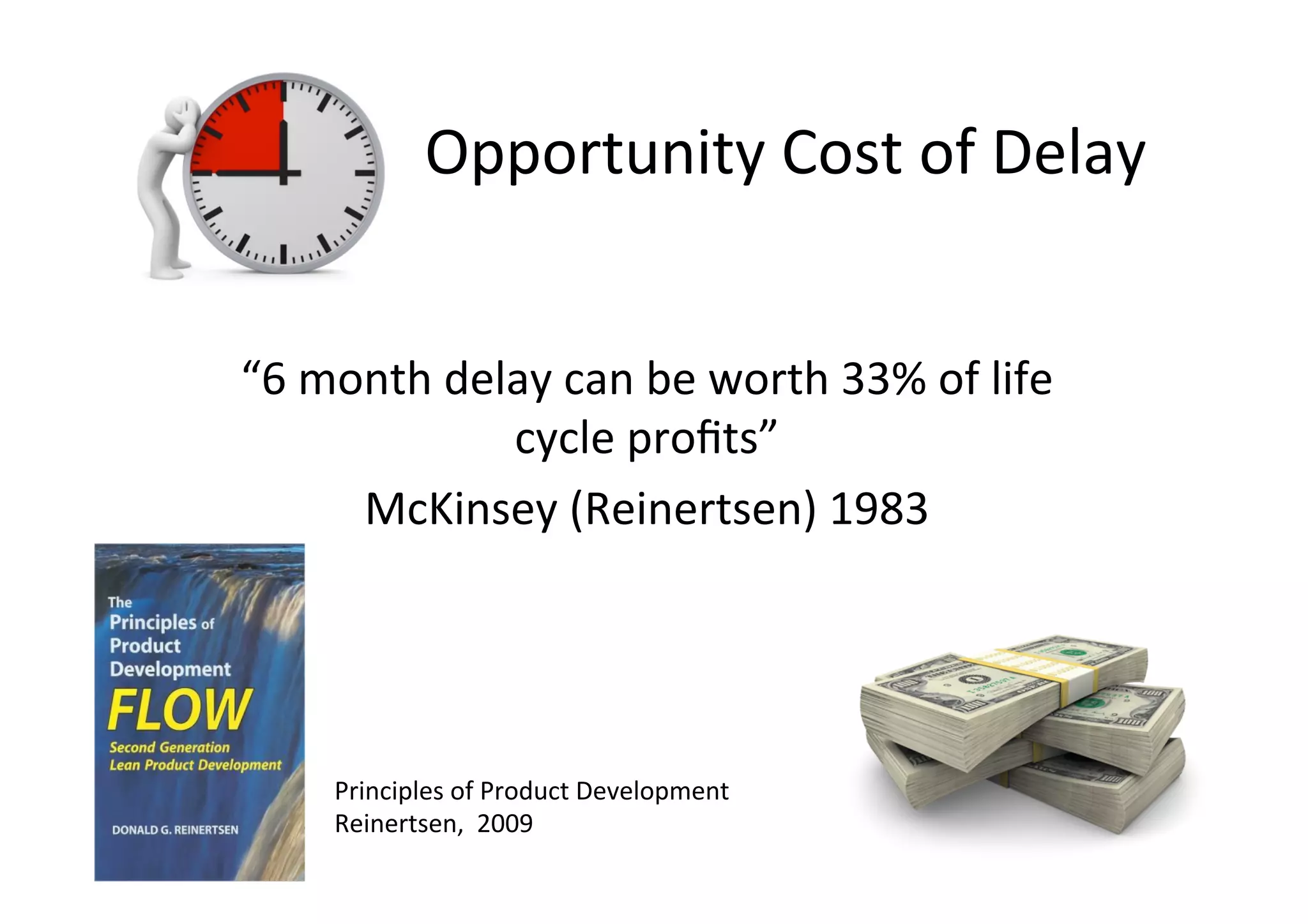

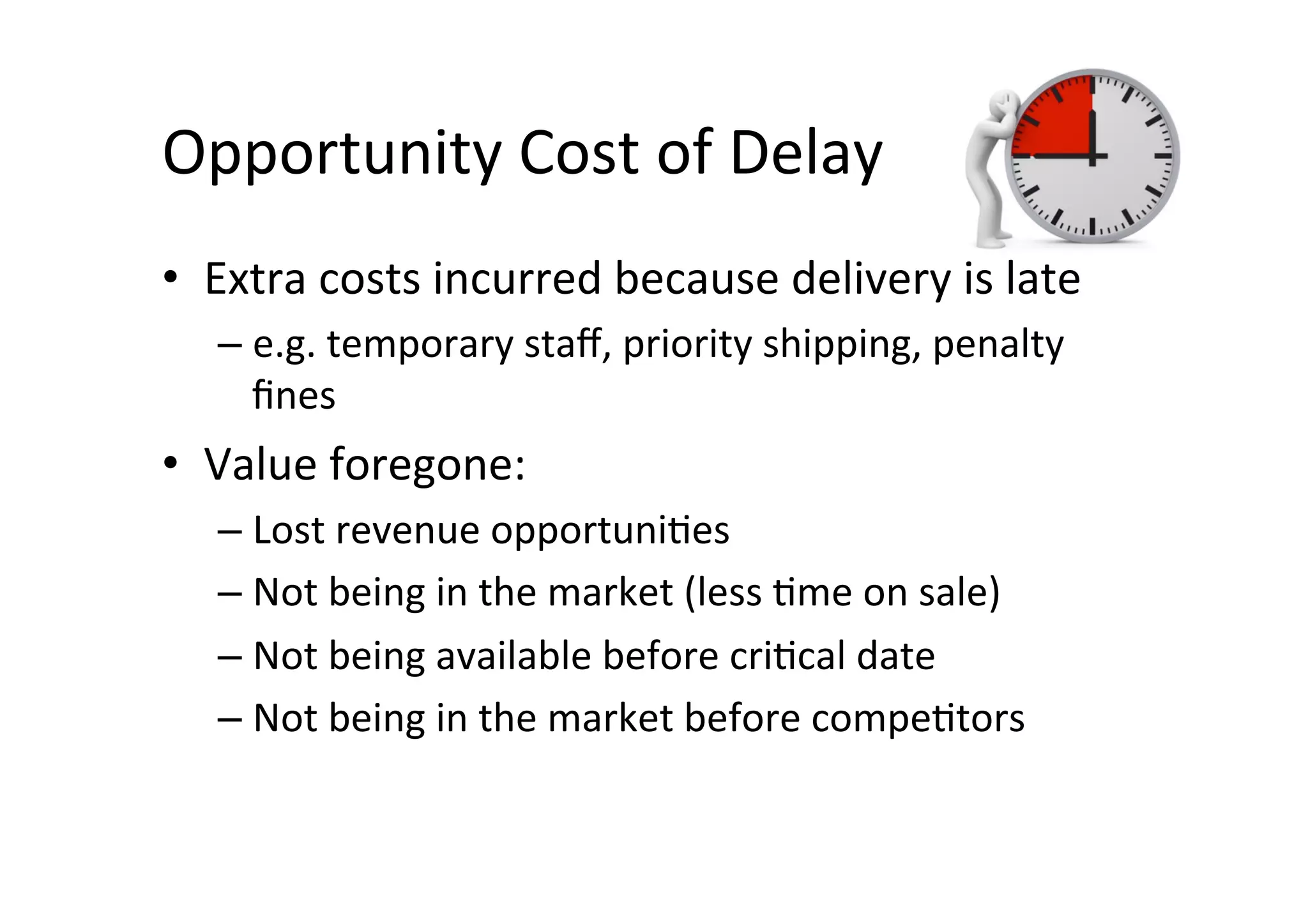

Opportunity	Cost	of	Delay
•  Extra	costs	incurred	because	delivery	is	late
– e.g.	temporary	staff,	priority	shipping,	penalty
fines
•  Value	foregone:
– Lost	revenue	opportuniSes
– Not	being	in	the	market	(less	Sme	on	sale)
– Not	being	available	before	criScal	date
– Not	being	in	the	market	before	compeStors
Time	is	money?
More	Sme	->	More	costs
More	Sme	->	Less	revenue

(Usually)	Revenue	is	inversely	proporSonal	to
Sme	to	delivery
Opportunity	Cost	of	Delay
“6	month	delay	can	be	worth	33%	of	life
cycle	profits”
McKinsey	(Reinertsen)	1983
Principles	of	Product	Development
Reinertsen,		2009

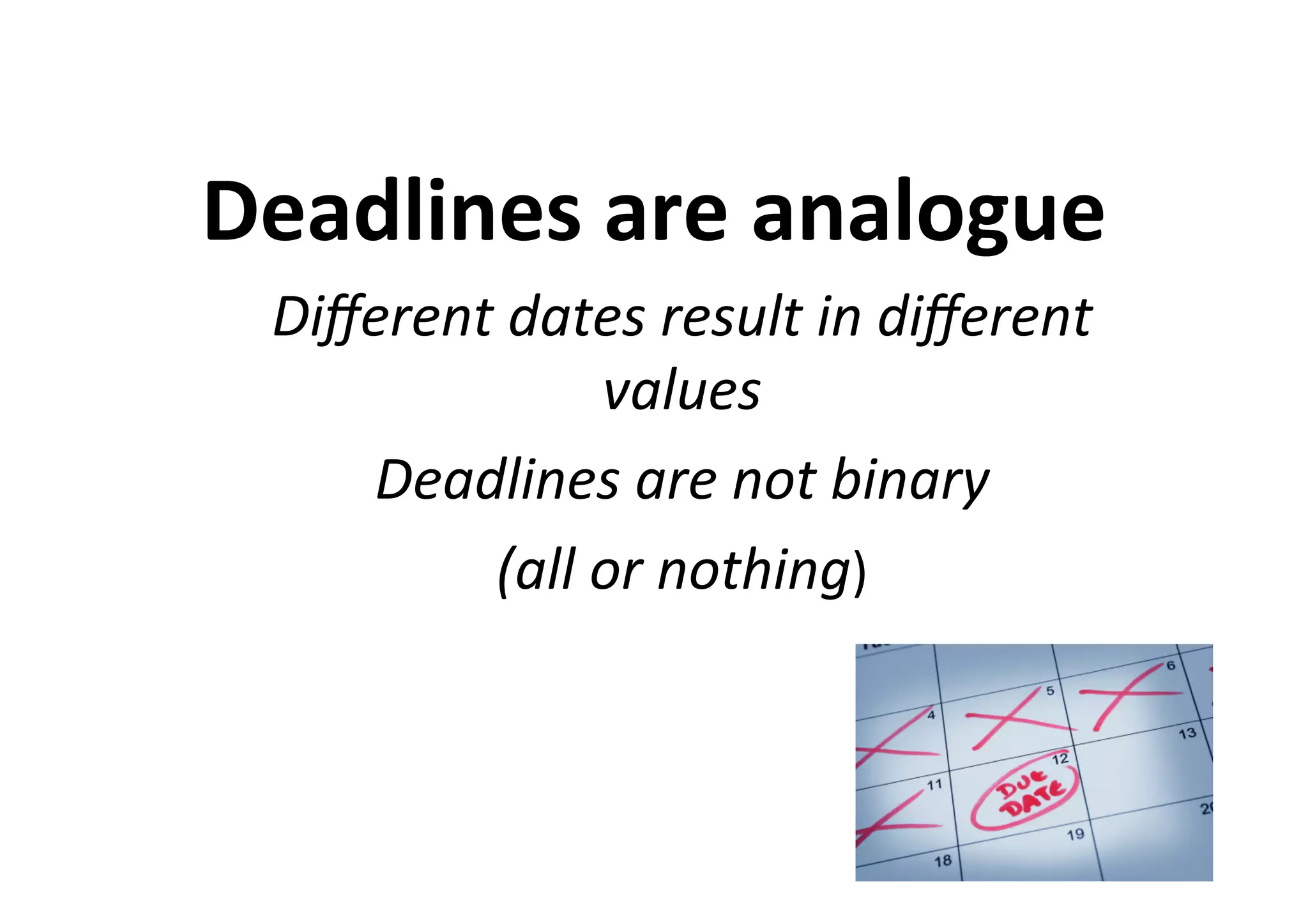

Deadlines	are	analogue
Different	dates	result	in	different
values
Deadlines	are	not	binary
(all	or	nothing)
I	need	this	and	I	need	it
YESTERDAY

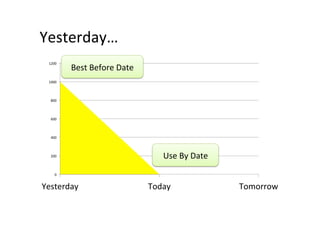

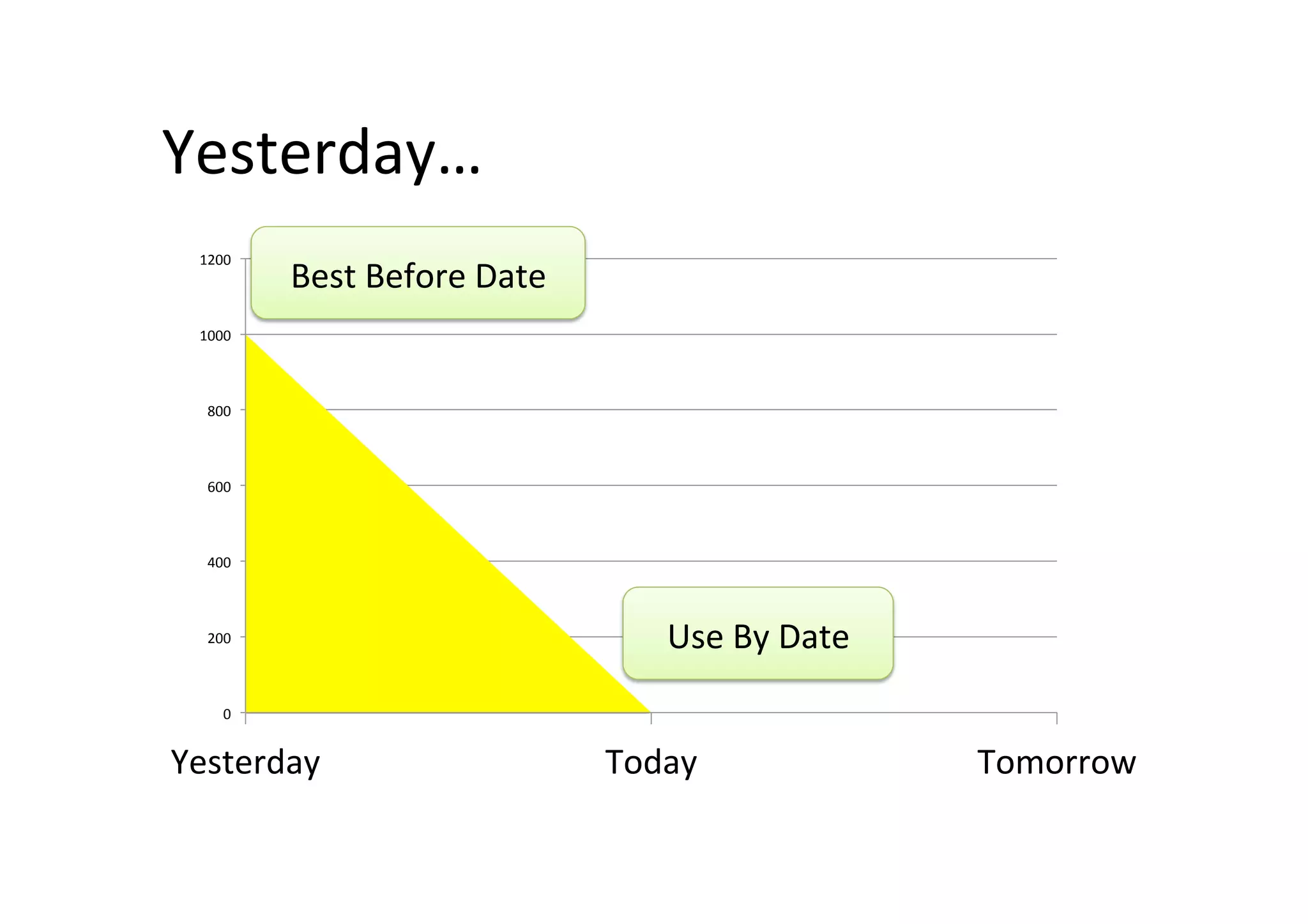

Yesterday…
0
200
400
600
800
1000
1200
Yesterday	 Today	 Tomorrow
Best	Before	Date
Use	By	Date

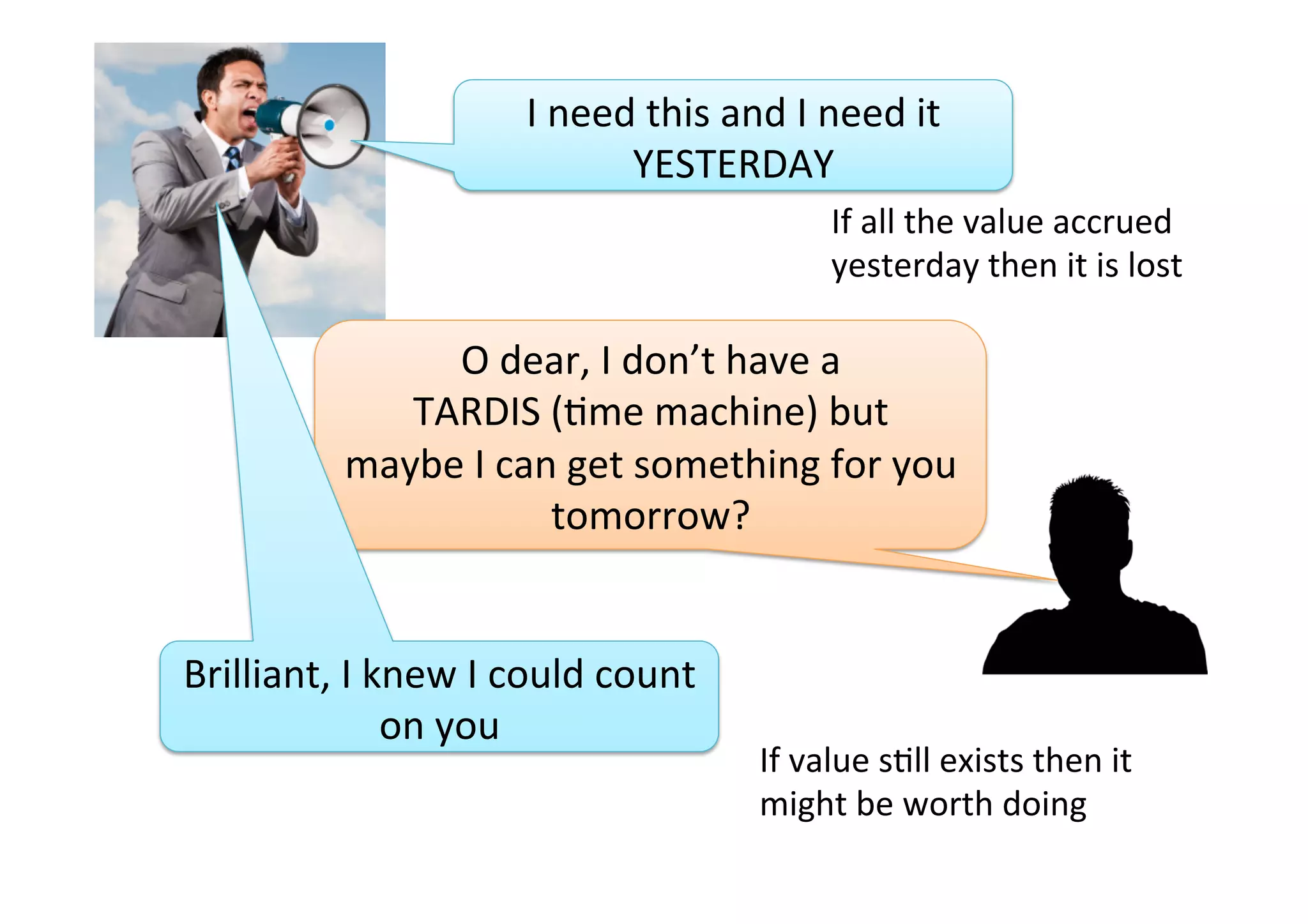

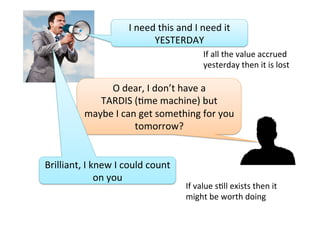

I	need	this	and	I	need	it
YESTERDAY
O	dear,	I	don’t	have	a
TARDIS	(Sme	machine)	but
maybe	I	can	get	something	for	you
tomorrow?
Brilliant,	I	knew	I	could	count
on	you
If	all	the	value	accrued
yesterday	then	it	is	lost
If	value	sSll	exists	then	it
might	be	worth	doing

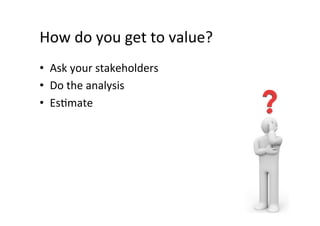

How	do	you	get	to	value?
•  Ask	your	stakeholders
•  Do	the	analysis
•  EsSmate
Value	Poker
Like	Planning	Poker
•  Value	points	not	Effort	points

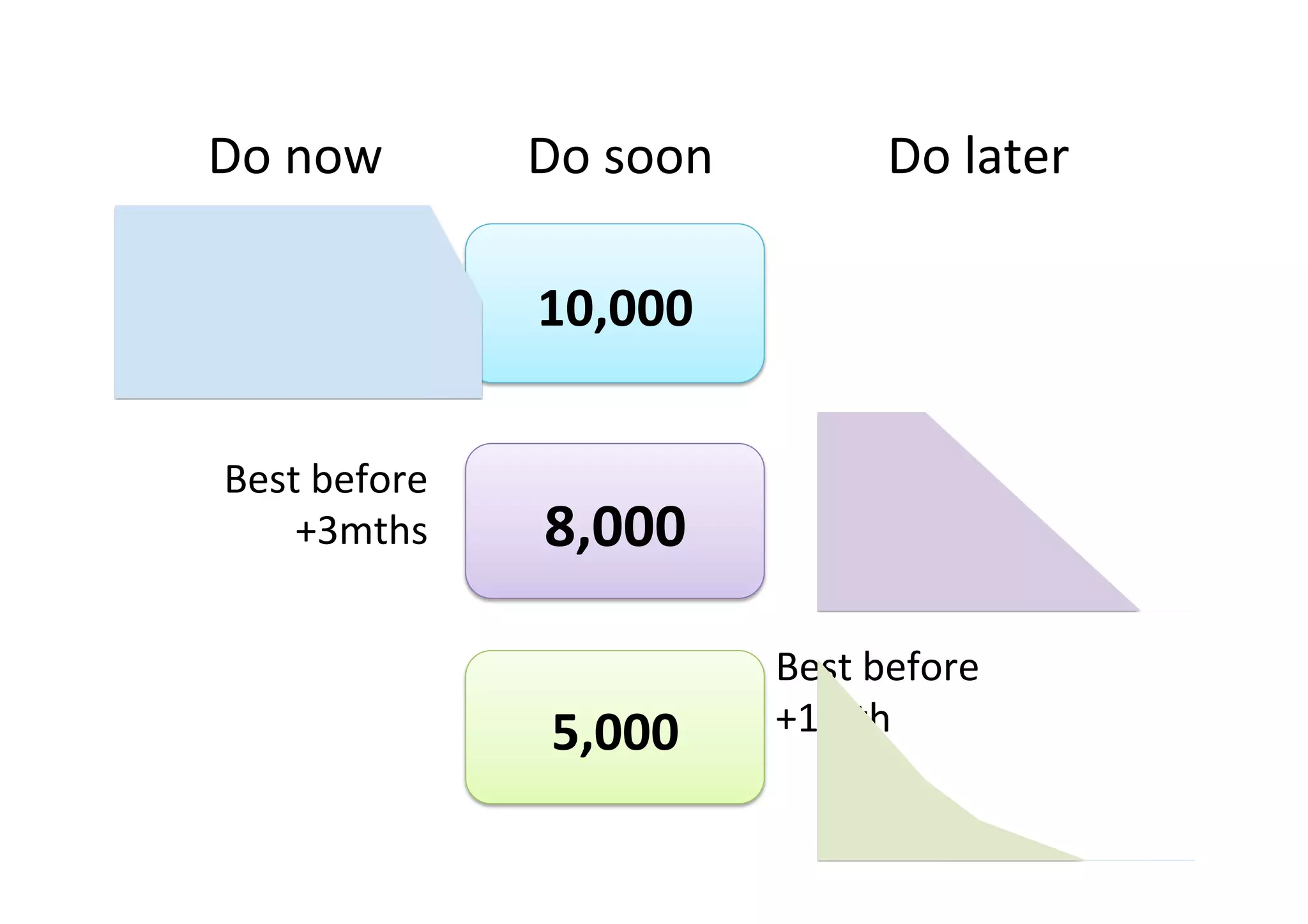

10,000
8,000
Do	now	 Do	soon	 Do	later
5,000
Best	before
+1mth
Best	before
+6mths
Best	before
+3mths
Time-Value	Profile	is	an
input	to	planning
0
50000
100000
150000
200000
250000
300000
350000
400000
Sep	1	 Sep	15	 Sep	29	 Oct	13	 Oct	27	 Nov	10	 Nov	24	 Dec	8	 Dec	22	 Jan	5
Product	B	value	over	4	months

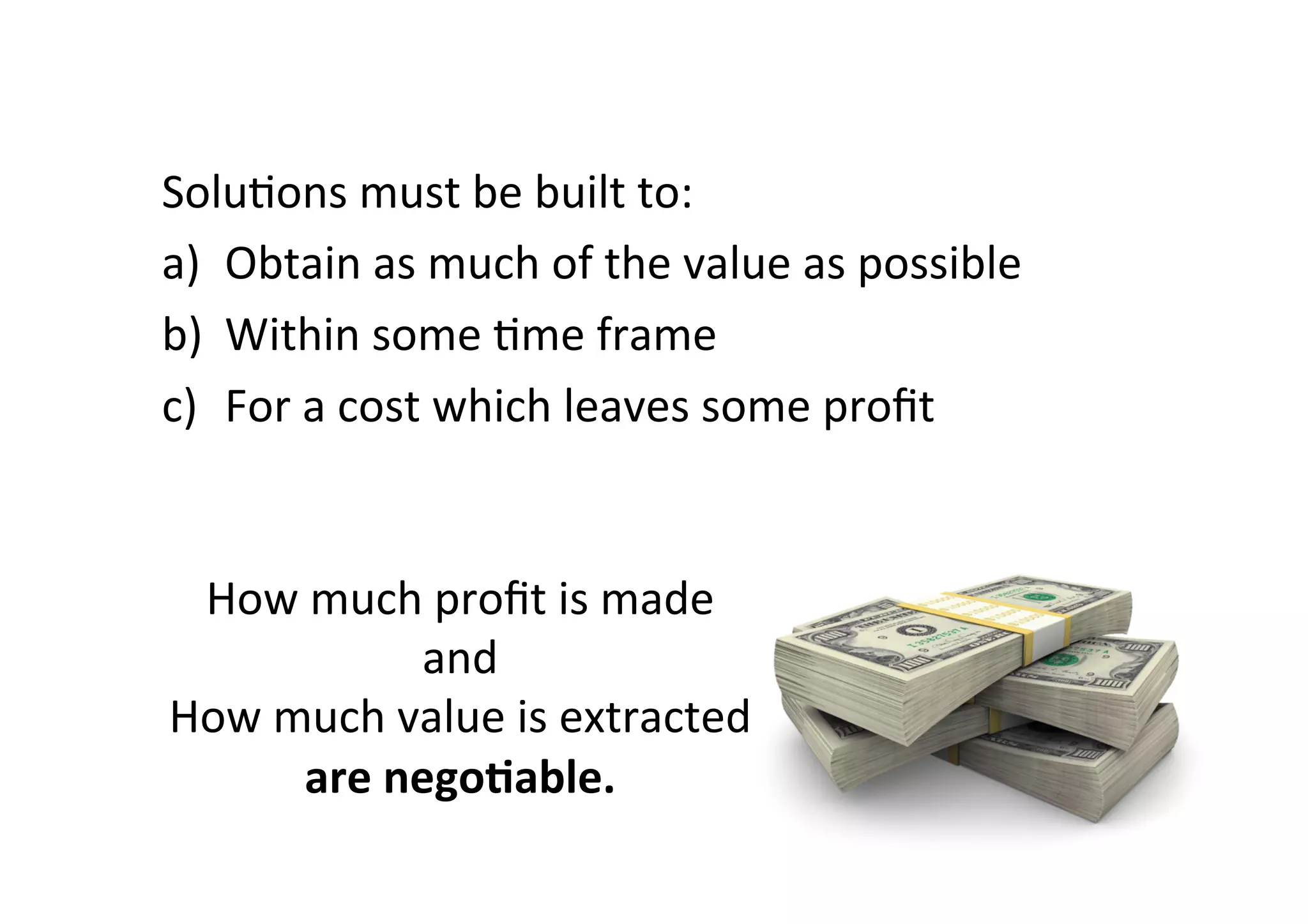

SoluSons	must	be	built	to:
a)  Obtain	as	much	of	the	value	as	possible
b)  Within	some	Sme	frame
c)  For	a	cost	which	leaves	some	profit
How	much	profit	is	made
and
How	much	value	is	extracted
are	negoIable.

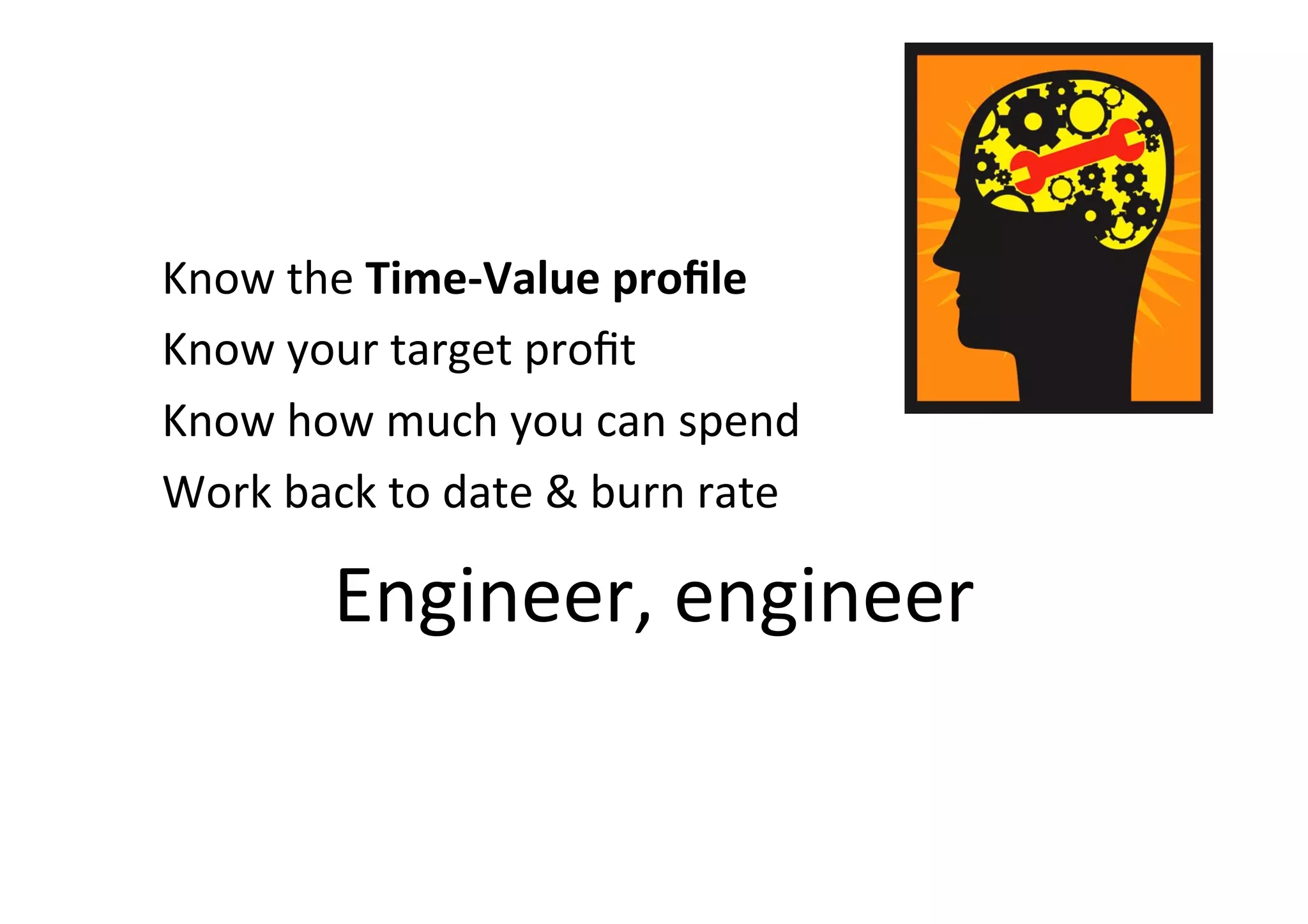

Know	the	Time-Value	profile
Know	your	target	profit
Know	how	much	you	can	spend
Work	back	to	date	&	burn	rate
Engineer,	engineer
Allan	Kelly…
Ø ConsulSng	on	sonware	development	&	strategy
Ø Training	for	Agile
Author
–  LiSle	Book	of	Requirements	&	User	Stories	(2016)
h>p://www.leanpub.com/userstories
–  Xanpan:	Team	Centric	Agile	Sonware	Development	(2014)
h>ps://leanpub.com/xanpan
–  Business	PaSerns	for	SoXware	Developers	(2012)
–  Changing	Sonware	Development	(2008)
More…
www.allankelly.net
LeanPub
h>ps://leanpub.com/cdigital
1.  A	li>le	soon	is	worth	more	than
a	lot	later
2.  Know	the	Sme-value	profile
3.  Deadlines	are	elasSc	by	value

allan@allankelly.net
Twi>er:	@allankellynet
½price	code:
AOTB2017
48	hours

Planning for Value: How much? When?
