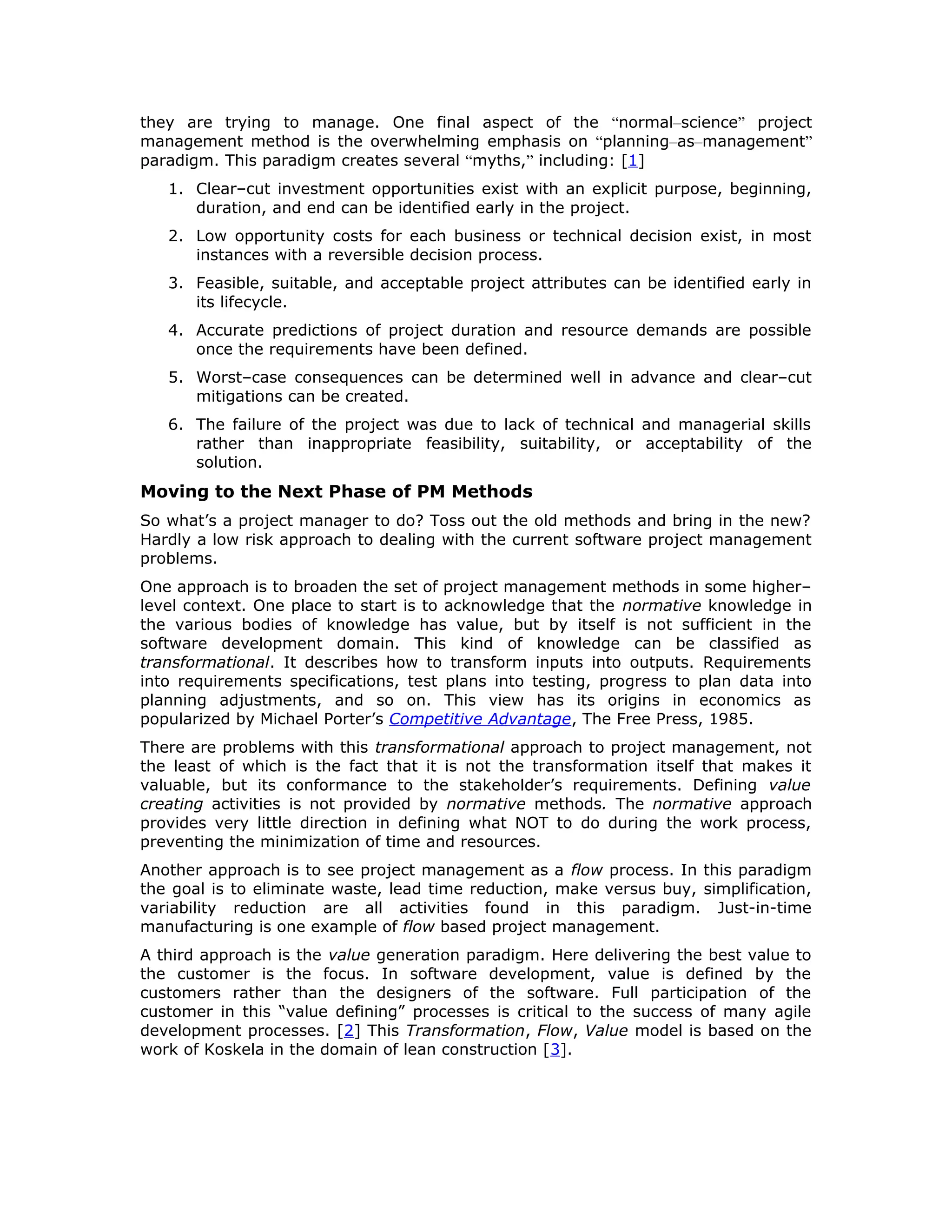

Reform of the traditional approaches to managing software development projects is driven by several factors, not the least of which is some spectacular failures of soft-ware projects. Ranging from the IRS, to the FAA, to large e–commerce systems, we all have some “war story” of a major failure that can be traced to non–technical causes.
This document provides “notional” questions and answers for Control Account Managers (CAM) during CAM interviews, IBR interviews and DCMA validation and surveillance interviews. The sections are common to all DCMA style programs.
Probabilistic Cost, Schedule, and Risk managementGlen Alleman
All variables on projects are random variables. Cost, Schedule, and Technical performance interact with each other is statistical ways to produce probabilistic outcomes for their values.
Managing a project to a successful outcomes requires not only understanding the underlying statistics, but forecasting outcomes from these interactions in enough time to take corrective actions.
The basis of decision making for software development started in the 1980's with the application of classical discounted cash flow analysis.
This paper speaks to the extension of those principles to the development of Agile software
Risk Management is essential to the success of all project work. Information about key project cost, performance, and schedule attributes are often unknown until the project is underway and changes are occurring during execution.
Risk Management is essential for the success of any significant project. Information about key project cost, performance, and schedule attributes is often unknown until the project is underway.
With uncertainty comes opportunity. But if a project manager is consumed with managing the risks, there is little time to manage the opportunities. Good risk management is not about fear of failure; it is about removing barriers to success. This is when opportunity management emerges.
This document provides “notional” questions and answers for Control Account Managers (CAM) during CAM interviews, IBR interviews and DCMA validation and surveillance interviews. The sections are common to all DCMA style programs.
Probabilistic Cost, Schedule, and Risk managementGlen Alleman
All variables on projects are random variables. Cost, Schedule, and Technical performance interact with each other is statistical ways to produce probabilistic outcomes for their values.
Managing a project to a successful outcomes requires not only understanding the underlying statistics, but forecasting outcomes from these interactions in enough time to take corrective actions.
The basis of decision making for software development started in the 1980's with the application of classical discounted cash flow analysis.
This paper speaks to the extension of those principles to the development of Agile software
Risk Management is essential to the success of all project work. Information about key project cost, performance, and schedule attributes are often unknown until the project is underway and changes are occurring during execution.
Risk Management is essential for the success of any significant project. Information about key project cost, performance, and schedule attributes is often unknown until the project is underway.
With uncertainty comes opportunity. But if a project manager is consumed with managing the risks, there is little time to manage the opportunities. Good risk management is not about fear of failure; it is about removing barriers to success. This is when opportunity management emerges.
Notes on IT programmatic risk in 5 not so easy piecesGlen Alleman
Risk management in the IT business is similar to risk management most domains. Here's a starting point for understanding the steps needed to manage risk
The role of Risk Assessment and Risk Management is to continuously Identify, Analyze, Plan, Track, Control, and Communicate the risks associated with a project.
The Webster’s definition of risk is the possibility of suffering a loss. Risk in itself is not bad. Risk is essential to progress and failure is often a key part of learning. Managing risk is a key part of success.
This document describes the foundations for conducting a risk assessment of a large-scale system development project. Such a project will likely include the procurement of Commercial Off The Shelf (COTS) products as well as their integration with legacy systems.
Cost and schedule growth for federal programs is created by unrealistic technical performance expectations, unrealistic cost and schedule estimates, inadequate risk assessments, unanticipated technical issues, and poorly performed and ineffective risk management, all contributing to program technical and programmatic shortfalls
Increasing the Probability of Success with Continuous Risk ManagementGlen Alleman
Cost and schedule growth is created when unrealistic technical performance expectations, unrealistic cost and schedule estimates, unanticipated technical issues, and poorly performed and ineffective risk management contribute to program technical and programmatic shortfalls
Managing in the presence of uncertaintyGlen Alleman
Uncertainty is the source of risk. Uncertainty comes in two types, aleatory and epistemic. It is important to understand both and deal with both in distinct ways, in order to produce a credible risk handling strategy.
Increasing the Probability of Project SuccessGlen Alleman
Risk Management is essential for development and production programs. Information about key cost, performance and schedule attributes are often uncertain or unknown until late in the program.
Risk issues that can be identified early in the program, which may potentially impact the program, termed Known Unknowns, can be alleviated with good risk management. -- Effective Risk Management 2nd Edition, Page 1, Edmund Conrow, American Institute of Aeronautics and Astronautics, 2003
Risk Management is a critical success factor for all project work.
Risk identification, quantitative and qualitative analysis, and risk response planning and execution is provided in this presentation
Delivering programs with less capability than promised, while exceeding the cost and planned durations, distorts decision making, contributes to increasing cost growth to other programs, undermines the Federal government’s credibility with taxpayers and contributes to the public’s negative support for these programs.
Five Immutable Principles of Project of Digital Transformation SuccessGlen Alleman
Successful Digital Transformation projects are fraught with technical, cost, and schedule risks.
These Five Principles of Project Success have been shown to increase the Probability of Project Success (PoPS).
The question – what does Done Look Like? – was asked every week on the program that changed my life as a Program Manager. Rocky Flats Environmental Technology Site (RFETS) was the marketing term for the 3rd worst toxic waste site on the planet. RFETS was a nuclear bomb manufacturing plant, built in 1951, operating until 1989, and closed in 2005. I served as the VP of Program Management of the ITC (Information Technology and Communications) group, providing ERP, purpose built IT, voice, and data systems for 5,000 employees and contractors of the Bomb Factory.
The naturally occurring uncertainties (Aleatory) in cost, schedule, and technical performance can be modeled in a Monte Carlo Simulation tool. The Event Based uncertainties (Epistemic) require capture, modeling of their impacts, defining handling strategies, modeling the effectiveness of these handling efforts, and the residual risks, and their impacts of both the original risk and the residual risk on the program.
