2012

Glen
  B.
  Alleman

Niwot
  Ridge,
  LLC

Copyright
  ©
  2012

All
  Rights
  Reserved

+
  1
  303
  241
  9633

[NOTIONAL
  CAM
  INTERVIEW
  QUESTIONS]

A
  collection
  of
  CAM
  interview
  questions
  and
  typical
  answers
  based
  on
  ANSI-­‐748-­‐C
  Earned
  Value
  Management
  processes

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  2

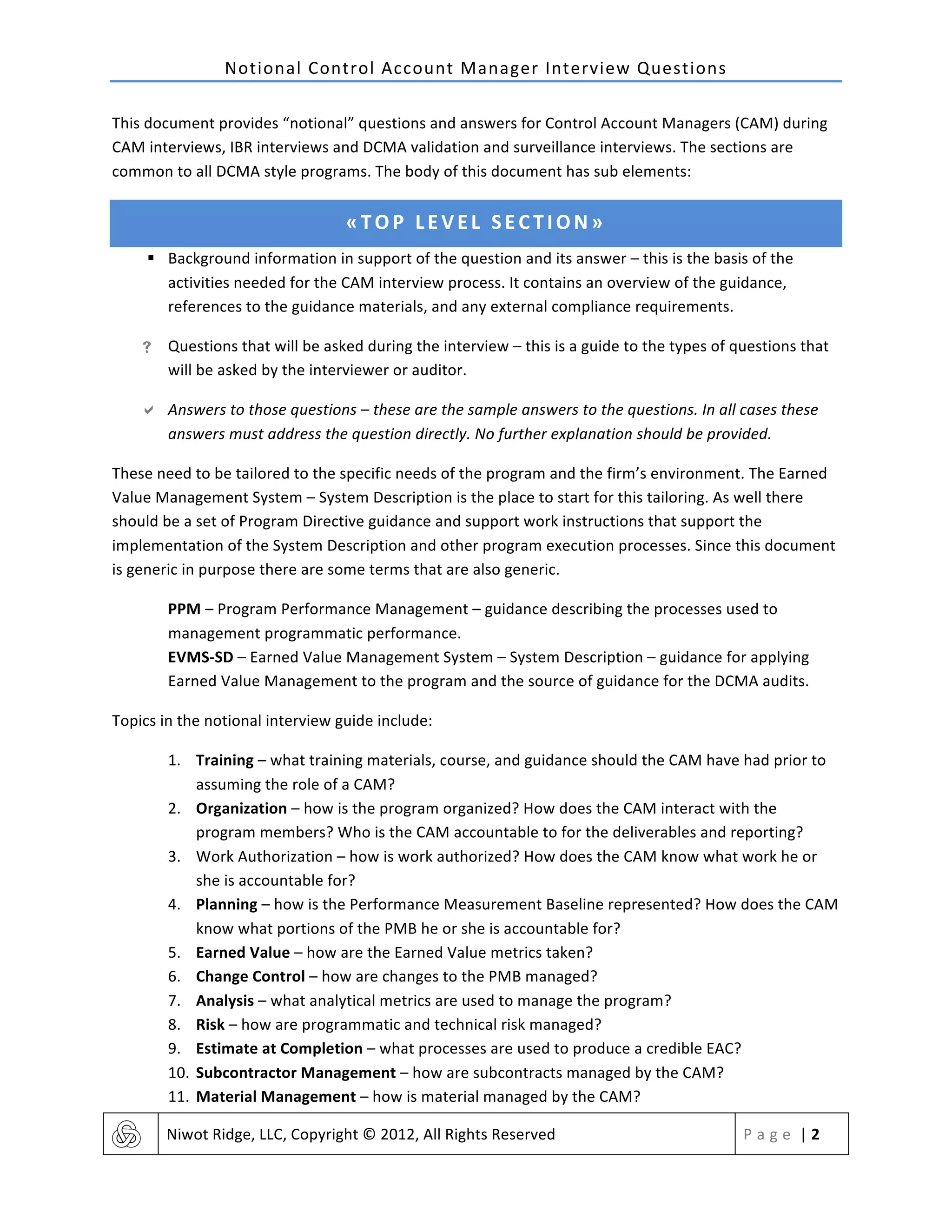

This
  document
  provides
  “notional”
  questions
  and
  answers
  for
  Control
  Account
  Managers
  (CAM)
  during

CAM
  interviews,
  IBR
  interviews
  and
  DCMA
  validation
  and
  surveillance
  interviews.
  The
  sections
  are

common
  to
  all
  DCMA
  style
  programs.
  The
  body
  of
  this
  document
  has
  sub
  elements:

«TOP
  LEVEL
  SECTION»

§ Background
  information
  in
  support
  of
  the
  question
  and
  its
  answer
  –
  this
  is
  the
  basis
  of
  the

activities
  needed
  for
  the
  CAM
  interview
  process.
  It
  contains
  an
  overview
  of
  the
  guidance,

references
  to
  the
  guidance
  materials,
  and
  any
  external
  compliance
  requirements.

! Questions
  that
  will
  be
  asked
  during
  the
  interview
  –
  this
  is
  a
  guide
  to
  the
  types
  of
  questions
  that

will
  be
  asked
  by
  the
  interviewer
  or
  auditor.

" Answers
  to
  those
  questions
  –
  these
  are
  the
  sample
  answers
  to
  the
  questions.
  In
  all
  cases
  these

answers
  must
  address
  the
  question
  directly.
  No
  further
  explanation
  should
  be
  provided.

These
  need
  to
  be
  tailored
  to
  the
  specific
  needs
  of
  the
  program
  and
  the
  firm’s
  environment.
  The
  Earned

Value
  Management
  System
  –
  System
  Description
  is
  the
  place
  to
  start
  for
  this
  tailoring.
  As
  well
  there

should
  be
  a
  set
  of
  Program
  Directive
  guidance
  and
  support
  work
  instructions
  that
  support
  the

implementation
  of
  the
  System
  Description
  and
  other
  program
  execution
  processes.
  Since
  this
  document

is
  generic
  in
  purpose
  there
  are
  some
  terms
  that
  are
  also
  generic.

PPM
  –
  Program
  Performance
  Management
  –
  guidance
  describing
  the
  processes
  used
  to

management
  programmatic
  performance.

EVMS-­‐SD
  –
  Earned
  Value
  Management
  System
  –
  System
  Description
  –
  guidance
  for
  applying

Earned
  Value
  Management
  to
  the
  program
  and
  the
  source
  of
  guidance
  for
  the
  DCMA
  audits.

Topics
  in
  the
  notional
  interview
  guide
  include:

1. Training
  –
  what
  training
  materials,
  course,
  and
  guidance
  should
  the
  CAM
  have
  had
  prior
  to

assuming
  the
  role
  of
  a
  CAM?

2. Organization
  –
  how
  is
  the
  program
  organized?
  How
  does
  the
  CAM
  interact
  with
  the

program
  members?
  Who
  is
  the
  CAM
  accountable
  to
  for
  the
  deliverables
  and
  reporting?

3. Work
  Authorization
  –
  how
  is
  work
  authorized?
  How
  does
  the
  CAM
  know
  what
  work
  he
  or

she
  is
  accountable
  for?

4. Planning
  –
  how
  is
  the
  Performance
  Measurement
  Baseline
  represented?
  How
  does
  the
  CAM

know
  what
  portions
  of
  the
  PMB
  he
  or
  she
  is
  accountable
  for?

5. Earned
  Value
  –
  how
  are
  the
  Earned
  Value
  metrics
  taken?

6. Change
  Control
  –
  how
  are
  changes
  to
  the
  PMB
  managed?

7. Analysis
  –
  what
  analytical
  metrics
  are
  used
  to
  manage
  the
  program?

8. Risk
  –
  how
  are
  programmatic
  and
  technical
  risk
  managed?

9. Estimate
  at
  Completion
  –
  what
  processes
  are
  used
  to
  produce
  a
  credible
  EAC?

10. Subcontractor
  Management
  –
  how
  are
  subcontracts
  managed
  by
  the
  CAM?

11. Material
  Management
  –
  how
  is
  material
  managed
  by
  the
  CAM?

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  3

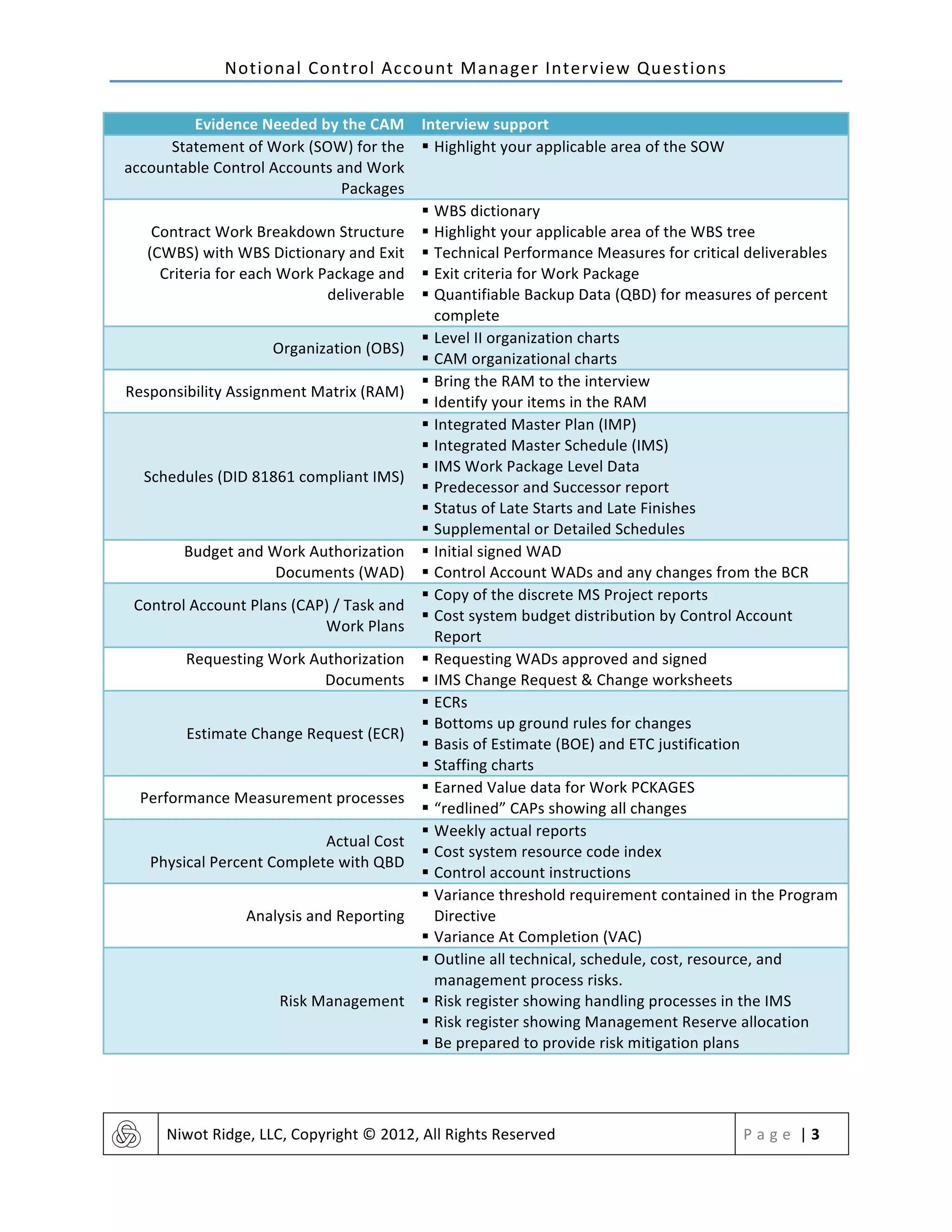

Evidence
  Needed
  by
  the
  CAM
   Interview
  support

Statement
  of
  Work
  (SOW)
  for
  the

accountable
  Control
  Accounts
  and
  Work

Packages

§ Highlight
  your
  applicable
  area
  of
  the
  SOW

Contract
  Work
  Breakdown
  Structure

(CWBS)
  with
  WBS
  Dictionary
  and
  Exit

Criteria
  for
  each
  Work
  Package
  and

deliverable

§ WBS
  dictionary

§ Highlight
  your
  applicable
  area
  of
  the
  WBS
  tree

§ Technical
  Performance
  Measures
  for
  critical
  deliverables

§ Exit
  criteria
  for
  Work
  Package

§ Quantifiable
  Backup
  Data
  (QBD)
  for
  measures
  of
  percent

complete

Organization
  (OBS)

§ Level
  II
  organization
  charts

§ CAM
  organizational
  charts

Responsibility
  Assignment
  Matrix
  (RAM)

§ Bring
  the
  RAM
  to
  the
  interview

§ Identify
  your
  items
  in
  the
  RAM

Schedules
  (DID
  81861
  compliant
  IMS)

§ Integrated
  Master
  Plan
  (IMP)

§ Integrated
  Master
  Schedule
  (IMS)

§ IMS
  Work
  Package
  Level
  Data

§ Predecessor
  and
  Successor
  report

§ Status
  of
  Late
  Starts
  and
  Late
  Finishes

§ Supplemental
  or
  Detailed
  Schedules

Budget
  and
  Work
  Authorization

Documents
  (WAD)

§ Initial
  signed
  WAD

§ Control
  Account
  WADs
  and
  any
  changes
  from
  the
  BCR

Control
  Account
  Plans
  (CAP)
  /
  Task
  and

Work
  Plans

§ Copy
  of
  the
  discrete
  MS
  Project
  reports

§ Cost
  system
  budget
  distribution
  by
  Control
  Account

Report

Requesting
  Work
  Authorization

Documents

§ Requesting
  WADs
  approved
  and
  signed

§ IMS
  Change
  Request
  &
  Change
  worksheets

Estimate
  Change
  Request
  (ECR)

§ ECRs

§ Bottoms
  up
  ground
  rules
  for
  changes

§ Basis
  of
  Estimate
  (BOE)
  and
  ETC
  justification

§ Staffing
  charts

Performance
  Measurement
  processes

§ Earned
  Value
  data
  for
  Work
  PCKAGES

§ “redlined”
  CAPs
  showing
  all
  changes

Actual
  Cost

Physical
  Percent
  Complete
  with
  QBD

§ Weekly
  actual
  reports

§ Cost
  system
  resource
  code
  index

§ Control
  account
  instructions

Analysis
  and
  Reporting

§ Variance
  threshold
  requirement
  contained
  in
  the
  Program

Directive

§ Variance
  At
  Completion
  (VAC)

Risk
  Management

§ Outline
  all
  technical,
  schedule,
  cost,
  resource,
  and

management
  process
  risks.

§ Risk
  register
  showing
  handling
  processes
  in
  the
  IMS

§ Risk
  register
  showing
  Management
  Reserve
  allocation

§ Be
  prepared
  to
  provide
  risk
  mitigation
  plans

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  4

«HISTORY
  OF
  THIS
  DOCUMENT»

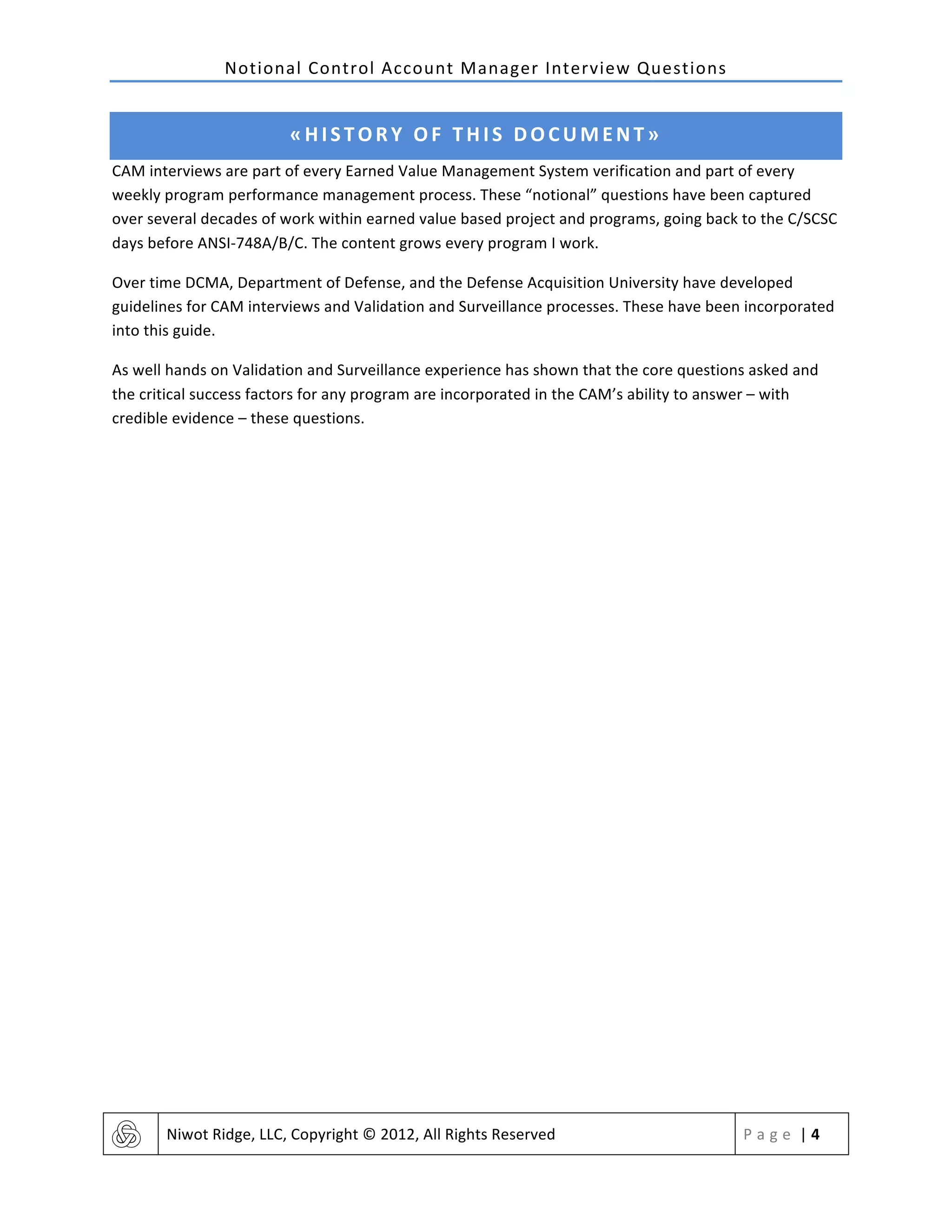

CAM
  interviews
  are
  part
  of
  every
  Earned
  Value
  Management
  System
  verification
  and
  part
  of
  every

weekly
  program
  performance
  management
  process.
  These
  “notional”
  questions
  have
  been
  captured

over
  several
  decades
  of
  work
  within
  earned
  value
  based
  project
  and
  programs,
  going
  back
  to
  the
  C/SCSC

days
  before
  ANSI-­‐748A/B/C.
  The
  content
  grows
  every
  program
  I
  work.

Over
  time
  DCMA,
  Department
  of
  Defense,
  and
  the
  Defense
  Acquisition
  University
  have
  developed

guidelines
  for
  CAM
  interviews
  and
  Validation
  and
  Surveillance
  processes.
  These
  have
  been
  incorporated

into
  this
  guide.

As
  well
  hands
  on
  Validation
  and
  Surveillance
  experience
  has
  shown
  that
  the
  core
  questions
  asked
  and

the
  critical
  success
  factors
  for
  any
  program
  are
  incorporated
  in
  the
  CAM’s
  ability
  to
  answer
  –
  with

credible
  evidence
  –
  these
  questions.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  5

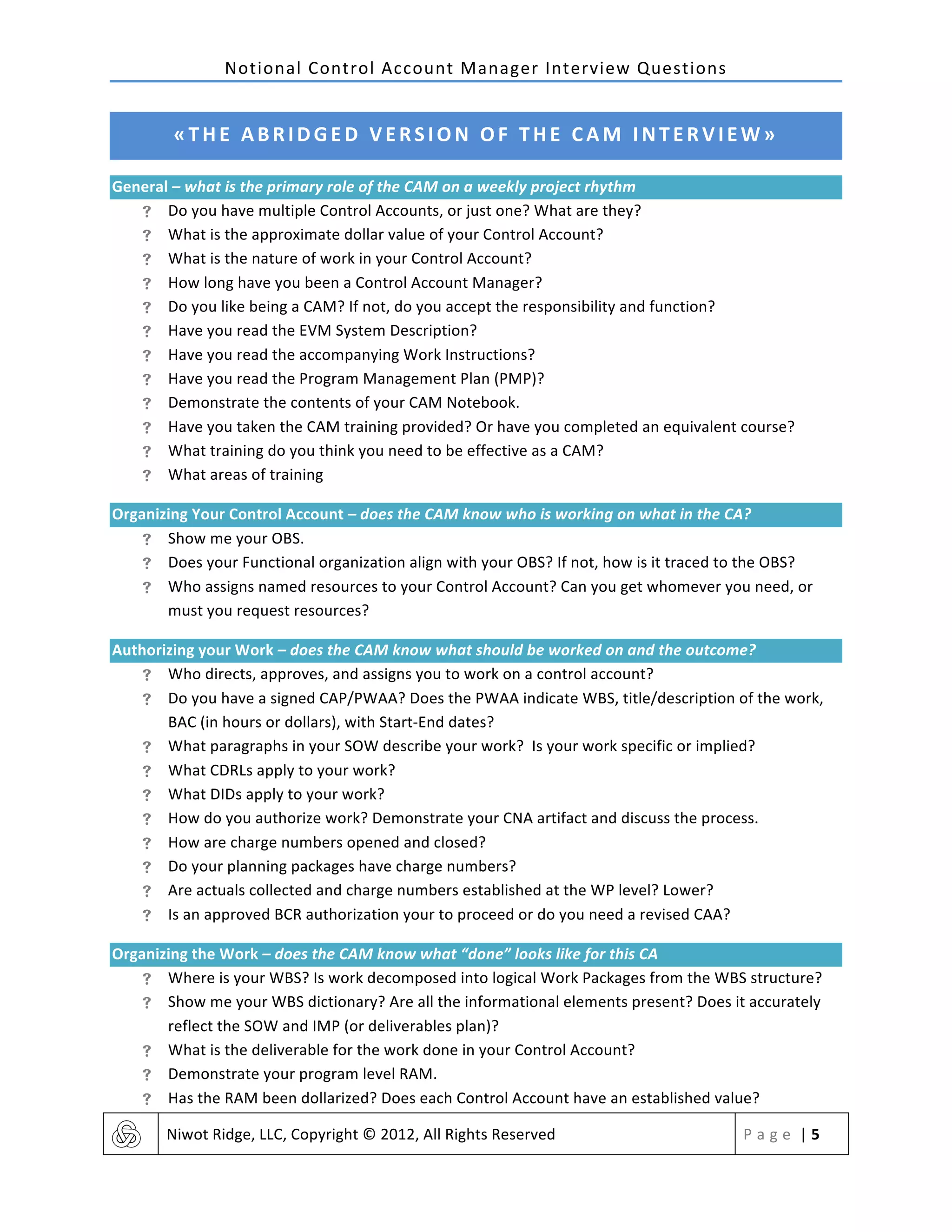

«THE
  ABRIDGED
  VERSION
  OF
  THE
  CAM
  INTERVIEW»

General
  –
  what
  is
  the
  primary
  role
  of
  the
  CAM
  on
  a
  weekly
  project
  rhythm

! Do
  you
  have
  multiple
  Control
  Accounts,
  or
  just
  one?
  What
  are
  they?

! What
  is
  the
  approximate
  dollar
  value
  of
  your
  Control
  Account?

! What
  is
  the
  nature
  of
  work
  in
  your
  Control
  Account?

! How
  long
  have
  you
  been
  a
  Control
  Account
  Manager?

! Do
  you
  like
  being
  a
  CAM?
  If
  not,
  do
  you
  accept
  the
  responsibility
  and
  function?

! Have
  you
  read
  the
  EVM
  System
  Description?

! Have
  you
  read
  the
  accompanying
  Work
  Instructions?

! Have
  you
  read
  the
  Program
  Management
  Plan
  (PMP)?

! Demonstrate
  the
  contents
  of
  your
  CAM
  Notebook.

! Have
  you
  taken
  the
  CAM
  training
  provided?
  Or
  have
  you
  completed
  an
  equivalent
  course?

! What
  training
  do
  you
  think
  you
  need
  to
  be
  effective
  as
  a
  CAM?

! What
  areas
  of
  training

Organizing
  Your
  Control
  Account
  –
  does
  the
  CAM
  know
  who
  is
  working
  on
  what
  in
  the
  CA?

! Show
  me
  your
  OBS.

! Does
  your
  Functional
  organization
  align
  with
  your
  OBS?
  If
  not,
  how
  is
  it
  traced
  to
  the
  OBS?

! Who
  assigns
  named
  resources
  to
  your
  Control
  Account?
  Can
  you
  get
  whomever
  you
  need,
  or

must
  you
  request
  resources?

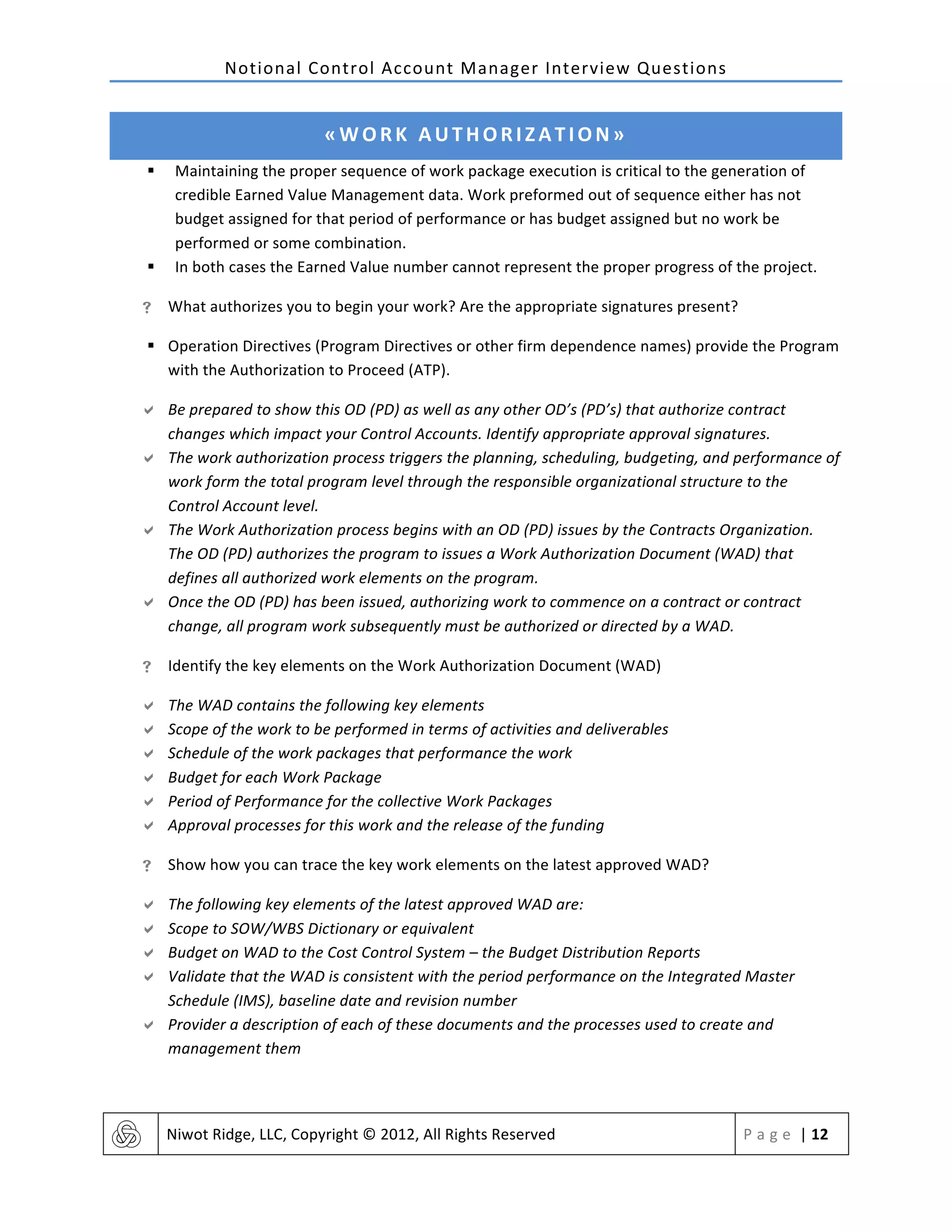

Authorizing
  your
  Work
  –
  does
  the
  CAM
  know
  what
  should
  be
  worked
  on
  and
  the
  outcome?

! Who
  directs,
  approves,
  and
  assigns
  you
  to
  work
  on
  a
  control
  account?

! Do
  you
  have
  a
  signed
  CAP/PWAA?
  Does
  the
  PWAA
  indicate
  WBS,
  title/description
  of
  the
  work,

BAC
  (in
  hours
  or
  dollars),
  with
  Start-­‐End
  dates?

! What
  paragraphs
  in
  your
  SOW
  describe
  your
  work?

  Is
  your
  work
  specific
  or
  implied?

! What
  CDRLs
  apply
  to
  your
  work?

! What
  DIDs
  apply
  to
  your
  work?

! How
  do
  you
  authorize
  work?
  Demonstrate
  your
  CNA
  artifact
  and
  discuss
  the
  process.

! How
  are
  charge
  numbers
  opened
  and
  closed?

! Do
  your
  planning
  packages
  have
  charge
  numbers?

! Are
  actuals
  collected
  and
  charge
  numbers
  established
  at
  the
  WP
  level?
  Lower?

! Is
  an
  approved
  BCR
  authorization
  your
  to
  proceed
  or
  do
  you
  need
  a
  revised
  CAA?

Organizing
  the
  Work
  –
  does
  the
  CAM
  know
  what
  “done”
  looks
  like
  for
  this
  CA

! Where
  is
  your
  WBS?
  Is
  work
  decomposed
  into
  logical
  Work
  Packages
  from
  the
  WBS
  structure?

! Show
  me
  your
  WBS
  dictionary?
  Are
  all
  the
  informational
  elements
  present?
  Does
  it
  accurately

reflect
  the
  SOW
  and
  IMP
  (or
  deliverables
  plan)?

! What
  is
  the
  deliverable
  for
  the
  work
  done
  in
  your
  Control
  Account?

! Demonstrate
  your
  program
  level
  RAM.

! Has
  the
  RAM
  been
  dollarized?
  Does
  each
  Control
  Account
  have
  an
  established
  value?

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  6

! Demonstrate
  your
  detailed
  RAM?

! Demonstrate
  your
  Basis
  of
  Estimate
  summary?

! What
  is
  your
  estimating
  process/tool?

! Demonstrate
  your
  CAP?

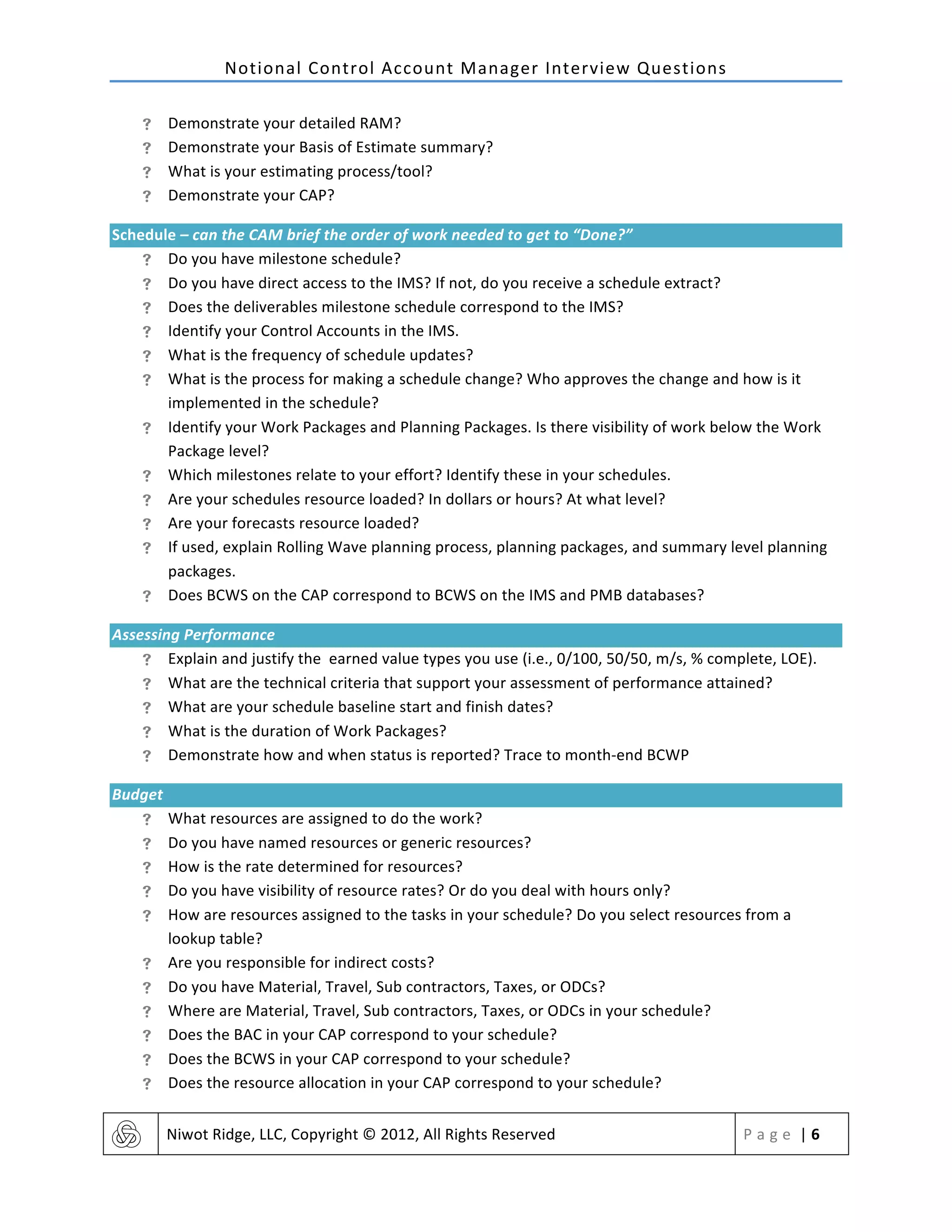

Schedule
  –
  can
  the
  CAM
  brief
  the
  order
  of
  work
  needed
  to
  get
  to
  “Done?”

! Do
  you
  have
  milestone
  schedule?

! Do
  you
  have
  direct
  access
  to
  the
  IMS?
  If
  not,
  do
  you
  receive
  a
  schedule
  extract?

! Does
  the
  deliverables
  milestone
  schedule
  correspond
  to
  the
  IMS?

! Identify
  your
  Control
  Accounts
  in
  the
  IMS.

! What
  is
  the
  frequency
  of
  schedule
  updates?

! What
  is
  the
  process
  for
  making
  a
  schedule
  change?
  Who
  approves
  the
  change
  and
  how
  is
  it

implemented
  in
  the
  schedule?

! Identify
  your
  Work
  Packages
  and
  Planning
  Packages.
  Is
  there
  visibility
  of
  work
  below
  the
  Work

Package
  level?

! Which
  milestones
  relate
  to
  your
  effort?
  Identify
  these
  in
  your
  schedules.

! Are
  your
  schedules
  resource
  loaded?
  In
  dollars
  or
  hours?
  At
  what
  level?

! Are
  your
  forecasts
  resource
  loaded?

! If
  used,
  explain
  Rolling
  Wave
  planning
  process,
  planning
  packages,
  and
  summary
  level
  planning

packages.

! Does
  BCWS
  on
  the
  CAP
  correspond
  to
  BCWS
  on
  the
  IMS
  and
  PMB
  databases?

Assessing
  Performance

! Explain
  and
  justify
  the
  earned
  value
  types
  you
  use
  (i.e.,
  0/100,
  50/50,
  m/s,
  %
  complete,
  LOE).

! What
  are
  the
  technical
  criteria
  that
  support
  your
  assessment
  of
  performance
  attained?

! What
  are
  your
  schedule
  baseline
  start
  and
  finish
  dates?

! What
  is
  the
  duration
  of
  Work
  Packages?

! Demonstrate
  how
  and
  when
  status
  is
  reported?
  Trace
  to
  month-­‐end
  BCWP

Budget

! What
  resources
  are
  assigned
  to
  do
  the
  work?

! Do
  you
  have
  named
  resources
  or
  generic
  resources?

! How
  is
  the
  rate
  determined
  for
  resources?

! Do
  you
  have
  visibility
  of
  resource
  rates?
  Or
  do
  you
  deal
  with
  hours
  only?

! How
  are
  resources
  assigned
  to
  the
  tasks
  in
  your
  schedule?
  Do
  you
  select
  resources
  from
  a

lookup
  table?

! Are
  you
  responsible
  for
  indirect
  costs?

! Do
  you
  have
  Material,
  Travel,
  Sub
  contractors,
  Taxes,
  or
  ODCs?

! Where
  are
  Material,
  Travel,
  Sub
  contractors,
  Taxes,
  or
  ODCs
  in
  your
  schedule?

! Does
  the
  BAC
  in
  your
  CAP
  correspond
  to
  your
  schedule?

! Does
  the
  BCWS
  in
  your
  CAP
  correspond
  to
  your
  schedule?

! Does
  the
  resource
  allocation
  in
  your
  CAP
  correspond
  to
  your
  schedule?

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  7

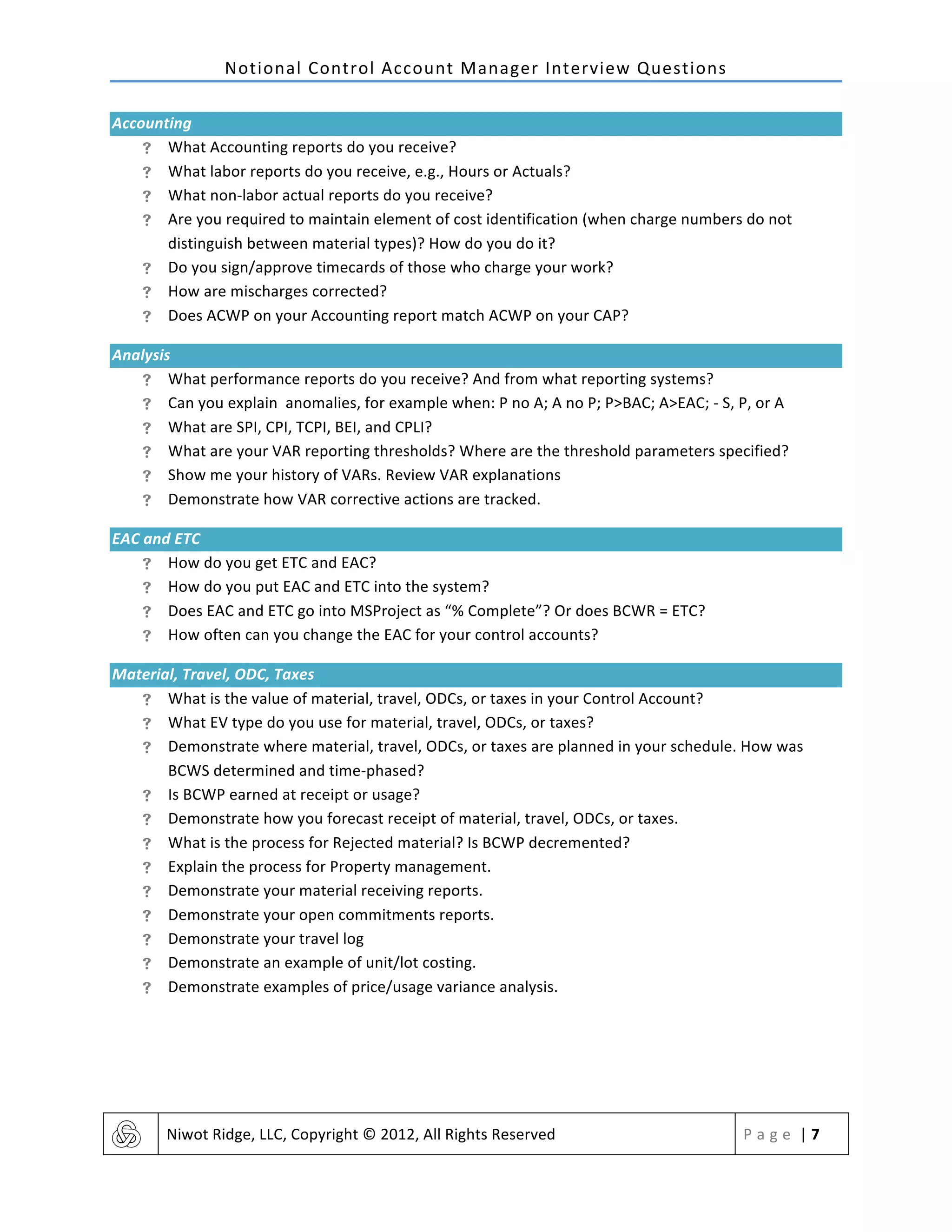

Accounting

! What
  Accounting
  reports
  do
  you
  receive?

! What
  labor
  reports
  do
  you
  receive,
  e.g.,
  Hours
  or
  Actuals?

! What
  non-­‐labor
  actual
  reports
  do
  you
  receive?

! Are
  you
  required
  to
  maintain
  element
  of
  cost
  identification
  (when
  charge
  numbers
  do
  not

distinguish
  between
  material
  types)?
  How
  do
  you
  do
  it?

! Do
  you
  sign/approve
  timecards
  of
  those
  who
  charge
  your
  work?

! How
  are
  mischarges
  corrected?

! Does
  ACWP
  on
  your
  Accounting
  report
  match
  ACWP
  on
  your
  CAP?

Analysis

! What
  performance
  reports
  do
  you
  receive?
  And
  from
  what
  reporting
  systems?

! Can
  you
  explain
  anomalies,
  for
  example
  when:
  P
  no
  A;
  A
  no
  P;
  P>BAC;
  A>EAC;
  -­‐
  S,
  P,
  or
  A

! What
  are
  SPI,
  CPI,
  TCPI,
  BEI,
  and
  CPLI?

! What
  are
  your
  VAR
  reporting
  thresholds?
  Where
  are
  the
  threshold
  parameters
  specified?

! Show
  me
  your
  history
  of
  VARs.
  Review
  VAR
  explanations

! Demonstrate
  how
  VAR
  corrective
  actions
  are
  tracked.

EAC
  and
  ETC

! How
  do
  you
  get
  ETC
  and
  EAC?

! How
  do
  you
  put
  EAC
  and
  ETC
  into
  the
  system?

! Does
  EAC
  and
  ETC
  go
  into
  MSProject
  as
  “%
  Complete”?
  Or
  does
  BCWR
  =
  ETC?

! How
  often
  can
  you
  change
  the
  EAC
  for
  your
  control
  accounts?

Material,
  Travel,
  ODC,
  Taxes

! What
  is
  the
  value
  of
  material,
  travel,
  ODCs,
  or
  taxes
  in
  your
  Control
  Account?

! What
  EV
  type
  do
  you
  use
  for
  material,
  travel,
  ODCs,
  or
  taxes?

! Demonstrate
  where
  material,
  travel,
  ODCs,
  or
  taxes
  are
  planned
  in
  your
  schedule.
  How
  was

BCWS
  determined
  and
  time-­‐phased?

! Is
  BCWP
  earned
  at
  receipt
  or
  usage?

! Demonstrate
  how
  you
  forecast
  receipt
  of
  material,
  travel,
  ODCs,
  or
  taxes.

! What
  is
  the
  process
  for
  Rejected
  material?
  Is
  BCWP
  decremented?

! Explain
  the
  process
  for
  Property
  management.

! Demonstrate
  your
  material
  receiving
  reports.

! Demonstrate
  your
  open
  commitments
  reports.

! Demonstrate
  your
  travel
  log

! Demonstrate
  an
  example
  of
  unit/lot
  costing.

! Demonstrate
  examples
  of
  price/usage
  variance
  analysis.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  8

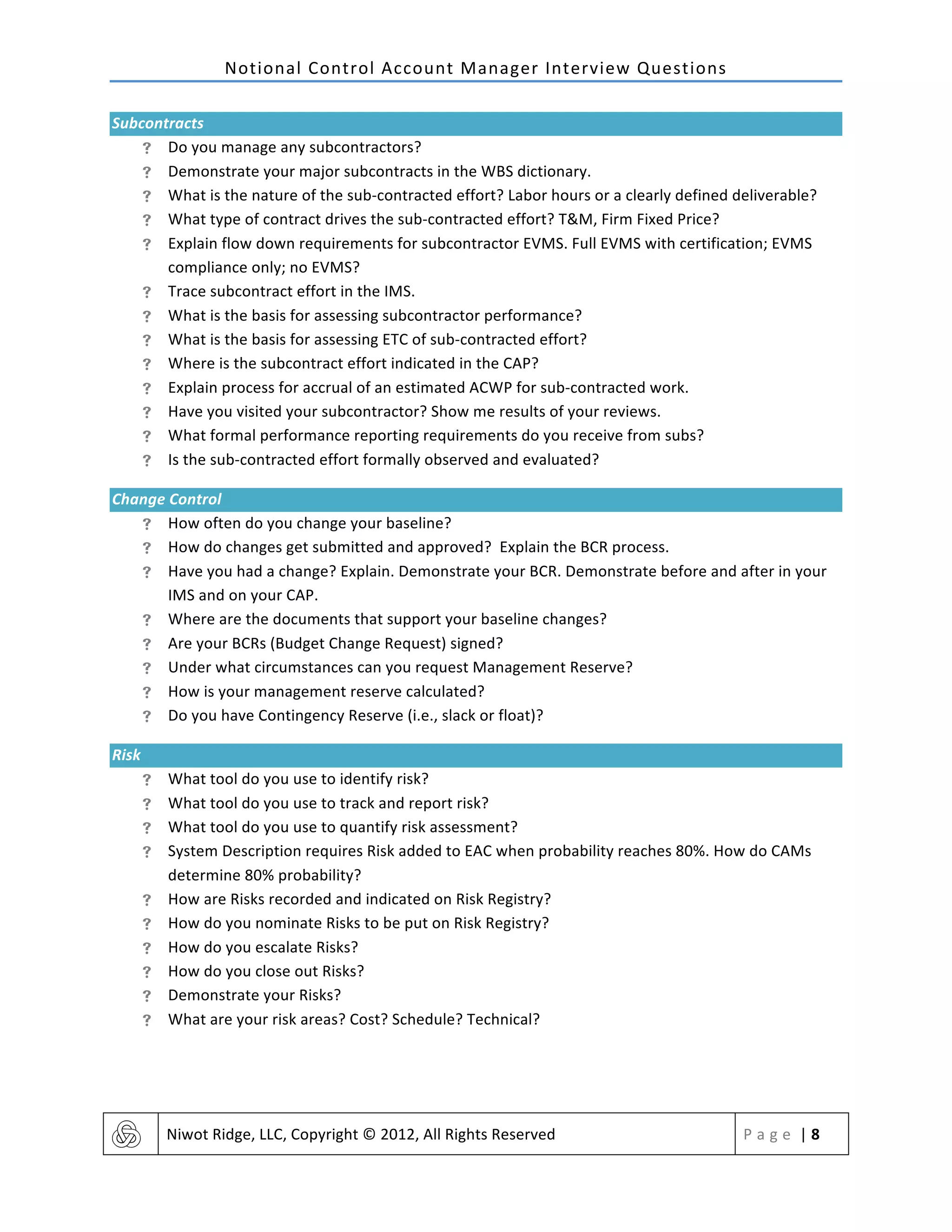

Subcontracts

! Do
  you
  manage
  any
  subcontractors?

! Demonstrate
  your
  major
  subcontracts
  in
  the
  WBS
  dictionary.

! What
  is
  the
  nature
  of
  the
  sub-­‐contracted
  effort?
  Labor
  hours
  or
  a
  clearly
  defined
  deliverable?

! What
  type
  of
  contract
  drives
  the
  sub-­‐contracted
  effort?
  T&M,
  Firm
  Fixed
  Price?

! Explain
  flow
  down
  requirements
  for
  subcontractor
  EVMS.
  Full
  EVMS
  with
  certification;
  EVMS

compliance
  only;
  no
  EVMS?

! Trace
  subcontract
  effort
  in
  the
  IMS.

! What
  is
  the
  basis
  for
  assessing
  subcontractor
  performance?

! What
  is
  the
  basis
  for
  assessing
  ETC
  of
  sub-­‐contracted
  effort?

! Where
  is
  the
  subcontract
  effort
  indicated
  in
  the
  CAP?

! Explain
  process
  for
  accrual
  of
  an
  estimated
  ACWP
  for
  sub-­‐contracted
  work.

! Have
  you
  visited
  your
  subcontractor?
  Show
  me
  results
  of
  your
  reviews.

! What
  formal
  performance
  reporting
  requirements
  do
  you
  receive
  from
  subs?

! Is
  the
  sub-­‐contracted
  effort
  formally
  observed
  and
  evaluated?

Change
  Control

! How
  often
  do
  you
  change
  your
  baseline?

! How
  do
  changes
  get
  submitted
  and
  approved?
  Explain
  the
  BCR
  process.

! Have
  you
  had
  a
  change?
  Explain.
  Demonstrate
  your
  BCR.
  Demonstrate
  before
  and
  after
  in
  your

IMS
  and
  on
  your
  CAP.

! Where
  are
  the
  documents
  that
  support
  your
  baseline
  changes?

! Are
  your
  BCRs
  (Budget
  Change
  Request)
  signed?

! Under
  what
  circumstances
  can
  you
  request
  Management
  Reserve?

! How
  is
  your
  management
  reserve
  calculated?

! Do
  you
  have
  Contingency
  Reserve
  (i.e.,
  slack
  or
  float)?

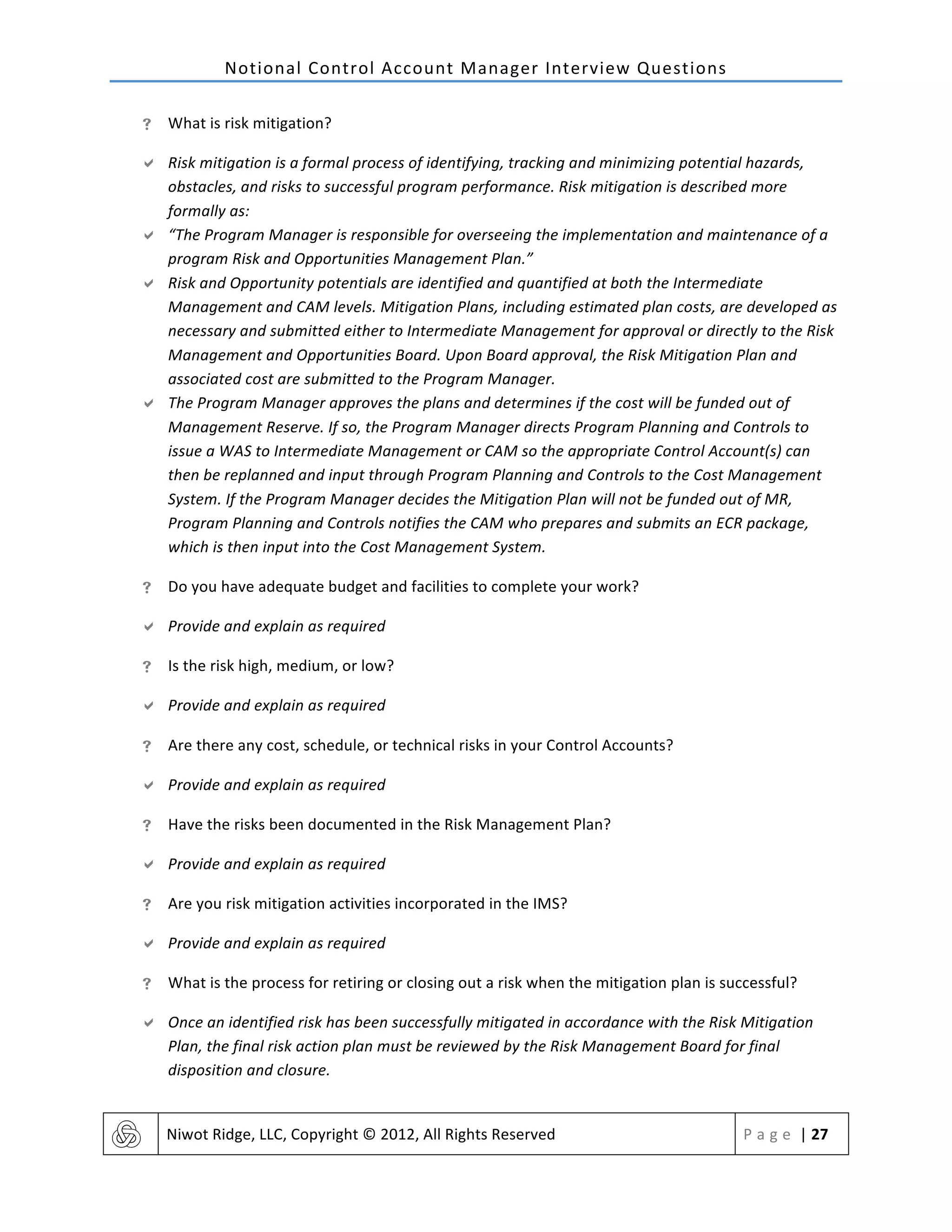

Risk

! What
  tool
  do
  you
  use
  to
  identify
  risk?

! What
  tool
  do
  you
  use
  to
  track
  and
  report
  risk?

! What
  tool
  do
  you
  use
  to
  quantify
  risk
  assessment?

! System
  Description
  requires
  Risk
  added
  to
  EAC
  when
  probability
  reaches
  80%.
  How
  do
  CAMs

determine
  80%
  probability?

! How
  are
  Risks
  recorded
  and
  indicated
  on
  Risk
  Registry?

! How
  do
  you
  nominate
  Risks
  to
  be
  put
  on
  Risk
  Registry?

! How
  do
  you
  escalate
  Risks?

! How
  do
  you
  close
  out
  Risks?

! Demonstrate
  your
  Risks?

! What
  are
  your
  risk
  areas?
  Cost?
  Schedule?
  Technical?

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  9

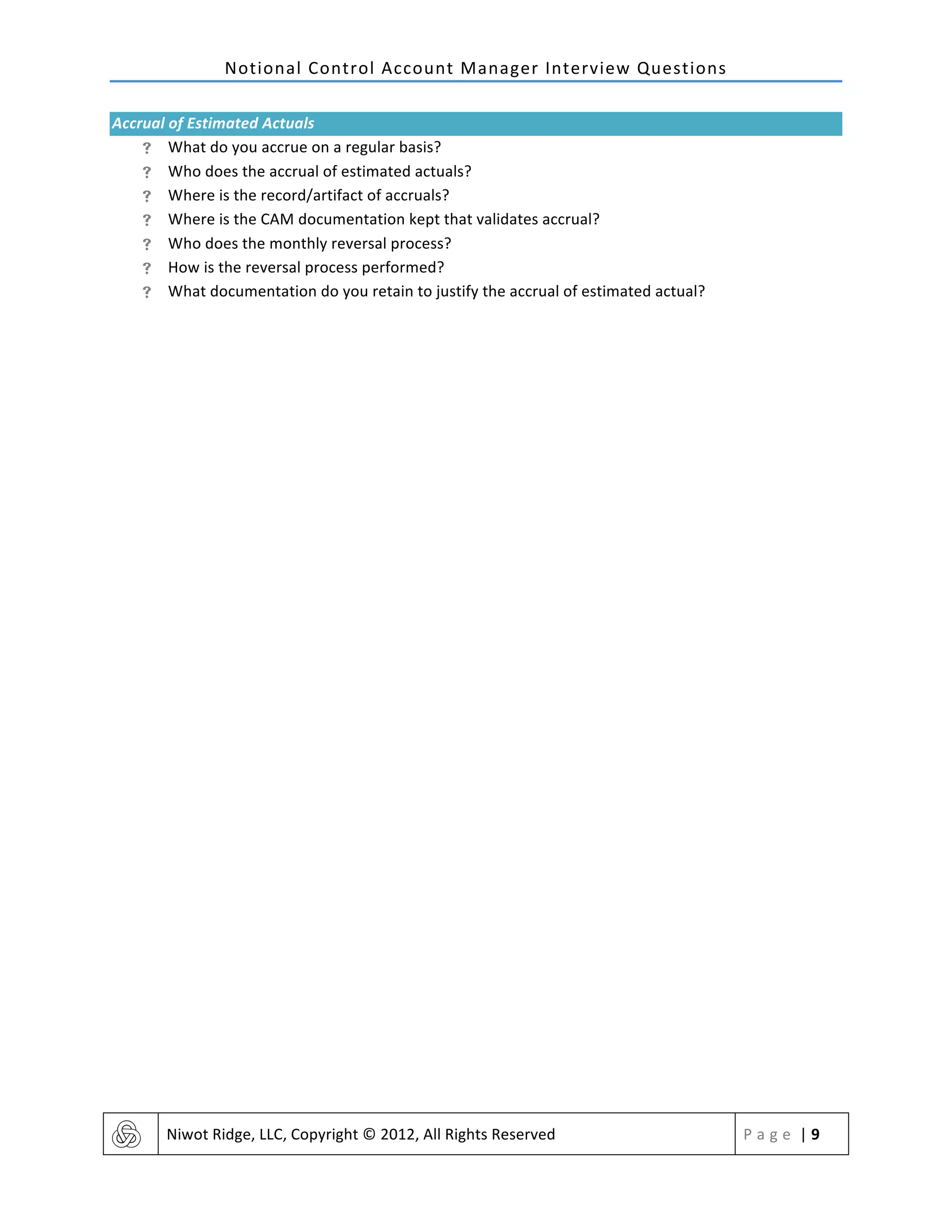

Accrual
  of
  Estimated
  Actuals

! What
  do
  you
  accrue
  on
  a
  regular
  basis?

! Who
  does
  the
  accrual
  of
  estimated
  actuals?

! Where
  is
  the
  record/artifact
  of
  accruals?

! Where
  is
  the
  CAM
  documentation
  kept
  that
  validates
  accrual?

! Who
  does
  the
  monthly
  reversal
  process?

! How
  is
  the
  reversal
  process
  performed?

! What
  documentation
  do
  you
  retain
  to
  justify
  the
  accrual
  of
  estimated
  actual?

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  10

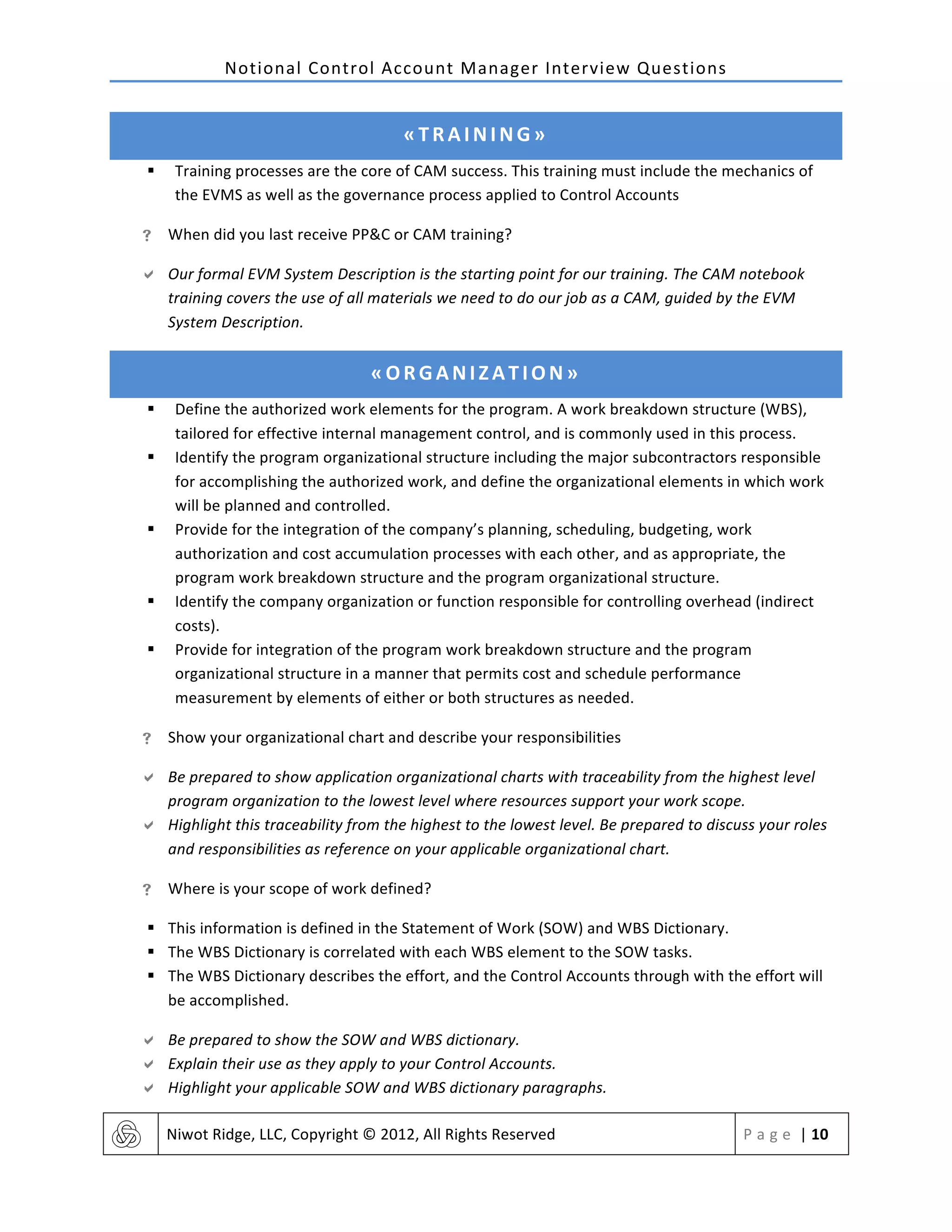

«TRAINING»

§ Training
  processes
  are
  the
  core
  of
  CAM
  success.
  This
  training
  must
  include
  the
  mechanics
  of

the
  EVMS
  as
  well
  as
  the
  governance
  process
  applied
  to
  Control
  Accounts

! When
  did
  you
  last
  receive
  PP&C
  or
  CAM
  training?

" Our
  formal
  EVM
  System
  Description
  is
  the
  starting
  point
  for
  our
  training.
  The
  CAM
  notebook

training
  covers
  the
  use
  of
  all
  materials
  we
  need
  to
  do
  our
  job
  as
  a
  CAM,
  guided
  by
  the
  EVM

System
  Description.

«ORGANIZATION»

§ Define
  the
  authorized
  work
  elements
  for
  the
  program.
  A
  work
  breakdown
  structure
  (WBS),

tailored
  for
  effective
  internal
  management
  control,
  and
  is
  commonly
  used
  in
  this
  process.

§ Identify
  the
  program
  organizational
  structure
  including
  the
  major
  subcontractors
  responsible

for
  accomplishing
  the
  authorized
  work,
  and
  define
  the
  organizational
  elements
  in
  which
  work

will
  be
  planned
  and
  controlled.

§ Provide
  for
  the
  integration
  of
  the
  company’s
  planning,
  scheduling,
  budgeting,
  work

authorization
  and
  cost
  accumulation
  processes
  with
  each
  other,
  and
  as
  appropriate,
  the

program
  work
  breakdown
  structure
  and
  the
  program
  organizational
  structure.

§ Identify
  the
  company
  organization
  or
  function
  responsible
  for
  controlling
  overhead
  (indirect

costs).

§ Provide
  for
  integration
  of
  the
  program
  work
  breakdown
  structure
  and
  the
  program

organizational
  structure
  in
  a
  manner
  that
  permits
  cost
  and
  schedule
  performance

measurement
  by
  elements
  of
  either
  or
  both
  structures
  as
  needed.

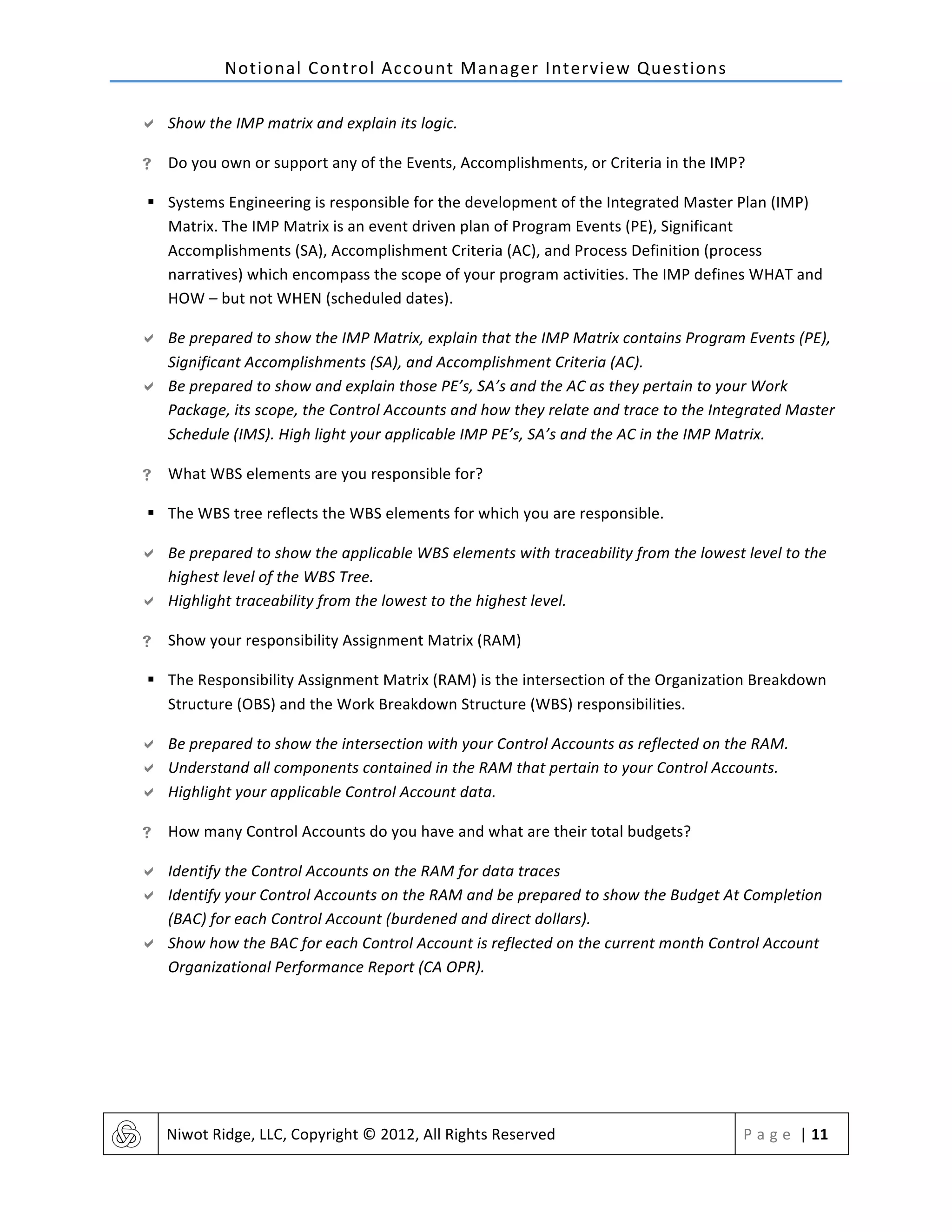

! Show
  your
  organizational
  chart
  and
  describe
  your
  responsibilities

" Be
  prepared
  to
  show
  application
  organizational
  charts
  with
  traceability
  from
  the
  highest
  level

program
  organization
  to
  the
  lowest
  level
  where
  resources
  support
  your
  work
  scope.

" Highlight
  this
  traceability
  from
  the
  highest
  to
  the
  lowest
  level.
  Be
  prepared
  to
  discuss
  your
  roles

and
  responsibilities
  as
  reference
  on
  your
  applicable
  organizational
  chart.

! Where
  is
  your
  scope
  of
  work
  defined?

§ This
  information
  is
  defined
  in
  the
  Statement
  of
  Work
  (SOW)
  and
  WBS
  Dictionary.

§ The
  WBS
  Dictionary
  is
  correlated
  with
  each
  WBS
  element
  to
  the
  SOW
  tasks.

§ The
  WBS
  Dictionary
  describes
  the
  effort,
  and
  the
  Control
  Accounts
  through
  with
  the
  effort
  will

be
  accomplished.

" Be
  prepared
  to
  show
  the
  SOW
  and
  WBS
  dictionary.

" Explain
  their
  use
  as
  they
  apply
  to
  your
  Control
  Accounts.

" Highlight
  your
  applicable
  SOW
  and
  WBS
  dictionary
  paragraphs.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  11

" Show
  the
  IMP
  matrix
  and
  explain
  its
  logic.

! Do
  you
  own
  or
  support
  any
  of
  the
  Events,
  Accomplishments,
  or
  Criteria
  in
  the
  IMP?

§ Systems
  Engineering
  is
  responsible
  for
  the
  development
  of
  the
  Integrated
  Master
  Plan
  (IMP)

Matrix.
  The
  IMP
  Matrix
  is
  an
  event
  driven
  plan
  of
  Program
  Events
  (PE),
  Significant

Accomplishments
  (SA),
  Accomplishment
  Criteria
  (AC),
  and
  Process
  Definition
  (process

narratives)
  which
  encompass
  the
  scope
  of
  your
  program
  activities.
  The
  IMP
  defines
  WHAT
  and

HOW
  –
  but
  not
  WHEN
  (scheduled
  dates).

" Be
  prepared
  to
  show
  the
  IMP
  Matrix,
  explain
  that
  the
  IMP
  Matrix
  contains
  Program
  Events
  (PE),

Significant
  Accomplishments
  (SA),
  and
  Accomplishment
  Criteria
  (AC).

" Be
  prepared
  to
  show
  and
  explain
  those
  PE’s,
  SA’s
  and
  the
  AC
  as
  they
  pertain
  to
  your
  Work

Package,
  its
  scope,
  the
  Control
  Accounts
  and
  how
  they
  relate
  and
  trace
  to
  the
  Integrated
  Master

Schedule
  (IMS).
  High
  light
  your
  applicable
  IMP
  PE’s,
  SA’s
  and
  the
  AC
  in
  the
  IMP
  Matrix.

! What
  WBS
  elements
  are
  you
  responsible
  for?

§ The
  WBS
  tree
  reflects
  the
  WBS
  elements
  for
  which
  you
  are
  responsible.

" Be
  prepared
  to
  show
  the
  applicable
  WBS
  elements
  with
  traceability
  from
  the
  lowest
  level
  to
  the

highest
  level
  of
  the
  WBS
  Tree.

" Highlight
  traceability
  from
  the
  lowest
  to
  the
  highest
  level.

! Show
  your
  responsibility
  Assignment
  Matrix
  (RAM)

§ The
  Responsibility
  Assignment
  Matrix
  (RAM)
  is
  the
  intersection
  of
  the
  Organization
  Breakdown

Structure
  (OBS)
  and
  the
  Work
  Breakdown
  Structure
  (WBS)
  responsibilities.

" Be
  prepared
  to
  show
  the
  intersection
  with
  your
  Control
  Accounts
  as
  reflected
  on
  the
  RAM.

" Understand
  all
  components
  contained
  in
  the
  RAM
  that
  pertain
  to
  your
  Control
  Accounts.

" Highlight
  your
  applicable
  Control
  Account
  data.

! How
  many
  Control
  Accounts
  do
  you
  have
  and
  what
  are
  their
  total
  budgets?

" Identify
  the
  Control
  Accounts
  on
  the
  RAM
  for
  data
  traces

" Identify
  your
  Control
  Accounts
  on
  the
  RAM
  and
  be
  prepared
  to
  show
  the
  Budget
  At
  Completion

(BAC)
  for
  each
  Control
  Account
  (burdened
  and
  direct
  dollars).

" Show
  how
  the
  BAC
  for
  each
  Control
  Account
  is
  reflected
  on
  the
  current
  month
  Control
  Account

Organizational
  Performance
  Report
  (CA
  OPR).

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  12

«WORK
  AUTHORIZATION»

§ Maintaining
  the
  proper
  sequence
  of
  work
  package
  execution
  is
  critical
  to
  the
  generation
  of

credible
  Earned
  Value
  Management
  data.
  Work
  preformed
  out
  of
  sequence
  either
  has
  not

budget
  assigned
  for
  that
  period
  of
  performance
  or
  has
  budget
  assigned
  but
  no
  work
  be

performed
  or
  some
  combination.

§ In
  both
  cases
  the
  Earned
  Value
  number
  cannot
  represent
  the
  proper
  progress
  of
  the
  project.

! What
  authorizes
  you
  to
  begin
  your
  work?
  Are
  the
  appropriate
  signatures
  present?

§ Operation
  Directives
  (Program
  Directives
  or
  other
  firm
  dependence
  names)
  provide
  the
  Program

with
  the
  Authorization
  to
  Proceed
  (ATP).

" Be
  prepared
  to
  show
  this
  OD
  (PD)
  as
  well
  as
  any
  other
  OD’s
  (PD’s)
  that
  authorize
  contract

changes
  which
  impact
  your
  Control
  Accounts.
  Identify
  appropriate
  approval
  signatures.

" The
  work
  authorization
  process
  triggers
  the
  planning,
  scheduling,
  budgeting,
  and
  performance
  of

work
  form
  the
  total
  program
  level
  through
  the
  responsible
  organizational
  structure
  to
  the

Control
  Account
  level.

" The
  Work
  Authorization
  process
  begins
  with
  an
  OD
  (PD)
  issues
  by
  the
  Contracts
  Organization.

The
  OD
  (PD)
  authorizes
  the
  program
  to
  issues
  a
  Work
  Authorization
  Document
  (WAD)
  that

defines
  all
  authorized
  work
  elements
  on
  the
  program.

" Once
  the
  OD
  (PD)
  has
  been
  issued,
  authorizing
  work
  to
  commence
  on
  a
  contract
  or
  contract

change,
  all
  program
  work
  subsequently
  must
  be
  authorized
  or
  directed
  by
  a
  WAD.

! Identify
  the
  key
  elements
  on
  the
  Work
  Authorization
  Document
  (WAD)

" The
  WAD
  contains
  the
  following
  key
  elements

" Scope
  of
  the
  work
  to
  be
  performed
  in
  terms
  of
  activities
  and
  deliverables

" Schedule
  of
  the
  work
  packages
  that
  performance
  the
  work

" Budget
  for
  each
  Work
  Package

" Period
  of
  Performance
  for
  the
  collective
  Work
  Packages

" Approval
  processes
  for
  this
  work
  and
  the
  release
  of
  the
  funding

! Show
  how
  you
  can
  trace
  the
  key
  work
  elements
  on
  the
  latest
  approved
  WAD?

" The
  following
  key
  elements
  of
  the
  latest
  approved
  WAD
  are:

" Scope
  to
  SOW/WBS
  Dictionary
  or
  equivalent

" Budget
  on
  WAD
  to
  the
  Cost
  Control
  System
  –
  the
  Budget
  Distribution
  Reports

" Validate
  that
  the
  WAD
  is
  consistent
  with
  the
  period
  performance
  on
  the
  Integrated
  Master

Schedule
  (IMS),
  baseline
  date
  and
  revision
  number

" Provider
  a
  description
  of
  each
  of
  these
  documents
  and
  the
  processes
  used
  to
  create
  and

management
  them

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  13

! Does
  the
  Control
  Account
  period
  of
  performance
  on
  the
  WAD
  match
  the
  start
  and
  end
  dates
  for

the
  time
  phased
  resources
  in
  your
  Control
  Account
  Plan?

" Be
  prepared
  to
  trace
  the
  period
  of
  performance
  for
  each
  Control
  Account
  budget
  referenced
  on

the
  current
  approved
  WAD
  to
  the
  applicable
  IMS
  time–phases
  Control
  Account
  /
  task
  period
  of

performance.
  Ensure
  all
  dates
  can
  be
  reconciled.

! Do
  the
  Control
  Account
  periods
  of
  performance
  match
  the
  schedule
  time
  spans
  in
  the
  IMS?

" Be
  prepared
  to
  trace
  the
  period
  of
  performance
  for
  each
  Control
  Account
  budget
  referenced
  on

the
  most
  current
  approved
  WAD
  to
  the
  applicable
  IMS
  time–phased
  Control
  Account
  /
  task

period
  of
  performance.
  Ensure
  all
  dates
  reconcile.

" Be
  prepared
  to
  justify
  the
  budget
  and
  the
  Earned
  Value
  methods
  selected.

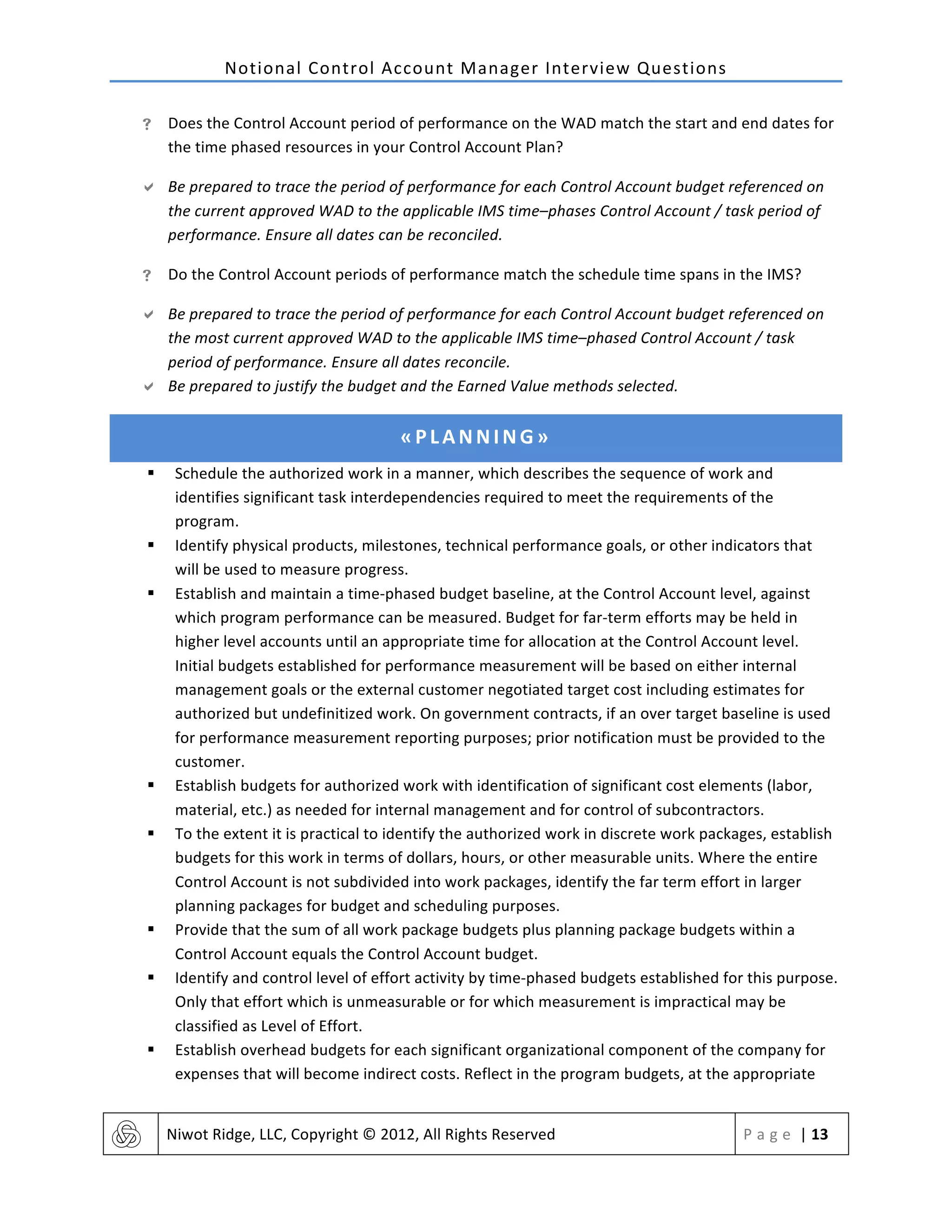

«PLANNING»

§ Schedule
  the
  authorized
  work
  in
  a
  manner,
  which
  describes
  the
  sequence
  of
  work
  and

identifies
  significant
  task
  interdependencies
  required
  to
  meet
  the
  requirements
  of
  the

program.

§ Identify
  physical
  products,
  milestones,
  technical
  performance
  goals,
  or
  other
  indicators
  that

will
  be
  used
  to
  measure
  progress.

§ Establish
  and
  maintain
  a
  time-­‐phased
  budget
  baseline,
  at
  the
  Control
  Account
  level,
  against

which
  program
  performance
  can
  be
  measured.

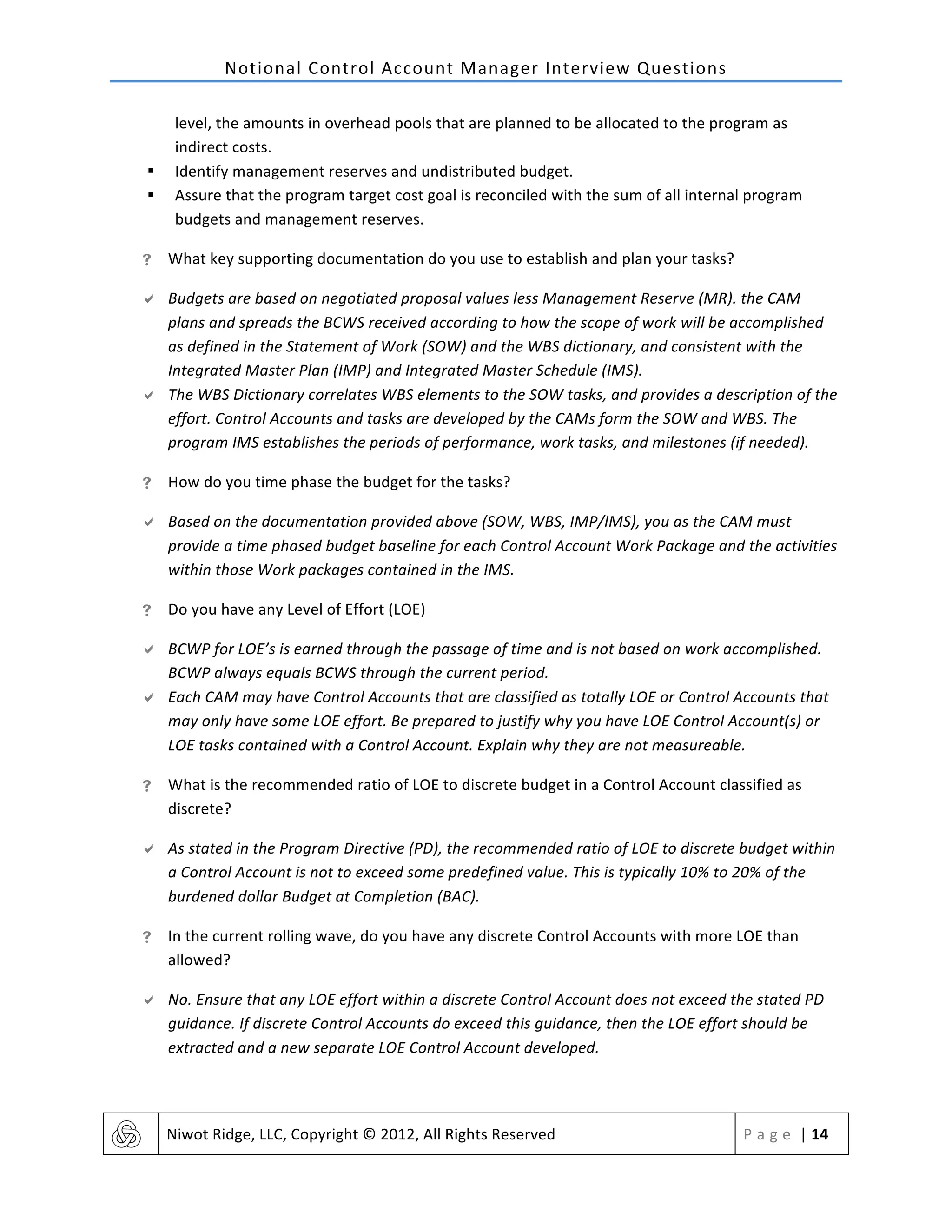

  Budget
  for
  far-­‐term
  efforts
  may
  be
  held
  in

higher
  level
  accounts
  until
  an
  appropriate
  time
  for
  allocation
  at
  the
  Control
  Account
  level.

Initial
  budgets
  established
  for
  performance
  measurement
  will
  be
  based
  on
  either
  internal

management
  goals
  or
  the
  external
  customer
  negotiated
  target
  cost
  including
  estimates
  for

authorized
  but
  undefinitized
  work.
  On
  government
  contracts,
  if
  an
  over
  target
  baseline
  is
  used

for
  performance
  measurement
  reporting
  purposes;
  prior
  notification
  must
  be
  provided
  to
  the

customer.

§ Establish
  budgets
  for
  authorized
  work
  with
  identification
  of
  significant
  cost
  elements
  (labor,

material,
  etc.)
  as
  needed
  for
  internal
  management
  and
  for
  control
  of
  subcontractors.

§ To
  the
  extent
  it
  is
  practical
  to
  identify
  the
  authorized
  work
  in
  discrete
  work
  packages,
  establish

budgets
  for
  this
  work
  in
  terms
  of
  dollars,
  hours,
  or
  other
  measurable
  units.
  Where
  the
  entire

Control
  Account
  is
  not
  subdivided
  into
  work
  packages,
  identify
  the
  far
  term
  effort
  in
  larger

planning
  packages
  for
  budget
  and
  scheduling
  purposes.

§ Provide
  that
  the
  sum
  of
  all
  work
  package
  budgets
  plus
  planning
  package
  budgets
  within
  a

Control
  Account
  equals
  the
  Control
  Account
  budget.

§ Identify
  and
  control
  level
  of
  effort
  activity
  by
  time-­‐phased
  budgets
  established
  for
  this
  purpose.

Only
  that
  effort
  which
  is
  unmeasurable
  or
  for
  which
  measurement
  is
  impractical
  may
  be

classified
  as
  Level
  of
  Effort.

§ Establish
  overhead
  budgets
  for
  each
  significant
  organizational
  component
  of
  the
  company
  for

expenses
  that
  will
  become
  indirect
  costs.
  Reflect
  in
  the
  program
  budgets,
  at
  the
  appropriate

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  14

level,
  the
  amounts
  in
  overhead
  pools
  that
  are
  planned
  to
  be
  allocated
  to
  the
  program
  as

indirect
  costs.

§ Identify
  management
  reserves
  and
  undistributed
  budget.

§ Assure
  that
  the
  program
  target
  cost
  goal
  is
  reconciled
  with
  the
  sum
  of
  all
  internal
  program

budgets
  and
  management
  reserves.

! What
  key
  supporting
  documentation
  do
  you
  use
  to
  establish
  and
  plan
  your
  tasks?

" Budgets
  are
  based
  on
  negotiated
  proposal
  values
  less
  Management
  Reserve
  (MR).
  the
  CAM

plans
  and
  spreads
  the
  BCWS
  received
  according
  to
  how
  the
  scope
  of
  work
  will
  be
  accomplished

as
  defined
  in
  the
  Statement
  of
  Work
  (SOW)
  and
  the
  WBS
  dictionary,
  and
  consistent
  with
  the

Integrated
  Master
  Plan
  (IMP)
  and
  Integrated
  Master
  Schedule
  (IMS).

" The
  WBS
  Dictionary
  correlates
  WBS
  elements
  to
  the
  SOW
  tasks,
  and
  provides
  a
  description
  of
  the

effort.
  Control
  Accounts
  and
  tasks
  are
  developed
  by
  the
  CAMs
  form
  the
  SOW
  and
  WBS.
  The

program
  IMS
  establishes
  the
  periods
  of
  performance,
  work
  tasks,
  and
  milestones
  (if
  needed).

! How
  do
  you
  time
  phase
  the
  budget
  for
  the
  tasks?

" Based
  on
  the
  documentation
  provided
  above
  (SOW,
  WBS,
  IMP/IMS),
  you
  as
  the
  CAM
  must

provide
  a
  time
  phased
  budget
  baseline
  for
  each
  Control
  Account
  Work
  Package
  and
  the
  activities

within
  those
  Work
  packages
  contained
  in
  the
  IMS.

! Do
  you
  have
  any
  Level
  of
  Effort
  (LOE)

" BCWP
  for
  LOE’s
  is
  earned
  through
  the
  passage
  of
  time
  and
  is
  not
  based
  on
  work
  accomplished.

BCWP
  always
  equals
  BCWS
  through
  the
  current
  period.

" Each
  CAM
  may
  have
  Control
  Accounts
  that
  are
  classified
  as
  totally
  LOE
  or
  Control
  Accounts
  that

may
  only
  have
  some
  LOE
  effort.
  Be
  prepared
  to
  justify
  why
  you
  have
  LOE
  Control
  Account(s)
  or

LOE
  tasks
  contained
  with
  a
  Control
  Account.
  Explain
  why
  they
  are
  not
  measureable.

! What
  is
  the
  recommended
  ratio
  of
  LOE
  to
  discrete
  budget
  in
  a
  Control
  Account
  classified
  as

discrete?

" As
  stated
  in
  the
  Program
  Directive
  (PD),
  the
  recommended
  ratio
  of
  LOE
  to
  discrete
  budget
  within

a
  Control
  Account
  is
  not
  to
  exceed
  some
  predefined
  value.
  This
  is
  typically
  10%
  to
  20%
  of
  the

burdened
  dollar
  Budget
  at
  Completion
  (BAC).

! In
  the
  current
  rolling
  wave,
  do
  you
  have
  any
  discrete
  Control
  Accounts
  with
  more
  LOE
  than

allowed?

" No.
  Ensure
  that
  any
  LOE
  effort
  within
  a
  discrete
  Control
  Account
  does
  not
  exceed
  the
  stated
  PD

guidance.
  If
  discrete
  Control
  Accounts
  do
  exceed
  this
  guidance,
  then
  the
  LOE
  effort
  should
  be

extracted
  and
  a
  new
  separate
  LOE
  Control
  Account
  developed.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  15

! Are
  all
  your
  LOE
  Control
  Accounts
  detail
  planned
  through
  completion?

" Yes.
  All
  LOE
  effort
  has
  been
  planned
  through
  completion

" When
  the
  current
  program
  has
  multiple
  rolling
  wave
  periods
  –
  Discrete
  work
  scope
  must
  be

planned
  through
  the
  current
  rolling
  wave
  period.
  Future
  rolling
  wave
  periods
  must
  be
  contained

in
  discrete
  planning
  packages.

" These
  must
  be
  “detail
  planned”
  at
  least
  30
  days
  prior
  to
  the
  start
  of
  the
  next
  rolling
  wave
  period

of
  performance.

! Do
  you
  have
  the
  current
  approved
  version
  of
  the
  Integrated
  Master
  Schedule
  and
  know
  how

your
  work
  packages
  and
  planning
  packages
  support
  the
  major
  program
  events
  and
  milestones?

" Be
  prepared
  to
  trace
  the
  period
  of
  performance
  for
  each
  Control
  Account
  work
  package
  and
  its

work
  activities
  references
  in
  the
  Control
  Account
  Plan
  (CAP)
  to
  the
  applicable
  Program
  Events

referenced
  in
  the
  program
  Integrate
  Master
  Schedule
  or
  master
  Milestones
  contained
  in
  the

Program
  IMS.

" Ensure
  all
  dates
  reconcile.

" Be
  able
  to
  justify
  the
  budget
  and
  Earned
  Value
  methods
  selected
  for
  each
  Work
  Package
  and

Planning
  Package.

! Is
  the
  task
  /
  milestone
  exit
  criteria
  clearly
  defined?
  Either
  separately
  documented
  or
  embedded

in
  the
  task
  description.

" A
  Task
  Entry
  and
  Exit
  (TEC)
  must
  be
  established
  for
  each
  discrete
  work
  package.
  If
  the
  task

descriptions
  in
  the
  IMS
  are
  at
  such
  a
  detailed
  level
  that
  clearly
  defines
  the
  exit
  criteria
  closure,

then
  no
  additional
  exit
  criteria
  documentation
  is
  required.

" Be
  prepared
  to
  show
  and
  explain
  the
  TECs
  referenced
  on
  the
  IMS
  that
  support
  your
  Control

Account
  tasks.
  Also
  be
  prepared
  to
  show
  the
  entrance
  and
  exit
  criteria
  for
  each
  discrete
  Control

Account
  work
  package.
  Explain
  how
  they
  were
  derived.

! For
  the
  current
  planning
  period,
  what
  is
  your
  total
  LOE
  versus
  Discrete
  in
  dollars
  and
  hours?

" Be
  prepared
  to
  identify
  the
  Budget
  At
  Completion
  (BAC)
  in
  burdened
  dollars
  and
  hours
  for
  all

current
  LOE
  effort
  contained
  in
  your
  Control
  Accounts.
  Divide
  the
  dollar
  amount
  by
  the
  total
  of
  all

current
  open
  Control
  Accounts
  Budget
  At
  Completion.
  This
  will
  provide
  the
  LOE
  versus
  Discrete

percent
  ratio.

! Trace
  a
  task(s)
  from
  your
  IMS
  to
  your
  Control
  Account
  Plan
  (CAP)
  for
  both
  total
  and
  time
  phase

resources

" Be
  prepared
  to
  trace
  the
  period
  of
  performance
  for
  each
  Control
  Account
  budget
  referenced
  on

the
  current
  approved
  WAD
  to
  the
  applicable
  IMS
  time
  phased
  Control
  Account
  or
  task
  period
  of

performance.
  Ensure
  all
  dates
  and
  resources
  allocated
  reconcile
  with
  the
  current
  rolling
  wave

period.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  16

! Show
  an
  example
  that
  you
  have
  predecessors
  and
  successors
  identified
  within
  your
  organization

or
  Integrated
  Product
  Team
  (IPT)
  and
  between
  other
  organizations
  or
  IPTs.

" A
  series
  or
  network
  of
  activities
  which
  are
  required
  to
  accomplish
  a
  task
  are
  linked
  together
  with

logical
  predecessors
  and
  successor
  relationships
  must
  provide
  for
  the
  identification
  of
  the
  critical

path(s).
  Each
  discrete
  activity
  has
  an
  output
  predecessor
  which
  is
  linked
  to
  an
  input
  or
  successor

activity.
  This
  defining
  activity
  relationship
  enables
  the
  process
  to
  assess
  progress
  within
  the

network.
  Be
  prepared
  to
  show
  an
  example
  of
  how
  your
  predecessor/successor
  activities
  are

indentified
  with
  your
  organization
  or
  Integrated
  Product
  Team
  (IPT)
  are
  dependent
  or
  linked

between
  other
  organizations
  or
  IPTs
  predecessors
  and
  successor
  activities.
  Program
  Planning

and
  Controls
  can
  provide
  predecessor
  and
  successor
  reports
  to
  help
  clarify
  your
  response.

! If
  you
  are
  responsible
  for
  any
  major
  subcontracts
  or
  intercompany
  work
  transfers,
  where
  is
  it

reflected
  in
  your
  IMS?

" Be
  prepared
  to
  show
  the
  major
  subcontracting
  and
  inter-­‐company
  work
  transfer
  authorization

(IWTA)
  effort
  reflected
  in
  the
  IMS
  and
  how
  your
  tasks
  support
  the
  major
  events
  and
  milestones.

! If
  you
  are
  responsible
  for
  any
  high
  value
  material,
  where
  is
  it
  reflected
  in
  your
  IMS?

" Be
  prepared
  to
  show
  any
  high
  value
  material
  effort
  reflected
  on
  the
  IMS.
  Explain
  how
  your
  tasks

support
  the
  major
  events
  and
  milestones.

! Are
  any
  of
  your
  tasks
  on
  the
  program
  or
  IPT
  critical
  path?

" If
  yes,
  be
  prepared
  to
  show
  which
  tasks
  are
  contained
  on
  the
  critical
  path.

" The
  critical
  path
  is
  defined
  as
  the
  longest
  computed
  path
  through
  a
  program
  schedule
  network.

The
  critical
  path
  represents
  scheduled
  activities
  with
  the
  highest
  risk
  and
  the
  least
  margin
  for

error.

! Do
  you
  have
  any
  special
  requirements
  because
  you
  are
  on
  the
  critical
  path?

" Yes.
  Any
  schedule
  activities
  that
  are
  contained
  on
  the
  critical
  path
  will
  have
  increased

management
  visibility
  and
  must
  be
  statused
  weekly
  for
  impacts
  to
  the
  program.

! What
  are
  the
  most
  critical
  areas
  of
  your
  work
  effort?

" Identify
  areas
  in
  your
  work
  scope
  which
  you
  consider
  the
  most
  critical.
  Explain
  why.

! What
  is
  your
  schedule
  reserve?

§ Schedule
  reserve
  is
  generally
  expressed
  as
  float.
  Float
  is
  the
  amount
  of
  time
  an
  activity
  can
  slip

before
  it
  affects
  another
  activity
  finish
  date.
  It
  is
  the
  difference
  between
  when
  the
  activity
  can

happen
  and
  when
  the
  activity
  must
  happen.
  Positive
  float
  (reserve)
  should
  be
  conserved
  and

managed.
  Negative
  float
  indicates
  activities
  that
  must
  be
  reworked
  to
  meet
  the
  event
  schedule.

Events
  may
  be
  milestones
  or
  deliverables.
  If
  the
  total
  float
  is
  less
  than
  or
  equal
  to
  zero
  (0),
  then

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |

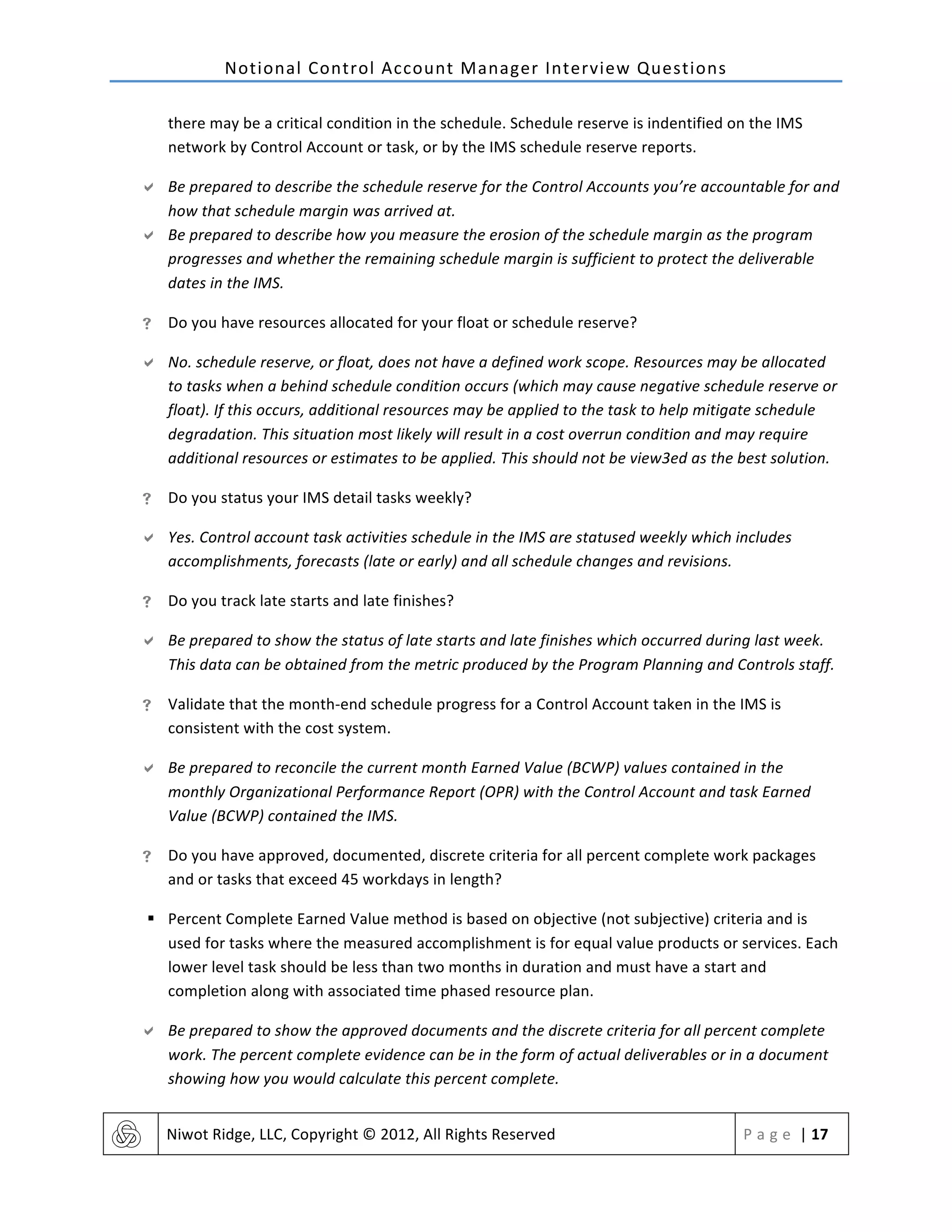

  17

there
  may
  be
  a
  critical
  condition
  in
  the
  schedule.
  Schedule
  reserve
  is
  indentified
  on
  the
  IMS

network
  by
  Control
  Account
  or
  task,
  or
  by
  the
  IMS
  schedule
  reserve
  reports.

" Be
  prepared
  to
  describe
  the
  schedule
  reserve
  for
  the
  Control
  Accounts
  you’re
  accountable
  for
  and

how
  that
  schedule
  margin
  was
  arrived
  at.

" Be
  prepared
  to
  describe
  how
  you
  measure
  the
  erosion
  of
  the
  schedule
  margin
  as
  the
  program

progresses
  and
  whether
  the
  remaining
  schedule
  margin
  is
  sufficient
  to
  protect
  the
  deliverable

dates
  in
  the
  IMS.

! Do
  you
  have
  resources
  allocated
  for
  your
  float
  or
  schedule
  reserve?

" No.
  schedule
  reserve,
  or
  float,
  does
  not
  have
  a
  defined
  work
  scope.
  Resources
  may
  be
  allocated

to
  tasks
  when
  a
  behind
  schedule
  condition
  occurs
  (which
  may
  cause
  negative
  schedule
  reserve
  or

float).
  If
  this
  occurs,
  additional
  resources
  may
  be
  applied
  to
  the
  task
  to
  help
  mitigate
  schedule

degradation.
  This
  situation
  most
  likely
  will
  result
  in
  a
  cost
  overrun
  condition
  and
  may
  require

additional
  resources
  or
  estimates
  to
  be
  applied.
  This
  should
  not
  be
  view3ed
  as
  the
  best
  solution.

! Do
  you
  status
  your
  IMS
  detail
  tasks
  weekly?

" Yes.
  Control
  account
  task
  activities
  schedule
  in
  the
  IMS
  are
  statused
  weekly
  which
  includes

accomplishments,
  forecasts
  (late
  or
  early)
  and
  all
  schedule
  changes
  and
  revisions.

! Do
  you
  track
  late
  starts
  and
  late
  finishes?

" Be
  prepared
  to
  show
  the
  status
  of
  late
  starts
  and
  late
  finishes
  which
  occurred
  during
  last
  week.

This
  data
  can
  be
  obtained
  from
  the
  metric
  produced
  by
  the
  Program
  Planning
  and
  Controls
  staff.

! Validate
  that
  the
  month-­‐end
  schedule
  progress
  for
  a
  Control
  Account
  taken
  in
  the
  IMS
  is

consistent
  with
  the
  cost
  system.

" Be
  prepared
  to
  reconcile
  the
  current
  month
  Earned
  Value
  (BCWP)
  values
  contained
  in
  the

monthly
  Organizational
  Performance
  Report
  (OPR)
  with
  the
  Control
  Account
  and
  task
  Earned

Value
  (BCWP)
  contained
  the
  IMS.

! Do
  you
  have
  approved,
  documented,
  discrete
  criteria
  for
  all
  percent
  complete
  work
  packages

and
  or
  tasks
  that
  exceed
  45
  workdays
  in
  length?

§ Percent
  Complete
  Earned
  Value
  method
  is
  based
  on
  objective
  (not
  subjective)
  criteria
  and
  is

used
  for
  tasks
  where
  the
  measured
  accomplishment
  is
  for
  equal
  value
  products
  or
  services.
  Each

lower
  level
  task
  should
  be
  less
  than
  two
  months
  in
  duration
  and
  must
  have
  a
  start
  and

completion
  along
  with
  associated
  time
  phased
  resource
  plan.

" Be
  prepared
  to
  show
  the
  approved
  documents
  and
  the
  discrete
  criteria
  for
  all
  percent
  complete

work.

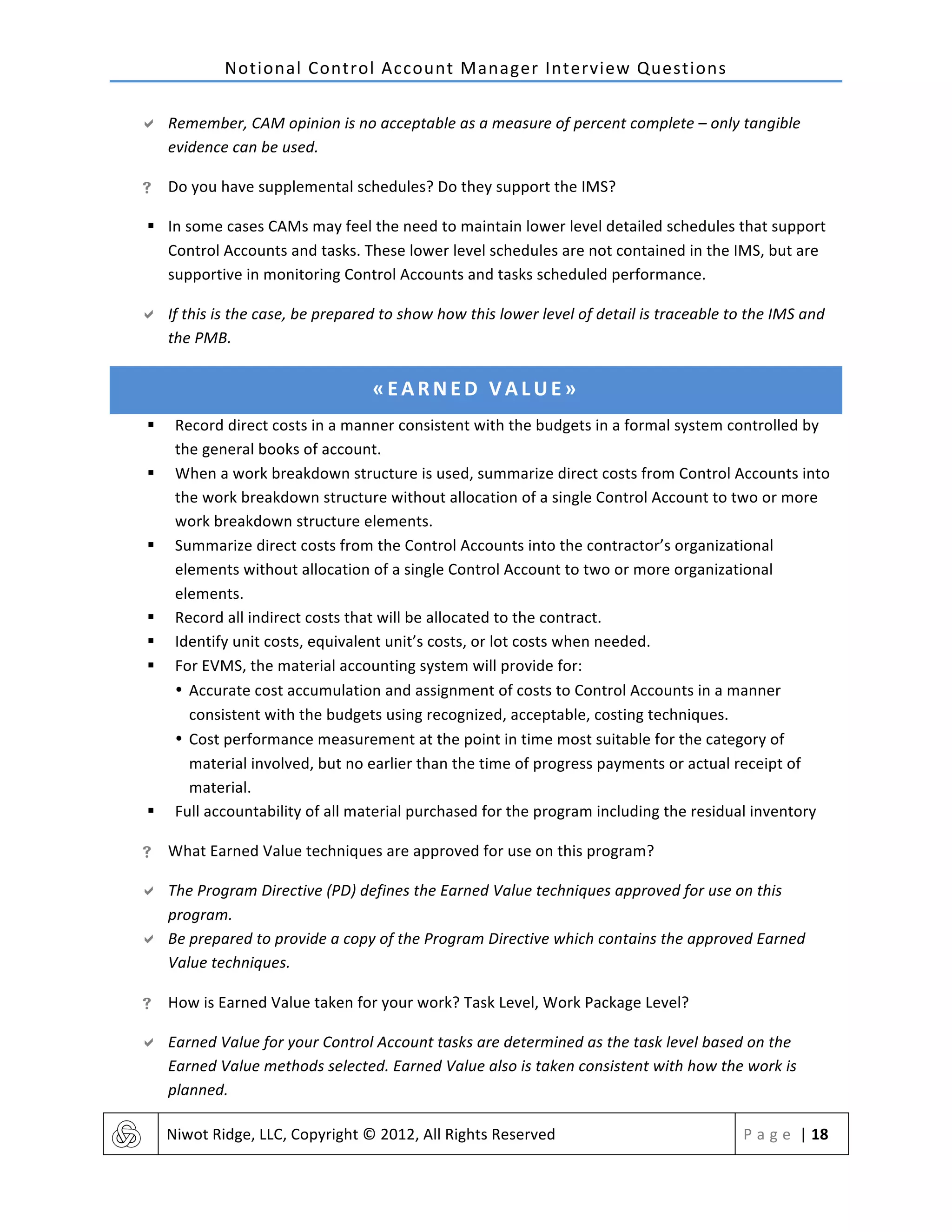

  The
  percent
  complete
  evidence
  can
  be
  in
  the
  form
  of
  actual
  deliverables
  or
  in
  a
  document

showing
  how
  you
  would
  calculate
  this
  percent
  complete.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  18

" Remember,
  CAM
  opinion
  is
  no
  acceptable
  as
  a
  measure
  of
  percent
  complete
  –
  only
  tangible

evidence
  can
  be
  used.

! Do
  you
  have
  supplemental
  schedules?
  Do
  they
  support
  the
  IMS?

§ In
  some
  cases
  CAMs
  may
  feel
  the
  need
  to
  maintain
  lower
  level
  detailed
  schedules
  that
  support

Control
  Accounts
  and
  tasks.
  These
  lower
  level
  schedules
  are
  not
  contained
  in
  the
  IMS,
  but
  are

supportive
  in
  monitoring
  Control
  Accounts
  and
  tasks
  scheduled
  performance.

" If
  this
  is
  the
  case,
  be
  prepared
  to
  show
  how
  this
  lower
  level
  of
  detail
  is
  traceable
  to
  the
  IMS
  and

the
  PMB.

«EARNED
  VALUE»

§ Record
  direct
  costs
  in
  a
  manner
  consistent
  with
  the
  budgets
  in
  a
  formal
  system
  controlled
  by

the
  general
  books
  of
  account.

§ When
  a
  work
  breakdown
  structure
  is
  used,
  summarize
  direct
  costs
  from
  Control
  Accounts
  into

the
  work
  breakdown
  structure
  without
  allocation
  of
  a
  single
  Control
  Account
  to
  two
  or
  more

work
  breakdown
  structure
  elements.

§ Summarize
  direct
  costs
  from
  the
  Control
  Accounts
  into
  the
  contractor’s
  organizational

elements
  without
  allocation
  of
  a
  single
  Control
  Account
  to
  two
  or
  more
  organizational

elements.

§ Record
  all
  indirect
  costs
  that
  will
  be
  allocated
  to
  the
  contract.

§ Identify
  unit
  costs,
  equivalent
  unit’s
  costs,
  or
  lot
  costs
  when
  needed.

§ For
  EVMS,
  the
  material
  accounting
  system
  will
  provide
  for:

• Accurate
  cost
  accumulation
  and
  assignment
  of
  costs
  to
  Control
  Accounts
  in
  a
  manner

consistent
  with
  the
  budgets
  using
  recognized,
  acceptable,
  costing
  techniques.

• Cost
  performance
  measurement
  at
  the
  point
  in
  time
  most
  suitable
  for
  the
  category
  of

material
  involved,
  but
  no
  earlier
  than
  the
  time
  of
  progress
  payments
  or
  actual
  receipt
  of

material.

§ Full
  accountability
  of
  all
  material
  purchased
  for
  the
  program
  including
  the
  residual
  inventory

! What
  Earned
  Value
  techniques
  are
  approved
  for
  use
  on
  this
  program?

" The
  Program
  Directive
  (PD)
  defines
  the
  Earned
  Value
  techniques
  approved
  for
  use
  on
  this

program.

" Be
  prepared
  to
  provide
  a
  copy
  of
  the
  Program
  Directive
  which
  contains
  the
  approved
  Earned

Value
  techniques.

! How
  is
  Earned
  Value
  taken
  for
  your
  work?
  Task
  Level,
  Work
  Package
  Level?

" Earned
  Value
  for
  your
  Control
  Account
  tasks
  are
  determined
  as
  the
  task
  level
  based
  on
  the

Earned
  Value
  methods
  selected.
  Earned
  Value
  also
  is
  taken
  consistent
  with
  how
  the
  work
  is

planned.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  19

" Be
  prepared
  to
  discuss
  each
  Control
  Account
  task
  Earned
  Value
  technique
  and
  the
  method

selected
  for
  determining
  earned
  Value.

! Is
  the
  Earned
  Value
  technique
  or
  method
  chosen
  appropriately
  for
  the
  specific
  task
  or
  work

package?

" Be
  prepared
  to
  provide
  a
  rational
  for
  selecting
  the
  earned
  value
  method
  for
  each
  task.
  Explain

why
  the
  earned
  value
  methods
  selected
  are
  appropriate.

! Do
  you
  have
  any
  apportioned
  effort?

" An
  apportioned
  earned
  value
  method
  is
  used
  for
  efforts
  like
  quality
  assurance
  which
  can
  be

identified
  and
  measured
  with
  the
  completion
  of
  an
  assembly,
  a
  manufacturing
  process,
  or
  a

portion
  thereof.

" If
  you
  have
  selected
  an
  apportioned
  earned
  value
  method,
  be
  able
  to
  explain
  the
  BCWP
  of
  the

base
  or
  parent
  account.
  Parent
  apportioned
  accounts
  must
  have
  the
  same
  start
  and
  completion

date.
  Apportioned
  accounts
  must
  have
  discrete
  effort
  as
  a
  base
  and
  not
  LOE.
  BCWP
  for
  the

apportioned
  account
  is
  expressed
  as
  the
  same
  percentage
  of
  its
  Budget
  At
  Completion
  (BAC)
  as

the
  BCWP
  calculated
  for
  the
  base
  account
  or
  work
  task.

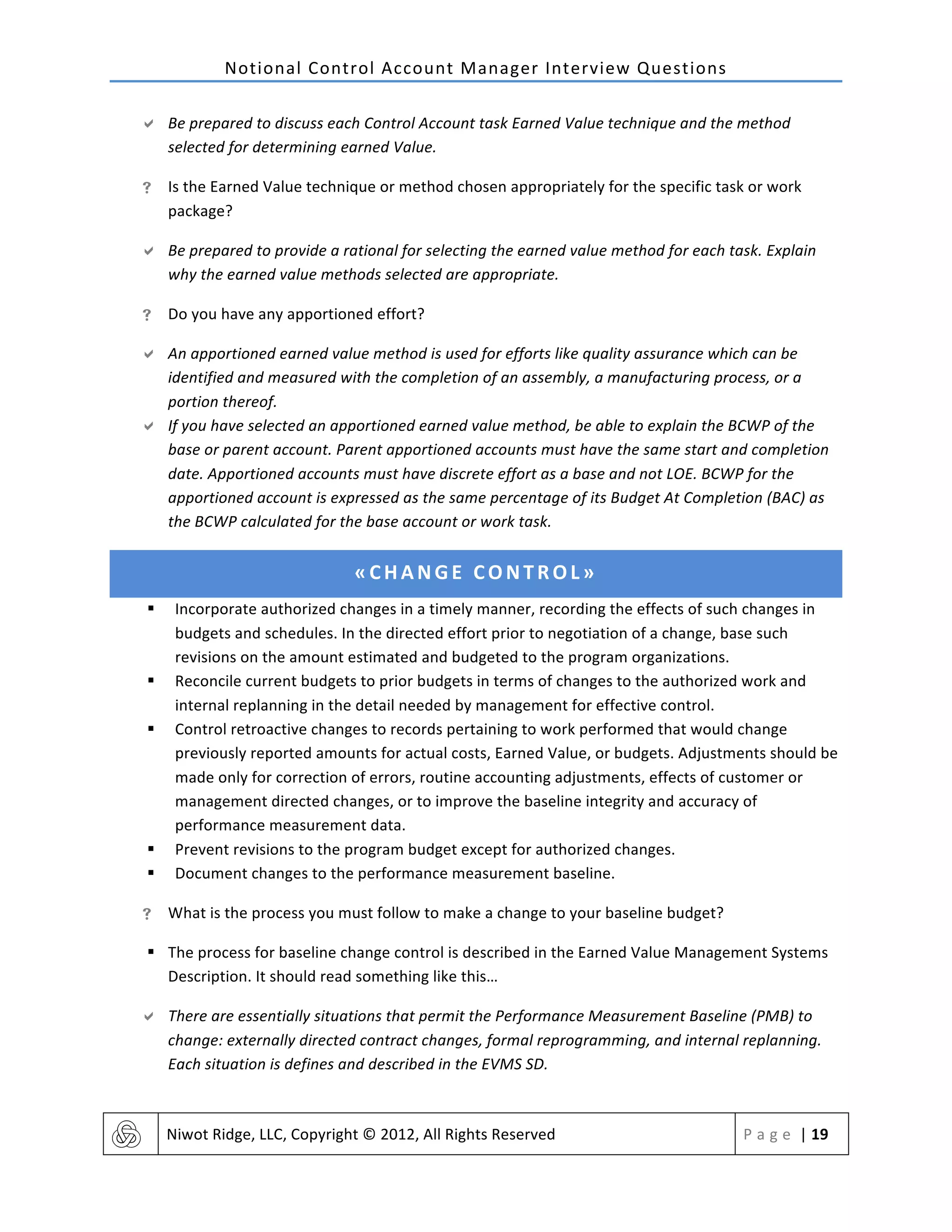

«CHANGE
  CONTROL»

§ Incorporate
  authorized
  changes
  in
  a
  timely
  manner,
  recording
  the
  effects
  of
  such
  changes
  in

budgets
  and
  schedules.
  In
  the
  directed
  effort
  prior
  to
  negotiation
  of
  a
  change,
  base
  such

revisions
  on
  the
  amount
  estimated
  and
  budgeted
  to
  the
  program
  organizations.

§ Reconcile
  current
  budgets
  to
  prior
  budgets
  in
  terms
  of
  changes
  to
  the
  authorized
  work
  and

internal
  replanning
  in
  the
  detail
  needed
  by
  management
  for
  effective
  control.

§ Control
  retroactive
  changes
  to
  records
  pertaining
  to
  work
  performed
  that
  would
  change

previously
  reported
  amounts
  for
  actual
  costs,
  Earned
  Value,
  or
  budgets.
  Adjustments
  should
  be

made
  only
  for
  correction
  of
  errors,
  routine
  accounting
  adjustments,
  effects
  of
  customer
  or

management
  directed
  changes,
  or
  to
  improve
  the
  baseline
  integrity
  and
  accuracy
  of

performance
  measurement
  data.

§ Prevent
  revisions
  to
  the
  program
  budget
  except
  for
  authorized
  changes.

§ Document
  changes
  to
  the
  performance
  measurement
  baseline.

! What
  is
  the
  process
  you
  must
  follow
  to
  make
  a
  change
  to
  your
  baseline
  budget?

§ The
  process
  for
  baseline
  change
  control
  is
  described
  in
  the
  Earned
  Value
  Management
  Systems

Description.
  It
  should
  read
  something
  like
  this…

" There
  are
  essentially
  situations
  that
  permit
  the
  Performance
  Measurement
  Baseline
  (PMB)
  to

change:
  externally
  directed
  contract
  changes,
  formal
  reprogramming,
  and
  internal
  replanning.

Each
  situation
  is
  defines
  and
  described
  in
  the
  EVMS
  SD.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©

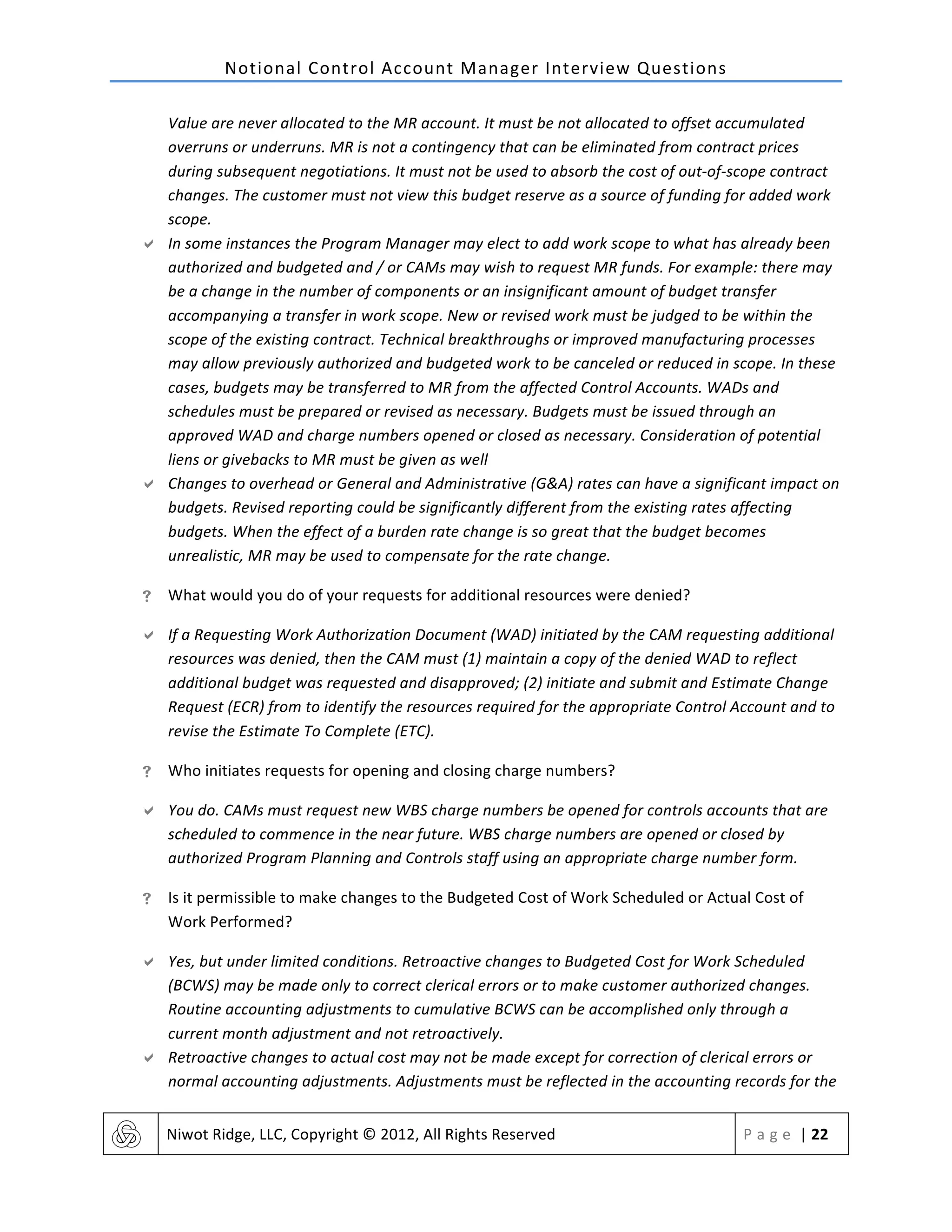

  2012,
  All
  Rights
  Reserved
   P a g e
  |
  20

" Externally
  directed
  contract
  changes
  and
  formal
  reprogramming
  are
  the
  only
  conditions
  that

permit
  a
  change
  to
  the
  Contract
  Budget
  Base
  (CBB)
  and
  both
  require
  permission
  from
  the

customer.

" If
  changes
  to
  the
  PMB
  are
  within
  the
  constraints
  of
  the
  contract
  then
  internal
  replanning
  is

permitted
  subject
  to
  the
  limitation
  of
  the
  EVMS
  SD.

" The
  internal
  budget
  replanning
  process
  should
  following
  this
  approach:
  The
  CAM
  requests
  a

change
  to
  a
  Control
  Account(s)
  level
  budget
  through
  a
  Requesting
  WAD
  and
  reviews
  the
  request

with
  the
  Program
  Planning
  and
  Controls
  lead
  for
  determination
  of
  any
  impact
  to
  the
  IMS.
  If
  it
  is

determined
  that
  the
  change
  will
  impact
  the
  IMS,
  then
  the
  process
  for
  internal
  schedule

replanning
  must
  be
  followed.

" Typically
  this
  internal
  replanning
  process
  follows
  these
  steps
  (1)
  Intermediate
  Management
  and

the
  Change
  Control
  Board
  (CCB)
  approve
  or
  deny
  the
  request.
  Approved
  requests
  are
  sent
  to
  the

Program
  Planning
  and
  Control
  Lead
  for
  approval
  (2)
  The
  PP&C
  Lead
  reviews
  and
  approves
  or

denies
  the
  request;
  (3)
  if
  the
  requesting
  WAD
  is
  disputed
  or
  involves
  Management
  Reserve

distribution,
  the
  Program
  Manager
  makes
  the
  final
  determination
  of
  approval;
  (4)
  If
  the
  changes

are
  to
  occur
  within
  two
  accounting
  period
  beyond
  the
  current
  accounting
  period,
  the
  Program

Manager
  or
  Business
  Deputy
  notifies
  the
  customer
  in
  writing
  of
  the
  change;
  (5)
  If
  the
  change
  is

approved,
  the
  WAD
  is
  sent
  to
  the
  CAM.
  The
  CAM
  revises
  the
  detailed
  schedules
  and
  prepares
  an

Estimate
  To
  Complete
  (ETC).
  PP&C
  inputs
  the
  data
  into
  the
  cost
  and
  schedule
  tools.
  If
  the
  CAM

states
  in
  the
  Comments
  Section
  of
  the
  Requesting
  WAD
  that
  this
  ETC
  is
  equal
  to
  the
  change
  to

the
  time
  phased
  BCWS
  (budget),
  then
  no
  Estimate
  Change
  Request
  (ECR)
  is
  required.
  If
  the
  ETC
  is

different
  than
  the
  time
  phased
  BCWS
  on
  the
  Requesting
  WAD,
  then
  the
  CAM
  must
  submit
  an

ECR.

! What
  is
  the
  process
  you
  must
  follow
  to
  make
  a
  change
  to
  your
  baseline
  schedule?
  Where
  is
  this

documented?

" The
  internal
  schedule
  replanning
  process
  is
  usually
  described
  in
  the
  EVMS
  Systems
  Description.

This
  usually
  is
  described
  as
  follows:

" The
  CAM
  submits
  a
  Request
  for
  IMS
  Change
  for
  and
  the
  accompanying
  IMS
  Change
  Request

Worksheet
  to
  the
  Schedule
  Review
  Board
  (SRB).
  The
  SRB
  includes
  the
  IPT
  and
  organizational

scheduler,
  intermediate
  management
  and
  the
  CAM.
  The
  SRB
  determines
  of
  the
  change
  is
  minor

or
  major.
  Guidelines
  for
  the
  classification
  of
  changes
  is
  usually
  described
  in
  the
  EVMS
  System

Description.

" If
  the
  change
  is
  determined
  minor,
  then
  the
  forms
  are
  sent
  to
  the
  Program
  Master
  Scheduler
  for

review.
  Of
  the
  Program
  Master
  Scheduler
  approves
  the
  request,
  the
  approved
  forms
  are
  sent
  to

the
  Schedule
  Review
  Board
  (SRB)
  and
  evaluated.
  Of
  the
  SRB
  approves
  the
  change,
  and
  then
  it

may
  be
  implemented.

" If
  the
  change
  is
  determined
  major
  by
  the
  SRB
  and
  the
  Program
  Master
  Scheduler,
  then
  the
  forms

are
  sent
  to
  the
  Change
  Control
  Board
  (CCB)
  for
  review.
  If
  the
  CCB
  approves
  the
  change,
  the

change
  may
  be
  implemented.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  21

" If
  approved
  changes
  are
  to
  occur
  within
  two
  accounting
  periods
  beyond
  the
  current
  accounting

period,
  the
  Program
  Manager
  or
  Business
  Deputy
  notifies
  the
  customer
  in
  writing
  of
  the
  change.

" As
  soon
  as
  practical
  WAD(s)
  are
  updated
  to
  reflect
  the
  schedule
  change.

! What
  was
  the
  last
  change
  to
  one
  of
  your
  Control
  Accounts?

" Be
  prepared
  to
  describe
  this
  change,
  the
  reason
  for
  the
  change

" Be
  able
  to
  show
  the
  latest
  revised
  IMS
  resulting
  from
  the
  change
  and
  the
  affected
  Control

Accounts
  and
  any
  Work
  Packages
  affected
  by
  the
  change.

" If
  no
  changes
  were
  made
  to
  the
  work
  packages,
  describe
  the
  process
  used
  to
  make
  a
  change.

! Were
  any
  changes
  performed
  in
  the
  last
  60
  days?

" Walk
  through
  the
  last
  change
  you
  made
  to
  a
  Control
  Account.

" If
  no
  changes
  were
  made,
  describe
  the
  process
  used
  to
  make
  a
  change

! Were
  all
  appropriate
  documents
  used
  to
  process
  the
  change?

" Show
  the
  requesting
  WAD
  or
  IMS
  change
  request
  involved.

! What
  is
  the
  difference
  between
  the
  classes
  of
  change
  defined
  in
  your
  change
  control

management
  system?

" Class
  1
  changes
  are
  usually
  out
  of
  scope
  to
  the
  contract.
  Class
  I
  changes
  are
  customer
  directed

(authorized
  negotiated
  work
  scope
  or
  authorized
  unpriced
  work
  scope).
  All
  contract
  baseline

changes
  must
  be
  authorized
  by
  a
  Program
  Directive
  (PD)
  or
  Operations
  Directive
  (OD)
  and

directed
  by
  Work
  Authorization
  Documents
  (WAD)

" Class
  2
  changes
  are
  in
  scope
  to
  the
  contract
  but
  out
  of
  scope
  to
  the
  CAM
  or
  Control
  Account.

Class
  2
  changes
  are
  classified
  to
  internal
  revisions
  to
  the
  baseline.
  They
  are
  either
  within
  the

baseline
  scope
  or
  are
  changes
  to
  the
  baseline
  scope
  which
  requires
  a
  transfer
  from
  Management

Reserve
  (MR).

! Were
  the
  changes
  performed
  in
  a
  timely
  manner?

" Changes
  to
  the
  baseline
  must
  be
  accomplished
  in
  a
  timely
  manner.
  Revisions
  to
  the
  budget
  and

schedule
  must
  be
  completed
  and
  input
  to
  the
  cost
  and
  schedule
  tool
  within
  60
  calendar
  days

after
  authorization
  of
  a
  change.
  Work
  authorizing
  documents
  and
  schedules
  must
  be
  amended

where
  appropriate

! What
  is
  the
  acceptable
  use
  of
  management
  reserve?

" The
  acceptable
  use
  of
  Management
  Reserve
  (MR)
  is
  described
  in
  the
  EVMS
  Systems
  Description

and
  a
  sample
  is
  stated
  below

" Management
  Reserve
  (MR)
  is
  a
  budget
  account
  established
  by
  Program
  Management
  for
  use
  in

accommodating
  growth
  in
  the
  current
  work
  scope,
  rate
  changes,
  and
  other
  program
  unknowns.

MR
  must
  be
  held
  for
  current
  and
  future
  needs.
  Because
  it
  is
  a
  control
  tool,
  actual
  and
  Earned

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  22

Value
  are
  never
  allocated
  to
  the
  MR
  account.
  It
  must
  be
  not
  allocated
  to
  offset
  accumulated

overruns
  or
  underruns.
  MR
  is
  not
  a
  contingency
  that
  can
  be
  eliminated
  from
  contract
  prices

during
  subsequent
  negotiations.
  It
  must
  not
  be
  used
  to
  absorb
  the
  cost
  of
  out-­‐of-­‐scope
  contract

changes.
  The
  customer
  must
  not
  view
  this
  budget
  reserve
  as
  a
  source
  of
  funding
  for
  added
  work

scope.

" In
  some
  instances
  the
  Program
  Manager
  may
  elect
  to
  add
  work
  scope
  to
  what
  has
  already
  been

authorized
  and
  budgeted
  and
  /
  or
  CAMs
  may
  wish
  to
  request
  MR
  funds.
  For
  example:
  there
  may

be
  a
  change
  in
  the
  number
  of
  components
  or
  an
  insignificant
  amount
  of
  budget
  transfer

accompanying
  a
  transfer
  in
  work
  scope.
  New
  or
  revised
  work
  must
  be
  judged
  to
  be
  within
  the

scope
  of
  the
  existing
  contract.
  Technical
  breakthroughs
  or
  improved
  manufacturing
  processes

may
  allow
  previously
  authorized
  and
  budgeted
  work
  to
  be
  canceled
  or
  reduced
  in
  scope.
  In
  these

cases,
  budgets
  may
  be
  transferred
  to
  MR
  from
  the
  affected
  Control
  Accounts.
  WADs
  and

schedules
  must
  be
  prepared
  or
  revised
  as
  necessary.
  Budgets
  must
  be
  issued
  through
  an

approved
  WAD
  and
  charge
  numbers
  opened
  or
  closed
  as
  necessary.
  Consideration
  of
  potential

liens
  or
  givebacks
  to
  MR
  must
  be
  given
  as
  well

" Changes
  to
  overhead
  or
  General
  and
  Administrative
  (G&A)
  rates
  can
  have
  a
  significant
  impact
  on

budgets.
  Revised
  reporting
  could
  be
  significantly
  different
  from
  the
  existing
  rates
  affecting

budgets.
  When
  the
  effect
  of
  a
  burden
  rate
  change
  is
  so
  great
  that
  the
  budget
  becomes

unrealistic,
  MR
  may
  be
  used
  to
  compensate
  for
  the
  rate
  change.

! What
  would
  you
  do
  of
  your
  requests
  for
  additional
  resources
  were
  denied?

" If
  a
  Requesting
  Work
  Authorization
  Document
  (WAD)
  initiated
  by
  the
  CAM
  requesting
  additional

resources
  was
  denied,
  then
  the
  CAM
  must
  (1)
  maintain
  a
  copy
  of
  the
  denied
  WAD
  to
  reflect

additional
  budget
  was
  requested
  and
  disapproved;
  (2)
  initiate
  and
  submit
  and
  Estimate
  Change

Request
  (ECR)
  from
  to
  identify
  the
  resources
  required
  for
  the
  appropriate
  Control
  Account
  and
  to

revise
  the
  Estimate
  To
  Complete
  (ETC).

! Who
  initiates
  requests
  for
  opening
  and
  closing
  charge
  numbers?

" You
  do.
  CAMs
  must
  request
  new
  WBS
  charge
  numbers
  be
  opened
  for
  controls
  accounts
  that
  are

scheduled
  to
  commence
  in
  the
  near
  future.
  WBS
  charge
  numbers
  are
  opened
  or
  closed
  by

authorized
  Program
  Planning
  and
  Controls
  staff
  using
  an
  appropriate
  charge
  number
  form.

! Is
  it
  permissible
  to
  make
  changes
  to
  the
  Budgeted
  Cost
  of
  Work
  Scheduled
  or
  Actual
  Cost
  of

Work
  Performed?

" Yes,
  but
  under
  limited
  conditions.
  Retroactive
  changes
  to
  Budgeted
  Cost
  for
  Work
  Scheduled

(BCWS)
  may
  be
  made
  only
  to
  correct
  clerical
  errors
  or
  to
  make
  customer
  authorized
  changes.

Routine
  accounting
  adjustments
  to
  cumulative
  BCWS
  can
  be
  accomplished
  only
  through
  a

current
  month
  adjustment
  and
  not
  retroactively.

" Retroactive
  changes
  to
  actual
  cost
  may
  not
  be
  made
  except
  for
  correction
  of
  clerical
  errors
  or

normal
  accounting
  adjustments.
  Adjustments
  must
  be
  reflected
  in
  the
  accounting
  records
  for
  the

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  23

month
  the
  adjustments
  are
  made.
  The
  categories
  of
  adjustments
  are:
  (1)
  non
  labor,
  (2)
  labor

current
  year,
  (3)
  labor
  prior
  year.

«ANALYSIS»

§ At
  least
  on
  a
  monthly
  basis,
  generate
  the
  following
  information
  at
  the
  Control
  Account
  and

other
  levels
  as
  necessary
  for
  management
  control
  using
  actual
  cost
  data
  from,
  or
  reconcilable

with,
  the
  accounting
  system:

♦ Comparison
  of
  the
  amount
  of
  planned
  budget
  and
  the
  amount
  of
  budget
  earned
  for
  work

accomplished.
  This
  comparison
  provides
  the
  schedule
  variance.

♦ Comparison
  of
  the
  amount
  of
  the
  budget
  earned
  the
  actual
  (applied
  where
  appropriate)

direct
  costs
  for
  the
  same
  work.
  This
  comparison
  provides
  the
  cost
  variance.

§ Identify,
  at
  least
  monthly,
  the
  significant
  differences
  between
  both
  planned
  and
  actual

schedule
  performance
  and
  planned
  and
  actual
  cost
  performance,
  and
  provide
  the
  reasons
  for

the
  variances
  in
  the
  detail
  needed
  by
  program
  management.

§ Identify
  budgeted
  and
  applied
  (or
  actual)
  indirect
  costs
  at
  the
  level
  and
  frequency
  needed
  by

management
  for
  effective
  control,
  along
  with
  the
  reasons
  for
  any
  significant
  variances.

§ Summarize
  the
  data
  elements
  and
  associated
  variances
  through
  the
  program
  organization

and/or
  work
  breakdown
  structure
  to
  support
  management
  needs
  and
  any
  customer
  reporting

specified
  in
  the
  contract.

§ Implement
  managerial
  actions
  taken
  as
  the
  result
  of
  Earned
  Value
  information.

§ Develop
  revised
  estimates
  of
  cost
  at
  completion
  based
  on
  performance
  to
  date,
  commitment

values
  for
  material,
  and
  estimates
  of
  future
  conditions.
  Compare
  this
  information
  with
  the

performance
  measurement
  baseline
  to
  identify
  variances
  at
  completion
  important
  to
  company

management
  and
  any
  applicable
  customer
  reporting
  requirements
  including
  statements
  of

funding
  requirements.

! Show
  how
  you
  monitor
  who
  charges
  your
  Control
  Account

" By
  using
  the
  Systems,
  Applications,
  Products
  data
  processing
  (SAP)
  or
  equivalent
  weekly
  actual

cost
  reports.
  These
  reports
  are
  generated
  and
  distributed
  weekly
  by
  Cost
  Management
  and

Program
  Controls.
  Each
  CAM
  must
  review
  the
  SAP
  actual
  cost
  reports
  on
  a
  weekly
  basis
  and

assess
  proper
  charging
  practices.
  If
  resources
  aren’t
  recognized
  or
  incorrect
  charging
  practices

occur,
  a
  Current
  Year
  Labor
  Cost
  Transfer
  form
  must
  be
  completed
  and
  submitted
  to
  correct
  any

charging
  anomalies.

! How
  does
  Earned
  Value
  get
  into
  the
  cost
  accounting
  system?
  How
  do
  you
  verify
  what
  was

submitted?

" The
  Program
  Directive
  defines
  the
  Earned
  Value
  techniques
  approved
  for
  use
  on
  the
  program.

Earned
  Value
  for
  your
  Control
  Account
  tasks
  is
  based
  on
  the
  Earned
  Value
  methods
  selected.

Earned
  Value
  is
  taken
  consistent
  with
  how
  the
  work
  is
  planned.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  24

" On
  a
  monthly
  basis
  (month-­‐end)
  Program
  Planning
  and
  Controls
  and
  the
  CAM
  assess
  each
  work

package
  and
  the
  tasks
  in
  the
  Work
  Package
  to
  assure
  progress
  and
  Earned
  Value
  is
  taken
  in

accordance
  with
  the
  method
  selected.

" After
  this
  process
  is
  complete
  the
  planning
  tool’s
  Earned
  Value
  is
  uploaded
  to
  the
  Cost

Management
  system
  for
  pricing
  and
  cost
  analysis.
  Once
  the
  Cost
  System
  has
  been
  uploaded
  the

Organizational
  Performance
  Reports
  (OPR)
  are
  generated
  to
  validate
  the
  Earned
  Value
  taken.

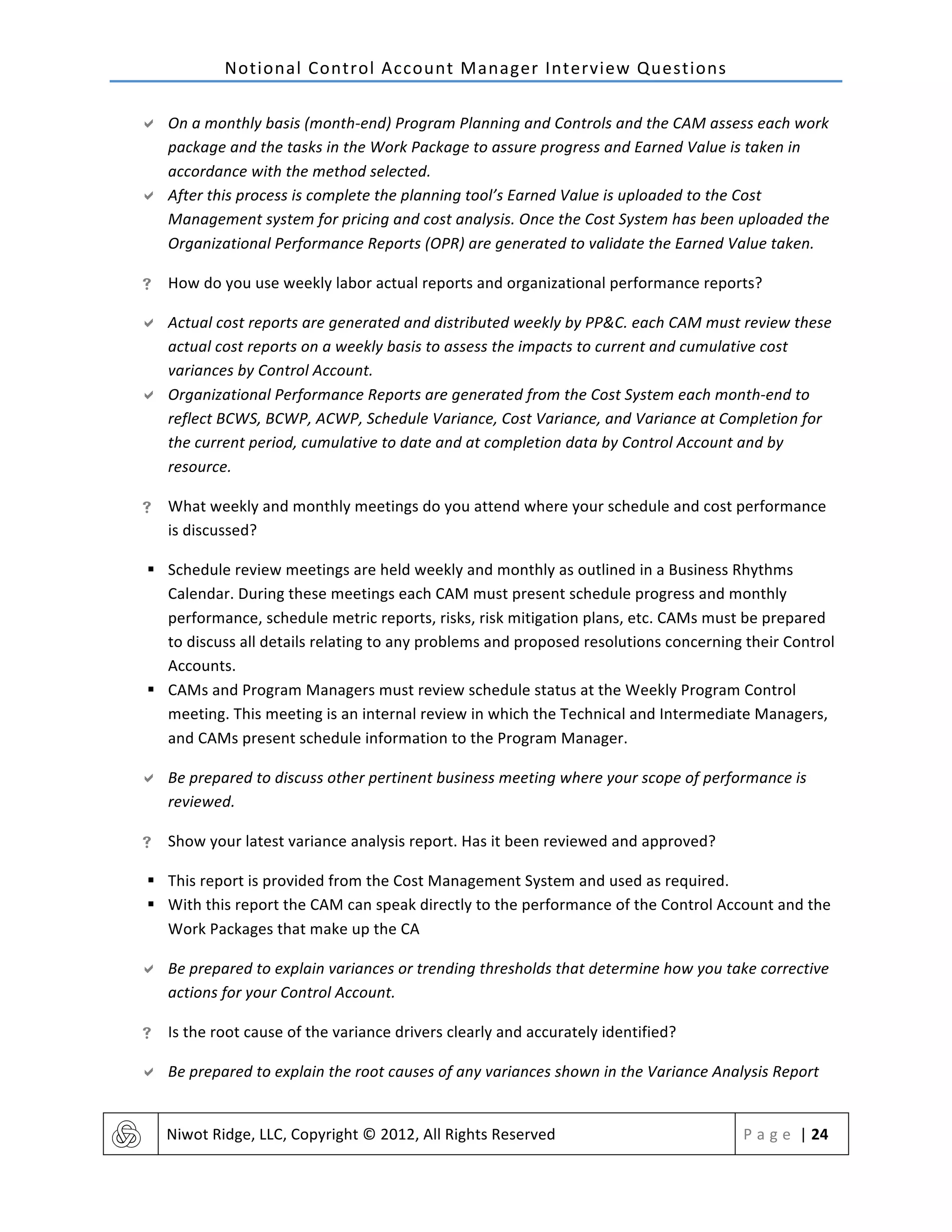

! How
  do
  you
  use
  weekly
  labor
  actual
  reports
  and
  organizational
  performance
  reports?

" Actual
  cost
  reports
  are
  generated
  and
  distributed
  weekly
  by
  PP&C.
  each
  CAM
  must
  review
  these

actual
  cost
  reports
  on
  a
  weekly
  basis
  to
  assess
  the
  impacts
  to
  current
  and
  cumulative
  cost

variances
  by
  Control
  Account.

" Organizational
  Performance
  Reports
  are
  generated
  from
  the
  Cost
  System
  each
  month-­‐end
  to

reflect
  BCWS,
  BCWP,
  ACWP,
  Schedule
  Variance,
  Cost
  Variance,
  and
  Variance
  at
  Completion
  for

the
  current
  period,
  cumulative
  to
  date
  and
  at
  completion
  data
  by
  Control
  Account
  and
  by

resource.

! What
  weekly
  and
  monthly
  meetings
  do
  you
  attend
  where
  your
  schedule
  and
  cost
  performance

is
  discussed?

§ Schedule
  review
  meetings
  are
  held
  weekly
  and
  monthly
  as
  outlined
  in
  a
  Business
  Rhythms

Calendar.
  During
  these
  meetings
  each
  CAM
  must
  present
  schedule
  progress
  and
  monthly

performance,
  schedule
  metric
  reports,
  risks,
  risk
  mitigation
  plans,
  etc.
  CAMs
  must
  be
  prepared

to
  discuss
  all
  details
  relating
  to
  any
  problems
  and
  proposed
  resolutions
  concerning
  their
  Control

Accounts.

§ CAMs
  and
  Program
  Managers
  must
  review
  schedule
  status
  at
  the
  Weekly
  Program
  Control

meeting.
  This
  meeting
  is
  an
  internal
  review
  in
  which
  the
  Technical
  and
  Intermediate
  Managers,

and
  CAMs
  present
  schedule
  information
  to
  the
  Program
  Manager.

" Be
  prepared
  to
  discuss
  other
  pertinent
  business
  meeting
  where
  your
  scope
  of
  performance
  is

reviewed.

! Show
  your
  latest
  variance
  analysis
  report.
  Has
  it
  been
  reviewed
  and
  approved?

§ This
  report
  is
  provided
  from
  the
  Cost
  Management
  System
  and
  used
  as
  required.

§ With
  this
  report
  the
  CAM
  can
  speak
  directly
  to
  the
  performance
  of
  the
  Control
  Account
  and
  the

Work
  Packages
  that
  make
  up
  the
  CA

" Be
  prepared
  to
  explain
  variances
  or
  trending
  thresholds
  that
  determine
  how
  you
  take
  corrective

actions
  for
  your
  Control
  Account.

! Is
  the
  root
  cause
  of
  the
  variance
  drivers
  clearly
  and
  accurately
  identified?

" Be
  prepared
  to
  explain
  the
  root
  causes
  of
  any
  variances
  shown
  in
  the
  Variance
  Analysis
  Report

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  25

! Has
  the
  impact
  to
  other
  Control
  Accounts
  or
  the
  program
  been
  identified?

" Be
  prepared
  to
  explain
  the
  impacts
  to
  other
  Control
  Accounts
  and
  the
  Program.

! If
  recoverable,
  has
  a
  corrective
  action
  plan
  been
  identified?

" Be
  prepared
  to
  explain
  your
  corrective
  action
  plan.

! Does
  the
  schedule
  variance
  correlate
  with
  the
  schedule
  status?

" Be
  prepared
  to
  explain
  how
  the
  schedule
  variance
  is
  correlated
  with
  the
  schedule
  status.

! Who
  reviewed
  and
  approves
  the
  variance
  analysis
  reports?

" The
  approval
  signatures
  for
  a
  Control
  Account
  variance
  analysis
  for
  are:
  (a)
  The
  Control
  Account

Manager
  (CAM);
  (b)
  the
  Intermediate
  Manager
  or
  Business
  Manager;
  (c)
  the
  Program
  Manager

or
  Director.

! How
  do
  you
  use
  the
  organizations
  performance
  reports
  or
  their
  equivalents?

" Organizational
  Performance
  Reports
  (OPRs)
  are
  generated
  from
  the
  Cost
  Management
  System

each
  month
  end
  to
  reflect
  BCWS,
  BCWP,
  ACWP,
  schedule
  variance,
  cost
  variance,
  and
  variance
  at

completion
  for
  the
  current
  period
  and
  cumulative
  to
  date
  and
  at
  completion
  data
  by
  Control

Account.

" The
  OPR
  is
  the
  official
  Cost
  Management
  System
  document
  used
  to
  identify
  and
  status
  all

variance
  analyses
  for
  each
  Control
  Account.
  Be
  prepared
  to
  provide
  the
  OPR
  for
  all
  your
  Control

Accounts.
  Be
  able
  to
  explain
  all
  variance
  calculations
  and
  indices
  referenced
  along
  with
  their

impacts
  to
  your
  Control
  Accounts.

" Some
  type
  of
  Performance
  Management
  Fact
  Sheet
  contain
  all
  variance
  analyses,
  indices
  and

percentage
  calculations
  must
  be
  contained
  in
  your
  CAM
  Notebook

! Show
  and
  explain
  your
  CPI
  and
  SPI
  values
  that
  support
  your
  TCPI
  values?

" Be
  prepared
  to
  show
  your
  CPI
  and
  SPI
  values
  from
  the
  Cost
  Management
  System
  performance

reports
  and
  how
  they
  support
  the
  To
  Complete
  Performance
  Index.

! What
  drives
  your
  variances?

" The
  following
  are
  explanations
  that
  must
  be
  considered
  tin
  order
  to
  address
  properly
  favorable

or
  unfavorable
  cost
  and
  schedule
  performance
  measurement
  variance
  analysis
  problem

statements:

" Cost
  Variance
  –
  problem
  statement
  (favorable
  or
  unfavorable)

" BCWP
  >
  BCWS
  –
  favorable
  variance
  explanations

" The
  task
  is
  less
  complex
  and
  will
  be
  completed
  earlier
  than
  planned

" Early
  effort
  has
  been
  confined
  to
  tasks
  which
  are
  less
  complex
  than
  those
  that
  follow

" The
  task
  has
  been
  overstaffed
  early
  in
  order
  to
  recognize
  the
  establishment
  of
  a
  higher
  priority

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  26

" Deliverables
  of
  hardware
  have
  been
  accomplished
  in
  advance
  of
  need
  date

" Earned
  Value
  may
  be
  incorrect
  and
  require
  an
  adjustment
  in
  the
  next
  reporting
  period

" The
  plan
  is
  time
  phased
  poorly
  and
  the
  current
  status
  is
  not
  reflective
  of
  what
  is
  really
  happening

" BCWP
  <
  BCWS
  –
  unfavorable
  variance
  explanation

" The
  task
  is
  more
  complex
  than
  originally
  planned

" Early
  effort
  has
  been
  more
  complex
  than
  the
  effort
  that
  follows

" Delays
  in
  staffing
  have
  slowed
  progress

" Hardware
  deliverables
  are
  late

" Design
  of
  rework
  activities
  has
  delayed
  progress

" Software
  deliverables
  are
  late

" Data
  from
  another
  organization
  (drawings
  or
  technical
  analysis)
  has
  been
  late

" Additional
  requirements
  have
  been
  established
  or
  changed

" Higher
  priority
  has
  been
  establishes
  on
  other
  work

" The
  plan
  is
  time
  phased
  poorly

" Schedule
  Variance
  –
  favorable
  or
  unfavorable
  explanations

" The
  complexity
  of
  the
  task
  is
  less
  than
  originally
  estimated

" The
  less
  complex
  tasks
  have
  been
  completed
  early

" The
  task
  is
  primarily
  LOE
  and
  not
  been
  fully
  staffed

" The
  plan
  is
  time
  phased
  poorly

" BCWP
  <
  BCWS
  –
  unfavorable

" The
  task
  is
  more
  complex
  than
  originally
  planned

" The
  more
  complex
  tasks
  have
  been
  complete
  early

" Program
  priorities
  have
  resulted
  in
  application
  of
  resources
  in
  an
  inefficient
  manner
  –
  more

overtime
  or
  additional
  staffing

" Delays
  in
  receipt
  of
  data
  have
  resulted
  in
  implementation
  of
  workarounds
  to
  make
  schedule.

More
  overtime
  or
  additional
  staffing

" Changes,
  redesign,
  additional
  requirements,
  or
  out-­‐of-­‐scope
  effort

" The
  plan
  is
  time
  phased
  poorly

" Rate
  or
  usage
  variance

«RISK»

§ DID
  81650
  calls
  out
  a
  Statistical
  Risk
  Analysis
  (SRA)
  for
  the
  Integrated
  Master
  Schedule
  (IMS).

§ The
  risk
  management
  of
  the
  technical
  aspects
  of
  the
  program
  should
  be
  included
  in
  the
  IMS
  as

well.

§ Technical
  risk
  management
  is
  guided
  by
  the
  specific
  procurement
  agency,
  but
  DoD
  Risk

Management
  is
  the
  starting
  document.

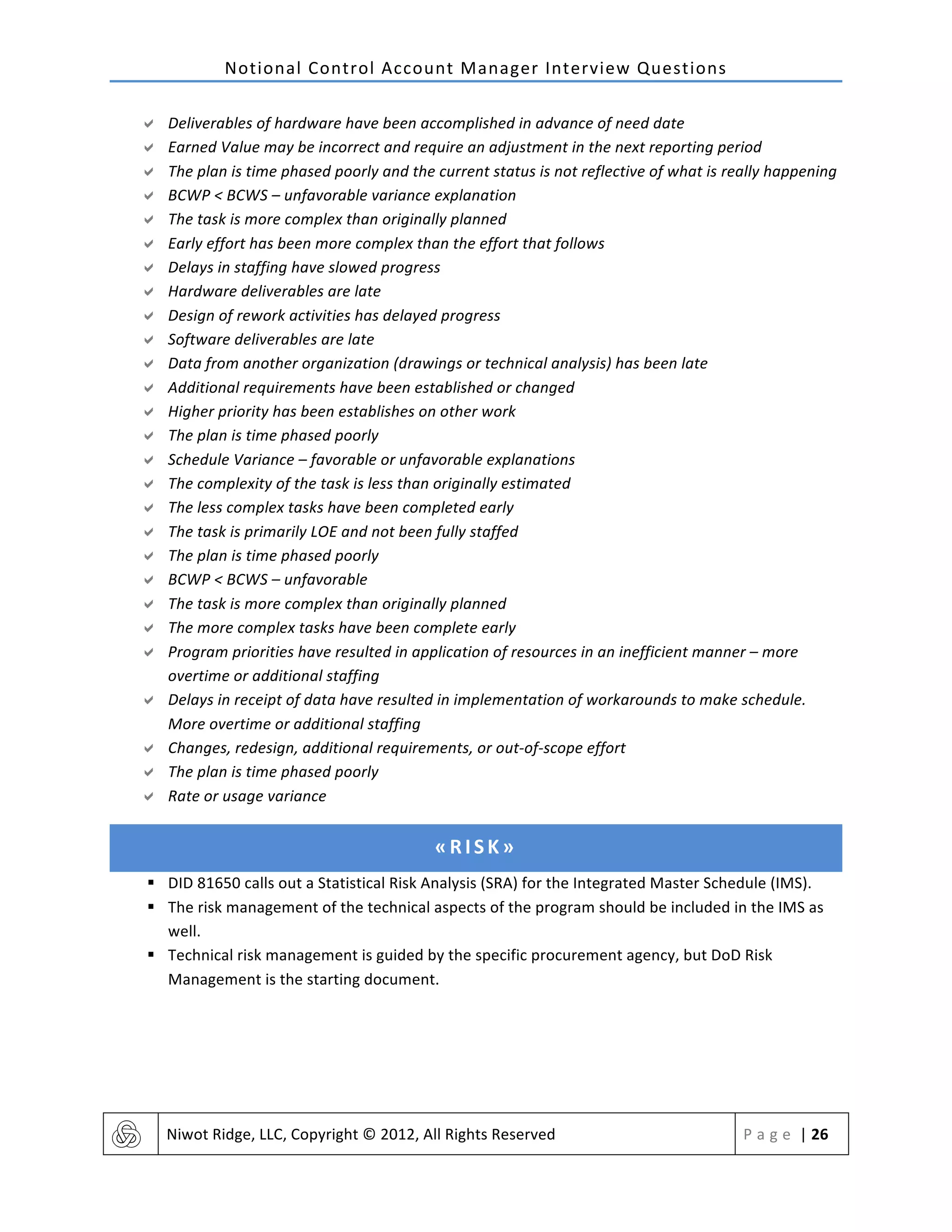

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  27

! What
  is
  risk
  mitigation?

" Risk
  mitigation
  is
  a
  formal
  process
  of
  identifying,
  tracking
  and
  minimizing
  potential
  hazards,

obstacles,
  and
  risks
  to
  successful
  program
  performance.
  Risk
  mitigation
  is
  described
  more

formally
  as:

" “The
  Program
  Manager
  is
  responsible
  for
  overseeing
  the
  implementation
  and
  maintenance
  of
  a

program
  Risk
  and
  Opportunities
  Management
  Plan.”

" Risk
  and
  Opportunity
  potentials
  are
  identified
  and
  quantified
  at
  both
  the
  Intermediate

Management
  and
  CAM
  levels.
  Mitigation
  Plans,
  including
  estimated
  plan
  costs,
  are
  developed
  as

necessary
  and
  submitted
  either
  to
  Intermediate
  Management
  for
  approval
  or
  directly
  to
  the
  Risk

Management
  and
  Opportunities
  Board.
  Upon
  Board
  approval,
  the
  Risk
  Mitigation
  Plan
  and

associated
  cost
  are
  submitted
  to
  the
  Program
  Manager.

" The
  Program
  Manager
  approves
  the
  plans
  and
  determines
  if
  the
  cost
  will
  be
  funded
  out
  of

Management
  Reserve.
  If
  so,
  the
  Program
  Manager
  directs
  Program
  Planning
  and
  Controls
  to

issue
  a
  WAS
  to
  Intermediate
  Management
  or
  CAM
  so
  the
  appropriate
  Control
  Account(s)
  can

then
  be
  replanned
  and
  input
  through
  Program
  Planning
  and
  Controls
  to
  the
  Cost
  Management

System.
  If
  the
  Program
  Manager
  decides
  the
  Mitigation
  Plan
  will
  not
  be
  funded
  out
  of
  MR,

Program
  Planning
  and
  Controls
  notifies
  the
  CAM
  who
  prepares
  and
  submits
  an
  ECR
  package,

which
  is
  then
  input
  into
  the
  Cost
  Management
  System.

! Do
  you
  have
  adequate
  budget
  and
  facilities
  to
  complete
  your
  work?

" Provide
  and
  explain
  as
  required

! Is
  the
  risk
  high,
  medium,
  or
  low?

" Provide
  and
  explain
  as
  required

! Are
  there
  any
  cost,
  schedule,
  or
  technical
  risks
  in
  your
  Control
  Accounts?

" Provide
  and
  explain
  as
  required

! Have
  the
  risks
  been
  documented
  in
  the
  Risk
  Management
  Plan?

" Provide
  and
  explain
  as
  required

! Are
  you
  risk
  mitigation
  activities
  incorporated
  in
  the
  IMS?

" Provide
  and
  explain
  as
  required

! What
  is
  the
  process
  for
  retiring
  or
  closing
  out
  a
  risk
  when
  the
  mitigation
  plan
  is
  successful?

" Once
  an
  identified
  risk
  has
  been
  successfully
  mitigated
  in
  accordance
  with
  the
  Risk
  Mitigation

Plan,
  the
  final
  risk
  action
  plan
  must
  be
  reviewed
  by
  the
  Risk
  Management
  Board
  for
  final

disposition
  and
  closure.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  28

! What
  is
  the
  process
  for
  retiring
  or
  closing
  out
  a
  risk
  when
  the
  mitigation
  plan
  is
  unsuccessful?

" If
  an
  identified
  risk
  has
  not
  been
  mitigated
  completely
  in
  accordance
  with
  the
  Risk
  Mitigation

Plan,
  then
  the
  Risk
  Management
  Board
  must
  review
  the
  mitigation
  plan
  actions
  taken
  and
  make

appropriate
  adjustments
  as
  needed
  (mitigation
  plans,
  mitigation
  times,
  etc.).
  The
  Risk

Management
  Board
  may
  simply
  accept
  the
  risk
  level
  as
  is
  and
  continue
  to
  monitor
  as

appropriate.
  These
  actions
  could
  result
  in
  additional
  revisions
  to
  the
  Control
  Account
  Baseline.

This
  change
  may
  require
  a
  WAD
  or
  an
  Estimate
  Change
  Request

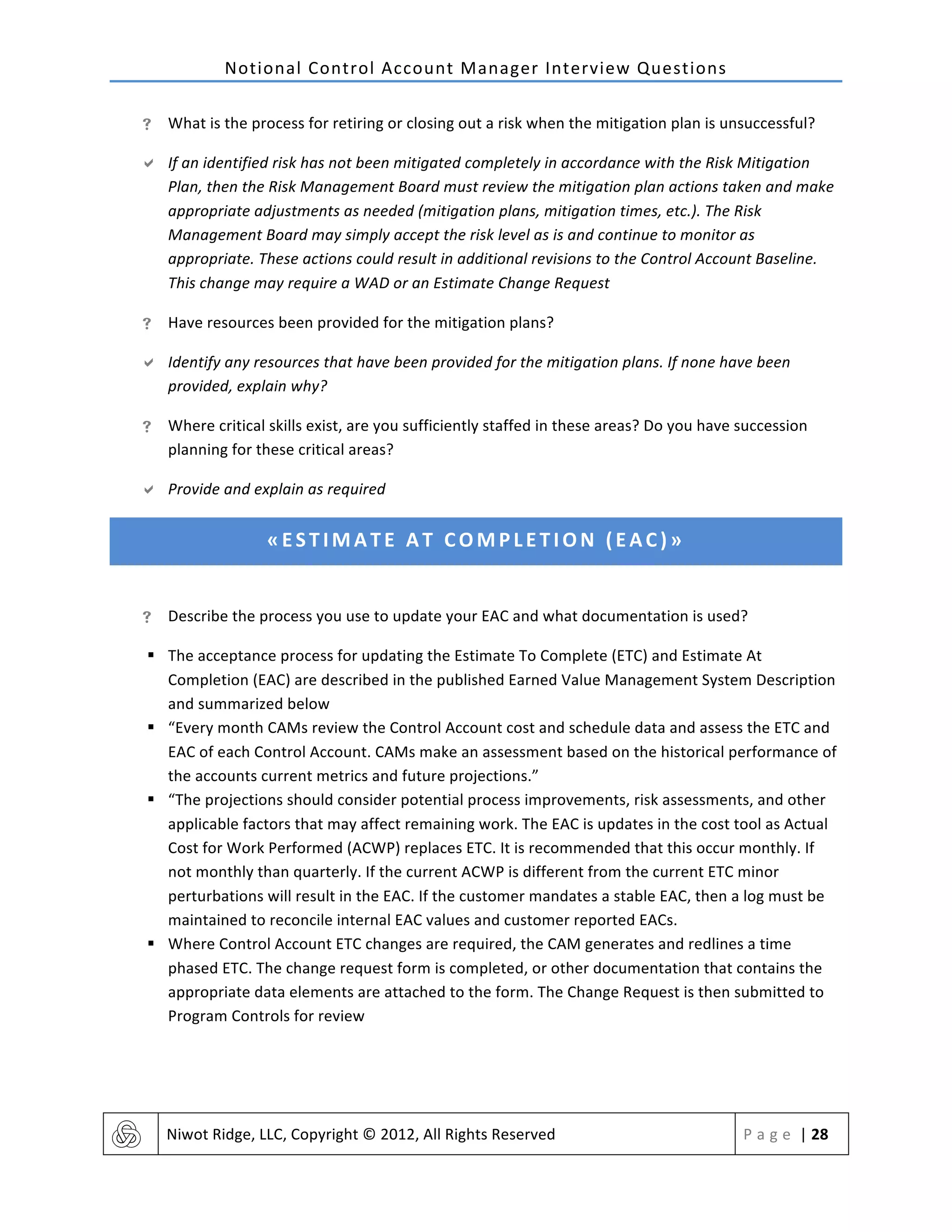

! Have
  resources
  been
  provided
  for
  the
  mitigation
  plans?

" Identify
  any
  resources
  that
  have
  been
  provided
  for
  the
  mitigation
  plans.
  If
  none
  have
  been

provided,
  explain
  why?

! Where
  critical
  skills
  exist,
  are
  you
  sufficiently
  staffed
  in
  these
  areas?
  Do
  you
  have
  succession

planning
  for
  these
  critical
  areas?

" Provide
  and
  explain
  as
  required

«ESTIMATE
  AT
  COMPLETION
  (EAC)»

! Describe
  the
  process
  you
  use
  to
  update
  your
  EAC
  and
  what
  documentation
  is
  used?

§ The
  acceptance
  process
  for
  updating
  the
  Estimate
  To
  Complete
  (ETC)
  and
  Estimate
  At

Completion
  (EAC)
  are
  described
  in
  the
  published
  Earned
  Value
  Management
  System
  Description

and
  summarized
  below

§ “Every
  month
  CAMs
  review
  the
  Control
  Account
  cost
  and
  schedule
  data
  and
  assess
  the
  ETC
  and

EAC
  of
  each
  Control
  Account.
  CAMs
  make
  an
  assessment
  based
  on
  the
  historical
  performance
  of

the
  accounts
  current
  metrics
  and
  future
  projections.”

§ “The
  projections
  should
  consider
  potential
  process
  improvements,
  risk
  assessments,
  and
  other

applicable
  factors
  that
  may
  affect
  remaining
  work.
  The
  EAC
  is
  updates
  in
  the
  cost
  tool
  as
  Actual

Cost
  for
  Work
  Performed
  (ACWP)
  replaces
  ETC.
  It
  is
  recommended
  that
  this
  occur
  monthly.
  If

not
  monthly
  than
  quarterly.
  If
  the
  current
  ACWP
  is
  different
  from
  the
  current
  ETC
  minor

perturbations
  will
  result
  in
  the
  EAC.
  If
  the
  customer
  mandates
  a
  stable
  EAC,
  then
  a
  log
  must
  be

maintained
  to
  reconcile
  internal
  EAC
  values
  and
  customer
  reported
  EACs.

§ Where
  Control
  Account
  ETC
  changes
  are
  required,
  the
  CAM
  generates
  and
  redlines
  a
  time

phased
  ETC.
  The
  change
  request
  form
  is
  completed,
  or
  other
  documentation
  that
  contains
  the

appropriate
  data
  elements
  are
  attached
  to
  the
  form.
  The
  Change
  Request
  is
  then
  submitted
  to

Program
  Controls
  for
  review

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  29

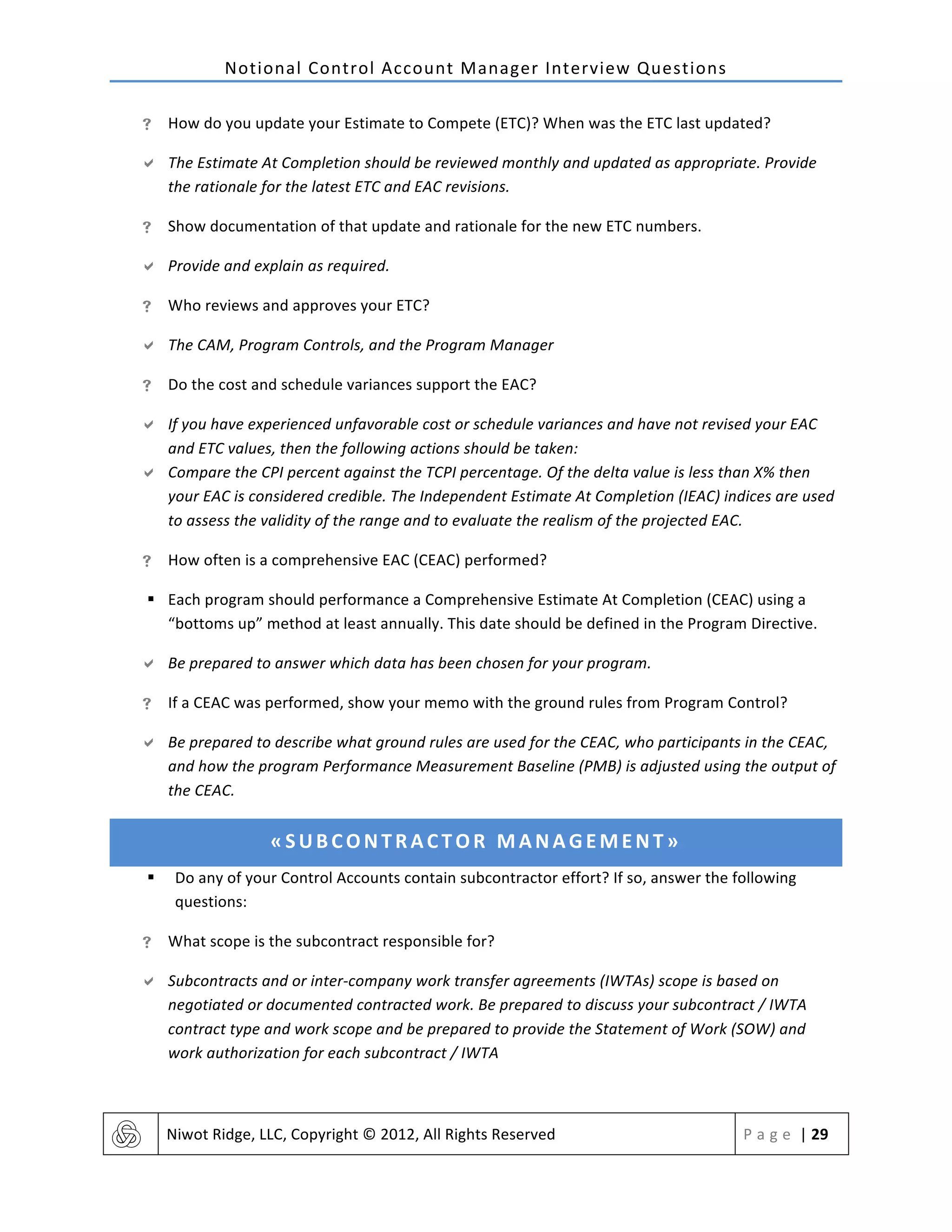

! How
  do
  you
  update
  your
  Estimate
  to
  Compete
  (ETC)?
  When
  was
  the
  ETC
  last
  updated?

" The
  Estimate
  At
  Completion
  should
  be
  reviewed
  monthly
  and
  updated
  as
  appropriate.
  Provide

the
  rationale
  for
  the
  latest
  ETC
  and
  EAC
  revisions.

! Show
  documentation
  of
  that
  update
  and
  rationale
  for
  the
  new
  ETC
  numbers.

" Provide
  and
  explain
  as
  required.

! Who
  reviews
  and
  approves
  your
  ETC?

" The
  CAM,
  Program
  Controls,
  and
  the
  Program
  Manager

! Do
  the
  cost
  and
  schedule
  variances
  support
  the
  EAC?

" If
  you
  have
  experienced
  unfavorable
  cost
  or
  schedule
  variances
  and
  have
  not
  revised
  your
  EAC

and
  ETC
  values,
  then
  the
  following
  actions
  should
  be
  taken:

" Compare
  the
  CPI
  percent
  against
  the
  TCPI
  percentage.
  Of
  the
  delta
  value
  is
  less
  than
  X%
  then

your
  EAC
  is
  considered
  credible.
  The
  Independent
  Estimate
  At
  Completion
  (IEAC)
  indices
  are
  used

to
  assess
  the
  validity
  of
  the
  range
  and
  to
  evaluate
  the
  realism
  of
  the
  projected
  EAC.

! How
  often
  is
  a
  comprehensive
  EAC
  (CEAC)
  performed?

§ Each
  program
  should
  performance
  a
  Comprehensive
  Estimate
  At
  Completion
  (CEAC)
  using
  a

“bottoms
  up”
  method
  at
  least
  annually.
  This
  date
  should
  be
  defined
  in
  the
  Program
  Directive.

" Be
  prepared
  to
  answer
  which
  data
  has
  been
  chosen
  for
  your
  program.

! If
  a
  CEAC
  was
  performed,
  show
  your
  memo
  with
  the
  ground
  rules
  from
  Program
  Control?

" Be
  prepared
  to
  describe
  what
  ground
  rules
  are
  used
  for
  the
  CEAC,
  who
  participants
  in
  the
  CEAC,

and
  how
  the
  program
  Performance
  Measurement
  Baseline
  (PMB)
  is
  adjusted
  using
  the
  output
  of

the
  CEAC.

«SUBCONTRACTOR
  MANAGEMENT»

§ Do
  any
  of
  your
  Control
  Accounts
  contain
  subcontractor
  effort?
  If
  so,
  answer
  the
  following

questions:

! What
  scope
  is
  the
  subcontract
  responsible
  for?

" Subcontracts
  and
  or
  inter-­‐company
  work
  transfer
  agreements
  (IWTAs)
  scope
  is
  based
  on

negotiated
  or
  documented
  contracted
  work.
  Be
  prepared
  to
  discuss
  your
  subcontract
  /
  IWTA

contract
  type
  and
  work
  scope
  and
  be
  prepared
  to
  provide
  the
  Statement
  of
  Work
  (SOW)
  and

work
  authorization
  for
  each
  subcontract
  /
  IWTA

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  30

! How
  does
  the
  subcontractor
  receive
  authorizations
  for
  scope,
  schedule,
  and
  resources
  from
  the

prime?

§ Subcontractor
  and
  IWTA
  direction
  is
  provided
  by
  the
  contract
  administration
  organization

through
  a
  negotiated
  contract
  or
  a
  contract
  modification
  to
  amend
  or
  change
  work
  scope,

schedule,
  and
  resources.

! What
  reporting
  requirements
  have
  been
  levied
  on
  the
  subcontractors?

§ Any
  nonrecurring
  or
  development
  subcontract
  that
  is
  larger
  than
  $25M
  and
  not
  Firm
  Fixed
  Price

(FFP),
  has
  a
  Cost
  Performance
  Report
  (CPR)
  requirement.
  A
  non-­‐FFP
  sub-­‐contract
  larger
  than

$10M,
  but
  less
  than
  $25M,
  has
  a
  modified
  Cost
  Performance
  Report
  (MCPR)
  requirement.
  The

Non-­‐FFP
  subcontracts
  under
  $10M
  have
  minor
  reporting
  requirements
  although
  if
  considered
  a

high
  cost,
  schedule,
  or
  technical
  risk
  a
  MCPR
  is
  required.
  Firm
  Fixed
  Price
  contracts
  fall
  into
  two

categories:
  Delivery
  and
  Support
  /
  Level
  of
  Effort

" Be
  prepared
  to
  provide
  copies
  of
  the
  latest
  reporting
  documentation
  pertaining
  to
  your

subcontracts
  /
  IWTAs

! Are
  the
  subcontractor’s
  schedules
  status
  weekly?

" Provide
  and
  explain
  as
  required

! How
  are
  the
  resources
  planned
  for
  the
  subcontractors
  (BCWS
  spreads
  for
  the
  subcontractor

work
  packages)

§ The
  budget
  information
  should
  represent
  the
  cost
  baseline
  negotiated
  or
  proposed.
  The
  BCWS

must
  be
  time-­‐phased
  consistent
  with
  the
  baseline
  schedule
  spans
  negotiated
  with
  each

subcontractor,
  and
  should
  be
  reconciled
  to
  the
  reporting
  requirement
  documentation
  (CPR,

MCPR)
  with
  the
  cost
  management
  system.
  Regardless
  of
  the
  Program
  Performance

Management
  system
  applied
  to
  the
  subcontractor,
  the
  Program
  Performance
  Management
  data

must
  be
  reviewed
  for
  logic,
  consistently,
  and
  validity

§ For
  minor
  subcontracts
  the
  CAM
  uses
  the
  IMS
  information
  and
  the
  time
  phased
  budget
  to
  plan

and
  status
  the
  effort
  in
  the
  PPM
  cost
  management
  tool.
  The
  BCWS
  in
  input
  into
  the
  PPM
  Cost

Tool
  and
  planned
  by
  the
  CAM
  using
  the
  time
  phased
  data
  in
  conjunction
  with
  the
  schedules

tasks.
  The
  subcontractor’s
  scheduled
  tasks
  are
  given
  as
  associated
  dollar
  value
  using
  the

appropriate
  Earned
  Value
  techniques
  allowed
  in
  the
  PPM
  cost
  tool.
  The
  recommended

technciques
  for
  minor
  subcontarcts
  is
  Percent
  Complete
  method.
  It
  provide
  a
  means
  to
  gain

partial
  earnings,
  thereby
  minimizing
  erroneous
  cost
  and
  schedule
  variances.

! Is
  the
  BCWS
  time
  phased
  with
  the
  baseline
  schedule
  plans?

" Be
  prepared
  to
  provide
  copies
  of
  your
  sibcontracts
  or
  IWTAs
  latest
  budget
  milestone
  plans
  and

reporting
  documentation,
  and
  show
  traceability
  to
  the
  applicable
  Control
  Account

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  31

! Can
  you
  trace
  the
  budget
  from
  the
  Work
  Authorization
  to
  the
  Control
  Account
  Plans,
  to
  the

subcontractors?

" Be
  prepared
  to
  provide
  traceability
  for
  each
  subcontractor
  /
  IWTA
  Work
  Authorization
  Document

(WAD)
  that
  provides
  scope,
  schedule,
  budget,
  period
  of
  performance,
  and
  approvals
  to
  the

applicable
  PPM
  cost
  report
  and
  control
  account
  plan.

! Can
  you
  trace
  the
  schedule
  from
  the
  subcontractor’s
  schedule
  to
  the
  Control
  Account
  Plan,
  to

the
  IMS?

" Be
  prepared
  to
  provide
  copies
  of
  your
  subcontract
  /
  IWTA
  latest
  milestone
  plans
  and
  reporting

documentation
  and
  provide
  traceability
  to
  the
  program
  IMS

! How
  do
  you
  determine
  BCWP
  for
  each
  subcontractor?

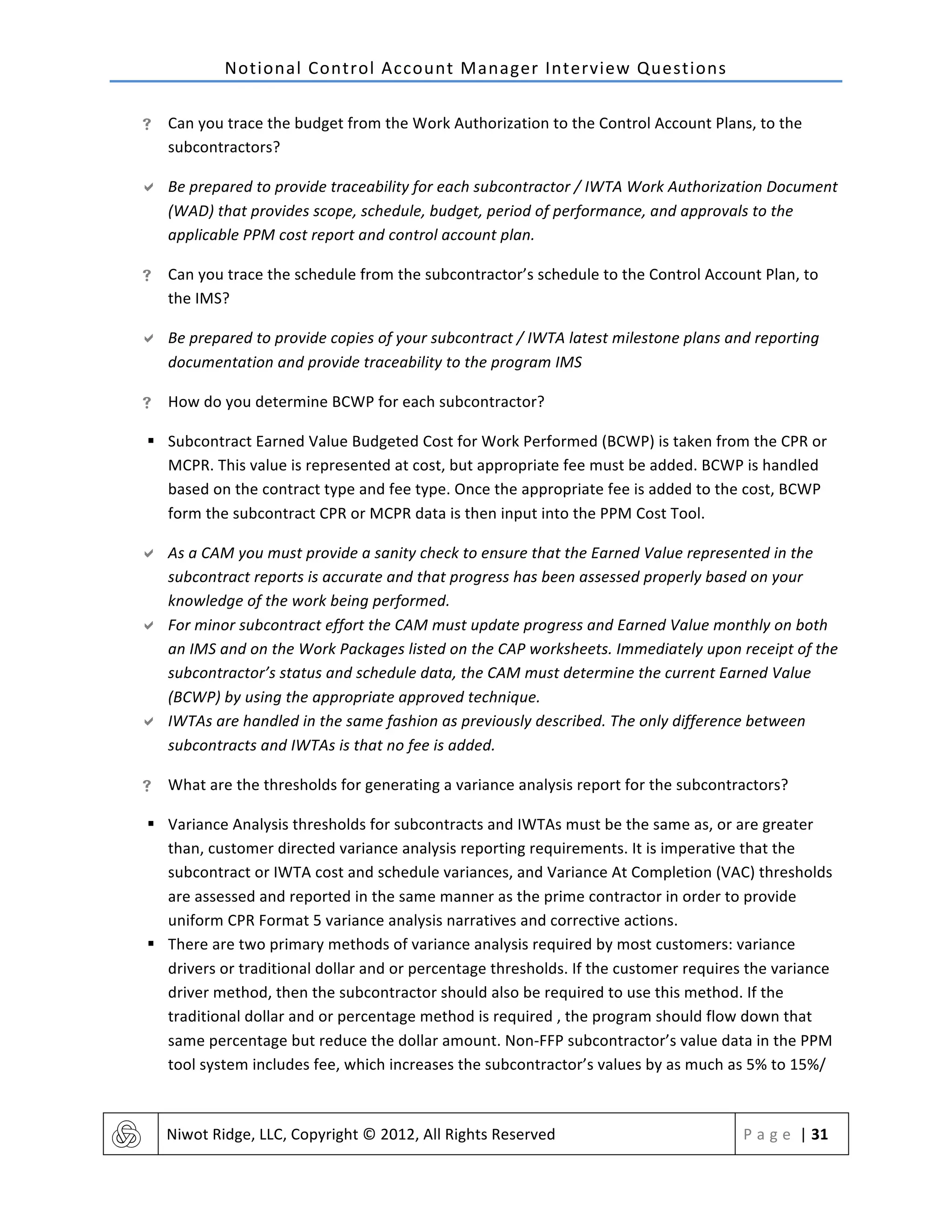

§ Subcontract
  Earned
  Value
  Budgeted
  Cost
  for
  Work
  Performed
  (BCWP)
  is
  taken
  from
  the
  CPR
  or

MCPR.
  This
  value
  is
  represented
  at
  cost,
  but
  appropriate
  fee
  must
  be
  added.
  BCWP
  is
  handled

based
  on
  the
  contract
  type
  and
  fee
  type.
  Once
  the
  appropriate
  fee
  is
  added
  to
  the
  cost,
  BCWP

form
  the
  subcontract
  CPR
  or
  MCPR
  data
  is
  then
  input
  into
  the
  PPM
  Cost
  Tool.

" As
  a
  CAM
  you
  must
  provide
  a
  sanity
  check
  to
  ensure
  that
  the
  Earned
  Value
  represented
  in
  the

subcontract
  reports
  is
  accurate
  and
  that
  progress
  has
  been
  assessed
  properly
  based
  on
  your

knowledge
  of
  the
  work
  being
  performed.

" For
  minor
  subcontract
  effort
  the
  CAM
  must
  update
  progress
  and
  Earned
  Value
  monthly
  on
  both

an
  IMS
  and
  on
  the
  Work
  Packages
  listed
  on
  the
  CAP
  worksheets.
  Immediately
  upon
  receipt
  of
  the

subcontractor’s
  status
  and
  schedule
  data,
  the
  CAM
  must
  determine
  the
  current
  Earned
  Value

(BCWP)
  by
  using
  the
  appropriate
  approved
  technique.

" IWTAs
  are
  handled
  in
  the
  same
  fashion
  as
  previously
  described.
  The
  only
  difference
  between

subcontracts
  and
  IWTAs
  is
  that
  no
  fee
  is
  added.

! What
  are
  the
  thresholds
  for
  generating
  a
  variance
  analysis
  report
  for
  the
  subcontractors?

§ Variance
  Analysis
  thresholds
  for
  subcontracts
  and
  IWTAs
  must
  be
  the
  same
  as,
  or
  are
  greater

than,
  customer
  directed
  variance
  analysis
  reporting
  requirements.
  It
  is
  imperative
  that
  the

subcontract
  or
  IWTA
  cost
  and
  schedule
  variances,
  and
  Variance
  At
  Completion
  (VAC)
  thresholds

are
  assessed
  and
  reported
  in
  the
  same
  manner
  as
  the
  prime
  contractor
  in
  order
  to
  provide

uniform
  CPR
  Format
  5
  variance
  analysis
  narratives
  and
  corrective
  actions.

§ There
  are
  two
  primary
  methods
  of
  variance
  analysis
  required
  by
  most
  customers:
  variance

drivers
  or
  traditional
  dollar
  and
  or
  percentage
  thresholds.
  If
  the
  customer
  requires
  the
  variance

driver
  method,
  then
  the
  subcontractor
  should
  also
  be
  required
  to
  use
  this
  method.
  If
  the

traditional
  dollar
  and
  or
  percentage
  method
  is
  required
  ,
  the
  program
  should
  flow
  down
  that

same
  percentage
  but
  reduce
  the
  dollar
  amount.
  Non-­‐FFP
  subcontractor’s
  value
  data
  in
  the
  PPM

tool
  system
  includes
  fee,
  which
  increases
  the
  subcontractor’s
  values
  by
  as
  much
  as
  5%
  to
  15%/

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  32

as
  such,
  tighter
  variance
  thresholds
  should
  be
  given
  to
  the
  subcontractor,
  and
  these
  should
  be

documented
  in
  the
  variance
  reporting
  thresholds
  section
  of
  the
  PPM
  Program
  Directive.

! Is
  the
  subcontractor’s
  ETC
  consistent
  with
  the
  IMS
  forecast
  completion
  date?

" Be
  prepared
  to
  provide
  copies
  of
  your
  subcontract
  or
  IWTA
  latest
  milestone
  plans
  and
  reporting

documentation
  and
  provide
  traceability
  to
  the
  program
  IMS.

" Show
  traceability
  for
  each
  subcontract
  Estimate
  To
  Complete
  (ETC)
  period
  of
  performance
  as

reflected
  in
  the
  appropriate
  Organizational
  Performance
  Report
  or
  equivalent,
  to
  the
  completion

dates
  reflected
  in
  the
  IMS.

! Is
  you
  subcontractor
  required
  to
  do
  a
  Comprehensive
  EAC
  (CEAC)?

§ Subcontract
  or
  IWTA
  Estimate
  At
  Complete
  (EAC)
  should
  be
  reviewed
  monthly
  and
  updated
  as

appropriated.
  Subcontract
  and
  IWTA
  Comprehensive
  Estimate
  At
  Completion
  (EAC)
  must
  be

conducted
  annually
  at
  the
  same
  time
  the
  prime
  contractor
  perform
  its
  CEAC,
  as
  described

Program
  Directive
  and
  the
  Business
  Rhythm
  Calendar.
  Subcontract
  or
  IWTA
  CEAC
  process
  may

be
  performed
  more
  often,
  or
  at
  a
  different
  time
  as
  the
  prime,
  but
  must
  be
  authorized
  and

documented
  in
  the
  PPM
  Program
  Directive
  and
  Business
  Rhythm
  Calendar.

" Be
  prepared
  to
  show
  the
  PPM
  Program
  Directive
  and
  Business
  Rhythm
  Calendar
  reflects
  the

latest
  upcoming
  subcontract
  or
  IWTA
  CEAC
  process
  dates.

" Provide
  the
  latest
  CEAC
  documentation
  (if
  performed)
  and
  be
  able
  to
  explain
  the
  process
  and

how
  the
  data
  is
  incorporated
  in
  the
  Contract
  Performance
  Report
  (CPR)
  and
  IMS
  documentation.

! How
  often
  is
  this
  done?

" Be
  prepared
  to
  support
  the
  period
  of
  assessment
  for
  the
  Subcontractor
  CEAC
  and
  its
  relation
  to

programmatic
  risk
  reduction.

! How
  is
  it
  incorporated?

" Be
  prepared
  to
  show
  who
  the
  subcontract
  CEAC
  and
  the
  associated
  programmatic
  risk
  is

incorporated
  in
  the
  Performance
  Measurement
  Baseline.

! Does
  your
  subcontractor
  have
  a
  risk
  mitigation
  plan?

" If
  the
  Subcontract
  has
  a
  risk
  management
  plan,
  show
  a
  copy
  and
  explain
  its
  use.

«MATERIAL
  MANAGEMENT»

§ If
  there
  are
  Control
  Accounts
  with
  material,
  you
  need
  to
  answer
  the
  following
  questions:

! Is
  the
  material
  high
  or
  low
  value,
  and
  how
  are
  these
  values
  determined?

" The
  process
  of
  material
  management
  is
  described
  below

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  33

§ “Initially
  material
  budgets
  can
  be
  placed
  in
  planning
  packages
  until
  specific
  material

requirements
  are
  identified
  (by
  purchase
  requisition,
  purchase
  order,
  development
  Bill
  of

Materials,
  or
  material
  lists).
  As
  requirements
  are
  identified,
  budgets
  are
  converted
  into
  tasks

with
  schedules
  and
  estimated
  or
  know
  costs.
  For
  the
  purpose
  of
  performance
  management

there
  are
  generally
  three
  type
  of
  material:
  direct
  charge,
  inventory,
  and
  miscellaneous
  material.

BCWS
  and
  BCWP
  are
  handled
  differently
  for
  each
  category.”

§ “If
  a
  program
  does
  not
  utilize
  a
  Materials
  Requirements
  Plan
  (MRP)
  system
  for
  tracking
  direct
  or

inventory
  material,
  it
  must
  be
  tracked
  using
  high-­‐dollar-­‐value
  or
  high-­‐quantity
  level
  that

warrants
  planning
  and
  statusing
  by
  part
  number
  because
  of
  its
  criticality
  to
  the
  program.
  The

definition
  of
  “high
  dollar
  or
  high
  quantity”
  must
  be
  defined
  in
  the
  Program
  Directive.
  High
  Value

Material
  is
  to
  be
  planned
  discretely
  while
  low
  value
  material
  may
  be
  planned
  as
  Level
  of
  Effort.”

" Be
  prepared
  to
  explain
  how
  the
  program
  determine
  “high”
  and
  “low”
  value
  material

requirements,
  and
  provide
  the
  definition
  referenced
  in
  the
  Program
  Directive.

! How
  do
  you
  plan
  your
  material?
  Is
  it
  listed
  by
  Bill
  of
  Materials
  or
  an
  equivalent?

§ BCWS
  for
  Direct
  Charge
  Material:
  typically
  Direct
  Charge
  Material
  is
  represented
  by
  estimated

(of
  not
  yet
  negotiated)
  pt
  negotiated
  values
  time-­‐phased
  by
  month;
  and
  based
  on
  milestone

schedules,
  on
  expected
  receipt
  of
  hardware
  to
  the
  point-­‐of-­‐use,
  or
  on
  a
  monthly
  percentage.

§ In
  determining
  the
  BCWS
  methodology
  consideration
  should
  be
  given
  to
  program
  requirements,

the
  subcontractor
  /
  purchase
  order
  type
  of
  the
  contract
  and
  the
  payment
  terms
  (milestones,

payment
  on
  delivery,
  etc.).
  Tasks
  should
  be
  primarily
  considered
  “discrete
  effort”
  and
  planned

as
  such,
  using
  any
  of
  the
  Earned
  Value
  techniques
  defined
  in
  the
  Program
  Directive.

§ Inventory
  Material
  BCWS:
  BCWS
  for
  inventory
  material
  should
  be
  time
  phased
  in
  months
  based

on
  the
  expected
  point
  of
  consumption.
  Typically
  this
  is
  based
  on
  anticipated
  inventory

withdrawal,
  or
  the
  expected
  parts
  fabrication
  support.
  Inventory
  materials
  tasks
  should
  be

primarily
  considered
  “discrete
  effort.”
  The
  only
  tasks
  that
  should
  be
  planned
  as
  LOE
  are

common
  use
  inventory
  items
  such
  as
  fasteners,
  wire,
  bulks
  supplies
  and
  standard
  parts.

§ Miscellaneous
  Material
  BCWS:
  BCWS
  for
  miscellaneous
  material
  Work
  Packages
  should
  be

planned
  as
  LOE.

" Be
  prepared
  to
  explain
  how
  you
  have
  planned
  your
  material,
  and
  provide
  Bill
  of
  Materials
  if

available.

" Explain
  any
  alternative
  methods
  you
  use
  to
  track
  your
  material
  requirements.

! Is
  the
  high
  value
  material
  tracked
  in
  the
  cost
  system?

" Based
  on
  the
  answer
  from
  above,
  show
  the
  appropriate
  high
  level
  materials
  Control
  Account
  or

work
  package
  monthly
  BCWS
  spreads
  as
  reflected
  in
  the
  cost
  accounting
  system
  report.

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  34

! What
  Earned
  Value
  techniques
  are
  used
  for
  the
  high
  value
  materials?

" Utilizing
  the
  definitions
  for
  BCWS
  provided
  in
  answer
  above,
  explain
  the
  appropriated
  Earned

Value
  techniques
  you
  use
  for
  your
  Low
  and
  High
  Value
  material
  Control
  Accounts
  or
  work

packages.

! Are
  material
  actual
  and
  Earned
  Value
  recorded
  on
  the
  same
  basis
  /
  time
  period?

§ Direct
  Charge
  BCWP:
  is
  based
  on
  completion
  or
  milestones,
  percent
  complete,
  or
  receipt
  and

acceptance
  of
  material

§ Direct
  Charge
  ACWP:
  are
  typically
  entered
  into
  work
  in
  progress
  when
  material
  is
  received,

milestone
  requirements
  are
  completed,
  or
  nondeliverable
  items
  have
  been
  invoiced.
  When

using
  the
  Percent
  Complete
  methodology,
  ACWP
  must
  be
  ratioed
  (allocated)
  relative
  to
  BCWP

percentages,
  thereby
  reflecting
  true
  purchase
  order
  values.
  Estimated
  actual
  can
  be
  used
  to

avoid
  billing
  lags
  between
  accrual
  and
  paid
  values.
  In
  addition,
  based
  on
  program
  requirements,

ACWP
  may
  be
  allocated
  but
  must
  be
  readily
  traceable
  to
  subcontract
  or
  purchase
  order
  values.

§ Miscellaneous
  Material
  BCWS:
  is
  credited
  using
  LOE
  Earned
  Value
  methodology.
  BCWP
  is

measured
  through
  the
  passage
  of
  time
  and
  always
  equals
  BCWS
  values.

§ Miscellaneous
  Material
  ACWP:
  are
  entered
  into
  work
  in
  progress
  when
  material
  is
  withdrawn

from
  common
  usage
  inventory
  based
  on
  accounting
  system
  practices
  (average
  unit
  costs,

standards,
  latest
  purchase
  order
  price,
  etc.)
  or
  based
  on
  invoice
  value
  for
  non-­‐inventory
  or

deliverable
  items.

" Based
  in
  the
  information
  provided
  above,
  explain
  how
  and
  at
  what
  time
  period,
  actual
  and

Earned
  Value
  /
  BCWP
  are
  recorded
  for
  the
  material
  you
  manage.

! To
  what
  extent
  is
  the
  variance
  being
  driven
  by
  price
  and
  /
  or
  quantity?

§ Variance
  analysis
  includes
  schedule,
  cost
  (price
  and
  usage)
  and
  “at
  complete”
  variances.

§ Schedule
  Variances:
  are
  used
  to
  determine
  if
  material
  availability
  jeopardized
  completion
  of

program
  milestones.
  Corrective
  actions
  include
  improved
  availability
  or
  a
  satisfactory
  work

around.
  Schedule
  variances
  reflect
  whether
  material
  was
  received,
  accepted,
  completes,
  by
  the

user
  when
  planned
  or
  in
  the
  case
  of
  point
  consumption
  items,
  whether
  the
  performance

occurred
  at
  expected
  consumption
  rates
  (manufacturing
  delays
  or
  re-­‐prioritization
  of
  tasks
  have

contributed
  to
  different
  than
  planned
  inventory
  withdrawal
  rates).

§ Cost
  Variances:
  are
  analyzed
  by
  segregating
  the
  price
  and
  use
  of
  components
  for
  the
  direct
  and

inventory
  material
  categories.
  Segregation
  of
  price
  and
  usage
  is
  not
  practical
  for
  LOE
  or

miscellaneous
  types
  of
  material.

§ Price
  Variances:
  analysis
  of
  potential
  price
  variances
  should
  begin
  when
  difference
  between
  the

actual
  material
  costs
  and
  amounts
  initially
  planned
  are
  recognized.
  The
  CAM
  is
  responsible
  for

analyzing
  price
  variances
  and
  ensuring
  they
  are
  included
  in
  the
  Estimate-­‐At-­‐Completion
  (EAC).

The
  price
  variance
  is
  calculated
  as:

(Budgeted
  Unit
  Price)
  –
  (Actual
  Unit
  Prices)
  x
  (Actual
  Quantity
  Used)

Notional
  Control
  Account
  Manager
  Interview
  Questions

   Niwot
  Ridge,
  LLC,
  Copyright
  ©
  2012,
  All
  Rights
  Reserved
   P a g e
  |
  35

§ Usage
  Variance:
  can
  be
  attributed
  to
  many
  causes
  including
  engineering
  changes,
  liaison
  calls,

order
  policies
  (safety
  stock),
  economics
  of
  scale,
  spares,
  minimum
  buys,
  nonconforming

material,
  substitute
  parts,
  part
  availability,
  etc.
  The
  usage
  variance
  calculation
  is:

(Budgeted
  Quantity)
  –
  (Actual
  Quantity)
  x
  (Budgeted
  Unit
  Price)

" If
  your
  material
  Control
  Account
  has
  a
  variance,
  explain
  to
  what
  extent
  the
  variance
  is
  being

driven
  by
  price
  and
  or
  quantity.

Notional cam interview questions (update)

  • 1.
                2012                   Glen  B.  Alleman   Niwot  Ridge,  LLC   Copyright  ©  2012   All  Rights  Reserved   +  1  303  241  9633       [NOTIONAL  CAM  INTERVIEW  QUESTIONS]   A  collection  of  CAM  interview  questions  and  typical  answers  based  on  ANSI-­‐748-­‐C  Earned  Value  Management  processes
  • 2.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  2     This  document  provides  “notional”  questions  and  answers  for  Control  Account  Managers  (CAM)  during   CAM  interviews,  IBR  interviews  and  DCMA  validation  and  surveillance  interviews.  The  sections  are   common  to  all  DCMA  style  programs.  The  body  of  this  document  has  sub  elements:   «TOP  LEVEL  SECTION»   § Background  information  in  support  of  the  question  and  its  answer  –  this  is  the  basis  of  the   activities  needed  for  the  CAM  interview  process.  It  contains  an  overview  of  the  guidance,   references  to  the  guidance  materials,  and  any  external  compliance  requirements.   ! Questions  that  will  be  asked  during  the  interview  –  this  is  a  guide  to  the  types  of  questions  that   will  be  asked  by  the  interviewer  or  auditor.   " Answers  to  those  questions  –  these  are  the  sample  answers  to  the  questions.  In  all  cases  these   answers  must  address  the  question  directly.  No  further  explanation  should  be  provided.   These  need  to  be  tailored  to  the  specific  needs  of  the  program  and  the  firm’s  environment.  The  Earned   Value  Management  System  –  System  Description  is  the  place  to  start  for  this  tailoring.  As  well  there   should  be  a  set  of  Program  Directive  guidance  and  support  work  instructions  that  support  the   implementation  of  the  System  Description  and  other  program  execution  processes.  Since  this  document   is  generic  in  purpose  there  are  some  terms  that  are  also  generic.   PPM  –  Program  Performance  Management  –  guidance  describing  the  processes  used  to   management  programmatic  performance.   EVMS-­‐SD  –  Earned  Value  Management  System  –  System  Description  –  guidance  for  applying   Earned  Value  Management  to  the  program  and  the  source  of  guidance  for  the  DCMA  audits.   Topics  in  the  notional  interview  guide  include:   1. Training  –  what  training  materials,  course,  and  guidance  should  the  CAM  have  had  prior  to   assuming  the  role  of  a  CAM?   2. Organization  –  how  is  the  program  organized?  How  does  the  CAM  interact  with  the   program  members?  Who  is  the  CAM  accountable  to  for  the  deliverables  and  reporting?   3. Work  Authorization  –  how  is  work  authorized?  How  does  the  CAM  know  what  work  he  or   she  is  accountable  for?   4. Planning  –  how  is  the  Performance  Measurement  Baseline  represented?  How  does  the  CAM   know  what  portions  of  the  PMB  he  or  she  is  accountable  for?   5. Earned  Value  –  how  are  the  Earned  Value  metrics  taken?   6. Change  Control  –  how  are  changes  to  the  PMB  managed?   7. Analysis  –  what  analytical  metrics  are  used  to  manage  the  program?   8. Risk  –  how  are  programmatic  and  technical  risk  managed?   9. Estimate  at  Completion  –  what  processes  are  used  to  produce  a  credible  EAC?   10. Subcontractor  Management  –  how  are  subcontracts  managed  by  the  CAM?   11. Material  Management  –  how  is  material  managed  by  the  CAM?
  • 3.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  3     Evidence  Needed  by  the  CAM   Interview  support   Statement  of  Work  (SOW)  for  the   accountable  Control  Accounts  and  Work   Packages   § Highlight  your  applicable  area  of  the  SOW   Contract  Work  Breakdown  Structure   (CWBS)  with  WBS  Dictionary  and  Exit   Criteria  for  each  Work  Package  and   deliverable   § WBS  dictionary   § Highlight  your  applicable  area  of  the  WBS  tree   § Technical  Performance  Measures  for  critical  deliverables   § Exit  criteria  for  Work  Package   § Quantifiable  Backup  Data  (QBD)  for  measures  of  percent   complete   Organization  (OBS)   § Level  II  organization  charts   § CAM  organizational  charts   Responsibility  Assignment  Matrix  (RAM)   § Bring  the  RAM  to  the  interview   § Identify  your  items  in  the  RAM   Schedules  (DID  81861  compliant  IMS)   § Integrated  Master  Plan  (IMP)   § Integrated  Master  Schedule  (IMS)   § IMS  Work  Package  Level  Data   § Predecessor  and  Successor  report   § Status  of  Late  Starts  and  Late  Finishes   § Supplemental  or  Detailed  Schedules   Budget  and  Work  Authorization   Documents  (WAD)   § Initial  signed  WAD   § Control  Account  WADs  and  any  changes  from  the  BCR   Control  Account  Plans  (CAP)  /  Task  and   Work  Plans   § Copy  of  the  discrete  MS  Project  reports   § Cost  system  budget  distribution  by  Control  Account   Report   Requesting  Work  Authorization   Documents     § Requesting  WADs  approved  and  signed   § IMS  Change  Request  &  Change  worksheets   Estimate  Change  Request  (ECR)   § ECRs   § Bottoms  up  ground  rules  for  changes   § Basis  of  Estimate  (BOE)  and  ETC  justification   § Staffing  charts   Performance  Measurement  processes   § Earned  Value  data  for  Work  PCKAGES     § “redlined”  CAPs  showing  all  changes   Actual  Cost   Physical  Percent  Complete  with  QBD   § Weekly  actual  reports   § Cost  system  resource  code  index   § Control  account  instructions   Analysis  and  Reporting   § Variance  threshold  requirement  contained  in  the  Program   Directive   § Variance  At  Completion  (VAC)   Risk  Management   § Outline  all  technical,  schedule,  cost,  resource,  and   management  process  risks.     § Risk  register  showing  handling  processes  in  the  IMS   § Risk  register  showing  Management  Reserve  allocation     § Be  prepared  to  provide  risk  mitigation  plans
  • 4.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  4     «HISTORY  OF  THIS  DOCUMENT»   CAM  interviews  are  part  of  every  Earned  Value  Management  System  verification  and  part  of  every   weekly  program  performance  management  process.  These  “notional”  questions  have  been  captured   over  several  decades  of  work  within  earned  value  based  project  and  programs,  going  back  to  the  C/SCSC   days  before  ANSI-­‐748A/B/C.  The  content  grows  every  program  I  work.   Over  time  DCMA,  Department  of  Defense,  and  the  Defense  Acquisition  University  have  developed   guidelines  for  CAM  interviews  and  Validation  and  Surveillance  processes.  These  have  been  incorporated   into  this  guide.   As  well  hands  on  Validation  and  Surveillance  experience  has  shown  that  the  core  questions  asked  and   the  critical  success  factors  for  any  program  are  incorporated  in  the  CAM’s  ability  to  answer  –  with   credible  evidence  –  these  questions.
  • 5.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  5     «THE  ABRIDGED  VERSION  OF  THE  CAM  INTERVIEW»   General  –  what  is  the  primary  role  of  the  CAM  on  a  weekly  project  rhythm     ! Do  you  have  multiple  Control  Accounts,  or  just  one?  What  are  they?   ! What  is  the  approximate  dollar  value  of  your  Control  Account?   ! What  is  the  nature  of  work  in  your  Control  Account?   ! How  long  have  you  been  a  Control  Account  Manager?   ! Do  you  like  being  a  CAM?  If  not,  do  you  accept  the  responsibility  and  function?   ! Have  you  read  the  EVM  System  Description?   ! Have  you  read  the  accompanying  Work  Instructions?   ! Have  you  read  the  Program  Management  Plan  (PMP)?   ! Demonstrate  the  contents  of  your  CAM  Notebook.   ! Have  you  taken  the  CAM  training  provided?  Or  have  you  completed  an  equivalent  course?   ! What  training  do  you  think  you  need  to  be  effective  as  a  CAM?   ! What  areas  of  training     Organizing  Your  Control  Account  –  does  the  CAM  know  who  is  working  on  what  in  the  CA?   ! Show  me  your  OBS.     ! Does  your  Functional  organization  align  with  your  OBS?  If  not,  how  is  it  traced  to  the  OBS?   ! Who  assigns  named  resources  to  your  Control  Account?  Can  you  get  whomever  you  need,  or   must  you  request  resources?   Authorizing  your  Work  –  does  the  CAM  know  what  should  be  worked  on  and  the  outcome?   ! Who  directs,  approves,  and  assigns  you  to  work  on  a  control  account?   ! Do  you  have  a  signed  CAP/PWAA?  Does  the  PWAA  indicate  WBS,  title/description  of  the  work,   BAC  (in  hours  or  dollars),  with  Start-­‐End  dates?   ! What  paragraphs  in  your  SOW  describe  your  work?    Is  your  work  specific  or  implied?   ! What  CDRLs  apply  to  your  work?   ! What  DIDs  apply  to  your  work?     ! How  do  you  authorize  work?  Demonstrate  your  CNA  artifact  and  discuss  the  process.       ! How  are  charge  numbers  opened  and  closed?     ! Do  your  planning  packages  have  charge  numbers?   ! Are  actuals  collected  and  charge  numbers  established  at  the  WP  level?  Lower?   ! Is  an  approved  BCR  authorization  your  to  proceed  or  do  you  need  a  revised  CAA?   Organizing  the  Work  –  does  the  CAM  know  what  “done”  looks  like  for  this  CA   ! Where  is  your  WBS?  Is  work  decomposed  into  logical  Work  Packages  from  the  WBS  structure?   ! Show  me  your  WBS  dictionary?  Are  all  the  informational  elements  present?  Does  it  accurately   reflect  the  SOW  and  IMP  (or  deliverables  plan)?   ! What  is  the  deliverable  for  the  work  done  in  your  Control  Account?   ! Demonstrate  your  program  level  RAM.     ! Has  the  RAM  been  dollarized?  Does  each  Control  Account  have  an  established  value?
  • 6.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  6     ! Demonstrate  your  detailed  RAM?     ! Demonstrate  your  Basis  of  Estimate  summary?   ! What  is  your  estimating  process/tool?   ! Demonstrate  your  CAP?   Schedule  –  can  the  CAM  brief  the  order  of  work  needed  to  get  to  “Done?”   ! Do  you  have  milestone  schedule?   ! Do  you  have  direct  access  to  the  IMS?  If  not,  do  you  receive  a  schedule  extract?     ! Does  the  deliverables  milestone  schedule  correspond  to  the  IMS?   ! Identify  your  Control  Accounts  in  the  IMS.     ! What  is  the  frequency  of  schedule  updates?     ! What  is  the  process  for  making  a  schedule  change?  Who  approves  the  change  and  how  is  it   implemented  in  the  schedule?   ! Identify  your  Work  Packages  and  Planning  Packages.  Is  there  visibility  of  work  below  the  Work   Package  level?   ! Which  milestones  relate  to  your  effort?  Identify  these  in  your  schedules.   ! Are  your  schedules  resource  loaded?  In  dollars  or  hours?  At  what  level?     ! Are  your  forecasts  resource  loaded?     ! If  used,  explain  Rolling  Wave  planning  process,  planning  packages,  and  summary  level  planning   packages.   ! Does  BCWS  on  the  CAP  correspond  to  BCWS  on  the  IMS  and  PMB  databases?   Assessing  Performance   ! Explain  and  justify  the  earned  value  types  you  use  (i.e.,  0/100,  50/50,  m/s,  %  complete,  LOE).   ! What  are  the  technical  criteria  that  support  your  assessment  of  performance  attained?   ! What  are  your  schedule  baseline  start  and  finish  dates?     ! What  is  the  duration  of  Work  Packages?   ! Demonstrate  how  and  when  status  is  reported?  Trace  to  month-­‐end  BCWP   Budget   ! What  resources  are  assigned  to  do  the  work?   ! Do  you  have  named  resources  or  generic  resources?   ! How  is  the  rate  determined  for  resources?   ! Do  you  have  visibility  of  resource  rates?  Or  do  you  deal  with  hours  only?   ! How  are  resources  assigned  to  the  tasks  in  your  schedule?  Do  you  select  resources  from  a   lookup  table?   ! Are  you  responsible  for  indirect  costs?   ! Do  you  have  Material,  Travel,  Sub  contractors,  Taxes,  or  ODCs?     ! Where  are  Material,  Travel,  Sub  contractors,  Taxes,  or  ODCs  in  your  schedule?     ! Does  the  BAC  in  your  CAP  correspond  to  your  schedule?   ! Does  the  BCWS  in  your  CAP  correspond  to  your  schedule?   ! Does  the  resource  allocation  in  your  CAP  correspond  to  your  schedule?
  • 7.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  7     Accounting   ! What  Accounting  reports  do  you  receive?   ! What  labor  reports  do  you  receive,  e.g.,  Hours  or  Actuals?   ! What  non-­‐labor  actual  reports  do  you  receive?     ! Are  you  required  to  maintain  element  of  cost  identification  (when  charge  numbers  do  not   distinguish  between  material  types)?  How  do  you  do  it?     ! Do  you  sign/approve  timecards  of  those  who  charge  your  work?   ! How  are  mischarges  corrected?     ! Does  ACWP  on  your  Accounting  report  match  ACWP  on  your  CAP?   Analysis   ! What  performance  reports  do  you  receive?  And  from  what  reporting  systems?     ! Can  you  explain  anomalies,  for  example  when:  P  no  A;  A  no  P;  P>BAC;  A>EAC;  -­‐  S,  P,  or  A   ! What  are  SPI,  CPI,  TCPI,  BEI,  and  CPLI?   ! What  are  your  VAR  reporting  thresholds?  Where  are  the  threshold  parameters  specified?   ! Show  me  your  history  of  VARs.  Review  VAR  explanations   ! Demonstrate  how  VAR  corrective  actions  are  tracked.     EAC  and  ETC   ! How  do  you  get  ETC  and  EAC?   ! How  do  you  put  EAC  and  ETC  into  the  system?   ! Does  EAC  and  ETC  go  into  MSProject  as  “%  Complete”?  Or  does  BCWR  =  ETC?     ! How  often  can  you  change  the  EAC  for  your  control  accounts?     Material,  Travel,  ODC,  Taxes   ! What  is  the  value  of  material,  travel,  ODCs,  or  taxes  in  your  Control  Account?     ! What  EV  type  do  you  use  for  material,  travel,  ODCs,  or  taxes?     ! Demonstrate  where  material,  travel,  ODCs,  or  taxes  are  planned  in  your  schedule.  How  was   BCWS  determined  and  time-­‐phased?   ! Is  BCWP  earned  at  receipt  or  usage?     ! Demonstrate  how  you  forecast  receipt  of  material,  travel,  ODCs,  or  taxes.     ! What  is  the  process  for  Rejected  material?  Is  BCWP  decremented?   ! Explain  the  process  for  Property  management.     ! Demonstrate  your  material  receiving  reports.   ! Demonstrate  your  open  commitments  reports.   ! Demonstrate  your  travel  log     ! Demonstrate  an  example  of  unit/lot  costing.   ! Demonstrate  examples  of  price/usage  variance  analysis.
  • 8.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  8     Subcontracts   ! Do  you  manage  any  subcontractors?     ! Demonstrate  your  major  subcontracts  in  the  WBS  dictionary.   ! What  is  the  nature  of  the  sub-­‐contracted  effort?  Labor  hours  or  a  clearly  defined  deliverable?     ! What  type  of  contract  drives  the  sub-­‐contracted  effort?  T&M,  Firm  Fixed  Price?     ! Explain  flow  down  requirements  for  subcontractor  EVMS.  Full  EVMS  with  certification;  EVMS   compliance  only;  no  EVMS?   ! Trace  subcontract  effort  in  the  IMS.   ! What  is  the  basis  for  assessing  subcontractor  performance?     ! What  is  the  basis  for  assessing  ETC  of  sub-­‐contracted  effort?     ! Where  is  the  subcontract  effort  indicated  in  the  CAP?   ! Explain  process  for  accrual  of  an  estimated  ACWP  for  sub-­‐contracted  work.   ! Have  you  visited  your  subcontractor?  Show  me  results  of  your  reviews.     ! What  formal  performance  reporting  requirements  do  you  receive  from  subs?   ! Is  the  sub-­‐contracted  effort  formally  observed  and  evaluated?     Change  Control   ! How  often  do  you  change  your  baseline?     ! How  do  changes  get  submitted  and  approved?  Explain  the  BCR  process.   ! Have  you  had  a  change?  Explain.  Demonstrate  your  BCR.  Demonstrate  before  and  after  in  your   IMS  and  on  your  CAP.   ! Where  are  the  documents  that  support  your  baseline  changes?   ! Are  your  BCRs  (Budget  Change  Request)  signed?   ! Under  what  circumstances  can  you  request  Management  Reserve?   ! How  is  your  management  reserve  calculated?   ! Do  you  have  Contingency  Reserve  (i.e.,  slack  or  float)?   Risk   ! What  tool  do  you  use  to  identify  risk?   ! What  tool  do  you  use  to  track  and  report  risk?   ! What  tool  do  you  use  to  quantify  risk  assessment?   ! System  Description  requires  Risk  added  to  EAC  when  probability  reaches  80%.  How  do  CAMs   determine  80%  probability?     ! How  are  Risks  recorded  and  indicated  on  Risk  Registry?     ! How  do  you  nominate  Risks  to  be  put  on  Risk  Registry?   ! How  do  you  escalate  Risks?   ! How  do  you  close  out  Risks?   ! Demonstrate  your  Risks?   ! What  are  your  risk  areas?  Cost?  Schedule?  Technical?
  • 9.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  9     Accrual  of  Estimated  Actuals   ! What  do  you  accrue  on  a  regular  basis?   ! Who  does  the  accrual  of  estimated  actuals?   ! Where  is  the  record/artifact  of  accruals?   ! Where  is  the  CAM  documentation  kept  that  validates  accrual?   ! Who  does  the  monthly  reversal  process?   ! How  is  the  reversal  process  performed?   ! What  documentation  do  you  retain  to  justify  the  accrual  of  estimated  actual?
  • 10.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  10     «TRAINING»   § Training  processes  are  the  core  of  CAM  success.  This  training  must  include  the  mechanics  of   the  EVMS  as  well  as  the  governance  process  applied  to  Control  Accounts   ! When  did  you  last  receive  PP&C  or  CAM  training?   " Our  formal  EVM  System  Description  is  the  starting  point  for  our  training.  The  CAM  notebook   training  covers  the  use  of  all  materials  we  need  to  do  our  job  as  a  CAM,  guided  by  the  EVM   System  Description.   «ORGANIZATION»   § Define  the  authorized  work  elements  for  the  program.  A  work  breakdown  structure  (WBS),   tailored  for  effective  internal  management  control,  and  is  commonly  used  in  this  process.   § Identify  the  program  organizational  structure  including  the  major  subcontractors  responsible   for  accomplishing  the  authorized  work,  and  define  the  organizational  elements  in  which  work   will  be  planned  and  controlled.   § Provide  for  the  integration  of  the  company’s  planning,  scheduling,  budgeting,  work   authorization  and  cost  accumulation  processes  with  each  other,  and  as  appropriate,  the   program  work  breakdown  structure  and  the  program  organizational  structure.   § Identify  the  company  organization  or  function  responsible  for  controlling  overhead  (indirect   costs).   § Provide  for  integration  of  the  program  work  breakdown  structure  and  the  program   organizational  structure  in  a  manner  that  permits  cost  and  schedule  performance   measurement  by  elements  of  either  or  both  structures  as  needed.   ! Show  your  organizational  chart  and  describe  your  responsibilities   " Be  prepared  to  show  application  organizational  charts  with  traceability  from  the  highest  level   program  organization  to  the  lowest  level  where  resources  support  your  work  scope.     " Highlight  this  traceability  from  the  highest  to  the  lowest  level.  Be  prepared  to  discuss  your  roles   and  responsibilities  as  reference  on  your  applicable  organizational  chart.   ! Where  is  your  scope  of  work  defined?   § This  information  is  defined  in  the  Statement  of  Work  (SOW)  and  WBS  Dictionary.     § The  WBS  Dictionary  is  correlated  with  each  WBS  element  to  the  SOW  tasks.     § The  WBS  Dictionary  describes  the  effort,  and  the  Control  Accounts  through  with  the  effort  will   be  accomplished.     " Be  prepared  to  show  the  SOW  and  WBS  dictionary.     " Explain  their  use  as  they  apply  to  your  Control  Accounts.     " Highlight  your  applicable  SOW  and  WBS  dictionary  paragraphs.
  • 11.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  11     " Show  the  IMP  matrix  and  explain  its  logic.     ! Do  you  own  or  support  any  of  the  Events,  Accomplishments,  or  Criteria  in  the  IMP?   § Systems  Engineering  is  responsible  for  the  development  of  the  Integrated  Master  Plan  (IMP)   Matrix.  The  IMP  Matrix  is  an  event  driven  plan  of  Program  Events  (PE),  Significant   Accomplishments  (SA),  Accomplishment  Criteria  (AC),  and  Process  Definition  (process   narratives)  which  encompass  the  scope  of  your  program  activities.  The  IMP  defines  WHAT  and   HOW  –  but  not  WHEN  (scheduled  dates).   " Be  prepared  to  show  the  IMP  Matrix,  explain  that  the  IMP  Matrix  contains  Program  Events  (PE),   Significant  Accomplishments  (SA),  and  Accomplishment  Criteria  (AC).     " Be  prepared  to  show  and  explain  those  PE’s,  SA’s  and  the  AC  as  they  pertain  to  your  Work   Package,  its  scope,  the  Control  Accounts  and  how  they  relate  and  trace  to  the  Integrated  Master   Schedule  (IMS).  High  light  your  applicable  IMP  PE’s,  SA’s  and  the  AC  in  the  IMP  Matrix.   ! What  WBS  elements  are  you  responsible  for?   § The  WBS  tree  reflects  the  WBS  elements  for  which  you  are  responsible.     " Be  prepared  to  show  the  applicable  WBS  elements  with  traceability  from  the  lowest  level  to  the   highest  level  of  the  WBS  Tree.     " Highlight  traceability  from  the  lowest  to  the  highest  level.   ! Show  your  responsibility  Assignment  Matrix  (RAM)   § The  Responsibility  Assignment  Matrix  (RAM)  is  the  intersection  of  the  Organization  Breakdown   Structure  (OBS)  and  the  Work  Breakdown  Structure  (WBS)  responsibilities.     " Be  prepared  to  show  the  intersection  with  your  Control  Accounts  as  reflected  on  the  RAM.     " Understand  all  components  contained  in  the  RAM  that  pertain  to  your  Control  Accounts.     " Highlight  your  applicable  Control  Account  data.   ! How  many  Control  Accounts  do  you  have  and  what  are  their  total  budgets?     " Identify  the  Control  Accounts  on  the  RAM  for  data  traces   " Identify  your  Control  Accounts  on  the  RAM  and  be  prepared  to  show  the  Budget  At  Completion   (BAC)  for  each  Control  Account  (burdened  and  direct  dollars).     " Show  how  the  BAC  for  each  Control  Account  is  reflected  on  the  current  month  Control  Account   Organizational  Performance  Report  (CA  OPR).
  • 12.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  12     «WORK  AUTHORIZATION»   § Maintaining  the  proper  sequence  of  work  package  execution  is  critical  to  the  generation  of   credible  Earned  Value  Management  data.  Work  preformed  out  of  sequence  either  has  not   budget  assigned  for  that  period  of  performance  or  has  budget  assigned  but  no  work  be   performed  or  some  combination.   § In  both  cases  the  Earned  Value  number  cannot  represent  the  proper  progress  of  the  project.   ! What  authorizes  you  to  begin  your  work?  Are  the  appropriate  signatures  present?   § Operation  Directives  (Program  Directives  or  other  firm  dependence  names)  provide  the  Program   with  the  Authorization  to  Proceed  (ATP).     " Be  prepared  to  show  this  OD  (PD)  as  well  as  any  other  OD’s  (PD’s)  that  authorize  contract   changes  which  impact  your  Control  Accounts.  Identify  appropriate  approval  signatures.   " The  work  authorization  process  triggers  the  planning,  scheduling,  budgeting,  and  performance  of   work  form  the  total  program  level  through  the  responsible  organizational  structure  to  the   Control  Account  level.     " The  Work  Authorization  process  begins  with  an  OD  (PD)  issues  by  the  Contracts  Organization.   The  OD  (PD)  authorizes  the  program  to  issues  a  Work  Authorization  Document  (WAD)  that   defines  all  authorized  work  elements  on  the  program.     " Once  the  OD  (PD)  has  been  issued,  authorizing  work  to  commence  on  a  contract  or  contract   change,  all  program  work  subsequently  must  be  authorized  or  directed  by  a  WAD.   ! Identify  the  key  elements  on  the  Work  Authorization  Document  (WAD)   " The  WAD  contains  the  following  key  elements   " Scope  of  the  work  to  be  performed  in  terms  of  activities  and  deliverables   " Schedule  of  the  work  packages  that  performance  the  work   " Budget  for  each  Work  Package   " Period  of  Performance  for  the  collective  Work  Packages   " Approval  processes  for  this  work  and  the  release  of  the  funding   ! Show  how  you  can  trace  the  key  work  elements  on  the  latest  approved  WAD?   " The  following  key  elements  of  the  latest  approved  WAD  are:   " Scope  to  SOW/WBS  Dictionary  or  equivalent   " Budget  on  WAD  to  the  Cost  Control  System  –  the  Budget  Distribution  Reports   " Validate  that  the  WAD  is  consistent  with  the  period  performance  on  the  Integrated  Master   Schedule  (IMS),  baseline  date  and  revision  number   " Provider  a  description  of  each  of  these  documents  and  the  processes  used  to  create  and   management  them
  • 13.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  13     ! Does  the  Control  Account  period  of  performance  on  the  WAD  match  the  start  and  end  dates  for   the  time  phased  resources  in  your  Control  Account  Plan?   " Be  prepared  to  trace  the  period  of  performance  for  each  Control  Account  budget  referenced  on   the  current  approved  WAD  to  the  applicable  IMS  time–phases  Control  Account  /  task  period  of   performance.  Ensure  all  dates  can  be  reconciled.   ! Do  the  Control  Account  periods  of  performance  match  the  schedule  time  spans  in  the  IMS?   " Be  prepared  to  trace  the  period  of  performance  for  each  Control  Account  budget  referenced  on   the  most  current  approved  WAD  to  the  applicable  IMS  time–phased  Control  Account  /  task   period  of  performance.  Ensure  all  dates  reconcile.     " Be  prepared  to  justify  the  budget  and  the  Earned  Value  methods  selected.   «PLANNING»   § Schedule  the  authorized  work  in  a  manner,  which  describes  the  sequence  of  work  and   identifies  significant  task  interdependencies  required  to  meet  the  requirements  of  the   program.   § Identify  physical  products,  milestones,  technical  performance  goals,  or  other  indicators  that   will  be  used  to  measure  progress.   § Establish  and  maintain  a  time-­‐phased  budget  baseline,  at  the  Control  Account  level,  against   which  program  performance  can  be  measured.  Budget  for  far-­‐term  efforts  may  be  held  in   higher  level  accounts  until  an  appropriate  time  for  allocation  at  the  Control  Account  level.   Initial  budgets  established  for  performance  measurement  will  be  based  on  either  internal   management  goals  or  the  external  customer  negotiated  target  cost  including  estimates  for   authorized  but  undefinitized  work.  On  government  contracts,  if  an  over  target  baseline  is  used   for  performance  measurement  reporting  purposes;  prior  notification  must  be  provided  to  the   customer.   § Establish  budgets  for  authorized  work  with  identification  of  significant  cost  elements  (labor,   material,  etc.)  as  needed  for  internal  management  and  for  control  of  subcontractors.   § To  the  extent  it  is  practical  to  identify  the  authorized  work  in  discrete  work  packages,  establish   budgets  for  this  work  in  terms  of  dollars,  hours,  or  other  measurable  units.  Where  the  entire   Control  Account  is  not  subdivided  into  work  packages,  identify  the  far  term  effort  in  larger   planning  packages  for  budget  and  scheduling  purposes.   § Provide  that  the  sum  of  all  work  package  budgets  plus  planning  package  budgets  within  a   Control  Account  equals  the  Control  Account  budget.   § Identify  and  control  level  of  effort  activity  by  time-­‐phased  budgets  established  for  this  purpose.   Only  that  effort  which  is  unmeasurable  or  for  which  measurement  is  impractical  may  be   classified  as  Level  of  Effort.   § Establish  overhead  budgets  for  each  significant  organizational  component  of  the  company  for   expenses  that  will  become  indirect  costs.  Reflect  in  the  program  budgets,  at  the  appropriate
  • 14.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  14     level,  the  amounts  in  overhead  pools  that  are  planned  to  be  allocated  to  the  program  as   indirect  costs.   § Identify  management  reserves  and  undistributed  budget.   § Assure  that  the  program  target  cost  goal  is  reconciled  with  the  sum  of  all  internal  program   budgets  and  management  reserves.   ! What  key  supporting  documentation  do  you  use  to  establish  and  plan  your  tasks?   " Budgets  are  based  on  negotiated  proposal  values  less  Management  Reserve  (MR).  the  CAM   plans  and  spreads  the  BCWS  received  according  to  how  the  scope  of  work  will  be  accomplished   as  defined  in  the  Statement  of  Work  (SOW)  and  the  WBS  dictionary,  and  consistent  with  the   Integrated  Master  Plan  (IMP)  and  Integrated  Master  Schedule  (IMS).   " The  WBS  Dictionary  correlates  WBS  elements  to  the  SOW  tasks,  and  provides  a  description  of  the   effort.  Control  Accounts  and  tasks  are  developed  by  the  CAMs  form  the  SOW  and  WBS.  The   program  IMS  establishes  the  periods  of  performance,  work  tasks,  and  milestones  (if  needed).   ! How  do  you  time  phase  the  budget  for  the  tasks?   " Based  on  the  documentation  provided  above  (SOW,  WBS,  IMP/IMS),  you  as  the  CAM  must   provide  a  time  phased  budget  baseline  for  each  Control  Account  Work  Package  and  the  activities   within  those  Work  packages  contained  in  the  IMS.   ! Do  you  have  any  Level  of  Effort  (LOE)   " BCWP  for  LOE’s  is  earned  through  the  passage  of  time  and  is  not  based  on  work  accomplished.   BCWP  always  equals  BCWS  through  the  current  period.   " Each  CAM  may  have  Control  Accounts  that  are  classified  as  totally  LOE  or  Control  Accounts  that   may  only  have  some  LOE  effort.  Be  prepared  to  justify  why  you  have  LOE  Control  Account(s)  or   LOE  tasks  contained  with  a  Control  Account.  Explain  why  they  are  not  measureable.   ! What  is  the  recommended  ratio  of  LOE  to  discrete  budget  in  a  Control  Account  classified  as   discrete?   " As  stated  in  the  Program  Directive  (PD),  the  recommended  ratio  of  LOE  to  discrete  budget  within   a  Control  Account  is  not  to  exceed  some  predefined  value.  This  is  typically  10%  to  20%  of  the   burdened  dollar  Budget  at  Completion  (BAC).   ! In  the  current  rolling  wave,  do  you  have  any  discrete  Control  Accounts  with  more  LOE  than   allowed?   " No.  Ensure  that  any  LOE  effort  within  a  discrete  Control  Account  does  not  exceed  the  stated  PD   guidance.  If  discrete  Control  Accounts  do  exceed  this  guidance,  then  the  LOE  effort  should  be   extracted  and  a  new  separate  LOE  Control  Account  developed.
  • 15.

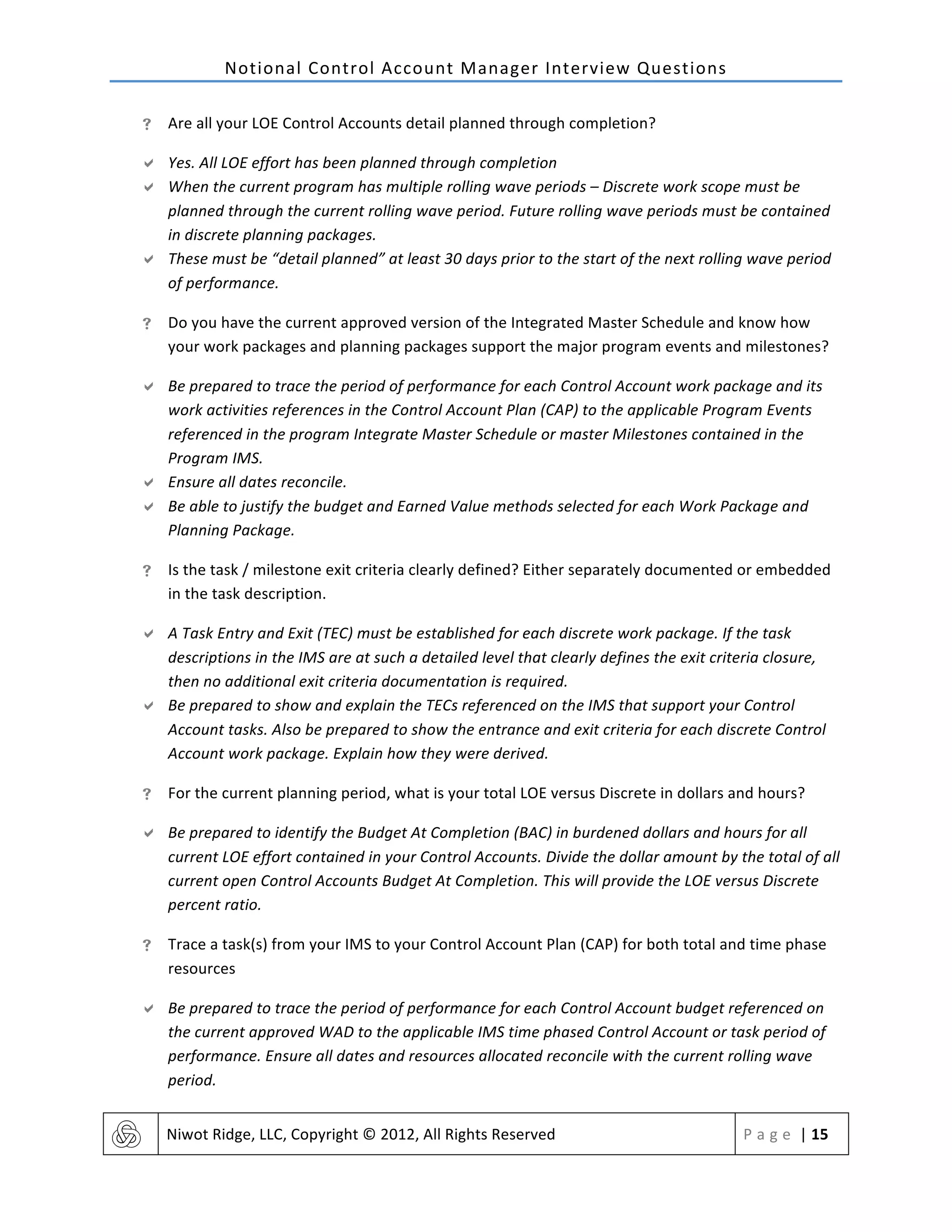

    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  15     ! Are  all  your  LOE  Control  Accounts  detail  planned  through  completion?   " Yes.  All  LOE  effort  has  been  planned  through  completion   " When  the  current  program  has  multiple  rolling  wave  periods  –  Discrete  work  scope  must  be   planned  through  the  current  rolling  wave  period.  Future  rolling  wave  periods  must  be  contained   in  discrete  planning  packages.     " These  must  be  “detail  planned”  at  least  30  days  prior  to  the  start  of  the  next  rolling  wave  period   of  performance.   ! Do  you  have  the  current  approved  version  of  the  Integrated  Master  Schedule  and  know  how   your  work  packages  and  planning  packages  support  the  major  program  events  and  milestones?   " Be  prepared  to  trace  the  period  of  performance  for  each  Control  Account  work  package  and  its   work  activities  references  in  the  Control  Account  Plan  (CAP)  to  the  applicable  Program  Events   referenced  in  the  program  Integrate  Master  Schedule  or  master  Milestones  contained  in  the   Program  IMS.     " Ensure  all  dates  reconcile.     " Be  able  to  justify  the  budget  and  Earned  Value  methods  selected  for  each  Work  Package  and   Planning  Package.   ! Is  the  task  /  milestone  exit  criteria  clearly  defined?  Either  separately  documented  or  embedded   in  the  task  description.   " A  Task  Entry  and  Exit  (TEC)  must  be  established  for  each  discrete  work  package.  If  the  task   descriptions  in  the  IMS  are  at  such  a  detailed  level  that  clearly  defines  the  exit  criteria  closure,   then  no  additional  exit  criteria  documentation  is  required.   " Be  prepared  to  show  and  explain  the  TECs  referenced  on  the  IMS  that  support  your  Control   Account  tasks.  Also  be  prepared  to  show  the  entrance  and  exit  criteria  for  each  discrete  Control   Account  work  package.  Explain  how  they  were  derived.   ! For  the  current  planning  period,  what  is  your  total  LOE  versus  Discrete  in  dollars  and  hours?   " Be  prepared  to  identify  the  Budget  At  Completion  (BAC)  in  burdened  dollars  and  hours  for  all   current  LOE  effort  contained  in  your  Control  Accounts.  Divide  the  dollar  amount  by  the  total  of  all   current  open  Control  Accounts  Budget  At  Completion.  This  will  provide  the  LOE  versus  Discrete   percent  ratio.   ! Trace  a  task(s)  from  your  IMS  to  your  Control  Account  Plan  (CAP)  for  both  total  and  time  phase   resources   " Be  prepared  to  trace  the  period  of  performance  for  each  Control  Account  budget  referenced  on   the  current  approved  WAD  to  the  applicable  IMS  time  phased  Control  Account  or  task  period  of   performance.  Ensure  all  dates  and  resources  allocated  reconcile  with  the  current  rolling  wave   period.
  • 16.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  16     ! Show  an  example  that  you  have  predecessors  and  successors  identified  within  your  organization   or  Integrated  Product  Team  (IPT)  and  between  other  organizations  or  IPTs.   " A  series  or  network  of  activities  which  are  required  to  accomplish  a  task  are  linked  together  with   logical  predecessors  and  successor  relationships  must  provide  for  the  identification  of  the  critical   path(s).  Each  discrete  activity  has  an  output  predecessor  which  is  linked  to  an  input  or  successor   activity.  This  defining  activity  relationship  enables  the  process  to  assess  progress  within  the   network.  Be  prepared  to  show  an  example  of  how  your  predecessor/successor  activities  are   indentified  with  your  organization  or  Integrated  Product  Team  (IPT)  are  dependent  or  linked   between  other  organizations  or  IPTs  predecessors  and  successor  activities.  Program  Planning   and  Controls  can  provide  predecessor  and  successor  reports  to  help  clarify  your  response.   ! If  you  are  responsible  for  any  major  subcontracts  or  intercompany  work  transfers,  where  is  it   reflected  in  your  IMS?   " Be  prepared  to  show  the  major  subcontracting  and  inter-­‐company  work  transfer  authorization   (IWTA)  effort  reflected  in  the  IMS  and  how  your  tasks  support  the  major  events  and  milestones.   ! If  you  are  responsible  for  any  high  value  material,  where  is  it  reflected  in  your  IMS?   " Be  prepared  to  show  any  high  value  material  effort  reflected  on  the  IMS.  Explain  how  your  tasks   support  the  major  events  and  milestones.   ! Are  any  of  your  tasks  on  the  program  or  IPT  critical  path?   " If  yes,  be  prepared  to  show  which  tasks  are  contained  on  the  critical  path.   " The  critical  path  is  defined  as  the  longest  computed  path  through  a  program  schedule  network.   The  critical  path  represents  scheduled  activities  with  the  highest  risk  and  the  least  margin  for   error.   ! Do  you  have  any  special  requirements  because  you  are  on  the  critical  path?   " Yes.  Any  schedule  activities  that  are  contained  on  the  critical  path  will  have  increased   management  visibility  and  must  be  statused  weekly  for  impacts  to  the  program.   ! What  are  the  most  critical  areas  of  your  work  effort?   " Identify  areas  in  your  work  scope  which  you  consider  the  most  critical.  Explain  why.   ! What  is  your  schedule  reserve?   § Schedule  reserve  is  generally  expressed  as  float.  Float  is  the  amount  of  time  an  activity  can  slip   before  it  affects  another  activity  finish  date.  It  is  the  difference  between  when  the  activity  can   happen  and  when  the  activity  must  happen.  Positive  float  (reserve)  should  be  conserved  and   managed.  Negative  float  indicates  activities  that  must  be  reworked  to  meet  the  event  schedule.   Events  may  be  milestones  or  deliverables.  If  the  total  float  is  less  than  or  equal  to  zero  (0),  then
  • 17.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  17     there  may  be  a  critical  condition  in  the  schedule.  Schedule  reserve  is  indentified  on  the  IMS   network  by  Control  Account  or  task,  or  by  the  IMS  schedule  reserve  reports.   " Be  prepared  to  describe  the  schedule  reserve  for  the  Control  Accounts  you’re  accountable  for  and   how  that  schedule  margin  was  arrived  at.   " Be  prepared  to  describe  how  you  measure  the  erosion  of  the  schedule  margin  as  the  program   progresses  and  whether  the  remaining  schedule  margin  is  sufficient  to  protect  the  deliverable   dates  in  the  IMS.   ! Do  you  have  resources  allocated  for  your  float  or  schedule  reserve?   " No.  schedule  reserve,  or  float,  does  not  have  a  defined  work  scope.  Resources  may  be  allocated   to  tasks  when  a  behind  schedule  condition  occurs  (which  may  cause  negative  schedule  reserve  or   float).  If  this  occurs,  additional  resources  may  be  applied  to  the  task  to  help  mitigate  schedule   degradation.  This  situation  most  likely  will  result  in  a  cost  overrun  condition  and  may  require   additional  resources  or  estimates  to  be  applied.  This  should  not  be  view3ed  as  the  best  solution.   ! Do  you  status  your  IMS  detail  tasks  weekly?   " Yes.  Control  account  task  activities  schedule  in  the  IMS  are  statused  weekly  which  includes   accomplishments,  forecasts  (late  or  early)  and  all  schedule  changes  and  revisions.   ! Do  you  track  late  starts  and  late  finishes?   " Be  prepared  to  show  the  status  of  late  starts  and  late  finishes  which  occurred  during  last  week.   This  data  can  be  obtained  from  the  metric  produced  by  the  Program  Planning  and  Controls  staff.   ! Validate  that  the  month-­‐end  schedule  progress  for  a  Control  Account  taken  in  the  IMS  is   consistent  with  the  cost  system.   " Be  prepared  to  reconcile  the  current  month  Earned  Value  (BCWP)  values  contained  in  the   monthly  Organizational  Performance  Report  (OPR)  with  the  Control  Account  and  task  Earned   Value  (BCWP)  contained  the  IMS.   ! Do  you  have  approved,  documented,  discrete  criteria  for  all  percent  complete  work  packages   and  or  tasks  that  exceed  45  workdays  in  length?   § Percent  Complete  Earned  Value  method  is  based  on  objective  (not  subjective)  criteria  and  is   used  for  tasks  where  the  measured  accomplishment  is  for  equal  value  products  or  services.  Each   lower  level  task  should  be  less  than  two  months  in  duration  and  must  have  a  start  and   completion  along  with  associated  time  phased  resource  plan.   " Be  prepared  to  show  the  approved  documents  and  the  discrete  criteria  for  all  percent  complete   work.  The  percent  complete  evidence  can  be  in  the  form  of  actual  deliverables  or  in  a  document   showing  how  you  would  calculate  this  percent  complete.
  • 18.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  18     " Remember,  CAM  opinion  is  no  acceptable  as  a  measure  of  percent  complete  –  only  tangible   evidence  can  be  used.   ! Do  you  have  supplemental  schedules?  Do  they  support  the  IMS?   § In  some  cases  CAMs  may  feel  the  need  to  maintain  lower  level  detailed  schedules  that  support   Control  Accounts  and  tasks.  These  lower  level  schedules  are  not  contained  in  the  IMS,  but  are   supportive  in  monitoring  Control  Accounts  and  tasks  scheduled  performance.   " If  this  is  the  case,  be  prepared  to  show  how  this  lower  level  of  detail  is  traceable  to  the  IMS  and   the  PMB.   «EARNED  VALUE»   § Record  direct  costs  in  a  manner  consistent  with  the  budgets  in  a  formal  system  controlled  by   the  general  books  of  account.   § When  a  work  breakdown  structure  is  used,  summarize  direct  costs  from  Control  Accounts  into   the  work  breakdown  structure  without  allocation  of  a  single  Control  Account  to  two  or  more   work  breakdown  structure  elements.   § Summarize  direct  costs  from  the  Control  Accounts  into  the  contractor’s  organizational   elements  without  allocation  of  a  single  Control  Account  to  two  or  more  organizational   elements.   § Record  all  indirect  costs  that  will  be  allocated  to  the  contract.   § Identify  unit  costs,  equivalent  unit’s  costs,  or  lot  costs  when  needed.   § For  EVMS,  the  material  accounting  system  will  provide  for:   • Accurate  cost  accumulation  and  assignment  of  costs  to  Control  Accounts  in  a  manner   consistent  with  the  budgets  using  recognized,  acceptable,  costing  techniques.   • Cost  performance  measurement  at  the  point  in  time  most  suitable  for  the  category  of   material  involved,  but  no  earlier  than  the  time  of  progress  payments  or  actual  receipt  of   material.   § Full  accountability  of  all  material  purchased  for  the  program  including  the  residual  inventory   ! What  Earned  Value  techniques  are  approved  for  use  on  this  program?   " The  Program  Directive  (PD)  defines  the  Earned  Value  techniques  approved  for  use  on  this   program.   " Be  prepared  to  provide  a  copy  of  the  Program  Directive  which  contains  the  approved  Earned   Value  techniques.   ! How  is  Earned  Value  taken  for  your  work?  Task  Level,  Work  Package  Level?   " Earned  Value  for  your  Control  Account  tasks  are  determined  as  the  task  level  based  on  the   Earned  Value  methods  selected.  Earned  Value  also  is  taken  consistent  with  how  the  work  is   planned.
  • 19.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  19     " Be  prepared  to  discuss  each  Control  Account  task  Earned  Value  technique  and  the  method   selected  for  determining  earned  Value.   ! Is  the  Earned  Value  technique  or  method  chosen  appropriately  for  the  specific  task  or  work   package?   " Be  prepared  to  provide  a  rational  for  selecting  the  earned  value  method  for  each  task.  Explain   why  the  earned  value  methods  selected  are  appropriate.   ! Do  you  have  any  apportioned  effort?   " An  apportioned  earned  value  method  is  used  for  efforts  like  quality  assurance  which  can  be   identified  and  measured  with  the  completion  of  an  assembly,  a  manufacturing  process,  or  a   portion  thereof.   " If  you  have  selected  an  apportioned  earned  value  method,  be  able  to  explain  the  BCWP  of  the   base  or  parent  account.  Parent  apportioned  accounts  must  have  the  same  start  and  completion   date.  Apportioned  accounts  must  have  discrete  effort  as  a  base  and  not  LOE.  BCWP  for  the   apportioned  account  is  expressed  as  the  same  percentage  of  its  Budget  At  Completion  (BAC)  as   the  BCWP  calculated  for  the  base  account  or  work  task.   «CHANGE  CONTROL»   § Incorporate  authorized  changes  in  a  timely  manner,  recording  the  effects  of  such  changes  in   budgets  and  schedules.  In  the  directed  effort  prior  to  negotiation  of  a  change,  base  such   revisions  on  the  amount  estimated  and  budgeted  to  the  program  organizations.   § Reconcile  current  budgets  to  prior  budgets  in  terms  of  changes  to  the  authorized  work  and   internal  replanning  in  the  detail  needed  by  management  for  effective  control.   § Control  retroactive  changes  to  records  pertaining  to  work  performed  that  would  change   previously  reported  amounts  for  actual  costs,  Earned  Value,  or  budgets.  Adjustments  should  be   made  only  for  correction  of  errors,  routine  accounting  adjustments,  effects  of  customer  or   management  directed  changes,  or  to  improve  the  baseline  integrity  and  accuracy  of   performance  measurement  data.   § Prevent  revisions  to  the  program  budget  except  for  authorized  changes.   § Document  changes  to  the  performance  measurement  baseline.   ! What  is  the  process  you  must  follow  to  make  a  change  to  your  baseline  budget?   § The  process  for  baseline  change  control  is  described  in  the  Earned  Value  Management  Systems   Description.  It  should  read  something  like  this…   " There  are  essentially  situations  that  permit  the  Performance  Measurement  Baseline  (PMB)  to   change:  externally  directed  contract  changes,  formal  reprogramming,  and  internal  replanning.   Each  situation  is  defines  and  described  in  the  EVMS  SD.
  • 20.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  20     " Externally  directed  contract  changes  and  formal  reprogramming  are  the  only  conditions  that   permit  a  change  to  the  Contract  Budget  Base  (CBB)  and  both  require  permission  from  the   customer.     " If  changes  to  the  PMB  are  within  the  constraints  of  the  contract  then  internal  replanning  is   permitted  subject  to  the  limitation  of  the  EVMS  SD.   " The  internal  budget  replanning  process  should  following  this  approach:  The  CAM  requests  a   change  to  a  Control  Account(s)  level  budget  through  a  Requesting  WAD  and  reviews  the  request   with  the  Program  Planning  and  Controls  lead  for  determination  of  any  impact  to  the  IMS.  If  it  is   determined  that  the  change  will  impact  the  IMS,  then  the  process  for  internal  schedule   replanning  must  be  followed.   " Typically  this  internal  replanning  process  follows  these  steps  (1)  Intermediate  Management  and   the  Change  Control  Board  (CCB)  approve  or  deny  the  request.  Approved  requests  are  sent  to  the   Program  Planning  and  Control  Lead  for  approval  (2)  The  PP&C  Lead  reviews  and  approves  or   denies  the  request;  (3)  if  the  requesting  WAD  is  disputed  or  involves  Management  Reserve   distribution,  the  Program  Manager  makes  the  final  determination  of  approval;  (4)  If  the  changes   are  to  occur  within  two  accounting  period  beyond  the  current  accounting  period,  the  Program   Manager  or  Business  Deputy  notifies  the  customer  in  writing  of  the  change;  (5)  If  the  change  is   approved,  the  WAD  is  sent  to  the  CAM.  The  CAM  revises  the  detailed  schedules  and  prepares  an   Estimate  To  Complete  (ETC).  PP&C  inputs  the  data  into  the  cost  and  schedule  tools.  If  the  CAM   states  in  the  Comments  Section  of  the  Requesting  WAD  that  this  ETC  is  equal  to  the  change  to   the  time  phased  BCWS  (budget),  then  no  Estimate  Change  Request  (ECR)  is  required.  If  the  ETC  is   different  than  the  time  phased  BCWS  on  the  Requesting  WAD,  then  the  CAM  must  submit  an   ECR.   ! What  is  the  process  you  must  follow  to  make  a  change  to  your  baseline  schedule?  Where  is  this   documented?   " The  internal  schedule  replanning  process  is  usually  described  in  the  EVMS  Systems  Description.   This  usually  is  described  as  follows:   " The  CAM  submits  a  Request  for  IMS  Change  for  and  the  accompanying  IMS  Change  Request   Worksheet  to  the  Schedule  Review  Board  (SRB).  The  SRB  includes  the  IPT  and  organizational   scheduler,  intermediate  management  and  the  CAM.  The  SRB  determines  of  the  change  is  minor   or  major.  Guidelines  for  the  classification  of  changes  is  usually  described  in  the  EVMS  System   Description.   " If  the  change  is  determined  minor,  then  the  forms  are  sent  to  the  Program  Master  Scheduler  for   review.  Of  the  Program  Master  Scheduler  approves  the  request,  the  approved  forms  are  sent  to   the  Schedule  Review  Board  (SRB)  and  evaluated.  Of  the  SRB  approves  the  change,  and  then  it   may  be  implemented.   " If  the  change  is  determined  major  by  the  SRB  and  the  Program  Master  Scheduler,  then  the  forms   are  sent  to  the  Change  Control  Board  (CCB)  for  review.  If  the  CCB  approves  the  change,  the   change  may  be  implemented.
  • 21.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  21     " If  approved  changes  are  to  occur  within  two  accounting  periods  beyond  the  current  accounting   period,  the  Program  Manager  or  Business  Deputy  notifies  the  customer  in  writing  of  the  change.   " As  soon  as  practical  WAD(s)  are  updated  to  reflect  the  schedule  change.   ! What  was  the  last  change  to  one  of  your  Control  Accounts?   " Be  prepared  to  describe  this  change,  the  reason  for  the  change   " Be  able  to  show  the  latest  revised  IMS  resulting  from  the  change  and  the  affected  Control   Accounts  and  any  Work  Packages  affected  by  the  change.   " If  no  changes  were  made  to  the  work  packages,  describe  the  process  used  to  make  a  change.   ! Were  any  changes  performed  in  the  last  60  days?   " Walk  through  the  last  change  you  made  to  a  Control  Account.   " If  no  changes  were  made,  describe  the  process  used  to  make  a  change   ! Were  all  appropriate  documents  used  to  process  the  change?   " Show  the  requesting  WAD  or  IMS  change  request  involved.   ! What  is  the  difference  between  the  classes  of  change  defined  in  your  change  control   management  system?   " Class  1  changes  are  usually  out  of  scope  to  the  contract.  Class  I  changes  are  customer  directed   (authorized  negotiated  work  scope  or  authorized  unpriced  work  scope).  All  contract  baseline   changes  must  be  authorized  by  a  Program  Directive  (PD)  or  Operations  Directive  (OD)  and   directed  by  Work  Authorization  Documents  (WAD)   " Class  2  changes  are  in  scope  to  the  contract  but  out  of  scope  to  the  CAM  or  Control  Account.   Class  2  changes  are  classified  to  internal  revisions  to  the  baseline.  They  are  either  within  the   baseline  scope  or  are  changes  to  the  baseline  scope  which  requires  a  transfer  from  Management   Reserve  (MR).   ! Were  the  changes  performed  in  a  timely  manner?   " Changes  to  the  baseline  must  be  accomplished  in  a  timely  manner.  Revisions  to  the  budget  and   schedule  must  be  completed  and  input  to  the  cost  and  schedule  tool  within  60  calendar  days   after  authorization  of  a  change.  Work  authorizing  documents  and  schedules  must  be  amended   where  appropriate   ! What  is  the  acceptable  use  of  management  reserve?   " The  acceptable  use  of  Management  Reserve  (MR)  is  described  in  the  EVMS  Systems  Description   and  a  sample  is  stated  below   " Management  Reserve  (MR)  is  a  budget  account  established  by  Program  Management  for  use  in   accommodating  growth  in  the  current  work  scope,  rate  changes,  and  other  program  unknowns.   MR  must  be  held  for  current  and  future  needs.  Because  it  is  a  control  tool,  actual  and  Earned
  • 22.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  22     Value  are  never  allocated  to  the  MR  account.  It  must  be  not  allocated  to  offset  accumulated   overruns  or  underruns.  MR  is  not  a  contingency  that  can  be  eliminated  from  contract  prices   during  subsequent  negotiations.  It  must  not  be  used  to  absorb  the  cost  of  out-­‐of-­‐scope  contract   changes.  The  customer  must  not  view  this  budget  reserve  as  a  source  of  funding  for  added  work   scope.   " In  some  instances  the  Program  Manager  may  elect  to  add  work  scope  to  what  has  already  been   authorized  and  budgeted  and  /  or  CAMs  may  wish  to  request  MR  funds.  For  example:  there  may   be  a  change  in  the  number  of  components  or  an  insignificant  amount  of  budget  transfer   accompanying  a  transfer  in  work  scope.  New  or  revised  work  must  be  judged  to  be  within  the   scope  of  the  existing  contract.  Technical  breakthroughs  or  improved  manufacturing  processes   may  allow  previously  authorized  and  budgeted  work  to  be  canceled  or  reduced  in  scope.  In  these   cases,  budgets  may  be  transferred  to  MR  from  the  affected  Control  Accounts.  WADs  and   schedules  must  be  prepared  or  revised  as  necessary.  Budgets  must  be  issued  through  an   approved  WAD  and  charge  numbers  opened  or  closed  as  necessary.  Consideration  of  potential   liens  or  givebacks  to  MR  must  be  given  as  well   " Changes  to  overhead  or  General  and  Administrative  (G&A)  rates  can  have  a  significant  impact  on   budgets.  Revised  reporting  could  be  significantly  different  from  the  existing  rates  affecting   budgets.  When  the  effect  of  a  burden  rate  change  is  so  great  that  the  budget  becomes   unrealistic,  MR  may  be  used  to  compensate  for  the  rate  change.   ! What  would  you  do  of  your  requests  for  additional  resources  were  denied?   " If  a  Requesting  Work  Authorization  Document  (WAD)  initiated  by  the  CAM  requesting  additional   resources  was  denied,  then  the  CAM  must  (1)  maintain  a  copy  of  the  denied  WAD  to  reflect   additional  budget  was  requested  and  disapproved;  (2)  initiate  and  submit  and  Estimate  Change   Request  (ECR)  from  to  identify  the  resources  required  for  the  appropriate  Control  Account  and  to   revise  the  Estimate  To  Complete  (ETC).   ! Who  initiates  requests  for  opening  and  closing  charge  numbers?   " You  do.  CAMs  must  request  new  WBS  charge  numbers  be  opened  for  controls  accounts  that  are   scheduled  to  commence  in  the  near  future.  WBS  charge  numbers  are  opened  or  closed  by   authorized  Program  Planning  and  Controls  staff  using  an  appropriate  charge  number  form.   ! Is  it  permissible  to  make  changes  to  the  Budgeted  Cost  of  Work  Scheduled  or  Actual  Cost  of   Work  Performed?   " Yes,  but  under  limited  conditions.  Retroactive  changes  to  Budgeted  Cost  for  Work  Scheduled   (BCWS)  may  be  made  only  to  correct  clerical  errors  or  to  make  customer  authorized  changes.   Routine  accounting  adjustments  to  cumulative  BCWS  can  be  accomplished  only  through  a   current  month  adjustment  and  not  retroactively.   " Retroactive  changes  to  actual  cost  may  not  be  made  except  for  correction  of  clerical  errors  or   normal  accounting  adjustments.  Adjustments  must  be  reflected  in  the  accounting  records  for  the
  • 23.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  23     month  the  adjustments  are  made.  The  categories  of  adjustments  are:  (1)  non  labor,  (2)  labor   current  year,  (3)  labor  prior  year.   «ANALYSIS»   § At  least  on  a  monthly  basis,  generate  the  following  information  at  the  Control  Account  and   other  levels  as  necessary  for  management  control  using  actual  cost  data  from,  or  reconcilable   with,  the  accounting  system:   ♦ Comparison  of  the  amount  of  planned  budget  and  the  amount  of  budget  earned  for  work   accomplished.  This  comparison  provides  the  schedule  variance.   ♦ Comparison  of  the  amount  of  the  budget  earned  the  actual  (applied  where  appropriate)   direct  costs  for  the  same  work.  This  comparison  provides  the  cost  variance.   § Identify,  at  least  monthly,  the  significant  differences  between  both  planned  and  actual   schedule  performance  and  planned  and  actual  cost  performance,  and  provide  the  reasons  for   the  variances  in  the  detail  needed  by  program  management.   § Identify  budgeted  and  applied  (or  actual)  indirect  costs  at  the  level  and  frequency  needed  by   management  for  effective  control,  along  with  the  reasons  for  any  significant  variances.   § Summarize  the  data  elements  and  associated  variances  through  the  program  organization   and/or  work  breakdown  structure  to  support  management  needs  and  any  customer  reporting   specified  in  the  contract.   § Implement  managerial  actions  taken  as  the  result  of  Earned  Value  information.   § Develop  revised  estimates  of  cost  at  completion  based  on  performance  to  date,  commitment   values  for  material,  and  estimates  of  future  conditions.  Compare  this  information  with  the   performance  measurement  baseline  to  identify  variances  at  completion  important  to  company   management  and  any  applicable  customer  reporting  requirements  including  statements  of   funding  requirements.   ! Show  how  you  monitor  who  charges  your  Control  Account   " By  using  the  Systems,  Applications,  Products  data  processing  (SAP)  or  equivalent  weekly  actual   cost  reports.  These  reports  are  generated  and  distributed  weekly  by  Cost  Management  and   Program  Controls.  Each  CAM  must  review  the  SAP  actual  cost  reports  on  a  weekly  basis  and   assess  proper  charging  practices.  If  resources  aren’t  recognized  or  incorrect  charging  practices   occur,  a  Current  Year  Labor  Cost  Transfer  form  must  be  completed  and  submitted  to  correct  any   charging  anomalies.   ! How  does  Earned  Value  get  into  the  cost  accounting  system?  How  do  you  verify  what  was   submitted?   " The  Program  Directive  defines  the  Earned  Value  techniques  approved  for  use  on  the  program.   Earned  Value  for  your  Control  Account  tasks  is  based  on  the  Earned  Value  methods  selected.   Earned  Value  is  taken  consistent  with  how  the  work  is  planned.
  • 24.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  24     " On  a  monthly  basis  (month-­‐end)  Program  Planning  and  Controls  and  the  CAM  assess  each  work   package  and  the  tasks  in  the  Work  Package  to  assure  progress  and  Earned  Value  is  taken  in   accordance  with  the  method  selected.   " After  this  process  is  complete  the  planning  tool’s  Earned  Value  is  uploaded  to  the  Cost   Management  system  for  pricing  and  cost  analysis.  Once  the  Cost  System  has  been  uploaded  the   Organizational  Performance  Reports  (OPR)  are  generated  to  validate  the  Earned  Value  taken.   ! How  do  you  use  weekly  labor  actual  reports  and  organizational  performance  reports?   " Actual  cost  reports  are  generated  and  distributed  weekly  by  PP&C.  each  CAM  must  review  these   actual  cost  reports  on  a  weekly  basis  to  assess  the  impacts  to  current  and  cumulative  cost   variances  by  Control  Account.   " Organizational  Performance  Reports  are  generated  from  the  Cost  System  each  month-­‐end  to   reflect  BCWS,  BCWP,  ACWP,  Schedule  Variance,  Cost  Variance,  and  Variance  at  Completion  for   the  current  period,  cumulative  to  date  and  at  completion  data  by  Control  Account  and  by   resource.   ! What  weekly  and  monthly  meetings  do  you  attend  where  your  schedule  and  cost  performance   is  discussed?   § Schedule  review  meetings  are  held  weekly  and  monthly  as  outlined  in  a  Business  Rhythms   Calendar.  During  these  meetings  each  CAM  must  present  schedule  progress  and  monthly   performance,  schedule  metric  reports,  risks,  risk  mitigation  plans,  etc.  CAMs  must  be  prepared   to  discuss  all  details  relating  to  any  problems  and  proposed  resolutions  concerning  their  Control   Accounts.   § CAMs  and  Program  Managers  must  review  schedule  status  at  the  Weekly  Program  Control   meeting.  This  meeting  is  an  internal  review  in  which  the  Technical  and  Intermediate  Managers,   and  CAMs  present  schedule  information  to  the  Program  Manager.   " Be  prepared  to  discuss  other  pertinent  business  meeting  where  your  scope  of  performance  is   reviewed.   ! Show  your  latest  variance  analysis  report.  Has  it  been  reviewed  and  approved?   § This  report  is  provided  from  the  Cost  Management  System  and  used  as  required.   § With  this  report  the  CAM  can  speak  directly  to  the  performance  of  the  Control  Account  and  the   Work  Packages  that  make  up  the  CA   " Be  prepared  to  explain  variances  or  trending  thresholds  that  determine  how  you  take  corrective   actions  for  your  Control  Account.   ! Is  the  root  cause  of  the  variance  drivers  clearly  and  accurately  identified?   " Be  prepared  to  explain  the  root  causes  of  any  variances  shown  in  the  Variance  Analysis  Report
  • 25.

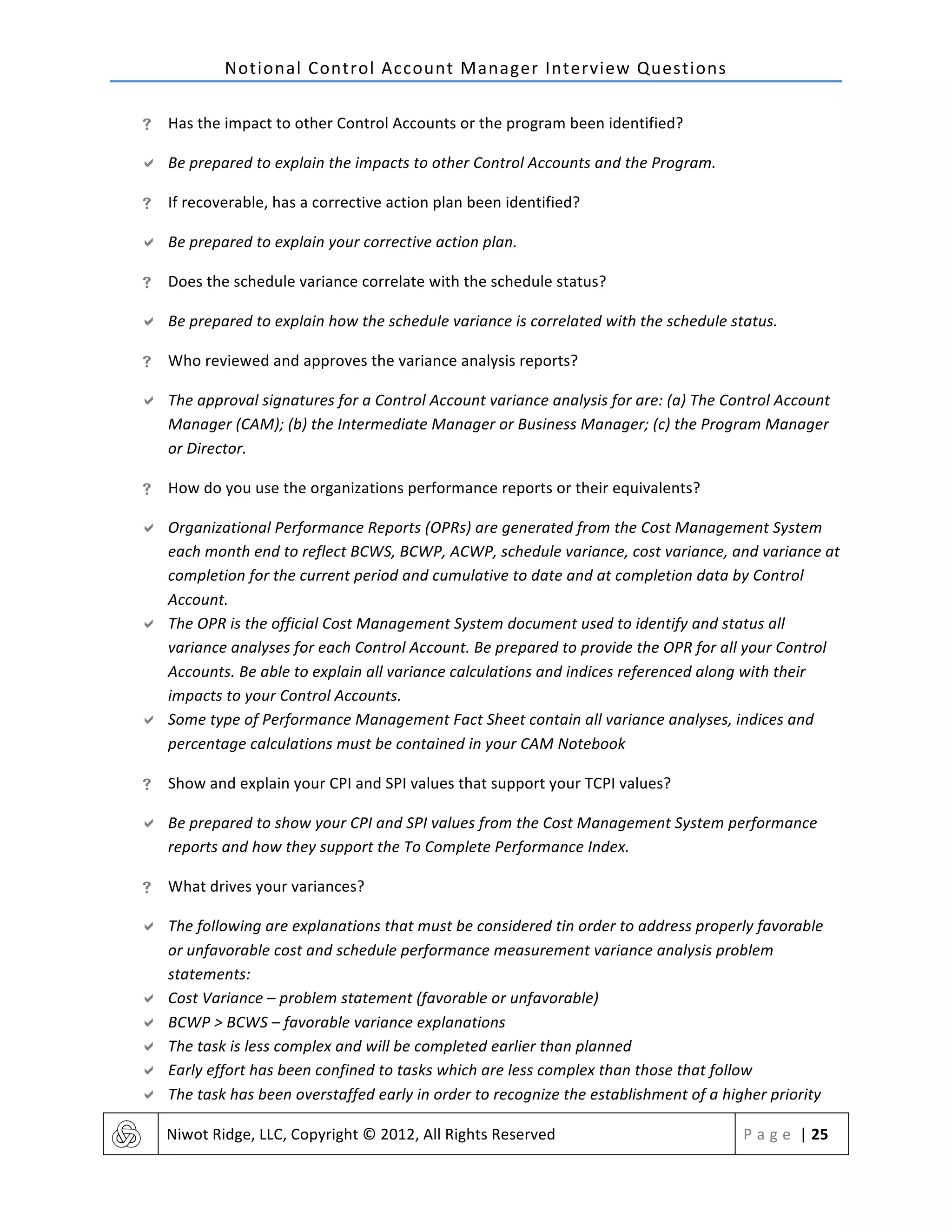

    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  25     ! Has  the  impact  to  other  Control  Accounts  or  the  program  been  identified?   " Be  prepared  to  explain  the  impacts  to  other  Control  Accounts  and  the  Program.   ! If  recoverable,  has  a  corrective  action  plan  been  identified?   " Be  prepared  to  explain  your  corrective  action  plan.   ! Does  the  schedule  variance  correlate  with  the  schedule  status?   " Be  prepared  to  explain  how  the  schedule  variance  is  correlated  with  the  schedule  status.     ! Who  reviewed  and  approves  the  variance  analysis  reports?   " The  approval  signatures  for  a  Control  Account  variance  analysis  for  are:  (a)  The  Control  Account   Manager  (CAM);  (b)  the  Intermediate  Manager  or  Business  Manager;  (c)  the  Program  Manager   or  Director.   ! How  do  you  use  the  organizations  performance  reports  or  their  equivalents?   " Organizational  Performance  Reports  (OPRs)  are  generated  from  the  Cost  Management  System   each  month  end  to  reflect  BCWS,  BCWP,  ACWP,  schedule  variance,  cost  variance,  and  variance  at   completion  for  the  current  period  and  cumulative  to  date  and  at  completion  data  by  Control   Account.   " The  OPR  is  the  official  Cost  Management  System  document  used  to  identify  and  status  all   variance  analyses  for  each  Control  Account.  Be  prepared  to  provide  the  OPR  for  all  your  Control   Accounts.  Be  able  to  explain  all  variance  calculations  and  indices  referenced  along  with  their   impacts  to  your  Control  Accounts.   " Some  type  of  Performance  Management  Fact  Sheet  contain  all  variance  analyses,  indices  and   percentage  calculations  must  be  contained  in  your  CAM  Notebook   ! Show  and  explain  your  CPI  and  SPI  values  that  support  your  TCPI  values?   " Be  prepared  to  show  your  CPI  and  SPI  values  from  the  Cost  Management  System  performance   reports  and  how  they  support  the  To  Complete  Performance  Index.   ! What  drives  your  variances?   " The  following  are  explanations  that  must  be  considered  tin  order  to  address  properly  favorable   or  unfavorable  cost  and  schedule  performance  measurement  variance  analysis  problem   statements:   " Cost  Variance  –  problem  statement  (favorable  or  unfavorable)   " BCWP  >  BCWS  –  favorable  variance  explanations   " The  task  is  less  complex  and  will  be  completed  earlier  than  planned   " Early  effort  has  been  confined  to  tasks  which  are  less  complex  than  those  that  follow   " The  task  has  been  overstaffed  early  in  order  to  recognize  the  establishment  of  a  higher  priority
  • 26.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  26     " Deliverables  of  hardware  have  been  accomplished  in  advance  of  need  date   " Earned  Value  may  be  incorrect  and  require  an  adjustment  in  the  next  reporting  period   " The  plan  is  time  phased  poorly  and  the  current  status  is  not  reflective  of  what  is  really  happening   " BCWP  <  BCWS  –  unfavorable  variance  explanation   " The  task  is  more  complex  than  originally  planned   " Early  effort  has  been  more  complex  than  the  effort  that  follows   " Delays  in  staffing  have  slowed  progress   " Hardware  deliverables  are  late   " Design  of  rework  activities  has  delayed  progress   " Software  deliverables  are  late   " Data  from  another  organization  (drawings  or  technical  analysis)  has  been  late   " Additional  requirements  have  been  established  or  changed   " Higher  priority  has  been  establishes  on  other  work   " The  plan  is  time  phased  poorly   " Schedule  Variance  –  favorable  or  unfavorable  explanations   " The  complexity  of  the  task  is  less  than  originally  estimated   " The  less  complex  tasks  have  been  completed  early   " The  task  is  primarily  LOE  and  not  been  fully  staffed   " The  plan  is  time  phased  poorly   " BCWP  <  BCWS  –  unfavorable   " The  task  is  more  complex  than  originally  planned   " The  more  complex  tasks  have  been  complete  early   " Program  priorities  have  resulted  in  application  of  resources  in  an  inefficient  manner  –  more   overtime  or  additional  staffing   " Delays  in  receipt  of  data  have  resulted  in  implementation  of  workarounds  to  make  schedule.   More  overtime  or  additional  staffing   " Changes,  redesign,  additional  requirements,  or  out-­‐of-­‐scope  effort   " The  plan  is  time  phased  poorly   " Rate  or  usage  variance   «RISK»   § DID  81650  calls  out  a  Statistical  Risk  Analysis  (SRA)  for  the  Integrated  Master  Schedule  (IMS).     § The  risk  management  of  the  technical  aspects  of  the  program  should  be  included  in  the  IMS  as   well.   § Technical  risk  management  is  guided  by  the  specific  procurement  agency,  but  DoD  Risk   Management  is  the  starting  document.
  • 27.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  27     ! What  is  risk  mitigation?   " Risk  mitigation  is  a  formal  process  of  identifying,  tracking  and  minimizing  potential  hazards,   obstacles,  and  risks  to  successful  program  performance.  Risk  mitigation  is  described  more   formally  as:   " “The  Program  Manager  is  responsible  for  overseeing  the  implementation  and  maintenance  of  a   program  Risk  and  Opportunities  Management  Plan.”   " Risk  and  Opportunity  potentials  are  identified  and  quantified  at  both  the  Intermediate   Management  and  CAM  levels.  Mitigation  Plans,  including  estimated  plan  costs,  are  developed  as   necessary  and  submitted  either  to  Intermediate  Management  for  approval  or  directly  to  the  Risk   Management  and  Opportunities  Board.  Upon  Board  approval,  the  Risk  Mitigation  Plan  and   associated  cost  are  submitted  to  the  Program  Manager.   " The  Program  Manager  approves  the  plans  and  determines  if  the  cost  will  be  funded  out  of   Management  Reserve.  If  so,  the  Program  Manager  directs  Program  Planning  and  Controls  to   issue  a  WAS  to  Intermediate  Management  or  CAM  so  the  appropriate  Control  Account(s)  can   then  be  replanned  and  input  through  Program  Planning  and  Controls  to  the  Cost  Management   System.  If  the  Program  Manager  decides  the  Mitigation  Plan  will  not  be  funded  out  of  MR,   Program  Planning  and  Controls  notifies  the  CAM  who  prepares  and  submits  an  ECR  package,   which  is  then  input  into  the  Cost  Management  System.   ! Do  you  have  adequate  budget  and  facilities  to  complete  your  work?   " Provide  and  explain  as  required   ! Is  the  risk  high,  medium,  or  low?   " Provide  and  explain  as  required   ! Are  there  any  cost,  schedule,  or  technical  risks  in  your  Control  Accounts?   " Provide  and  explain  as  required   ! Have  the  risks  been  documented  in  the  Risk  Management  Plan?   " Provide  and  explain  as  required   ! Are  you  risk  mitigation  activities  incorporated  in  the  IMS?   " Provide  and  explain  as  required   ! What  is  the  process  for  retiring  or  closing  out  a  risk  when  the  mitigation  plan  is  successful?   " Once  an  identified  risk  has  been  successfully  mitigated  in  accordance  with  the  Risk  Mitigation   Plan,  the  final  risk  action  plan  must  be  reviewed  by  the  Risk  Management  Board  for  final   disposition  and  closure.
  • 28.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  28     ! What  is  the  process  for  retiring  or  closing  out  a  risk  when  the  mitigation  plan  is  unsuccessful?   " If  an  identified  risk  has  not  been  mitigated  completely  in  accordance  with  the  Risk  Mitigation   Plan,  then  the  Risk  Management  Board  must  review  the  mitigation  plan  actions  taken  and  make   appropriate  adjustments  as  needed  (mitigation  plans,  mitigation  times,  etc.).  The  Risk   Management  Board  may  simply  accept  the  risk  level  as  is  and  continue  to  monitor  as   appropriate.  These  actions  could  result  in  additional  revisions  to  the  Control  Account  Baseline.   This  change  may  require  a  WAD  or  an  Estimate  Change  Request   ! Have  resources  been  provided  for  the  mitigation  plans?   " Identify  any  resources  that  have  been  provided  for  the  mitigation  plans.  If  none  have  been   provided,  explain  why?   ! Where  critical  skills  exist,  are  you  sufficiently  staffed  in  these  areas?  Do  you  have  succession   planning  for  these  critical  areas?   " Provide  and  explain  as  required   «ESTIMATE  AT  COMPLETION  (EAC)»     ! Describe  the  process  you  use  to  update  your  EAC  and  what  documentation  is  used?   § The  acceptance  process  for  updating  the  Estimate  To  Complete  (ETC)  and  Estimate  At   Completion  (EAC)  are  described  in  the  published  Earned  Value  Management  System  Description   and  summarized  below   § “Every  month  CAMs  review  the  Control  Account  cost  and  schedule  data  and  assess  the  ETC  and   EAC  of  each  Control  Account.  CAMs  make  an  assessment  based  on  the  historical  performance  of   the  accounts  current  metrics  and  future  projections.”   § “The  projections  should  consider  potential  process  improvements,  risk  assessments,  and  other   applicable  factors  that  may  affect  remaining  work.  The  EAC  is  updates  in  the  cost  tool  as  Actual   Cost  for  Work  Performed  (ACWP)  replaces  ETC.  It  is  recommended  that  this  occur  monthly.  If   not  monthly  than  quarterly.  If  the  current  ACWP  is  different  from  the  current  ETC  minor   perturbations  will  result  in  the  EAC.  If  the  customer  mandates  a  stable  EAC,  then  a  log  must  be   maintained  to  reconcile  internal  EAC  values  and  customer  reported  EACs.   § Where  Control  Account  ETC  changes  are  required,  the  CAM  generates  and  redlines  a  time   phased  ETC.  The  change  request  form  is  completed,  or  other  documentation  that  contains  the   appropriate  data  elements  are  attached  to  the  form.  The  Change  Request  is  then  submitted  to   Program  Controls  for  review
  • 29.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  29     ! How  do  you  update  your  Estimate  to  Compete  (ETC)?  When  was  the  ETC  last  updated?   " The  Estimate  At  Completion  should  be  reviewed  monthly  and  updated  as  appropriate.  Provide   the  rationale  for  the  latest  ETC  and  EAC  revisions.   ! Show  documentation  of  that  update  and  rationale  for  the  new  ETC  numbers.   " Provide  and  explain  as  required.   ! Who  reviews  and  approves  your  ETC?   " The  CAM,  Program  Controls,  and  the  Program  Manager   ! Do  the  cost  and  schedule  variances  support  the  EAC?   " If  you  have  experienced  unfavorable  cost  or  schedule  variances  and  have  not  revised  your  EAC   and  ETC  values,  then  the  following  actions  should  be  taken:   " Compare  the  CPI  percent  against  the  TCPI  percentage.  Of  the  delta  value  is  less  than  X%  then   your  EAC  is  considered  credible.  The  Independent  Estimate  At  Completion  (IEAC)  indices  are  used   to  assess  the  validity  of  the  range  and  to  evaluate  the  realism  of  the  projected  EAC.   ! How  often  is  a  comprehensive  EAC  (CEAC)  performed?   § Each  program  should  performance  a  Comprehensive  Estimate  At  Completion  (CEAC)  using  a   “bottoms  up”  method  at  least  annually.  This  date  should  be  defined  in  the  Program  Directive.     " Be  prepared  to  answer  which  data  has  been  chosen  for  your  program.   ! If  a  CEAC  was  performed,  show  your  memo  with  the  ground  rules  from  Program  Control?   " Be  prepared  to  describe  what  ground  rules  are  used  for  the  CEAC,  who  participants  in  the  CEAC,   and  how  the  program  Performance  Measurement  Baseline  (PMB)  is  adjusted  using  the  output  of   the  CEAC.   «SUBCONTRACTOR  MANAGEMENT»   § Do  any  of  your  Control  Accounts  contain  subcontractor  effort?  If  so,  answer  the  following   questions:   ! What  scope  is  the  subcontract  responsible  for?   " Subcontracts  and  or  inter-­‐company  work  transfer  agreements  (IWTAs)  scope  is  based  on   negotiated  or  documented  contracted  work.  Be  prepared  to  discuss  your  subcontract  /  IWTA   contract  type  and  work  scope  and  be  prepared  to  provide  the  Statement  of  Work  (SOW)  and   work  authorization  for  each  subcontract  /  IWTA
  • 30.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  30     ! How  does  the  subcontractor  receive  authorizations  for  scope,  schedule,  and  resources  from  the   prime?   § Subcontractor  and  IWTA  direction  is  provided  by  the  contract  administration  organization   through  a  negotiated  contract  or  a  contract  modification  to  amend  or  change  work  scope,   schedule,  and  resources.   ! What  reporting  requirements  have  been  levied  on  the  subcontractors?   § Any  nonrecurring  or  development  subcontract  that  is  larger  than  $25M  and  not  Firm  Fixed  Price   (FFP),  has  a  Cost  Performance  Report  (CPR)  requirement.  A  non-­‐FFP  sub-­‐contract  larger  than   $10M,  but  less  than  $25M,  has  a  modified  Cost  Performance  Report  (MCPR)  requirement.  The   Non-­‐FFP  subcontracts  under  $10M  have  minor  reporting  requirements  although  if  considered  a   high  cost,  schedule,  or  technical  risk  a  MCPR  is  required.  Firm  Fixed  Price  contracts  fall  into  two   categories:  Delivery  and  Support  /  Level  of  Effort   " Be  prepared  to  provide  copies  of  the  latest  reporting  documentation  pertaining  to  your   subcontracts  /  IWTAs   ! Are  the  subcontractor’s  schedules  status  weekly?   " Provide  and  explain  as  required   ! How  are  the  resources  planned  for  the  subcontractors  (BCWS  spreads  for  the  subcontractor   work  packages)   § The  budget  information  should  represent  the  cost  baseline  negotiated  or  proposed.  The  BCWS   must  be  time-­‐phased  consistent  with  the  baseline  schedule  spans  negotiated  with  each   subcontractor,  and  should  be  reconciled  to  the  reporting  requirement  documentation  (CPR,   MCPR)  with  the  cost  management  system.  Regardless  of  the  Program  Performance   Management  system  applied  to  the  subcontractor,  the  Program  Performance  Management  data   must  be  reviewed  for  logic,  consistently,  and  validity     § For  minor  subcontracts  the  CAM  uses  the  IMS  information  and  the  time  phased  budget  to  plan   and  status  the  effort  in  the  PPM  cost  management  tool.  The  BCWS  in  input  into  the  PPM  Cost   Tool  and  planned  by  the  CAM  using  the  time  phased  data  in  conjunction  with  the  schedules   tasks.  The  subcontractor’s  scheduled  tasks  are  given  as  associated  dollar  value  using  the   appropriate  Earned  Value  techniques  allowed  in  the  PPM  cost  tool.  The  recommended   technciques  for  minor  subcontarcts  is  Percent  Complete  method.  It  provide  a  means  to  gain   partial  earnings,  thereby  minimizing  erroneous  cost  and  schedule  variances.   ! Is  the  BCWS  time  phased  with  the  baseline  schedule  plans?   " Be  prepared  to  provide  copies  of  your  sibcontracts  or  IWTAs  latest  budget  milestone  plans  and   reporting  documentation,  and  show  traceability  to  the  applicable  Control  Account
  • 31.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  31     ! Can  you  trace  the  budget  from  the  Work  Authorization  to  the  Control  Account  Plans,  to  the   subcontractors?   " Be  prepared  to  provide  traceability  for  each  subcontractor  /  IWTA  Work  Authorization  Document   (WAD)  that  provides  scope,  schedule,  budget,  period  of  performance,  and  approvals  to  the   applicable  PPM  cost  report  and  control  account  plan.   ! Can  you  trace  the  schedule  from  the  subcontractor’s  schedule  to  the  Control  Account  Plan,  to   the  IMS?   " Be  prepared  to  provide  copies  of  your  subcontract  /  IWTA  latest  milestone  plans  and  reporting   documentation  and  provide  traceability  to  the  program  IMS   ! How  do  you  determine  BCWP  for  each  subcontractor?   § Subcontract  Earned  Value  Budgeted  Cost  for  Work  Performed  (BCWP)  is  taken  from  the  CPR  or   MCPR.  This  value  is  represented  at  cost,  but  appropriate  fee  must  be  added.  BCWP  is  handled   based  on  the  contract  type  and  fee  type.  Once  the  appropriate  fee  is  added  to  the  cost,  BCWP   form  the  subcontract  CPR  or  MCPR  data  is  then  input  into  the  PPM  Cost  Tool.     " As  a  CAM  you  must  provide  a  sanity  check  to  ensure  that  the  Earned  Value  represented  in  the   subcontract  reports  is  accurate  and  that  progress  has  been  assessed  properly  based  on  your   knowledge  of  the  work  being  performed.   " For  minor  subcontract  effort  the  CAM  must  update  progress  and  Earned  Value  monthly  on  both   an  IMS  and  on  the  Work  Packages  listed  on  the  CAP  worksheets.  Immediately  upon  receipt  of  the   subcontractor’s  status  and  schedule  data,  the  CAM  must  determine  the  current  Earned  Value   (BCWP)  by  using  the  appropriate  approved  technique.   " IWTAs  are  handled  in  the  same  fashion  as  previously  described.  The  only  difference  between   subcontracts  and  IWTAs  is  that  no  fee  is  added.   ! What  are  the  thresholds  for  generating  a  variance  analysis  report  for  the  subcontractors?   § Variance  Analysis  thresholds  for  subcontracts  and  IWTAs  must  be  the  same  as,  or  are  greater   than,  customer  directed  variance  analysis  reporting  requirements.  It  is  imperative  that  the   subcontract  or  IWTA  cost  and  schedule  variances,  and  Variance  At  Completion  (VAC)  thresholds   are  assessed  and  reported  in  the  same  manner  as  the  prime  contractor  in  order  to  provide   uniform  CPR  Format  5  variance  analysis  narratives  and  corrective  actions.   § There  are  two  primary  methods  of  variance  analysis  required  by  most  customers:  variance   drivers  or  traditional  dollar  and  or  percentage  thresholds.  If  the  customer  requires  the  variance   driver  method,  then  the  subcontractor  should  also  be  required  to  use  this  method.  If  the   traditional  dollar  and  or  percentage  method  is  required  ,  the  program  should  flow  down  that   same  percentage  but  reduce  the  dollar  amount.  Non-­‐FFP  subcontractor’s  value  data  in  the  PPM   tool  system  includes  fee,  which  increases  the  subcontractor’s  values  by  as  much  as  5%  to  15%/
  • 32.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  32     as  such,  tighter  variance  thresholds  should  be  given  to  the  subcontractor,  and  these  should  be   documented  in  the  variance  reporting  thresholds  section  of  the  PPM  Program  Directive.     ! Is  the  subcontractor’s  ETC  consistent  with  the  IMS  forecast  completion  date?   " Be  prepared  to  provide  copies  of  your  subcontract  or  IWTA  latest  milestone  plans  and  reporting   documentation  and  provide  traceability  to  the  program  IMS.   " Show  traceability  for  each  subcontract  Estimate  To  Complete  (ETC)  period  of  performance  as   reflected  in  the  appropriate  Organizational  Performance  Report  or  equivalent,  to  the  completion   dates  reflected  in  the  IMS.   ! Is  you  subcontractor  required  to  do  a  Comprehensive  EAC  (CEAC)?   § Subcontract  or  IWTA  Estimate  At  Complete  (EAC)  should  be  reviewed  monthly  and  updated  as   appropriated.  Subcontract  and  IWTA  Comprehensive  Estimate  At  Completion  (EAC)  must  be   conducted  annually  at  the  same  time  the  prime  contractor  perform  its  CEAC,  as  described   Program  Directive  and  the  Business  Rhythm  Calendar.  Subcontract  or  IWTA  CEAC  process  may   be  performed  more  often,  or  at  a  different  time  as  the  prime,  but  must  be  authorized  and   documented  in  the  PPM  Program  Directive  and  Business  Rhythm  Calendar.   " Be  prepared  to  show  the  PPM  Program  Directive  and  Business  Rhythm  Calendar  reflects  the   latest  upcoming  subcontract  or  IWTA  CEAC  process  dates.   " Provide  the  latest  CEAC  documentation  (if  performed)  and  be  able  to  explain  the  process  and   how  the  data  is  incorporated  in  the  Contract  Performance  Report  (CPR)  and  IMS  documentation.   ! How  often  is  this  done?   " Be  prepared  to  support  the  period  of  assessment  for  the  Subcontractor  CEAC  and  its  relation  to   programmatic  risk  reduction.     ! How  is  it  incorporated?   " Be  prepared  to  show  who  the  subcontract  CEAC  and  the  associated  programmatic  risk  is   incorporated  in  the  Performance  Measurement  Baseline.   ! Does  your  subcontractor  have  a  risk  mitigation  plan?   " If  the  Subcontract  has  a  risk  management  plan,  show  a  copy  and  explain  its  use.   «MATERIAL  MANAGEMENT»   § If  there  are  Control  Accounts  with  material,  you  need  to  answer  the  following  questions:   ! Is  the  material  high  or  low  value,  and  how  are  these  values  determined?   " The  process  of  material  management  is  described  below
  • 33.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  33     § “Initially  material  budgets  can  be  placed  in  planning  packages  until  specific  material   requirements  are  identified  (by  purchase  requisition,  purchase  order,  development  Bill  of   Materials,  or  material  lists).  As  requirements  are  identified,  budgets  are  converted  into  tasks   with  schedules  and  estimated  or  know  costs.  For  the  purpose  of  performance  management   there  are  generally  three  type  of  material:  direct  charge,  inventory,  and  miscellaneous  material.   BCWS  and  BCWP  are  handled  differently  for  each  category.”   § “If  a  program  does  not  utilize  a  Materials  Requirements  Plan  (MRP)  system  for  tracking  direct  or   inventory  material,  it  must  be  tracked  using  high-­‐dollar-­‐value  or  high-­‐quantity  level  that   warrants  planning  and  statusing  by  part  number  because  of  its  criticality  to  the  program.  The   definition  of  “high  dollar  or  high  quantity”  must  be  defined  in  the  Program  Directive.  High  Value   Material  is  to  be  planned  discretely  while  low  value  material  may  be  planned  as  Level  of  Effort.”   " Be  prepared  to  explain  how  the  program  determine  “high”  and  “low”  value  material   requirements,  and  provide  the  definition  referenced  in  the  Program  Directive.   ! How  do  you  plan  your  material?  Is  it  listed  by  Bill  of  Materials  or  an  equivalent?   § BCWS  for  Direct  Charge  Material:  typically  Direct  Charge  Material  is  represented  by  estimated   (of  not  yet  negotiated)  pt  negotiated  values  time-­‐phased  by  month;  and  based  on  milestone   schedules,  on  expected  receipt  of  hardware  to  the  point-­‐of-­‐use,  or  on  a  monthly  percentage.   § In  determining  the  BCWS  methodology  consideration  should  be  given  to  program  requirements,   the  subcontractor  /  purchase  order  type  of  the  contract  and  the  payment  terms  (milestones,   payment  on  delivery,  etc.).  Tasks  should  be  primarily  considered  “discrete  effort”  and  planned   as  such,  using  any  of  the  Earned  Value  techniques  defined  in  the  Program  Directive.   § Inventory  Material  BCWS:  BCWS  for  inventory  material  should  be  time  phased  in  months  based   on  the  expected  point  of  consumption.  Typically  this  is  based  on  anticipated  inventory   withdrawal,  or  the  expected  parts  fabrication  support.  Inventory  materials  tasks  should  be   primarily  considered  “discrete  effort.”  The  only  tasks  that  should  be  planned  as  LOE  are   common  use  inventory  items  such  as  fasteners,  wire,  bulks  supplies  and  standard  parts.   § Miscellaneous  Material  BCWS:  BCWS  for  miscellaneous  material  Work  Packages  should  be   planned  as  LOE.   " Be  prepared  to  explain  how  you  have  planned  your  material,  and  provide  Bill  of  Materials  if   available.     " Explain  any  alternative  methods  you  use  to  track  your  material  requirements.   ! Is  the  high  value  material  tracked  in  the  cost  system?   " Based  on  the  answer  from  above,  show  the  appropriate  high  level  materials  Control  Account  or   work  package  monthly  BCWS  spreads  as  reflected  in  the  cost  accounting  system  report.
  • 34.

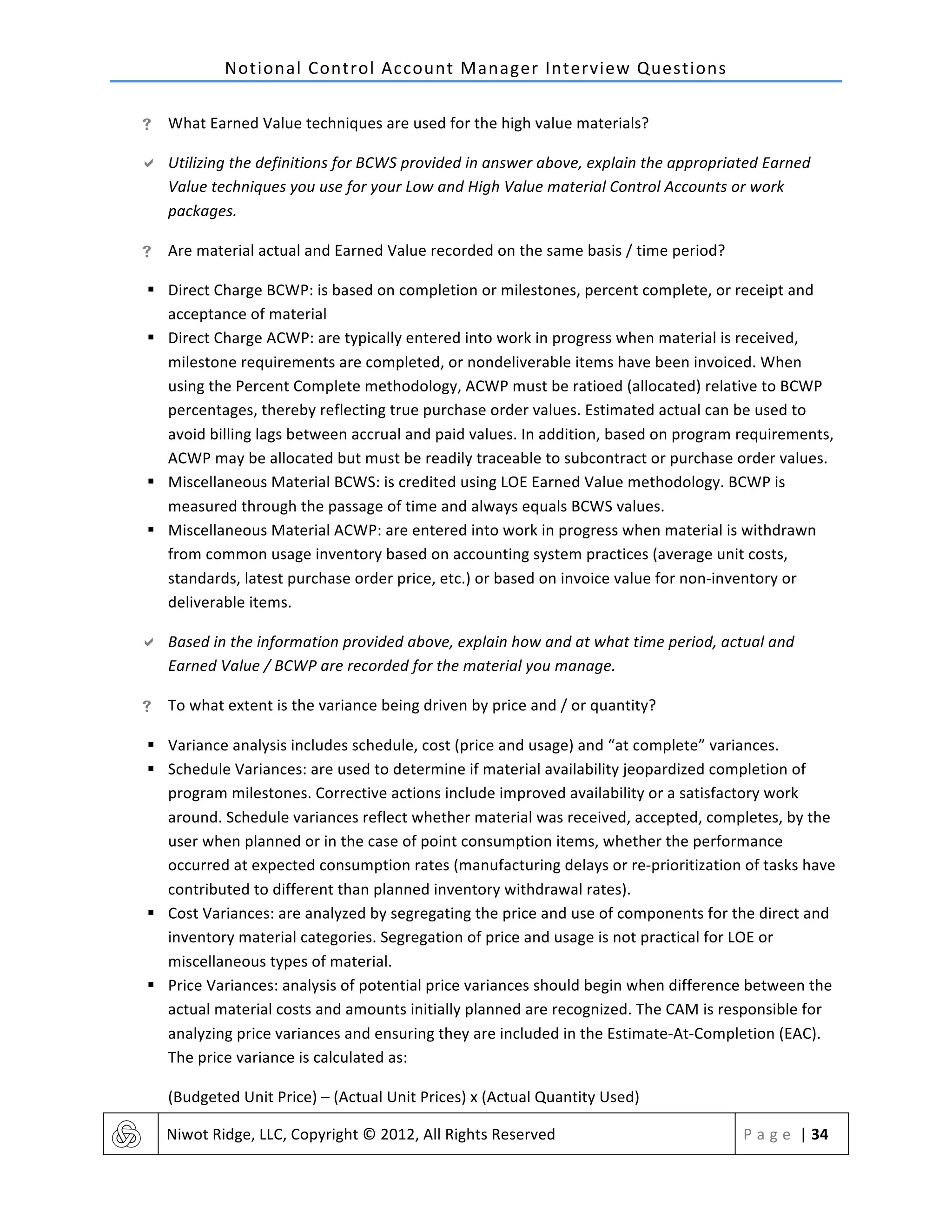

    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  34     ! What  Earned  Value  techniques  are  used  for  the  high  value  materials?   " Utilizing  the  definitions  for  BCWS  provided  in  answer  above,  explain  the  appropriated  Earned   Value  techniques  you  use  for  your  Low  and  High  Value  material  Control  Accounts  or  work   packages.   ! Are  material  actual  and  Earned  Value  recorded  on  the  same  basis  /  time  period?   § Direct  Charge  BCWP:  is  based  on  completion  or  milestones,  percent  complete,  or  receipt  and   acceptance  of  material   § Direct  Charge  ACWP:  are  typically  entered  into  work  in  progress  when  material  is  received,   milestone  requirements  are  completed,  or  nondeliverable  items  have  been  invoiced.  When   using  the  Percent  Complete  methodology,  ACWP  must  be  ratioed  (allocated)  relative  to  BCWP   percentages,  thereby  reflecting  true  purchase  order  values.  Estimated  actual  can  be  used  to   avoid  billing  lags  between  accrual  and  paid  values.  In  addition,  based  on  program  requirements,   ACWP  may  be  allocated  but  must  be  readily  traceable  to  subcontract  or  purchase  order  values.   § Miscellaneous  Material  BCWS:  is  credited  using  LOE  Earned  Value  methodology.  BCWP  is   measured  through  the  passage  of  time  and  always  equals  BCWS  values.   § Miscellaneous  Material  ACWP:  are  entered  into  work  in  progress  when  material  is  withdrawn   from  common  usage  inventory  based  on  accounting  system  practices  (average  unit  costs,   standards,  latest  purchase  order  price,  etc.)  or  based  on  invoice  value  for  non-­‐inventory  or   deliverable  items.   " Based  in  the  information  provided  above,  explain  how  and  at  what  time  period,  actual  and   Earned  Value  /  BCWP  are  recorded  for  the  material  you  manage.   ! To  what  extent  is  the  variance  being  driven  by  price  and  /  or  quantity?   § Variance  analysis  includes  schedule,  cost  (price  and  usage)  and  “at  complete”  variances.   § Schedule  Variances:  are  used  to  determine  if  material  availability  jeopardized  completion  of   program  milestones.  Corrective  actions  include  improved  availability  or  a  satisfactory  work   around.  Schedule  variances  reflect  whether  material  was  received,  accepted,  completes,  by  the   user  when  planned  or  in  the  case  of  point  consumption  items,  whether  the  performance   occurred  at  expected  consumption  rates  (manufacturing  delays  or  re-­‐prioritization  of  tasks  have   contributed  to  different  than  planned  inventory  withdrawal  rates).   § Cost  Variances:  are  analyzed  by  segregating  the  price  and  use  of  components  for  the  direct  and   inventory  material  categories.  Segregation  of  price  and  usage  is  not  practical  for  LOE  or   miscellaneous  types  of  material.   § Price  Variances:  analysis  of  potential  price  variances  should  begin  when  difference  between  the   actual  material  costs  and  amounts  initially  planned  are  recognized.  The  CAM  is  responsible  for   analyzing  price  variances  and  ensuring  they  are  included  in  the  Estimate-­‐At-­‐Completion  (EAC).   The  price  variance  is  calculated  as:     (Budgeted  Unit  Price)  –  (Actual  Unit  Prices)  x  (Actual  Quantity  Used)
  • 35.
    Notional  Control  Account  Manager  Interview  Questions     Niwot  Ridge,  LLC,  Copyright  ©  2012,  All  Rights  Reserved   P a g e  |  35     § Usage  Variance:  can  be  attributed  to  many  causes  including  engineering  changes,  liaison  calls,   order  policies  (safety  stock),  economics  of  scale,  spares,  minimum  buys,  nonconforming   material,  substitute  parts,  part  availability,  etc.  The  usage  variance  calculation  is:   (Budgeted  Quantity)  –  (Actual  Quantity)  x  (Budgeted  Unit  Price)   " If  your  material  Control  Account  has  a  variance,  explain  to  what  extent  the  variance  is  being   driven  by  price  and  or  quantity.
