A short white paper of self-learning about how
to interpret the classic Agile burn-down chart as
a tool of earned value management
An Exercise in
Earned Value
Management
in AGILE
Presented by Square Peg
Consulting, LLC
John Goodpasture, PMP
Copyright 2014, All rights reserved
Square Peg Consulting, LLC
An exercise in earned value management in Agile methods
1 Set-up and background
A project applying agile methods has developed a backlog of three objects.
 Backlog is a prioritized list of objects to be delivered in a scheduled time frame
 An object can be anything that is countable and measureable, with a beginning
effort and a clear definition of complete.
A common tool in Agile methods for assessing earned value is the burn-down chart.
 A burn-down chart is a plot of COUNT of backlog objects vs SCHEDULE
(planned wall time)
 There can be surrogates for COUNT of objects: count of stories; count of story
points; count of cases; and, number of remaining hours to deplete the backlog, or
number of remaining hours to complete the backlog
 There is no information on the burn-down about sequence, since that would
require planning the work for a specific object.
 There is no information on the burn-down about actual hours or resources
consumed
 In this project the backlog count is 3; but the count could go up or down during
the course of the project due to abandoned objects or new objects or technical
debt that modifies the backlog. Technical debt is treated as objects.
 An object has a burn-down status of COMPLETE or NOT COMPLETE.
It’s common to link the burn-down chart with a Work in Process (WIP) chart (a.k.a
Kanban chart) to track object status in finer detail than the NOT COMPLETE status. WIP
status could include, but not limited to: Not Started, Design, Develop, Test, Verify,
Validate, and Hold for inventory, etc.
2 Planning the project
Assume the following backlog plan for the backlog with COUNT = 3:
Backlog plan
Object identification Planned resource Wall time
Object A 40 hours 2 days
Object B 45 hours 3 days
Object C 35 hours 2 days
Copyright 2014, All rights reserved
Square Peg Consulting, LLC
Total Backlog 120 hours 13 days
Planned resource is the estimated effort; wall time includes consideration for the
availability or conflicts or constraints regarding resources. Thus, a resource rate, like
hours/day, is not always the case.
Wall time may or may not be the calendar schedule, since there could be overlap of wall
time if there are enough resources to go around.
The planner should have access to a team benchmark for productivity. Productivity is not
usually measured over a day; rather it is measured over a duration of a sprint or iteration,
typically 2-4 weeks. A productivity measure for this project might be:
6 objects per sprint (4 weeks)
3 Setting up the baseline burn-down charts
At the outset, the PLANNED VALUE of the baseline is:
 REMAINING COUNT = 3;
 REMAINING HOURS = 120;
And, the PLANNED SCHEDULE is 12 days (1 day of overlap assumed)
Since there is no information about sequence on the burn-down chart, the planner does
not know if Object A will be started or completed before the other two objects, and the
same for the others. Thus, simple linearity is assumed for the initial planning plots.
Typically, X-Y scatter plots are applied because each axis is independent and can have its
own data set. Also, the major and minor axis are independently set to integers because
there is no partial credit.
And, it’s typical to keep the object count and the remaining hours on different charts.
Burn-down plots
The following are the baseline burn-down plots.
Copyright 2014, All rights reserved
Square Peg Consulting, LLC
Baseline burn-down chart:
Of course, you can use row-column data in a spreadsheet chart without the plots.
Copyright 2014, All rights reserved
Square Peg Consulting, LLC

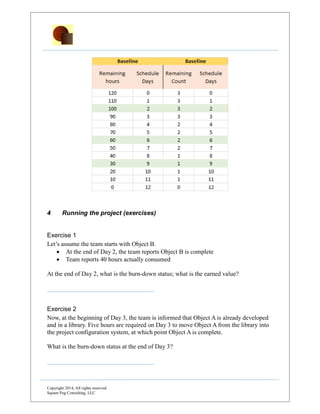

4 Running the project (exercises)
For all exercise answers, apply this template:
Remaining count:
Remaining hours:
Earned value:
 objects earned
 planned hours earned
 hours actually used
 Efficiency: planned hours/actual hours
Exercise 1
Let’s assume the team starts with Object B.
 At the end of Day 2, the team reports Object B is complete
 Team reports 40 hours actually consumed
At the end of Day 2, what is the burn-down status; what is the earned value?
Copyright 2014, All rights reserved
Square Peg Consulting, LLC
Exercise 2

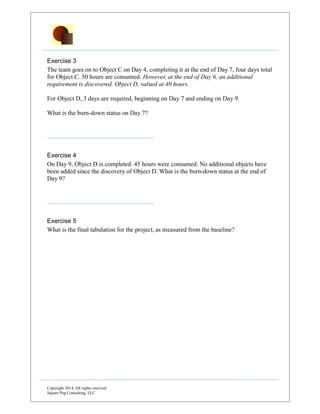

Now, at the beginning of Day 3, the team is informed that Object A is already developed
and in a library. Five hours are required on Day 3 to move Object A from the library into
the project configuration system, at which point Object A is complete.
What is the burn-down status at the end of Day 3?
Exercise 3
The team goes on to Object C on Day 4, completing it at the end of Day 7, four days total
for Object C. 50 hours are consumed. However, at the end of Day 6, an additional
requirement is discovered. Object D, valued at 40 hours.
For Object D, 3 days are required, beginning on Day 7 and ending on Day 9.
What is the burn-down status on Day 7?
Exercise 4
On Day 9, Object D is completed. 45 hours were consumed. No additional objects have
been added since the discovery of Object D. What is the burn-down status at the end of
Day 9?
Exercise 5
What is the final tabulation for the project, as measured from the baseline?
Copyright 2014, All rights reserved
Square Peg Consulting, LLC

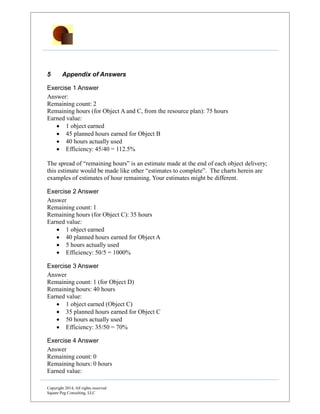

5 Appendix of Answers
Exercise 1 Answer
Answer:
Remaining count: 2
Remaining hours (for Object A and C, from the resource plan): 75 hours
Earned value:
 1 object earned
 45 planned hours earned for Object B
 40 hours actually used
 Efficiency: 45/40 = 112.5%
The spread of “remaining hours” is an estimate made at the end of each object delivery;
this estimate would be made like other “estimates to complete”. The charts herein are
examples of estimates of hour remaining. Your estimates might be different.
Exercise 2 Answer
Answer
Remaining count: 1
Remaining hours (for Object C): 35 hours
Earned value:
 1 object earned
 40 planned hours earned for Object A
 5 hours actually used
 Efficiency: 50/5 = 1000%
Exercise 3 Answer
Answer
Remaining count: 1 (for Object D)
Remaining hours: 40 hours
Earned value:
 1 object earned (Object C)
 35 planned hours earned for Object C
 50 hours actually used
 Efficiency: 35/50 = 70%
Exercise 4 Answer

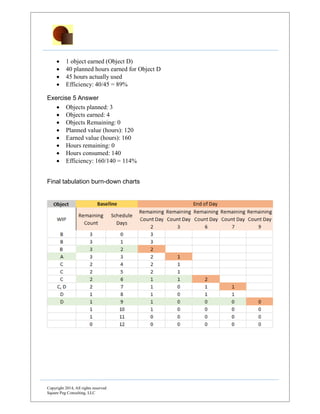

Answer
Remaining count: 0
Remaining hours: 0 hours
Earned value:
Copyright 2014, All rights reserved
Square Peg Consulting, LLC
 1 object earned (Object D)
 40 planned hours earned for Object D
 45 hours actually used
 Efficiency: 40/45 = 89%
Exercise 5 Answer
 Objects planned: 3
 Objects earned: 4
 Objects Remaining: 0
 Planned value (hours): 120
 Earned value (hours): 160
 Hours remaining: 0
 Hours consumed: 140
 Efficiency: 160/140 = 114%

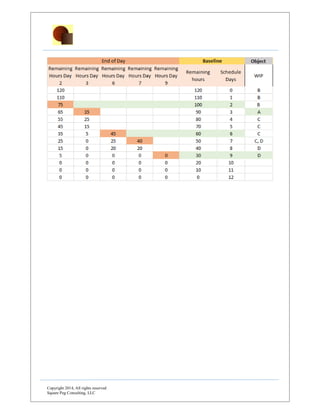

Final tabulation burn-down charts
Copyright 2014, All rights reserved
Square Peg Consulting, LLC
