Agile Metrics and Quality
Metrics -> Improvements

Use metrics to
 •   Improve quality
 •   Shorten product cycle time
 •   Decrease costs
 •   Decrease risks
 •   Increase predictability and reliability

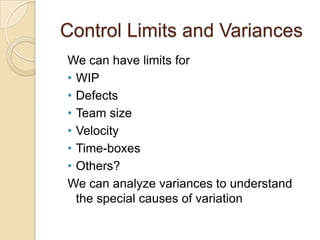

Control Limits and Variances
We can have limits for
• WIP
• Defects
• Team size
• Velocity
• Time-boxes
• Others?
We can analyze variances to understand
  the special causes of variation

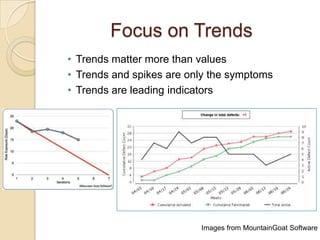

Focus on Trends
• Trends matter more than values
• Trends and spikes are only the symptoms
• Trends are leading indicators

                          Images from MountainGoat Software
Improve quality
 ◦ Quality is measured by passed tests and
   customer acceptance
 ◦ Quality is defined by Definition of Done
   and Acceptance Criteria
 ◦ Defect trends to use in Agile projects
     Number of open defects
     Escaped defects
     Defect Cycle Time
     Defect spill-over
 ◦ Test Automation is critical!
Defect Injection and
     Resolution

What is the trend of total Active Defects?
                                 Image from MountainGoat Software

Analyzing and Preventing
Pareto Chart           Defects

                              Fishbone / 5 Why Technique

Escaped Defects
• Used to measure the quality of delivered
  code
 Calculation:
                             9

  ◦ For all releases, find   8
                             7
    all defects related to
                             6
    the release found
                             5
    after the release date
                             4
                             3
  ◦ Add up all the defects   2
                             1

  ◦ Can be captured per
                             0
                                 Jan   Feb Mar    Apr May Jun   Jul   Aug Sep   Oct   Nov Dec
    day / week / month /
    … or per sprint /                            Escaped Defects over Time
    release
Defect Cycle Time
• Rapid resolution of defects is important
• Average bug-fix time can also be tracked for
  different priority bugs
                         Defect Cycle Time
           20
           18
           16
                                                               Desired Threshold
           14
           12
   Hours

           10
            8
            6
            4
            2
            0
                1    2   3   4    5      6    7   8   9   10
                                 Sprint No.

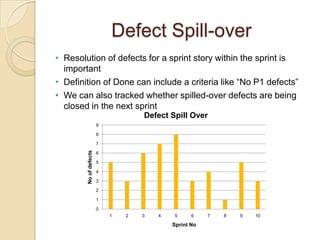

Defect Spill-over
• Resolution of defects for a sprint story within the sprint is
  important
• Definition of Done can include a criteria like “No P1 defects”
• We can also tracked whether spilled-over defects are being
  closed in the next sprint
                                    Defect Spill Over
                        9

                        8

                        7
        No of defects

                        6

                        5

                        4

                        3

                        2

                        1

                        0
                            1   2   3   4   5      6    7   8   9   10

                                            Sprint No

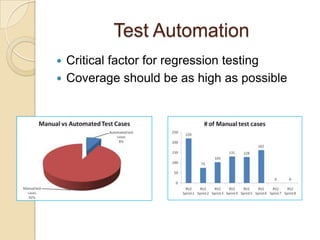

Test Automation
 Critical factor for regression testing
 Coverage should be as high as possible
Shorten product cycle time
   Cumulative Flow Diagrams
    ◦ Lead Time
    ◦ Cycle Time
Features   CFD – An Elaboration

                 Time

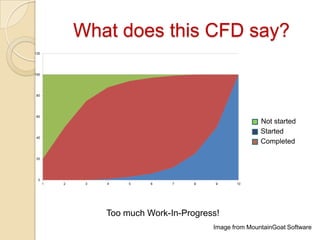

What does this CFD say?

                                          Not started
                                          Started
                                          Completed

   Too much Work-In-Progress!
                           Image from MountainGoat Software

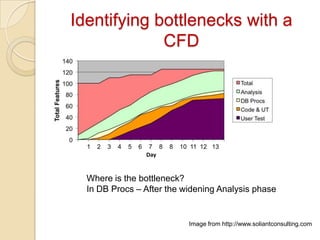

Identifying bottlenecks with a
             CFD

  1   2   3   4   5   6    7 8   8   10 11 12 13
                          Day

  Where is the bottleneck?
  In DB Procs – After the widening Analysis phase

                                       Image from http://www.soliantconsulting.com
Decrease costs
• Earned Value Management
• Wastage
Earned Value Analysis
PV – Planned Value
EV - Earned Value
AC - Actual cost
BAC     - Budget @
Completion
EAC     - Estimate @
Completion
ETC     - Estimate to
CompletionCost Variance (CV)              = EV – AC
VAC- Variance @ Completion (SV)
          Schedule Variance               = EV – PV
         Cost Performance Index (CPI)     = EV / AC
         Schedule Performance Index (SPI) = EV / PV
         Estimate at Completion (EAC)     = BAC / CPI or
                                          = AC + BAC – EV
         Estimate To Complete (ETC)                = EAC – AC
         Variance at Completion (VAC)     = BAC – EAC

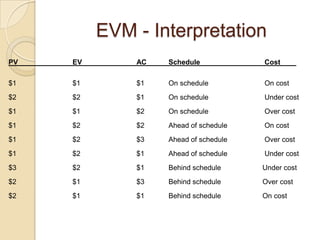

EVM - Interpretation
PV   EV       AC   Schedule            Cost

$1   $1       $1   On schedule         On cost
$2   $2       $1   On schedule         Under cost
$1   $1       $2   On schedule         Over cost
$1   $2       $2   Ahead of schedule   On cost
$1   $2       $3   Ahead of schedule   Over cost
$1   $2       $1   Ahead of schedule   Under cost
$3   $2       $1   Behind schedule     Under cost
$2   $1       $3   Behind schedule     Over cost
$2   $1       $1   Behind schedule     On cost
EVM - Progress
 EV                PV                    AC

           CV

      SV

                Ref: Earned Value and Agile Reporting
                      Anthony Cabri, Mike Griffiths
Wastage
          Any time not dedicated to working on the
           highest priority story / task on the sprint
           backlog
          Should be tracked over time and by cause
             Wastage (in hrs)                                   Wastage (in hrs)
60                                                        160
                                                          140
50                                                        120
                                                          100
40                                                         80
                                                           60
30                                                         40
                                                           20
20                                                          0

10

 0
     1   2   3   4   5   6   7   8   9   10   11   12
Decrease risks
• WIP Limits
• Small Iterations
• More predictability

Increase Predictability /
                   Reliability
•   Velocity
•   Lead Time
•   Cycle Time
Metrics to Avoid
•   Velocity comparisons
•   Productivity e.g. Story Points per day
•   Effort Estimation accuracy
•   Number of stories completed
•   LOC/Function Points
•   Code quality
Questions?
