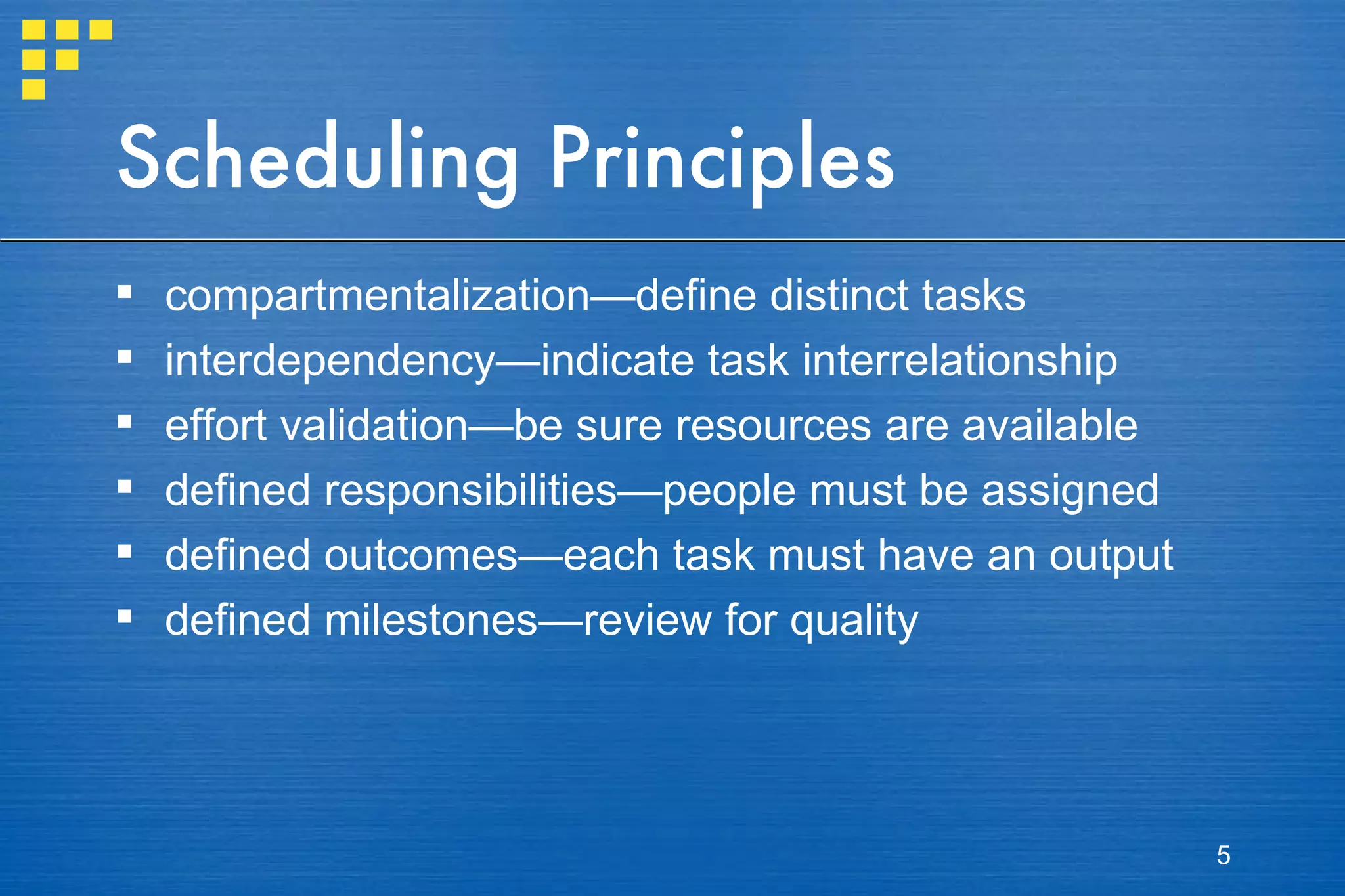

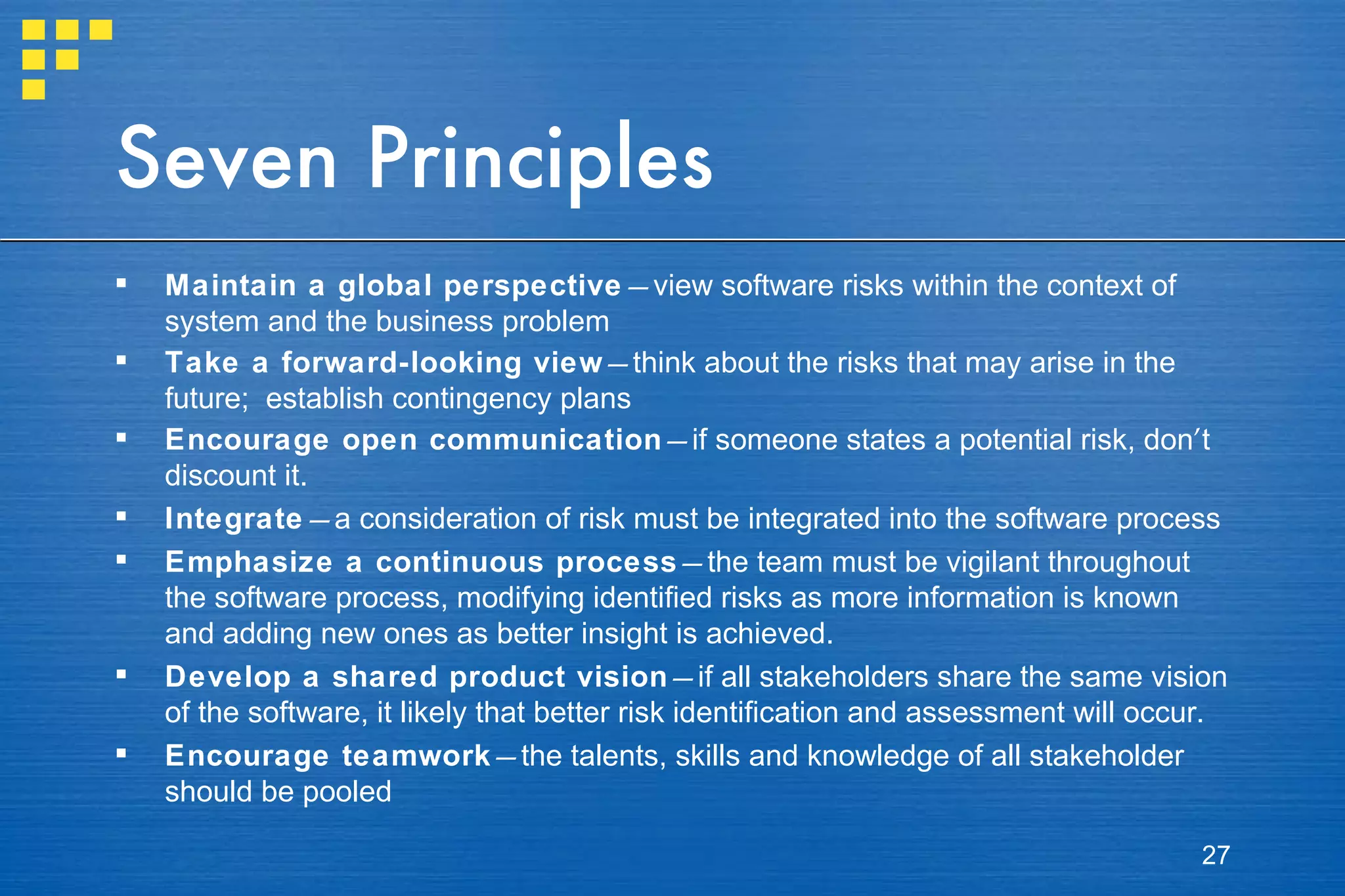

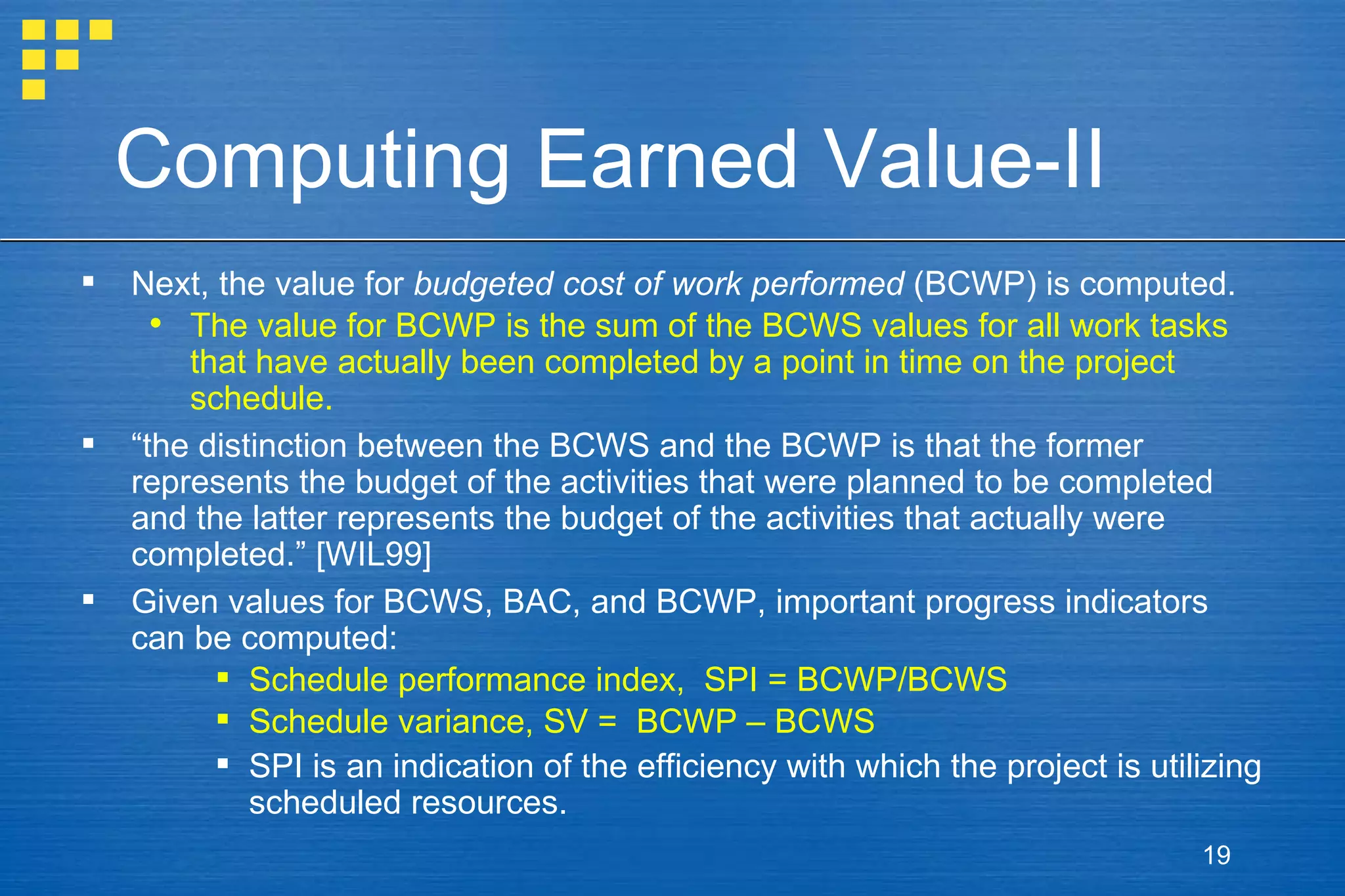

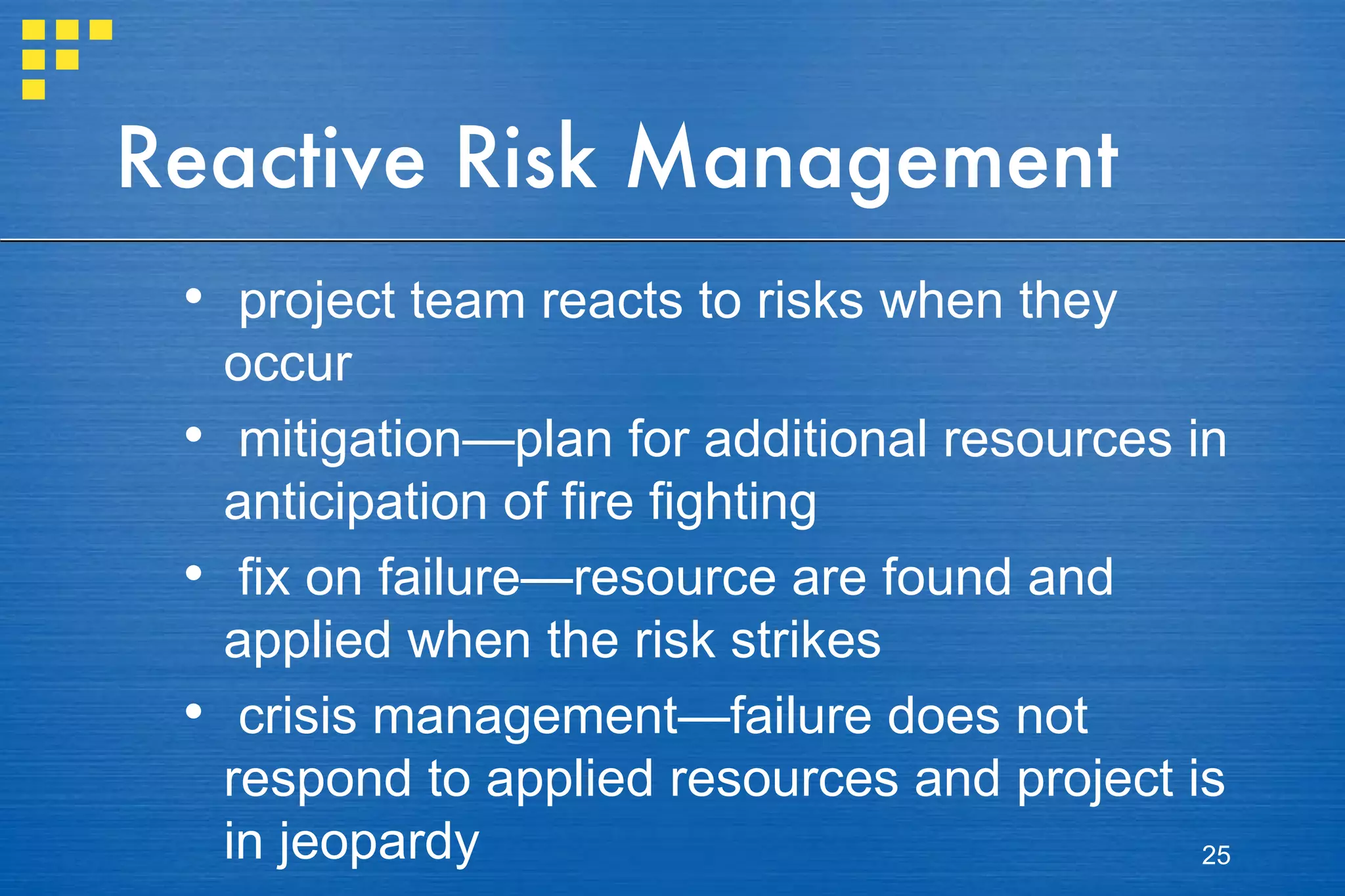

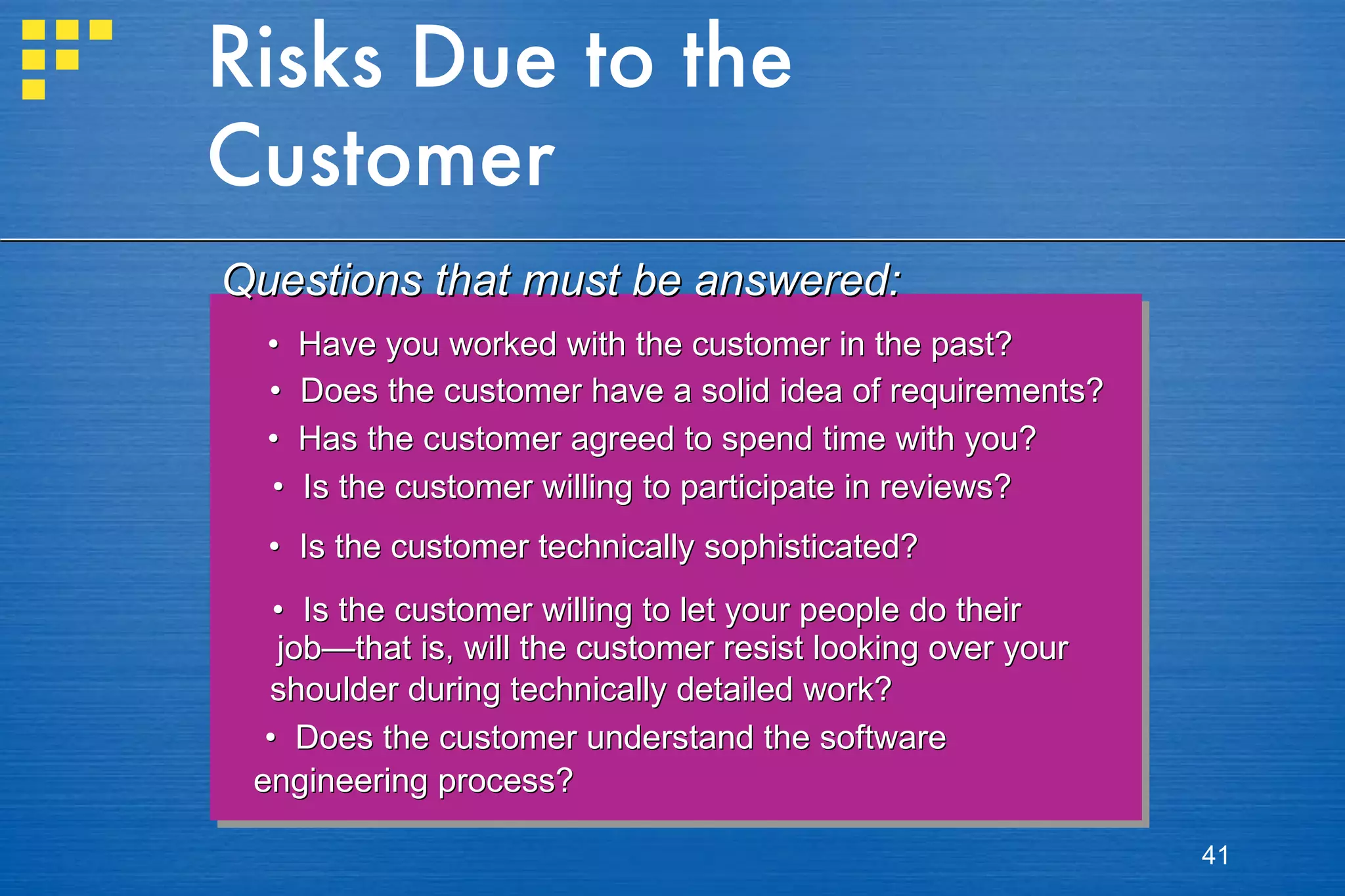

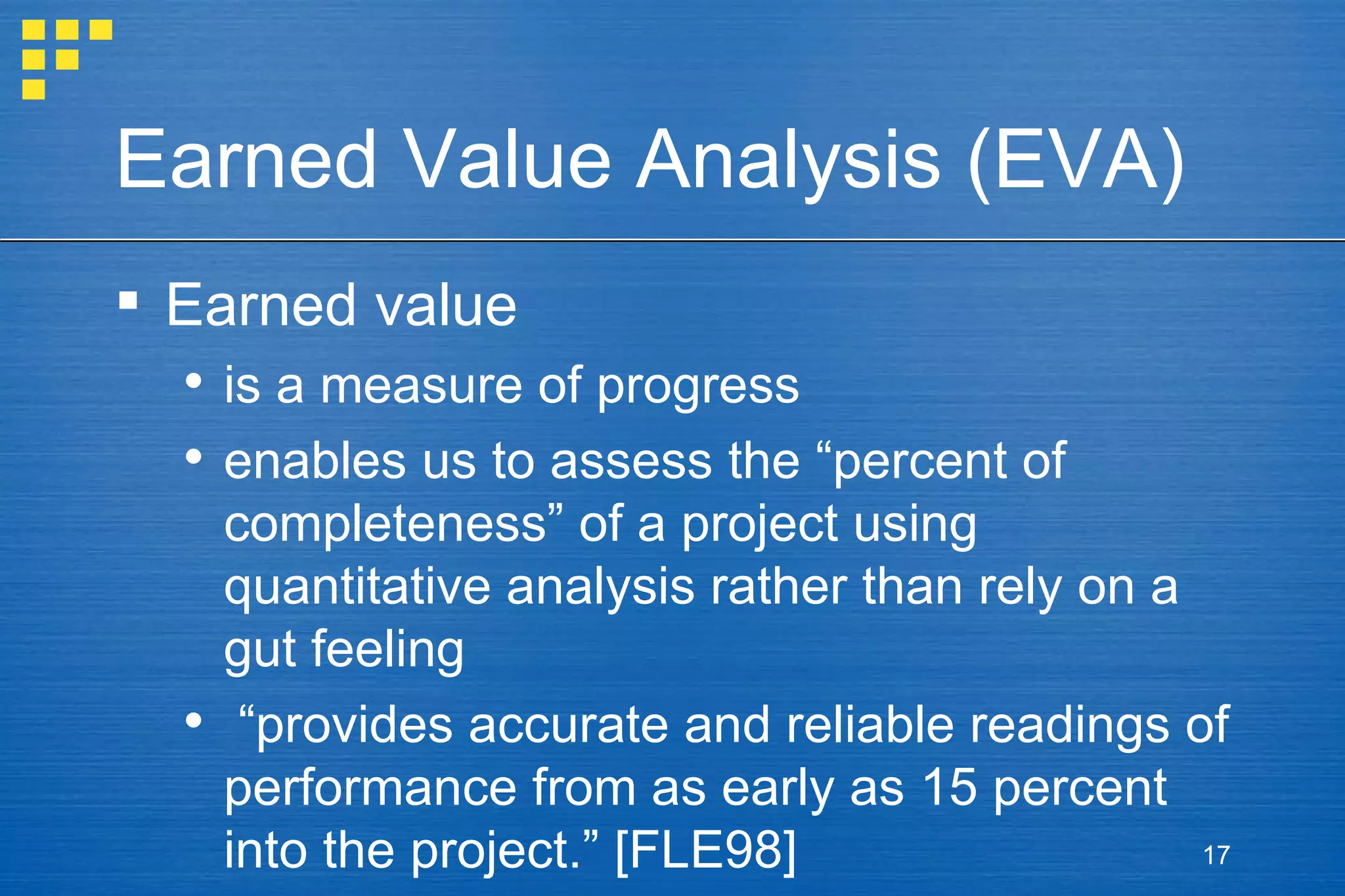

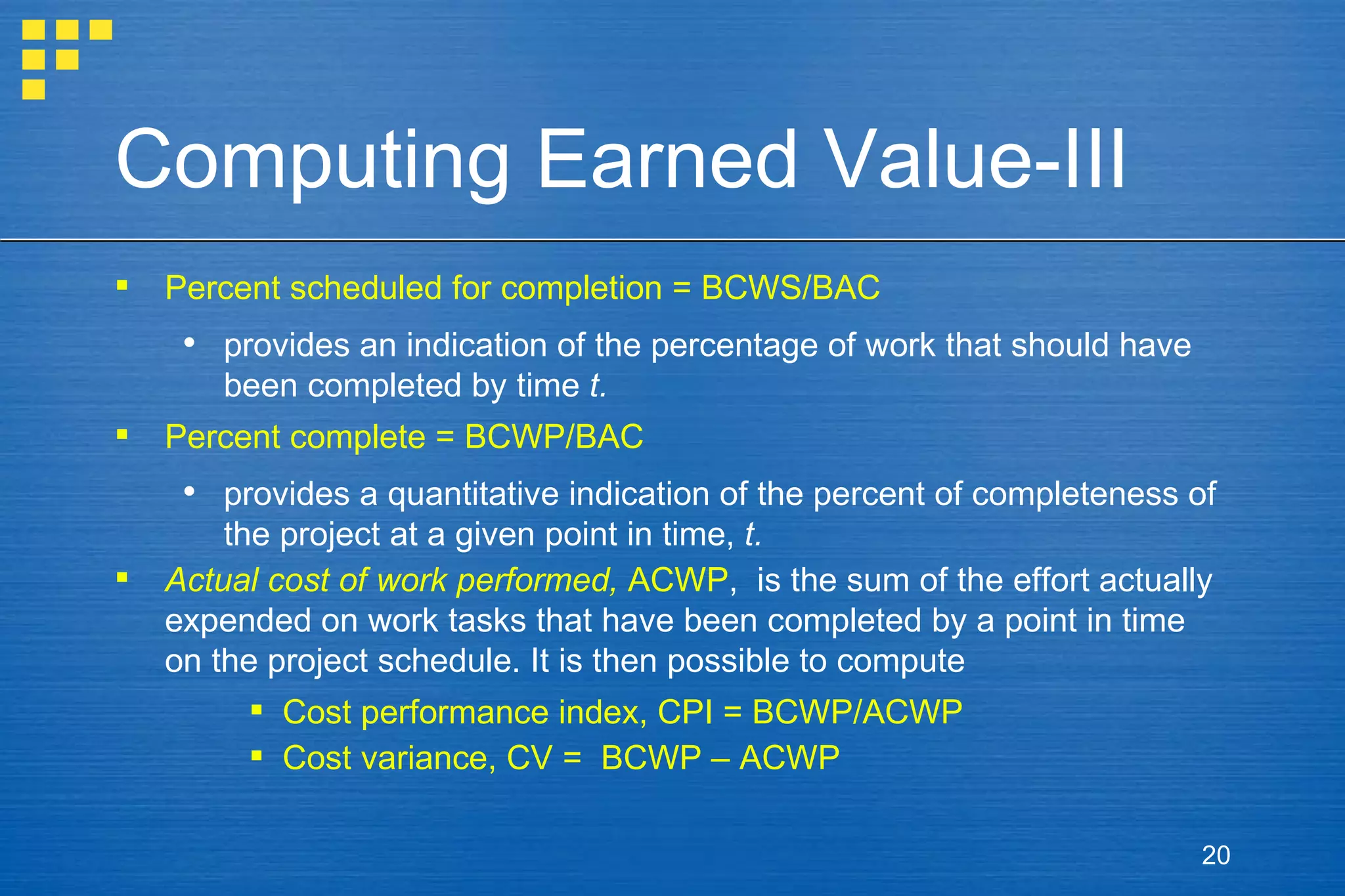

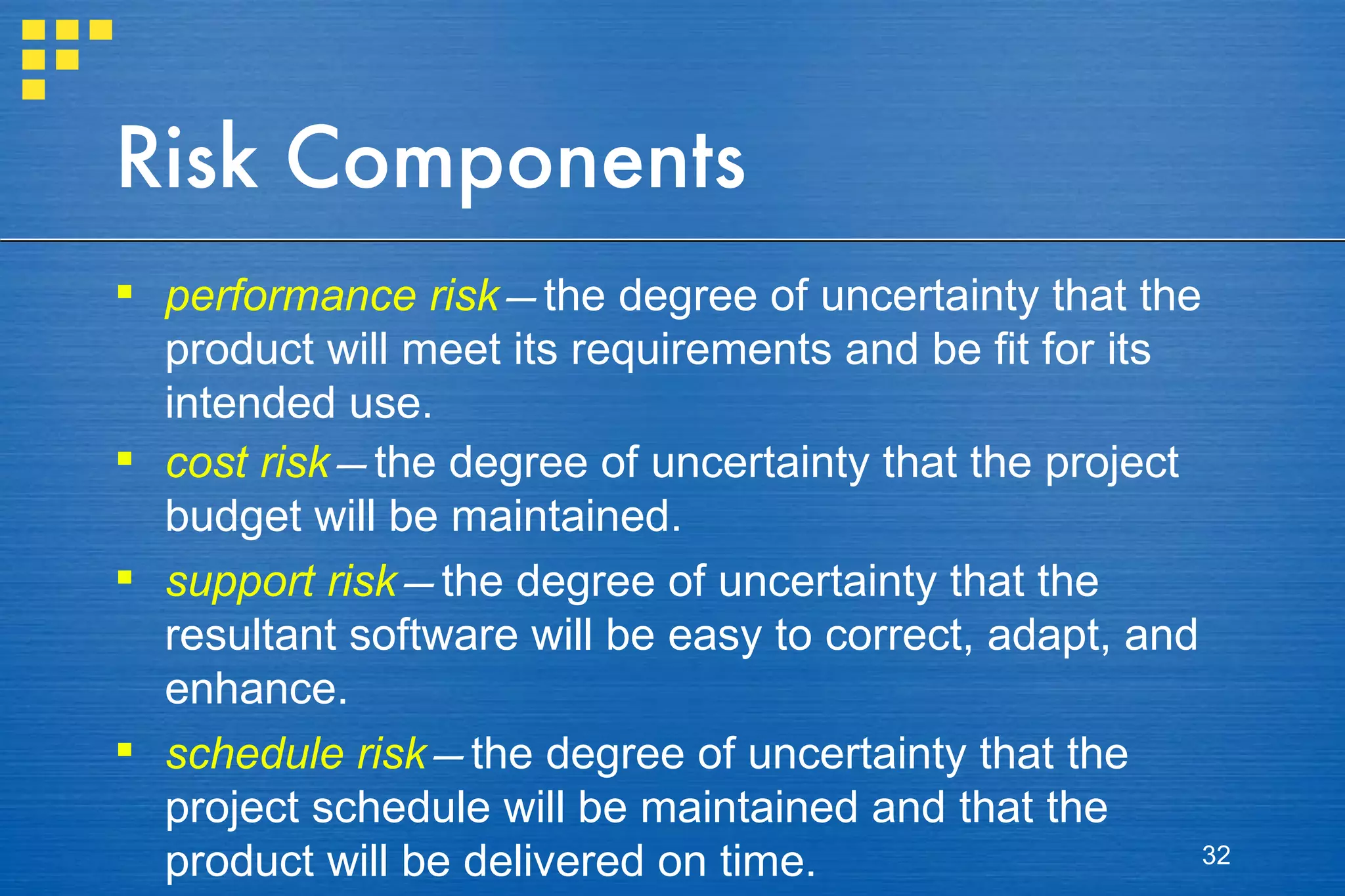

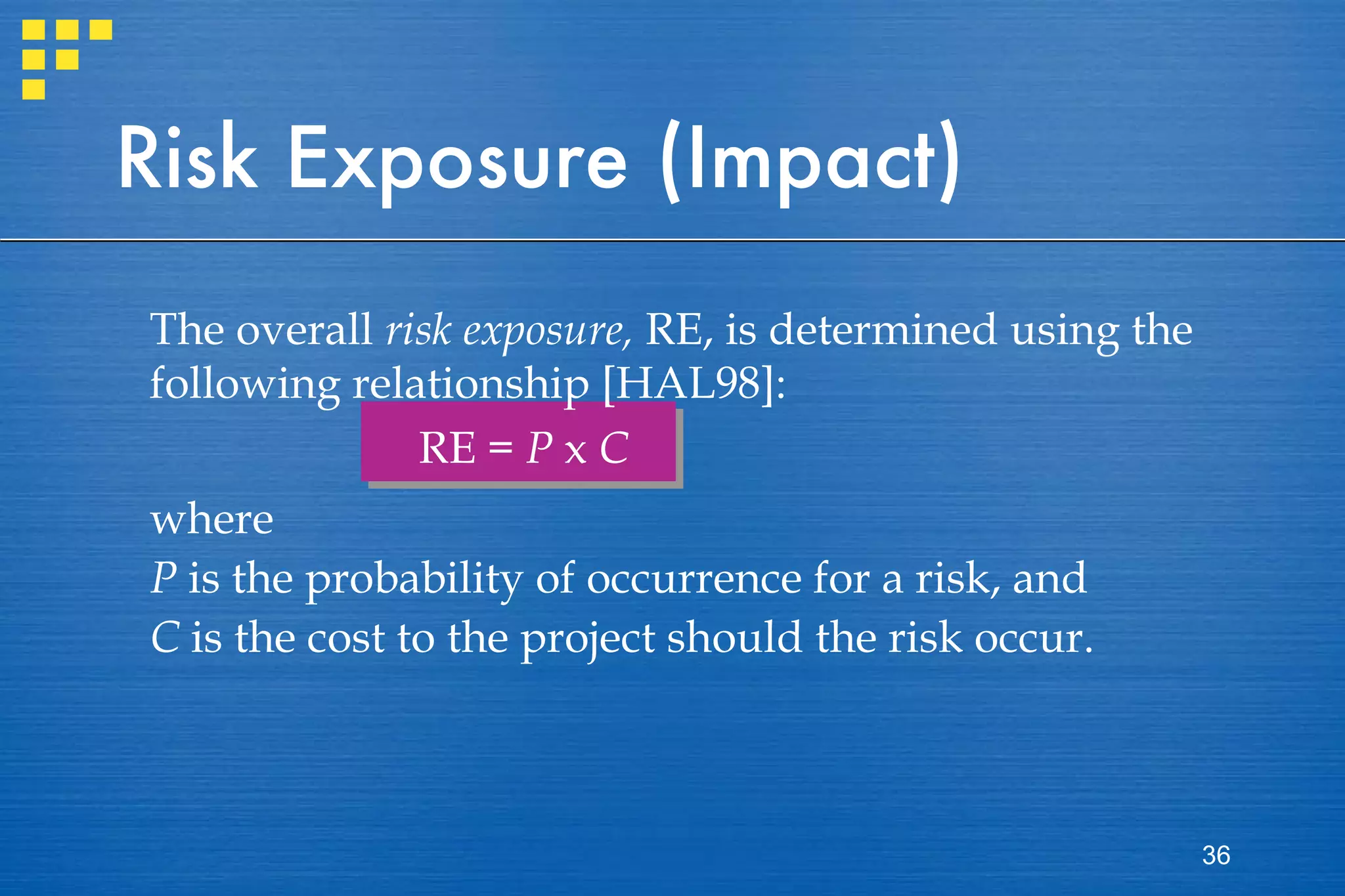

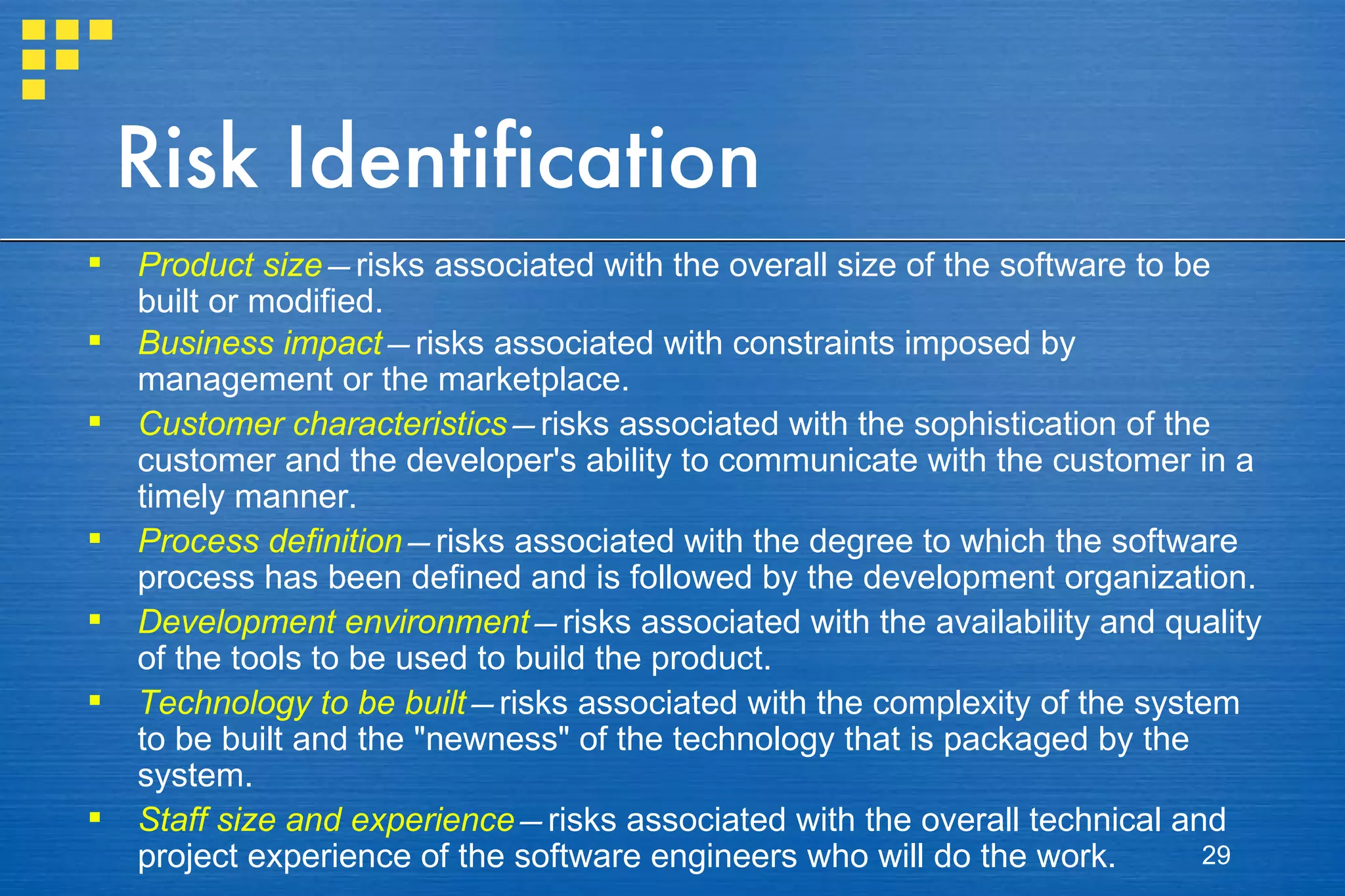

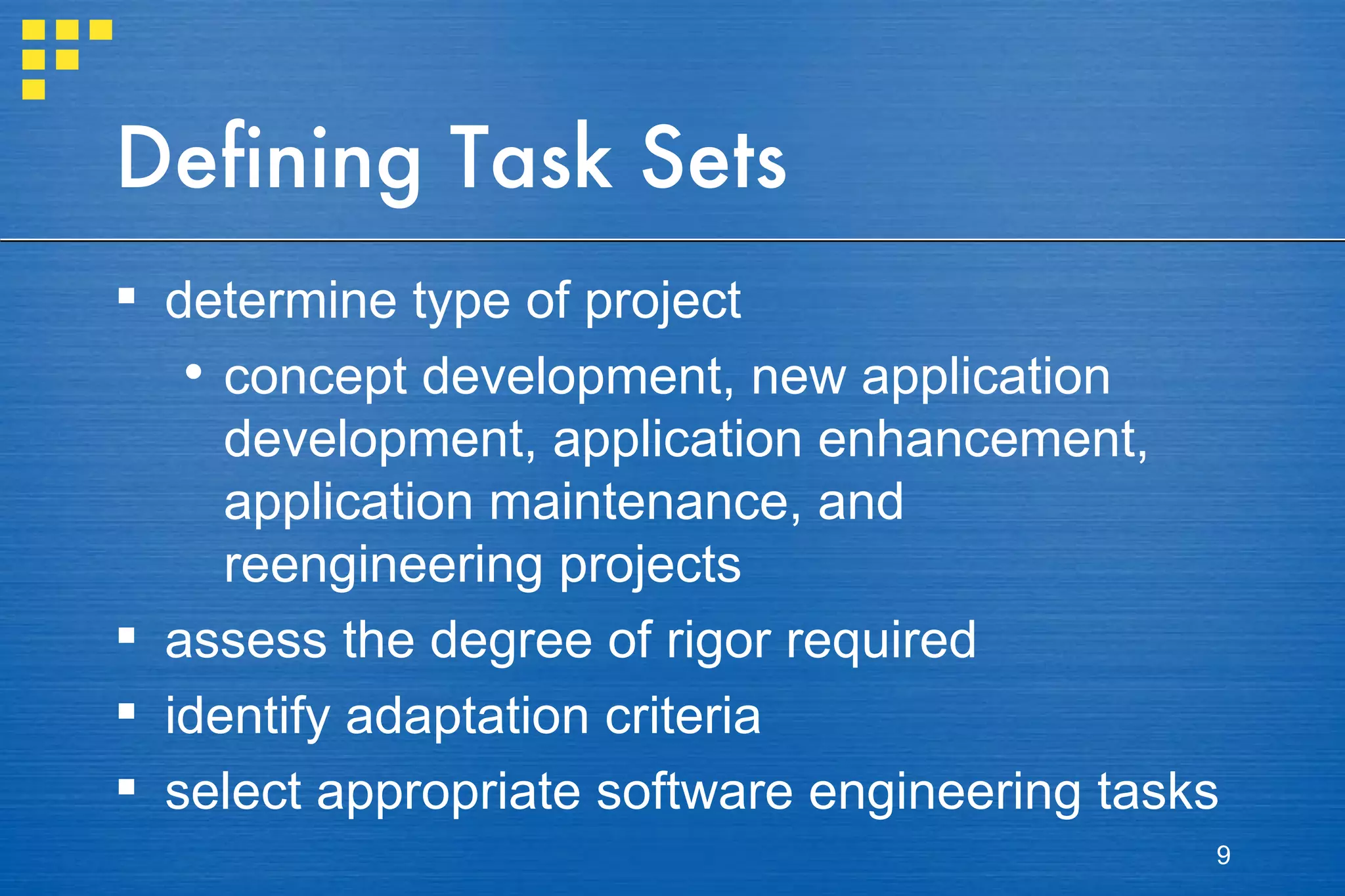

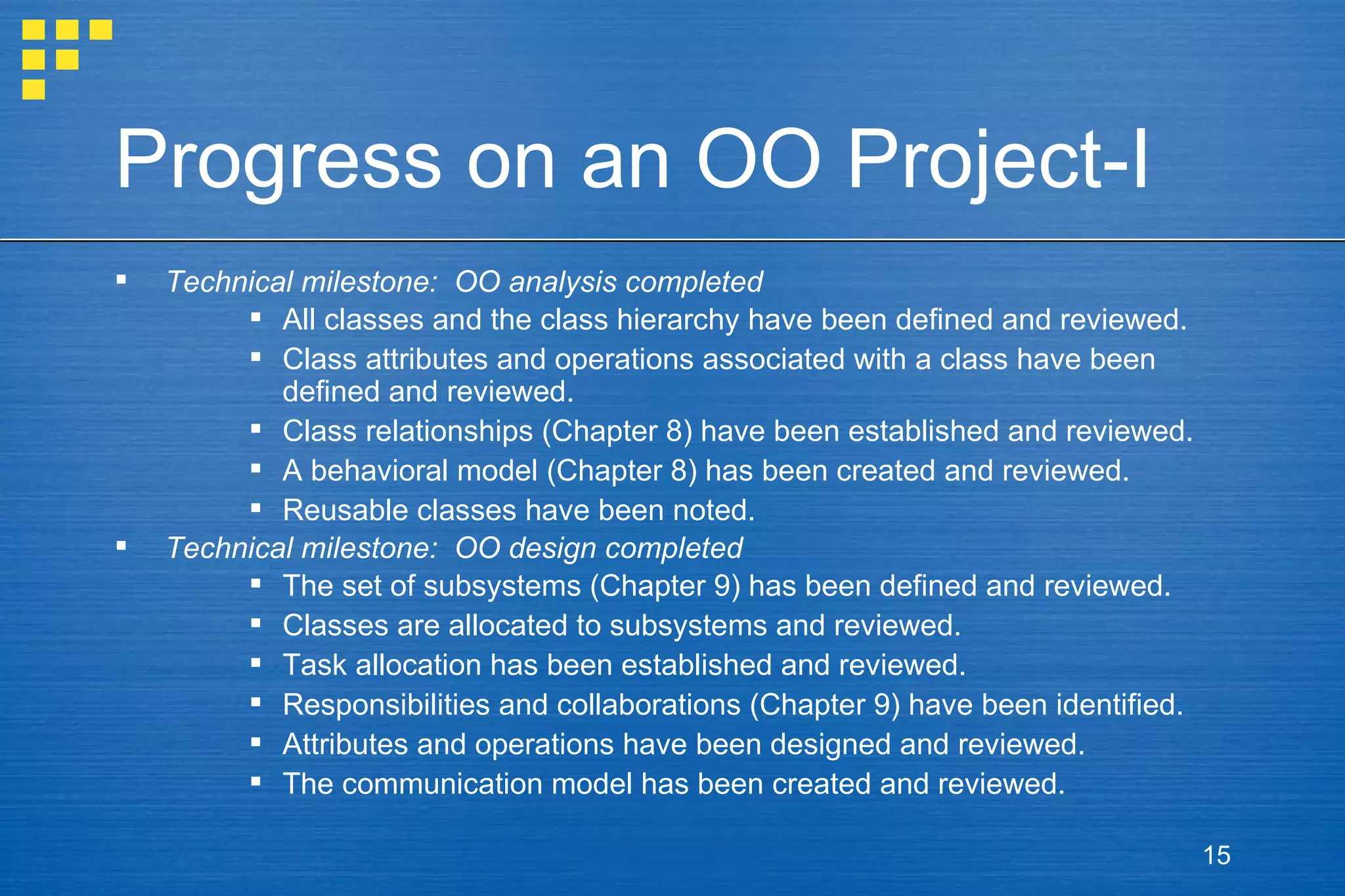

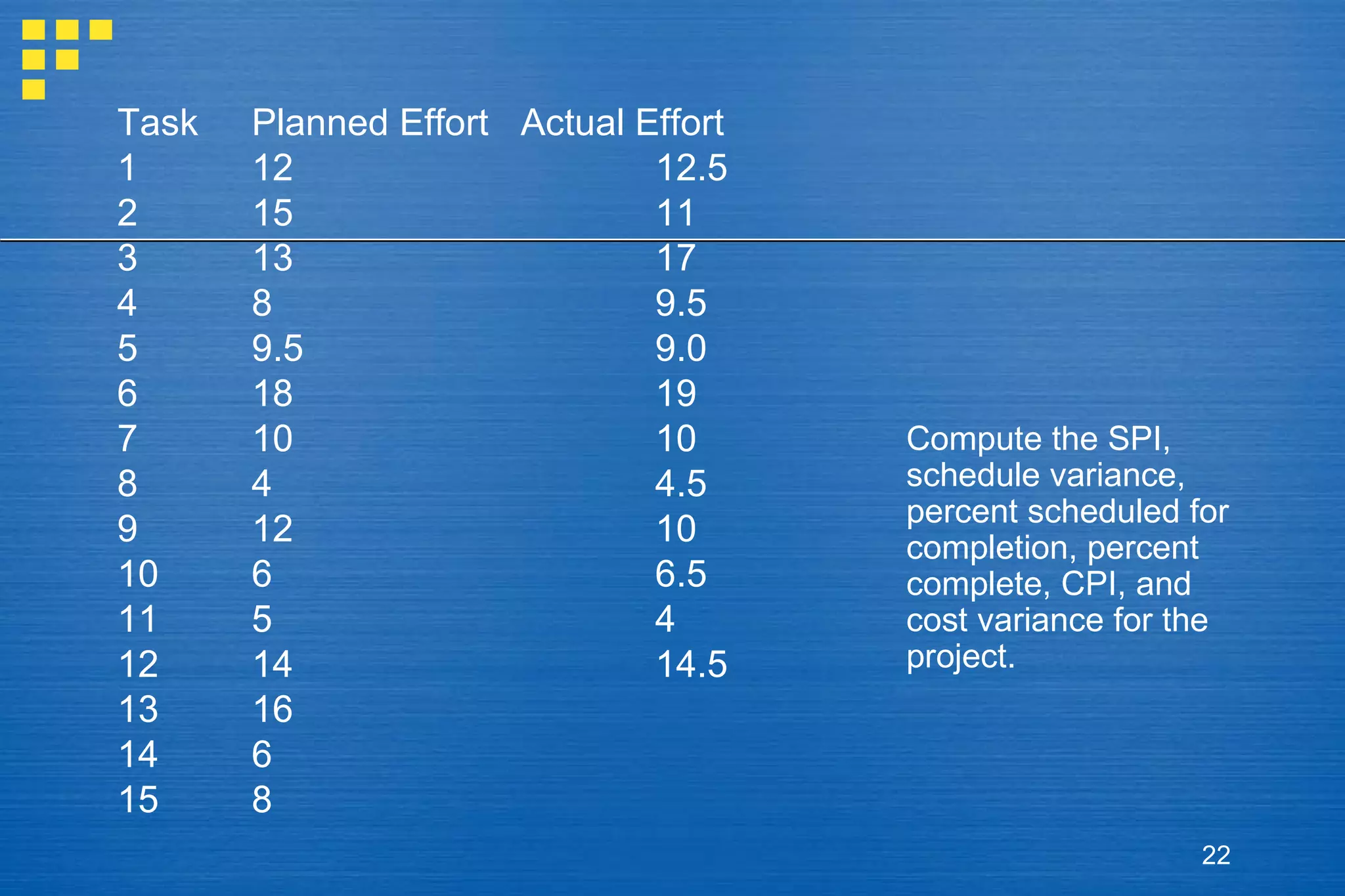

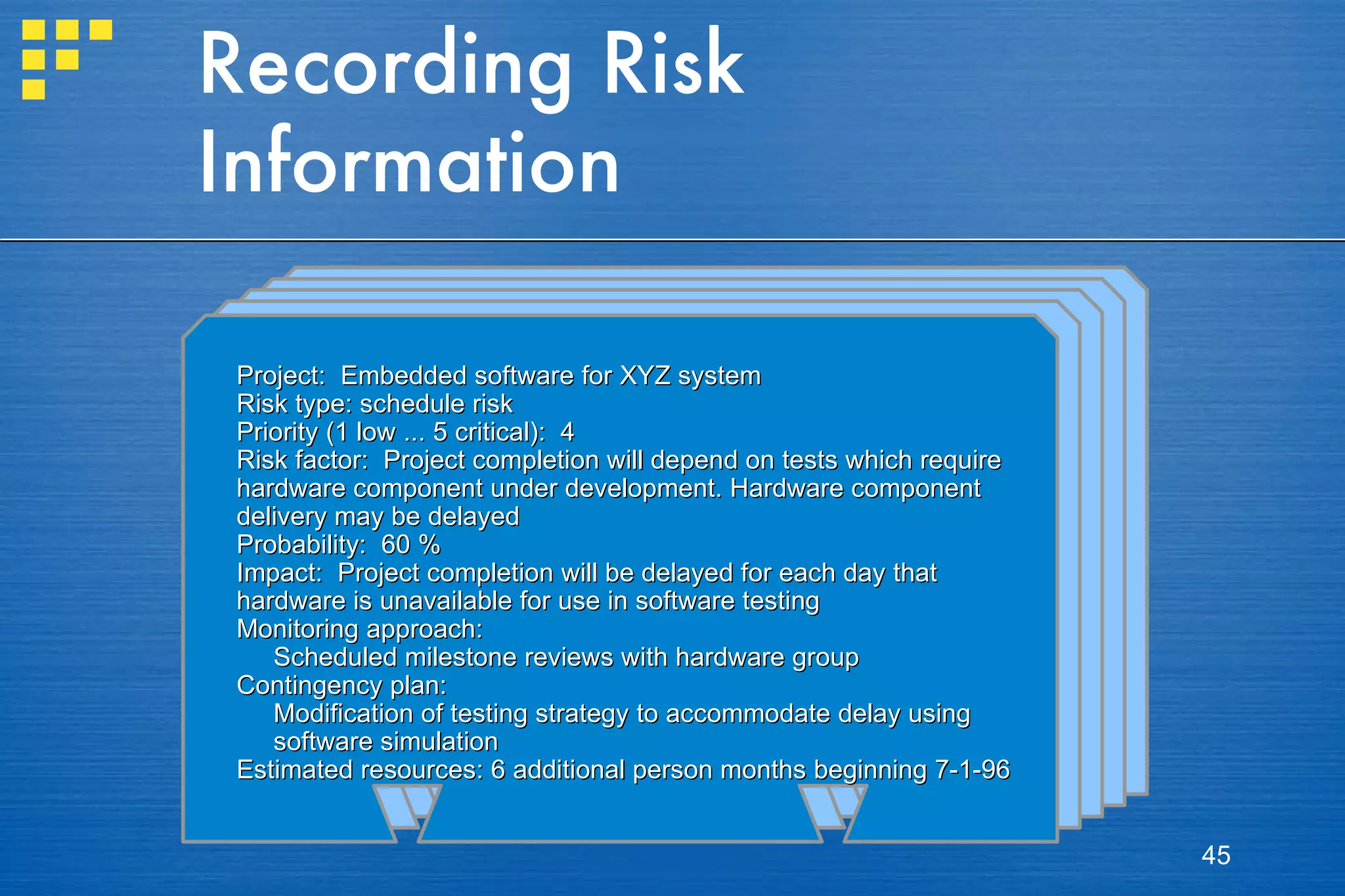

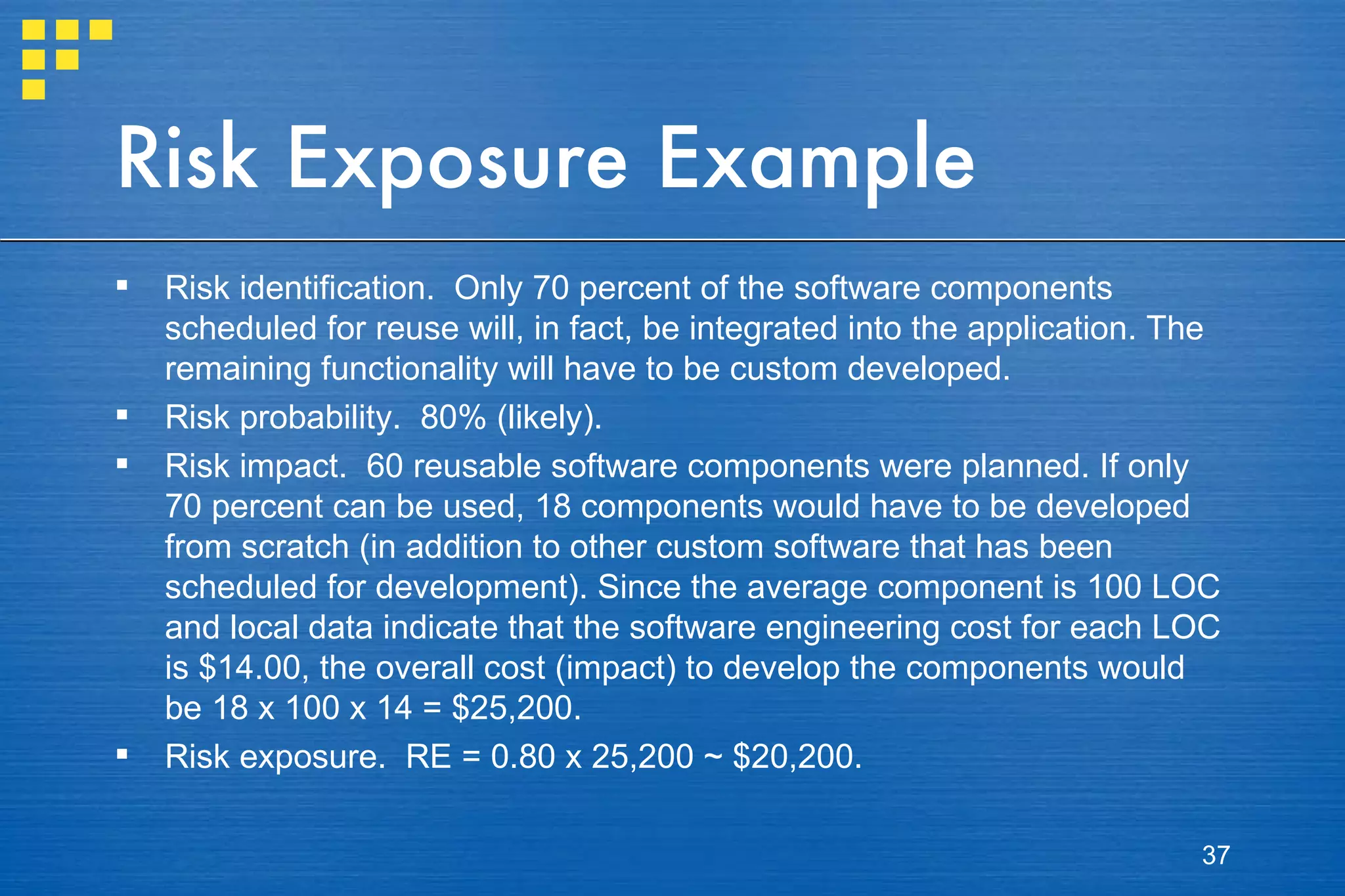

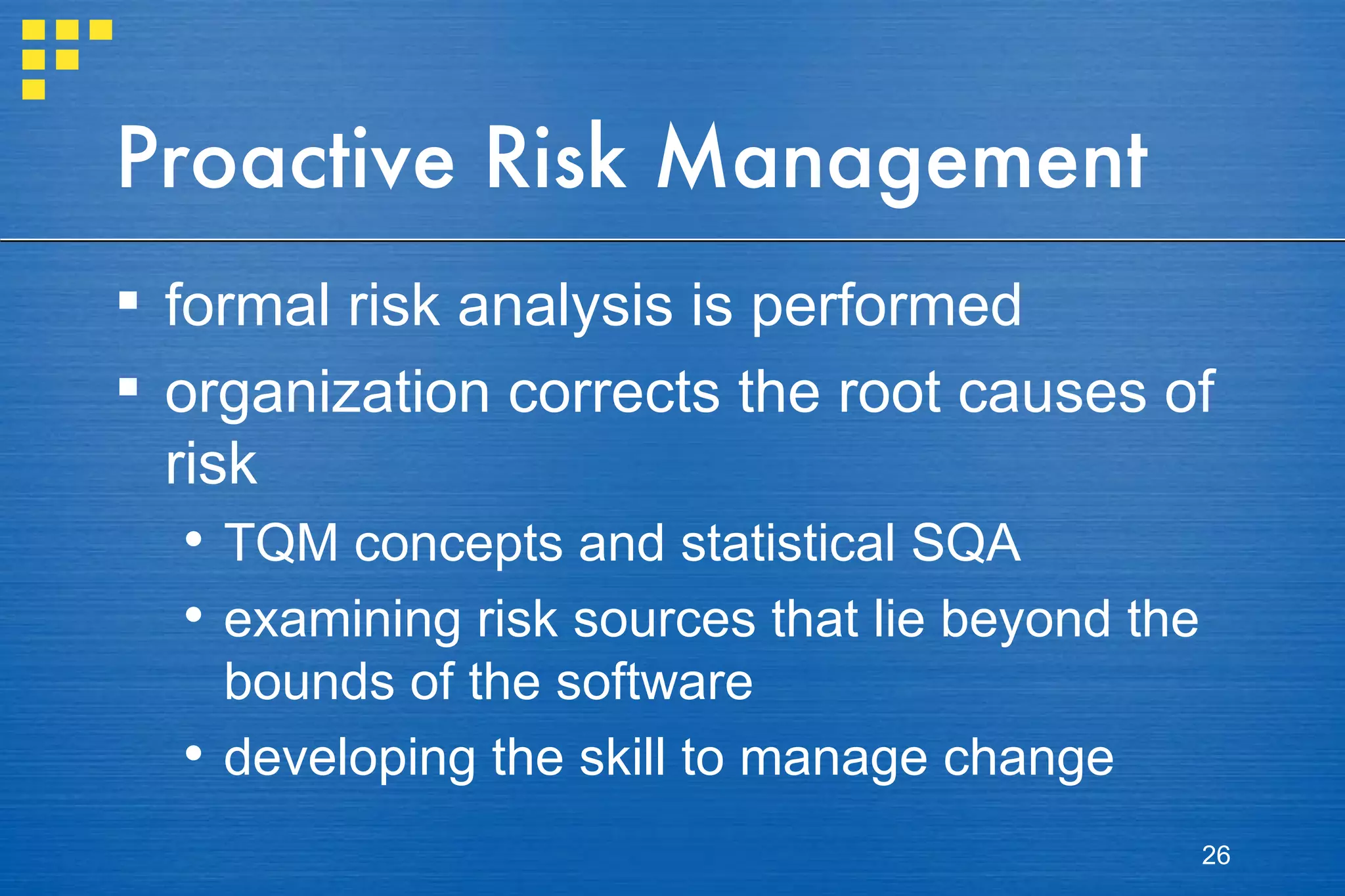

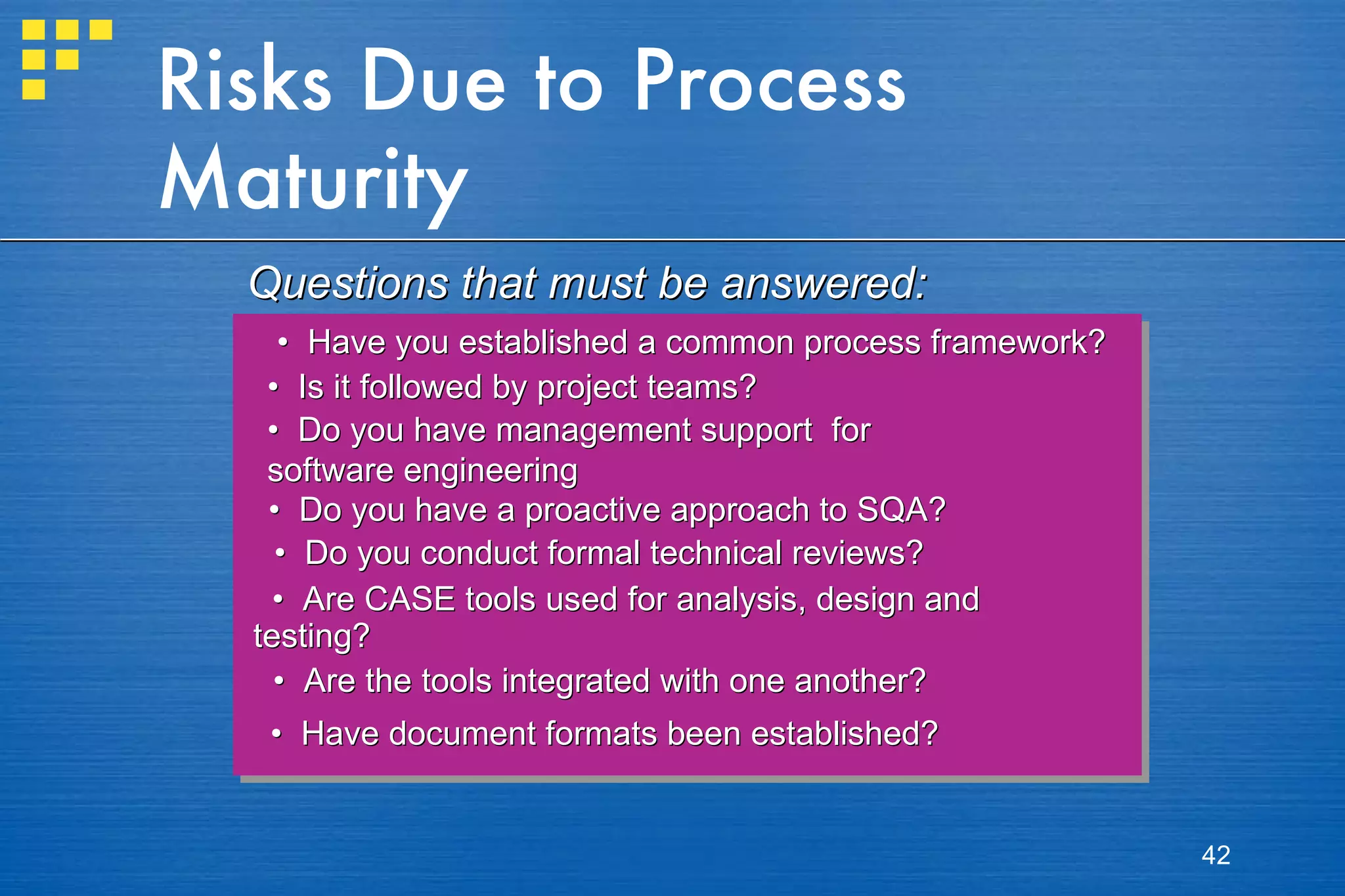

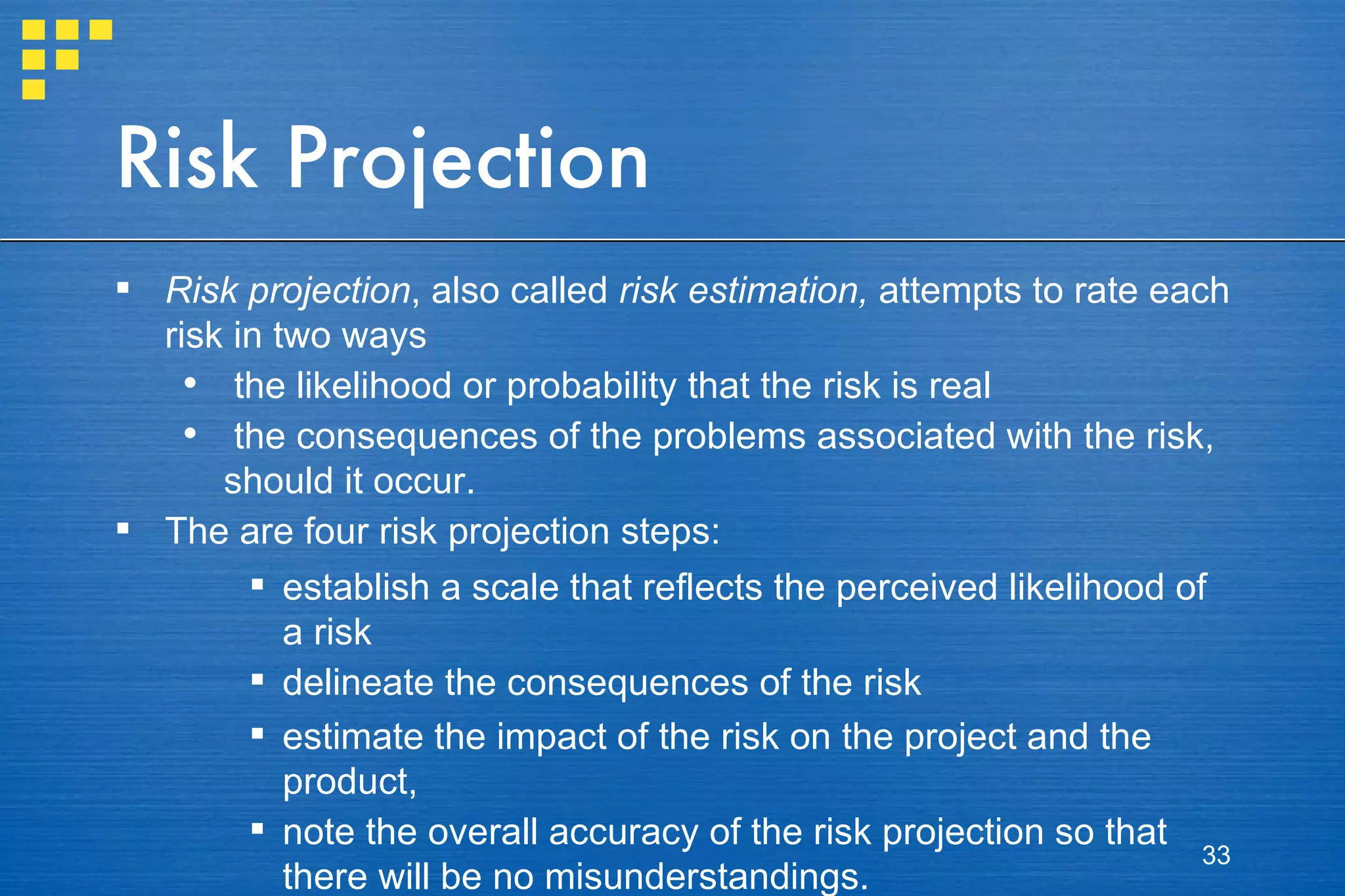

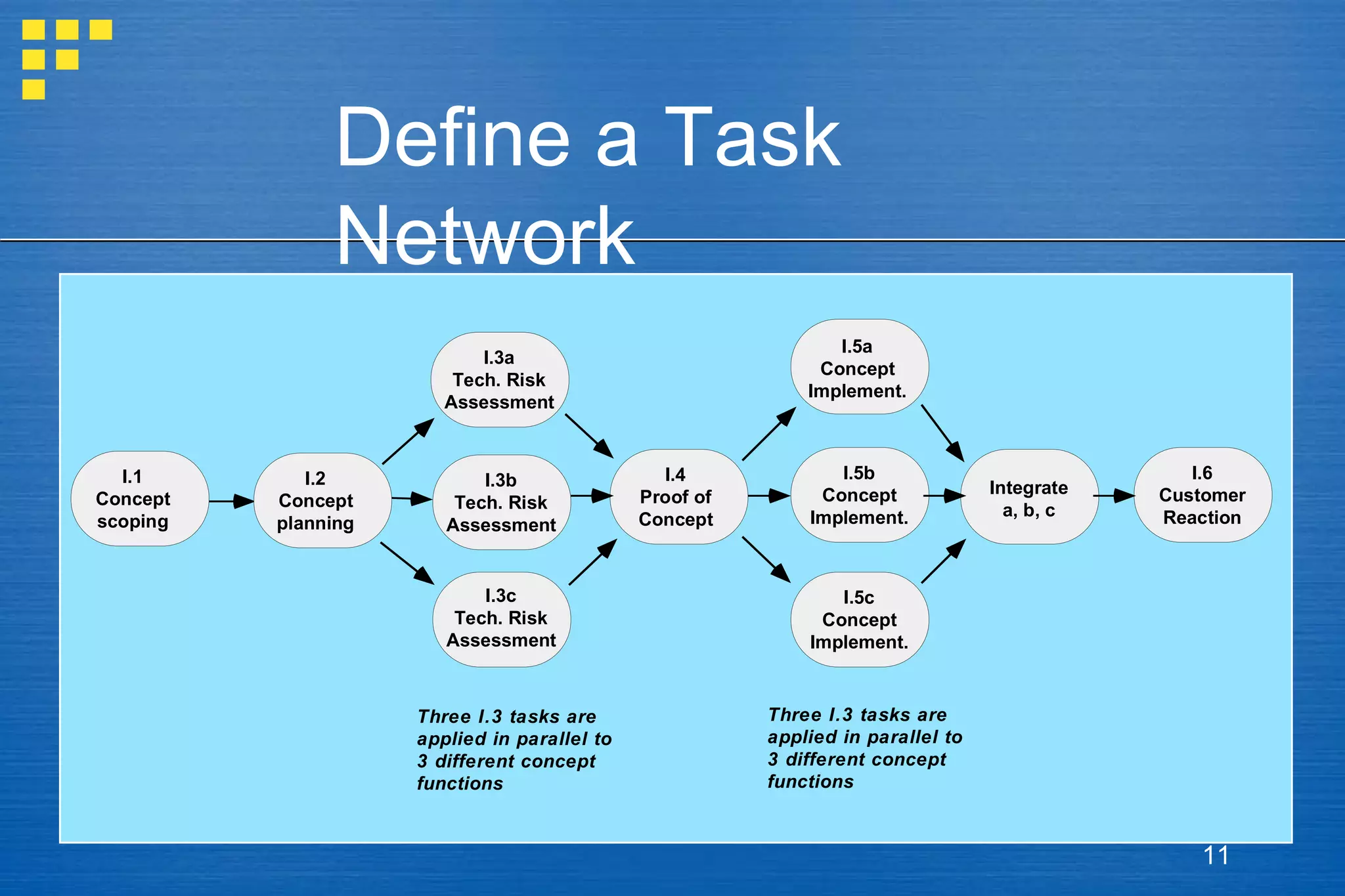

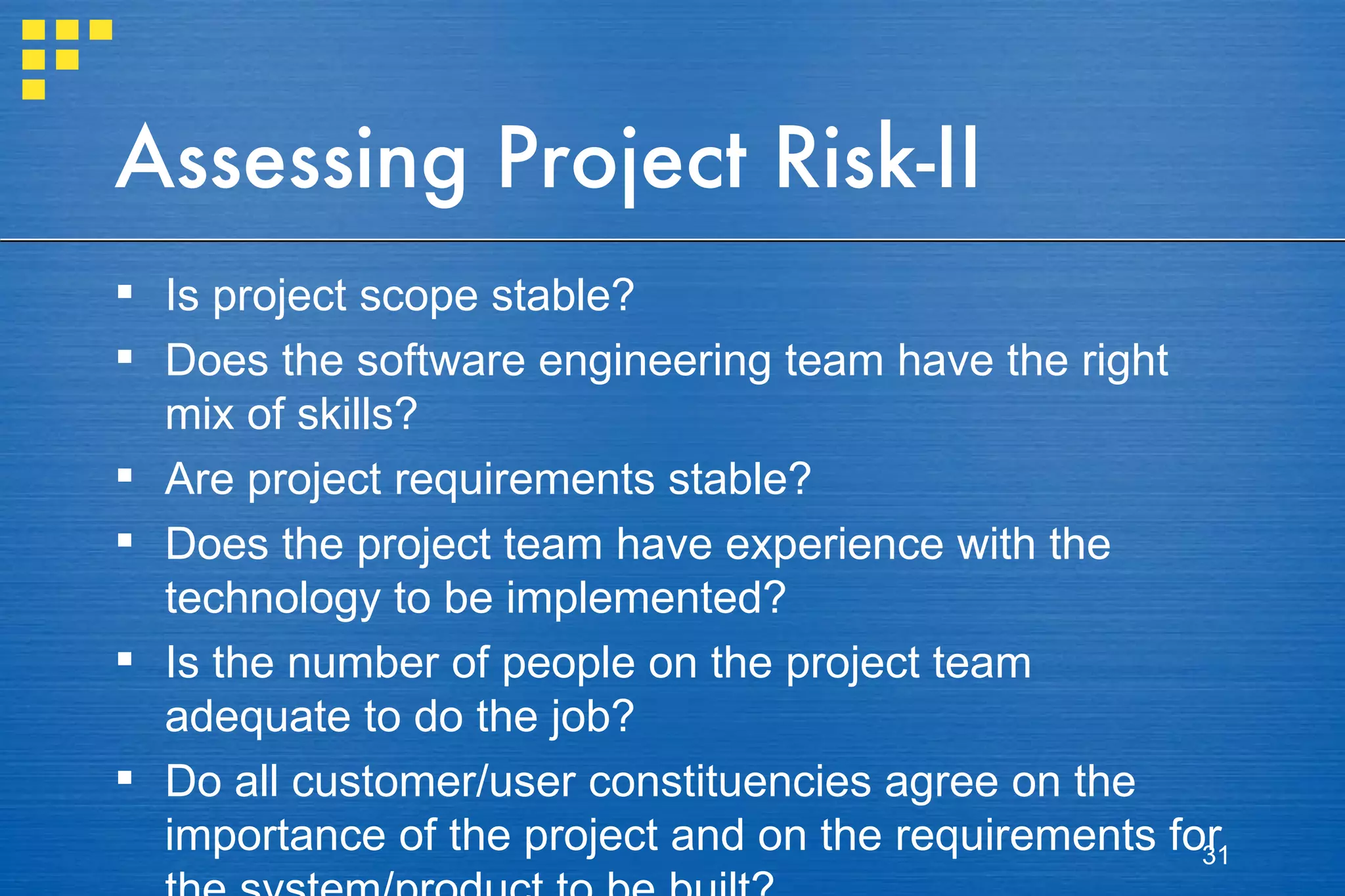

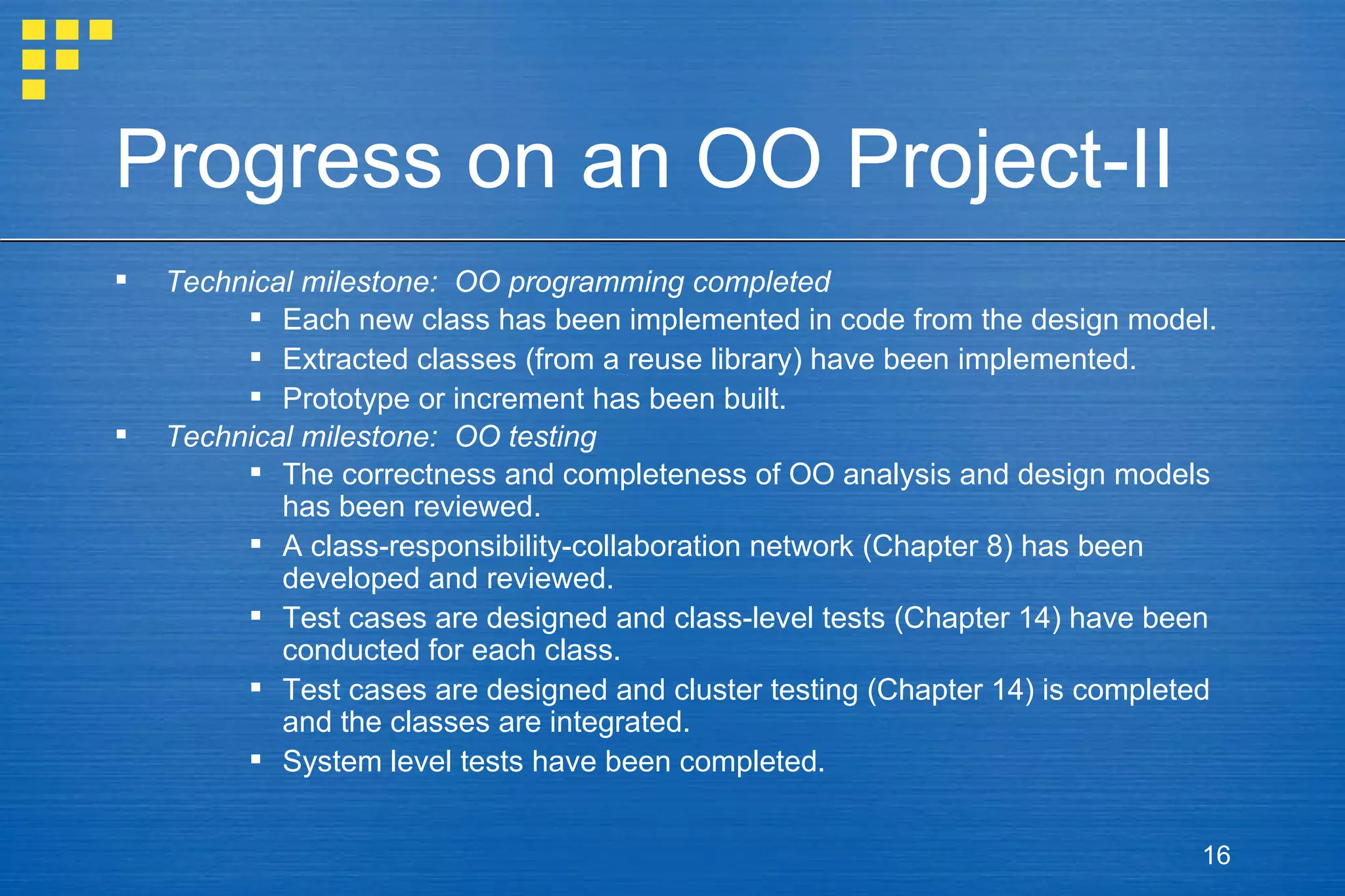

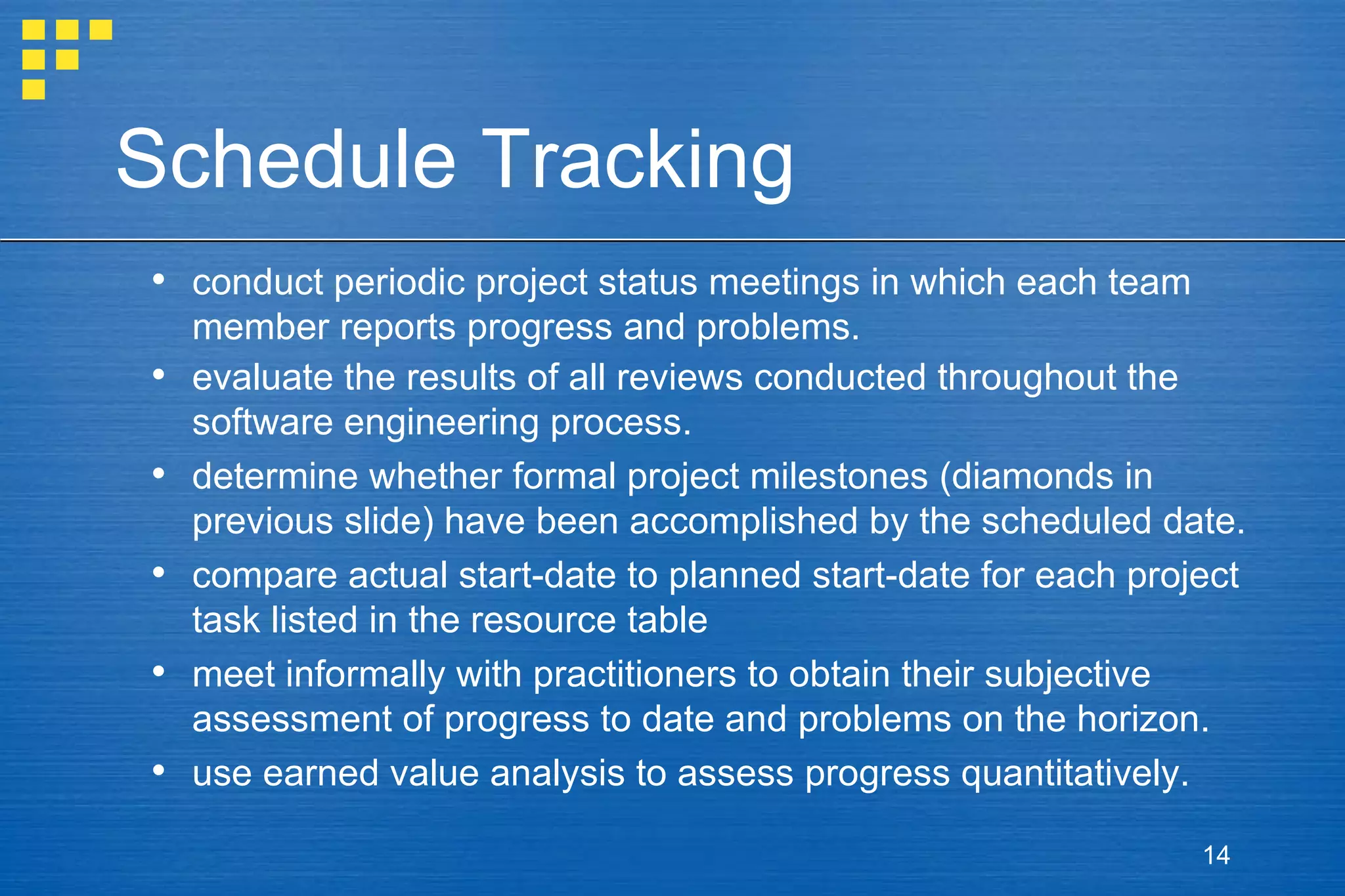

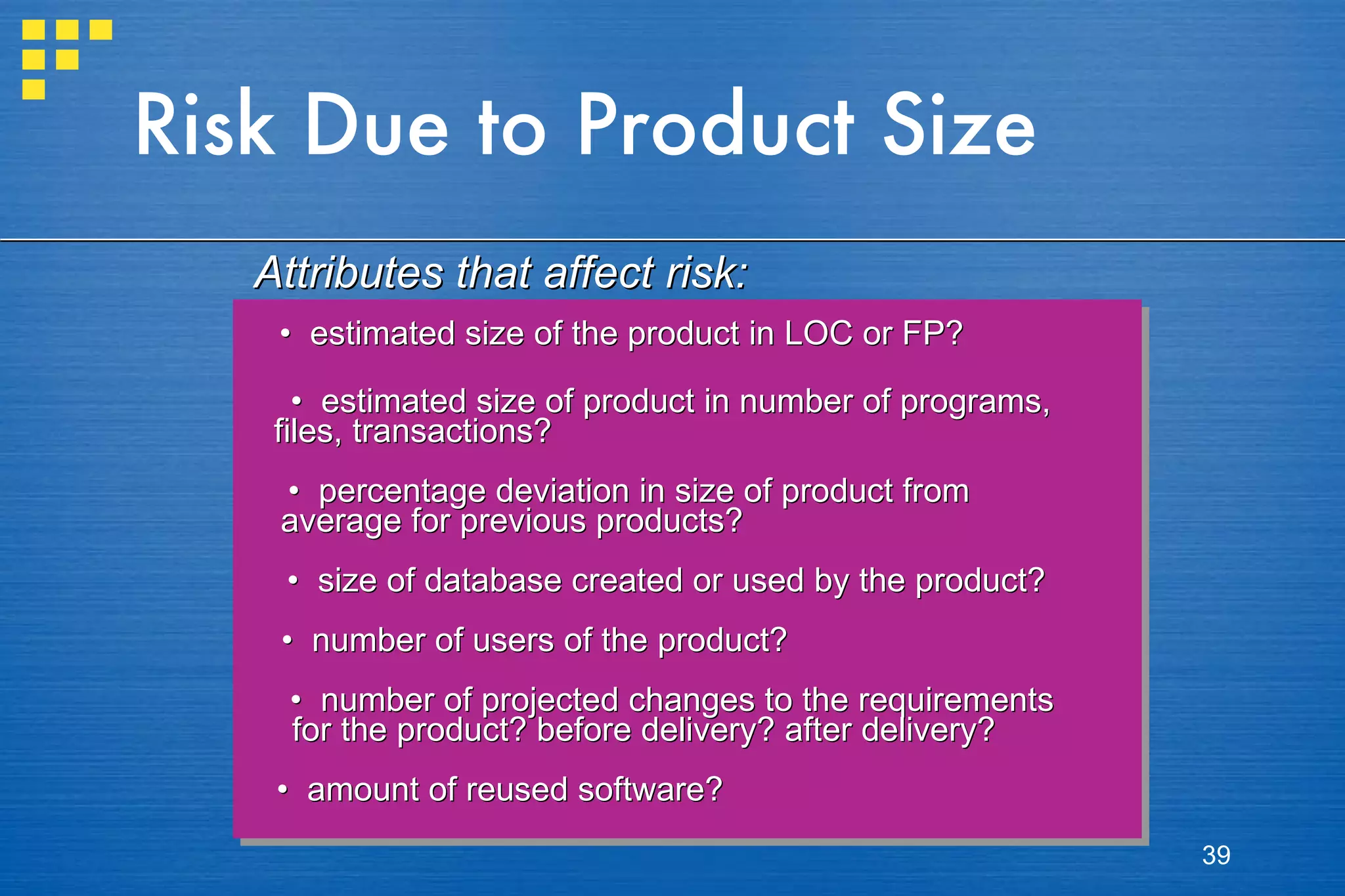

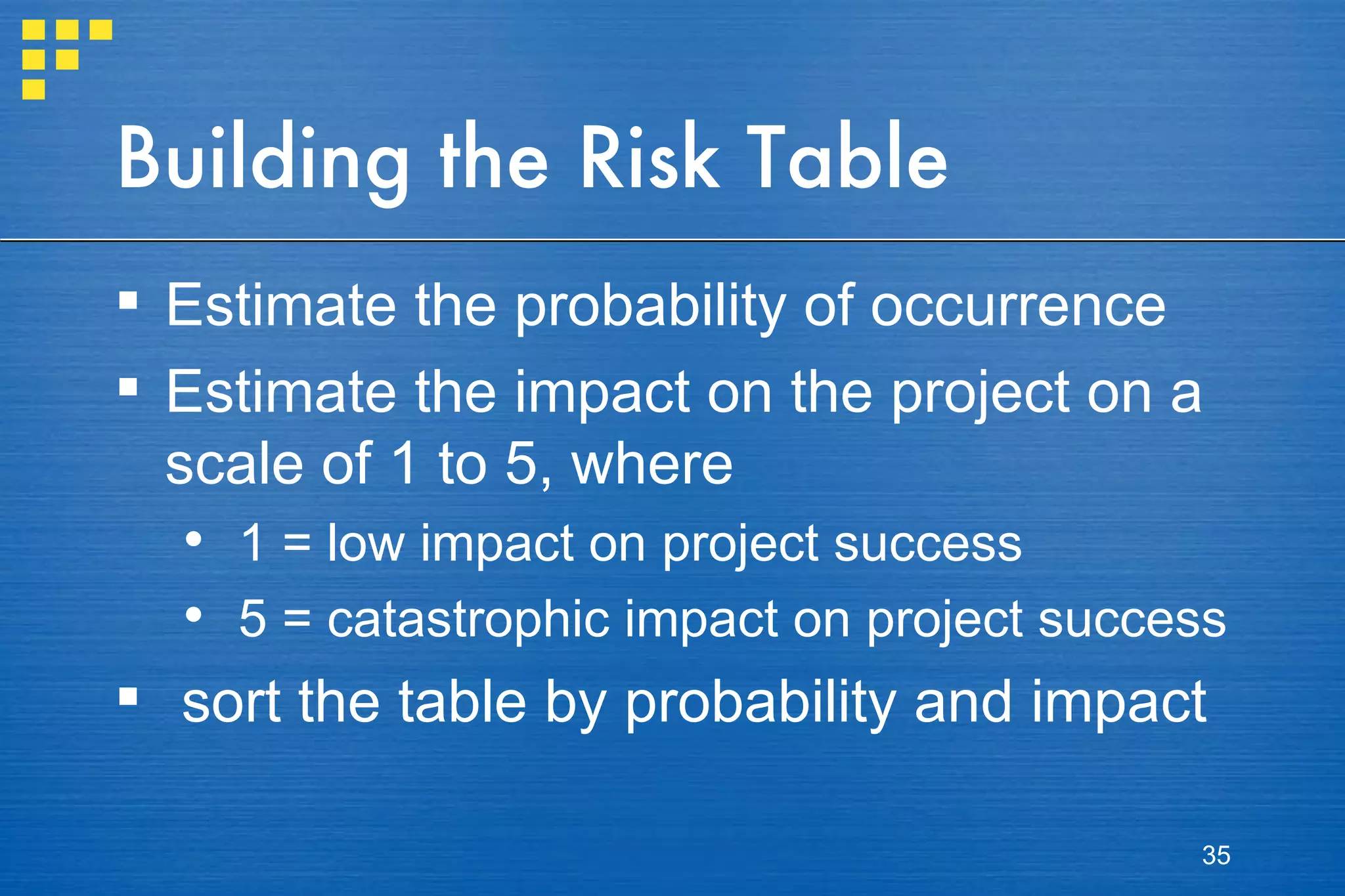

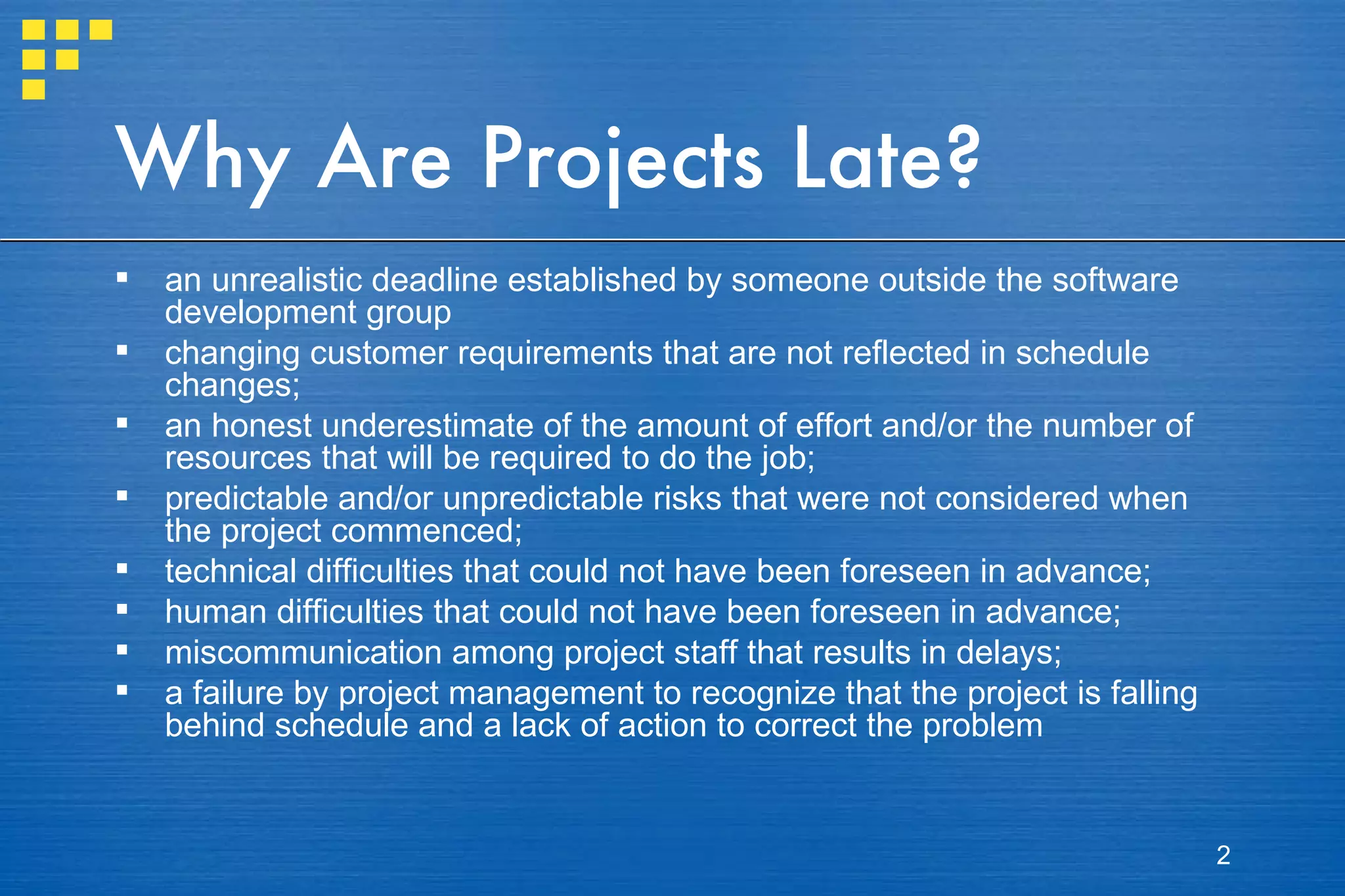

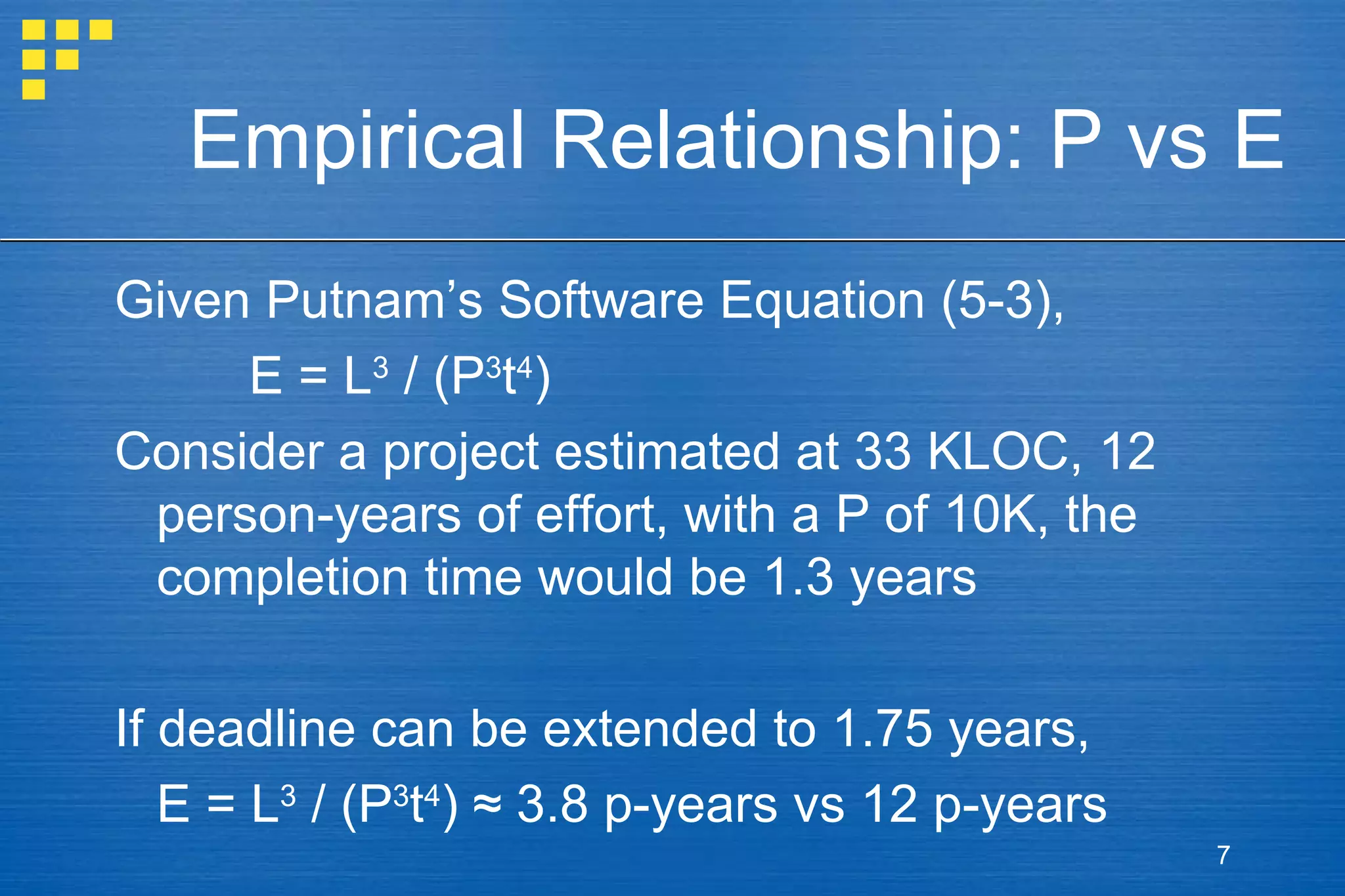

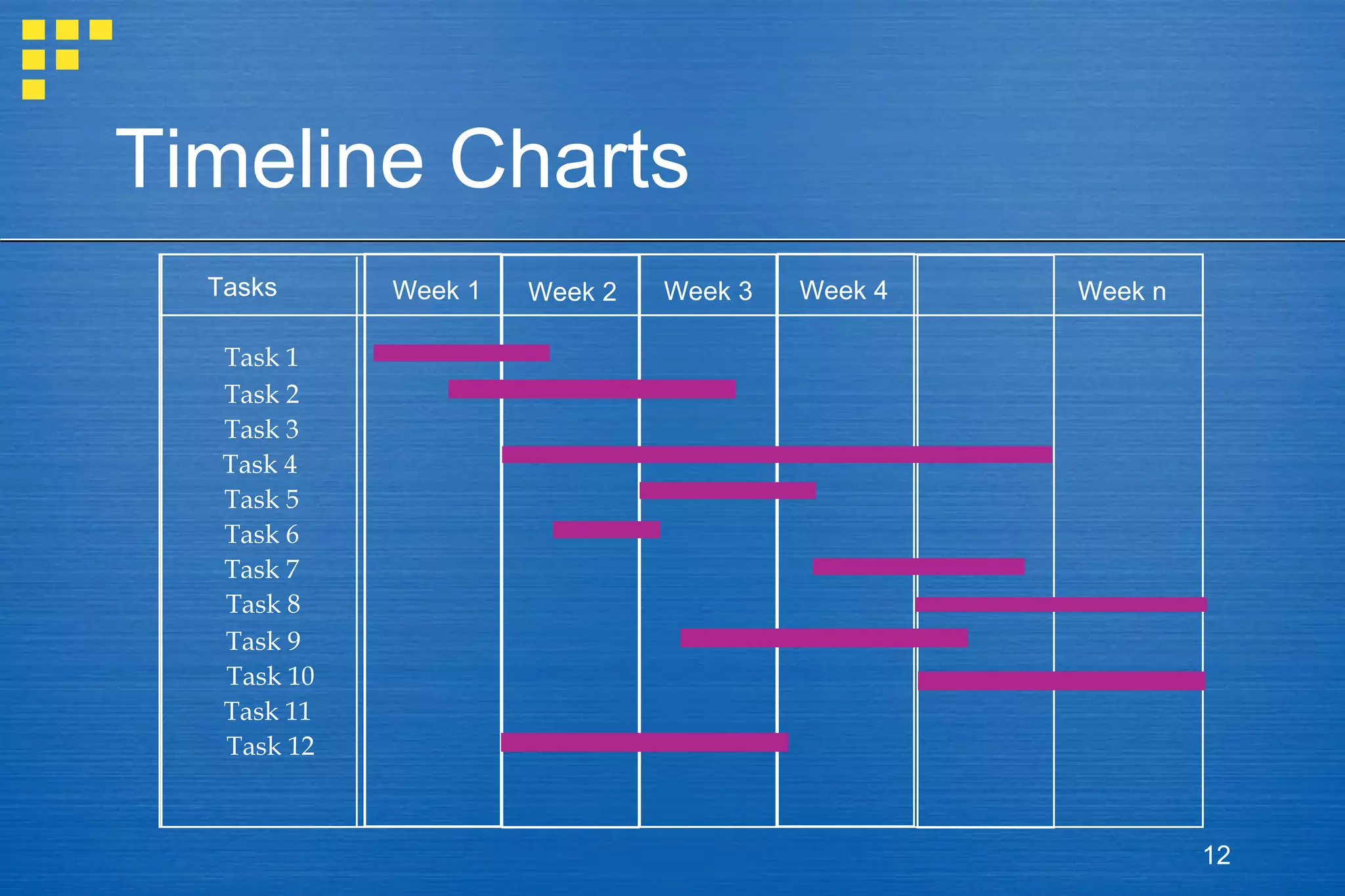

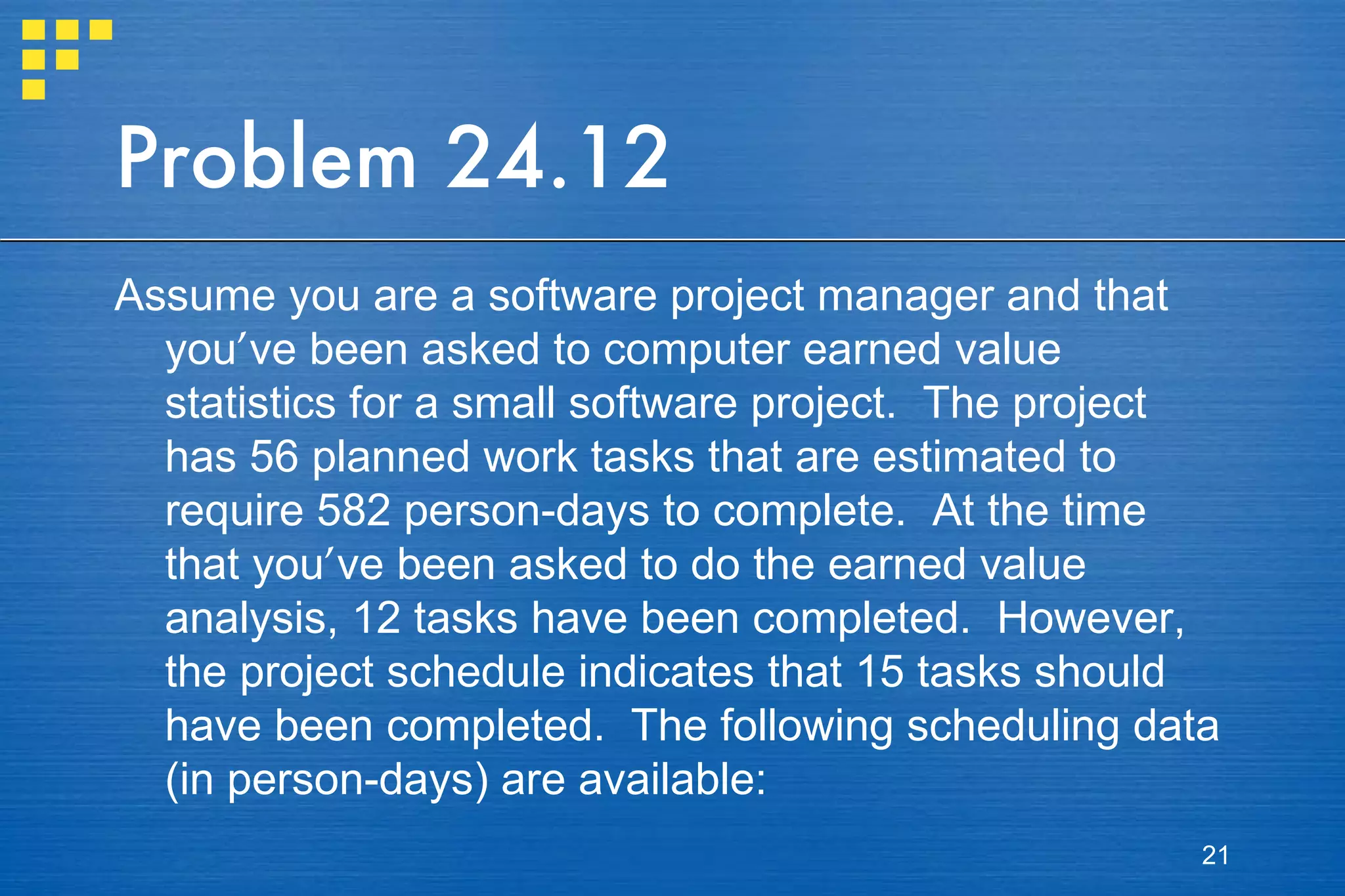

The document discusses project scheduling and tracking in software engineering. It provides reasons why projects may be late, such as unrealistic deadlines or changing requirements. It discusses principles for effective scheduling like compartmentalization of tasks and defining responsibilities. Metrics like earned value analysis are presented to quantitatively track project progress versus what was planned. Risk management techniques like proactive risk analysis are outlined to improve project success.
