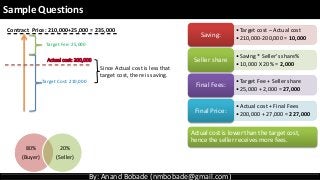

Here are the steps to solve this CPIF contract question:
* Target cost was estimated at AED 210,000
* Target fee was AED 25,000
* Actual cost incurred was AED 200,000
* Since actual cost was lower than target cost, there is a saving to share (210,000 - 200,000 = 10,000)
* Sharing ratio is 80% to buyer and 20% to seller
* Seller's share of savings is 20% of 10,000 = AED 2,000
* Final fee = Target fee + Seller's share of savings = AED 25,000 + AED 2,000 = AED 27,000
* Final price =
