1
Project Procurement Management
Chapter 12
2
 What is a Contract
 Types of Contracts
 12.1 Plan Procurement
 12.2 Conduct Procurements
 12.3 Control Procurements
 12.4 Close Procurements
KEY TERMS
Project Procurement Management
3
12.1 Plan Procurement Management The process of
documenting project procurement decisions, specifying the
approach, and identifying potential sellers
12.2 Conduct Procurements The process of obtaining seller
responses, selecting a seller, and awarding a contract.
12.3 Control Procurements The process of managing
procurement relationships, monitoring contract performance,
and making changes and corrections as appropriate
.
12.4 Close Procurements The process of completing each
project procurement.

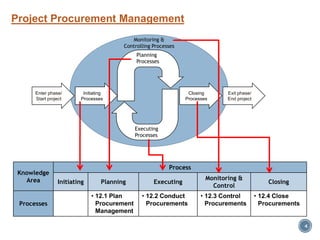

Project Procurement Management
Knowledge
Area
Process
Initiating Planning Executing
Monitoring &
Control
Closing
Processes
• 12.1 Plan
Procurement
Management
• 12.2 Conduct
Procurements
• 12.3 Control
Procurements
• 12.4 Close
Procurements
Enter phase/
Start project
Exit phase/
End project
Initiating
Processes
Closing
Processes
Planning
Processes
Executing
Processes
Monitoring &
Controlling Processes
4
5
What is a Contract
 A Contract is a Legally binding detailed formal
document that refers to an entire agreement
between 2 or more parties.
 All terms & conditions of
a Contract must be met.
 Anything not mentioned in the Contract is not
Legally Binding to anyone.
6
Centralized Contracting
ADVANTAGES DISADVANTAGES
Can result in procurement
managers with higher levels of
expertise.
It may be more difficult for the
project manager to obtain
contracting help when needed.
Employees will have continuous
improvement, training, and shared
lessons learned.
Standardized company practices
help improve understanding.
The procurement manager has
less time to spend working on
your project and understanding
its unique needs.Individuals have a clearly defined
career path in procurement.
There is one procurement department, and a procurement
manager may handle procurements on many projects.
7
Decentralized Contracting
ADVANTAGES DISADVANTAGES
The project manager has easier
access to contracting expertise
because the procurement manager
is a member of the team.
No "home" department for the
procurement manager to return to
after the project is completed.
The procurement manager has
more loyalty to the project.
More difficult to maintain a high
level of contracting expertise.
( no procurement dep.)
The procurement manager has a
better understanding of the project
and its procurement needs.
Little standardized company
practices
There is one procurement department, and a procurement
manager may handle procurements on many projects.
8
Types of Contracts
The three broad categories of contracts are:3
Fixed price
(FP)
Time and material
(T&M)
Or
Unit Price
Cost-reimbursable
(CR)
1. Fixed Price / Lump Sum
/ Firm Fixed Price)
1. Cost Plus Fee ( CPF) /
Cost Plus Percentage of
Costs ( CPPC)
2. Fixed Price Incentive
Fee (FPIF)
2. Cost Plus Fixed Fee
(CPFF)
3. Fixed Price Award Fee
(FPAF)
3. Cost Plus Incentive
Fee (CPIF)
4. Fixed Price with
Economic Price
Adjustment Contracts
(FP-EPA).
4. Cost Plus Award Fee
( CPAF)
9

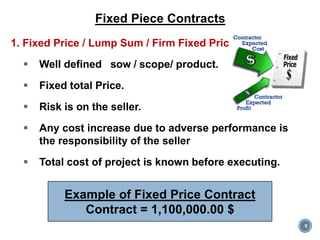

Fixed Piece Contracts
1. Fixed Price / Lump Sum / Firm Fixed Price)
 Well defined sow / scope/ product.
 Fixed total Price.
 Risk is on the seller.
 Any cost increase due to adverse performance is
the responsibility of the seller
 Total cost of project is known before executing.
Example of Fixed Price Contract
Contract = 1,100,000.00 $
10

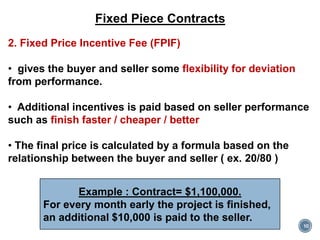

Fixed Piece Contracts
2. Fixed Price Incentive Fee (FPIF)
• gives the buyer and seller some flexibility for deviation
from performance.
• Additional incentives is paid based on seller performance
such as finish faster / cheaper / better
• The final price is calculated by a formula based on the
relationship between the buyer and seller ( ex. 20/80 )
Example : Contract= $1,100,000.
For every month early the project is finished,
an additional $10,000 is paid to the seller.
11
Fixed Piece Contracts

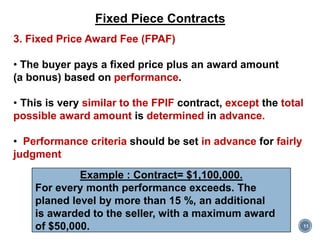

3. Fixed Price Award Fee (FPAF)
• The buyer pays a fixed price plus an award amount
(a bonus) based on performance.
• This is very similar to the FPIF contract, except the total
possible award amount is determined in advance.
• Performance criteria should be set in advance for fairly
judgment
Example : Contract= $1,100,000.
For every month performance exceeds. The
planed level by more than 15 %, an additional
is awarded to the seller, with a maximum award
of $50,000.
12
Fixed Piece Contracts

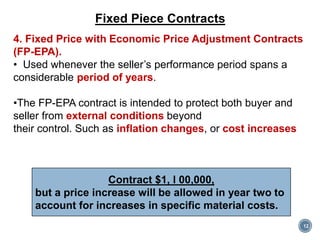

4. Fixed Price with Economic Price Adjustment Contracts
(FP-EPA).
• Used whenever the seller’s performance period spans a
considerable period of years.
•The FP-EPA contract is intended to protect both buyer and
seller from external conditions beyond
their control. Such as inflation changes, or cost increases
Contract $1, l 00,000,
but a price increase will be allowed in year two to
account for increases in specific material costs.
13
Cost-reimbursable (CR)
1. Cost + Fee ( CPF).
Cost Plus Percentage of Costs ( CPPC).
• Involves payments to the seller for all legitimate actual
costs incurred for completed work, plus a percentage of
costs as a fee.
• It is bad for the buyers.
2. Cost Plus Fixed Fee.(CPFF).
14
Cost-reimbursable (CR)
3. Cost Plus Incentive Fee (CPIF).
4. Cost Plus Award Fee ( CPAF).
Cost + additional fee bases on manager satisfaction
(performance criteria)
Contract = $500,000
target cost plus $50,000 target fee. The buyer and
seller share any cost savings or overruns at 80% to
the buyer and 20% to the seller.
15
Cost-reimbursable (CR)
ADVANTAGES DISADVANTAGES
This type allows for a simpler
procurement statement of work.
requires auditing the seller's
invoices.
It usually requires less work to
define the scope for a cost-
reimbursable contract
than for a fixed-price contract.
This contract type requires more
work for the buyer to manage.
A cost-reimbursable contract is
generally less costly than fixed
price because the seller does not
have to add as much for risk.
The seller has only a moderate
incentive to control costs.
The total price is unknown.
16
Time and material (T&M) / Unit Price
• Used for service efforts in which the level of effort
cannot be defined at the time the contract is awarded.
•To make sure the costs do not become higher than
budgeted, the buyer may put a "Not to Exceed" and time
limits clause in the contract.
•Often used for staff augmentation, acquisition of experts,
outside support
Example:
Contract = $1K per day plus expenses or material cost.
Contract = $1K per day plus material at $5 per linear meter of wood.
17
Purchase Order
• A purchase order is the simplest type of fixed-
price contract
• This type of contract is normally unilateral
(signed by one party) instead of bilateral (signed by
both parties.
Cost Contract
• A cost contract is one in which the seller
receives no fee (profit). It is appropriate for
work performed by nonprofit organizations.
18
Fixed Price
FFP
FPIF
Time and Materials
Cost Reimbursable
CPIF
CPFF
CPF
CPPC
SELLER
RISK
BUYER
RISK
Low
High
T&M can be a high
risk for buyer if
contract does not
include a “total not-
to-exceed” (NTE)
Contract Types vs. Risk
Low
High
19

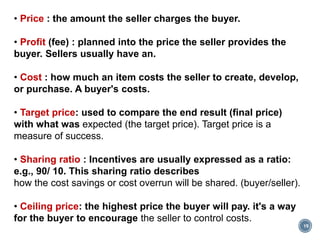

• Price : the amount the seller charges the buyer.
• Profit (fee) : planned into the price the seller provides the
buyer. Sellers usually have an.
• Cost : how much an item costs the seller to create, develop,
or purchase. A buyer's costs.
• Target price: used to compare the end result (final price)
with what was expected (the target price). Target price is a
measure of success.
• Sharing ratio : Incentives are usually expressed as a ratio:
e.g., 90/ 10. This sharing ratio describes
how the cost savings or cost overrun will be shared. (buyer/seller).
• Ceiling price: the highest price the buyer will pay. it's a way
for the buyer to encourage the seller to control costs.
20
PTA - Point of Total Assumption
 Only applies to Fixed Price incentive fee contracts.
 Refers to the amount above which the seller bears all the
loss of a cost overrun
 Costs that go above the PTA are assumed to be due to
management
CP = Ceiling Price TP = Target Price
BSR = Buys Share Ratio TC = Target Cost
CP –TP
BSR
+ TC
21

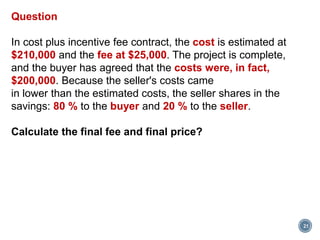

Question
In cost plus incentive fee contract, the cost is estimated at
$210,000 and the fee at $25,000. The project is complete,
and the buyer has agreed that the costs were, in fact,
$200,000. Because the seller's costs came
in lower than the estimated costs, the seller shares in the
savings: 80 % to the buyer and 20 % to the seller.
Calculate the final fee and final price?
22
Target cost $210,000
Target fee $25,000
Target price $235,000
Sharing ratio 80/20
Actual cost $200,000
Final fee
$210,000 - $200,000 = $10,000
$10,000 x 20% = $2,000
$25,000 target fee + $2,000 = $27,000 fee
Final price $200,000 + $27,000 = $227,000
12.1- Plan Procurement
Management
23
24
12.1 Plan Procurement Management
• The process of documenting project procurement
decisions, specifying the approach, and identifying
potential sellers
• Identifies products or services that can be acquired from
outside the project organization Vs needs that can be
accomplished from within the organization.
25
26

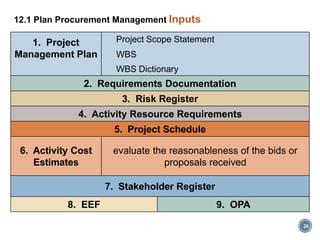

12.1 Plan Procurement Management Inputs
1. Project
Management Plan
Project Scope Statement
WBS
WBS Dictionary
2. Requirements Documentation
3. Risk Register
4. Activity Resource Requirements
5. Project Schedule
6. Activity Cost
Estimates
evaluate the reasonableness of the bids or
proposals received
7. Stakeholder Register
8. EEF 9. OPA
27
12.1 Plan Procurement Management T & T
1. Make or Buy Analysis:
• Purchase or make - Purchase or renting/leasing.
• Determine whether a product or service needs to
be procured or can be produced by the project team.
Reasons to Buy:
Capacity and Capability
Exploit Opportunity
Shift risk (cost, time, or scope)
Reasons to Make:
Idle resources
Want to control
Confidential information
28
Question

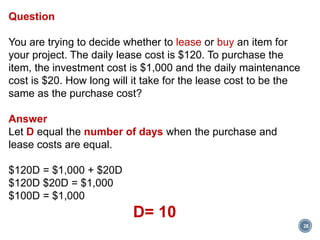

You are trying to decide whether to lease or buy an item for
your project. The daily lease cost is $120. To purchase the
item, the investment cost is $1,000 and the daily maintenance
cost is $20. How long will it take for the lease cost to be the
same as the purchase cost?
Answer
Let D equal the number of days when the purchase and
lease costs are equal.
$120D = $1,000 + $20D
$120D $20D = $1,000
$100D = $1,000
D= 10
29

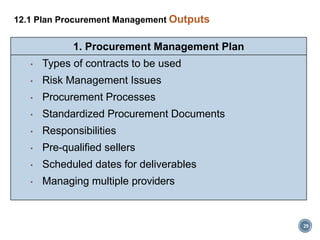

12.1 Plan Procurement Management Outputs
1. Procurement Management Plan
• Types of contracts to be used
• Risk Management Issues
• Procurement Processes
• Standardized Procurement Documents
• Responsibilities
• Pre-qualified sellers
• Scheduled dates for deliverables
• Managing multiple providers
30
12.1 Plan Procurement Management Outputs
2. Procurement Statement of Work
• Specifications, quality levels, quantity desired and other
requirements.
• Describes the procurement item in sufficient detail to
allow sellers to determine if they are capable of
providing the item.
3. Make or Buy Decision
4. Change Requests
5. Project Document Updates
31
12.1 Plan Procurement Management Outputs
6. Procurement Documents
• Are used to solicit proposals, quotes, and bids from sellers
• Request for Information ( RFI )
• Request for Proposal (Tender) RFP. request a detailed
proposal on how the work will be accomplished, who will do
it, resumes, company experience.
• Invitation for bid (IFB, or request for bid, RFB) IFBs usually
just request a total price to do all the work.
• Request for Quotation RFQ : price quote per item, hour, or
foot (T&M contracts).
32
12.1 Plan Procurement Management Outputs
7. Source Selection Criteria
• The project team must be prepared to compare the proposals
received in an unbiased manner based on identified & documented
selection criteria to rate or score proposals.
Includes but not limited to:
 Past performance
 Understanding of need
 Overall or life cycle cost
 References
 Technical capability and approach
 Risk
 Management approach
 Financial stability and capacity
33
Types of Procurement Statements of Work
Performance Functional Design
This type conveys what
the final product
should be able to
accomplish.
This type conveys the
end purpose or result
This type precisely
conveys what work is
to be done.
Used in Information
systems, information
technology, research
and development
Used in Information
systems, information
technology, research
and development
Commonly used in
construction and
equipment purchasing
(Ex. I want a car goes
from 0 to 100 km in 4
seconds )
(Ex. I want a car with 2
cup holders and a
small TV screen)
12.2- Conduct Procurement
34
35
12.2 Conduct Procurement.
 Obtaining seller responses, selecting a seller,
and awarding a contract.
 The key benefit is to provide alignment of internal and
external stakeholder expectations through established
agreements.
36
37
12.2 Conduct Procurement Inputs
1. Procurement Management Plan
2. Procurement Documents
3. Source Selection Criteria
4. Seller Proposals
5. Project Documents
6. Make or Buy Decisions
7. Procurement Statement of Work
8. OPA
38
12.2 Conduct Procurement T & T
1. Bidder Conferences
 Also known as contractor, vendor, or pre-bid
conferences.
 The purpose of these conferences is to clarify any of
the information not clearly stated in the RFP.
 Creates a clear and common understanding of the
procurement.
 Proposals received will be more clearly aligned with
project requirements, due to the fact that bidder
conferences make the requirements clear.
39
12.2 Conduct Procurement T & T
2. Proposal Evaluation Techniques
3. Independent Estimates
4. Expert Judgment
5. Advertising
6. Analytical Techniques
7. Procurement Negotiations
40
• Attacks "If your organization cannot manage the details of its own
operations, perhaps it should get out of the business!“
• Personal insults "If you do not understand what you are doing,
perhaps you should find another job!“
• Good guy/bad guy One person is helpful to the other side, while
another is difficult to deal with.
• Deadline "We have a flight leaving at 5 p.m. today and must finish
negotiations before that time.
• Lying lying may be obvious or hidden.
• Limited authority "I can't agree to shorten the schedule by six months.
I have only been authorized to offer three months.
Negotiation tactics
41
• Missing man "Only my boss can agree to that request, and he isn't
here. Why don't we agree to only what I can agree to.
• Fair and reasonable "Let's be fair and reasonable. Accept this offer as
it stands.
• Delay "Let's revisit this issue the next time we get together." This may
also take the form of never actually getting down to negotiating until the
last day of a planned visit.
• Extreme demands "As the buyer you will have to pay for all of the
risks for this work. It is not our responsibility to plan for risks!“
• Withdrawal This can either be an emotional withdrawal or a physical
withdrawal and can show less interest.
• Fait accompli This is a done deal. "These government terms and
conditions must be in all our contracts.
42
12.2 Conduct Procurement Outputs
1. Selected Sellers
2. Agreements
3. Resource Calendars
4. Change Requests
5. Project Management Plan Updates
6. Project Document Updates
(SOW and Requirements Documentation)
43
Agreements include:
• SOW
• Acceptance How will you specifically know if the work is acceptable?
• Changes How will changes be made
• Confidentiality What information must not be made known or given to
third parties?
• Material breach This breach is so large that it may not be possible to
complete the work under the contract.
• Dispute resolution.
• Force majeure
• Incentives.
• Liability.
• Independent contractor.
• Intellectual property.
• Liquidated damages.
• Payments method.
• Retention
• Warranties
44
What Do You Need to Have a Legal
Contract?
• An offer
• Acceptance
• Consideration (Something of value, not necessarily
money)
• Legal capacity (Separate legal parties, competent parties)
• Legal purpose (You cannot have a legal, enforceable
contract for the sale of illegal goods or services)
45
• Single Source
In this type of procurement, you contract directly with
your preferred seller without going through the full
procurement process.
• Sole Source
In this type of procurement, there is only one seller.
This might be a company that owns a patent.
12.3- Control Procurement
46
47
12.3 Control Procurement.
The process of managing procurement relationships, monitoring
contract performance, and making changes and corrections as
appropriate
48
49
12.3 Control Procurement Inputs
1. Project Management Plan
2. Procurement Documents
3. Agreements
4. Work Performance Reports
5. Approved Change Request.
6. Work Performance Information
50
12.3 Control Procurement T & T
1. Contract Change Control System
2. Procurement Performance Review
3. Inspections and Audits
4. Performance Reporting
5. Payment Systems.
6. Claims Administration: (disputes)
7. Record Management System
51
12.3 Control Procurement Outputs
1. Work Performance Information
2. Change Requests
3. Project Management Plan Updates
4. Project Documents Updates
5. OPA.
12.4- Close Procurement
52
53
12.4 Close Procurement.
• The process of completing each project procurement.
• Accept deliverables.
• Procurements are closed:
When a contract is completed.
When a contract is terminated before the work is completed
54
55
what work must be done during procurement closure
• Product validation
• Procurement negotiation
• Financial closure
• Procurement audit
• Update to records
• Final contract performance reporting
• Lessons learned
Administrative closure
• Check completion or exit criteria for project or phase.
• Transfer the product to next phase.
• Collect records.
56
Organizational Process Assets Updates
• Procurement file. A complete set of indexed contract
documentation, including the closed contract
• Deliverable acceptance. Documentation of formal
acceptance of seller-provided deliverables may be
required to be retained by the organization.
• Lessons learned documentation.
• Close Procurements occurs before Close Project or
Phase . Close Procurements is done once for each
procurement, at the end of the contract.
• All procurements are closed before the project is
closed.
57
Questions
1. Once signed, a contract is legally binding unless:
A. One party is unable to perform.
B. One party is unable to finance its part of the work.
C. It is in violation of applicable law.
D. It is declared null and void by either party's legal counsel.
58
Questions
1. Once signed, a contract is legally binding unless:
A. One party is unable to perform.
B. One party is unable to finance its part of the work.
C. It is in violation of applicable law.
D. It is declared null and void by either party's legal counsel.
Answer : C
59
Questions
2. With a clear procurement statement of work, a seller
completes work as specified, but the buyer is not pleased
with the results. The contract is considered to be:
A. Null and void.
B. Incomplete.
C. Complete.
D. Waived.
60
Questions
2. With a clear procurement statement of work, a seller
completes work as specified, but the buyer is not pleased
with the results. The contract is considered to be:
A. Null and void.
B. Incomplete.
C. Complete.
D. Waived.
Answer : C
61
Questions
3. A project manager for the seller is told by her
management that the project should do whatever possible to
be awarded incentive money. The primary objective of
incentive clauses in a contract is to:
A. Reduce costs for the buyer.
B. Help the seller control costs.
C. Synchronize objectives.
D. Reduce risk for the seller by shifting risk to the buyer.
62
Questions
3. A project manager for the seller is told by her
management that the project should do whatever possible to
be awarded incentive money. The primary objective of
incentive clauses in a contract is to:
A. Reduce costs for the buyer.
B. Help the seller control costs.
C. Synchronize objectives.
D. Reduce risk for the seller by shifting risk to the buyer.
Answer : C
63
Questions
4. A seller is working on a cost-reimbursable (CR) contract
when the buyer decides he would like to expand the scope of
services and change to a fixed-price (FP) contract. All of the
following are the seller's options EXCEPT:
A. Completing the original work on a cost-reimbursable basis and
then negotiating a fixed price for the additional work.
B. Completing the original work and rejecting the additional work.
C. Negotiating a fixed-price contract that includes the work.
D. Starting over with a new contract.
64
Questions
4. A seller is working on a cost-reimbursable (CR) contract
when the buyer decides he would like to expand the scope of
services and change to a fixed-price (FP) contract. All of the
following are the seller's options EXCEPT:
A. Completing the original work on a cost-reimbursable basis and
then negotiating a fixed price for the additional work.
B. Completing the original work and rejecting the additional work.
C. Negotiating a fixed-price contract that includes the work.
D. Starting over with a new contract.
Answer : D
65
Questions
5. 1he sponsor is worried about the seller deriving extra
profit on the cost plus fixed fee (CPFF) contract. Each month
he requires the project manager to submit CPI calculations
and an analysis of the cost to complete. The project manager
explains to the sponsor that extra profits should NOT
be a worry on this project because:
A. The team is making sure the seller does not cut scope.
B. All costs invoiced are being audited.
C. There can only be a maximum 10 percent increase if there is an
unexpected cost overrun.
D. The fee is only received by the seller when the project is
completed.
66
Questions
5. 1he sponsor is worried about the seller deriving extra
profit on the cost plus fixed fee (CPFF) contract. Each month
he requires the project manager to submit CPI calculations
and an analysis of the cost to complete. The project manager
explains to the sponsor that extra profits should NOT
be a worry on this project because:
A. The team is making sure the seller does not cut scope.
B. All costs invoiced are being audited.
C. There can only be a maximum 10 percent increase if there is an
unexpected cost overrun.
D. The fee is only received by the seller when the project is
completed.
Answer : B
67
Questions
6. In a fixed-price (FP) contract, the fee or profit is:
A. Unknown.
B. Part of the negotiation involved in paying every invoice.
C. Applied as a line item to every invoice.
D. Determined with the other party at the end of the
project.
68
Questions
6. In a fixed-price (FP) contract, the fee or profit is:
A. Unknown.
B. Part of the negotiation involved in paying every invoice.
C. Applied as a line item to every invoice.
D. Determined with the other party at the end of the
project.
Answer : A
69
Questions
7. A project performed under a cost-reimbursable contract
has finally entered the Close Procurements process. What
MUST the buyer remember to do?
A. Decrease the risk rating of the project.
B. Audit seller's cost submittals.
C. Evaluate the fee she is paying.
D. Make sure the seller is not adding resources.
70
Questions
7. A project performed under a cost-reimbursable contract
has finally entered the Close Procurements process. What
MUST the buyer remember to do?
A. Decrease the risk rating of the project.
B. Audit seller's cost submittals.
C. Evaluate the fee she is paying.
D. Make sure the seller is not adding resources.
Answer : B
71
Questions
8. The sponsor and the project manager are discussing what
type of contract the project manager plans to use on the
project. The sponsor points out that the performing
organization spent a lot of money hiring a design team to
come up with the design. The project manager is concerned
that the risk for the buyer be as small as possible. An
advantage of a fixed-price contract for the buyer is:
A. Cost risk is lower.
B. Cost risk is higher.
C. There is little risk.
D. Risk is shared by all parties.
72
Questions
8. The sponsor and the project manager are discussing what
type of contract the project manager plans to use on the
project. The sponsor points out that the performing
organization spent a lot of money hiring a design team to
come up with the design. The project manager is concerned
that the risk for the buyer be as small as possible. An
advantage of a fixed-price contract for the buyer is:
A. Cost risk is lower.
B. Cost risk is higher.
C. There is little risk.
D. Risk is shared by all parties.
Answer : A
73
Questions
9. Your company has an emergency and needs contracted
work done as soon as possible. Under these circumstances,
which of the following would be the MOST helpful to add to
the contract?
A. A clear procurement statement of work.
B. Requirements as to which subcontractors can be used.
C. Incentives.
D. A force majeure clause.
74
Questions
9. Your company has an emergency and needs contracted
work done as soon as possible. Under these circumstances,
which of the following would be the MOST helpful to add to
the contract?
A. A clear procurement statement of work.
B. Requirements as to which subcontractors can be used.
C. Incentives.
D. A force majeure clause.
Answer : C
75
Questions
10. During which procurement processes does procurement
negotiation occur?
A. Plan Procurement Management and Close Procurements
B. Control Procurements and Close Procurements
C. Conduct Procurements and Control Procurements
D. Conduct Procurements and Close Procurements
76
Questions
10. During which procurement processes does procurement
negotiation occur?
A. Plan Procurement Management and Close Procurements
B. Control Procurements and Close Procurements
C. Conduct Procurements and Control Procurements
D. Conduct Procurements and Close Procurements
Answer : D
77
Questions
11. Your program manager has come to you, the project
manager, for help with a bid for her newest project. You
want to protect your company from financial risk, and you
have limited scope definition. What is the BEST type of
contract to choose?
A. Fixed price (FP)
B. Cost plus percentage of cost ( CPPC)
C. Time and material (T &M)
D. Cost plus fixed fee ( CPFF)
78
Questions
11. Your program manager has come to you, the project
manager, for help with a bid for her newest project. You
want to protect your company from financial risk, and you
have limited scope definition. What is the BEST type of
contract to choose?
A. Fixed price (FP)
B. Cost plus percentage of cost ( CPPC)
C. Time and material (T &M)
D. Cost plus fixed fee ( CPFF)
Answer : D
79
Questions
12. Close Procurements is different from Close Project or
Phase in that Close Procurements:
A. Occurs before Close Project or Phase.
B. Is the only one to involve the customer.
C. Includes the return of property.
D. May be done more than once for each contract.
80
Questions
12. Close Procurements is different from Close Project or
Phase in that Close Procurements:
A. Occurs before Close Project or Phase.
B. Is the only one to involve the customer.
C. Includes the return of property.
D. May be done more than once for each contract.
Answer : A
81
Questions
13. You have just started work on a procurement when
management decides to terminate the contract. What should
you do FIRST?
A. Go back to the Plan Procurement Management process.
B. Go back to the Conduct Procurements process.
C. Finish the Control Procurements process.
D. Go to the Close Procurements process.
82
Questions
13. You have just started work on a procurement when
management decides to terminate the contract. What should
you do FIRST?
A. Go back to the Plan Procurement Management process.
B. Go back to the Conduct Procurements process.
C. Finish the Control Procurements process.
D. Go to the Close Procurements process.
Answer : D
83
Questions
14. What type of contract do you NOT want to use if you do
not have enough labor to audit invoices?
A. Cost plus fixed fee ( CPFF)
B. Time & material (T &M)
C. Fixed price (FP)
D. Fixed price incentive fee (FPIF)
84
Questions
14. What type of contract do you NOT want to use if you do
not have enough labor to audit invoices?
A. Cost plus fixed fee ( CPFF)
B. Time & material (T &M)
C. Fixed price (FP)
D. Fixed price incentive fee (FPIF)
Answer : A
85
Questions
15. Which of the following is an advantage of centralized
contracting?
A. Increased expertise
B. Easier access
C. No home for the procurement manager
D. More loyalty to the project
86
Questions
15. Which of the following is an advantage of centralized
contracting?
A. Increased expertise
B. Easier access
C. No home for the procurement manager
D. More loyalty to the project
Answer : A

More Related Content

What's hot

Pp 1-report-complete
Pp 1-report-completePp 1-report-complete
Pp 1-report-completeYong Sy

Lecture 1 introduction to construction procurement process.
Lecture 1   introduction to construction procurement process.Lecture 1   introduction to construction procurement process.
Lecture 1 introduction to construction procurement process.Aszahari Aie

Effective Contract Management
Effective Contract ManagementEffective Contract Management
Effective Contract ManagementDr Gordon Murray

Lecture 1 Introduction to Procurement and contract Management Management - Co...
Lecture 1 Introduction to Procurement and contract Management Management - Co...Lecture 1 Introduction to Procurement and contract Management Management - Co...
Lecture 1 Introduction to Procurement and contract Management Management - Co...axmedbaasaay

Project management procurement
Project management  procurementProject management  procurement
Project management procurementMalcolm Peart

Project Risk Management - PMBOK5
Project Risk Management - PMBOK5Project Risk Management - PMBOK5
Project Risk Management - PMBOK5pankajsh10

Contract Administration Presentation
Contract Administration PresentationContract Administration Presentation
Contract Administration PresentationYanet Ormeno

Construction Contracts: Basics of Contracts and Contract Administration
Construction Contracts:  Basics of Contracts and Contract AdministrationConstruction Contracts:  Basics of Contracts and Contract Administration
Construction Contracts: Basics of Contracts and Contract AdministrationGerald R. (Jerry) Genge

Procurement contract management
Procurement contract managementProcurement contract management
Procurement contract managementAavenir

contract administration PPT
 contract administration PPT contract administration PPT
contract administration PPTKEVINMISTRY8

12.0 Project Procurement Management Overview
12.0 Project Procurement Management Overview12.0 Project Procurement Management Overview
12.0 Project Procurement Management OverviewDavidMcLachlan1

Project communication management
Project communication  managementProject communication  management
Project communication managementyouness jabbar

PMP Chap9 - Project Human Resource management
PMP Chap9 - Project Human Resource managementPMP Chap9 - Project Human Resource management
PMP Chap9 - Project Human Resource managementAnand Bobade

Chapter_2-Procurement and Contract management.pptx
Chapter_2-Procurement and Contract management.pptxChapter_2-Procurement and Contract management.pptx
Chapter_2-Procurement and Contract management.pptxssuserc0bf9b

4.4 Manage Project Knowledge
4.4 Manage Project Knowledge4.4 Manage Project Knowledge
4.4 Manage Project KnowledgeDavidMcLachlan1

An introduction to taking off building quantities
An introduction to taking off building quantities An introduction to taking off building quantities
An introduction to taking off building quantities Arshad Mohanut


What's hot (20)

Pp 1-report-complete
Pp 1-report-completePp 1-report-complete
Pp 1-report-complete

9. project procurement management
9. project procurement management9. project procurement management
9. project procurement management

Lecture 1 introduction to construction procurement process.
Lecture 1   introduction to construction procurement process.Lecture 1   introduction to construction procurement process.
Lecture 1 introduction to construction procurement process.

Effective Contract Management
Effective Contract ManagementEffective Contract Management
Effective Contract Management

Lecture 1 Introduction to Procurement and contract Management Management - Co...
Lecture 1 Introduction to Procurement and contract Management Management - Co...Lecture 1 Introduction to Procurement and contract Management Management - Co...
Lecture 1 Introduction to Procurement and contract Management Management - Co...

Project management procurement
Project management  procurementProject management  procurement
Project management procurement

Project Risk Management - PMBOK5
Project Risk Management - PMBOK5Project Risk Management - PMBOK5
Project Risk Management - PMBOK5

Contract management sys
Contract management sysContract management sys
Contract management sys

Contract Administration Presentation
Contract Administration PresentationContract Administration Presentation
Contract Administration Presentation

Construction Contracts: Basics of Contracts and Contract Administration
Construction Contracts:  Basics of Contracts and Contract AdministrationConstruction Contracts:  Basics of Contracts and Contract Administration
Construction Contracts: Basics of Contracts and Contract Administration

PMP / Framework 1 2-3
PMP / Framework 1 2-3PMP / Framework 1 2-3
PMP / Framework 1 2-3

Procurement contract management
Procurement contract managementProcurement contract management
Procurement contract management

contract administration PPT
 contract administration PPT contract administration PPT
contract administration PPT

12.0 Project Procurement Management Overview
12.0 Project Procurement Management Overview12.0 Project Procurement Management Overview
12.0 Project Procurement Management Overview

Project communication management
Project communication  managementProject communication  management
Project communication management

PMP Chap9 - Project Human Resource management
PMP Chap9 - Project Human Resource managementPMP Chap9 - Project Human Resource management
PMP Chap9 - Project Human Resource management

Chapter_2-Procurement and Contract management.pptx
Chapter_2-Procurement and Contract management.pptxChapter_2-Procurement and Contract management.pptx
Chapter_2-Procurement and Contract management.pptx

4.4 Manage Project Knowledge
4.4 Manage Project Knowledge4.4 Manage Project Knowledge
4.4 Manage Project Knowledge

An introduction to taking off building quantities
An introduction to taking off building quantities An introduction to taking off building quantities
An introduction to taking off building quantities

Project Procurement Management
Project Procurement ManagementProject Procurement Management
Project Procurement Management


Viewers also liked

Pmbok 4th edition chapter 12 - Project Procurement Management
Pmbok 4th edition   chapter 12 - Project Procurement ManagementPmbok 4th edition   chapter 12 - Project Procurement Management
Pmbok 4th edition chapter 12 - Project Procurement ManagementAhmad Maharma, PMP,RMP

Project Procurement Management PMBOK 5
Project Procurement Management PMBOK 5Project Procurement Management PMBOK 5
Project Procurement Management PMBOK 5pankajsh10

Project Management-Project procurement Management
Project Management-Project procurement ManagementProject Management-Project procurement Management
Project Management-Project procurement ManagementYogender Singh Rana

Procurement Contract Types | PMP | iZenBridge - Webinar
Procurement Contract Types | PMP | iZenBridge - Webinar Procurement Contract Types | PMP | iZenBridge - Webinar
Procurement Contract Types | PMP | iZenBridge - Webinar Saket Bansal

PMP Chap 12 - Project Procurement Management Details - Part2
PMP   Chap 12 - Project Procurement Management Details - Part2PMP   Chap 12 - Project Procurement Management Details - Part2
PMP Chap 12 - Project Procurement Management Details - Part2Anand Bobade

PMP Chap 12 - Project Procurement Management Details - Part 1
PMP   Chap 12 - Project Procurement Management Details - Part 1PMP   Chap 12 - Project Procurement Management Details - Part 1
PMP Chap 12 - Project Procurement Management Details - Part 1Anand Bobade

PMP Training - 12 project procurement management
PMP Training - 12 project procurement managementPMP Training - 12 project procurement management
PMP Training - 12 project procurement managementejlp12

Contract & Tender Management
Contract & Tender ManagementContract & Tender Management
Contract & Tender ManagementAnand Subramaniam

PMP 1600 Questions by TechFAQ360
PMP 1600 Questions by TechFAQ360PMP 1600 Questions by TechFAQ360
PMP 1600 Questions by TechFAQ360Artonline Home


Viewers also liked (20)

Pmp stakeholder chapter 13
Pmp stakeholder chapter 13Pmp stakeholder chapter 13
Pmp stakeholder chapter 13

Pmp cost chapter 7
Pmp cost chapter 7Pmp cost chapter 7
Pmp cost chapter 7

Pmp scope chapter 5
Pmp scope chapter 5Pmp scope chapter 5
Pmp scope chapter 5

Pmp integration chapter 4
Pmp integration chapter 4Pmp integration chapter 4
Pmp integration chapter 4

Pmp time chapter 6
Pmp time chapter 6Pmp time chapter 6
Pmp time chapter 6

Pmp risk chapter 11
Pmp risk chapter 11Pmp risk chapter 11
Pmp risk chapter 11

Pmp communication chapter 10
Pmp communication chapter 10Pmp communication chapter 10
Pmp communication chapter 10

Pmp quality chapter 8
Pmp quality chapter 8Pmp quality chapter 8
Pmp quality chapter 8

Pmp hr chapter 9
Pmp hr chapter 9Pmp hr chapter 9
Pmp hr chapter 9

Pmbok 4th edition chapter 12 - Project Procurement Management
Pmbok 4th edition   chapter 12 - Project Procurement ManagementPmbok 4th edition   chapter 12 - Project Procurement Management
Pmbok 4th edition chapter 12 - Project Procurement Management

Project Procurement Management PMBOK 5
Project Procurement Management PMBOK 5Project Procurement Management PMBOK 5
Project Procurement Management PMBOK 5

Chap12 project procurement management
Chap12 project procurement managementChap12 project procurement management
Chap12 project procurement management

Project Management-Project procurement Management
Project Management-Project procurement ManagementProject Management-Project procurement Management
Project Management-Project procurement Management

Procurement Contract Types | PMP | iZenBridge - Webinar
Procurement Contract Types | PMP | iZenBridge - Webinar Procurement Contract Types | PMP | iZenBridge - Webinar
Procurement Contract Types | PMP | iZenBridge - Webinar

PMP Chap 12 - Project Procurement Management Details - Part2
PMP   Chap 12 - Project Procurement Management Details - Part2PMP   Chap 12 - Project Procurement Management Details - Part2
PMP Chap 12 - Project Procurement Management Details - Part2

PMP Chap 12 - Project Procurement Management Details - Part 1
PMP   Chap 12 - Project Procurement Management Details - Part 1PMP   Chap 12 - Project Procurement Management Details - Part 1
PMP Chap 12 - Project Procurement Management Details - Part 1

PMP Training - 12 project procurement management
PMP Training - 12 project procurement managementPMP Training - 12 project procurement management
PMP Training - 12 project procurement management

PMP_Project Procurement Management
PMP_Project Procurement ManagementPMP_Project Procurement Management
PMP_Project Procurement Management

Contract & Tender Management
Contract & Tender ManagementContract & Tender Management
Contract & Tender Management

PMP 1600 Questions by TechFAQ360
PMP 1600 Questions by TechFAQ360PMP 1600 Questions by TechFAQ360
PMP 1600 Questions by TechFAQ360


Similar to Here are some factors to consider in deciding whether to lease or buy an asset like a vehicle:Buy:- Own the asset outright and can sell it later to recover some costs- May be able to deduct depreciation from taxes- Interest on loans may be tax deductible - Asset value may appreciate over timeLease: - Lower monthly payments than loan payments for buying- Don't have to put down a large down payment up front- Can upgrade to a new vehicle more frequently by turning it in at end of lease- Someone else (lessor) assumes risk of repairs/maintenance- Don't own the vehicle at the end of the lease termThings to weigh are

12 projectprocurementmanagement
12 projectprocurementmanagement12 projectprocurementmanagement
12 projectprocurementmanagementDhamo daran

Project Procurment Management
Project Procurment ManagementProject Procurment Management
Project Procurment ManagementSaad Al Jabri

PMP Muzette Charles_Sp2019_Chapter12_13 Procurement_Stakeholder
PMP Muzette Charles_Sp2019_Chapter12_13 Procurement_StakeholderPMP Muzette Charles_Sp2019_Chapter12_13 Procurement_Stakeholder
PMP Muzette Charles_Sp2019_Chapter12_13 Procurement_StakeholderMuzette Charles, PMP

Procurements Chapter 12
Procurements Chapter 12Procurements Chapter 12
Procurements Chapter 12KareemBullard1

Project procuremenet contract in ethiopia
Project procuremenet contract in ethiopiaProject procuremenet contract in ethiopia
Project procuremenet contract in ethiopiaGuta Mengesha

CONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPESCONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPESPundlik Rathod

Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...
Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...
Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...GlobalSkillup

Procurement Management Knowledge Area
Procurement Management Knowledge AreaProcurement Management Knowledge Area
Procurement Management Knowledge AreaJoshua Render

Contract Types + EVMS
Contract Types + EVMSContract Types + EVMS
Contract Types + EVMSSteven Norton

Negotiation Case Study
Negotiation Case StudyNegotiation Case Study
Negotiation Case StudyPrateek Mishra

Role of agreement and contract in risk mitigation
Role of agreement and contract in risk mitigationRole of agreement and contract in risk mitigation
Role of agreement and contract in risk mitigationZameerul Islam

Chapter 15 Methods of Compensation
Chapter 15 Methods of CompensationChapter 15 Methods of Compensation
Chapter 15 Methods of CompensationTran Thang

Procurement Management
Procurement Management Procurement Management
Procurement Management Riyas Rushard


Similar to Here are some factors to consider in deciding whether to lease or buy an asset like a vehicle:Buy:- Own the asset outright and can sell it later to recover some costs- May be able to deduct depreciation from taxes- Interest on loans may be tax deductible - Asset value may appreciate over timeLease: - Lower monthly payments than loan payments for buying- Don't have to put down a large down payment up front- Can upgrade to a new vehicle more frequently by turning it in at end of lease- Someone else (lessor) assumes risk of repairs/maintenance- Don't own the vehicle at the end of the lease termThings to weigh are (20)

procurement Management
procurement Management procurement Management
procurement Management

12 projectprocurementmanagement
12 projectprocurementmanagement12 projectprocurementmanagement
12 projectprocurementmanagement

Project Procurment Management
Project Procurment ManagementProject Procurment Management
Project Procurment Management

PMP Muzette Charles_Sp2019_Chapter12_13 Procurement_Stakeholder
PMP Muzette Charles_Sp2019_Chapter12_13 Procurement_StakeholderPMP Muzette Charles_Sp2019_Chapter12_13 Procurement_Stakeholder
PMP Muzette Charles_Sp2019_Chapter12_13 Procurement_Stakeholder

Project contracting
Project contracting Project contracting
Project contracting

Session 19 4th edition PMP
Session  19 4th edition PMPSession  19 4th edition PMP
Session 19 4th edition PMP

Common contract types
Common contract typesCommon contract types
Common contract types

Pm session11
Pm session11Pm session11
Pm session11

PROCUMENT - Copy.pptx
PROCUMENT - Copy.pptxPROCUMENT - Copy.pptx
PROCUMENT - Copy.pptx

Procurements Chapter 12
Procurements Chapter 12Procurements Chapter 12
Procurements Chapter 12

Contract Types
Contract TypesContract Types
Contract Types

Project procuremenet contract in ethiopia
Project procuremenet contract in ethiopiaProject procuremenet contract in ethiopia
Project procuremenet contract in ethiopia

CONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPESCONTRACTS AND ITS TYPES
CONTRACTS AND ITS TYPES

Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...
Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...
Online PMP Training Material for PMP Exam - Procurement Management Knowledge ...

Procurement Management Knowledge Area
Procurement Management Knowledge AreaProcurement Management Knowledge Area
Procurement Management Knowledge Area

Contract Types + EVMS
Contract Types + EVMSContract Types + EVMS
Contract Types + EVMS

Negotiation Case Study
Negotiation Case StudyNegotiation Case Study
Negotiation Case Study

Role of agreement and contract in risk mitigation
Role of agreement and contract in risk mitigationRole of agreement and contract in risk mitigation
Role of agreement and contract in risk mitigation

Chapter 15 Methods of Compensation
Chapter 15 Methods of CompensationChapter 15 Methods of Compensation
Chapter 15 Methods of Compensation

Procurement Management
Procurement Management Procurement Management
Procurement Management


Recently uploaded

Day 0- Bootcamp Roadmap for PLC Bootcamp
Day 0- Bootcamp Roadmap for PLC BootcampDay 0- Bootcamp Roadmap for PLC Bootcamp
Day 0- Bootcamp Roadmap for PLC BootcampPLCLeadershipDevelop

LPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations ReviewLPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations Reviewthomas851723

Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Nehwal

LPC User Requirements for Automated Storage System Presentation
LPC User Requirements for Automated Storage System PresentationLPC User Requirements for Automated Storage System Presentation
LPC User Requirements for Automated Storage System Presentationthomas851723

CEO of Google, Sunder Pichai's biography
CEO of Google, Sunder Pichai's biographyCEO of Google, Sunder Pichai's biography
CEO of Google, Sunder Pichai's biographyHafizMuhammadAbdulla5

Fifteenth Finance Commission Presentation
Fifteenth Finance Commission PresentationFifteenth Finance Commission Presentation
Fifteenth Finance Commission Presentationmintusiprd

Training Methods and Training Objectives
Training Methods and Training ObjectivesTraining Methods and Training Objectives
Training Methods and Training Objectivesmintusiprd

GENUINE Babe,Call Girls IN Badarpur Delhi | +91-8377087607
GENUINE Babe,Call Girls IN Badarpur  Delhi | +91-8377087607GENUINE Babe,Call Girls IN Badarpur  Delhi | +91-8377087607
GENUINE Babe,Call Girls IN Badarpur Delhi | +91-8377087607dollysharma2066

Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...
Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...
Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...Pooja Nehwal

Introduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-EngineeringIntroduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-Engineeringthomas851723

{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai
{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai
{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, MumbaiPooja Nehwal

VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With RoomVIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Roomdivyansh0kumar0

CALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual serviceCALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual serviceanilsa9823

Board Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch PresentationBoard Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch Presentationcraig524401

LPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business SectorLPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business Sectorthomas851723

Risk management in surgery (bailey and love).pptx
Risk management in surgery (bailey and love).pptxRisk management in surgery (bailey and love).pptx
Risk management in surgery (bailey and love).pptxSaujanya Jung Pandey

LPC Facility Design And Re-engineering Presentation
LPC Facility Design And Re-engineering PresentationLPC Facility Design And Re-engineering Presentation
LPC Facility Design And Re-engineering Presentationthomas851723


Recently uploaded (20)

Day 0- Bootcamp Roadmap for PLC Bootcamp
Day 0- Bootcamp Roadmap for PLC BootcampDay 0- Bootcamp Roadmap for PLC Bootcamp
Day 0- Bootcamp Roadmap for PLC Bootcamp

LPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations ReviewLPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations Review

Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...

LPC User Requirements for Automated Storage System Presentation
LPC User Requirements for Automated Storage System PresentationLPC User Requirements for Automated Storage System Presentation
LPC User Requirements for Automated Storage System Presentation

sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service
sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Servicesauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service
sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service

CEO of Google, Sunder Pichai's biography
CEO of Google, Sunder Pichai's biographyCEO of Google, Sunder Pichai's biography
CEO of Google, Sunder Pichai's biography

Fifteenth Finance Commission Presentation
Fifteenth Finance Commission PresentationFifteenth Finance Commission Presentation
Fifteenth Finance Commission Presentation

Training Methods and Training Objectives
Training Methods and Training ObjectivesTraining Methods and Training Objectives
Training Methods and Training Objectives

GENUINE Babe,Call Girls IN Badarpur Delhi | +91-8377087607
GENUINE Babe,Call Girls IN Badarpur  Delhi | +91-8377087607GENUINE Babe,Call Girls IN Badarpur  Delhi | +91-8377087607
GENUINE Babe,Call Girls IN Badarpur Delhi | +91-8377087607

Becoming an Inclusive Leader - Bernadette Thompson
Becoming an Inclusive Leader - Bernadette ThompsonBecoming an Inclusive Leader - Bernadette Thompson
Becoming an Inclusive Leader - Bernadette Thompson

Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...
Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...
Call now : 9892124323 Nalasopara Beautiful Call Girls Vasai virar Best Call G...

Introduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-EngineeringIntroduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-Engineering

{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai
{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai
{ 9892124323 }} Call Girls & Escorts in Hotel JW Marriott juhu, Mumbai

VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With RoomVIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room

CALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual serviceCALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual service
CALL ON ➥8923113531 🔝Call Girls Charbagh Lucknow best sexual service

Board Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch PresentationBoard Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch Presentation

LPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business SectorLPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business Sector

Risk management in surgery (bailey and love).pptx
Risk management in surgery (bailey and love).pptxRisk management in surgery (bailey and love).pptx
Risk management in surgery (bailey and love).pptx

LPC Facility Design And Re-engineering Presentation
LPC Facility Design And Re-engineering PresentationLPC Facility Design And Re-engineering Presentation
LPC Facility Design And Re-engineering Presentation

Call Girls Service Tilak Nagar @9999965857 Delhi 🫦 No Advance VVIP 🍎 SERVICE
Call Girls Service Tilak Nagar @9999965857 Delhi 🫦 No Advance  VVIP 🍎 SERVICECall Girls Service Tilak Nagar @9999965857 Delhi 🫦 No Advance  VVIP 🍎 SERVICE
Call Girls Service Tilak Nagar @9999965857 Delhi 🫦 No Advance VVIP 🍎 SERVICE


Here are some factors to consider in deciding whether to lease or buy an asset like a vehicle:Buy:- Own the asset outright and can sell it later to recover some costs- May be able to deduct depreciation from taxes- Interest on loans may be tax deductible - Asset value may appreciate over timeLease: - Lower monthly payments than loan payments for buying- Don't have to put down a large down payment up front- Can upgrade to a new vehicle more frequently by turning it in at end of lease- Someone else (lessor) assumes risk of repairs/maintenance- Don't own the vehicle at the end of the lease termThings to weigh are

  • 2. 2  What is a Contract  Types of Contracts  12.1 Plan Procurement  12.2 Conduct Procurements  12.3 Control Procurements  12.4 Close Procurements KEY TERMS
  • 3. Project Procurement Management 3 12.1 Plan Procurement Management The process of documenting project procurement decisions, specifying the approach, and identifying potential sellers 12.2 Conduct Procurements The process of obtaining seller responses, selecting a seller, and awarding a contract. 12.3 Control Procurements The process of managing procurement relationships, monitoring contract performance, and making changes and corrections as appropriate . 12.4 Close Procurements The process of completing each project procurement.
  • 4. Project Procurement Management Knowledge Area Process Initiating Planning Executing Monitoring & Control Closing Processes • 12.1 Plan Procurement Management • 12.2 Conduct Procurements • 12.3 Control Procurements • 12.4 Close Procurements Enter phase/ Start project Exit phase/ End project Initiating Processes Closing Processes Planning Processes Executing Processes Monitoring & Controlling Processes 4
  • 5. 5 What is a Contract  A Contract is a Legally binding detailed formal document that refers to an entire agreement between 2 or more parties.  All terms & conditions of a Contract must be met.  Anything not mentioned in the Contract is not Legally Binding to anyone.
  • 6. 6 Centralized Contracting ADVANTAGES DISADVANTAGES Can result in procurement managers with higher levels of expertise. It may be more difficult for the project manager to obtain contracting help when needed. Employees will have continuous improvement, training, and shared lessons learned. Standardized company practices help improve understanding. The procurement manager has less time to spend working on your project and understanding its unique needs.Individuals have a clearly defined career path in procurement. There is one procurement department, and a procurement manager may handle procurements on many projects.
  • 7. 7 Decentralized Contracting ADVANTAGES DISADVANTAGES The project manager has easier access to contracting expertise because the procurement manager is a member of the team. No "home" department for the procurement manager to return to after the project is completed. The procurement manager has more loyalty to the project. More difficult to maintain a high level of contracting expertise. ( no procurement dep.) The procurement manager has a better understanding of the project and its procurement needs. Little standardized company practices There is one procurement department, and a procurement manager may handle procurements on many projects.
  • 8. 8 Types of Contracts The three broad categories of contracts are:3 Fixed price (FP) Time and material (T&M) Or Unit Price Cost-reimbursable (CR) 1. Fixed Price / Lump Sum / Firm Fixed Price) 1. Cost Plus Fee ( CPF) / Cost Plus Percentage of Costs ( CPPC) 2. Fixed Price Incentive Fee (FPIF) 2. Cost Plus Fixed Fee (CPFF) 3. Fixed Price Award Fee (FPAF) 3. Cost Plus Incentive Fee (CPIF) 4. Fixed Price with Economic Price Adjustment Contracts (FP-EPA). 4. Cost Plus Award Fee ( CPAF)
  • 9. 9 Fixed Piece Contracts 1. Fixed Price / Lump Sum / Firm Fixed Price)  Well defined sow / scope/ product.  Fixed total Price.  Risk is on the seller.  Any cost increase due to adverse performance is the responsibility of the seller  Total cost of project is known before executing. Example of Fixed Price Contract Contract = 1,100,000.00 $
  • 10. 10 Fixed Piece Contracts 2. Fixed Price Incentive Fee (FPIF) • gives the buyer and seller some flexibility for deviation from performance. • Additional incentives is paid based on seller performance such as finish faster / cheaper / better • The final price is calculated by a formula based on the relationship between the buyer and seller ( ex. 20/80 ) Example : Contract= $1,100,000. For every month early the project is finished, an additional $10,000 is paid to the seller.
  • 11. 11 Fixed Piece Contracts 3. Fixed Price Award Fee (FPAF) • The buyer pays a fixed price plus an award amount (a bonus) based on performance. • This is very similar to the FPIF contract, except the total possible award amount is determined in advance. • Performance criteria should be set in advance for fairly judgment Example : Contract= $1,100,000. For every month performance exceeds. The planed level by more than 15 %, an additional is awarded to the seller, with a maximum award of $50,000.
  • 12. 12 Fixed Piece Contracts 4. Fixed Price with Economic Price Adjustment Contracts (FP-EPA). • Used whenever the seller’s performance period spans a considerable period of years. •The FP-EPA contract is intended to protect both buyer and seller from external conditions beyond their control. Such as inflation changes, or cost increases Contract $1, l 00,000, but a price increase will be allowed in year two to account for increases in specific material costs.
  • 13. 13 Cost-reimbursable (CR) 1. Cost + Fee ( CPF). Cost Plus Percentage of Costs ( CPPC). • Involves payments to the seller for all legitimate actual costs incurred for completed work, plus a percentage of costs as a fee. • It is bad for the buyers. 2. Cost Plus Fixed Fee.(CPFF).
  • 14. 14 Cost-reimbursable (CR) 3. Cost Plus Incentive Fee (CPIF). 4. Cost Plus Award Fee ( CPAF). Cost + additional fee bases on manager satisfaction (performance criteria) Contract = $500,000 target cost plus $50,000 target fee. The buyer and seller share any cost savings or overruns at 80% to the buyer and 20% to the seller.
  • 15. 15 Cost-reimbursable (CR) ADVANTAGES DISADVANTAGES This type allows for a simpler procurement statement of work. requires auditing the seller's invoices. It usually requires less work to define the scope for a cost- reimbursable contract than for a fixed-price contract. This contract type requires more work for the buyer to manage. A cost-reimbursable contract is generally less costly than fixed price because the seller does not have to add as much for risk. The seller has only a moderate incentive to control costs. The total price is unknown.
  • 16. 16 Time and material (T&M) / Unit Price • Used for service efforts in which the level of effort cannot be defined at the time the contract is awarded. •To make sure the costs do not become higher than budgeted, the buyer may put a "Not to Exceed" and time limits clause in the contract. •Often used for staff augmentation, acquisition of experts, outside support Example: Contract = $1K per day plus expenses or material cost. Contract = $1K per day plus material at $5 per linear meter of wood.
  • 17. 17 Purchase Order • A purchase order is the simplest type of fixed- price contract • This type of contract is normally unilateral (signed by one party) instead of bilateral (signed by both parties. Cost Contract • A cost contract is one in which the seller receives no fee (profit). It is appropriate for work performed by nonprofit organizations.
  • 18. 18 Fixed Price FFP FPIF Time and Materials Cost Reimbursable CPIF CPFF CPF CPPC SELLER RISK BUYER RISK Low High T&M can be a high risk for buyer if contract does not include a “total not- to-exceed” (NTE) Contract Types vs. Risk Low High
  • 19. 19 • Price : the amount the seller charges the buyer. • Profit (fee) : planned into the price the seller provides the buyer. Sellers usually have an. • Cost : how much an item costs the seller to create, develop, or purchase. A buyer's costs. • Target price: used to compare the end result (final price) with what was expected (the target price). Target price is a measure of success. • Sharing ratio : Incentives are usually expressed as a ratio: e.g., 90/ 10. This sharing ratio describes how the cost savings or cost overrun will be shared. (buyer/seller). • Ceiling price: the highest price the buyer will pay. it's a way for the buyer to encourage the seller to control costs.
  • 20. 20 PTA - Point of Total Assumption  Only applies to Fixed Price incentive fee contracts.  Refers to the amount above which the seller bears all the loss of a cost overrun  Costs that go above the PTA are assumed to be due to management CP = Ceiling Price TP = Target Price BSR = Buys Share Ratio TC = Target Cost CP –TP BSR + TC
  • 21. 21 Question In cost plus incentive fee contract, the cost is estimated at $210,000 and the fee at $25,000. The project is complete, and the buyer has agreed that the costs were, in fact, $200,000. Because the seller's costs came in lower than the estimated costs, the seller shares in the savings: 80 % to the buyer and 20 % to the seller. Calculate the final fee and final price?
  • 22. 22 Target cost $210,000 Target fee $25,000 Target price $235,000 Sharing ratio 80/20 Actual cost $200,000 Final fee $210,000 - $200,000 = $10,000 $10,000 x 20% = $2,000 $25,000 target fee + $2,000 = $27,000 fee Final price $200,000 + $27,000 = $227,000
  • 24. 24 12.1 Plan Procurement Management • The process of documenting project procurement decisions, specifying the approach, and identifying potential sellers • Identifies products or services that can be acquired from outside the project organization Vs needs that can be accomplished from within the organization.
  • 25. 25
  • 26. 26 12.1 Plan Procurement Management Inputs 1. Project Management Plan Project Scope Statement WBS WBS Dictionary 2. Requirements Documentation 3. Risk Register 4. Activity Resource Requirements 5. Project Schedule 6. Activity Cost Estimates evaluate the reasonableness of the bids or proposals received 7. Stakeholder Register 8. EEF 9. OPA
  • 27. 27 12.1 Plan Procurement Management T & T 1. Make or Buy Analysis: • Purchase or make - Purchase or renting/leasing. • Determine whether a product or service needs to be procured or can be produced by the project team. Reasons to Buy: Capacity and Capability Exploit Opportunity Shift risk (cost, time, or scope) Reasons to Make: Idle resources Want to control Confidential information
  • 28. 28 Question You are trying to decide whether to lease or buy an item for your project. The daily lease cost is $120. To purchase the item, the investment cost is $1,000 and the daily maintenance cost is $20. How long will it take for the lease cost to be the same as the purchase cost? Answer Let D equal the number of days when the purchase and lease costs are equal. $120D = $1,000 + $20D $120D $20D = $1,000 $100D = $1,000 D= 10
  • 29. 29 12.1 Plan Procurement Management Outputs 1. Procurement Management Plan • Types of contracts to be used • Risk Management Issues • Procurement Processes • Standardized Procurement Documents • Responsibilities • Pre-qualified sellers • Scheduled dates for deliverables • Managing multiple providers
  • 30. 30 12.1 Plan Procurement Management Outputs 2. Procurement Statement of Work • Specifications, quality levels, quantity desired and other requirements. • Describes the procurement item in sufficient detail to allow sellers to determine if they are capable of providing the item. 3. Make or Buy Decision 4. Change Requests 5. Project Document Updates
  • 31. 31 12.1 Plan Procurement Management Outputs 6. Procurement Documents • Are used to solicit proposals, quotes, and bids from sellers • Request for Information ( RFI ) • Request for Proposal (Tender) RFP. request a detailed proposal on how the work will be accomplished, who will do it, resumes, company experience. • Invitation for bid (IFB, or request for bid, RFB) IFBs usually just request a total price to do all the work. • Request for Quotation RFQ : price quote per item, hour, or foot (T&M contracts).
  • 32. 32 12.1 Plan Procurement Management Outputs 7. Source Selection Criteria • The project team must be prepared to compare the proposals received in an unbiased manner based on identified & documented selection criteria to rate or score proposals. Includes but not limited to:  Past performance  Understanding of need  Overall or life cycle cost  References  Technical capability and approach  Risk  Management approach  Financial stability and capacity
  • 33. 33 Types of Procurement Statements of Work Performance Functional Design This type conveys what the final product should be able to accomplish. This type conveys the end purpose or result This type precisely conveys what work is to be done. Used in Information systems, information technology, research and development Used in Information systems, information technology, research and development Commonly used in construction and equipment purchasing (Ex. I want a car goes from 0 to 100 km in 4 seconds ) (Ex. I want a car with 2 cup holders and a small TV screen)
  • 35. 35 12.2 Conduct Procurement.  Obtaining seller responses, selecting a seller, and awarding a contract.  The key benefit is to provide alignment of internal and external stakeholder expectations through established agreements.
  • 36. 36
  • 37. 37 12.2 Conduct Procurement Inputs 1. Procurement Management Plan 2. Procurement Documents 3. Source Selection Criteria 4. Seller Proposals 5. Project Documents 6. Make or Buy Decisions 7. Procurement Statement of Work 8. OPA
  • 38. 38 12.2 Conduct Procurement T & T 1. Bidder Conferences  Also known as contractor, vendor, or pre-bid conferences.  The purpose of these conferences is to clarify any of the information not clearly stated in the RFP.  Creates a clear and common understanding of the procurement.  Proposals received will be more clearly aligned with project requirements, due to the fact that bidder conferences make the requirements clear.
  • 39. 39 12.2 Conduct Procurement T & T 2. Proposal Evaluation Techniques 3. Independent Estimates 4. Expert Judgment 5. Advertising 6. Analytical Techniques 7. Procurement Negotiations
  • 40. 40 • Attacks "If your organization cannot manage the details of its own operations, perhaps it should get out of the business!“ • Personal insults "If you do not understand what you are doing, perhaps you should find another job!“ • Good guy/bad guy One person is helpful to the other side, while another is difficult to deal with. • Deadline "We have a flight leaving at 5 p.m. today and must finish negotiations before that time. • Lying lying may be obvious or hidden. • Limited authority "I can't agree to shorten the schedule by six months. I have only been authorized to offer three months. Negotiation tactics
  • 41. 41 • Missing man "Only my boss can agree to that request, and he isn't here. Why don't we agree to only what I can agree to. • Fair and reasonable "Let's be fair and reasonable. Accept this offer as it stands. • Delay "Let's revisit this issue the next time we get together." This may also take the form of never actually getting down to negotiating until the last day of a planned visit. • Extreme demands "As the buyer you will have to pay for all of the risks for this work. It is not our responsibility to plan for risks!“ • Withdrawal This can either be an emotional withdrawal or a physical withdrawal and can show less interest. • Fait accompli This is a done deal. "These government terms and conditions must be in all our contracts.
  • 42. 42 12.2 Conduct Procurement Outputs 1. Selected Sellers 2. Agreements 3. Resource Calendars 4. Change Requests 5. Project Management Plan Updates 6. Project Document Updates (SOW and Requirements Documentation)
  • 43. 43 Agreements include: • SOW • Acceptance How will you specifically know if the work is acceptable? • Changes How will changes be made • Confidentiality What information must not be made known or given to third parties? • Material breach This breach is so large that it may not be possible to complete the work under the contract. • Dispute resolution. • Force majeure • Incentives. • Liability. • Independent contractor. • Intellectual property. • Liquidated damages. • Payments method. • Retention • Warranties
  • 44. 44 What Do You Need to Have a Legal Contract? • An offer • Acceptance • Consideration (Something of value, not necessarily money) • Legal capacity (Separate legal parties, competent parties) • Legal purpose (You cannot have a legal, enforceable contract for the sale of illegal goods or services)
  • 45. 45 • Single Source In this type of procurement, you contract directly with your preferred seller without going through the full procurement process. • Sole Source In this type of procurement, there is only one seller. This might be a company that owns a patent.
  • 47. 47 12.3 Control Procurement. The process of managing procurement relationships, monitoring contract performance, and making changes and corrections as appropriate
  • 48. 48
  • 49. 49 12.3 Control Procurement Inputs 1. Project Management Plan 2. Procurement Documents 3. Agreements 4. Work Performance Reports 5. Approved Change Request. 6. Work Performance Information
  • 50. 50 12.3 Control Procurement T & T 1. Contract Change Control System 2. Procurement Performance Review 3. Inspections and Audits 4. Performance Reporting 5. Payment Systems. 6. Claims Administration: (disputes) 7. Record Management System
  • 51. 51 12.3 Control Procurement Outputs 1. Work Performance Information 2. Change Requests 3. Project Management Plan Updates 4. Project Documents Updates 5. OPA.
  • 53. 53 12.4 Close Procurement. • The process of completing each project procurement. • Accept deliverables. • Procurements are closed: When a contract is completed. When a contract is terminated before the work is completed
  • 54. 54
  • 55. 55 what work must be done during procurement closure • Product validation • Procurement negotiation • Financial closure • Procurement audit • Update to records • Final contract performance reporting • Lessons learned Administrative closure • Check completion or exit criteria for project or phase. • Transfer the product to next phase. • Collect records.
  • 56. 56 Organizational Process Assets Updates • Procurement file. A complete set of indexed contract documentation, including the closed contract • Deliverable acceptance. Documentation of formal acceptance of seller-provided deliverables may be required to be retained by the organization. • Lessons learned documentation. • Close Procurements occurs before Close Project or Phase . Close Procurements is done once for each procurement, at the end of the contract. • All procurements are closed before the project is closed.
  • 57. 57 Questions 1. Once signed, a contract is legally binding unless: A. One party is unable to perform. B. One party is unable to finance its part of the work. C. It is in violation of applicable law. D. It is declared null and void by either party's legal counsel.
  • 58. 58 Questions 1. Once signed, a contract is legally binding unless: A. One party is unable to perform. B. One party is unable to finance its part of the work. C. It is in violation of applicable law. D. It is declared null and void by either party's legal counsel. Answer : C
  • 59. 59 Questions 2. With a clear procurement statement of work, a seller completes work as specified, but the buyer is not pleased with the results. The contract is considered to be: A. Null and void. B. Incomplete. C. Complete. D. Waived.
  • 60. 60 Questions 2. With a clear procurement statement of work, a seller completes work as specified, but the buyer is not pleased with the results. The contract is considered to be: A. Null and void. B. Incomplete. C. Complete. D. Waived. Answer : C
  • 61. 61 Questions 3. A project manager for the seller is told by her management that the project should do whatever possible to be awarded incentive money. The primary objective of incentive clauses in a contract is to: A. Reduce costs for the buyer. B. Help the seller control costs. C. Synchronize objectives. D. Reduce risk for the seller by shifting risk to the buyer.
  • 62. 62 Questions 3. A project manager for the seller is told by her management that the project should do whatever possible to be awarded incentive money. The primary objective of incentive clauses in a contract is to: A. Reduce costs for the buyer. B. Help the seller control costs. C. Synchronize objectives. D. Reduce risk for the seller by shifting risk to the buyer. Answer : C
  • 63. 63 Questions 4. A seller is working on a cost-reimbursable (CR) contract when the buyer decides he would like to expand the scope of services and change to a fixed-price (FP) contract. All of the following are the seller's options EXCEPT: A. Completing the original work on a cost-reimbursable basis and then negotiating a fixed price for the additional work. B. Completing the original work and rejecting the additional work. C. Negotiating a fixed-price contract that includes the work. D. Starting over with a new contract.
  • 64. 64 Questions 4. A seller is working on a cost-reimbursable (CR) contract when the buyer decides he would like to expand the scope of services and change to a fixed-price (FP) contract. All of the following are the seller's options EXCEPT: A. Completing the original work on a cost-reimbursable basis and then negotiating a fixed price for the additional work. B. Completing the original work and rejecting the additional work. C. Negotiating a fixed-price contract that includes the work. D. Starting over with a new contract. Answer : D
  • 65. 65 Questions 5. 1he sponsor is worried about the seller deriving extra profit on the cost plus fixed fee (CPFF) contract. Each month he requires the project manager to submit CPI calculations and an analysis of the cost to complete. The project manager explains to the sponsor that extra profits should NOT be a worry on this project because: A. The team is making sure the seller does not cut scope. B. All costs invoiced are being audited. C. There can only be a maximum 10 percent increase if there is an unexpected cost overrun. D. The fee is only received by the seller when the project is completed.
  • 66. 66 Questions 5. 1he sponsor is worried about the seller deriving extra profit on the cost plus fixed fee (CPFF) contract. Each month he requires the project manager to submit CPI calculations and an analysis of the cost to complete. The project manager explains to the sponsor that extra profits should NOT be a worry on this project because: A. The team is making sure the seller does not cut scope. B. All costs invoiced are being audited. C. There can only be a maximum 10 percent increase if there is an unexpected cost overrun. D. The fee is only received by the seller when the project is completed. Answer : B
  • 67. 67 Questions 6. In a fixed-price (FP) contract, the fee or profit is: A. Unknown. B. Part of the negotiation involved in paying every invoice. C. Applied as a line item to every invoice. D. Determined with the other party at the end of the project.
  • 68. 68 Questions 6. In a fixed-price (FP) contract, the fee or profit is: A. Unknown. B. Part of the negotiation involved in paying every invoice. C. Applied as a line item to every invoice. D. Determined with the other party at the end of the project. Answer : A
  • 69. 69 Questions 7. A project performed under a cost-reimbursable contract has finally entered the Close Procurements process. What MUST the buyer remember to do? A. Decrease the risk rating of the project. B. Audit seller's cost submittals. C. Evaluate the fee she is paying. D. Make sure the seller is not adding resources.
  • 70. 70 Questions 7. A project performed under a cost-reimbursable contract has finally entered the Close Procurements process. What MUST the buyer remember to do? A. Decrease the risk rating of the project. B. Audit seller's cost submittals. C. Evaluate the fee she is paying. D. Make sure the seller is not adding resources. Answer : B
  • 71. 71 Questions 8. The sponsor and the project manager are discussing what type of contract the project manager plans to use on the project. The sponsor points out that the performing organization spent a lot of money hiring a design team to come up with the design. The project manager is concerned that the risk for the buyer be as small as possible. An advantage of a fixed-price contract for the buyer is: A. Cost risk is lower. B. Cost risk is higher. C. There is little risk. D. Risk is shared by all parties.
  • 72. 72 Questions 8. The sponsor and the project manager are discussing what type of contract the project manager plans to use on the project. The sponsor points out that the performing organization spent a lot of money hiring a design team to come up with the design. The project manager is concerned that the risk for the buyer be as small as possible. An advantage of a fixed-price contract for the buyer is: A. Cost risk is lower. B. Cost risk is higher. C. There is little risk. D. Risk is shared by all parties. Answer : A
  • 73. 73 Questions 9. Your company has an emergency and needs contracted work done as soon as possible. Under these circumstances, which of the following would be the MOST helpful to add to the contract? A. A clear procurement statement of work. B. Requirements as to which subcontractors can be used. C. Incentives. D. A force majeure clause.
  • 74. 74 Questions 9. Your company has an emergency and needs contracted work done as soon as possible. Under these circumstances, which of the following would be the MOST helpful to add to the contract? A. A clear procurement statement of work. B. Requirements as to which subcontractors can be used. C. Incentives. D. A force majeure clause. Answer : C
  • 75. 75 Questions 10. During which procurement processes does procurement negotiation occur? A. Plan Procurement Management and Close Procurements B. Control Procurements and Close Procurements C. Conduct Procurements and Control Procurements D. Conduct Procurements and Close Procurements
  • 76. 76 Questions 10. During which procurement processes does procurement negotiation occur? A. Plan Procurement Management and Close Procurements B. Control Procurements and Close Procurements C. Conduct Procurements and Control Procurements D. Conduct Procurements and Close Procurements Answer : D
  • 77. 77 Questions 11. Your program manager has come to you, the project manager, for help with a bid for her newest project. You want to protect your company from financial risk, and you have limited scope definition. What is the BEST type of contract to choose? A. Fixed price (FP) B. Cost plus percentage of cost ( CPPC) C. Time and material (T &M) D. Cost plus fixed fee ( CPFF)
  • 78. 78 Questions 11. Your program manager has come to you, the project manager, for help with a bid for her newest project. You want to protect your company from financial risk, and you have limited scope definition. What is the BEST type of contract to choose? A. Fixed price (FP) B. Cost plus percentage of cost ( CPPC) C. Time and material (T &M) D. Cost plus fixed fee ( CPFF) Answer : D
  • 79. 79 Questions 12. Close Procurements is different from Close Project or Phase in that Close Procurements: A. Occurs before Close Project or Phase. B. Is the only one to involve the customer. C. Includes the return of property. D. May be done more than once for each contract.
  • 80. 80 Questions 12. Close Procurements is different from Close Project or Phase in that Close Procurements: A. Occurs before Close Project or Phase. B. Is the only one to involve the customer. C. Includes the return of property. D. May be done more than once for each contract. Answer : A
  • 81. 81 Questions 13. You have just started work on a procurement when management decides to terminate the contract. What should you do FIRST? A. Go back to the Plan Procurement Management process. B. Go back to the Conduct Procurements process. C. Finish the Control Procurements process. D. Go to the Close Procurements process.
  • 82. 82 Questions 13. You have just started work on a procurement when management decides to terminate the contract. What should you do FIRST? A. Go back to the Plan Procurement Management process. B. Go back to the Conduct Procurements process. C. Finish the Control Procurements process. D. Go to the Close Procurements process. Answer : D
  • 83. 83 Questions 14. What type of contract do you NOT want to use if you do not have enough labor to audit invoices? A. Cost plus fixed fee ( CPFF) B. Time & material (T &M) C. Fixed price (FP) D. Fixed price incentive fee (FPIF)
  • 84. 84 Questions 14. What type of contract do you NOT want to use if you do not have enough labor to audit invoices? A. Cost plus fixed fee ( CPFF) B. Time & material (T &M) C. Fixed price (FP) D. Fixed price incentive fee (FPIF) Answer : A
  • 85. 85 Questions 15. Which of the following is an advantage of centralized contracting? A. Increased expertise B. Easier access C. No home for the procurement manager D. More loyalty to the project
  • 86. 86 Questions 15. Which of the following is an advantage of centralized contracting? A. Increased expertise B. Easier access C. No home for the procurement manager D. More loyalty to the project Answer : A
