NORTH BLYTH BIOMASS
PROJECT
RIVER WALL REPAIR WORKS - REMEDIAL SECANT
PILE WALL
METHOD STATEMENT
14 June 2012
Document Ref: 02377-003093 Issue: 01
The SKM logo trade mark is a registered trade mark of Sinclair Knight Merz Pty Ltd.
NORTH BLYTH BIOMASS PROJECT
RIVER WALL REPAIR WORKS - REMEDIAL SECANT PILE WALL
METHOD STATEMENT
14 June 2012
SKM Enviros
Enviros House
Shrewsbury Business Park
Sitka Drive
Shrewsbury
Shropshire SY2 6LG
Tel: +44 (0)1743 284 800
Fax: +44 (0) 1743 245 558
Web: www.skmenviros.com
COPYRIGHT: The concepts and information contained in this document are the property of Sinclair
Knight Merz (Europe) Ltd. Use or copying of this document in whole or in part without the written
permission of Sinclair Knight Merz (Europe) Ltd constitutes an infringement of copyright.
LIMITATION: This report has been prepared on behalf of and for the exclusive use of Sinclair
Knight Merz (Europe) Ltd’s Client, and is subject to and issued in connection with the provisions of
the agreement between Sinclair Knight Merz (Europe) Ltd and its Client. Sinclair Knight Merz
(Europe) Ltd accepts no liability or responsibility whatsoever for or in respect of any use of or
reliance upon this report by any third party.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE i
Contents
1.  Introduction 1
1.1.  Background to the Works 1
1.2.  Scope of this Outline Method Statement 2
2.  Location of the Works 3
3.  Topography, Ground Conditions, Hydrogeology and Hydrology 4
3.1.  Data Source 4
3.2.  Topography 4
3.3.  Ground Conditions 4
3.4.  Hydrogeology 5
3.5.  Hydrology 5
4.  Existing River Walls 6
5.  The Selected Design Options 9
5.1.  Summary of Selected Options 9
5.2.  The Secant Pile Wall 9
5.3.  River Wall Reinstatement and Tie-back 10
6.  Sequence and Methods of Construction 11
6.1.  Considerations for Piling Activities 11
6.2.  Overall Sequence of Construction 11
6.3.  Construction Methods for the Bored Secant Pile Wall 12
6.4.  Construction Methods for the Remediation of the Old River Walls 12
6.5.  Contractor’s Compound 13
7.  Mitigation Measures to be employed during the works 14

Drawings 16

Appendix A: Options Report – Riverwall Remedial Works, D/I/D/81354/10517
Appendix B: Preliminary Outline Method Statement for other Remedial
Options- Riverwall Remedial Works, D/I/D/81354/10 18
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE ii

Document history and status
Revision Date issued Reviewed by Approved by Date approved Revision type
1 25/06/2012 DB MDF 25/06/2012 Initial Draft
2 02/07/2012 DB MDF 02/07/2012 Final Draft
3 03/07/2012 RLT MDF 03/07/2012 FINAL
Distribution of copies
Revision Copy no Quantity Issued to
1 1 1 RES
2 1 1 RES
3 1 1 RES
Printed: 3 July 2012
Last saved: 3 July 2012 09:27 AM
File name:
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant -
New Pile River Wall - Method Statement_Final 03.07.12.docx
Author: Richard Thomas
Project manager: Matt Faulkner
Name of organisation: RES
Name of project: North Blyth Biomass Project
Name of document: River Wall Method Statement
Document version: Final
Project number: JW30086
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
1. Introduction
1.1. Background to the Works
North Blyth Energy Ltd (NBEL), a wholly owned subsidiary of RES UK & Ireland (RES) is seeking
consent under the Planning Act 2008 (referred to hereafter as the PA 2008) to construct and
operate the North Blyth Renewable Energy Project (referred to hereafter as the Project), which has
an electrical export of approximately 99.9 Megawatts of Electricity (MWe) and is located at
Battleship Wharf, Port of Blyth, Northumberland. NBEL has submitted an application under Section
31 of the PA 2008 for a Development Consent Order (DCO) to the Planning Inspectorate (PINS) for
the Project.
This document provides a method statement describing improvement works that will be required at
the existing Port of Blyth site entrance to ensure vehicles from the Project do not impede Port of
Blyth vehicles or other road users. This will include widening of the existing access road which
leads from the adjacent, North Blyth roundabout that will in turn require repair to the existing river
wall. The widening will take place on the riverward side of the road.
The adjacent river walls are in a poor state of repair and therefore associated remedial support
measures are required to support the ground adjacent to the new road alignment and, thus, to
enable road widening to take place.
It was initially proposed to seal the walls with concrete, to prevent further washout, and to place
rock armour against them to prevent collapse. This option provides the quickest and lowest cost
construction option for the works, low noise disturbance and would not require any excavation
within the potentially contaminated fill material behind the existing river wall. Discussions with
Natural England, the Environment Agency and the MMO highlighted that the use of rock armour
would result in the loss of Biodiversity Action Plan habitat (mudflat) from the River Blyth Estuary.
As a result of feedback from consultees, a number of alternative construction techniques were
considered for the works.
The selected solution is a bored secant (interlocking) pile wall, constructed on the landward side of,
and generally parallel to the existing river wall, at a distance of the order of 4.0 to 4.5m from it. The
“interlocking” is achieved by drilling and forming the piles in an appropriate overlapping sequence.
Further background is provided in the report to RES, D/I/D/81354/105 “Options Report – Riverwall
Remedial Works” of February 2012 that was prepared by Fairhurst to inform the selection of a
construction technique that would not result in unacceptable loss of intertidal mudflats. This report
is provided within Appendix A of this report.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 2
1.2. Scope of this Outline Method Statement
This outline method statement relates to the secant (interlocking) pile wall installation, together with
related works to reduce the potential for further instability in the existing river walls and to minimise
wash out of material from the existing river wall. The method statement has been prepared in
consideration of the Options Report provided in Appendix A and the requirement to cause no loss
of mudflat habitat.
No reference is made to Health and Safety requirements, design, construction quality assurance,
regulatory liaison and liaison with third parties.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 3

2. Location of the Works

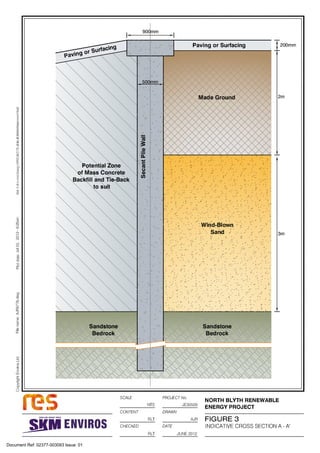

The location and layout of the works are shown on Figure 1 with an aerial photograph of the works
area provided in Figure 2. The remedial works location is at the southern end of Battleship Wharf,
North Blyth. The works will take place entirely within the Application Boundary, as defined within
the DCO Application that has been submitted by NBEL.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 4

3. Topography, Ground Conditions, Hydrogeology
and Hydrology
3.1. Data Source
The following geological and related data are reproduced from the report, reference
D/I/D/81354/105 “Options Report – Riverwall Remedial Works” of February 2012 that is provided in
Appendix A.
3.2. Topography
Comparatively shallow slopes are present on the landward side of the existing river wall, beyond
these the topography is reasonably flat. Beyond the line of the walls the slopes extend down to the
channel of the River Blyth.
3.3. Ground Conditions
The area retained by the river walls historically has been reclaimed from the estuary. Site
investigation information for this area is not available, but based on geotechnical information from
other locations in the Battleship Wharf area, ground conditions to the landward site of the river
walls have been inferred and are as tabulated below:-
Ground level to 2 – 3m below ground
level
Made Ground consisting of heterogeneous colliery spoil
2 – 3m to 4 – 5m below ground level Wind-blown Sand
Greater than 4 – 5m below ground
level
Bedrock comprising moderately strong to strong
sandstone
Colliery spoil is likely to contain contaminants including heavy metals, sulphate, combustible
materials, high pH, Polycyclic Aromatic Hydrocarbon (PAH) and Total Petroleum Hydrocarbon
(TPH), however these contaminants tend to be present in low concentrations with low solubility.
From historical records of the area it is considered that the fill has been in place for over 100 years
and that any leachable concentrations of contaminants are likely to have been leached from the
soil in the intertidal groundwater zone close to the wall by tidally influence groundwater movement.
Land immediately north of this location is known to have been contaminated by past uses as
railway sidings and for ship breaking. The affected area was remediated by Northumberland
County Council in 1993, hence any contamination which may remain is likely to be localised and in
low concentrations. (Chapter 15 Hydrogeology, Geology, Ground Conditions and Soils of the
Environmental Statement (ES), that has been submitted to PINS alongside the DCO application
provides further information on contamination).
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 5
On the riverward side of the river walls, sand overlying bedrock can be observed. As outcrops of
rock are visible, it is likely that beach sand deposits in this location are typically less than the order
of 1m thick.
3.4. Hydrogeology
Groundwater levels behind the existing river walls and in the vicinity of the proposed secant pile
wall are in a zone which is influenced by tidal conditions.

3.5. Hydrology
The tidal range in the River Blyth is:-
Highest recorded +3.61m OD
Mean High Water Spring Tides +2.44m OD
Mean Low Water Spring Tides -1.88m OD
Lowest Recorded -3.61m OD
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 6
4. Existing River Walls
The nature of the existing river walls was described in the Fairhurst report “Preliminary Outline
Method Statement - Riverwall Remedial Works”, Ref, D/I/D/81354/10 dated September 2011 and
provided in Appendix B, as follows. The river edge is made up of old concrete and masonry walls
which vary in distance between about 5m and 20m from the kerb line of the existing road. An
inspection of the river walls was carried out by Fairhurst during the low tide period on 8th Feb 2011.
Working from the Port entrance gate, the first section of wall (labelled Wall Section 1 on Figure 1) is
approximately 20m long, is constructed from stone masonry and gradually increases in height to
about 2m where it meets and old timber jetty. A section of wall has collapsed and an area behind
has been washed out by the river/sea, as shown in Photograph 1. This area has been roughly
infilled with whinstone rocks to prevent further washout.

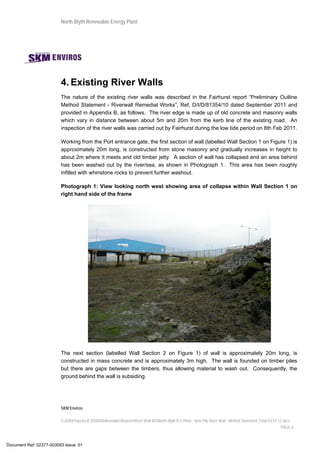

Photograph 1: View looking north west showing area of collapse within Wall Section 1 on
right hand side of the frame

The next section (labelled Wall Section 2 on Figure 1) of wall is approximately 20m long, is
constructed in mass concrete and is approximately 3m high. The wall is founded on timber piles
but there are gaps between the timbers, thus allowing material to wash out. Consequently, the
ground behind the wall is subsiding.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 7
Photograph 2: View looking west showing Wall Section 2

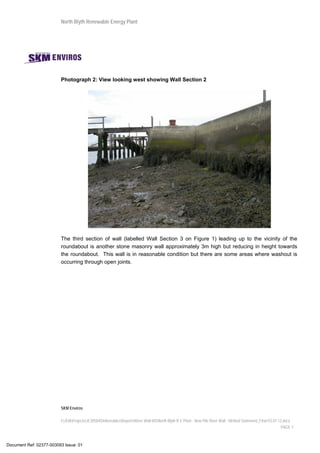

The third section of wall (labelled Wall Section 3 on Figure 1) leading up to the vicinity of the
roundabout is another stone masonry wall approximately 3m high but reducing in height towards
the roundabout. This wall is in reasonable condition but there are some areas where washout is
occurring through open joints.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 8
Photograph 3: View looking east showing Wall Section 3
Photograph 3: View looking west showing Wall Section 3
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 9
5. The Selected Design Options
5.1. Summary of Selected Options

The selected option to provide support to the widened road and immediately adjacent land, without
causing a loss of mudflat habitat, is the installation of a bored secant (interlocking) pile wall,
constructed on the landward side of and generally parallel to the existing river wall, at a distance of
the order of 4.0 to 4.5m from it. Whilst being more expensive than the original proposals involving
the use of rock armour, this option does not require excavation of potentially contaminated
materials, does not result in any loss of mudflat habitat and the use of bored piles reduces the
potential for noise and vibration impacts to occur. Chapter 3 of the ES that has been submitted to
PINS alongside the DCO application provides further detail regarding the choice of this option over
other methods described within Appendix A.
Associated work will include the provision of measures which will reduce washout through the
existing wall, together with the tying back of the existing wall to the secant pile wall.
5.2. The Secant Pile Wall
The secant wall option requires the minimum excavation of in situ soils, since the volume
excavated corresponds to the pile diameter and length and no additional excavation is required to
facilitate the construction of this remedial support measure for the access road widening. The
proposed Secant Pile Wall will be approximately 55m in length, located approximately 4.0 – 4.5m
on the landward side of the existing river walls and is anticipated to employ piles up to 500mm in
diameter. Figure 3 provides an indicative cross section of the proposed secant pile wall.
The piles will be bored through the superficial deposits into the sandstone bedrock to sufficient
depth to provide an adequate factor of safety against movement, should any further erosion or local
collapse of part of the existing river walls occur. Subject to detail design, it is anticipated that the
piles would need to extend 2 to 4m below the bedrock horizon, depending on the depth of surface
weathering in the rock. With the expected ground conditions summarised in Section 3.3, this would
provide an overall depth below the existing ground level of 7 to 9m, subject to detailed design.
Subject to detail design, local provision will be made to prevent the build-up of groundwater behind
the wall, where appropriate.
Assuming the use of 500mm piles with a 10% overlap, an overall wall length of 55m and depth of
8m below ground level, it is estimated that the works will generate approximately 190 m3
of soils
and rock arisings (Section 7.1 describes how arisings will be managed).
The use of bored piles will significantly reduce the potential noise and vibration levels arising from
the works when compared with sheet piling or other percussive piling techniques. The piling will
conform to the restrictions on piling described in Chapter 4, Section 4.5.80 of the ES that has been
submitted to PINS alongside the DCO application.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 10
5.3. River Wall Reinstatement and Tie-back

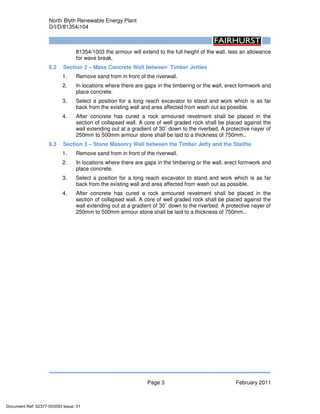

The western section (Wall Section 1 as shown on Figure 1) of the existing river wall constructed
from stone masonry between Battleship Wharf and the timber jetty will be reinstated against the
new bored pile wall following its installation.
The remaining sections of mass concrete wall and stone masonry wall between the timber jetties
and the staithes will be tied back to the new bored pile wall to prevent the existing wall collapsing
into the river. The form of the tie-back will be determined after inspection of the rear face of the
river walls to establish their condition. However, it is considered the most likely options to achieve
tie-back would include mass concrete infill between the walls together with either a tie at crest level
or the use of bolts drilled through selected blocks to tie back the existing wall into the propose
secant pile wall.
Local mass concrete works will be carried out immediately against the timber piles of the second
section of wall to minimise washout of material.
Subject to detail design, local provision such as weep holes containing or backed by a filter
medium, will be made in walls to prevent the build-up of groundwater behind walls, where
appropriate.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 11
6. Sequence and Methods of Construction
6.1. Considerations for Piling Activities
In order to mitigate potential impacts from piling noise on nearby sensitive ornithological receptors,
it is proposed that the noise from piling activities during the winter (October to March) is limited to
55 dB(A) LA Max or below at sensitive ornithological receptors unless otherwise agreed with
Northumberland County Council and Natural England. It is proposed that no piling works be
commenced until a Piling Method Statement has been submitted to and approved by
Northumberland County Council in consultation with Natural England, the Environment Agency and
the MMO.
The method statement will be informed by the detailed design stage and further geotechnical site
investigation. It is intended that this will be a Requirement of the DCO and will inform the method
of piling to be used during construction, the mitigation measures that will be employed to reduce
the impact of piling upon aquatic and marine animals and the method of measuring piling noise at
the Special Protection Area on the beach and Cambois coal staithes within the River Blyth Estuary
to the northwest of the Project. The piling method statement will also consider any potential
impacts upon groundwater. (Chapter 15 Hydrogeology, Geology, Ground Contamination and Soils
of the ES that accompanies the DCO application, assesses existing Made Ground and superficial
deposits to be granular in nature and therefore natural migration of contaminants is understood not
to be restricted and that piling operations cannot introduce additional potential pathways to lower
water bodies).
6.2. Overall Sequence of Construction
Installation of the bored secant pile wall will commence first and remedial works to the existing river
walls,which require temporary excavation behind them, will commence later in stages as sections
of the secant pile wall concrete gain sufficient strength. This is so that the secant pile wall will
provide stability as sequential, limited lengths of excavation are carried out behind the existing river
walls, to facilitate their stabilisation and tie-back, together with the construction of measures to
reduce wash-out. Local mass concrete works in front of the second section of wall, necessary to
reduce washout from between timber piles can be carried out at any time during the works.
These works will be carried out prior to the works required for the proposed new access to
Battleship Wharf that will involve widening the existing road on the riverwards side. It is anticipated
that the construction activities for the installation of the secant pile wall and remedial works to the
existing river walls can be conducted without impeding the existing North Blyth roundabout.
However, if this is not possible then a temporary road diversions, such as the temporary lane
closure required for the site access realignment works, may be required during the installation of
the bored piles.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 12
6.3. Construction Methods for the Bored Secant Pile Wall
The bored piles are excavated by means of a mechanical auger. The auger is advanced through
soils within a casing, to prevent collapse of soils during the drilling process. On completion of
excavation, the reinforcement cage is installed in the bore and concrete is placed. Any casing
used in the installation is withdrawn as the concrete is placed. The piles are constructed in an
overlapping, sequential basis to form the secant pile wall.
Although the use of casing will reduce any seepage of groundwater into the bore, it is possible that
potentially contaminated groundwater could collect within the bore prior to the concrete being
poured. If the bore does fill with significant quantities of groundwater, suitable bunding (such as
sandbags), will be placed around the work area to contain any water displaced during the pouring
of concrete. Any contained, potentially contaminated groundwater will then be transferred to a
tanker for treatment offsite at a suitable licensed facility. If it is sediment within the water that is
suspected of being contaminated then settlement tanks will be used to separate this from the
water, with the collected sediment sent for treatment offsite at a suitable licensed facility.
The soil and rock arisings from the bored piles will be handled and stored to ensure that no silt or
sand will be washed into the river during rainfall events. Although the topography on the landward
side of the wall is comparatively flat, should there be local variations which may concentrate rainfall
runoff, temporary sandbag (or other style) bunds will be placed to control runoff which could
otherwise mobilise silts and sands during their excavation and disposal.
Depending on the presence or absence of contamination, soil and rock arisings may be stockpiled
for later use, rather than being taken off site. Such stockpiles are likely to be in a designated area
away from bored pile wall construction and existing sea wall remediation and tie-back. This matter
is addressed below in Section 7.
Although it is envisaged that the bores will be filled with concrete almost immediately so as not to
leave open excavations for any length of time, if there are exceptional circumstances whereby
bores need to remain unfilled overnight (such as severe machinery failure), mitigation to prevent
entrapment of otters will be put in place. Suitable boarding or covers will be used to prevent otters
from accessing any deep and steep sided excavations near to the River Blyth Estuary. If this is not
practical a suitable means of escape will be provided within the excavation, to enable otters to
climb out of the construction. Otters are only likely to try and access the structure outside normal
working hours and so excavations will be covered or means of escape provided at the end of each
working day.
6.4. Construction Methods for the Remediation of the Old River Walls
The western section of the existing river wall constructed from stone masonry between Battleship
Wharf and the timber jetty will be reinstated against the new bored pile wall. Where tie-back is not
necessary simple options for surface paving will be considered.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 13
As determined appropriate, the remaining sections of mass concrete wall and stone masonry wall
between the timber jetties and the staithes will be tied back to the new bored pile wall to prevent
the existing wall collapsing into the river. The form of the tie-back will be determined after
inspection of the rear face of the wall to determine its condition. However, it is considered that it
will include mass concrete infill between the walls together with a tie at crest level.
Excavations behind the existing river walls will generate soil arisings. These will be handled with
care to prevent wind-blow transmission of fine particles into the river. If necessary, for this part of
the works, temporary sandbag (or other style) bunds will be placed to control runoff which could
otherwise mobilise silts and sands during their excavation from behind the existing river walls.
Depending on the presence or absence of contamination, soil arisings may be stockpiled for later
use, rather than being taken off site. As indicated for arisings from bored pile wall construction,
such stockpiles are likely to be in a designated area away from bored pile wall construction and
existing sea wall remediation and tie-back.
Where mass concrete infill is required, this will be contained by formwork which will have all joints
on the inside of the shuttering taped prior to concrete pouring. The concrete will press the tape
onto the shutter when it is poured, preventing any leaks. An anti washout additive will be added to
the concrete if it is considered there will be wave action before the concrete cures.
All heavy plant or machinery will be located on the landward side of the existing river wall and will
not be allowed to access the mudflat area. Appropriate signage and fencing will be used to enforce
this during the works. Only hand-held equipment, such tools used to erect formwork used to
contain the poured concrete, will be allowed onto the mudflat area and will be removed immediately
after use. No equipment or materials will be stored on the riverward side of the existing river wall,
regular checks and inspections will be made at the end of each work period (such as the return of
the tide), to make sure no materials are left in this area.
Any inspection activities and construction works on the River Blyth Estuary side of the existing river
wall will take place at states of low tide to prevent the disturbance of sediments within the river, to
allow access to the existing river wall and also to allow examination of the shuttering for leaks.
6.5. Contractor’s Compound
If a separate compound is provided for the contractor’s use, suitable measures will be applied to
prevent run-off of silts and sands directly to the estuary, following rainfall events. Further related
detail is provided below in Section 8.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 14
7. Mitigation Measures to be employed during the
works
Contractors for this work will be required to adhere to an Environmental Management System
(EMS) to ISO140001 or similar for the construction and decommissioning works, within the quality
assurance component of the Contract. Contractors will be required to agree to and develop the
overall Application Site Construction Environment Management Plan (CEMP) that will be agreed
with Northumberland County Council and the Environment Agency prior to commencement of the
construction works.
All water removed from excavations during construction will be treated where necessary and
discharged in accordance with relevant consents to discharge agreed with the Environment
Agency.
As part of the CEMP, mitigation to prevent the wash out of uncovered contaminated soils during
construction works will be employed. Where appropriate, bunds shall be constructed around work
areas where existing soils are exposed to prevent flood water inundating work areas and washing
out potentially contaminated surface soils.
As part of the CEMP, areas for locating the storage of construction materials will be indentified
outside the flood zone.
Specific guidance in dealing with silt contained in surface water runoff arising from construction
activities is contained within PPG5. A number of measures can be put in place in order to minimise
the actual transport of silt into surface water features, and will be agreed via the CEMP, including:
• Bunding – either earth bunds, cut-off ditches or other forms of diversion or sheeting of
stockpiles will be used to minimise the potential for silt laden runoff. Where appropriate silt
fences or straw / rock barriers at the toe of the stockpile would be put in place to mitigate
runoff during rainfall events. A silt fence comprises a geotextile filter fabric, straw bales, or a
combination of both, installed in the path of runoff and can filter out heavy sediments; and
• Wheel washing to prevent soils being spread onto roads outside of the construction area.
Appropriate measures will be put in place through the CEMP to mitigate potential effects of
contamination during concrete pouring, for containment of fuelling operations, and during fire
fighting events. Measures will be based on best practice (e.g. EA PPG Notes and CIRIA) and will
include the following:
• designated facilities designed and used for oil and fuel storage and refuelling (incorporating
appropriate bunds and drip trays);
• a site oil, chemical and product inventory;
• a list of emergency procedures, responsive to a risk assessment of areas of high sensitivity;
• site induction of all personnel on emergency spillage procedures and staff trained in
emergency procedures;
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 15
• a contact list for the emergency services, the relevant environmental regulators, the local
water supply and sewerage undertakers, the Health and Safety Executive and specialist
clean up contractors, if required; and
• emergency response equipment available at appropriate locations.
Prior to the commencement of construction and as a proposed Requirement accompanying the
DCO, a “Pollution Incident Response Plan” will be developed. In the event of an accidental
spillage, the “Pollution Incident Response Plan” will become effective. This plan will be part of the
contractor’s registered Quality Assurance programme to ISO 9001 and ISO 140001. This will
include details for the relevant contact at the MMO, should a marine pollution incident occur. The
Pollution Incident Response Plan will be agreed with consultees including the MMO and the
Environment Agency prior to commencement of the works.
The storage of potentially polluting materials will be kept to a minimum where practicable and,
where less hazardous or inert materials are available, these will be specified. In addition,
absorbent mats/pads, absorbent granules and sand will be made available, and site operatives
trained in their use, to deal with any spillages.
The positioning of fuel storage tanks and other potentially polluting materials and maintenance
facilities will be on bunded areas of hard standing with dedicated drainage systems. Bunded areas
will provide 110% storage volume to contain any possible leaks. Refuelling will also be undertaken
only in designated areas, where small spills and leaks can be controlled. Drip trays and absorbent
materials will be used to control spills.
Washing out of concrete wagons or other equipment used in concreting operations will be
undertaken in designated contained washout areas or offsite.

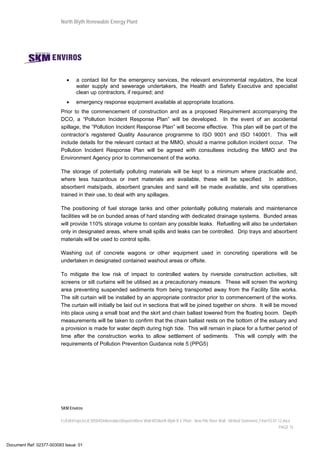

To mitigate the low risk of impact to controlled waters by riverside construction activities, silt
screens or silt curtains will be utilised as a precautionary measure. These will screen the working
area preventing suspended sediments from being transported away from the Facility Site works.
The silt curtain will be installed by an appropriate contractor prior to commencement of the works.
The curtain will initially be laid out in sections that will be joined together on shore. It will be moved
into place using a small boat and the skirt and chain ballast lowered from the floating boom. Depth
measurements will be taken to confirm that the chain ballast rests on the bottom of the estuary and
a provision is made for water depth during high tide. This will remain in place for a further period of
time after the construction works to allow settlement of sediments. This will comply with the
requirements of Pollution Prevention Guidance note 5 (PPG5)
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 16
Drawings

Figure 1: Remedial Secant Pile Wall location

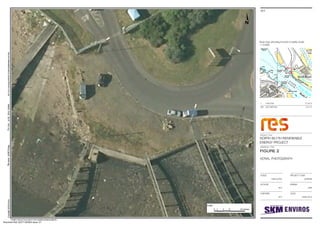

Figure 2: Aerial Photograph
Figure 3: Indicative Cross Section A – A’
Document Ref: 02377-003093 Issue: 01
Document Ref: 02377-003093 Issue: 01
Document Ref: 02377-003093 Issue: 01
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 17
Appendix A: Options Report – Riverwall Remedial
Works, D/I/D/81354/105
Document Ref: 02377-003093 Issue: 01

Options Report – Riverwall
Remedial Works

February 2012

RES
North Blyth Renewable
Energy Plant
D/I/D/81354/105
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105

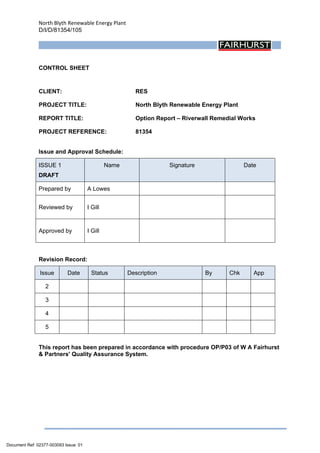

CONTROL SHEET
CLIENT: RES
PROJECT TITLE: North Blyth Renewable Energy Plant
REPORT TITLE: Option Report – Riverwall Remedial Works
PROJECT REFERENCE: 81354
Issue and Approval Schedule:
ISSUE 1
DRAFT
Name Signature Date
Prepared by A Lowes
Reviewed by I Gill
Approved by I Gill
Revision Record:
Issue Date Status Description By Chk App
2
3
4
5
This report has been prepared in accordance with procedure OP/P03 of W A Fairhurst
& Partners' Quality Assurance System.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105

CONTENTS

1.0  INTRODUCTION......................................................................................................... 1
2.0  LOCATION OF WORKS............................................................................................. 1
3.0  FORM OF STRUCTURE ............................................................................................ 1
4.0  EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS..................... 2
5.0  TECHNICAL CONSTRAINTS .................................................................................... 2

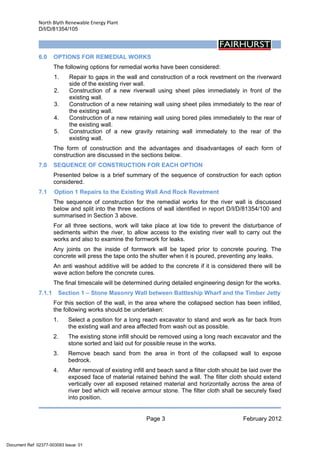

6.0  OPTIONS FOR REMEDIAL WORKS......................................................................... 3
7.0  SEQUENCE OF CONSTRUCTION FOR EACH OPTION.......................................... 3
8.0  ESTIMATED BUDGETARY COSTS .......................................................................... 7
9.0  ADVANTAGES AND DISADVANTAGES FOR EACH OPTION................................ 0
10.0  SUMMARY.................................................................................................................. 0

Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 1 February 2012

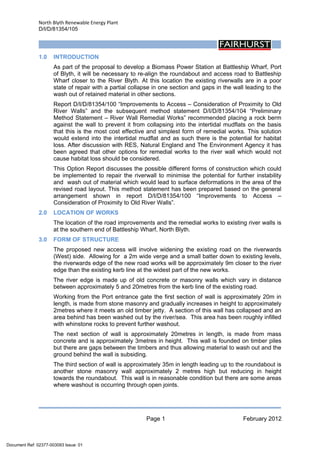

1.0 INTRODUCTION
As part of the proposal to develop a Biomass Power Station at Battleship Wharf, Port
of Blyth, it will be necessary to re-align the roundabout and access road to Battleship
Wharf closer to the River Blyth. At this location the existing riverwalls are in a poor
state of repair with a partial collapse in one section and gaps in the wall leading to the
wash out of retained material in other sections.
Report D/I/D/81354/100 “Improvements to Access – Consideration of Proximity to Old
River Walls” and the subsequent method statement D/I/D/81354/104 “Preliminary
Method Statement – River Wall Remedial Works” recommended placing a rock berm
against the wall to prevent it from collapsing into the intertidal mudflats on the basis
that this is the most cost effective and simplest form of remedial works. This solution
would extend into the intertidal mudflat and as such there is the potential for habitat
loss. After discussion with RES, Natural England and The Environment Agency it has
been agreed that other options for remedial works to the river wall which would not
cause habitat loss should be considered.
This Option Report discusses the possible different forms of construction which could
be implemented to repair the riverwall to minimise the potential for further instability
and wash out of material which would lead to surface deformations in the area of the
revised road layout. This method statement has been prepared based on the general
arrangement shown in report D/I/D/81354/100 “Improvements to Access –
Consideration of Proximity to Old River Walls”.
2.0 LOCATION OF WORKS
The location of the road improvements and the remedial works to existing river walls is
at the southern end of Battleship Wharf, North Blyth.
3.0 FORM OF STRUCTURE
The proposed new access will involve widening the existing road on the riverwards
(West) side. Allowing for a 2m wide verge and a small batter down to existing levels,
the riverwards edge of the new road works will be approximately 9m closer to the river
edge than the existing kerb line at the widest part of the new works.
The river edge is made up of old concrete or masonry walls which vary in distance
between approximately 5 and 20metres from the kerb line of the existing road.
Working from the Port entrance gate the first section of wall is approximately 20m in
length, is made from stone masonry and gradually increases in height to approximately
2metres where it meets an old timber jetty. A section of this wall has collapsed and an
area behind has been washed out by the river/sea. This area has been roughly infilled
with whinstone rocks to prevent further washout.
The next section of wall is approximately 20metres in length, is made from mass
concrete and is approximately 3metres in height. This wall is founded on timber piles
but there are gaps between the timbers and thus allowing material to wash out and the
ground behind the wall is subsiding.
The third section of wall is approximately 35m in length leading up to the roundabout is
another stone masonry wall approximately 2 metres high but reducing in height
towards the roundabout. This wall is in reasonable condition but there are some areas
where washout is occurring through open joints.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 2 February 2012

4.0 EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS
On the riverward side of the river walls, beach sand overlying bedrock has been
observed. Outcrops of rock are visible, as such, the beach sand deposit is expected to
be thin, less than 1m thick.
The area retained by the river walls has historically been reclaimed from the estuary.
Site investigation information for this area is not available, however based upon
geotechnical information from other locations within the Battleship Wharf area, the
following ground conditions to the landward side of the river walls are inferred:
Ground level to 2-3m
below ground level
Made Ground consisting of heterogeneous colliery spoil
2-3m to 4-5m below
ground level
Wind Blown Sand
Below 4-5m below
ground level
Bedrock consisting of moderately strong to strong
sandstone
Colliery spoil is likely to contain contaminants including heavy metals, sulphate,
combustible materials, high pH, Polycyclic Aromatic Hydrocarbon (PAH) and Total
Petroleum Hydrocarbon (TPH), however these contaminants tend to be present in low
concentrations with low solubility. From historical records for the area it is considered
that the fill has been in place for over 100 years and as such any leachable
concentrations of contaminants are likely to have been leached from the soil in the
intertidal groundwater zone close to the wall by tidally influenced groundwater
movement.
Land immediately north of this location is known to have been historically contaminated
by past uses as railway sidings and for ship breaking activities. The affected area was
remediated by Northumberland County Council in 1993 and as such any contamination
which may remain is likely to be localised, isolated and in low concentrations.
The tidal range in the River Blyth is:
Highest recorded +3.61m OD
Mean High Water Springs +2.44m OD
Mean Low Water Springs -1.88m OD
Lowest Recorded -3.61m OD
5.0 TECHNICAL CONSTRAINTS
To construct the remedial works the following technical challenges must be considered
in the design of the temporary and permanent works and construction methodology.
1. Existing riverwalls which potentially are unstable.
2. Working in the intertidal zone.
3. Presence of made ground which may contain low concentrations of
contamination.
4. Shallow competent bedrock.
5. Presence of wading and sea birds in the surrounding area.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 3 February 2012

6.0 OPTIONS FOR REMEDIAL WORKS
The following options for remedial works have been considered:
1. Repair to gaps in the wall and construction of a rock revetment on the riverward
side of the existing river wall.
2. Construction of a new riverwall using sheet piles immediately in front of the
existing wall.
3. Construction of a new retaining wall using sheet piles immediately to the rear of
the existing wall.
4. Construction of a new retaining wall using bored piles immediately to the rear of
the existing wall.
5. Construction of a new gravity retaining wall immediately to the rear of the
existing wall.
The form of construction and the advantages and disadvantages of each form of
construction are discussed in the sections below.
7.0 SEQUENCE OF CONSTRUCTION FOR EACH OPTION
Presented below is a brief summary of the sequence of construction for each option
considered.
7.1 Option 1 Repairs to the Existing Wall And Rock Revetment
The sequence of construction for the remedial works for the river wall is discussed
below and split into the three sections of wall identified in report D/I/D/81354/100 and
summarised in Section 3 above.
For all three sections, work will take place at low tide to prevent the disturbance of
sediments within the river, to allow access to the existing river wall to carry out the
works and also to examine the formwork for leaks.
Any joints on the inside of formwork will be taped prior to concrete pouring. The
concrete will press the tape onto the shutter when it is poured, preventing any leaks.
An anti washout additive will be added to the concrete if it is considered there will be
wave action before the concrete cures.
The final timescale will be determined during detailed engineering design for the works.
7.1.1 Section 1 – Stone Masonry Wall between Battleship Wharf and the Timber Jetty
For this section of the wall, in the area where the collapsed section has been infilled,
the following works should be undertaken:
1. Select a position for a long reach excavator to stand and work as far back from
the existing wall and area affected from wash out as possible.
2. The existing stone infill should be removed using a long reach excavator and the
stone sorted and laid out for possible reuse in the works.
3. Remove beach sand from the area in front of the collapsed wall to expose
bedrock.
4. After removal of existing infill and beach sand a filter cloth should be laid over the
exposed face of material retained behind the wall. The filter cloth should extend
vertically over all exposed retained material and horizontally across the area of
river bed which will receive armour stone. The filter cloth shall be securely fixed
into position.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 4 February 2012

5. A rock armoured revetment shall be placed in the section of collapsed wall. A
core of well graded rock shall be placed against the wall extending out at a
gradient of 30˚ down to the riverbed. A protective layer of 250mm to 500mm
armour stone shall be laid to a thickness of 750mm. As shown on Drawing
81354/1003 the armour will extend to the full height of the wall, less an allowance
for wave break.
7.1.2 Section 2 – Mass Concrete Wall between Timber Jetties
1. Remove sand from in front of the riverwall.
2. In locations where there are gaps in the timbering or the wall, erect formwork and
place concrete.
3. Select a position for a long reach excavator to stand and work as far back from
the existing wall and area affected from wash out as possible.
4. After concrete has cured a rock armoured revetment shall be placed in the
section of collapsed wall. A core of well graded rock shall be placed against the
wall extending out at a gradient of 30˚ down to the riverbed. A protective layer of
250mm to 500mm armour stone shall be laid to a thickness of 750mm.
7.1.3 Section 3 – Stone Masonry Wall between the Timber Jetty and the Staithe
1. Remove sand from in front of the riverwall.
2. In locations where there are gaps in the timbering or the wall, erect formwork and
place concrete.
3. Select a position for a long reach excavator to stand and work as far back from
the existing wall and area affected from wash out as possible.
4. After concrete has cured a rock armoured revetment shall be placed in the
section of collapsed wall. A core of well graded rock shall be placed against the
wall extending out at a gradient of 30˚ down to the riverbed. A protective layer of
250mm to 500mm armour stone shall be laid to a thickness of 750mm.
7.2 Option 2 Construction of a New Sheet Pile Wall In Front of the Existing Wall
The sequence of construction for the remedial works for the river wall for this option is
discussed below.
Due to the presence of shallow bedrock, an adequate penetration depth for the piles to
prevent instability of the wall cannot be achieved using conventional pile driving
methods. It will be necessary to cut a trench into the bedrock into which the sheet piles
will be inserted and set in place using concrete. It is anticipated that the depth of the
trench would be in the order of 2-4m below the bedrock horizon, depending on the
depth of surface weathering in the rock.
Works to excavate the trench could only be carried out during periods of low water.
Prior to breaking out of the rock to form the trench the overlying superficial deposits
would have to be removed and where necessary the existing wall would be shored to
allow excavation plant to be positioned close to the edge.
The trench would be excavated using conventional hydraulic breaker equipment
mounted on a long reach excavator. Arisings from the trench would be removed using
a long reach excavator.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 5 February 2012

After the trench is formed the sheet piles would be set into the trench and fixed in place
using mass concrete. Concrete will only be placed at low water when the top of the
trench is above the water level. An anti washout additive will be added to the concrete
to prevent migration of the concrete into the watercourse as the tide rises.
After the concrete has cured the small gap between the existing wall and the new
sheet pile wall will be infilled with either clean processed granular arisings generated
from the construction of the pile toe trench or mass concrete.
7.3 Option 3 Construction of a New Sheet Pile Wall to the Rear of the Existing Wall
The sequence of construction for the remedial works for the river wall for this option is
discussed below.
Due to the presence of shallow bedrock, an adequate penetration depth for the piles to
prevent instability of the wall cannot be achieved using conventional pile driving
methods. It will be necessary to cut a trench into the bedrock into which the sheet piles
will be inserted and set in place using concrete. It is anticipated that the depth of the
trench would be in the order of 2-4m below the bedrock horizon, depending on the
depth of surface weathering in the rock.
Works will be carried out in the intertidal zone and groundwater fluctuation matching
the state of tide can be expected.
Prior to remedial works being undertaken it will be necessary to undertake site
investigation to determine the profile of the rear of the wall, founding stratum and
chemical characteristics of the made ground to confirm:
• Any shoring works to maintain wall stability during the works.
• The potential to liberate contamination in the made ground into the water column
during the time the excavation is open.
• Determine the mitigation measures required to prevent short term contamination
of the river during construction works.
It will be necessary to construct a trench through the made ground and natural blown
sand deposits to expose the bedrock surface. The existing wall will be shored
appropriately to prevent collapse while the trench is open. On the landward side the
trench side would be battered back to a safe angle. This will expose potentially
contaminated materials at the surface of the slope which may have an increased
leachable potential due to exposure in the face of the excavation. If necessary
mitigation measures identified during the site investigation phase will be implemented
to prevent contamination. It is anticipated that, if required, this would take the form of
covering the cut face with an impermeable membrane.
Works to excavate the trench could only be carried out during periods of low water.
The trench would be excavated using conventional hydraulic breaker equipment
mounted on a long reach excavator. Arisings from the trench would be removed using
a long reach excavator.
After the trench is formed the sheet piles would be set into the trench and fixed in place
using mass concrete. Concrete will only be placed at low water when the top of the
trench is above the water level. An anti washout additive will be added to the concrete
to prevent migration of the concrete into the watercourse as the tide rises.
In Section 1 of the existing wall as identified in report D/I/D/81354/100, the existing
rock revetment would be reinstated against the new sheet pile wall.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 6 February 2012

In Sections 2 and 3 the existing wall would be tie back to the new sheet pile wall to
prevent the existing wall collapsing into the river. The form of the tied back would be
determined after inspection of the rear face of the wall to determine its condition,
however it is considered that it will include mass concrete infill between the walls
together with a tie at crest level.
7.4 Option 4 Construction of a New Bored Pile Wall to the Rear of the Existing Wall
The sequence of construction for the remedial works for the river wall for this option is
discussed below.
As an alternative to using sheet piles interlocking bored concrete piles could be utilised
to form a new retaining wall to the rear of the existing river wall. This method of
construction does not require the excavation of the superficial deposits or the
construction of a trench in the bedrock. The piles would be bored through the
superficial deposits into the rock to sufficient depth to provide an adequate factor of
safety against collapse. It is anticipated that this would be to a similar depth to as
required for the sheet piles.
In Section 1 of the existing wall as identified in report D/I/D/81354/100, the existing
rock revetment would be reinstated against the new bored pile wall.
In Sections 2 and 3 the existing wall would be tied back to the new bored pile wall to
prevent the existing wall collapsing into the river. The form of the tie back would be
determined after inspection of the rear face of the wall to determine its condition,
however it is considered that it will include mass concrete infill between the walls
together with a tie at crest level.
7.5 Option 5 Construction of a Gravity Wall to the Rear of the Existing Wall
The sequence of construction for the remedial works for the river wall for this option is
discussed below.
As an alternative to an embedded sheet pile or bored pile wall a gravity retaining wall,
constructed in mass concrete could be constructed to the rear of the existing river wall.
Based upon an assumed height of wall of 5m it is anticipated that the base of the wall
would be approximately 3m wide. The rear face would be tapered or stepped to give
an assumed wall thickness at the crest of the wall of 1m.
Works will be carried out in the intertidal zone and groundwater fluctuation matching
the state of tide can be expected.
Prior to remedial works being undertaken it will be necessary to undertake site
investigation to determine the profile of the rear of the wall, founding stratum and
chemical characteristics of the made ground to confirm:
• Any shoring works to maintain wall stability during the works.
• The potential to liberate contamination in the made ground into the water column
during the time the excavation is open.
• Determine the mitigation measures required to prevent short term contamination
of the river during construction works.
It will be necessary to excavate through the made ground and natural blown sand
deposits to expose the bedrock surface. The existing wall will be shored appropriately
to prevent collapse while the trench is open. On the landward side the trench side
would be battered back to a safe angle. This will expose potentially contaminated
materials at the surface of the slope which may have an increased leachable potential
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 7 February 2012

due to exposure in the face of the excavation. If necessary, mitigation measures
identified during the site investigation phase will be implemented to prevent
contamination. It is anticipated that, if required, this would take the form of covering the
cut face with an impermeable membrane.
Works to excavate the work area could only be carried out during periods of low water.
After the rock surface has been exposed localised breaking out will take place to level
the surface and remove any loose materials. Once the surface has been prepared,
formwork will be erected into which the concrete will be placed. Any joints on the inside
of formwork will be taped prior to concrete pouring. The concrete will press the tape
onto the shutter when it is poured, preventing any leaks. As the concrete will be
contained within the formwork it is not considered that an anti washout additive will be
required.
After the concrete has been cured the formwork will be removed. And the excavated
area will be infilled with the original arisings. Surplus arisings will either be reused
within the main works or disposed of off site.
In Section 1 of the existing wall as identified in report D/I/D/81354/100, the existing
rock revetment would be reinstated against the new gravity wall.
In Sections 2 and 3 the existing wall would be tied back to the new gravity wall to
prevent the existing wall collapsing into the river. The form of the tied back would be
determined after inspection of the rear face of the wall to determine its condition,
however it is considered that it will include mass concrete infill between the walls
together with a tie at crest level.
8.0 ESTIMATED BUDGETARY COSTS
For the options considered, the estimated costs are presented below:
8.1 Option 1 - Repair to gaps in the wall and construction of a rock revetment on the
riverward side of the existing river wall
For this costing the following assumptions have been made.
• The length of wall to be treated is 75m.
• The average cross section of the revetment is 3m high x 9m wide with a cross
sectional area of 13.5m2
.
• Revetment will be constructed from locally sourced Whinstone.
• Method Related Charges and Preliminaries include for intertidal working and
minor operations.
• A provisional sum of £10,000 has been allowed for localised repairs to wall.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 8 February 2012

Principal Items Quantity Rate Cost
Supply Rock for revetment 1015m3
£50/m3
£50,750
Supply and place filter cloth 2025m2
£5/m2
£10,125
Repairs to existing wall - Prov. Sum. £10,000
Lay revetment 1015m3
£10/m3
£10,150
Sub total £81,025
Method Related Charges and
Preliminaries (25%)
£20,275
Total £101,300
8.2 Option 2 - Construction of a new riverwall using sheet piles immediately in front
of the existing wall
For this costing the following assumptions have been made.
• The length of wall to be treated is 75m.
• The depth of embedment will be a worst case of 5m.
• Sheet piles will be AZ36 section (170kg/m2
).
• The average retained height is 3m. As such, the area of piles required is 600m2
and the tonnage is 102 tonnes.
• The gap between the piles and the wall will be filled with marine grade concrete
containing an anti segregation admixture.
• A provisional sum of £25,000 has been allowed for localised stabilisation of the
wall whilst the trench to receive the sheet piles is excavated.
• The piles will be set into the trench and concreted in place using marine grade
concrete containing an anti segregation admixture.
• Method Related Charges and Preliminaries include for intertidal working and
minor operations.
• Arisings from trench excavation can be disposed of as inert material.
Principal Items Quantity Rate Cost
Temporary works to stabilise wall
during trench excavation
Prov sum £25,000
Excavate trench 5m deep x 0.5m wide 200m3
£25/m3
£5,000
Supply and pitch piles 102 tonnes £1000/tonne. £102,000
Concrete infill to trench 200m3
£100/m3
£20,000
Concrete infill between piles and wall 80m3
£100/m3
£8,000
Dispose of arisings from trench
excavation
200/m3
£40/m3
£8,000
Sub total £168,000
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 9 February 2012

Method Related Charges and
Preliminaries (25%)
£42,000
Total £210,000
8.3 Option 3 - Construction of a new retaining wall using sheet piles immediately to
the rear of the existing wall
For this costing the following assumptions have been made.
• The length of wall to be treated is 75m.
• The depth of embedment will be a worst case of 5m.
• Sheet piles will be AZ36 section (170kg/m2
).
• The average retained height is 3m. As such, the area of piles required is 600m2
and the tonnage is 102 tonnes.
• A provisional sum of £25,000 has been allowed for localised stabilisation of the
wall whilst the trench to receive the sheet piles is excavated.
• A provisional sum of £10,000 has been allowed for slope protection to the rear
of the wall.
• The piles will be set into the trench and concreted in place using marine grade
concrete containing an anti segregation admixture.
• Method Related Charges and Preliminaries include for intertidal working and
minor operations.
• Arisings from trench excavation can be disposed of as inert material. There will
be no arisings from the excavations from the rear of the wall.
Principal Items Quantity Rate Cost
Temporary works to stabilise wall
during trench excavation
Prov sum £25,000
Excavate working area to rear of wall,
5m wide with a back slope of 1 in 1.
£1,500m3
£2/m3
£3,000
Excavate trench 5m deep x 0.5m wide 200m3
£25/m3
£5,000
Supply and pitch piles 102 tonnes £1000/tonne. £102,000
Concrete infill to trench 200m3
£100/m3
£20,000
Tie wall to piles 75m £25/m £1,875
Dispose of arisings from trench
excavation
200/m3
£40/m3
£8,000
Reinstate fill to rear of wall £1,500m3
£3.50/m3
£5,250
Sub total £170,125
Method Related Charges and
Preliminaries (25%)
£42,575
Total £212,700
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 10 February 2012

8.4 Option 4 - Construction of a new retaining wall using bored piles immediately to
the rear of the existing wall.
For this costing the following assumptions have been made.
• The length of wall to be treated is 75m.
• The depth of embedment will be a worst case of 5m.
• The piles will be bored and 300mm in diameter at 450mm spacing. The
concrete will be marine grade. No of piles required 167 with an average length
of 8m.
• A piling platform will not be required.
• Arisings from superficial deposits can be reused to level site.
• Method Related Charges and Preliminaries include for intertidal working and
minor operations.
• Arisings from sandstone excavation can be disposed of as inert material. The
arisings from superficial soils will be disposed of as non-hazardous material.
Principal Items Quantity Rate Cost
Install interlocking bored piles 167 nr £750 / pile. £125,250
Tie wall to piles 75m £25/m £1,875
Construct Capping Beam 20m3
£250/m3
£5,000
Dispose of arisings as inert fill 180/m3
£40/m3
£7,200
Sub total £139,325
Method Related Charges and
Preliminaries (25%)
£34,875
Total £174,200
8.5 Option 5 - Construction of a new gravity retaining wall immediately to the rear of
the existing wall.
For this costing the following assumptions have been made.
• The length of wall to be treated is 75m.
• The average retained height is 4m including foundation depth. As such, the
base of the wall will be approximately 3m wide stepped to 1m wide at top.
Cross sectional are of wall is 7.8m2
.
• A provisional sum of £25,000 has been allowed for localised stabilisation of the
wall whilst excavation at rear is open.
• A provisional sum of £10,000 has been allowed for slope protection to the rear
of the wall.
• The wall will be constructed fusing marine grade concrete.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 11 February 2012

• Method Related Charges and Preliminaries include for intertidal working and
minor operations.
• Arisings from excavation can be disposed of as non-hazardous material.
Principal Items Quantity Rate Cost
Temporary works to stabilise wall
during trench excavation
Prov sum £25,000
Excavate working area to rear of wall,
5m wide with a back slope of 1 in 1.
£1,500m3
£2/m3
£3,000
Construct mass gravity wall 585m3
£130/m3
. £76,050
Tie wall to piles 75m £25/m £1,875
Dispose of arisings as inert fill 585m3
£40/m3
£23,400
Reinstate fill to rear of wall £915m3
£3.50/m3
£3,200
Sub total £132,525
Method Related Charges and
Preliminaries (25%)
£33,175
Total £165,700
8.6 Cost Summary
The preliminary budget costing presented above is summarised as follows:
Option Estimated Cost
Repair to gaps in the wall and construction of a rock revetment on
the riverward side of the existing river wall.
£101,300
Construction of a new riverwall using sheet piles immediately in front
of the existing wall.
£210,000
Construction of a new retaining wall using sheet piles immediately to
the rear of the existing wall.
£212,700
Construction of a new retaining wall using bored piles immediately to
the rear of the existing wall.
£174,200
Construction of a new gravity retaining wall immediately to the rear of
the existing wall.
£165,700

Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 0 February 2012

9.0 ADVANTAGES AND DISADVANTAGES FOR EACH OPTION
Presented in the table below are the disadvantages and advantages of each option considered in relation to each other.
Option Advantage Disadvantage
1 Repairs to the Existing Wall And
Rock Revetment
Lowest cost solution
Quick to Install
Lowest potential noise disturbance
Will not require excavation into potential
contaminated fill
Requires land take in intertidal mudflats
2 Construction of a New Sheet
Pile Wall In Front of the Existing
Wall
Will provide new river wall in front of
existing as such, no tie back arrangements
needed.
Will not require excavation into potential
contaminated fill.
Requires land take in intertidal mudflats
Disturbance of river sediments in vicinity of
the works required.
Excavation could have destabilising effect
on wall and shoring required.
Excavation of trench will require hydraulic
breaker. Noise is likely to disturb birds and
vibration may disturb aquatic life
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 1 February 2012

Option Advantage Disadvantage
3 Construction of a New Sheet
Pile Wall to the Rear of the
Existing Wall
Does not require works in the river. Excavation work has potential to expose
contaminated materials at surface with
surface water contamination mitigation
required.
Excavation could have destabilising effect
on wall and shoring required.
Excavation of trench will require hydraulic
breaker. Noise is likely to disturb birds and
vibration may disturb aquatic life.
Tie back to existing wall could present
difficult details
4 Construction of a New Bored
Pile Wall to the Rear of the
Existing Wall
Does not require works in the river.
Does not require excavation works
through potentially contaminated fill.
Low noise and vibration operation.
Tie back to existing wall could present.
Potential contaminated arisings will require
disposal.
5 Construction of a Gravity Wall to
the Rear of the Existing Wall
Does not require works in the river.
Low noise and vibration operation.
Excavation work has potential to expose
contaminated materials at surface with
surface water contamination mitigation
required.
Excavation could have destabilising effect
on wall and shoring required.
Tie back to existing wall could present
difficult details
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/105
Page 0 February 2011

10.0 SUMMARY
It will be necessary to re-align the roundabout and access road to Battleship
Wharf closer to the River Blyth. At this location the existing riverwalls are in a
poor state of repair with a partial collapse in one section and gaps in the wall
leading to the wash out of retained material in other sections.
The following options for remedial works have been considered:
1. Repair to gaps in the wall and construction of a rock revetment on the
riverward side of the existing river wall.
2. Construction of a new riverwall using sheet piles immediately in front of
the existing wall.
3. Construction of a new retaining wall using sheet piles immediately to the
rear of the existing wall.
4. Construction of a new retaining wall using bored piles immediately to the
rear of the existing wall.
5. Construction of a new gravity retaining wall immediately to the rear of the
existing wall.
To summarise the advantages and disadvantages of each option:
• Of the options considered, Option 1 Repairs to the Existing Wall And
Rock Revetment would present the lowest cost and simplest solution.
However there is the significant disadvantage that land take in the
intertidal mudflats would be required.
• Option 4 Construction of a New Bored Pile Wall to the Rear of the
Existing Wall would provide a simple solution which has the lowest
potential environmental impact in terms of risk of exposing potential
contaminated materials, noise, vibration.
• Option 5 present the simplest form of construction for a new wall located
behind the existing river wall. However, it does have the disadvantage
that it will be necessary to expose potentially contaminated materials and
there will be a requirement to dispose of potentially contaminated
arisings.
As such, if work within the intertidal mudflats were to be permitted then the
option to construct a rock revetment would present the simplest and most cost
effective solution. However, if this will not be permitted then the construction of
a concrete wall to the rear of the existing wall would present the most cost
effective solution. Although slightly more expensive the bored pile wall would be
the least risk option in terms of risk of pollution to the River Blyth as it would not
require a large surface area of potentially contaminated material to be opened
up to intertidal river water
Document Ref: 02377-003093 Issue: 01

www.fairhurst.co.uk
Aberdeen
Birmingham
Bristol
Dundee
Edinburgh
Elgin
Glasgow
Inverness
Leeds
London
Manchester
Newcastle upon Tyne
Sheffield
Watford
Wellesbourne
CIVIL ENGINEERING • STRUCTURAL ENGINEERING • TRANSPORTATION • ROADS & BRIDGES
PORTS & HARBOURS • GEOTECHNICAL & ENVIRONMENTAL ENGINEERING • PLANNING &
DEVELOPMENT • WATER SERVICES • CDM COORDINATOR SERVICES
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
SKM Enviros
I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx
PAGE 18
Appendix B: Preliminary Outline Method Statement
for other Remedial Options- Riverwall
Remedial Works, D/I/D/81354/10
Document Ref: 02377-003093 Issue: 01
Preliminary Outline Method
Statement – Riverwall Remedial
Works
September 2011
RES
North Blyth Renewable
Energy Plant
D/I/D/81354/104
Document Ref: 02377-003093 Issue: 01
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/104
CONTENTS
1.0 INTRODUCTION....................................................................................................... 1
2.0 LOCATION OF WORKS ........................................................................................... 1
3.0 FORM OF STRUCTURE........................................................................................... 1
4.0 EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS .................... 1
5.0 TECHNICAL CONSTRAINTS ................................................................................... 2
6.0 SEQUENCE OF CONSTRUCTION........................................................................... 2
APPENDIX A DRAWINGS
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/104
Page 1 February 2011
1.0 INTRODUCTION
As part of the proposal to develop a Biomass Power Station at Battleship Wharf, Port
of Blyth, it will be necessary to re-align the roundabout and access road to Battleship
Wharf closer to the River Blyth. At this location the existing riverwalls are in a poor
state of repair with a partial collapse in one section and gaps in the wall leading to the
wash out of retained material in other sections.
This preliminary outline method statement discusses the works required to repair the
riverwall to minimise the potential for further instability, wash out of material which
would lead to surface deformations in the area of the revised road layout in this area.
This method statement has been prepared based on the recommendations of report
D/I/D/81354/100 “Improvements to Access – Consideration of Proximity to Old River
Walls”.
This method statement has been prepared to discuss the technical procedures and
sequence of works for the installation of the river wall remedial works. Health, safety
and environmental requirements, design and construction quality assurance
procedures, regulatory liaison and liaison with third parties are not included in this
method statement.
2.0 LOCATION OF WORKS
The location of the road improvements and the remedial works to existing river walls is
at the southern end of Battleship Wharf, North Blyth.
3.0 FORM OF STRUCTURE
The proposed new access will involve widening the existing road on the riverwards
(West) side. Allowing for a 2m wide verge and a small batter down to existing levels
,the riverwards edge of the new road works will be approximately 9m closer to the river
edge than the existing kerb line at the widest part of the new works.
The river edge is made up of old concrete or masonry walls which vary in distance
between about 5 and 20metres from the kerb line of the existing road.
Working from the Port entrance gate the first section of wall is approximately 20m in
length, is made from stone masonry and gradually increases in height to about
2metres where it meets an old timber jetty. A section of this wall has collapsed and an
area behind has been washed out by the river/sea. This area has been roughly infilled
with whinstone rocks to prevent further washout.
The next section of wall is approximately 20metres in length, is made from mass
concrete and is approximately 3metres in height. This wall is founded on timber piles
but there are gaps between the timbers and thus allowing material to wash out and the
ground behind the wall is subsiding.
The third section of wall leading up to the roundabout is another stone masonry wall
approximately 2 metres high but reducing in height towards the roundabout. This wall
is in reasonable condition but there are some areas where washout is occurring
through open joints.
4.0 EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS
On the riverward side of the river walls beach sand overlying bedrock has been
observed. Outcrops of rock are visible, as such, the beach sand deposit is expected to
be thin, less than 1m thick.
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/104
Page 2 February 2011
The tidal range in the River Blyth is:
Highest recorded +3.61m OD
Mean High Water Springs +2.44m OD
Mean Low Water Springs -1.88m OD
Lowest Recorded -3.61m OD
5.0 TECHNICAL CONSTRAINTS
To construct the intake the following technical challenges must be considered in the
design of the temporary and permanent works and construction methodology.
1. Existing riverwalls which potentially are unstable.
2. Working in the intertidal zone.
6.0 SEQUENCE OF CONSTRUCTION
The sequence of construction for the remedial works for the river wall is discussed
below and split into the three sections of wall identified in report D/I/D/81354/100 and
summarised in Section 3 above. Proposals are shown on Drawing 81354/1003.
For all three sections work will take place at states of low tide to prevent the
disturbance of sediments within the river, to allow access to the existing river wall to
carry out the works and also to examine the shuttering for leaks.
Any joints on the inside of shuttering will be taped prior to concrete pouring. The
concrete will press the tape onto the shutter when it is poured, preventing any leaks.
An anti washout additive will be added to the concrete if it is considered there will be
wave action before the concrete cures.
The final timescale will be determined during detailed engineering design for the works.
6.1 Section 1 – Stone Masonry Wall between Battleship Wharf and the Timber Jetty
For this section of the wall, in the area where the collapsed section has been infilled,
the following works should be undertaken:
1. Select a position for a long reach excavator to stand and work which is as far
back from the existing wall and area affected from wash out as possible.
2. The existing stone infill should be removed using a long reach excavator and the
stone sorted and laid out for possible reuse in the works.
3. Remove beach sand from the area in front of the collapsed wall to expose
bedrock.
4. After removal of existing infill and beach sand a filter cloth should be laid over the
exposed face of material retained behind the wall. The filter cloth should extend
vertically over all exposed retained material and horizontally across the area of
river bed which will receive armour stone. The filter cloth shall be securely fixed
into position.
5. A rock armoured revetment shall be placed in the section of collapsed wall. A
core of well graded rock shall be placed against the wall extending out at a
gradient of 30˚ down to the riverbed. A protective layer of 250mm to 500mm
armour stone shall be laid to a thickness of 750mm. As shown on Drawing
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/104
Page 3 February 2011
81354/1003 the armour will extend to the full height of the wall, less an allowance
for wave break.
6.2 Section 2 – Mass Concrete Wall between Timber Jetties
1. Remove sand from in front of the riverwall.
2. In locations where there are gaps in the timbering or the wall, erect formwork and
place concrete.
3. Select a position for a long reach excavator to stand and work which is as far
back from the existing wall and area affected from wash out as possible.
4. After concrete has cured a rock armoured revetment shall be placed in the
section of collapsed wall. A core of well graded rock shall be placed against the
wall extending out at a gradient of 30˚ down to the riverbed. A protective nayer of
250mm to 500mm armour stone shall be laid to a thickness of 750mm..
6.3 Section 3 – Stone Masonry Wall between the Timber Jetty and the Staithe
1. Remove sand from in front of the riverwall.
2. In locations where there are gaps in the timbering or the wall, erect formwork and
place concrete.
3. Select a position for a long reach excavator to stand and work which is as far
back from the existing wall and area affected from wash out as possible.
4. After concrete has cured a rock armoured revetment shall be placed in the
section of collapsed wall. A core of well graded rock shall be placed against the
wall extending out at a gradient of 30˚ down to the riverbed. A protective nayer of
250mm to 500mm armour stone shall be laid to a thickness of 750mm..
Document Ref: 02377-003093 Issue: 01
North Blyth Renewable Energy Plant
D/I/D/81354/104
February 2011
APPENDIX A
DRAWINGS
Document Ref: 02377-003093 Issue: 01
Document Ref: 02377-003093 Issue: 01
www.fairhurst.co.uk
Aberdeen
Birmingham
Bristol
Dundee
Edinburgh
Elgin
Glasgow
Inverness
Leeds
London
Manchester
Newcastle upon Tyne
Sheffield
Watford
Wellesbourne
CIVIL ENGINEERING • STRUCTURAL ENGINEERING • TRANSPORTATION • ROADS & BRIDGES
PORTS & HARBOURS • GEOTECHNICAL & ENVIRONMENTAL ENGINEERING • PLANNING &
DEVELOPMENT • WATER SERVICES • CDM COORDINATOR SERVICES
Document Ref: 02377-003093 Issue: 01

15.2.2 bored pile wall - method statement

  • 1.
    NORTH BLYTH BIOMASS PROJECT RIVERWALL REPAIR WORKS - REMEDIAL SECANT PILE WALL METHOD STATEMENT 14 June 2012 Document Ref: 02377-003093 Issue: 01
  • 2.

    The SKM logotrade mark is a registered trade mark of Sinclair Knight Merz Pty Ltd. NORTH BLYTH BIOMASS PROJECT RIVER WALL REPAIR WORKS - REMEDIAL SECANT PILE WALL METHOD STATEMENT 14 June 2012 SKM Enviros Enviros House Shrewsbury Business Park Sitka Drive Shrewsbury Shropshire SY2 6LG Tel: +44 (0)1743 284 800 Fax: +44 (0) 1743 245 558 Web: www.skmenviros.com COPYRIGHT: The concepts and information contained in this document are the property of Sinclair Knight Merz (Europe) Ltd. Use or copying of this document in whole or in part without the written permission of Sinclair Knight Merz (Europe) Ltd constitutes an infringement of copyright. LIMITATION: This report has been prepared on behalf of and for the exclusive use of Sinclair Knight Merz (Europe) Ltd’s Client, and is subject to and issued in connection with the provisions of the agreement between Sinclair Knight Merz (Europe) Ltd and its Client. Sinclair Knight Merz (Europe) Ltd accepts no liability or responsibility whatsoever for or in respect of any use of or reliance upon this report by any third party. Document Ref: 02377-003093 Issue: 01
  • 3.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE i Contents 1.  Introduction 1  1.1.  Background to the Works 1  1.2.  Scope of this Outline Method Statement 2  2.  Location of the Works 3  3.  Topography, Ground Conditions, Hydrogeology and Hydrology 4  3.1.  Data Source 4  3.2.  Topography 4  3.3.  Ground Conditions 4  3.4.  Hydrogeology 5  3.5.  Hydrology 5  4.  Existing River Walls 6  5.  The Selected Design Options 9  5.1.  Summary of Selected Options 9  5.2.  The Secant Pile Wall 9  5.3.  River Wall Reinstatement and Tie-back 10  6.  Sequence and Methods of Construction 11  6.1.  Considerations for Piling Activities 11  6.2.  Overall Sequence of Construction 11  6.3.  Construction Methods for the Bored Secant Pile Wall 12  6.4.  Construction Methods for the Remediation of the Old River Walls 12  6.5.  Contractor’s Compound 13  7.  Mitigation Measures to be employed during the works 14  Drawings 16  Appendix A: Options Report – Riverwall Remedial Works, D/I/D/81354/10517  Appendix B: Preliminary Outline Method Statement for other Remedial Options- Riverwall Remedial Works, D/I/D/81354/10 18  Document Ref: 02377-003093 Issue: 01
  • 4.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE ii Document history and status Revision Date issued Reviewed by Approved by Date approved Revision type 1 25/06/2012 DB MDF 25/06/2012 Initial Draft 2 02/07/2012 DB MDF 02/07/2012 Final Draft 3 03/07/2012 RLT MDF 03/07/2012 FINAL Distribution of copies Revision Copy no Quantity Issued to 1 1 1 RES 2 1 1 RES 3 1 1 RES Printed: 3 July 2012 Last saved: 3 July 2012 09:27 AM File name: I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx Author: Richard Thomas Project manager: Matt Faulkner Name of organisation: RES Name of project: North Blyth Biomass Project Name of document: River Wall Method Statement Document version: Final Project number: JW30086 Document Ref: 02377-003093 Issue: 01
  • 5.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx 1. Introduction 1.1. Background to the Works North Blyth Energy Ltd (NBEL), a wholly owned subsidiary of RES UK & Ireland (RES) is seeking consent under the Planning Act 2008 (referred to hereafter as the PA 2008) to construct and operate the North Blyth Renewable Energy Project (referred to hereafter as the Project), which has an electrical export of approximately 99.9 Megawatts of Electricity (MWe) and is located at Battleship Wharf, Port of Blyth, Northumberland. NBEL has submitted an application under Section 31 of the PA 2008 for a Development Consent Order (DCO) to the Planning Inspectorate (PINS) for the Project. This document provides a method statement describing improvement works that will be required at the existing Port of Blyth site entrance to ensure vehicles from the Project do not impede Port of Blyth vehicles or other road users. This will include widening of the existing access road which leads from the adjacent, North Blyth roundabout that will in turn require repair to the existing river wall. The widening will take place on the riverward side of the road. The adjacent river walls are in a poor state of repair and therefore associated remedial support measures are required to support the ground adjacent to the new road alignment and, thus, to enable road widening to take place. It was initially proposed to seal the walls with concrete, to prevent further washout, and to place rock armour against them to prevent collapse. This option provides the quickest and lowest cost construction option for the works, low noise disturbance and would not require any excavation within the potentially contaminated fill material behind the existing river wall. Discussions with Natural England, the Environment Agency and the MMO highlighted that the use of rock armour would result in the loss of Biodiversity Action Plan habitat (mudflat) from the River Blyth Estuary. As a result of feedback from consultees, a number of alternative construction techniques were considered for the works. The selected solution is a bored secant (interlocking) pile wall, constructed on the landward side of, and generally parallel to the existing river wall, at a distance of the order of 4.0 to 4.5m from it. The “interlocking” is achieved by drilling and forming the piles in an appropriate overlapping sequence. Further background is provided in the report to RES, D/I/D/81354/105 “Options Report – Riverwall Remedial Works” of February 2012 that was prepared by Fairhurst to inform the selection of a construction technique that would not result in unacceptable loss of intertidal mudflats. This report is provided within Appendix A of this report. Document Ref: 02377-003093 Issue: 01
  • 6.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 2 1.2. Scope of this Outline Method Statement This outline method statement relates to the secant (interlocking) pile wall installation, together with related works to reduce the potential for further instability in the existing river walls and to minimise wash out of material from the existing river wall. The method statement has been prepared in consideration of the Options Report provided in Appendix A and the requirement to cause no loss of mudflat habitat. No reference is made to Health and Safety requirements, design, construction quality assurance, regulatory liaison and liaison with third parties. Document Ref: 02377-003093 Issue: 01
  • 7.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 3 2. Location of the Works The location and layout of the works are shown on Figure 1 with an aerial photograph of the works area provided in Figure 2. The remedial works location is at the southern end of Battleship Wharf, North Blyth. The works will take place entirely within the Application Boundary, as defined within the DCO Application that has been submitted by NBEL. Document Ref: 02377-003093 Issue: 01
  • 8.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 4 3. Topography, Ground Conditions, Hydrogeology and Hydrology 3.1. Data Source The following geological and related data are reproduced from the report, reference D/I/D/81354/105 “Options Report – Riverwall Remedial Works” of February 2012 that is provided in Appendix A. 3.2. Topography Comparatively shallow slopes are present on the landward side of the existing river wall, beyond these the topography is reasonably flat. Beyond the line of the walls the slopes extend down to the channel of the River Blyth. 3.3. Ground Conditions The area retained by the river walls historically has been reclaimed from the estuary. Site investigation information for this area is not available, but based on geotechnical information from other locations in the Battleship Wharf area, ground conditions to the landward site of the river walls have been inferred and are as tabulated below:- Ground level to 2 – 3m below ground level Made Ground consisting of heterogeneous colliery spoil 2 – 3m to 4 – 5m below ground level Wind-blown Sand Greater than 4 – 5m below ground level Bedrock comprising moderately strong to strong sandstone Colliery spoil is likely to contain contaminants including heavy metals, sulphate, combustible materials, high pH, Polycyclic Aromatic Hydrocarbon (PAH) and Total Petroleum Hydrocarbon (TPH), however these contaminants tend to be present in low concentrations with low solubility. From historical records of the area it is considered that the fill has been in place for over 100 years and that any leachable concentrations of contaminants are likely to have been leached from the soil in the intertidal groundwater zone close to the wall by tidally influence groundwater movement. Land immediately north of this location is known to have been contaminated by past uses as railway sidings and for ship breaking. The affected area was remediated by Northumberland County Council in 1993, hence any contamination which may remain is likely to be localised and in low concentrations. (Chapter 15 Hydrogeology, Geology, Ground Conditions and Soils of the Environmental Statement (ES), that has been submitted to PINS alongside the DCO application provides further information on contamination). Document Ref: 02377-003093 Issue: 01
  • 9.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 5 On the riverward side of the river walls, sand overlying bedrock can be observed. As outcrops of rock are visible, it is likely that beach sand deposits in this location are typically less than the order of 1m thick. 3.4. Hydrogeology Groundwater levels behind the existing river walls and in the vicinity of the proposed secant pile wall are in a zone which is influenced by tidal conditions. 3.5. Hydrology The tidal range in the River Blyth is:- Highest recorded +3.61m OD Mean High Water Spring Tides +2.44m OD Mean Low Water Spring Tides -1.88m OD Lowest Recorded -3.61m OD Document Ref: 02377-003093 Issue: 01
  • 10.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 6 4. Existing River Walls The nature of the existing river walls was described in the Fairhurst report “Preliminary Outline Method Statement - Riverwall Remedial Works”, Ref, D/I/D/81354/10 dated September 2011 and provided in Appendix B, as follows. The river edge is made up of old concrete and masonry walls which vary in distance between about 5m and 20m from the kerb line of the existing road. An inspection of the river walls was carried out by Fairhurst during the low tide period on 8th Feb 2011. Working from the Port entrance gate, the first section of wall (labelled Wall Section 1 on Figure 1) is approximately 20m long, is constructed from stone masonry and gradually increases in height to about 2m where it meets and old timber jetty. A section of wall has collapsed and an area behind has been washed out by the river/sea, as shown in Photograph 1. This area has been roughly infilled with whinstone rocks to prevent further washout. Photograph 1: View looking north west showing area of collapse within Wall Section 1 on right hand side of the frame The next section (labelled Wall Section 2 on Figure 1) of wall is approximately 20m long, is constructed in mass concrete and is approximately 3m high. The wall is founded on timber piles but there are gaps between the timbers, thus allowing material to wash out. Consequently, the ground behind the wall is subsiding. Document Ref: 02377-003093 Issue: 01
  • 11.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 7 Photograph 2: View looking west showing Wall Section 2 The third section of wall (labelled Wall Section 3 on Figure 1) leading up to the vicinity of the roundabout is another stone masonry wall approximately 3m high but reducing in height towards the roundabout. This wall is in reasonable condition but there are some areas where washout is occurring through open joints. Document Ref: 02377-003093 Issue: 01
  • 12.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 8 Photograph 3: View looking east showing Wall Section 3 Photograph 3: View looking west showing Wall Section 3 Document Ref: 02377-003093 Issue: 01
  • 13.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 9 5. The Selected Design Options 5.1. Summary of Selected Options The selected option to provide support to the widened road and immediately adjacent land, without causing a loss of mudflat habitat, is the installation of a bored secant (interlocking) pile wall, constructed on the landward side of and generally parallel to the existing river wall, at a distance of the order of 4.0 to 4.5m from it. Whilst being more expensive than the original proposals involving the use of rock armour, this option does not require excavation of potentially contaminated materials, does not result in any loss of mudflat habitat and the use of bored piles reduces the potential for noise and vibration impacts to occur. Chapter 3 of the ES that has been submitted to PINS alongside the DCO application provides further detail regarding the choice of this option over other methods described within Appendix A. Associated work will include the provision of measures which will reduce washout through the existing wall, together with the tying back of the existing wall to the secant pile wall. 5.2. The Secant Pile Wall The secant wall option requires the minimum excavation of in situ soils, since the volume excavated corresponds to the pile diameter and length and no additional excavation is required to facilitate the construction of this remedial support measure for the access road widening. The proposed Secant Pile Wall will be approximately 55m in length, located approximately 4.0 – 4.5m on the landward side of the existing river walls and is anticipated to employ piles up to 500mm in diameter. Figure 3 provides an indicative cross section of the proposed secant pile wall. The piles will be bored through the superficial deposits into the sandstone bedrock to sufficient depth to provide an adequate factor of safety against movement, should any further erosion or local collapse of part of the existing river walls occur. Subject to detail design, it is anticipated that the piles would need to extend 2 to 4m below the bedrock horizon, depending on the depth of surface weathering in the rock. With the expected ground conditions summarised in Section 3.3, this would provide an overall depth below the existing ground level of 7 to 9m, subject to detailed design. Subject to detail design, local provision will be made to prevent the build-up of groundwater behind the wall, where appropriate. Assuming the use of 500mm piles with a 10% overlap, an overall wall length of 55m and depth of 8m below ground level, it is estimated that the works will generate approximately 190 m3 of soils and rock arisings (Section 7.1 describes how arisings will be managed). The use of bored piles will significantly reduce the potential noise and vibration levels arising from the works when compared with sheet piling or other percussive piling techniques. The piling will conform to the restrictions on piling described in Chapter 4, Section 4.5.80 of the ES that has been submitted to PINS alongside the DCO application. Document Ref: 02377-003093 Issue: 01
  • 14.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 10 5.3. River Wall Reinstatement and Tie-back The western section (Wall Section 1 as shown on Figure 1) of the existing river wall constructed from stone masonry between Battleship Wharf and the timber jetty will be reinstated against the new bored pile wall following its installation. The remaining sections of mass concrete wall and stone masonry wall between the timber jetties and the staithes will be tied back to the new bored pile wall to prevent the existing wall collapsing into the river. The form of the tie-back will be determined after inspection of the rear face of the river walls to establish their condition. However, it is considered the most likely options to achieve tie-back would include mass concrete infill between the walls together with either a tie at crest level or the use of bolts drilled through selected blocks to tie back the existing wall into the propose secant pile wall. Local mass concrete works will be carried out immediately against the timber piles of the second section of wall to minimise washout of material. Subject to detail design, local provision such as weep holes containing or backed by a filter medium, will be made in walls to prevent the build-up of groundwater behind walls, where appropriate. Document Ref: 02377-003093 Issue: 01
  • 15.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 11 6. Sequence and Methods of Construction 6.1. Considerations for Piling Activities In order to mitigate potential impacts from piling noise on nearby sensitive ornithological receptors, it is proposed that the noise from piling activities during the winter (October to March) is limited to 55 dB(A) LA Max or below at sensitive ornithological receptors unless otherwise agreed with Northumberland County Council and Natural England. It is proposed that no piling works be commenced until a Piling Method Statement has been submitted to and approved by Northumberland County Council in consultation with Natural England, the Environment Agency and the MMO. The method statement will be informed by the detailed design stage and further geotechnical site investigation. It is intended that this will be a Requirement of the DCO and will inform the method of piling to be used during construction, the mitigation measures that will be employed to reduce the impact of piling upon aquatic and marine animals and the method of measuring piling noise at the Special Protection Area on the beach and Cambois coal staithes within the River Blyth Estuary to the northwest of the Project. The piling method statement will also consider any potential impacts upon groundwater. (Chapter 15 Hydrogeology, Geology, Ground Contamination and Soils of the ES that accompanies the DCO application, assesses existing Made Ground and superficial deposits to be granular in nature and therefore natural migration of contaminants is understood not to be restricted and that piling operations cannot introduce additional potential pathways to lower water bodies). 6.2. Overall Sequence of Construction Installation of the bored secant pile wall will commence first and remedial works to the existing river walls,which require temporary excavation behind them, will commence later in stages as sections of the secant pile wall concrete gain sufficient strength. This is so that the secant pile wall will provide stability as sequential, limited lengths of excavation are carried out behind the existing river walls, to facilitate their stabilisation and tie-back, together with the construction of measures to reduce wash-out. Local mass concrete works in front of the second section of wall, necessary to reduce washout from between timber piles can be carried out at any time during the works. These works will be carried out prior to the works required for the proposed new access to Battleship Wharf that will involve widening the existing road on the riverwards side. It is anticipated that the construction activities for the installation of the secant pile wall and remedial works to the existing river walls can be conducted without impeding the existing North Blyth roundabout. However, if this is not possible then a temporary road diversions, such as the temporary lane closure required for the site access realignment works, may be required during the installation of the bored piles. Document Ref: 02377-003093 Issue: 01
  • 16.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 12 6.3. Construction Methods for the Bored Secant Pile Wall The bored piles are excavated by means of a mechanical auger. The auger is advanced through soils within a casing, to prevent collapse of soils during the drilling process. On completion of excavation, the reinforcement cage is installed in the bore and concrete is placed. Any casing used in the installation is withdrawn as the concrete is placed. The piles are constructed in an overlapping, sequential basis to form the secant pile wall. Although the use of casing will reduce any seepage of groundwater into the bore, it is possible that potentially contaminated groundwater could collect within the bore prior to the concrete being poured. If the bore does fill with significant quantities of groundwater, suitable bunding (such as sandbags), will be placed around the work area to contain any water displaced during the pouring of concrete. Any contained, potentially contaminated groundwater will then be transferred to a tanker for treatment offsite at a suitable licensed facility. If it is sediment within the water that is suspected of being contaminated then settlement tanks will be used to separate this from the water, with the collected sediment sent for treatment offsite at a suitable licensed facility. The soil and rock arisings from the bored piles will be handled and stored to ensure that no silt or sand will be washed into the river during rainfall events. Although the topography on the landward side of the wall is comparatively flat, should there be local variations which may concentrate rainfall runoff, temporary sandbag (or other style) bunds will be placed to control runoff which could otherwise mobilise silts and sands during their excavation and disposal. Depending on the presence or absence of contamination, soil and rock arisings may be stockpiled for later use, rather than being taken off site. Such stockpiles are likely to be in a designated area away from bored pile wall construction and existing sea wall remediation and tie-back. This matter is addressed below in Section 7. Although it is envisaged that the bores will be filled with concrete almost immediately so as not to leave open excavations for any length of time, if there are exceptional circumstances whereby bores need to remain unfilled overnight (such as severe machinery failure), mitigation to prevent entrapment of otters will be put in place. Suitable boarding or covers will be used to prevent otters from accessing any deep and steep sided excavations near to the River Blyth Estuary. If this is not practical a suitable means of escape will be provided within the excavation, to enable otters to climb out of the construction. Otters are only likely to try and access the structure outside normal working hours and so excavations will be covered or means of escape provided at the end of each working day. 6.4. Construction Methods for the Remediation of the Old River Walls The western section of the existing river wall constructed from stone masonry between Battleship Wharf and the timber jetty will be reinstated against the new bored pile wall. Where tie-back is not necessary simple options for surface paving will be considered. Document Ref: 02377-003093 Issue: 01
  • 17.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 13 As determined appropriate, the remaining sections of mass concrete wall and stone masonry wall between the timber jetties and the staithes will be tied back to the new bored pile wall to prevent the existing wall collapsing into the river. The form of the tie-back will be determined after inspection of the rear face of the wall to determine its condition. However, it is considered that it will include mass concrete infill between the walls together with a tie at crest level. Excavations behind the existing river walls will generate soil arisings. These will be handled with care to prevent wind-blow transmission of fine particles into the river. If necessary, for this part of the works, temporary sandbag (or other style) bunds will be placed to control runoff which could otherwise mobilise silts and sands during their excavation from behind the existing river walls. Depending on the presence or absence of contamination, soil arisings may be stockpiled for later use, rather than being taken off site. As indicated for arisings from bored pile wall construction, such stockpiles are likely to be in a designated area away from bored pile wall construction and existing sea wall remediation and tie-back. Where mass concrete infill is required, this will be contained by formwork which will have all joints on the inside of the shuttering taped prior to concrete pouring. The concrete will press the tape onto the shutter when it is poured, preventing any leaks. An anti washout additive will be added to the concrete if it is considered there will be wave action before the concrete cures. All heavy plant or machinery will be located on the landward side of the existing river wall and will not be allowed to access the mudflat area. Appropriate signage and fencing will be used to enforce this during the works. Only hand-held equipment, such tools used to erect formwork used to contain the poured concrete, will be allowed onto the mudflat area and will be removed immediately after use. No equipment or materials will be stored on the riverward side of the existing river wall, regular checks and inspections will be made at the end of each work period (such as the return of the tide), to make sure no materials are left in this area. Any inspection activities and construction works on the River Blyth Estuary side of the existing river wall will take place at states of low tide to prevent the disturbance of sediments within the river, to allow access to the existing river wall and also to allow examination of the shuttering for leaks. 6.5. Contractor’s Compound If a separate compound is provided for the contractor’s use, suitable measures will be applied to prevent run-off of silts and sands directly to the estuary, following rainfall events. Further related detail is provided below in Section 8. Document Ref: 02377-003093 Issue: 01
  • 18.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 14 7. Mitigation Measures to be employed during the works Contractors for this work will be required to adhere to an Environmental Management System (EMS) to ISO140001 or similar for the construction and decommissioning works, within the quality assurance component of the Contract. Contractors will be required to agree to and develop the overall Application Site Construction Environment Management Plan (CEMP) that will be agreed with Northumberland County Council and the Environment Agency prior to commencement of the construction works. All water removed from excavations during construction will be treated where necessary and discharged in accordance with relevant consents to discharge agreed with the Environment Agency. As part of the CEMP, mitigation to prevent the wash out of uncovered contaminated soils during construction works will be employed. Where appropriate, bunds shall be constructed around work areas where existing soils are exposed to prevent flood water inundating work areas and washing out potentially contaminated surface soils. As part of the CEMP, areas for locating the storage of construction materials will be indentified outside the flood zone. Specific guidance in dealing with silt contained in surface water runoff arising from construction activities is contained within PPG5. A number of measures can be put in place in order to minimise the actual transport of silt into surface water features, and will be agreed via the CEMP, including: • Bunding – either earth bunds, cut-off ditches or other forms of diversion or sheeting of stockpiles will be used to minimise the potential for silt laden runoff. Where appropriate silt fences or straw / rock barriers at the toe of the stockpile would be put in place to mitigate runoff during rainfall events. A silt fence comprises a geotextile filter fabric, straw bales, or a combination of both, installed in the path of runoff and can filter out heavy sediments; and • Wheel washing to prevent soils being spread onto roads outside of the construction area. Appropriate measures will be put in place through the CEMP to mitigate potential effects of contamination during concrete pouring, for containment of fuelling operations, and during fire fighting events. Measures will be based on best practice (e.g. EA PPG Notes and CIRIA) and will include the following: • designated facilities designed and used for oil and fuel storage and refuelling (incorporating appropriate bunds and drip trays); • a site oil, chemical and product inventory; • a list of emergency procedures, responsive to a risk assessment of areas of high sensitivity; • site induction of all personnel on emergency spillage procedures and staff trained in emergency procedures; Document Ref: 02377-003093 Issue: 01
  • 19.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 15 • a contact list for the emergency services, the relevant environmental regulators, the local water supply and sewerage undertakers, the Health and Safety Executive and specialist clean up contractors, if required; and • emergency response equipment available at appropriate locations. Prior to the commencement of construction and as a proposed Requirement accompanying the DCO, a “Pollution Incident Response Plan” will be developed. In the event of an accidental spillage, the “Pollution Incident Response Plan” will become effective. This plan will be part of the contractor’s registered Quality Assurance programme to ISO 9001 and ISO 140001. This will include details for the relevant contact at the MMO, should a marine pollution incident occur. The Pollution Incident Response Plan will be agreed with consultees including the MMO and the Environment Agency prior to commencement of the works. The storage of potentially polluting materials will be kept to a minimum where practicable and, where less hazardous or inert materials are available, these will be specified. In addition, absorbent mats/pads, absorbent granules and sand will be made available, and site operatives trained in their use, to deal with any spillages. The positioning of fuel storage tanks and other potentially polluting materials and maintenance facilities will be on bunded areas of hard standing with dedicated drainage systems. Bunded areas will provide 110% storage volume to contain any possible leaks. Refuelling will also be undertaken only in designated areas, where small spills and leaks can be controlled. Drip trays and absorbent materials will be used to control spills. Washing out of concrete wagons or other equipment used in concreting operations will be undertaken in designated contained washout areas or offsite. To mitigate the low risk of impact to controlled waters by riverside construction activities, silt screens or silt curtains will be utilised as a precautionary measure. These will screen the working area preventing suspended sediments from being transported away from the Facility Site works. The silt curtain will be installed by an appropriate contractor prior to commencement of the works. The curtain will initially be laid out in sections that will be joined together on shore. It will be moved into place using a small boat and the skirt and chain ballast lowered from the floating boom. Depth measurements will be taken to confirm that the chain ballast rests on the bottom of the estuary and a provision is made for water depth during high tide. This will remain in place for a further period of time after the construction works to allow settlement of sediments. This will comply with the requirements of Pollution Prevention Guidance note 5 (PPG5) Document Ref: 02377-003093 Issue: 01
  • 20.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 16 Drawings Figure 1: Remedial Secant Pile Wall location Figure 2: Aerial Photograph Figure 3: Indicative Cross Section A – A’ Document Ref: 02377-003093 Issue: 01
  • 21.
  • 22.
  • 23.
  • 24.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 17 Appendix A: Options Report – Riverwall Remedial Works, D/I/D/81354/105 Document Ref: 02377-003093 Issue: 01
  • 25.
      Options Report –Riverwall Remedial Works   February 2012   RES North Blyth Renewable Energy Plant D/I/D/81354/105 Document Ref: 02377-003093 Issue: 01
  • 26.
    North Blyth Renewable Energy Plant D/I/D/81354/105   CONTROL SHEET CLIENT: RES PROJECTTITLE: North Blyth Renewable Energy Plant REPORT TITLE: Option Report – Riverwall Remedial Works PROJECT REFERENCE: 81354 Issue and Approval Schedule: ISSUE 1 DRAFT Name Signature Date Prepared by A Lowes Reviewed by I Gill Approved by I Gill Revision Record: Issue Date Status Description By Chk App 2 3 4 5 This report has been prepared in accordance with procedure OP/P03 of W A Fairhurst & Partners' Quality Assurance System. Document Ref: 02377-003093 Issue: 01
  • 27.
    North Blyth Renewable Energy Plant D/I/D/81354/105   CONTENTS   1.0  INTRODUCTION......................................................................................................... 1  2.0 LOCATION OF WORKS............................................................................................. 1  3.0  FORM OF STRUCTURE ............................................................................................ 1  4.0  EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS..................... 2  5.0  TECHNICAL CONSTRAINTS .................................................................................... 2  6.0  OPTIONS FOR REMEDIAL WORKS......................................................................... 3  7.0  SEQUENCE OF CONSTRUCTION FOR EACH OPTION.......................................... 3  8.0  ESTIMATED BUDGETARY COSTS .......................................................................... 7  9.0  ADVANTAGES AND DISADVANTAGES FOR EACH OPTION................................ 0  10.0  SUMMARY.................................................................................................................. 0    Document Ref: 02377-003093 Issue: 01
  • 28.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 1 February2012   1.0 INTRODUCTION As part of the proposal to develop a Biomass Power Station at Battleship Wharf, Port of Blyth, it will be necessary to re-align the roundabout and access road to Battleship Wharf closer to the River Blyth. At this location the existing riverwalls are in a poor state of repair with a partial collapse in one section and gaps in the wall leading to the wash out of retained material in other sections. Report D/I/D/81354/100 “Improvements to Access – Consideration of Proximity to Old River Walls” and the subsequent method statement D/I/D/81354/104 “Preliminary Method Statement – River Wall Remedial Works” recommended placing a rock berm against the wall to prevent it from collapsing into the intertidal mudflats on the basis that this is the most cost effective and simplest form of remedial works. This solution would extend into the intertidal mudflat and as such there is the potential for habitat loss. After discussion with RES, Natural England and The Environment Agency it has been agreed that other options for remedial works to the river wall which would not cause habitat loss should be considered. This Option Report discusses the possible different forms of construction which could be implemented to repair the riverwall to minimise the potential for further instability and wash out of material which would lead to surface deformations in the area of the revised road layout. This method statement has been prepared based on the general arrangement shown in report D/I/D/81354/100 “Improvements to Access – Consideration of Proximity to Old River Walls”. 2.0 LOCATION OF WORKS The location of the road improvements and the remedial works to existing river walls is at the southern end of Battleship Wharf, North Blyth. 3.0 FORM OF STRUCTURE The proposed new access will involve widening the existing road on the riverwards (West) side. Allowing for a 2m wide verge and a small batter down to existing levels, the riverwards edge of the new road works will be approximately 9m closer to the river edge than the existing kerb line at the widest part of the new works. The river edge is made up of old concrete or masonry walls which vary in distance between approximately 5 and 20metres from the kerb line of the existing road. Working from the Port entrance gate the first section of wall is approximately 20m in length, is made from stone masonry and gradually increases in height to approximately 2metres where it meets an old timber jetty. A section of this wall has collapsed and an area behind has been washed out by the river/sea. This area has been roughly infilled with whinstone rocks to prevent further washout. The next section of wall is approximately 20metres in length, is made from mass concrete and is approximately 3metres in height. This wall is founded on timber piles but there are gaps between the timbers and thus allowing material to wash out and the ground behind the wall is subsiding. The third section of wall is approximately 35m in length leading up to the roundabout is another stone masonry wall approximately 2 metres high but reducing in height towards the roundabout. This wall is in reasonable condition but there are some areas where washout is occurring through open joints. Document Ref: 02377-003093 Issue: 01
  • 29.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 2 February2012   4.0 EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS On the riverward side of the river walls, beach sand overlying bedrock has been observed. Outcrops of rock are visible, as such, the beach sand deposit is expected to be thin, less than 1m thick. The area retained by the river walls has historically been reclaimed from the estuary. Site investigation information for this area is not available, however based upon geotechnical information from other locations within the Battleship Wharf area, the following ground conditions to the landward side of the river walls are inferred: Ground level to 2-3m below ground level Made Ground consisting of heterogeneous colliery spoil 2-3m to 4-5m below ground level Wind Blown Sand Below 4-5m below ground level Bedrock consisting of moderately strong to strong sandstone Colliery spoil is likely to contain contaminants including heavy metals, sulphate, combustible materials, high pH, Polycyclic Aromatic Hydrocarbon (PAH) and Total Petroleum Hydrocarbon (TPH), however these contaminants tend to be present in low concentrations with low solubility. From historical records for the area it is considered that the fill has been in place for over 100 years and as such any leachable concentrations of contaminants are likely to have been leached from the soil in the intertidal groundwater zone close to the wall by tidally influenced groundwater movement. Land immediately north of this location is known to have been historically contaminated by past uses as railway sidings and for ship breaking activities. The affected area was remediated by Northumberland County Council in 1993 and as such any contamination which may remain is likely to be localised, isolated and in low concentrations. The tidal range in the River Blyth is: Highest recorded +3.61m OD Mean High Water Springs +2.44m OD Mean Low Water Springs -1.88m OD Lowest Recorded -3.61m OD 5.0 TECHNICAL CONSTRAINTS To construct the remedial works the following technical challenges must be considered in the design of the temporary and permanent works and construction methodology. 1. Existing riverwalls which potentially are unstable. 2. Working in the intertidal zone. 3. Presence of made ground which may contain low concentrations of contamination. 4. Shallow competent bedrock. 5. Presence of wading and sea birds in the surrounding area. Document Ref: 02377-003093 Issue: 01
  • 30.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 3 February2012   6.0 OPTIONS FOR REMEDIAL WORKS The following options for remedial works have been considered: 1. Repair to gaps in the wall and construction of a rock revetment on the riverward side of the existing river wall. 2. Construction of a new riverwall using sheet piles immediately in front of the existing wall. 3. Construction of a new retaining wall using sheet piles immediately to the rear of the existing wall. 4. Construction of a new retaining wall using bored piles immediately to the rear of the existing wall. 5. Construction of a new gravity retaining wall immediately to the rear of the existing wall. The form of construction and the advantages and disadvantages of each form of construction are discussed in the sections below. 7.0 SEQUENCE OF CONSTRUCTION FOR EACH OPTION Presented below is a brief summary of the sequence of construction for each option considered. 7.1 Option 1 Repairs to the Existing Wall And Rock Revetment The sequence of construction for the remedial works for the river wall is discussed below and split into the three sections of wall identified in report D/I/D/81354/100 and summarised in Section 3 above. For all three sections, work will take place at low tide to prevent the disturbance of sediments within the river, to allow access to the existing river wall to carry out the works and also to examine the formwork for leaks. Any joints on the inside of formwork will be taped prior to concrete pouring. The concrete will press the tape onto the shutter when it is poured, preventing any leaks. An anti washout additive will be added to the concrete if it is considered there will be wave action before the concrete cures. The final timescale will be determined during detailed engineering design for the works. 7.1.1 Section 1 – Stone Masonry Wall between Battleship Wharf and the Timber Jetty For this section of the wall, in the area where the collapsed section has been infilled, the following works should be undertaken: 1. Select a position for a long reach excavator to stand and work as far back from the existing wall and area affected from wash out as possible. 2. The existing stone infill should be removed using a long reach excavator and the stone sorted and laid out for possible reuse in the works. 3. Remove beach sand from the area in front of the collapsed wall to expose bedrock. 4. After removal of existing infill and beach sand a filter cloth should be laid over the exposed face of material retained behind the wall. The filter cloth should extend vertically over all exposed retained material and horizontally across the area of river bed which will receive armour stone. The filter cloth shall be securely fixed into position. Document Ref: 02377-003093 Issue: 01
  • 31.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 4 February2012   5. A rock armoured revetment shall be placed in the section of collapsed wall. A core of well graded rock shall be placed against the wall extending out at a gradient of 30˚ down to the riverbed. A protective layer of 250mm to 500mm armour stone shall be laid to a thickness of 750mm. As shown on Drawing 81354/1003 the armour will extend to the full height of the wall, less an allowance for wave break. 7.1.2 Section 2 – Mass Concrete Wall between Timber Jetties 1. Remove sand from in front of the riverwall. 2. In locations where there are gaps in the timbering or the wall, erect formwork and place concrete. 3. Select a position for a long reach excavator to stand and work as far back from the existing wall and area affected from wash out as possible. 4. After concrete has cured a rock armoured revetment shall be placed in the section of collapsed wall. A core of well graded rock shall be placed against the wall extending out at a gradient of 30˚ down to the riverbed. A protective layer of 250mm to 500mm armour stone shall be laid to a thickness of 750mm. 7.1.3 Section 3 – Stone Masonry Wall between the Timber Jetty and the Staithe 1. Remove sand from in front of the riverwall. 2. In locations where there are gaps in the timbering or the wall, erect formwork and place concrete. 3. Select a position for a long reach excavator to stand and work as far back from the existing wall and area affected from wash out as possible. 4. After concrete has cured a rock armoured revetment shall be placed in the section of collapsed wall. A core of well graded rock shall be placed against the wall extending out at a gradient of 30˚ down to the riverbed. A protective layer of 250mm to 500mm armour stone shall be laid to a thickness of 750mm. 7.2 Option 2 Construction of a New Sheet Pile Wall In Front of the Existing Wall The sequence of construction for the remedial works for the river wall for this option is discussed below. Due to the presence of shallow bedrock, an adequate penetration depth for the piles to prevent instability of the wall cannot be achieved using conventional pile driving methods. It will be necessary to cut a trench into the bedrock into which the sheet piles will be inserted and set in place using concrete. It is anticipated that the depth of the trench would be in the order of 2-4m below the bedrock horizon, depending on the depth of surface weathering in the rock. Works to excavate the trench could only be carried out during periods of low water. Prior to breaking out of the rock to form the trench the overlying superficial deposits would have to be removed and where necessary the existing wall would be shored to allow excavation plant to be positioned close to the edge. The trench would be excavated using conventional hydraulic breaker equipment mounted on a long reach excavator. Arisings from the trench would be removed using a long reach excavator. Document Ref: 02377-003093 Issue: 01
  • 32.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 5 February2012   After the trench is formed the sheet piles would be set into the trench and fixed in place using mass concrete. Concrete will only be placed at low water when the top of the trench is above the water level. An anti washout additive will be added to the concrete to prevent migration of the concrete into the watercourse as the tide rises. After the concrete has cured the small gap between the existing wall and the new sheet pile wall will be infilled with either clean processed granular arisings generated from the construction of the pile toe trench or mass concrete. 7.3 Option 3 Construction of a New Sheet Pile Wall to the Rear of the Existing Wall The sequence of construction for the remedial works for the river wall for this option is discussed below. Due to the presence of shallow bedrock, an adequate penetration depth for the piles to prevent instability of the wall cannot be achieved using conventional pile driving methods. It will be necessary to cut a trench into the bedrock into which the sheet piles will be inserted and set in place using concrete. It is anticipated that the depth of the trench would be in the order of 2-4m below the bedrock horizon, depending on the depth of surface weathering in the rock. Works will be carried out in the intertidal zone and groundwater fluctuation matching the state of tide can be expected. Prior to remedial works being undertaken it will be necessary to undertake site investigation to determine the profile of the rear of the wall, founding stratum and chemical characteristics of the made ground to confirm: • Any shoring works to maintain wall stability during the works. • The potential to liberate contamination in the made ground into the water column during the time the excavation is open. • Determine the mitigation measures required to prevent short term contamination of the river during construction works. It will be necessary to construct a trench through the made ground and natural blown sand deposits to expose the bedrock surface. The existing wall will be shored appropriately to prevent collapse while the trench is open. On the landward side the trench side would be battered back to a safe angle. This will expose potentially contaminated materials at the surface of the slope which may have an increased leachable potential due to exposure in the face of the excavation. If necessary mitigation measures identified during the site investigation phase will be implemented to prevent contamination. It is anticipated that, if required, this would take the form of covering the cut face with an impermeable membrane. Works to excavate the trench could only be carried out during periods of low water. The trench would be excavated using conventional hydraulic breaker equipment mounted on a long reach excavator. Arisings from the trench would be removed using a long reach excavator. After the trench is formed the sheet piles would be set into the trench and fixed in place using mass concrete. Concrete will only be placed at low water when the top of the trench is above the water level. An anti washout additive will be added to the concrete to prevent migration of the concrete into the watercourse as the tide rises. In Section 1 of the existing wall as identified in report D/I/D/81354/100, the existing rock revetment would be reinstated against the new sheet pile wall. Document Ref: 02377-003093 Issue: 01
  • 33.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 6 February2012   In Sections 2 and 3 the existing wall would be tie back to the new sheet pile wall to prevent the existing wall collapsing into the river. The form of the tied back would be determined after inspection of the rear face of the wall to determine its condition, however it is considered that it will include mass concrete infill between the walls together with a tie at crest level. 7.4 Option 4 Construction of a New Bored Pile Wall to the Rear of the Existing Wall The sequence of construction for the remedial works for the river wall for this option is discussed below. As an alternative to using sheet piles interlocking bored concrete piles could be utilised to form a new retaining wall to the rear of the existing river wall. This method of construction does not require the excavation of the superficial deposits or the construction of a trench in the bedrock. The piles would be bored through the superficial deposits into the rock to sufficient depth to provide an adequate factor of safety against collapse. It is anticipated that this would be to a similar depth to as required for the sheet piles. In Section 1 of the existing wall as identified in report D/I/D/81354/100, the existing rock revetment would be reinstated against the new bored pile wall. In Sections 2 and 3 the existing wall would be tied back to the new bored pile wall to prevent the existing wall collapsing into the river. The form of the tie back would be determined after inspection of the rear face of the wall to determine its condition, however it is considered that it will include mass concrete infill between the walls together with a tie at crest level. 7.5 Option 5 Construction of a Gravity Wall to the Rear of the Existing Wall The sequence of construction for the remedial works for the river wall for this option is discussed below. As an alternative to an embedded sheet pile or bored pile wall a gravity retaining wall, constructed in mass concrete could be constructed to the rear of the existing river wall. Based upon an assumed height of wall of 5m it is anticipated that the base of the wall would be approximately 3m wide. The rear face would be tapered or stepped to give an assumed wall thickness at the crest of the wall of 1m. Works will be carried out in the intertidal zone and groundwater fluctuation matching the state of tide can be expected. Prior to remedial works being undertaken it will be necessary to undertake site investigation to determine the profile of the rear of the wall, founding stratum and chemical characteristics of the made ground to confirm: • Any shoring works to maintain wall stability during the works. • The potential to liberate contamination in the made ground into the water column during the time the excavation is open. • Determine the mitigation measures required to prevent short term contamination of the river during construction works. It will be necessary to excavate through the made ground and natural blown sand deposits to expose the bedrock surface. The existing wall will be shored appropriately to prevent collapse while the trench is open. On the landward side the trench side would be battered back to a safe angle. This will expose potentially contaminated materials at the surface of the slope which may have an increased leachable potential Document Ref: 02377-003093 Issue: 01
  • 34.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 7 February2012   due to exposure in the face of the excavation. If necessary, mitigation measures identified during the site investigation phase will be implemented to prevent contamination. It is anticipated that, if required, this would take the form of covering the cut face with an impermeable membrane. Works to excavate the work area could only be carried out during periods of low water. After the rock surface has been exposed localised breaking out will take place to level the surface and remove any loose materials. Once the surface has been prepared, formwork will be erected into which the concrete will be placed. Any joints on the inside of formwork will be taped prior to concrete pouring. The concrete will press the tape onto the shutter when it is poured, preventing any leaks. As the concrete will be contained within the formwork it is not considered that an anti washout additive will be required. After the concrete has been cured the formwork will be removed. And the excavated area will be infilled with the original arisings. Surplus arisings will either be reused within the main works or disposed of off site. In Section 1 of the existing wall as identified in report D/I/D/81354/100, the existing rock revetment would be reinstated against the new gravity wall. In Sections 2 and 3 the existing wall would be tied back to the new gravity wall to prevent the existing wall collapsing into the river. The form of the tied back would be determined after inspection of the rear face of the wall to determine its condition, however it is considered that it will include mass concrete infill between the walls together with a tie at crest level. 8.0 ESTIMATED BUDGETARY COSTS For the options considered, the estimated costs are presented below: 8.1 Option 1 - Repair to gaps in the wall and construction of a rock revetment on the riverward side of the existing river wall For this costing the following assumptions have been made. • The length of wall to be treated is 75m. • The average cross section of the revetment is 3m high x 9m wide with a cross sectional area of 13.5m2 . • Revetment will be constructed from locally sourced Whinstone. • Method Related Charges and Preliminaries include for intertidal working and minor operations. • A provisional sum of £10,000 has been allowed for localised repairs to wall. Document Ref: 02377-003093 Issue: 01
  • 35.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 8 February2012   Principal Items Quantity Rate Cost Supply Rock for revetment 1015m3 £50/m3 £50,750 Supply and place filter cloth 2025m2 £5/m2 £10,125 Repairs to existing wall - Prov. Sum. £10,000 Lay revetment 1015m3 £10/m3 £10,150 Sub total £81,025 Method Related Charges and Preliminaries (25%) £20,275 Total £101,300 8.2 Option 2 - Construction of a new riverwall using sheet piles immediately in front of the existing wall For this costing the following assumptions have been made. • The length of wall to be treated is 75m. • The depth of embedment will be a worst case of 5m. • Sheet piles will be AZ36 section (170kg/m2 ). • The average retained height is 3m. As such, the area of piles required is 600m2 and the tonnage is 102 tonnes. • The gap between the piles and the wall will be filled with marine grade concrete containing an anti segregation admixture. • A provisional sum of £25,000 has been allowed for localised stabilisation of the wall whilst the trench to receive the sheet piles is excavated. • The piles will be set into the trench and concreted in place using marine grade concrete containing an anti segregation admixture. • Method Related Charges and Preliminaries include for intertidal working and minor operations. • Arisings from trench excavation can be disposed of as inert material. Principal Items Quantity Rate Cost Temporary works to stabilise wall during trench excavation Prov sum £25,000 Excavate trench 5m deep x 0.5m wide 200m3 £25/m3 £5,000 Supply and pitch piles 102 tonnes £1000/tonne. £102,000 Concrete infill to trench 200m3 £100/m3 £20,000 Concrete infill between piles and wall 80m3 £100/m3 £8,000 Dispose of arisings from trench excavation 200/m3 £40/m3 £8,000 Sub total £168,000 Document Ref: 02377-003093 Issue: 01
  • 36.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 9 February2012   Method Related Charges and Preliminaries (25%) £42,000 Total £210,000 8.3 Option 3 - Construction of a new retaining wall using sheet piles immediately to the rear of the existing wall For this costing the following assumptions have been made. • The length of wall to be treated is 75m. • The depth of embedment will be a worst case of 5m. • Sheet piles will be AZ36 section (170kg/m2 ). • The average retained height is 3m. As such, the area of piles required is 600m2 and the tonnage is 102 tonnes. • A provisional sum of £25,000 has been allowed for localised stabilisation of the wall whilst the trench to receive the sheet piles is excavated. • A provisional sum of £10,000 has been allowed for slope protection to the rear of the wall. • The piles will be set into the trench and concreted in place using marine grade concrete containing an anti segregation admixture. • Method Related Charges and Preliminaries include for intertidal working and minor operations. • Arisings from trench excavation can be disposed of as inert material. There will be no arisings from the excavations from the rear of the wall. Principal Items Quantity Rate Cost Temporary works to stabilise wall during trench excavation Prov sum £25,000 Excavate working area to rear of wall, 5m wide with a back slope of 1 in 1. £1,500m3 £2/m3 £3,000 Excavate trench 5m deep x 0.5m wide 200m3 £25/m3 £5,000 Supply and pitch piles 102 tonnes £1000/tonne. £102,000 Concrete infill to trench 200m3 £100/m3 £20,000 Tie wall to piles 75m £25/m £1,875 Dispose of arisings from trench excavation 200/m3 £40/m3 £8,000 Reinstate fill to rear of wall £1,500m3 £3.50/m3 £5,250 Sub total £170,125 Method Related Charges and Preliminaries (25%) £42,575 Total £212,700 Document Ref: 02377-003093 Issue: 01
  • 37.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 10 February2012   8.4 Option 4 - Construction of a new retaining wall using bored piles immediately to the rear of the existing wall. For this costing the following assumptions have been made. • The length of wall to be treated is 75m. • The depth of embedment will be a worst case of 5m. • The piles will be bored and 300mm in diameter at 450mm spacing. The concrete will be marine grade. No of piles required 167 with an average length of 8m. • A piling platform will not be required. • Arisings from superficial deposits can be reused to level site. • Method Related Charges and Preliminaries include for intertidal working and minor operations. • Arisings from sandstone excavation can be disposed of as inert material. The arisings from superficial soils will be disposed of as non-hazardous material. Principal Items Quantity Rate Cost Install interlocking bored piles 167 nr £750 / pile. £125,250 Tie wall to piles 75m £25/m £1,875 Construct Capping Beam 20m3 £250/m3 £5,000 Dispose of arisings as inert fill 180/m3 £40/m3 £7,200 Sub total £139,325 Method Related Charges and Preliminaries (25%) £34,875 Total £174,200 8.5 Option 5 - Construction of a new gravity retaining wall immediately to the rear of the existing wall. For this costing the following assumptions have been made. • The length of wall to be treated is 75m. • The average retained height is 4m including foundation depth. As such, the base of the wall will be approximately 3m wide stepped to 1m wide at top. Cross sectional are of wall is 7.8m2 . • A provisional sum of £25,000 has been allowed for localised stabilisation of the wall whilst excavation at rear is open. • A provisional sum of £10,000 has been allowed for slope protection to the rear of the wall. • The wall will be constructed fusing marine grade concrete. Document Ref: 02377-003093 Issue: 01
  • 38.
    North Blyth Renewable Energy Plant D/I/D/81354/105 Page 11 February2012   • Method Related Charges and Preliminaries include for intertidal working and minor operations. • Arisings from excavation can be disposed of as non-hazardous material. Principal Items Quantity Rate Cost Temporary works to stabilise wall during trench excavation Prov sum £25,000 Excavate working area to rear of wall, 5m wide with a back slope of 1 in 1. £1,500m3 £2/m3 £3,000 Construct mass gravity wall 585m3 £130/m3 . £76,050 Tie wall to piles 75m £25/m £1,875 Dispose of arisings as inert fill 585m3 £40/m3 £23,400 Reinstate fill to rear of wall £915m3 £3.50/m3 £3,200 Sub total £132,525 Method Related Charges and Preliminaries (25%) £33,175 Total £165,700 8.6 Cost Summary The preliminary budget costing presented above is summarised as follows: Option Estimated Cost Repair to gaps in the wall and construction of a rock revetment on the riverward side of the existing river wall. £101,300 Construction of a new riverwall using sheet piles immediately in front of the existing wall. £210,000 Construction of a new retaining wall using sheet piles immediately to the rear of the existing wall. £212,700 Construction of a new retaining wall using bored piles immediately to the rear of the existing wall. £174,200 Construction of a new gravity retaining wall immediately to the rear of the existing wall. £165,700     Document Ref: 02377-003093 Issue: 01
  • 39.
    North Blyth RenewableEnergy Plant D/I/D/81354/105 Page 0 February 2012   9.0 ADVANTAGES AND DISADVANTAGES FOR EACH OPTION Presented in the table below are the disadvantages and advantages of each option considered in relation to each other. Option Advantage Disadvantage 1 Repairs to the Existing Wall And Rock Revetment Lowest cost solution Quick to Install Lowest potential noise disturbance Will not require excavation into potential contaminated fill Requires land take in intertidal mudflats 2 Construction of a New Sheet Pile Wall In Front of the Existing Wall Will provide new river wall in front of existing as such, no tie back arrangements needed. Will not require excavation into potential contaminated fill. Requires land take in intertidal mudflats Disturbance of river sediments in vicinity of the works required. Excavation could have destabilising effect on wall and shoring required. Excavation of trench will require hydraulic breaker. Noise is likely to disturb birds and vibration may disturb aquatic life Document Ref: 02377-003093 Issue: 01
  • 40.
    North Blyth RenewableEnergy Plant D/I/D/81354/105 Page 1 February 2012   Option Advantage Disadvantage 3 Construction of a New Sheet Pile Wall to the Rear of the Existing Wall Does not require works in the river. Excavation work has potential to expose contaminated materials at surface with surface water contamination mitigation required. Excavation could have destabilising effect on wall and shoring required. Excavation of trench will require hydraulic breaker. Noise is likely to disturb birds and vibration may disturb aquatic life. Tie back to existing wall could present difficult details 4 Construction of a New Bored Pile Wall to the Rear of the Existing Wall Does not require works in the river. Does not require excavation works through potentially contaminated fill. Low noise and vibration operation. Tie back to existing wall could present. Potential contaminated arisings will require disposal. 5 Construction of a Gravity Wall to the Rear of the Existing Wall Does not require works in the river. Low noise and vibration operation. Excavation work has potential to expose contaminated materials at surface with surface water contamination mitigation required. Excavation could have destabilising effect on wall and shoring required. Tie back to existing wall could present difficult details Document Ref: 02377-003093 Issue: 01
  • 41.
    North Blyth RenewableEnergy Plant D/I/D/81354/105 Page 0 February 2011   10.0 SUMMARY It will be necessary to re-align the roundabout and access road to Battleship Wharf closer to the River Blyth. At this location the existing riverwalls are in a poor state of repair with a partial collapse in one section and gaps in the wall leading to the wash out of retained material in other sections. The following options for remedial works have been considered: 1. Repair to gaps in the wall and construction of a rock revetment on the riverward side of the existing river wall. 2. Construction of a new riverwall using sheet piles immediately in front of the existing wall. 3. Construction of a new retaining wall using sheet piles immediately to the rear of the existing wall. 4. Construction of a new retaining wall using bored piles immediately to the rear of the existing wall. 5. Construction of a new gravity retaining wall immediately to the rear of the existing wall. To summarise the advantages and disadvantages of each option: • Of the options considered, Option 1 Repairs to the Existing Wall And Rock Revetment would present the lowest cost and simplest solution. However there is the significant disadvantage that land take in the intertidal mudflats would be required. • Option 4 Construction of a New Bored Pile Wall to the Rear of the Existing Wall would provide a simple solution which has the lowest potential environmental impact in terms of risk of exposing potential contaminated materials, noise, vibration. • Option 5 present the simplest form of construction for a new wall located behind the existing river wall. However, it does have the disadvantage that it will be necessary to expose potentially contaminated materials and there will be a requirement to dispose of potentially contaminated arisings. As such, if work within the intertidal mudflats were to be permitted then the option to construct a rock revetment would present the simplest and most cost effective solution. However, if this will not be permitted then the construction of a concrete wall to the rear of the existing wall would present the most cost effective solution. Although slightly more expensive the bored pile wall would be the least risk option in terms of risk of pollution to the River Blyth as it would not require a large surface area of potentially contaminated material to be opened up to intertidal river water Document Ref: 02377-003093 Issue: 01
  • 42.
      www.fairhurst.co.uk Aberdeen Birmingham Bristol Dundee Edinburgh Elgin Glasgow Inverness Leeds London Manchester Newcastle upon Tyne Sheffield Watford Wellesbourne CIVILENGINEERING • STRUCTURAL ENGINEERING • TRANSPORTATION • ROADS & BRIDGES PORTS & HARBOURS • GEOTECHNICAL & ENVIRONMENTAL ENGINEERING • PLANNING & DEVELOPMENT • WATER SERVICES • CDM COORDINATOR SERVICES Document Ref: 02377-003093 Issue: 01
  • 43.
    North Blyth RenewableEnergy Plant SKM Enviros I:JEIAProjectsJE30584DeliverablesReportsRiver Wall MSNorth Blyth R E Plant - New Pile River Wall - Method Statement_Final 03.07.12.docx PAGE 18 Appendix B: Preliminary Outline Method Statement for other Remedial Options- Riverwall Remedial Works, D/I/D/81354/10 Document Ref: 02377-003093 Issue: 01
  • 44.
    Preliminary Outline Method Statement– Riverwall Remedial Works September 2011 RES North Blyth Renewable Energy Plant D/I/D/81354/104 Document Ref: 02377-003093 Issue: 01
  • 45.
  • 46.
    North Blyth RenewableEnergy Plant D/I/D/81354/104 CONTENTS 1.0 INTRODUCTION....................................................................................................... 1 2.0 LOCATION OF WORKS ........................................................................................... 1 3.0 FORM OF STRUCTURE........................................................................................... 1 4.0 EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS .................... 1 5.0 TECHNICAL CONSTRAINTS ................................................................................... 2 6.0 SEQUENCE OF CONSTRUCTION........................................................................... 2 APPENDIX A DRAWINGS Document Ref: 02377-003093 Issue: 01
  • 47.
    North Blyth RenewableEnergy Plant D/I/D/81354/104 Page 1 February 2011 1.0 INTRODUCTION As part of the proposal to develop a Biomass Power Station at Battleship Wharf, Port of Blyth, it will be necessary to re-align the roundabout and access road to Battleship Wharf closer to the River Blyth. At this location the existing riverwalls are in a poor state of repair with a partial collapse in one section and gaps in the wall leading to the wash out of retained material in other sections. This preliminary outline method statement discusses the works required to repair the riverwall to minimise the potential for further instability, wash out of material which would lead to surface deformations in the area of the revised road layout in this area. This method statement has been prepared based on the recommendations of report D/I/D/81354/100 “Improvements to Access – Consideration of Proximity to Old River Walls”. This method statement has been prepared to discuss the technical procedures and sequence of works for the installation of the river wall remedial works. Health, safety and environmental requirements, design and construction quality assurance procedures, regulatory liaison and liaison with third parties are not included in this method statement. 2.0 LOCATION OF WORKS The location of the road improvements and the remedial works to existing river walls is at the southern end of Battleship Wharf, North Blyth. 3.0 FORM OF STRUCTURE The proposed new access will involve widening the existing road on the riverwards (West) side. Allowing for a 2m wide verge and a small batter down to existing levels ,the riverwards edge of the new road works will be approximately 9m closer to the river edge than the existing kerb line at the widest part of the new works. The river edge is made up of old concrete or masonry walls which vary in distance between about 5 and 20metres from the kerb line of the existing road. Working from the Port entrance gate the first section of wall is approximately 20m in length, is made from stone masonry and gradually increases in height to about 2metres where it meets an old timber jetty. A section of this wall has collapsed and an area behind has been washed out by the river/sea. This area has been roughly infilled with whinstone rocks to prevent further washout. The next section of wall is approximately 20metres in length, is made from mass concrete and is approximately 3metres in height. This wall is founded on timber piles but there are gaps between the timbers and thus allowing material to wash out and the ground behind the wall is subsiding. The third section of wall leading up to the roundabout is another stone masonry wall approximately 2 metres high but reducing in height towards the roundabout. This wall is in reasonable condition but there are some areas where washout is occurring through open joints. 4.0 EXPECTED GEOTECHNICAL AND HYDROLOGICAL CONDITIONS On the riverward side of the river walls beach sand overlying bedrock has been observed. Outcrops of rock are visible, as such, the beach sand deposit is expected to be thin, less than 1m thick. Document Ref: 02377-003093 Issue: 01
  • 48.
    North Blyth RenewableEnergy Plant D/I/D/81354/104 Page 2 February 2011 The tidal range in the River Blyth is: Highest recorded +3.61m OD Mean High Water Springs +2.44m OD Mean Low Water Springs -1.88m OD Lowest Recorded -3.61m OD 5.0 TECHNICAL CONSTRAINTS To construct the intake the following technical challenges must be considered in the design of the temporary and permanent works and construction methodology. 1. Existing riverwalls which potentially are unstable. 2. Working in the intertidal zone. 6.0 SEQUENCE OF CONSTRUCTION The sequence of construction for the remedial works for the river wall is discussed below and split into the three sections of wall identified in report D/I/D/81354/100 and summarised in Section 3 above. Proposals are shown on Drawing 81354/1003. For all three sections work will take place at states of low tide to prevent the disturbance of sediments within the river, to allow access to the existing river wall to carry out the works and also to examine the shuttering for leaks. Any joints on the inside of shuttering will be taped prior to concrete pouring. The concrete will press the tape onto the shutter when it is poured, preventing any leaks. An anti washout additive will be added to the concrete if it is considered there will be wave action before the concrete cures. The final timescale will be determined during detailed engineering design for the works. 6.1 Section 1 – Stone Masonry Wall between Battleship Wharf and the Timber Jetty For this section of the wall, in the area where the collapsed section has been infilled, the following works should be undertaken: 1. Select a position for a long reach excavator to stand and work which is as far back from the existing wall and area affected from wash out as possible. 2. The existing stone infill should be removed using a long reach excavator and the stone sorted and laid out for possible reuse in the works. 3. Remove beach sand from the area in front of the collapsed wall to expose bedrock. 4. After removal of existing infill and beach sand a filter cloth should be laid over the exposed face of material retained behind the wall. The filter cloth should extend vertically over all exposed retained material and horizontally across the area of river bed which will receive armour stone. The filter cloth shall be securely fixed into position. 5. A rock armoured revetment shall be placed in the section of collapsed wall. A core of well graded rock shall be placed against the wall extending out at a gradient of 30˚ down to the riverbed. A protective layer of 250mm to 500mm armour stone shall be laid to a thickness of 750mm. As shown on Drawing Document Ref: 02377-003093 Issue: 01
  • 49.
    North Blyth RenewableEnergy Plant D/I/D/81354/104 Page 3 February 2011 81354/1003 the armour will extend to the full height of the wall, less an allowance for wave break. 6.2 Section 2 – Mass Concrete Wall between Timber Jetties 1. Remove sand from in front of the riverwall. 2. In locations where there are gaps in the timbering or the wall, erect formwork and place concrete. 3. Select a position for a long reach excavator to stand and work which is as far back from the existing wall and area affected from wash out as possible. 4. After concrete has cured a rock armoured revetment shall be placed in the section of collapsed wall. A core of well graded rock shall be placed against the wall extending out at a gradient of 30˚ down to the riverbed. A protective nayer of 250mm to 500mm armour stone shall be laid to a thickness of 750mm.. 6.3 Section 3 – Stone Masonry Wall between the Timber Jetty and the Staithe 1. Remove sand from in front of the riverwall. 2. In locations where there are gaps in the timbering or the wall, erect formwork and place concrete. 3. Select a position for a long reach excavator to stand and work which is as far back from the existing wall and area affected from wash out as possible. 4. After concrete has cured a rock armoured revetment shall be placed in the section of collapsed wall. A core of well graded rock shall be placed against the wall extending out at a gradient of 30˚ down to the riverbed. A protective nayer of 250mm to 500mm armour stone shall be laid to a thickness of 750mm.. Document Ref: 02377-003093 Issue: 01
  • 50.
    North Blyth RenewableEnergy Plant D/I/D/81354/104 February 2011 APPENDIX A DRAWINGS Document Ref: 02377-003093 Issue: 01
  • 51.
  • 52.
    www.fairhurst.co.uk Aberdeen Birmingham Bristol Dundee Edinburgh Elgin Glasgow Inverness Leeds London Manchester Newcastle upon Tyne Sheffield Watford Wellesbourne CIVILENGINEERING • STRUCTURAL ENGINEERING • TRANSPORTATION • ROADS & BRIDGES PORTS & HARBOURS • GEOTECHNICAL & ENVIRONMENTAL ENGINEERING • PLANNING & DEVELOPMENT • WATER SERVICES • CDM COORDINATOR SERVICES Document Ref: 02377-003093 Issue: 01
