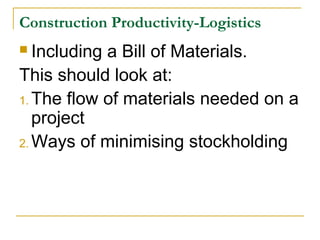

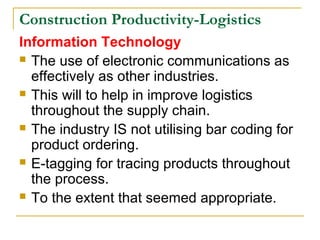

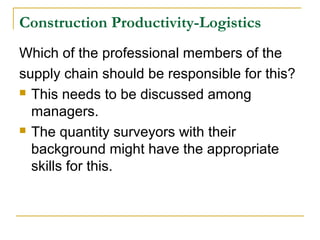

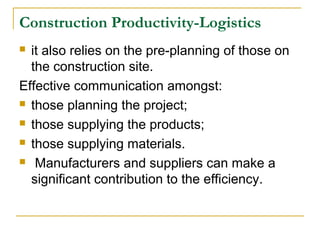

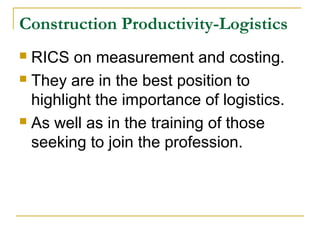

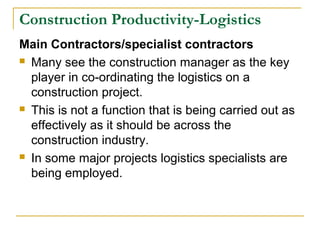

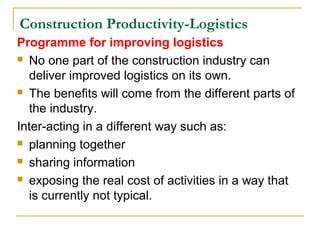

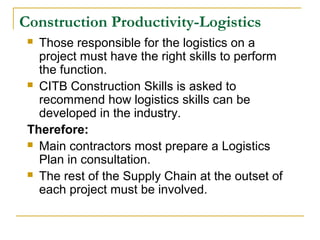

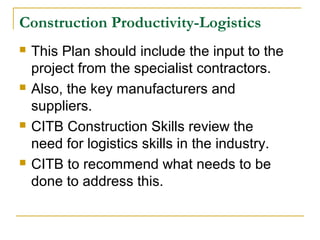

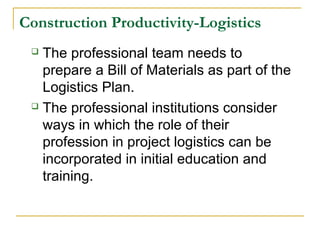

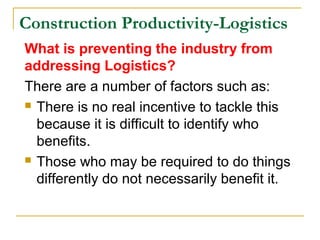

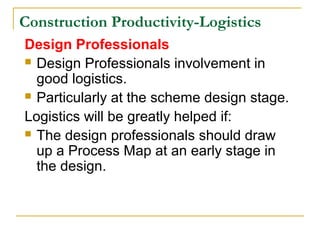

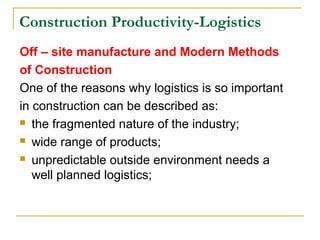

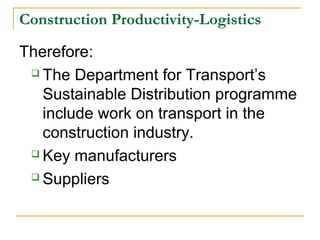

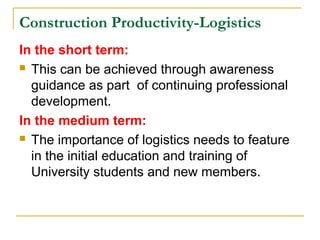

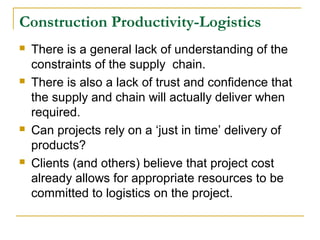

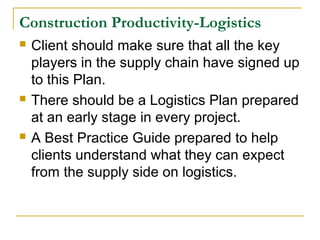

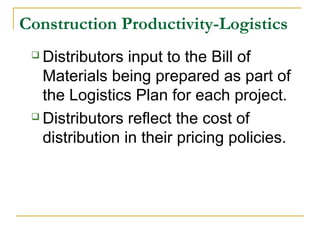

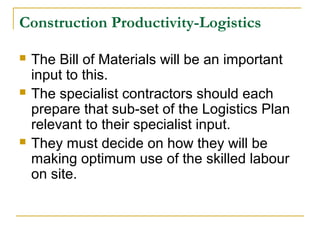

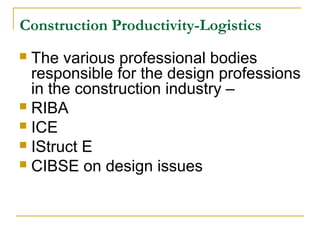

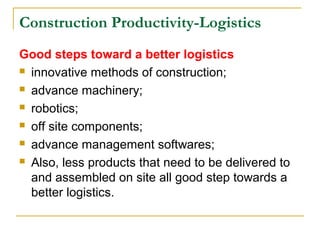

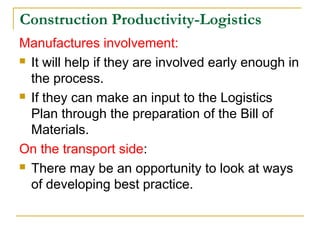

The document discusses factors preventing the construction industry from improving logistics and identifies steps that various groups could take. It notes that every construction project is unique, teams are temporary, and the industry is fragmented, hindering logistics. It recommends that clients require early logistics planning, designers create process maps and bill of materials, main contractors coordinate specialist input to logistics plans, and manufacturers contribute to planning and reflect distribution costs. Adopting lessons from other industries, using consolidation centers, and increased information technology could also improve construction logistics.
