Here are a few key things to remember when submitting your timesheet:
- Make sure all your hours are entered before submitting. You won't be able to edit it once submitted.
- Double check that your hours are accurate. Mistakes can cause delays or issues getting your timesheet approved.
- Include any comments needed to provide context for your manager about your work or hours.
- Submit your timesheet by the deadline your manager sets, usually by the end of the pay period. Late timesheets may not get approved or paid on time.
Peek at what’s going on behind the scenes
After you submit your timesheet, your timesheet manager receives a notification
that it needs to be
The topic "SaaS", which was once such a disputed topic, has now been widely accepted. The increase in the adoption as well as the new technology innovations such as cloud has significantly evolved SaaS architecture.
Mainframe Modernization with AWS: Patterns and Best PracticesAmazon Web Services
In this webinar, learn common mainframe migration patterns and best practices for a successful migration to AWS. Hear experiences and lessons learned based on real-world customer modernization projects to AWS.
SharePoint 2013 Composites from Microsoft and AtidanDavid J Rosenthal
SharePoint Composite Fundamentals
What is a SharePoint Composite?
Your organization has chosen and deployed Microsoft SharePoint Products 2013, and you’re on a mission to use and evangelize its many benefits. As you promote and adopt SharePoint Products 2013 throughout your business, you find the need to help users change old habits. Instead of storing files in network or e-mail folders, you gradually move them to SharePoint libraries for central management. Instead of routing documents in e-mail, you send links so that all users see the same and latest copy of the file in a shared library. Instead of attaching a spreadsheet of tables in e-mail, you use a list and list views to easily share and update the same data. Instead of manually performing routine business processes, you are using workflows to streamline regular tasks. Gradually, you are moving key project, content, and process information from individual e-mail accounts, personal computers, network drives, and sticky notes to SharePoint Products 2013 so that your teams and business can collaborate much more effectively.
But, is there more? Yes there is, and it’s called SharePoint Composites.
SharePoint Composites enable you to rapidly create solutions by assembling, connecting, and configuring the basic building blocks of functionality available in SharePoint Products 2013, and in many cases, Microsoft Office 2013. A SharePoint Composite combines data, documents, and business process in a useful, productive way.
Think of a SharePoint Composite like a wood composite: Pre-engineered layers merged together to provide a solution that is practical, inexpensive, easy to maintain, and good for your environment
In most cases, these solutions do not require code. Now there’s nothing wrong with writing code. But here’s a motto you might live by from now on: “Let’s not write code until we have to write code.”
In short, a SharePoint Composite is a “do-it-yourself” business solution. A SharePoint Composite could be as simple as a custom Web Page that uses a site list and several connected Web Parts to track mileage in a small business. Or, a SharePoint Composite could be as sophisticated as a corporate-wide absence reporting system connected to a Human Resource database by using Business Connectivity Services. A SharePoint Composite bears close resemblance to the often-used term, “mashup”. A mashup is a quick Web application that incorporates data into a simple, visual, and interactive solution. However, the term “composite” emphasizes the breadth and depth of solutions you can build on the SharePoint Products 2013 platform.
Project Web Access Quick Reference Guide For Team MembersToney Sisk
This printable Word document shows how to use Project Server 2007 and Project Web Access if you are a project manager. This is arranged by project management methodology, to make it easier to work within corporate standards.
The topic "SaaS", which was once such a disputed topic, has now been widely accepted. The increase in the adoption as well as the new technology innovations such as cloud has significantly evolved SaaS architecture.
Mainframe Modernization with AWS: Patterns and Best PracticesAmazon Web Services
In this webinar, learn common mainframe migration patterns and best practices for a successful migration to AWS. Hear experiences and lessons learned based on real-world customer modernization projects to AWS.
SharePoint 2013 Composites from Microsoft and AtidanDavid J Rosenthal
SharePoint Composite Fundamentals
What is a SharePoint Composite?
Your organization has chosen and deployed Microsoft SharePoint Products 2013, and you’re on a mission to use and evangelize its many benefits. As you promote and adopt SharePoint Products 2013 throughout your business, you find the need to help users change old habits. Instead of storing files in network or e-mail folders, you gradually move them to SharePoint libraries for central management. Instead of routing documents in e-mail, you send links so that all users see the same and latest copy of the file in a shared library. Instead of attaching a spreadsheet of tables in e-mail, you use a list and list views to easily share and update the same data. Instead of manually performing routine business processes, you are using workflows to streamline regular tasks. Gradually, you are moving key project, content, and process information from individual e-mail accounts, personal computers, network drives, and sticky notes to SharePoint Products 2013 so that your teams and business can collaborate much more effectively.
But, is there more? Yes there is, and it’s called SharePoint Composites.
SharePoint Composites enable you to rapidly create solutions by assembling, connecting, and configuring the basic building blocks of functionality available in SharePoint Products 2013, and in many cases, Microsoft Office 2013. A SharePoint Composite combines data, documents, and business process in a useful, productive way.
Think of a SharePoint Composite like a wood composite: Pre-engineered layers merged together to provide a solution that is practical, inexpensive, easy to maintain, and good for your environment
In most cases, these solutions do not require code. Now there’s nothing wrong with writing code. But here’s a motto you might live by from now on: “Let’s not write code until we have to write code.”
In short, a SharePoint Composite is a “do-it-yourself” business solution. A SharePoint Composite could be as simple as a custom Web Page that uses a site list and several connected Web Parts to track mileage in a small business. Or, a SharePoint Composite could be as sophisticated as a corporate-wide absence reporting system connected to a Human Resource database by using Business Connectivity Services. A SharePoint Composite bears close resemblance to the often-used term, “mashup”. A mashup is a quick Web application that incorporates data into a simple, visual, and interactive solution. However, the term “composite” emphasizes the breadth and depth of solutions you can build on the SharePoint Products 2013 platform.
Project Web Access Quick Reference Guide For Team MembersToney Sisk
This printable Word document shows how to use Project Server 2007 and Project Web Access if you are a project manager. This is arranged by project management methodology, to make it easier to work within corporate standards.
How many times your project was jammed because it depended on other project, shared resources with other projects, or simply waiting for something that others from your company had to provide? It’s like you are driving a car on the roads with no signs, no rules, but with police to blame you.
How many times did you tried to implement rules from the book? It like reading Grunf’s (Alan Ford) advices “If you want to win, you must not lose”.
So: How to do it? Which is the right way? How much it will cost? How long it takes? What we will gain? Come to share ideas and experience
Is your company starting to implement online marketing strategies such as SEO, PPC or social media? If this is the case, are you tracking your efforts through a web analytics platform like Google Analytics? If not, you may be wasting your time as you have no idea which strategies are driving traffic and converting visitors to leads or sales. If you are utilizing Google Analytics, what metrics are you looking at to determine campaign effectiveness? This presentation will provide info on the following: Google Analytics setup, advanced reporting features and reports offered by Google's free analytics platform. Learn how to measure your efforts, and better understand what success looks like.
Oracle In-Memory option to improve analytic queries
In-Memory is now the trend for database editors. But they do not implement in-memory storage for the same reason nor the same architecture. Oracle In-Memory option directly addresses BI reporting. Oracle has always favored an hybrid approach where we can query the OLTP database (from Oracle 6 the reads do not block the writes) and the In-Memory approach follows the same philosophy: run efficient analytic queries on OLTP databases. Their first approach to columnar storage was bitmap indexes in 8i, which were very efficient to support ad-hoc queries but not compatible with an OLTP workload. Then came the Exadata SmartScan and Hybrid Columnar Compression that was still addressing datawarehouses load and reporting.
The 12c In-Memory option now gives columnar and in-memory efficiency directly on the OLTP database, without changing any design or code. A demo will show how this option can be used.
Project Management is often seen as a complex activity. MS Office Project 2007 makes things easier as a tool to effective project management. This tutorial gives a general guideline to manage your projects.
Google Analytics 101 for Business - How to Get Started With Google AnalyticsJeff Sauer
Google Analytics is a widely adopted platform for websites and is used by most Internet marketers, but do we know its origins? Learn the basics about why we need Google Analytics, how to get started, and what to do in order to ensure success. Then look into some of the more advanced things that you can do with the tool in this presentation.
Google Analytics 101, with a sneak preview into the things you can do with Google Analytics 201, 301 and even 401.
Google Analytics 101 provides an introductory lesson on features of Google Analytics including Audience, Behavior, Conversion and A/B Testing. If you are considering a website redesign, you should review this to get familiar with how to integrate analytics. Check out http://insivia.com to learn more.
Introduction To Microsoft SharePoint 2013Vishal Pawar
Microsoft SharePoint is a Web application platform developed by Microsoft. First launched in 2001, SharePoint has historically been associated with intranet content management and document management, but recent versions have significantly broader capabilities
How to Make Awesome SlideShares: Tips & TricksSlideShare
Turbocharge your online presence with SlideShare. We provide the best tips and tricks for succeeding on SlideShare. Get ideas for what to upload, tips for designing your deck and more.
Website Development Explained (abriged from "The Website Manager's Handbook")Shane Diffily
Website Development is a process for creating a new website or implementing changes to one already in use, e.g. adding a significant
new section to a live site.
This extract from "The Website Manager's Handbook" outlines the key activities involved & how they link together.
Research: Developing an Interactive Web Information Retrieval and Visualizati...Roman Atachiants
Finding the needed information (images, articles or other) is not always as simple as going to a search en-
gine. This paper aim at developing an interactive presentation system, able to cope with live presentation
challenges.
How many times your project was jammed because it depended on other project, shared resources with other projects, or simply waiting for something that others from your company had to provide? It’s like you are driving a car on the roads with no signs, no rules, but with police to blame you.
How many times did you tried to implement rules from the book? It like reading Grunf’s (Alan Ford) advices “If you want to win, you must not lose”.
So: How to do it? Which is the right way? How much it will cost? How long it takes? What we will gain? Come to share ideas and experience
Is your company starting to implement online marketing strategies such as SEO, PPC or social media? If this is the case, are you tracking your efforts through a web analytics platform like Google Analytics? If not, you may be wasting your time as you have no idea which strategies are driving traffic and converting visitors to leads or sales. If you are utilizing Google Analytics, what metrics are you looking at to determine campaign effectiveness? This presentation will provide info on the following: Google Analytics setup, advanced reporting features and reports offered by Google's free analytics platform. Learn how to measure your efforts, and better understand what success looks like.
Oracle In-Memory option to improve analytic queries
In-Memory is now the trend for database editors. But they do not implement in-memory storage for the same reason nor the same architecture. Oracle In-Memory option directly addresses BI reporting. Oracle has always favored an hybrid approach where we can query the OLTP database (from Oracle 6 the reads do not block the writes) and the In-Memory approach follows the same philosophy: run efficient analytic queries on OLTP databases. Their first approach to columnar storage was bitmap indexes in 8i, which were very efficient to support ad-hoc queries but not compatible with an OLTP workload. Then came the Exadata SmartScan and Hybrid Columnar Compression that was still addressing datawarehouses load and reporting.
The 12c In-Memory option now gives columnar and in-memory efficiency directly on the OLTP database, without changing any design or code. A demo will show how this option can be used.
Project Management is often seen as a complex activity. MS Office Project 2007 makes things easier as a tool to effective project management. This tutorial gives a general guideline to manage your projects.
Google Analytics 101 for Business - How to Get Started With Google AnalyticsJeff Sauer
Google Analytics is a widely adopted platform for websites and is used by most Internet marketers, but do we know its origins? Learn the basics about why we need Google Analytics, how to get started, and what to do in order to ensure success. Then look into some of the more advanced things that you can do with the tool in this presentation.
Google Analytics 101, with a sneak preview into the things you can do with Google Analytics 201, 301 and even 401.
Google Analytics 101 provides an introductory lesson on features of Google Analytics including Audience, Behavior, Conversion and A/B Testing. If you are considering a website redesign, you should review this to get familiar with how to integrate analytics. Check out http://insivia.com to learn more.
Introduction To Microsoft SharePoint 2013Vishal Pawar
Microsoft SharePoint is a Web application platform developed by Microsoft. First launched in 2001, SharePoint has historically been associated with intranet content management and document management, but recent versions have significantly broader capabilities
How to Make Awesome SlideShares: Tips & TricksSlideShare
Turbocharge your online presence with SlideShare. We provide the best tips and tricks for succeeding on SlideShare. Get ideas for what to upload, tips for designing your deck and more.
Website Development Explained (abriged from "The Website Manager's Handbook")Shane Diffily
Website Development is a process for creating a new website or implementing changes to one already in use, e.g. adding a significant
new section to a live site.
This extract from "The Website Manager's Handbook" outlines the key activities involved & how they link together.
Research: Developing an Interactive Web Information Retrieval and Visualizati...Roman Atachiants
Finding the needed information (images, articles or other) is not always as simple as going to a search en-
gine. This paper aim at developing an interactive presentation system, able to cope with live presentation
challenges.
Brightwork Project Management Introductory Guide - From AtidanDavid J Rosenthal
BrightWork is the first collaborative Project and Portfolio Management product that was built on Microsoft SharePoint. BrightWork enables any organization to instantly deploy an affordable amount of project and portfolio management, delivering immediate visibility and control. The unique best practices template approach pioneered by BrightWork allows organizations to start quickly and evolve gradually, adding more templates and dashboards as needed and as ready.
Dos and dont's of sw architecture by Kamil WiteckiKamil Witecki
SW Architects are technical leaders. We will explore non technical aspects related to tasks SW Architect deals with. We will learn, that users, organization and business are equally important as technical aspects. As a result we will provide greater products in future.
A brownbag presentation at IPC media in London about the need to use libraries to make web development much less random and more professional. Get the audio at: http://www.archive.org/details/ProfessionalWebDevelopmentWithLibraries
Microsoft Teams Phone
Stay connected with voice and video calling using Microsoft Teams Phone on your computer, tablet, mobile device, or desk phone.
Stay connected with a modern calling solution
Make and receive voice and video calls directly in Microsoft Teams. Stay in touch and get more done anywhere.
Calling in the flow of work
Work smarter with an all-in-one app that brings together calling, chat, meetings, and collaboration.
Business-critical calling
Use built-in, innovative, and AI-powered calling experiences and integrated partner software solutions.
Devices for any calling scenario
Benefit from a wide portfolio of devices for any business need and get flexible financing options.
Simple set up and management
Easily add, monitor, and manage voice and video calling from the Teams admin center.
Microsoft Teams Phone with Calling Plan includes:
Cloud-based phone system with advanced features including call transfer, multilevel auto attendants, and call queues.
A domestic calling plan with 3,000 minutes2 per user, per month within the US and Canada.
Call from anywhere, on any device through the Microsoft Teams app on desktop, mobile, web, and desk phones.
Around-the-clock customer support seven days a week, backed by Microsoft.
Teams Phone with Calling Plan requires a Microsoft 365 subscription that includes Microsoft Teams
Microsoft Teams
Built for hybrid work
Feel seen and heard no matter where you are and do your best work, your way.
Empower people and teams in a hybrid work world
Flexible work is here to stay, and embracing it is critical to your future success. The latest tools from Microsoft empower hybrid work environments and enable flexible work beyond organizational boundaries.
Whats New in Microsoft Teams Hybrid Meetings November 2021David J Rosenthal
Microsoft Teams
Built for hybrid work
Feel seen and heard no matter where you are and do your best work, your way.
Empower people and teams in a hybrid work world
Flexible work is here to stay, and embracing it is critical to your future success. The latest tools from Microsoft empower hybrid work environments and enable flexible work beyond organizational boundaries.
Microsoft Viva Connections
A curated, company-branded experience that brings together relevant news, conversations, and resources in the apps and devices you use every day. Viva Connections is included in all Microsoft 365 plans with SharePoint Online.
Create connection
Encourage meaningful connections across the organization in a hybrid workplace.
Drive alignment
Rally the entire organization around your vision, mission, and strategic priorities.
Empower contribution
Foster a culture of inclusion by empowering every employee to contribute ideas and share feedback.
Built on Microsoft 365
Deploy and manage Viva Connections through your existing infrastructure.
Protect your hybrid workforce across the attack chainDavid J Rosenthal
Security is one of the most important considerations for SMBs. In fact, 77% of SMBs in a recent survey consider security a top feature when purchasing new PCs.1
Last year alone, 67% of SMBs experienced a security breach that cost, on average, 3.3% of their revenue.1 That’s a big risk to both profitability and reputation, and it shows how critical strong security protections are for businesses.
The good news is that 69% of SMBs in a recent survey agreed that new Windows 10 Pro devices offered better security and data protection than older devices.1
Research shows that modern devices help business owners by preventing identity attacks, minimizing phishing, and reducing the risk of malware attacks. These are all common ways that bad actors steal business data, steal personal information, or hold our devices hostage in exchange for huge amounts of ransom money.
And with modern PCs, most security functions can happen in the cloud, without interrupting worker productivity.
Connections is a company branded employee app in Teams. It is a gateway to your employee experience, with personalized news, communications, tasks, people and resources. It provides a single curated employee destination that can be configured for specific roles like frontline workers. So, leaders can communicate and engage their employees, and employees can get easy access to the tools and resources they need from one place.. Connections builds on existing capabilities in Microsoft 365 like SharePoint and Yammer. And it pulls your communications together into a pre-configured app in Teams, designed for both desktop and mobile workers. It also acts as a launching pad to the other 3 Viva modules
Insights brings together Workplace Analytics, MyAnalytics and Glint into a unified insights app in Teams to provide data-driven and privacy-protected insights for individuals, managers and leaders. For example, employees get personalized insights, only they can see, that help them protect their time for breaks, focused work, and learning in order to promote improved productivity and wellbeing.
Topics focuses on knowledge and expertise. Topics applies AI to identify knowledge and experts and organize them into shared topics. AI automatically creates a topic page for each topic. It’s like Wikipedia for the enterprise where AI does the first draft. And these topic pages are surfaced as Topic Cards right in the flow of work in Office and Teams.
Finally, Learning allows employees to easily discover informal and formal learning in the flow of work. It aggregates content from LinkedIn Learning, Microsoft Learn and 3rd party training content and your own organizations content – all in one place. Along with providing aggregation and recommendations, it also allows managers to assign and track training, as well as report on training within and across teams.
Connections is a company branded employee app in Teams. It is a gateway to your employee experience, with personalized news, communications, tasks, people and resources. It provides a single curated employee destination that can be configured for specific roles like frontline workers. So, leaders can communicate and engage their employees, and employees can get easy access to the tools and resources they need from one place.. Connections builds on existing capabilities in Microsoft 365 like SharePoint and Yammer. And it pulls your communications together into a pre-configured app in Teams, designed for both desktop and mobile workers. It also acts as a launching pad to the other 3 Viva modules
Insights brings together Workplace Analytics, MyAnalytics and Glint into a unified insights app in Teams to provide data-driven and privacy-protected insights for individuals, managers and leaders. For example, employees get personalized insights, only they can see, that help them protect their time for breaks, focused work, and learning in order to promote improved productivity and wellbeing.
Topics focuses on knowledge and expertise. Topics applies AI to identify knowledge and experts and organize them into shared topics. AI automatically creates a topic page for each topic. It’s like Wikipedia for the enterprise where AI does the first draft. And these topic pages are surfaced as Topic Cards right in the flow of work in Office and Teams.
Finally, Learning allows employees to easily discover informal and formal learning in the flow of work. It aggregates content from LinkedIn Learning, Microsoft Learn and 3rd party training content and your own organizations content – all in one place. Along with providing aggregation and recommendations, it also allows managers to assign and track training, as well as report on training within and across teams.
Connections is a company branded employee app in Teams. It is a gateway to your employee experience, with personalized news, communications, tasks, people and resources. It provides a single curated employee destination that can be configured for specific roles like frontline workers. So, leaders can communicate and engage their employees, and employees can get easy access to the tools and resources they need from one place.. Connections builds on existing capabilities in Microsoft 365 like SharePoint and Yammer. And it pulls your communications together into a pre-configured app in Teams, designed for both desktop and mobile workers. It also acts as a launching pad to the other 3 Viva modules
Insights brings together Workplace Analytics, MyAnalytics and Glint into a unified insights app in Teams to provide data-driven and privacy-protected insights for individuals, managers and leaders. For example, employees get personalized insights, only they can see, that help them protect their time for breaks, focused work, and learning in order to promote improved productivity and wellbeing.
Topics focuses on knowledge and expertise. Topics applies AI to identify knowledge and experts and organize them into shared topics. AI automatically creates a topic page for each topic. It’s like Wikipedia for the enterprise where AI does the first draft. And these topic pages are surfaced as Topic Cards right in the flow of work in Office and Teams.
Finally, Learning allows employees to easily discover informal and formal learning in the flow of work. It aggregates content from LinkedIn Learning, Microsoft Learn and 3rd party training content and your own organizations content – all in one place. Along with providing aggregation and recommendations, it also allows managers to assign and track training, as well as report on training within and across teams.
Our end-to-end, integrated portfolio of cloud solutions across Microsoft 365, Dynamics 365, and Azure is built on a foundation of security and privacy and helps every organization in every industry build resilience and improve the bottom line.
Azure Arc offers simplified management, faster app development, and consistent Azure services. Easily organize, govern, and secure Windows, Linux, SQL Server, and Kubernetes clusters across data centers, the edge, and multicloud environments right from Azure. Architect, design, and build cloud-native apps anywhere without sacrificing central visibility and control. Get Azure innovation and cloud benefits by deploying consistent Azure data, application, and machine learning services on any infrastructure.
Gain central visibility, operations, and compliance
Centrally manage a wide range of resources including Windows and Linux servers, SQL server, Kubernetes clusters, and Azure services.
Establish central visibility in the Azure portal and enable multi-environment search with Azure Resource Graph.
Meet governance and compliance standards for apps, infrastructure, and data with Azure Policy.
Delegate access and manage security policies for resources using role-based access control (RBAC) and Azure Lighthouse.
Organize and inventory assets through a variety of Azure scopes, such as management groups, subscriptions, resource groups, and tags.
Learn more about hybrid and multicloud management in the Microsoft Cloud Adoption Framework for Azure.
Windows Server 2022 is now in preview, the next release in our Long-Term Servicing Channel (LTSC), which will be generally available later this calendar year. It builds on Windows Server 2019, our fastest adopted Windows Server ever. This release includes advanced multi-layer security, hybrid capabilities with Azure, and a flexible platform to modernize applications with containers.
Windows 365 also creates a new hybrid personal computing category called Cloud PC, which uses both the power of the cloud and the capabilities of the device to provide a full, personalized Windows experience. This new Windows experience comes as organizations around the world grapple with the best ways to facilitate hybrid work models where employees are both on-site and distributed across the globe.
The Windows 365 Cloud PC experience is:
Versatile, familiar and productive by delivering users their personalized content, settings, and applications
Simple to deploy and manage from a single console, easy for anyone to use
Secure by design, leaving no data on the device
Available on any device and optimized for the best experience on a Windows PC at a predictable price
And lastly, it’s scalable and resilient to support changing workforce needs and new business scenarios
Designed for hybrid work
Productive
Improve employee productivity and focus with a simple, powerful user experience.
Collaborative
Discover a smarter way to collaborate with Microsoft Teams integration.
Secure
Protect data and secure access with a Zero Trust-ready operating system.
Consistent
Make adoption easy with app compatibility and cloud management.
Productive and collaborative
Reach your individual and team goals with built-in assistance features in Windows 11.
Simple, modern visuals
Snap assist
Personalized widgets
Intelligent video conferencing
Share a window while presenting
Meet now in Microsoft Teams
The Microsoft Teams call and chat function in the taskbar of Windows 11.
Meet now in Microsoft Teams
Connect with anyone on any platform with fast, easy-to-use calling and chat right from the taskbar.
The most secure Windows yet
Increase security with hardware-based integrity protection in Windows 11, from the silicon to the cloud.
Go passwordless
Get secure, multifactor single sign-on from devices to the cloud and apps with Windows Hello for Business.
Perfect for remote work
Ship employees a corporate-owned device secured by company policy and easily provisioned by them.
Microsoft Scheduler for M365 - Personal Digital AssistantDavid J Rosenthal
An assistant for everyone
Enjoy the speed of a virtual assistant augmented with human understanding.
Easy scheduling
Save time by handing off the time-consuming task of scheduling using your own words.
Works 24/7
Request a meeting at any time. Cortana works around the clock even when you are offline or busy.
You control your data
Scheduler works within your Microsoft 365 compliance boundaries and keeps the data inside your organization. You control your data.
Smart technology with human assistance
Increased reliability that will always complete your request by using human assistance to resolve ambiguities and context.
Grows with your needs
Available 24/7 and capable of handling thousands of requests at the same time.
What is New in Teams Meetings and Meeting Rooms July 2021David J Rosenthal
Chat
Share your opinion, and your personality. Send gifs, stickers, and emojis in a group chat or in one-to-one messages.
Instant messaging
Meet
Instantly go from group chat to video conference with the touch of a button. Teams of 2 or 10,000 can meet in one place, no matter how many places they’re in.
Online meetings
Call
Make and receive calls with internal and external groups using Microsoft Teams Phone, Operator Connect, or Direct Routing.
Voice calling
Collaborate
Easily find, share, and edit files in real time using familiar apps like Word, PowerPoint, and Excel in Teams.
Video conferencing
Make meetings more personal and increase your productivity by collaborating in real time.
Screen sharing
Keep everyone on the same page by sharing your screen so they can see the same content.
Custom backgrounds
Create the perfect virtual setting by choosing, uploading, or blurring your background.
Together mode
Digitally sit in a shared background, making it feel like you’re in the same room with everyone else.1
File sharing
Co-author files in real time. Securely store, access, share, and collaborate on files from anywhere.
Apps and workflows
Streamline tasks and critical business processes by integrating apps and workflows.
Market availability
Available in 53 languages and 181 markets. Connect across Windows, Mac, iOS, and Android.
Privacy and security
Meet regulatory, legal, and organizational needs with industry-leading compliance offerings.
The Java ecosystem is very broad, with different technologies including Java SE, Java EE/Jakarta EE, Spring, numerous application servers, and other frameworks. Wherever you are in Java, Azure supports your workload and process with an abundance of choice – from IaaS to fully managed services. You can run any application architecture, from monoliths, to containerized monoliths, all the way to completely microservices based apps.
We see three broad patterns for running Java applications in the cloud, depending on how much control or productivity you need.
The first is lift and shift with Virtual Machines:
Virtual machines provide the most flexibility, control and visibility while moving to the cloud, especially for initial lift and shift of Java workloads. Azure provides a variety of Java focused VM images and solutions templates in the Azure Marketplace to get you up and running quickly.
The second is modernization using containers:
Containers provide portability, flexibility, scalability, manageability, repeatability, and predictability.
Azure provides best of breed support for Docker and Kubernetes, especially through the Azure Kubernetes Service (AKS) and Azure Red Hat OpenShift.
Finally, Azure has the most managed hosting options for Java applications of any major cloud platform with fully managed PaaS for Spring, Tomcat, and JBoss EAP:
Managed services offer ease-of-use, ease-of-management, productivity, and lower total cost of ownership.
You can focus on building your applications, not managing infrastructure.
All of this is supported by managed databases and DevOps tooling:
Use fully managed SQL and NoSQL databases, including PostgreSQL, MySQL, Cosmos DB, and SQL.
Keep using the tools you love, with plugins for IntelliJ and Eclipse, integrations with a variety of DevOps tools like Maven, Gradle, Jenkins, and GitHub.
Get comprehensive protection across all your platforms and clouds
Protect your organization from threats across devices, identities, apps, data and clouds. Get unmatched visibility into your multiplatform environment that unifies Security Information and Event Management (SIEM) and Extended Detection and Response (XDR). Simplify your security stack with Azure Sentinel and Microsoft Defender.
Protect your business with a universal identity platform
The Azure Active Directory (Azure AD) enterprise identity service provides single sign-on and multi-factor authentication to help protect your users from 99.9 percent of cybersecurity attacks.
Gartner named Microsoft a leader in Magic Quadrant 2020 for Access Management
Single sign-on simplifies access to your apps from anywhere
Conditional Access and multi-factor authentication help protect and govern access
A single identity platform lets you engage with internal and external users more securely
Developer tools make it easy to integrate identity into your apps and services
Connect your workforce
Whether people are on-site or remote, give them seamless access to all their apps so they can stay productive from anywhere. Automate workflows for user lifecycle and provisioning. Save time and resources with self-service management.
Choose from thousands of SaaS apps
Simplify single sign-on. Azure AD supports thousands of pre-integrated software as a service (SaaS) applications.
Protect and govern access
Safeguard user credentials by enforcing strong authentication and conditional access policies. Efficiently manage your identities by ensuring that the right people have the right access to the right resources.
Engage with your customers and partners
Secure and manage customers and partners beyond your organizational boundaries, with one identity solution. Customize user journeys and simplify authentication with social identity and more.
Integrate identity into your apps
Accelerate adoption of your application in the enterprise by supporting single sign-on and user provisioning. Reduce sign-in friction and automate the creation, removal, and maintenance of user accounts.
The Nintex Platform is Easy-to-use, Powerful and Complete to manage, automate and optimize your processes.
Manage processes by discovering, mapping and sharing across process participants and owners.
This often leads to opportunities for process automation. Many processes involve the capture of information and our forms capability provides an ease-to-use, responsive design experience, often eliminating paper forms. With advanced workflow capabilities you can quickly design powerful applications using advanced logic and rules to eliminate manual work. Nintex RPA drives speed by automating those mundane, repetitive tasks. Since many processes involve the need to generate a document we have a DocGen offering to automatically create documents from both unstructured and structured data sources. With Nintex Sign powered by Adobe Sign you can easily integrate eSign into your signature-based workflows for total automation.
Once you have been managing and automating processes, imagine the amount of information available on how your business is operating. Leveraging Nintex Analytics you are able to get process intelligence allowing you to monitor, analyze and improve your business.
With the Nintex platform our customers and partners value our extensibility, using pre-built connecters as well as leveraging our Xtensions to build powerful bi-directional connectors to orchestrate processes across any systems in your organization.
Combining the power of Nintex with our customer success and vast partner network it is easy to see why our customers are so successful.
Microsoft Power BI is a unified self-service and enterprise business intelligence platform that combines an intuitive user experience with intelligent data visualizations to provide greater depth of data insight. Reports can be shared within Microsoft tools like Teams, SharePoint, PowerPoint, or within other productivity products.
UiPath Test Automation using UiPath Test Suite series, part 3DianaGray10
Welcome to UiPath Test Automation using UiPath Test Suite series part 3. In this session, we will cover desktop automation along with UI automation.
Topics covered:
UI automation Introduction,
UI automation Sample
Desktop automation flow
Pradeep Chinnala, Senior Consultant Automation Developer @WonderBotz and UiPath MVP
Deepak Rai, Automation Practice Lead, Boundaryless Group and UiPath MVP
Elevating Tactical DDD Patterns Through Object CalisthenicsDorra BARTAGUIZ
After immersing yourself in the blue book and its red counterpart, attending DDD-focused conferences, and applying tactical patterns, you're left with a crucial question: How do I ensure my design is effective? Tactical patterns within Domain-Driven Design (DDD) serve as guiding principles for creating clear and manageable domain models. However, achieving success with these patterns requires additional guidance. Interestingly, we've observed that a set of constraints initially designed for training purposes remarkably aligns with effective pattern implementation, offering a more ‘mechanical’ approach. Let's explore together how Object Calisthenics can elevate the design of your tactical DDD patterns, offering concrete help for those venturing into DDD for the first time!
Accelerate your Kubernetes clusters with Varnish CachingThijs Feryn
A presentation about the usage and availability of Varnish on Kubernetes. This talk explores the capabilities of Varnish caching and shows how to use the Varnish Helm chart to deploy it to Kubernetes.
This presentation was delivered at K8SUG Singapore. See https://feryn.eu/presentations/accelerate-your-kubernetes-clusters-with-varnish-caching-k8sug-singapore-28-2024 for more details.
GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...James Anderson
Effective Application Security in Software Delivery lifecycle using Deployment Firewall and DBOM
The modern software delivery process (or the CI/CD process) includes many tools, distributed teams, open-source code, and cloud platforms. Constant focus on speed to release software to market, along with the traditional slow and manual security checks has caused gaps in continuous security as an important piece in the software supply chain. Today organizations feel more susceptible to external and internal cyber threats due to the vast attack surface in their applications supply chain and the lack of end-to-end governance and risk management.
The software team must secure its software delivery process to avoid vulnerability and security breaches. This needs to be achieved with existing tool chains and without extensive rework of the delivery processes. This talk will present strategies and techniques for providing visibility into the true risk of the existing vulnerabilities, preventing the introduction of security issues in the software, resolving vulnerabilities in production environments quickly, and capturing the deployment bill of materials (DBOM).
Speakers:
Bob Boule
Robert Boule is a technology enthusiast with PASSION for technology and making things work along with a knack for helping others understand how things work. He comes with around 20 years of solution engineering experience in application security, software continuous delivery, and SaaS platforms. He is known for his dynamic presentations in CI/CD and application security integrated in software delivery lifecycle.
Gopinath Rebala
Gopinath Rebala is the CTO of OpsMx, where he has overall responsibility for the machine learning and data processing architectures for Secure Software Delivery. Gopi also has a strong connection with our customers, leading design and architecture for strategic implementations. Gopi is a frequent speaker and well-known leader in continuous delivery and integrating security into software delivery.
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...Jeffrey Haguewood
Sidekick Solutions uses Bonterra Impact Management (fka Social Solutions Apricot) and automation solutions to integrate data for business workflows.
We believe integration and automation are essential to user experience and the promise of efficient work through technology. Automation is the critical ingredient to realizing that full vision. We develop integration products and services for Bonterra Case Management software to support the deployment of automations for a variety of use cases.
This video focuses on the notifications, alerts, and approval requests using Slack for Bonterra Impact Management. The solutions covered in this webinar can also be deployed for Microsoft Teams.
Interested in deploying notification automations for Bonterra Impact Management? Contact us at sales@sidekicksolutionsllc.com to discuss next steps.
Generating a custom Ruby SDK for your web service or Rails API using Smithyg2nightmarescribd
Have you ever wanted a Ruby client API to communicate with your web service? Smithy is a protocol-agnostic language for defining services and SDKs. Smithy Ruby is an implementation of Smithy that generates a Ruby SDK using a Smithy model. In this talk, we will explore Smithy and Smithy Ruby to learn how to generate custom feature-rich SDKs that can communicate with any web service, such as a Rails JSON API.
Software Delivery At the Speed of AI: Inflectra Invests In AI-Powered QualityInflectra
In this insightful webinar, Inflectra explores how artificial intelligence (AI) is transforming software development and testing. Discover how AI-powered tools are revolutionizing every stage of the software development lifecycle (SDLC), from design and prototyping to testing, deployment, and monitoring.
Learn about:
• The Future of Testing: How AI is shifting testing towards verification, analysis, and higher-level skills, while reducing repetitive tasks.
• Test Automation: How AI-powered test case generation, optimization, and self-healing tests are making testing more efficient and effective.
• Visual Testing: Explore the emerging capabilities of AI in visual testing and how it's set to revolutionize UI verification.
• Inflectra's AI Solutions: See demonstrations of Inflectra's cutting-edge AI tools like the ChatGPT plugin and Azure Open AI platform, designed to streamline your testing process.
Whether you're a developer, tester, or QA professional, this webinar will give you valuable insights into how AI is shaping the future of software delivery.
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...Ramesh Iyer
In today's fast-changing business world, Companies that adapt and embrace new ideas often need help to keep up with the competition. However, fostering a culture of innovation takes much work. It takes vision, leadership and willingness to take risks in the right proportion. Sachin Dev Duggal, co-founder of Builder.ai, has perfected the art of this balance, creating a company culture where creativity and growth are nurtured at each stage.
Neuro-symbolic is not enough, we need neuro-*semantic*Frank van Harmelen
Neuro-symbolic (NeSy) AI is on the rise. However, simply machine learning on just any symbolic structure is not sufficient to really harvest the gains of NeSy. These will only be gained when the symbolic structures have an actual semantics. I give an operational definition of semantics as “predictable inference”.
All of this illustrated with link prediction over knowledge graphs, but the argument is general.
GraphRAG is All You need? LLM & Knowledge GraphGuy Korland
Guy Korland, CEO and Co-founder of FalkorDB, will review two articles on the integration of language models with knowledge graphs.
1. Unifying Large Language Models and Knowledge Graphs: A Roadmap.
https://arxiv.org/abs/2306.08302
2. Microsoft Research's GraphRAG paper and a review paper on various uses of knowledge graphs:
https://www.microsoft.com/en-us/research/blog/graphrag-unlocking-llm-discovery-on-narrative-private-data/
LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...DanBrown980551
Do you want to learn how to model and simulate an electrical network from scratch in under an hour?
Then welcome to this PowSyBl workshop, hosted by Rte, the French Transmission System Operator (TSO)!
During the webinar, you will discover the PowSyBl ecosystem as well as handle and study an electrical network through an interactive Python notebook.
PowSyBl is an open source project hosted by LF Energy, which offers a comprehensive set of features for electrical grid modelling and simulation. Among other advanced features, PowSyBl provides:
- A fully editable and extendable library for grid component modelling;
- Visualization tools to display your network;
- Grid simulation tools, such as power flows, security analyses (with or without remedial actions) and sensitivity analyses;
The framework is mostly written in Java, with a Python binding so that Python developers can access PowSyBl functionalities as well.
What you will learn during the webinar:
- For beginners: discover PowSyBl's functionalities through a quick general presentation and the notebook, without needing any expert coding skills;
- For advanced developers: master the skills to efficiently apply PowSyBl functionalities to your real-world scenarios.
Designing Great Products: The Power of Design and Leadership by Chief Designe...
Working on Tasks in Microsoft Project Web Access
1. Working on tasks inProject
Web App:
A guide for team members
My Project Web App administrator is: [name]
[contact info line 1]
[contact info line 2]
My Project Web App address is: [URL]
3. Table of Contents3
Table of Contents
Table of Contents
3
Introduction
7
Hold on, what’s Project Web App? ................................... 7
Is this guide for Project Online or Project Server? ........... 8
I need help!...................................................................... 8
1
10

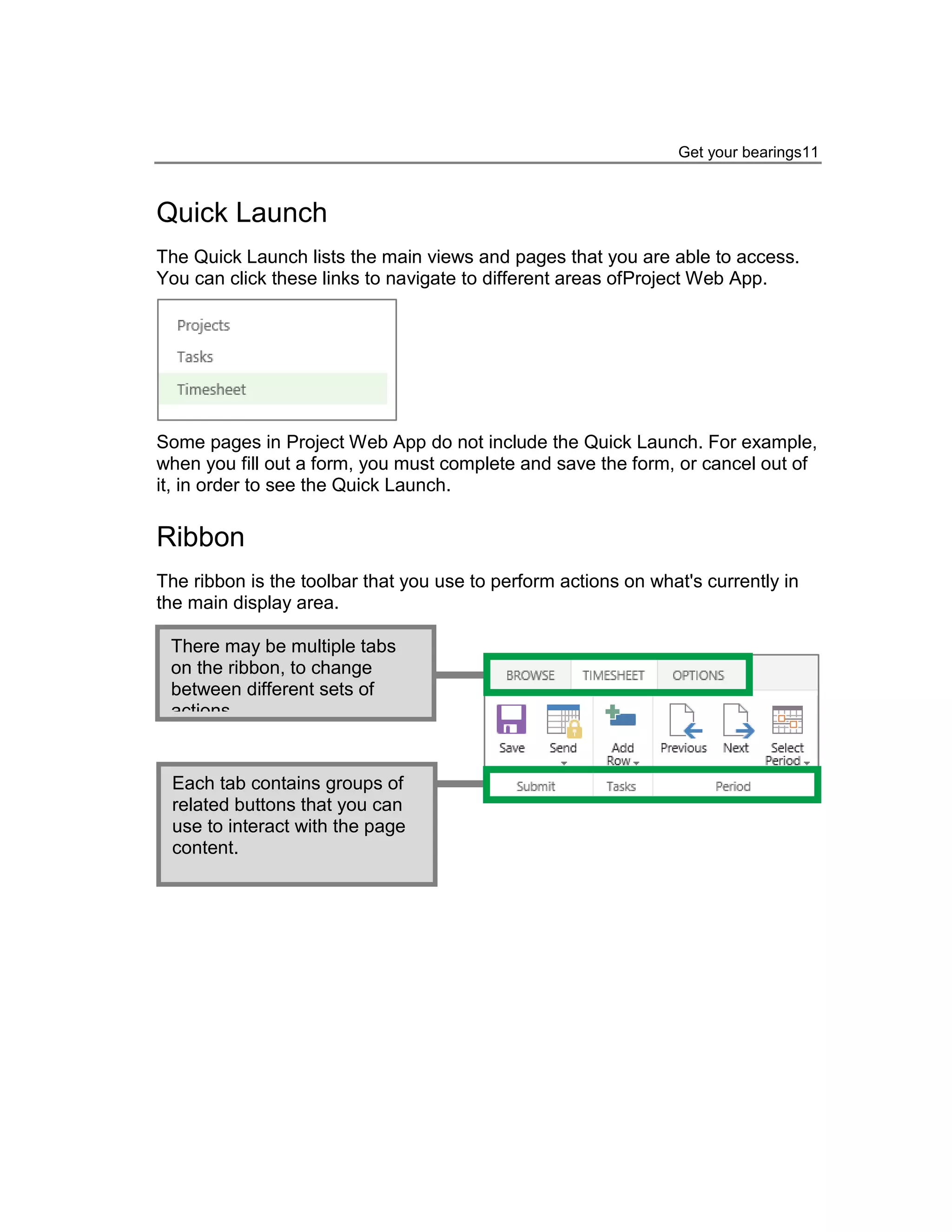

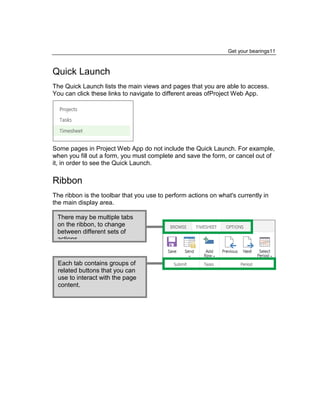

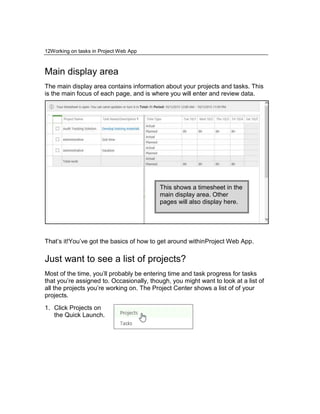

Get your bearings
10
Quick Launch ................................................................ 11
Ribbon ........................................................................... 11
Main display area .......................................................... 12
Just want to see a list of projects? ................................. 12
2
14

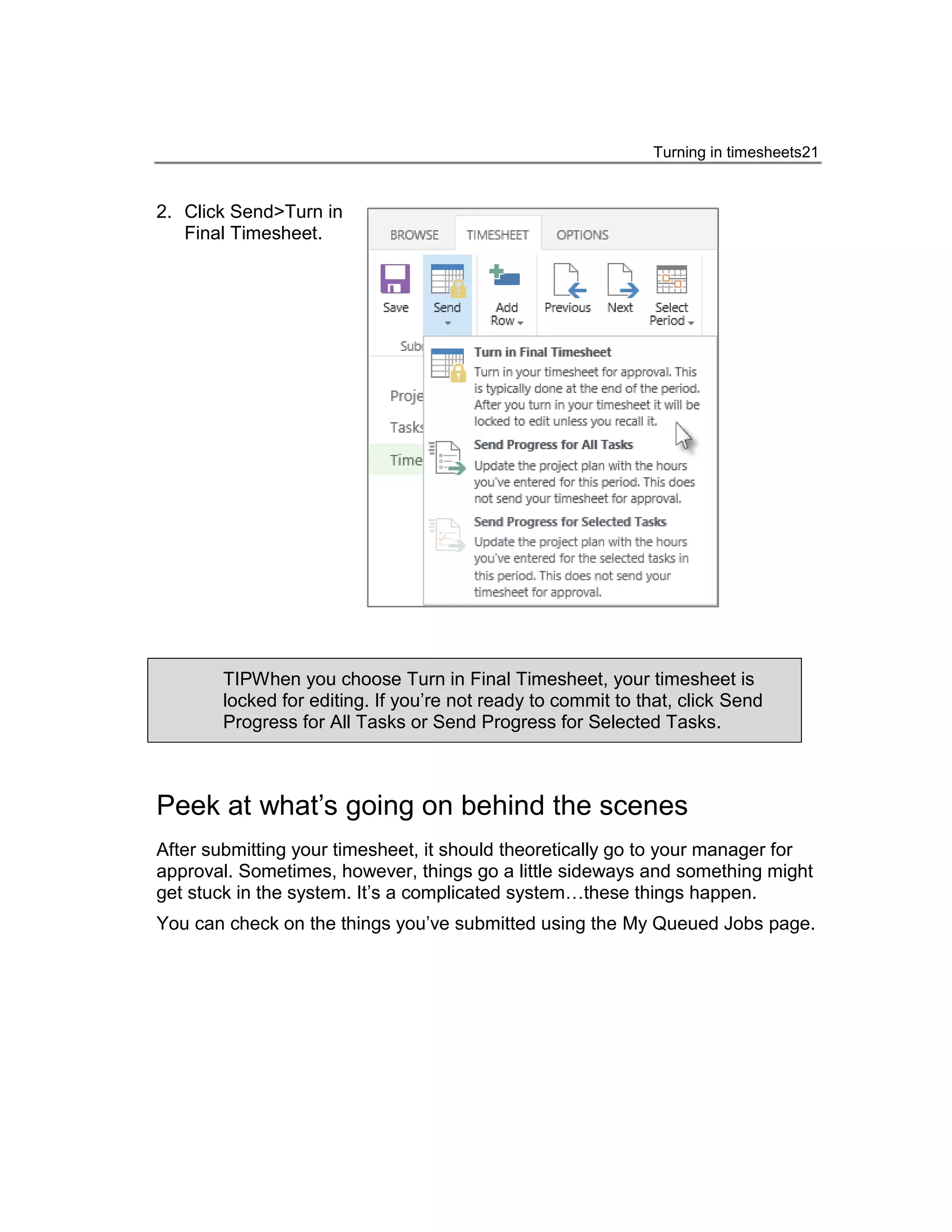

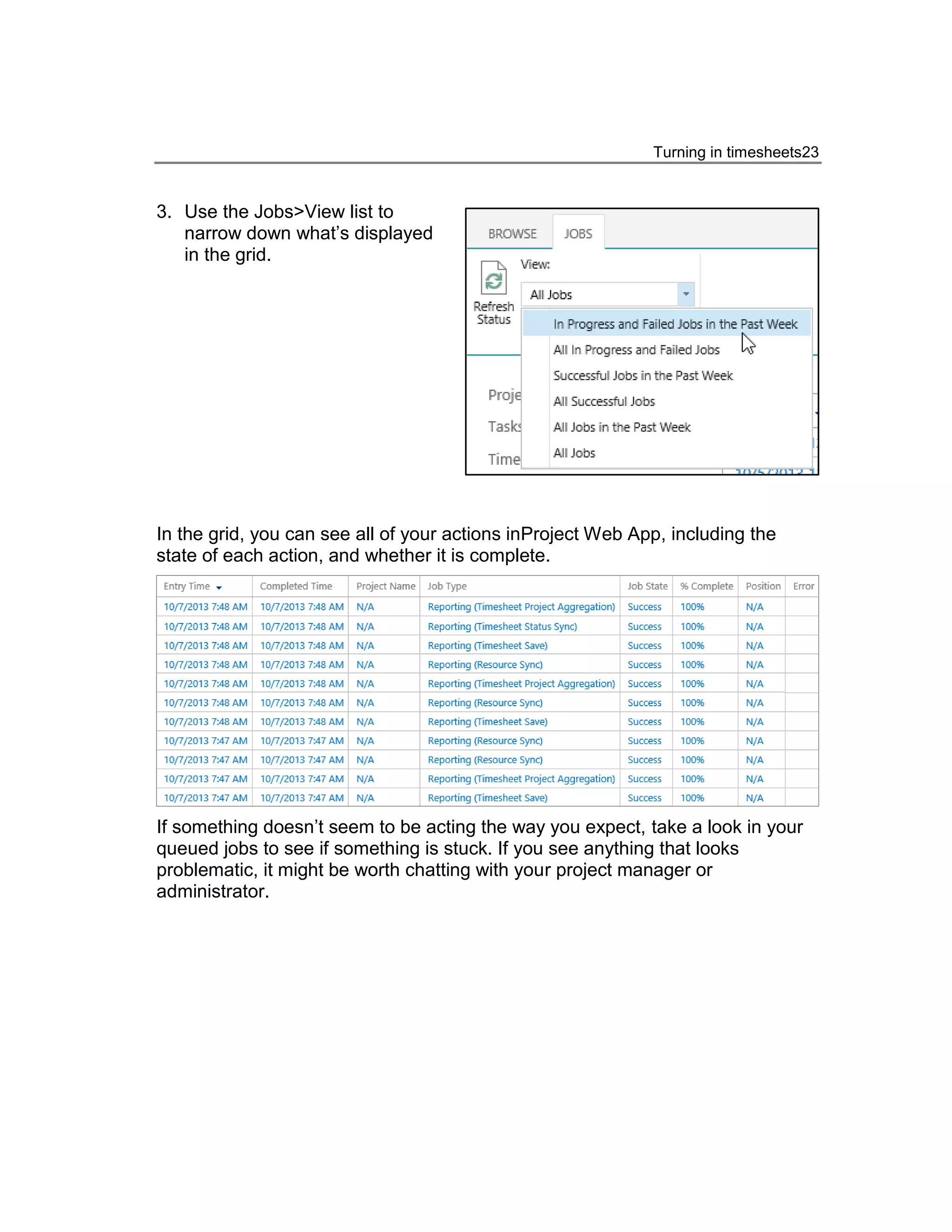

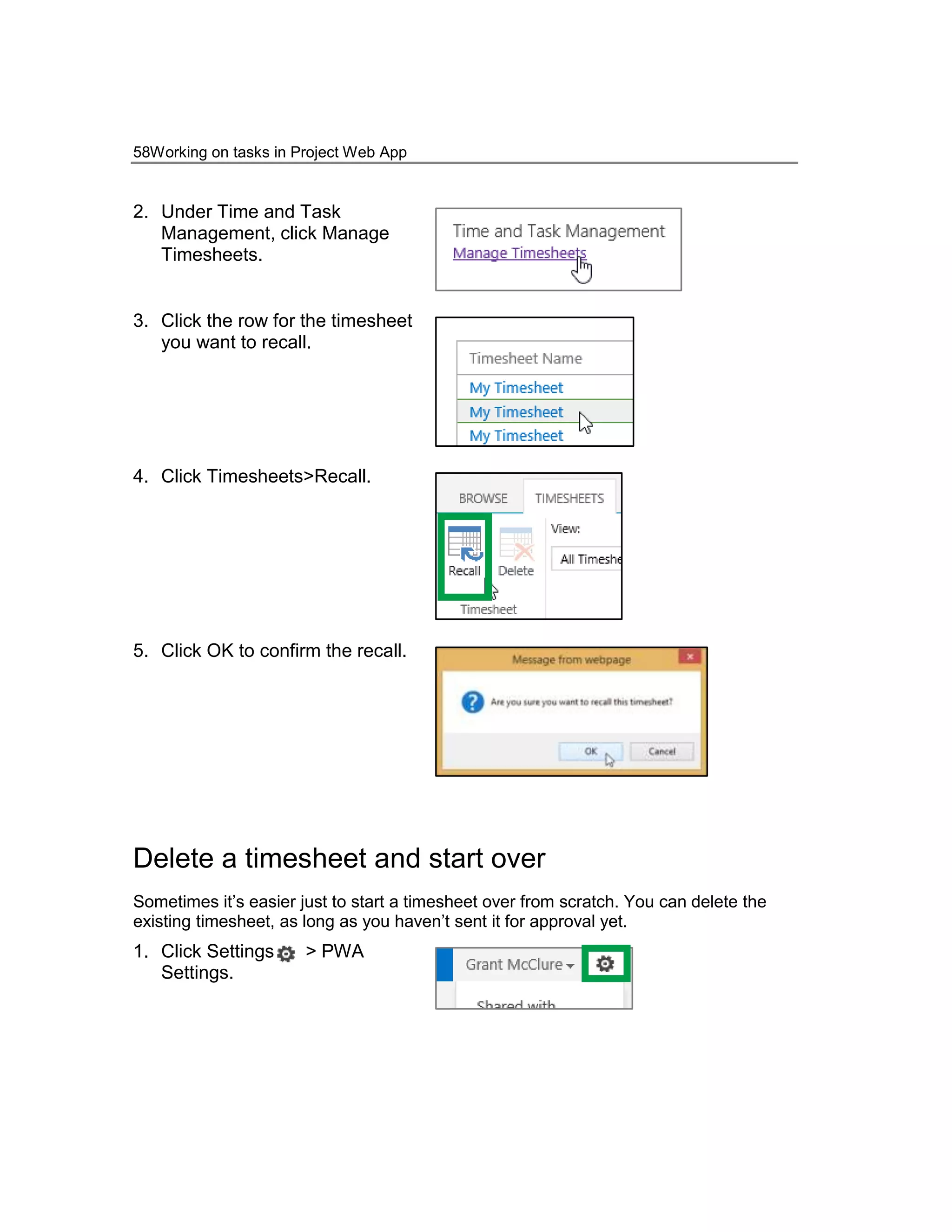

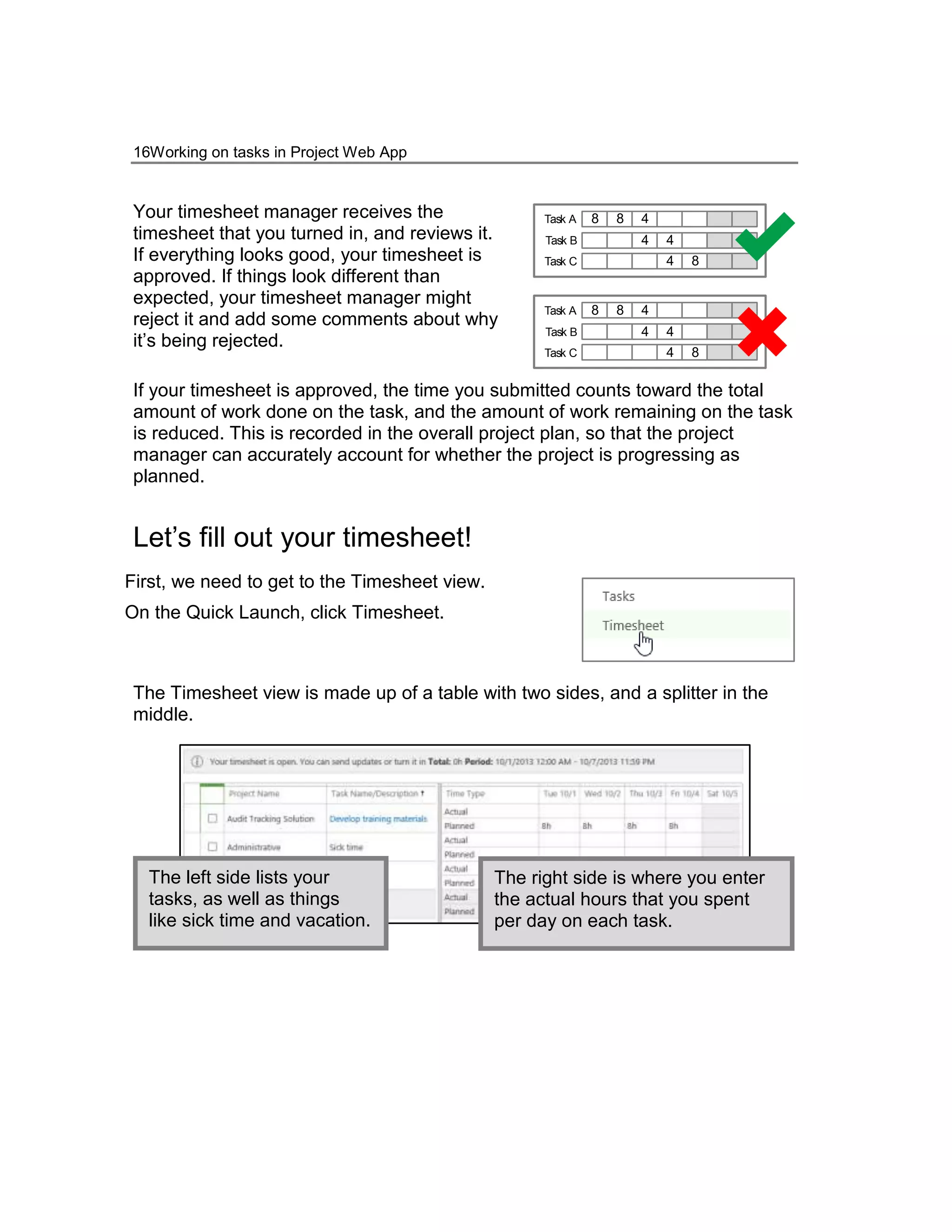

Turning in timesheets
14

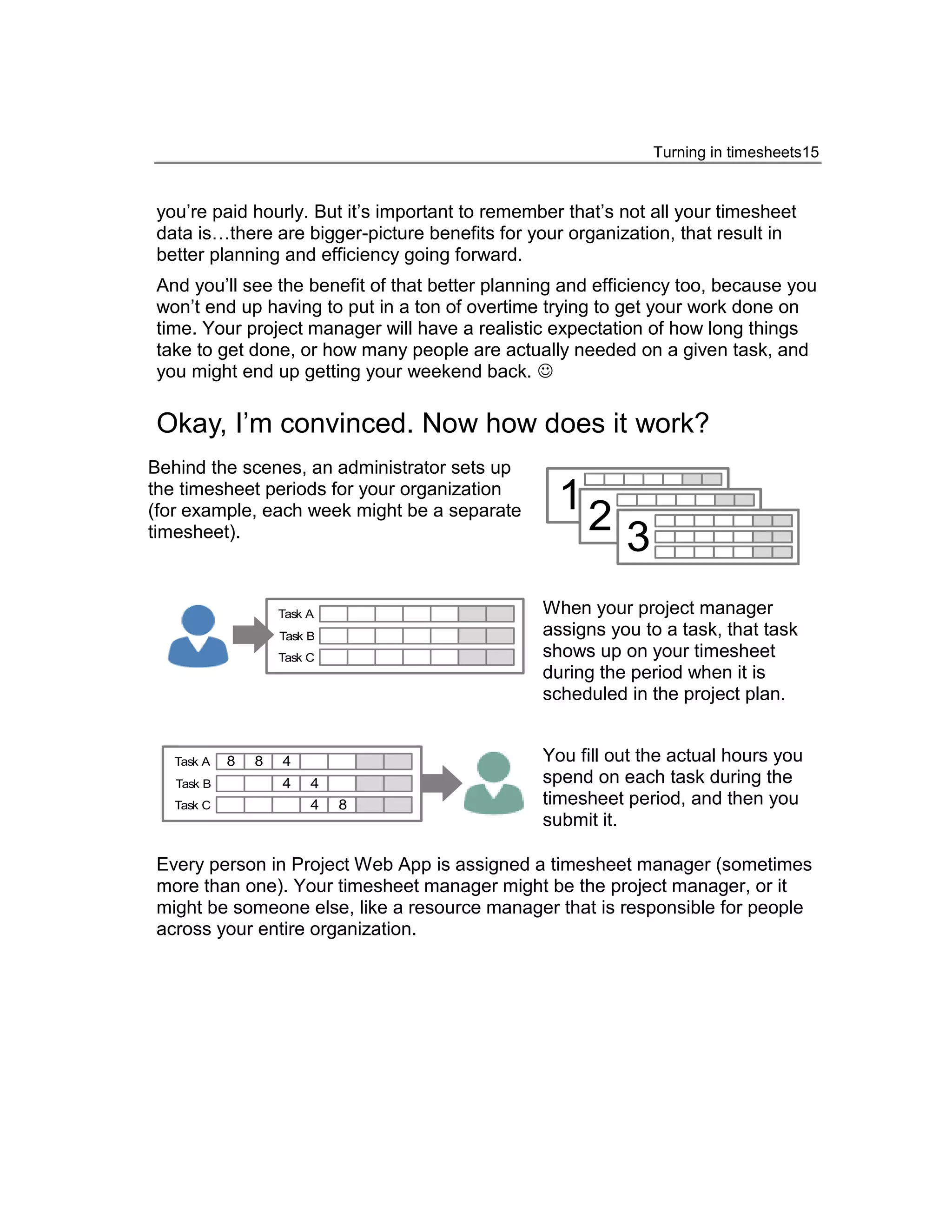

Why are timesheets important? ..................................... 14
Okay, I’m convinced. Now how does it work? ................ 15

Let’s fill out your timesheet! ........................................... 16
Ready to enter your hours? ........................................................................... 17
Don’t see the task you worked on? ............................................................... 17

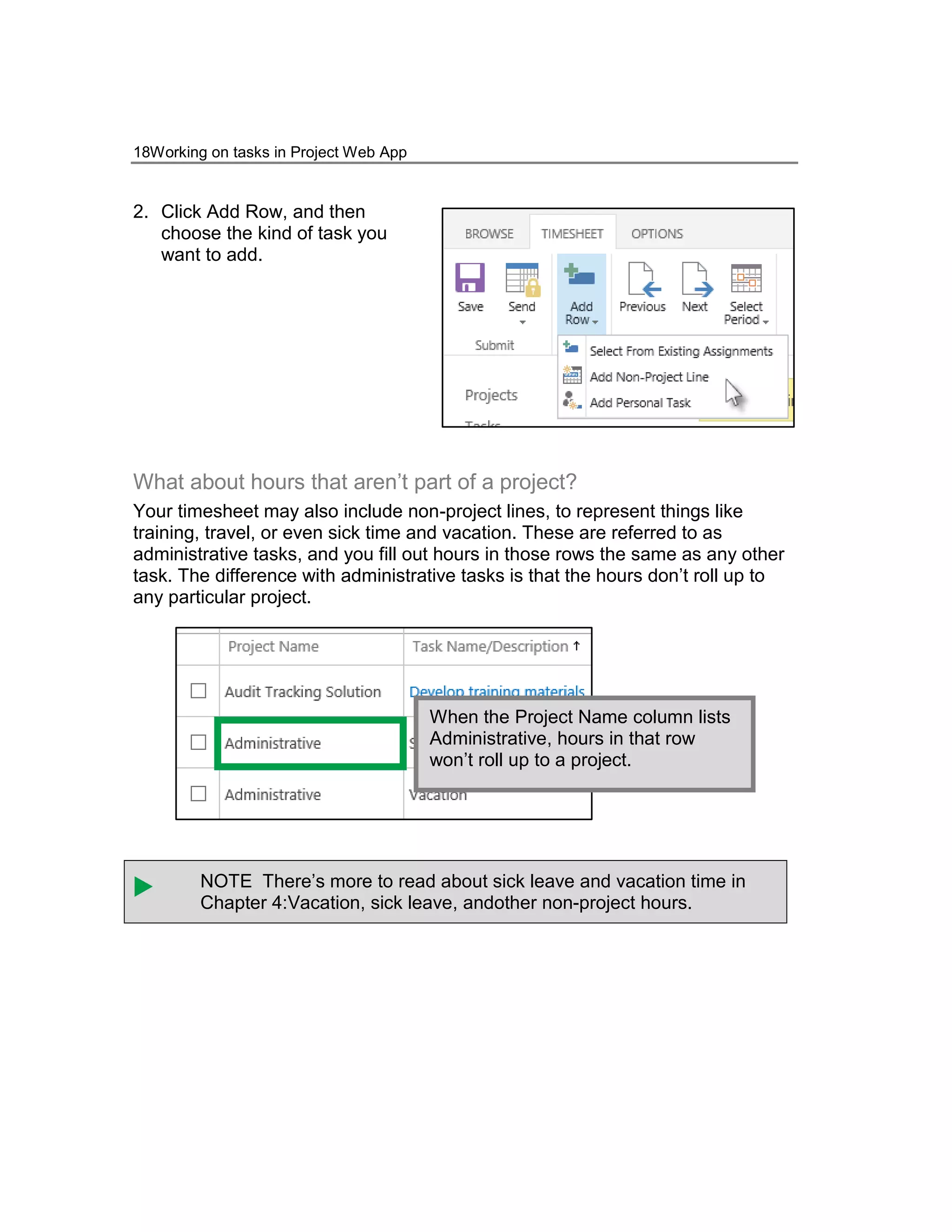

What about hours that aren’t part of a project? ............................................. 18

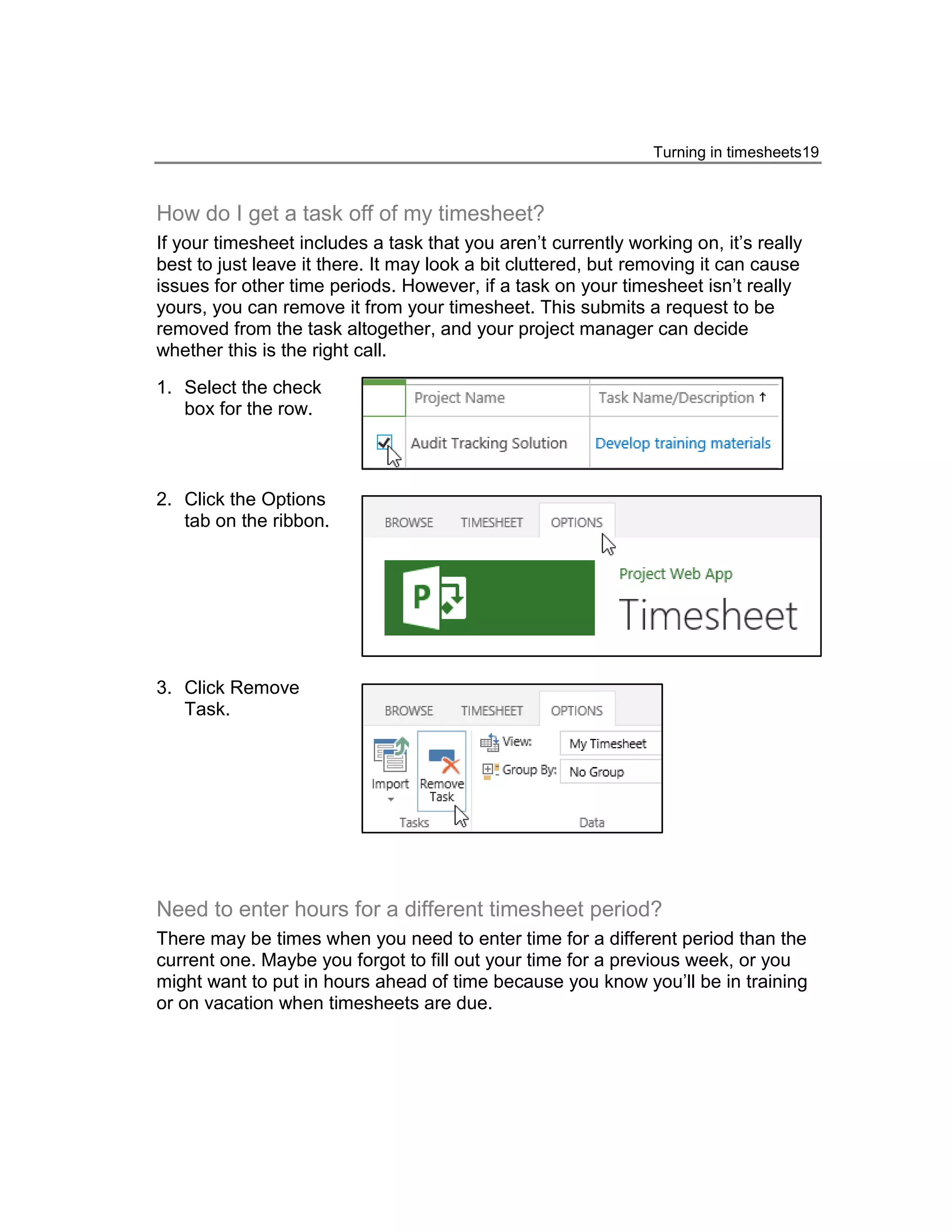

How do I get a task off of my timesheet? ...................................................... 19
Need to enter hours for a different timesheet period? .................................. 19

4. 4Working on tasks in Project Web App

And…SUBMIT! .............................................................. 20

Peek at what’s going on behind the scenes ................... 21
3
24

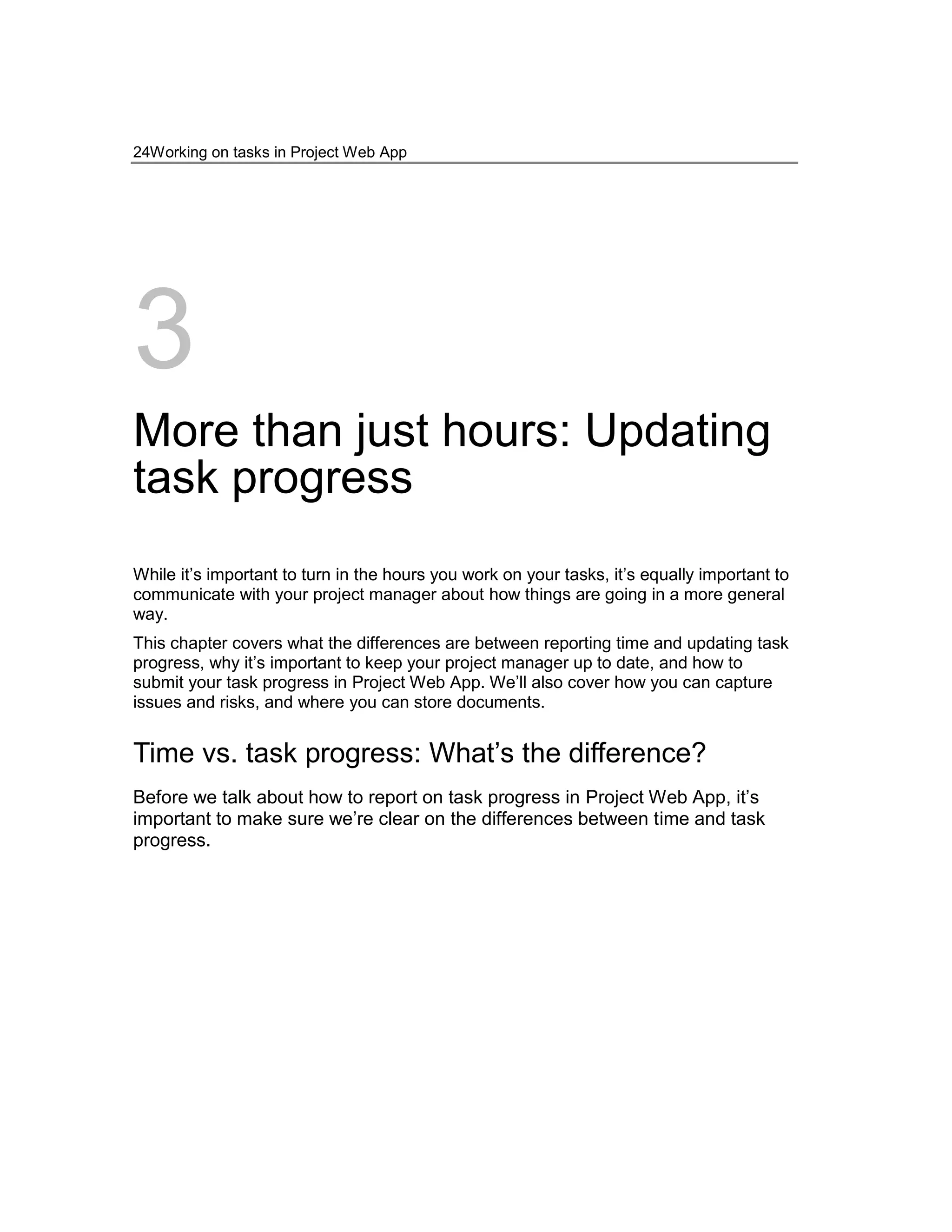

More than just hours: Updating task progress

24

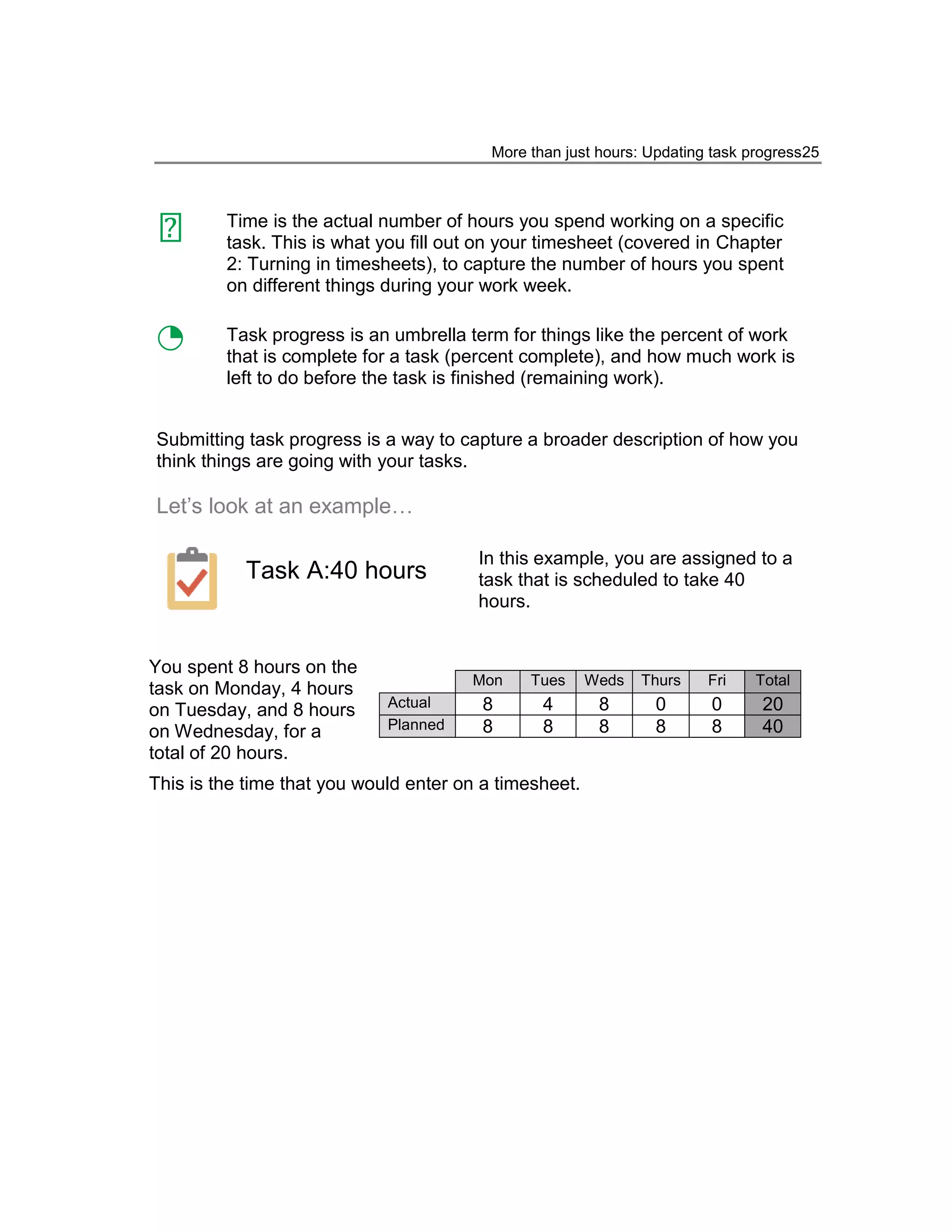

Time vs. task progress: What’s the difference? ............. 24
Let’s look at an example… ............................................................................ 25
Okay, but remind me, why are we doing this? .............................................. 26

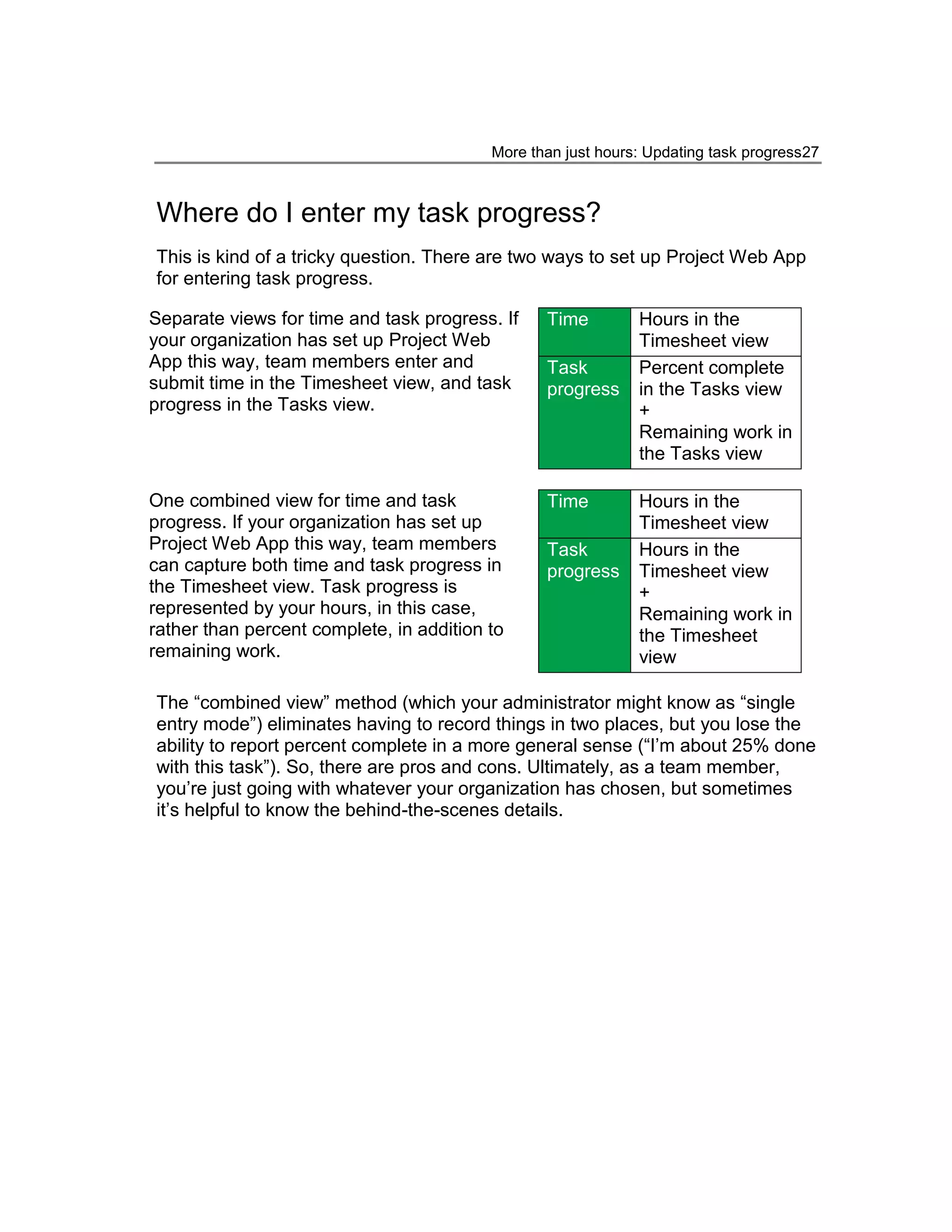

Where do I enter my task progress? .............................. 27

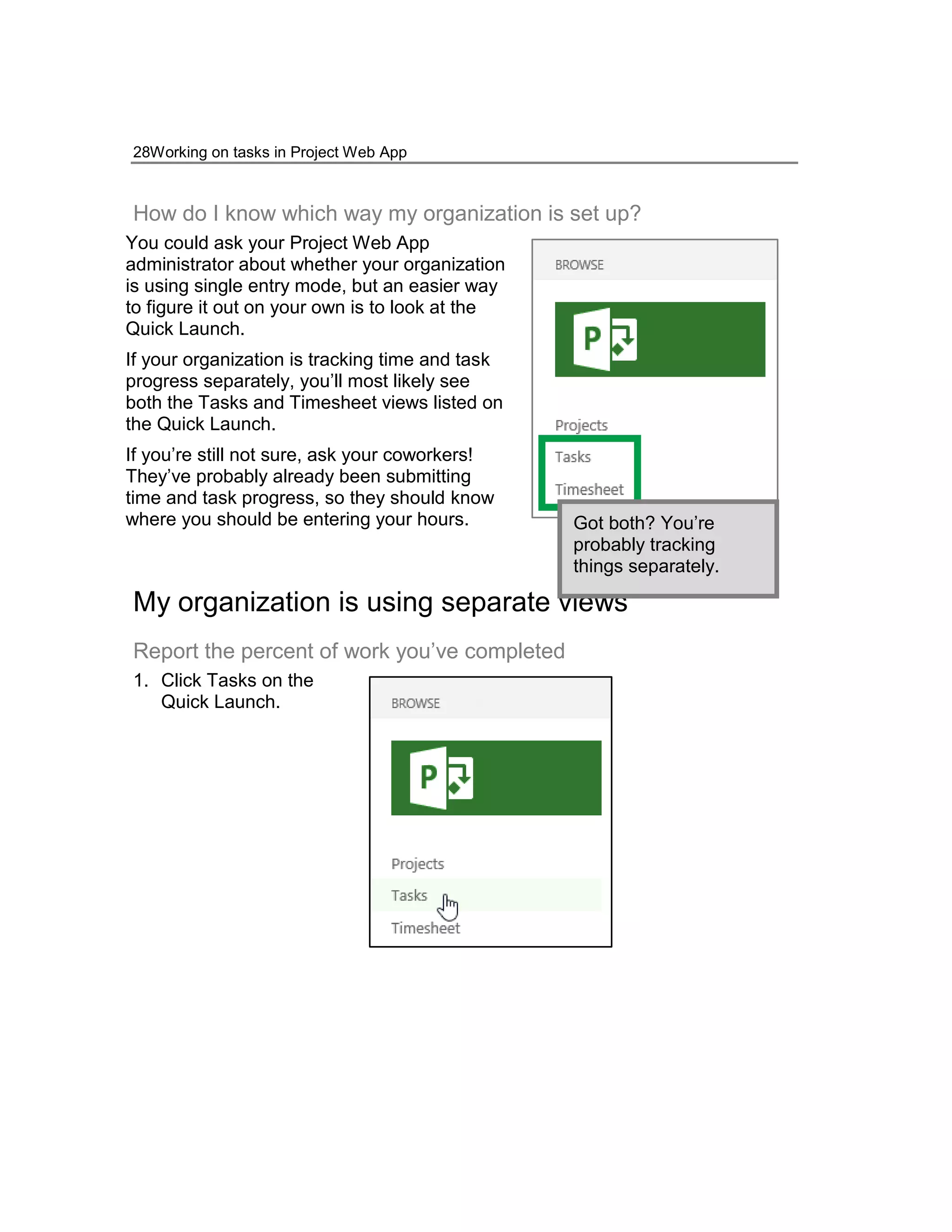

How do I know which way my organization is set up? .................................. 28
My organization is using separate views ....................... 28

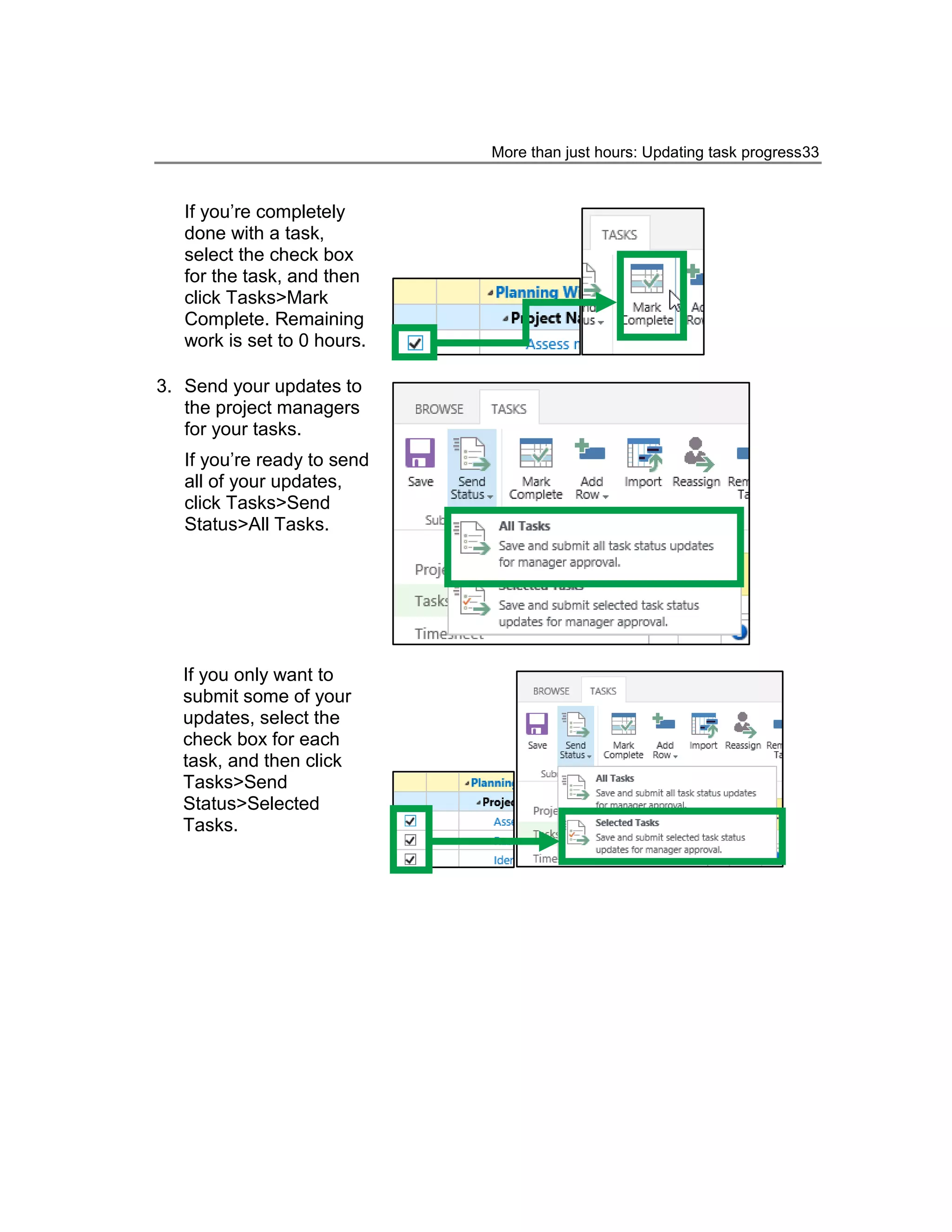

Report the percent of work you’ve completed ............................................... 28

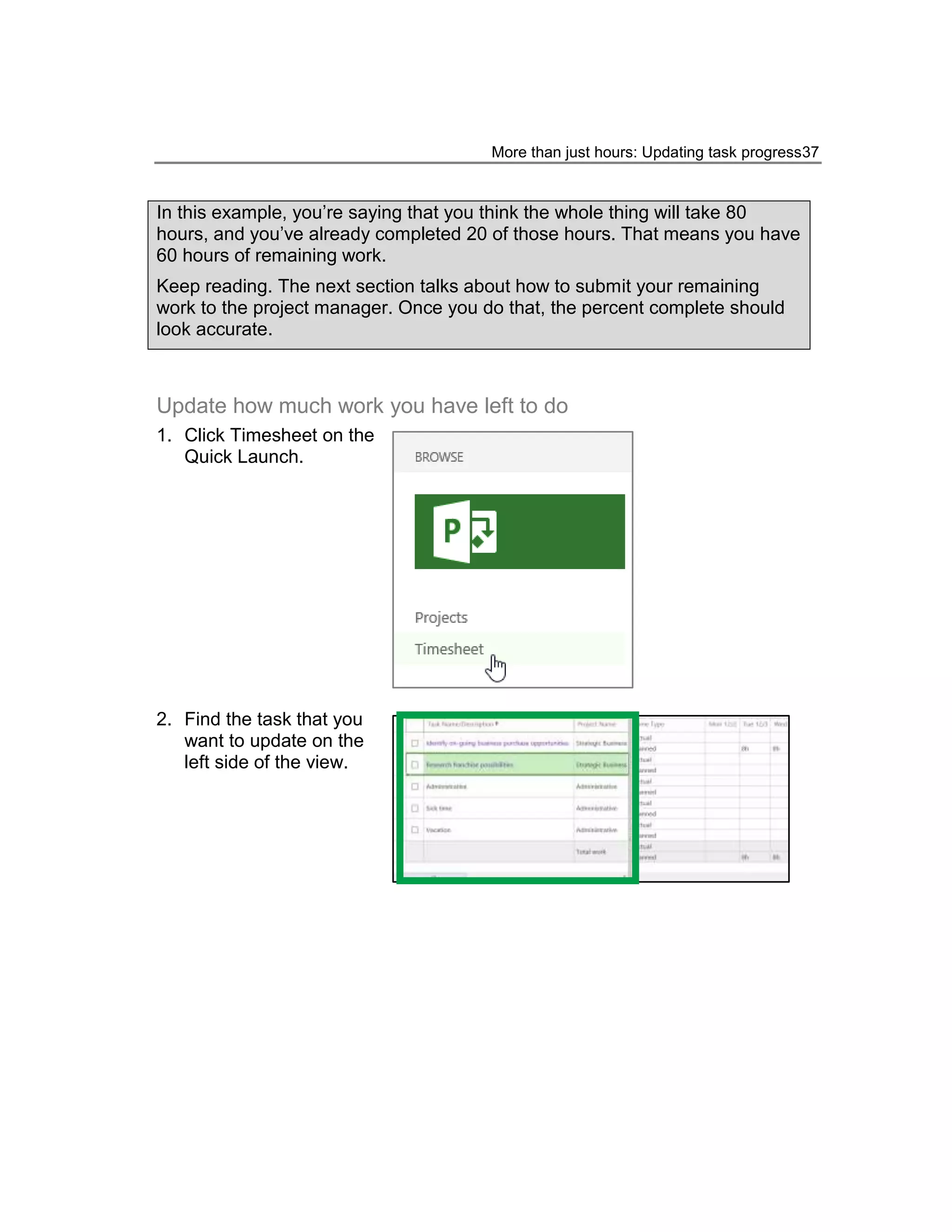

Update how much work you have left to do .................................................. 32

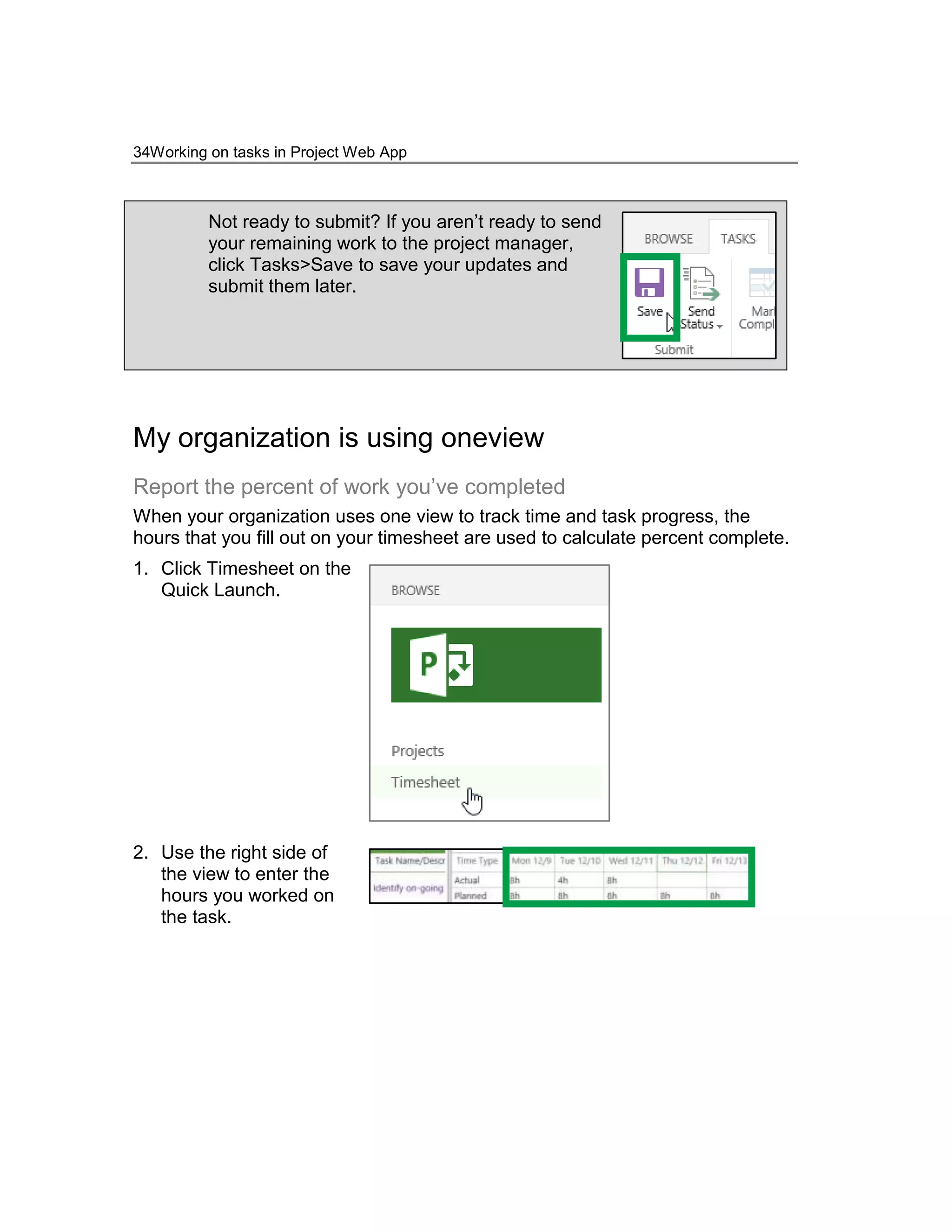

My organization is using one view ................................. 34
Report the percent of work you’ve completed ............................................... 34
Update how much work you have left to do .................................................. 37

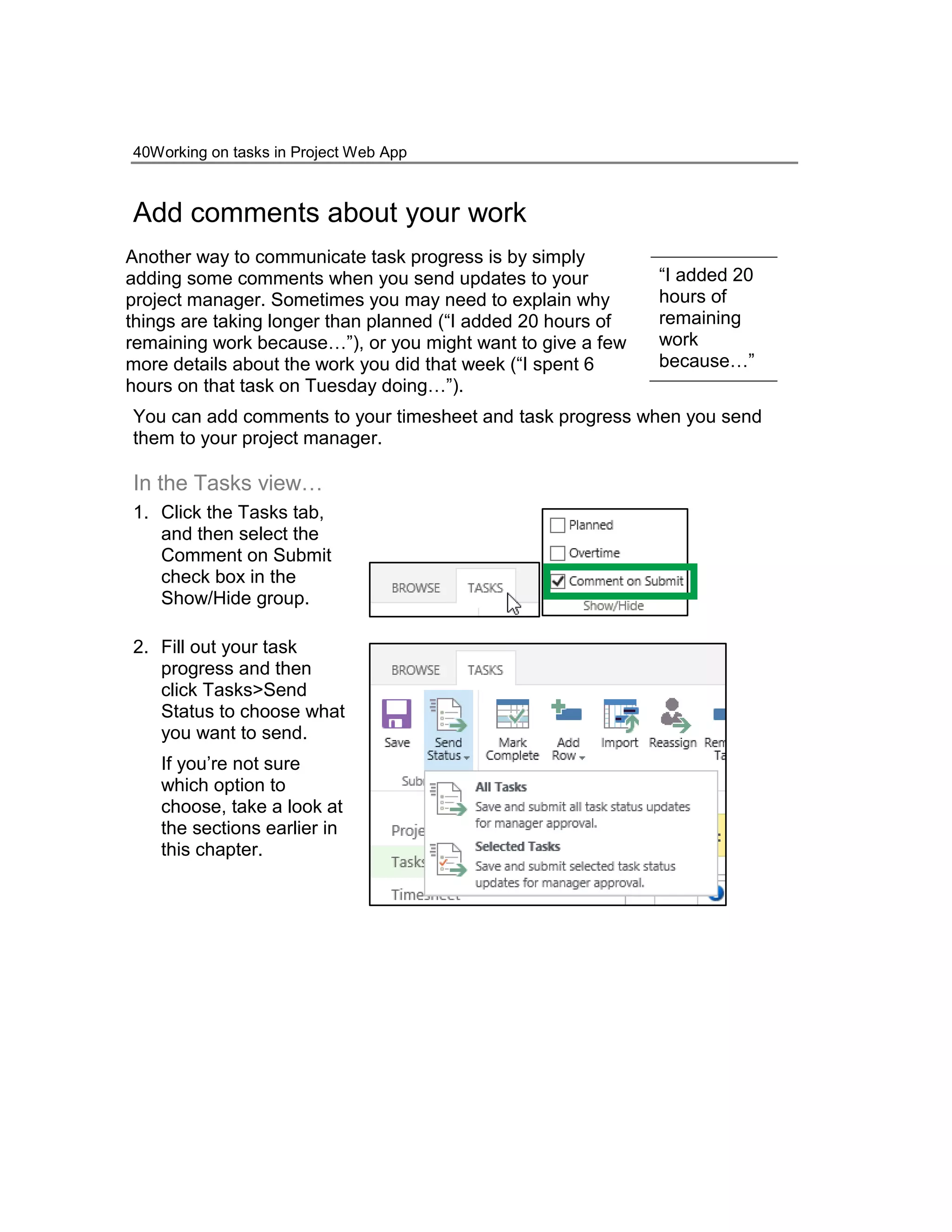

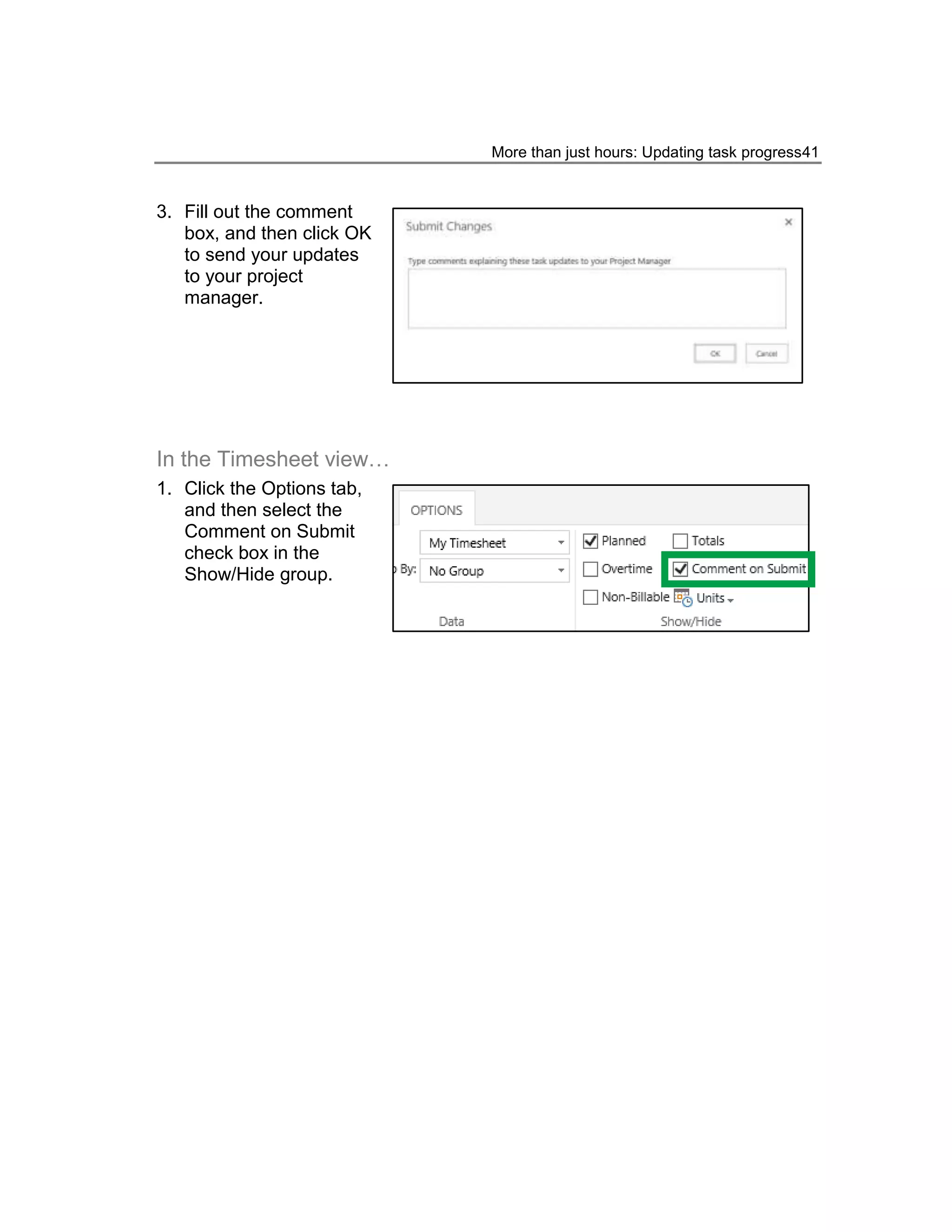

Add comments about your work .................................... 40
In the Tasks view… ....................................................................................... 40
In the Timesheet view… ................................................................................ 41

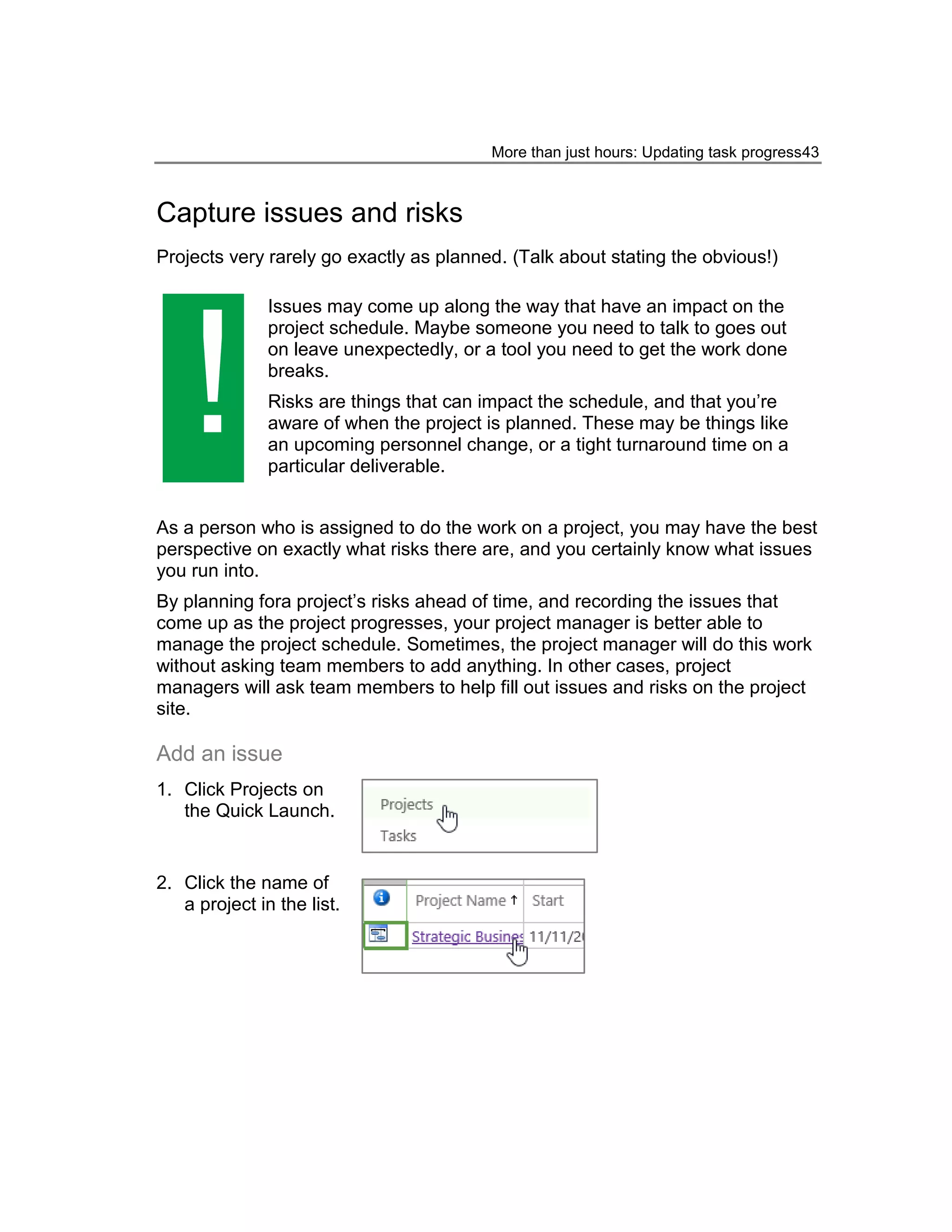

Capture issues and risks ............................................... 43
Add an issue .................................................................................................. 43
Add a risk ....................................................................................................... 45

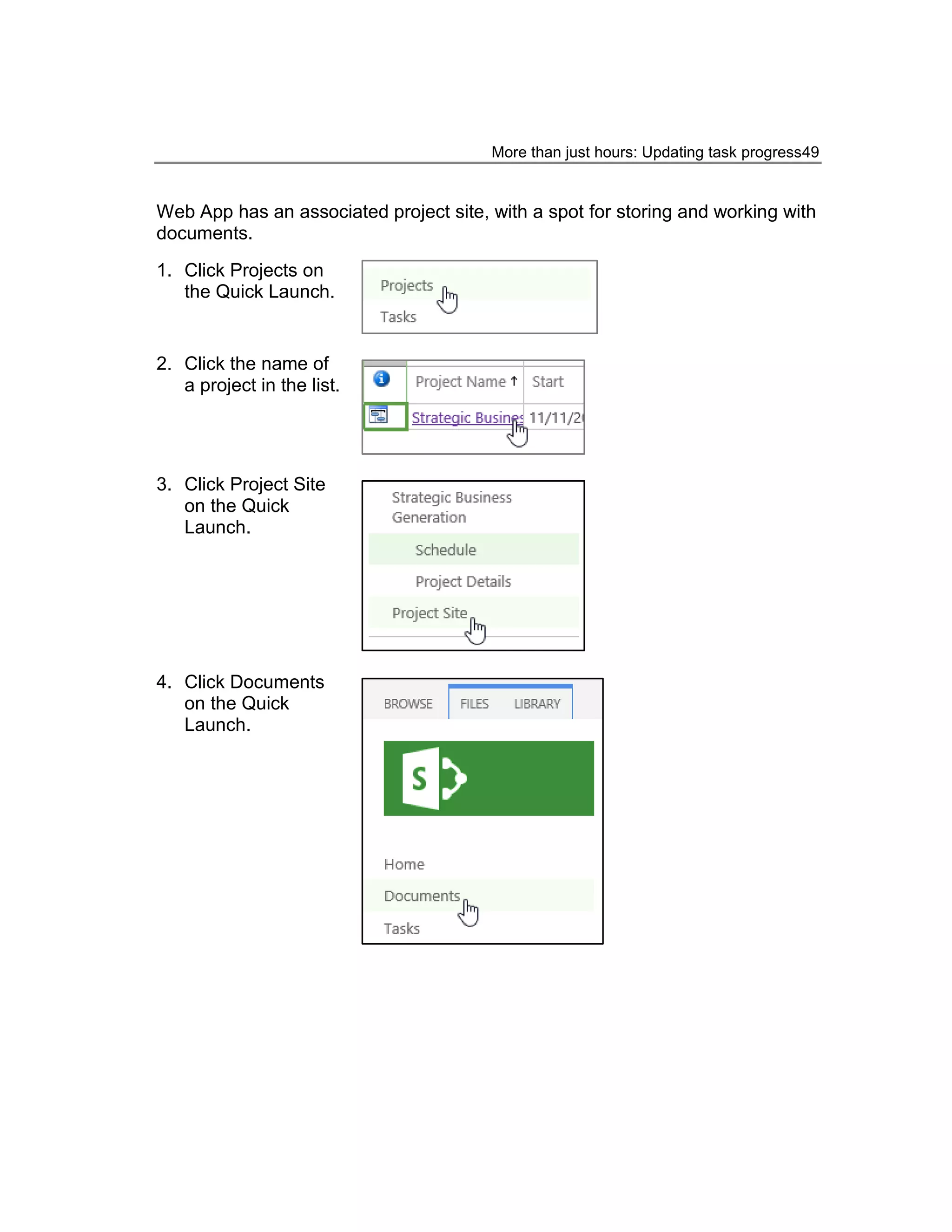

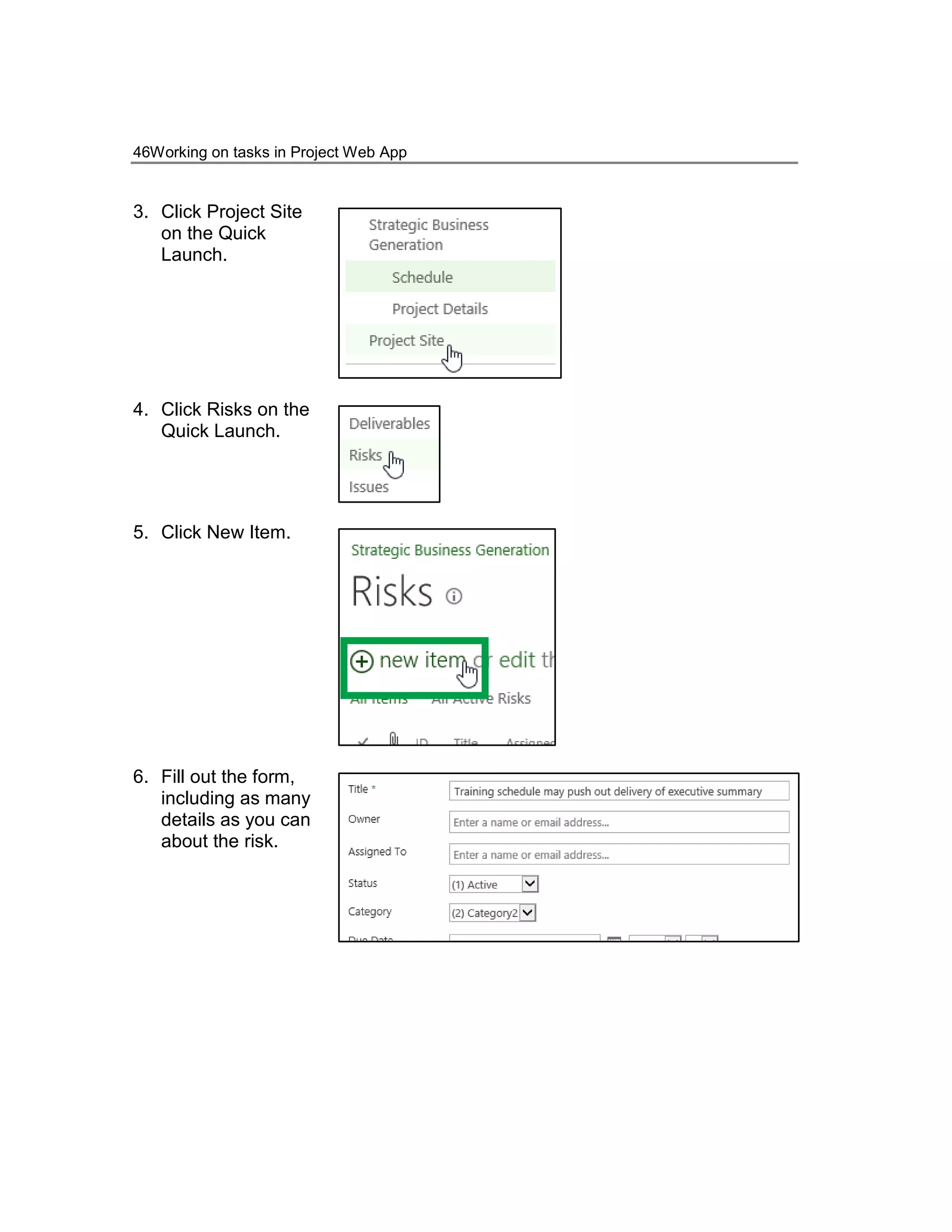

I need to look at a project document…where is it? ........ 48

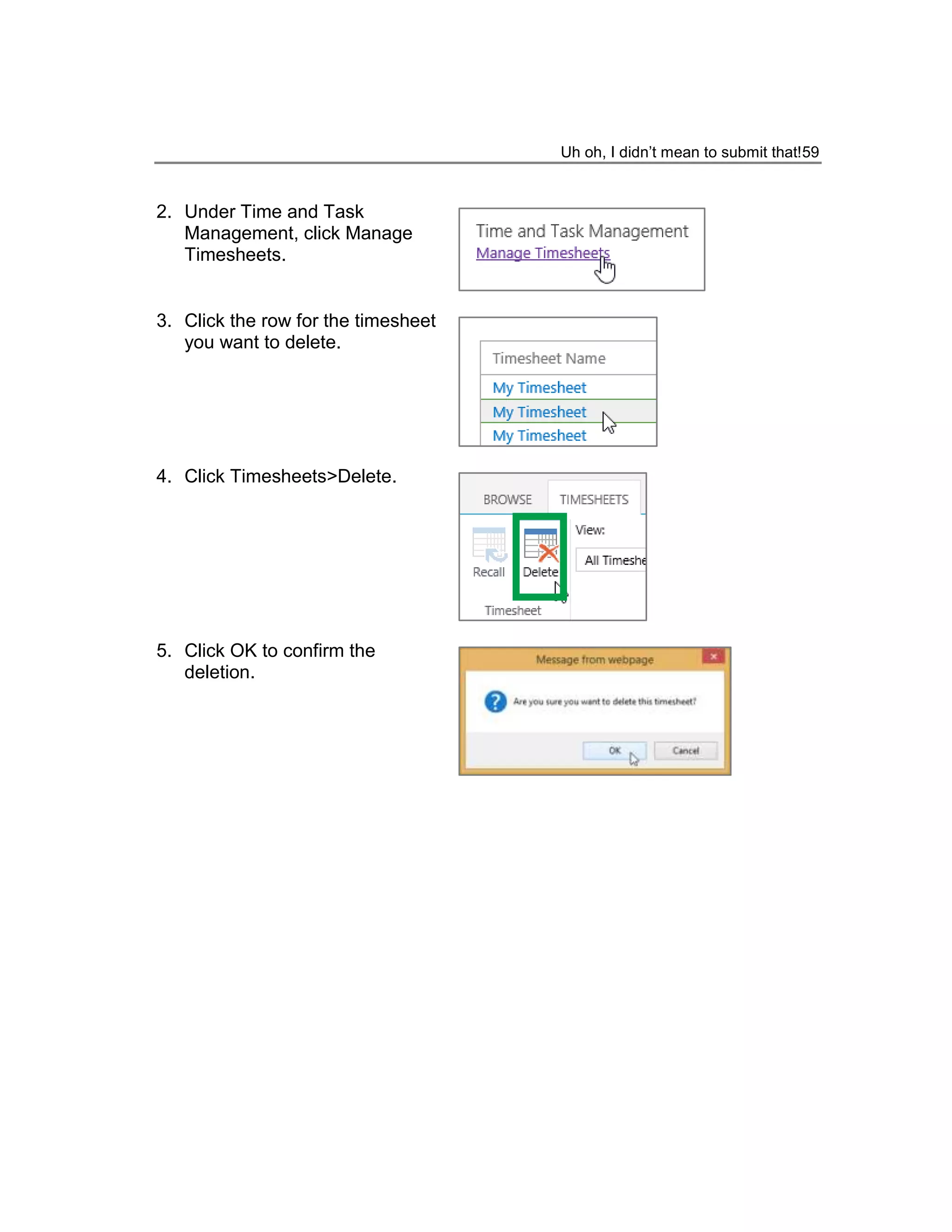

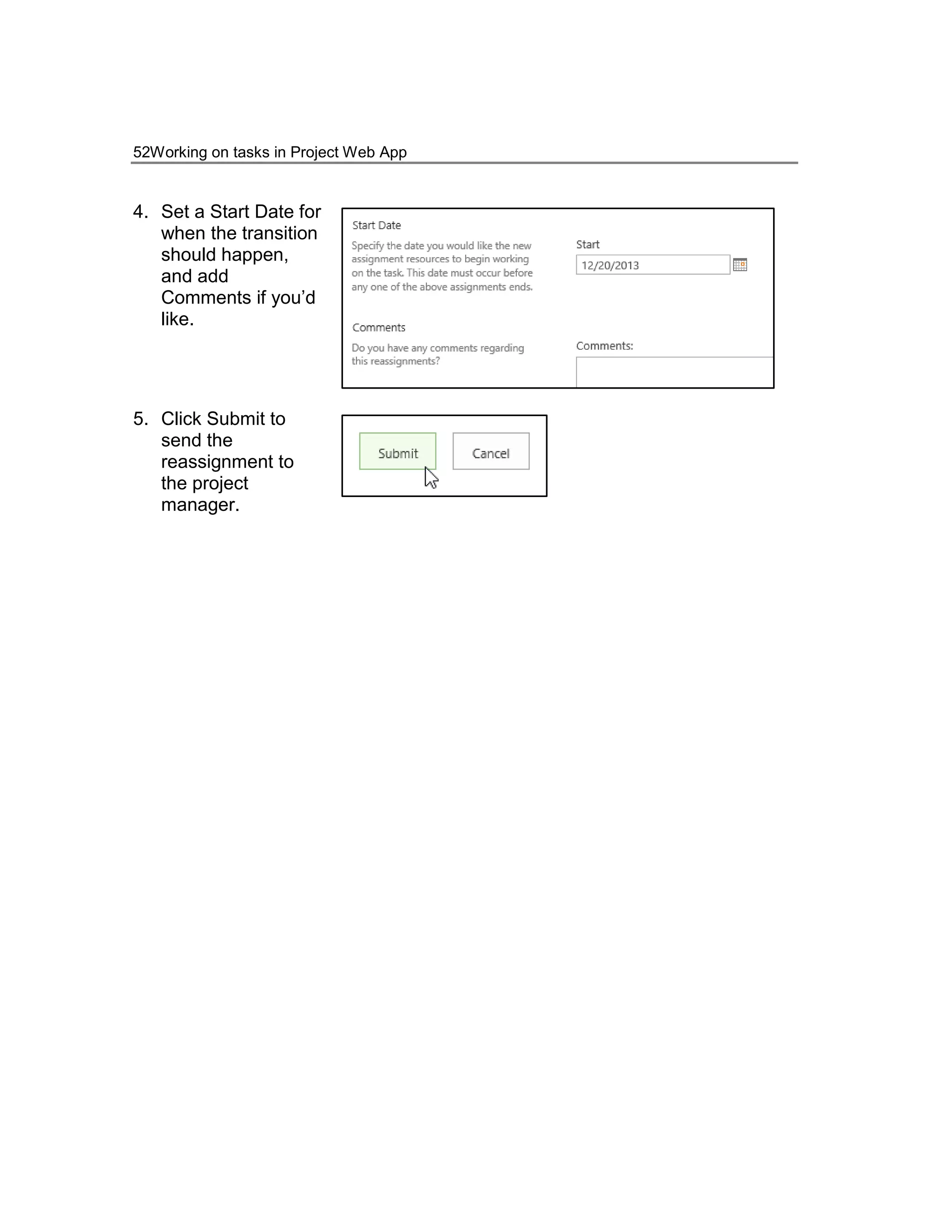

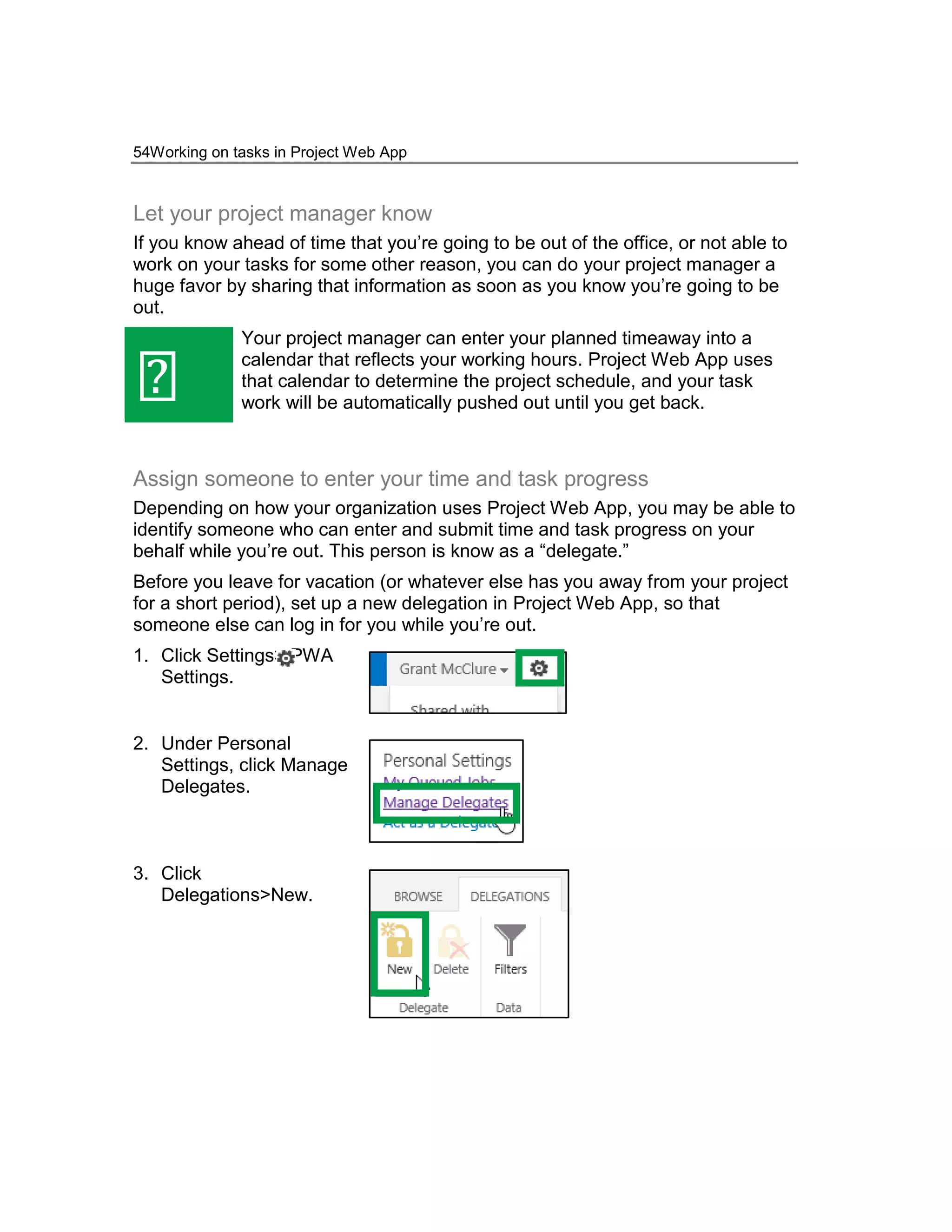

Hand off work to someone else ..................................... 50

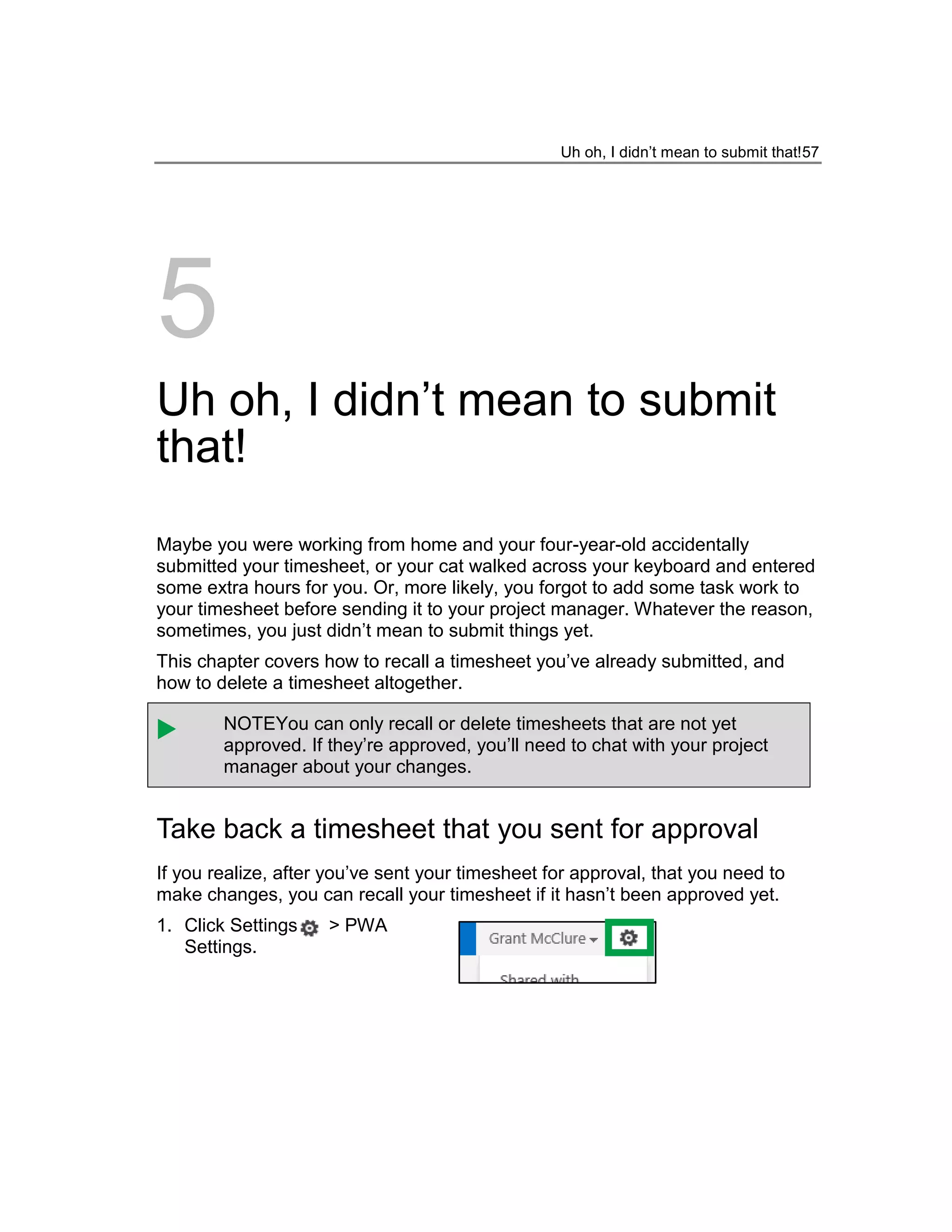

4

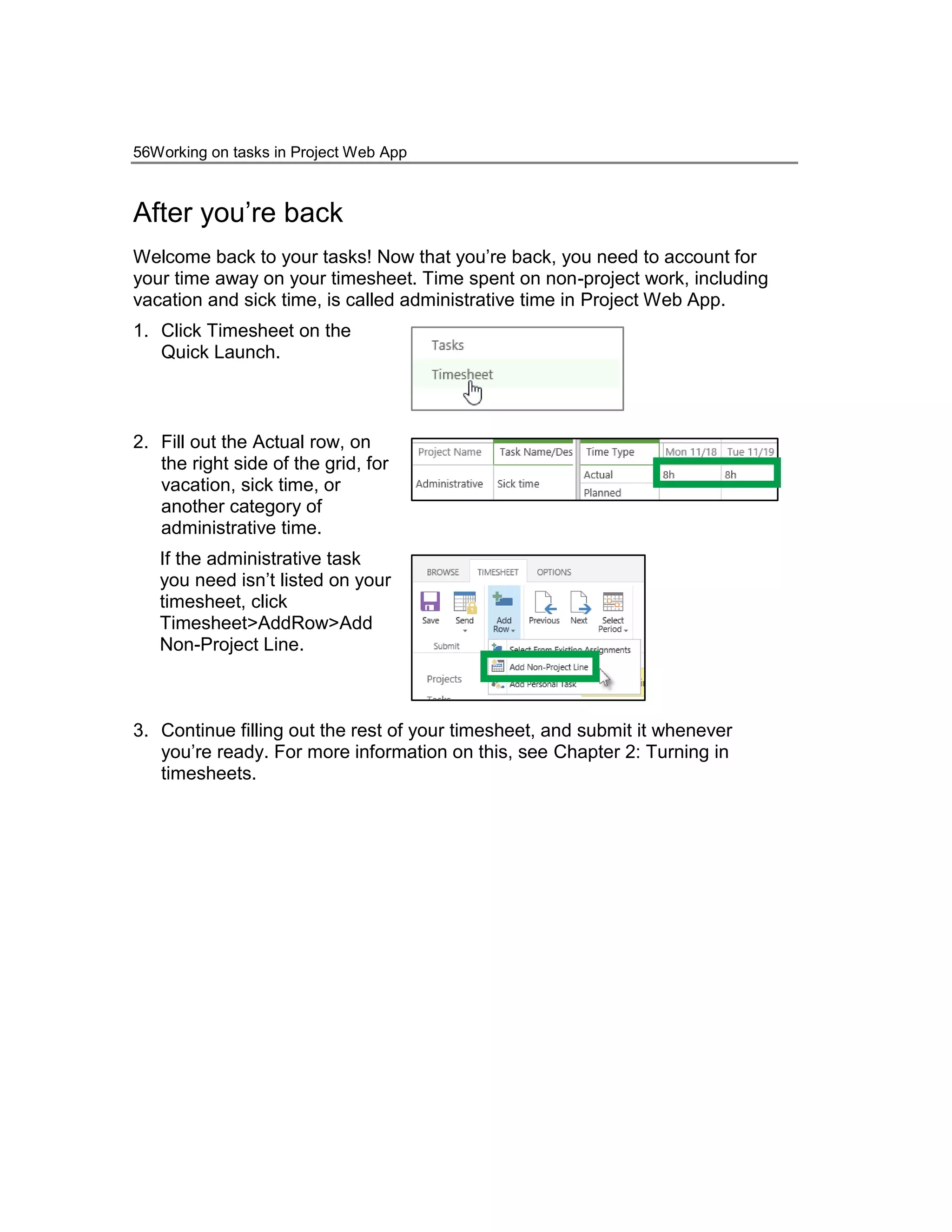

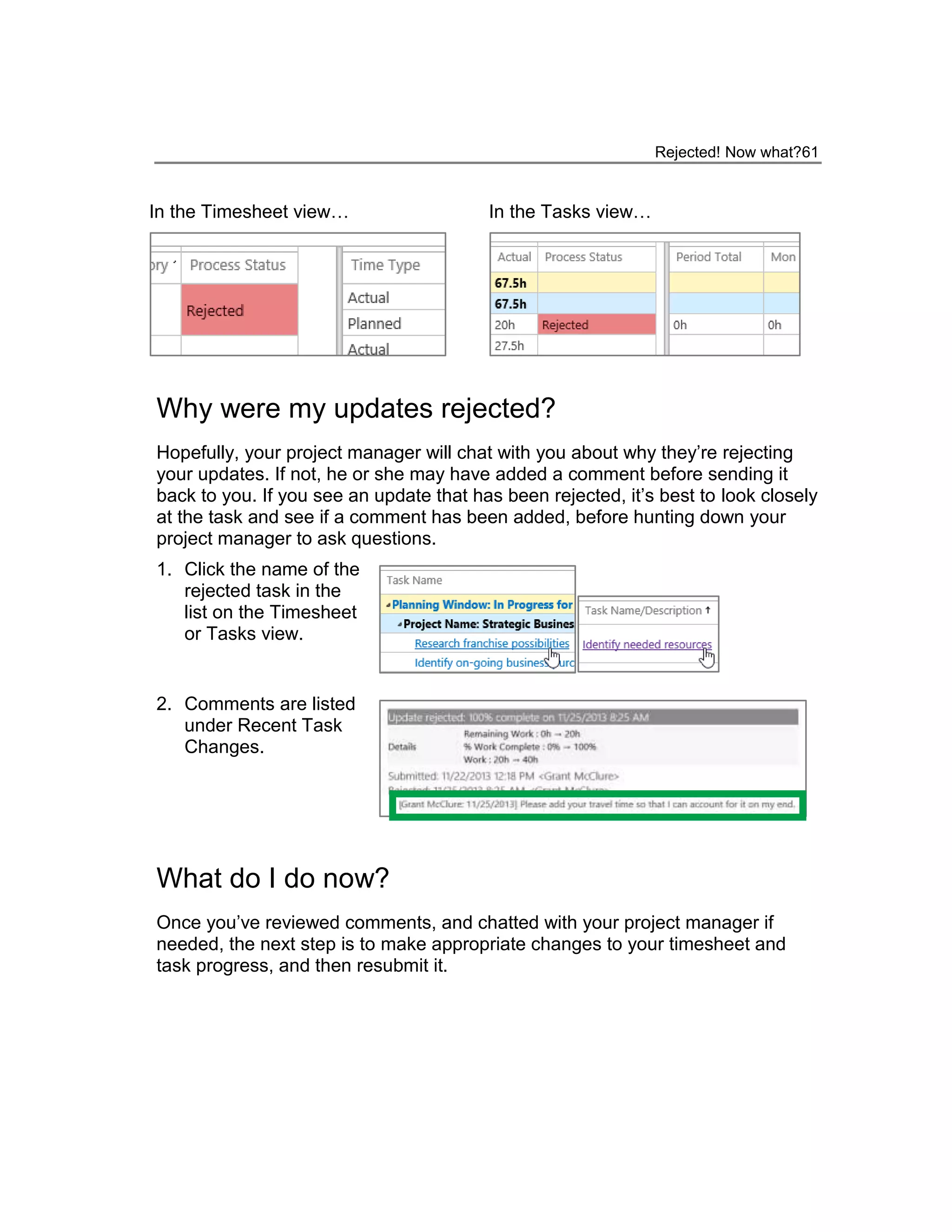

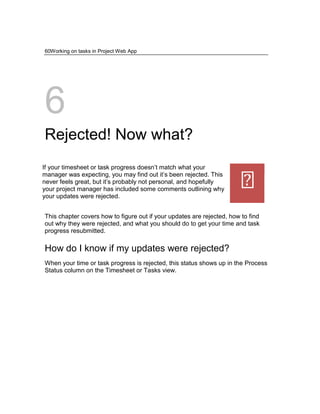

53
Vacation, sick leave, and other non-project hours
53

Ahead of time ................................................................ 53
Let your project manager know ..................................................................... 54
Assign someone to enter your time and task progress ................................. 54
5. Table of Contents5
While you’re out ............................................................. 55
After you’re back............................................................ 56
5
57
Uh oh, I didn’t mean to submit that!
57
Take back a timesheet that you sent for approval .......... 57
Delete a timesheet and start over .................................. 58
6
60
Rejected! Now what?
60
How do I know if my updates were rejected? ................. 60
Why were my updates rejected?.................................... 61
What do I do now?......................................................... 61
Okay, but how? ............................................................................................. 62
When in doubt, add comments… .................................................................. 62
Appendix
63

In Project Web App, how do I… ..................................... 64
6.
7. Introduction7
Introduction
If you have been assigned a task in a project, this guide can help you learn how
to stay plugged into the project and keep your project manager up to date on
how your task is progressing, usingProject Web App.
Send us your feedback (projdocs@microsoft.com). Please let us know what
you think about the quality of this content. If this guide does not meet your
needs, let us know how we can improve it. If this guide was helpful to you, let
us know how it helped. We love feedback!
Hold on, what’sProject Web App?
Project Web Appis a project management application that you access in a web
browser. It is connected to a database, behind the scenes, that stores
information about the projects going on in your organization, including:
The tasks that are part of each project.
All of the people who are available to work on those tasks.
The materials needed to complete tasks for each project.
The costs associated with the people, materials, projects, and
tasks in your organization.
8. 8Working on tasks in Project Web App
Is this guide for Project Online or Project Server?
Project Web Appis a part of Project Server 2013 (on premises), or Project
Online (in the cloud). From a team member perspective, it really doesn’t matter
whether you’re using Project Web App as part of Project Server 2013 or Project
Online. The functionality is mostly identical, and the steps in this guide apply
regardless of which option your organization has chosen.
For more information about Project Online and Project Server 2013, go to:
http://office.com/project
I need help!
If this guide doesn’t answer your questions, you can try a few different things:
Ask your peers! The people you work with are often the best source of
information about working in Project Web App. They’re familiar with how
your organization has customized things, and what processes are in
place. If you need help, don’t be shy! Your coworkers may be just as
confused as you are, and working together may make things easier.
Search on Office.com. Articles on Office.com are designed to help you
learn how to use Project Web App, but may not cover specific details
about how your organization has set things up. Try searching for “Find
information about Project Server 2013” or “Find information about Project
Online.”
Ask on the Project forums! The Project discussion forums on TechNet
tend to be very active, with subject matter experts and Microsoft MVPs
responding to posts, as well as some folks from Microsoft Support and
Engineering. This makes them a great resource for finding others who
may have worked through similar issues, or who have encountered the
same situation. Take a look at:
http://social.technet.microsoft.com/Forums/projectserver
9. Introduction9
And if none of that works, ask your
administrator! When you simply can’t
find the answer you’re looking for, try
asking your Project Web App
administrator.
My Project Web App administrator is:
[name]
[contact info line 1]
[contact info line 2]
10. Get your bearings10
1
Get your bearings
Ready to dive in and start usingProject Web App? This chapter will help you
figure out what you’re looking at when you log in, so you know which pieces do
what.
The Project Web App window is made up of three main areas: the Quick
Launch, the ribbon, and the main display area.
Ribbon
Quick Launch
Main display area
11. Get your bearings11
Quick Launch
The Quick Launch lists the main views and pages that you are able to access.
You can click these links to navigate to different areas ofProject Web App.
Some pages in Project Web App do not include the Quick Launch. For example,
when you fill out a form, you must complete and save the form, or cancel out of
it, in order to see the Quick Launch.
Ribbon
The ribbon is the toolbar that you use to perform actions on what's currently in
the main display area.
There may be multiple tabs
on the ribbon, to change
between different sets of
actions.
Each tab contains groups of
related buttons that you can
use to interact with the page
content.
12. 12Working on tasks in Project Web App
Main display area
The main display area contains information about your projects and tasks. This
is the main focus of each page, and is where you will enter and review data.
This shows a timesheet in the
main display area. Other
pages will also display here.
That’s it!You’ve got the basics of how to get around withinProject Web App.
Just want to see a list of projects?
Most of the time, you’ll probably be entering time and task progress for tasks
that you’re assigned to. Occasionally, though, you might want to look at a list of
all the projects you’re working on. The Project Center shows a list of of your
projects.
1. Click Projects on
the Quick Launch.
13. Get your bearings13

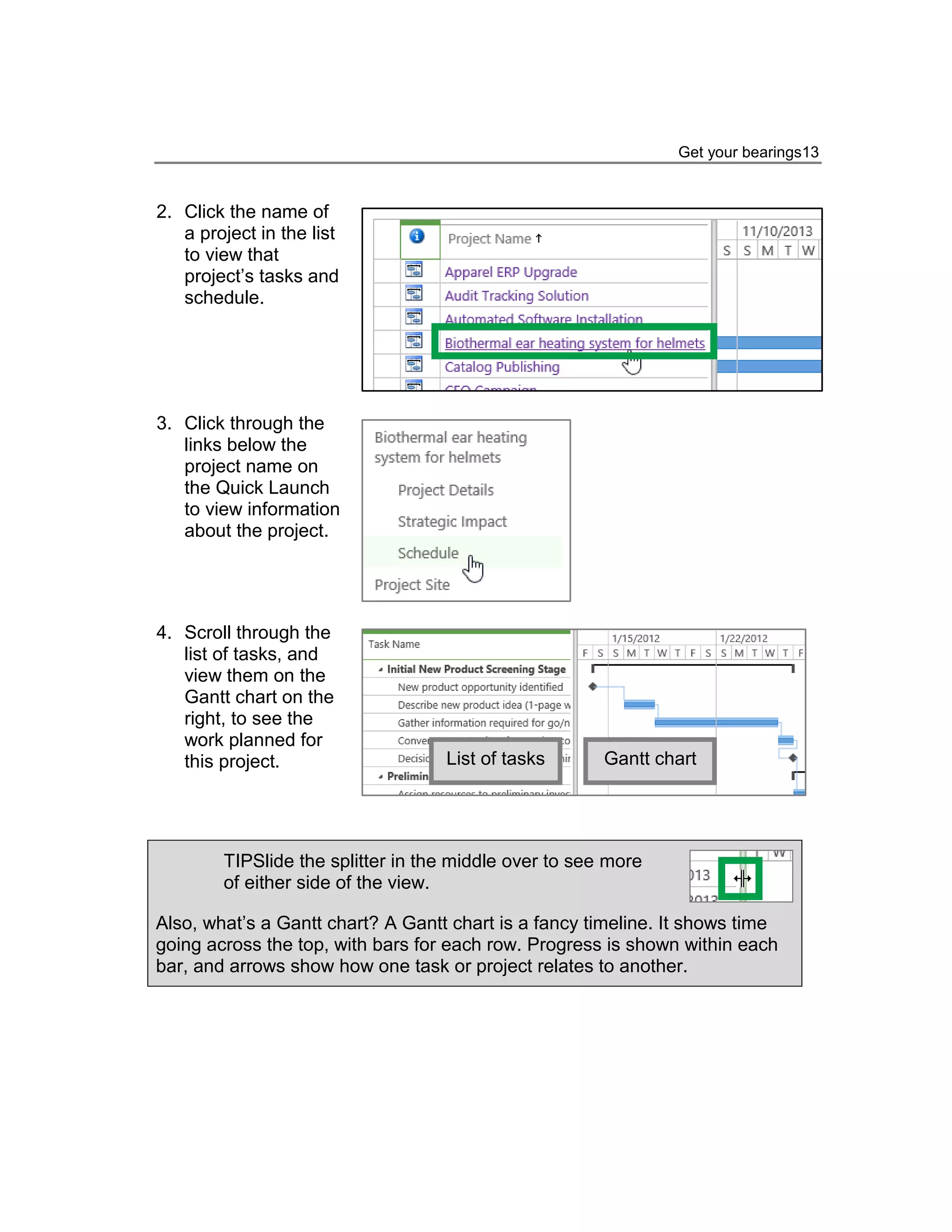

2. Click the name of
a project in the list
to view that
project’s tasks and
schedule.
3. Click through the
links below the
project name on
the Quick Launch
to view information
about the project.
4. Scroll through the
list of tasks, and
view them on the
Gantt chart on the
right, to see the
work planned for
this project.
�
List of tasks
Gantt chart
TIPSlide the splitter in the middle over to see more
of either side of the view.
Also, what’s a Gantt chart? A Gantt chart is a fancy timeline. It shows time
going across the top, with bars for each row. Progress is shown within each
bar, and arrows show how one task or project relates to another.
14. 14Working on tasks in Project Web App
2
Turning in timesheets
Timesheets are the core of what you, as a team member, will do inProject Web
App. This chapter covers why timesheets are important, how timesheets work
overall inProject Web App, and how you can get yours filled out and turned in.
Why are timesheets important?
Nobody loves filling out timesheets. If you’re working on a lot of different tasks
at the same time, it can be hard to figure out how much of your day was spent
on each task. It’s also sometimes tough to commit to having worked a set
number of hours. Maybe you feel like you should be working more hours, or
maybe you feel like you’re working too much. In either case, you might not feel
inclined to draw attention to your work hours.
When it comes to managing projects, the focus
really isn’t on your work ethic, although of course
that’s still important. The focus is about making sure
the right things get done on time and within budget.
It’s about making sure there are enough people to
get the work done without burning anyone out, or
costing the organization more money than planned.
The focus is about
making sure the right
things get done on time
and within budget.
Project managers use timesheet data to help them figure out how many people
need to be assigned to similar tasks in future projects. Your HR department
might use this data to make sure they have appropriate headcount allocated to
certain roles. And yes, timesheets can translate to dollars in your pocket if
15. Turning in timesheets15
you’re paid hourly. But it’s important to remember that’s not all your timesheet
data is…there are bigger-picture benefits for your organization, that result in
better planning and efficiency going forward.
And you’ll see the benefit of that better planning and efficiency too, because you
won’t end up having to put in a ton of overtime trying to get your work done on
time. Your project manager will have a realistic expectation of how long things
take to get done, or how many people are actually needed on a given task, and
you might end up getting your weekend back.
Okay, I’m convinced. Now how does it work?
Behind the scenes, an administrator sets up
the timesheet periods for your organization
(for example, each week might be a separate
timesheet).
Task B
Task C
Task B
Task C
8
8
4
4
4
4
23
When your project manager
assigns you to a task, that task
shows up on your timesheet
during the period when it is
scheduled in the project plan.
Task A
Task A
1
8
You fill out the actual hours you
spend on each task during the
timesheet period, and then you
submit it.
Every person in Project Web App is assigned a timesheet manager (sometimes
more than one). Your timesheet manager might be the project manager, or it
might be someone else, like a resource manager that is responsible for people
across your entire organization.
16. 16Working on tasks in Project Web App
Your timesheet manager receives the
timesheet that you turned in, and reviews it.
If everything looks good, your timesheet is
approved. If things look different than
expected, your timesheet manager might
reject it and add some comments about why
it’s being rejected.
Task A
8
8
4
4
Task B
Task A
Task B
Task C
4
4
Task C
8
8
8
4
4
4
4
8
If your timesheet is approved, the time you submitted counts toward the total
amount of work done on the task, and the amount of work remaining on the task
is reduced. This is recorded in the overall project plan, so that the project
manager can accurately account for whether the project is progressing as
planned.
Let’s fill out your timesheet!
First, we need to get to the Timesheet view.
On the Quick Launch, click Timesheet.
The Timesheet view is made up of a table with two sides, and a splitter in the
middle.
The left side lists your
tasks, as well as things
like sick time and vacation.
The right side is where you enter
the actual hours that you spent
per day on each task.
17. Turning in timesheets17
�
TIPSlide the splitter in the middle over to see
more of either side of the view.
Ready to enter your hours?

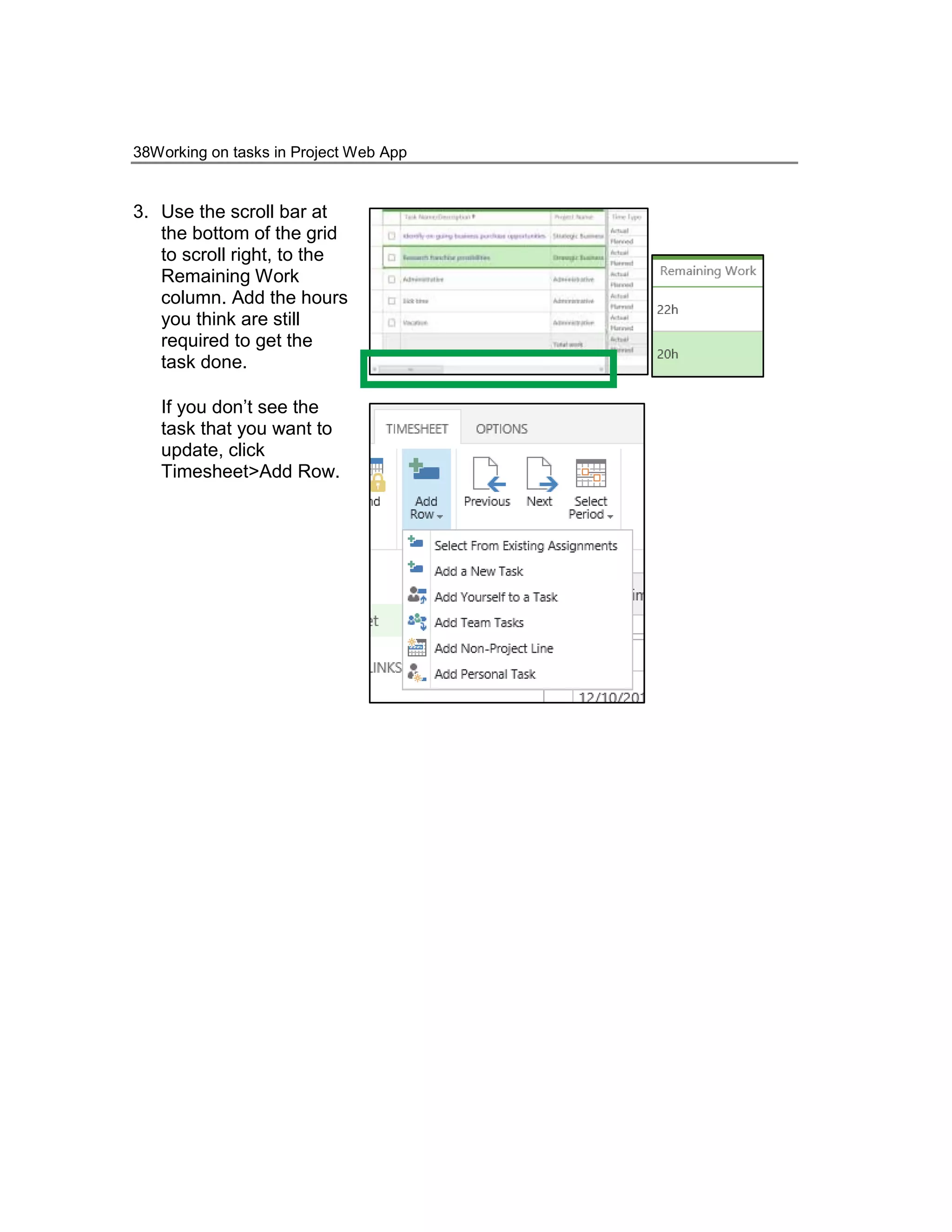

Find the task that you worked on in the list on the left side, and then follow the
row across to the right side of the view.
Do this▶
Fill in your hours across the top row of the grid, next to
Actual.
The bottom row of the grid shows the Planned hours, from
the when the task was initially scheduled in the project.
Don’t see the task you worked on?
Tasks assigned to you that are scheduled for the dates in the current timesheet
period will be automatically included on your timesheet. Sometimes, however,
you might start work on a task early, for example, and need to add a task to
your timesheet that isn’t automatically included. You can add a task to your
timesheet, and your time will be accounted for in the project.
1. Click the Timesheet
tab on the ribbon.
18. 18Working on tasks in Project Web App
2. Click Add Row, and then
choose the kind of task you
want to add.
What about hours that aren’t part of a project?
Your timesheet may also include non-project lines, to represent things like
training, travel, or even sick time and vacation. These are referred to as
administrative tasks, and you fill out hours in those rows the same as any other
task. The difference with administrative tasks is that the hours don’t roll up to
any particular project.
When the Project Name column lists
Administrative, hours in that row
won’t roll up to a project.
▶
NOTE There’s more to read about sick leave and vacation time in
Chapter 4:Vacation, sick leave, andother non-project hours.
19. Turning in timesheets19
How do I get a task off of my timesheet?
If your timesheet includes a task that you aren’t currently working on, it’s really
best to just leave it there. It may look a bit cluttered, but removing it can cause
issues for other time periods. However, if a task on your timesheet isn’t really
yours, you can remove it from your timesheet. This submits a request to be
removed from the task altogether, and your project manager can decide
whether this is the right call.
1. Select the check
box for the row.
2. Click the Options
tab on the ribbon.
3. Click Remove
Task.
Need to enter hours for a different timesheet period?
There may be times when you need to enter time for a different period than the
current one. Maybe you forgot to fill out your time for a previous week, or you
might want to put in hours ahead of time because you know you’ll be in training
or on vacation when timesheets are due.
20. 20Working on tasks in Project Web App
1. Click the
Timesheet tab on
the ribbon.
2. Click Select Period,
and then choose
which period you
want to show.
If you don’t see the
period you want
listed, click Select
Period to set
specific
dates.Older
periods may be
closed for editing.
And…SUBMIT!
After you’ve entered your hours on a timesheet, the next step is to submit it to your
manager for approval.
1. Click the Timesheet
tab on the ribbon.
21. Turning in timesheets21
2. Click Send>Turn in
Final Timesheet.
�
TIPWhen you choose Turn in Final Timesheet, your timesheet is
locked for editing. If you’re not ready to commit to that, click Send
Progress for All Tasks or Send Progress for Selected Tasks.
Peek at what’s going on behind the scenes
After submitting your timesheet, it should theoretically go to your manager for
approval. Sometimes, however, things go a little sideways and something might
get stuck in the system. It’s a complicated system…these things happen.
You can check on the things you’ve submitted using the My Queued Jobs page.
22. 22Working on tasks in Project Web App
1. Click Settings>PWA Settings.
2. Click My Queued Jobs.
23. Turning in timesheets23
3. Use the Jobs>View list to
narrow down what’s displayed
in the grid.
In the grid, you can see all of your actions inProject Web App, including the
state of each action, and whether it is complete.
If something doesn’t seem to be acting the way you expect, take a look in your
queued jobs to see if something is stuck. If you see anything that looks
problematic, it might be worth chatting with your project manager or
administrator.
24. 24Working on tasks in Project Web App
3
More than just hours: Updating
task progress
While it’s important to turn in the hours you work on your tasks, it’s equally important to
communicate with your project manager about how things are going in a more general
way.
This chapter covers what the differences are between reporting time and updating task
progress, why it’s important to keep your project manager up to date, and how to
submit your task progress in Project Web App. We’ll also cover how you can capture
issues and risks, and where you can store documents.
Time vs. task progress: What’s the difference?
Before we talk about how to report on task progress in Project Web App, it’s
important to make sure we’re clear on the differences between time and task
progress.
25. More than just hours: Updating task progress25
◔
Time is the actual number of hours you spend working on a specific
task. This is what you fill out on your timesheet (covered in Chapter
2: Turning in timesheets), to capture the number of hours you spent
on different things during your work week.
Task progress is an umbrella term for things like the percent of work
that is complete for a task (percent complete), and how much work is
left to do before the task is finished (remaining work).
Submitting task progress is a way to capture a broader description of how you
think things are going with your tasks.
Let’s look at an example…
Task A:40 hours
You spent 8 hours on the
task on Monday, 4 hours
on Tuesday, and 8 hours
on Wednesday, for a
total of 20 hours.
In this example, you are assigned to a
task that is scheduled to take 40
hours.
Mon
Actual
Planned
Tues
Weds
Thurs
Fri
Total
8
8
4
8
8
8
0
8
0
8
20
40
This is the time that you would enter on a timesheet.
26. 26Working on tasks in Project Web App
Now, let’s look at the work you did from a task progress perspective.
Even though 20 of 40
hours have been spent
on the task, you may not
feel that you are 50%
complete.
You may think you are
farther along, say 75%
complete, or a bit behind,
maybe 25% complete.
20 of 40 hours looks like
▶
this
But really,you may be
ahead of schedule, like
this ▶
Or behind schedule, like
▶
this
◑
◕
◔
When you communicate your estimated percent complete, this is your task
progress. Communicating your estimated number of hours left on the task
(remaining work) is also considered your task progress.
Continuing with our example, after completing 20 of the 40 scheduled hours,
you may feel like you have more than 20 hours of work left to do before the task
is finished. By submittingyour estimated remaining work to your project
manager, you are communicating task progress.
Okay, but remind me, why are we doing this?
Remember, just like with timesheets, reporting on task progress, frankly, isn’t
about you. It’s about the project itself, and making sure things get done on time
and within budget.
If the task you’re working on is taking longer than expected, for whatever
reason, your project manager may be able to rearrange things down the
road so that the overall project isn’t derailed.
Even when you do your job to the best of your abilities, things don’t always work
as planned. Every good project manager knows this, so don’t stress it if your
task progress doesn’t line up with the schedule. Just be honest, share how
things are going, and you’ll be doing your part to keep the project on track.
27. More than just hours: Updating task progress27
Where do I enter my task progress?
This is kind of a tricky question. There are two ways to set up Project Web App
for entering task progress.
Separate views for time and task progress. If
your organization has set up Project Web
App this way, team members enter and
submit time in the Timesheet view, and task
progress in the Tasks view.
Time
One combined view for time and task
progress. If your organization has set up
Project Web App this way, team members
can capture both time and task progress in
the Timesheet view. Task progress is
represented by your hours, in this case,
rather than percent complete, in addition to
remaining work.
Time
Task
progress
Task
progress
Hours in the
Timesheet view
Percent complete
in the Tasks view
+
Remaining work in
the Tasks view
Hours in the
Timesheet view
Hours in the
Timesheet view
+
Remaining work in
the Timesheet
view
The “combined view” method (which your administrator might know as “single
entry mode”) eliminates having to record things in two places, but you lose the
ability to report percent complete in a more general sense (“I’m about 25% done
with this task”). So, there are pros and cons. Ultimately, as a team member,
you’re just going with whatever your organization has chosen, but sometimes
it’s helpful to know the behind-the-scenes details.
28. 28Working on tasks in Project Web App
How do I know which way my organization is set up?
You could ask your Project Web App
administrator about whether your organization
is using single entry mode, but an easier way
to figure it out on your own is to look at the
Quick Launch.
If your organization is tracking time and task
progress separately, you’ll most likely see
both the Tasks and Timesheet views listed on
the Quick Launch.
If you’re still not sure, ask your coworkers!
They’ve probably already been submitting
time and task progress, so they should know
where you should be entering your hours.
Got both? You’re
probably tracking
things separately.
My organization is using separate views
Report the percent of work you’ve completed
1. Click Tasks on the
Quick Launch.
29. More than just hours: Updating task progress29
2. Fill out your hours on
the right side of the
grid.
The % Work Complete
column, on the left
side of the grid, will be
automatically updated
with the percent
complete.
If you don’t see the
task that you want to
update, click
Tasks>Add Row.
If you’re completely
done with a task,
select the check box
for the task, and then
click Tasks>Mark
Complete. Percent
complete is updated to
100%.
Actual Work
Actual Work
+ Remaining
Work
= % Work
Complete
30. 30Working on tasks in Project Web App
3. Send your updates to
the project managers
for your tasks.
If you’re ready to send
all of your updates,
click Tasks>Send
Status>All Tasks.
If you only want to
submit some of your
updates, select the
check box for each
task, and then click
Tasks>Send
Status>Selected
Tasks.
But the percentage doesn’t look accurate…what do I do?
Remember how percent complete is calculated?
20 hours completed
= 50% complete
40 hours scheduled
You know how much you worked, and you have an idea about what
percentage of the total work that represents, so what you’ll need to adjust is
31. More than just hours: Updating task progress31
the number of hours that are scheduled for the task.
For example, let’s say you’ve worked 20 hours, but you really only feel about
25% complete on the task. That means that you really think the task will take
80 hours, not 40, because 20 hours is 25% of 80 hours. Here’s what the math
looks like:
20 hours completed
= 25% complete
80 hours scheduled
To adjust the hours scheduled, you can either change the hours in the Work
column, to reflect the 80 total hours, or you can change the hours in the
Remaining Work column, to reflect the additional work left to do.
In this example, you’re saying that you think the whole thing will take 80
hours, and you’ve already completed 20 of those hours. That means you have
60 hours of remaining work. When you enter 60 in the Remaining Work
column, the % Work Complete column is updated to reflect the percentage
that you feel is more accurate.
Keep reading. The next section talks about how to submit your remaining
work to the project manager.
32. 32Working on tasks in Project Web App
Update how much work you have left to do
1. Click Tasks on the
Quick Launch.
2. Update your tasks.
In the grid, fill out the
Remaining Work
column.
If you don’t see the
task that you want to
update, click
Tasks>Add Row.
33. More than just hours: Updating task progress33
If you’re completely
done with a task,
select the check box
for the task, and then
click Tasks>Mark
Complete. Remaining
work is set to 0 hours.
3. Send your updates to
the project managers
for your tasks.
If you’re ready to send
all of your updates,
click Tasks>Send
Status>All Tasks.
If you only want to
submit some of your
updates, select the
check box for each
task, and then click
Tasks>Send
Status>Selected
Tasks.
34. 34Working on tasks in Project Web App
�
Not ready to submit? If you aren’t ready to send
your remaining work to the project manager,
click Tasks>Save to save your updates and
submit them later.
My organization is using oneview
Report the percent of work you’ve completed
When your organization uses one view to track time and task progress, the
hours that you fill out on your timesheet are used to calculate percent complete.
1. Click Timesheet on the
Quick Launch.
2. Use the right side of
the view to enter the
hours you worked on
the task.
35. More than just hours: Updating task progress35
3. Send your updates to
the project managers
for your tasks.
If you’re ready to send
all of your updates,
click Timesheet>Send
>Send Progress for All
Tasks.
If you only want to
submit some of your
updates, select the
check box for each
task, and then click
Timesheet>Send
>Send Progress for
Selected Tasks.
36. 36Working on tasks in Project Web App
4. After you’ve sent your
updates, the task will
be updated on your
timesheet, with the
new percent complete
in the % Work
Complete column.
But the percentage doesn’t look accurate…what do I do?
Remember how percent complete is calculated?
20 hours completed
= 50% complete
40 hours scheduled
You know how much you worked, and you have an idea about what
percentage of the total work that represents, so what you’ll need to adjust is
the number of hours that are scheduled for the task.
For example, let’s say you’ve worked 20 hours, but you really only feel about
25% complete on the task. That means that you really think the task will take
80 hours, not 40, because 20 hours is 25% of 80 hours. Here’s what the math
looks like:
20 hours completed
= 25% complete
80 hours scheduled
However, you’re a team member, not the project manager, so you can’t just
go in and change the project plan to get your numbers to work out. You need
to communicate this part of your task progress to your project manager. You
do this by submitting the remaining work on the task.
37. More than just hours: Updating task progress37
In this example, you’re saying that you think the whole thing will take 80
hours, and you’ve already completed 20 of those hours. That means you have
60 hours of remaining work.
Keep reading. The next section talks about how to submit your remaining
work to the project manager. Once you do that, the percent complete should
look accurate.
Update how much work you have left to do
1. Click Timesheet on the
Quick Launch.
2. Find the task that you
want to update on the
left side of the view.
38. 38Working on tasks in Project Web App
3. Use the scroll bar at
the bottom of the grid
to scroll right, to the
Remaining Work
column. Add the hours
you think are still
required to get the
task done.
If you don’t see the
task that you want to
update, click
Timesheet>Add Row.
39. More than just hours: Updating task progress39
4. Send your updates to
the project managers
for your tasks.
If you’re ready to send
all of your updates,
click Timesheet>Send
>Send Progress for All
Tasks.
If you only want to
submit some of your
updates, select the
check box for each
task, and then click
Timesheet>Send
>Send Progress for
Selected Tasks.
40. 40Working on tasks in Project Web App
Add comments about your work
Another way to communicate task progress is by simply
adding some comments when you send updates to your
project manager. Sometimes you may need to explain why
things are taking longer than planned (“I added 20 hours of
remaining work because…”), or you might want to give a few
more details about the work you did that week (“I spent 6
hours on that task on Tuesday doing…”).
“I added 20
hours of
remaining
work
because…”
You can add comments to your timesheet and task progress when you send
them to your project manager.
In the Tasks view…
1. Click the Tasks tab,
and then select the
Comment on Submit
check box in the
Show/Hide group.
2. Fill out your task
progress and then
click Tasks>Send
Status to choose what
you want to send.
If you’re not sure
which option to
choose, take a look at
the sections earlier in
this chapter.
41. More than just hours: Updating task progress41
3. Fill out the comment
box, and then click OK
to send your updates
to your project
manager.
In the Timesheet view…
1. Click the Options tab,
and then select the
Comment on Submit
check box in the
Show/Hide group.
42. 42Working on tasks in Project Web App
2. Fill out your timesheet
and then click
Timesheet>Send to
choose what you want
to send.
If you’re not sure
which option to
choose, take a look at
the sections earlier in
this chapter.
3. Fill out the Comment
box, and then click OK
to send your timesheet
to your manager.
43. More than just hours: Updating task progress43
Capture issues and risks
Projects very rarely go exactly as planned. (Talk about stating the obvious!)
!
Issues may come up along the way that have an impact on the
project schedule. Maybe someone you need to talk to goes out
on leave unexpectedly, or a tool you need to get the work done
breaks.
Risks are things that can impact the schedule, and that you’re
aware of when the project is planned. These may be things like
an upcoming personnel change, or a tight turnaround time on a
particular deliverable.
As a person who is assigned to do the work on a project, you may have the best
perspective on exactly what risks there are, and you certainly know what issues
you run into.
By planning fora project’s risks ahead of time, and recording the issues that
come up as the project progresses, your project manager is better able to
manage the project schedule. Sometimes, the project manager will do this work
without asking team members to add anything. In other cases, project
managers will ask team members to help fill out issues and risks on the project
site.
Add an issue
1. Click Projects on
the Quick Launch.
2. Click the name of
a project in the list.
44. 44Working on tasks in Project Web App

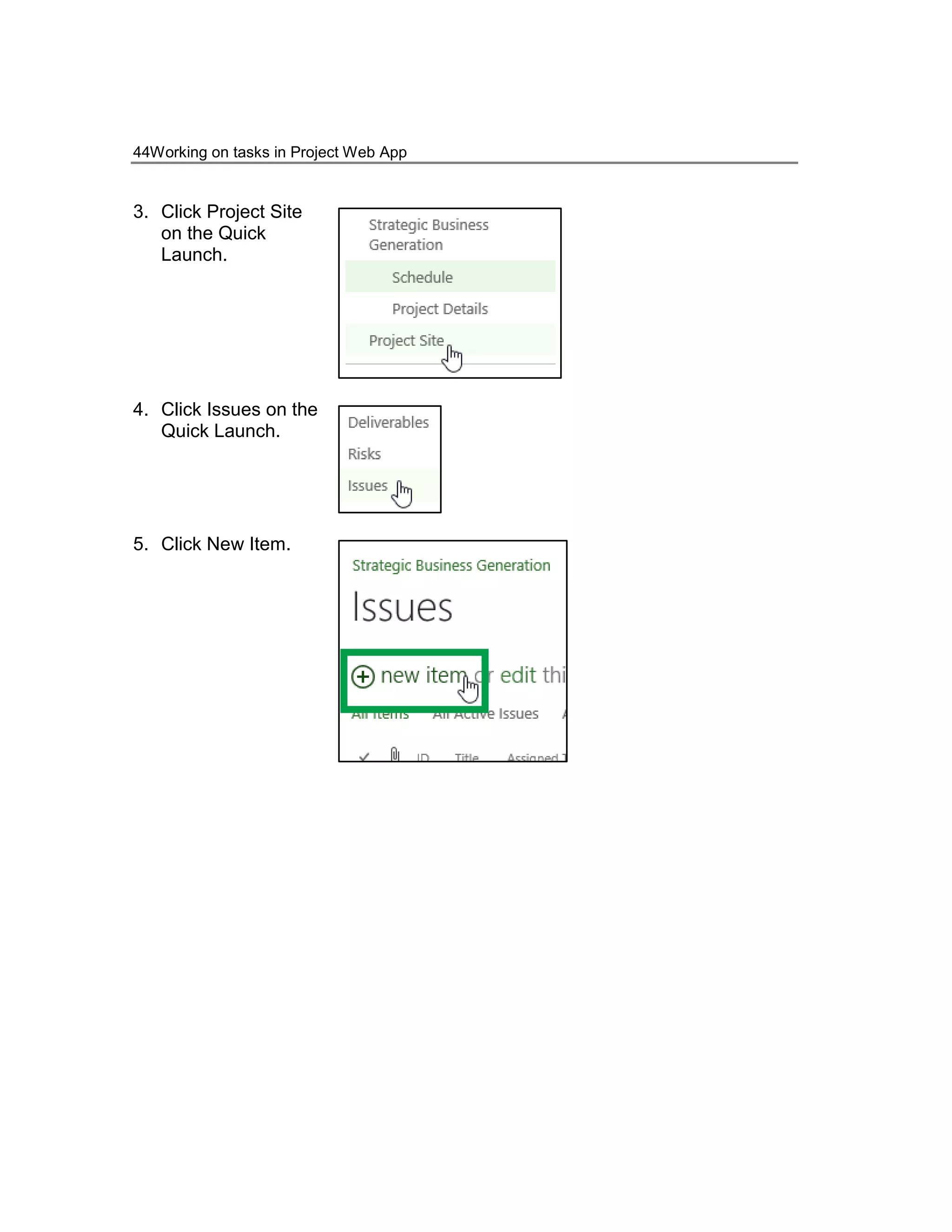

3. Click Project Site
on the Quick
Launch.
4. Click Issues on the
Quick Launch.
5. Click New Item.
45. More than just hours: Updating task progress45
6. Fill out the form,
including as many
details as you can
about the issue.
7. When you’re done,
click Edit>Save.
Add a risk
1. Click Projects on
the Quick Launch.
2. Click the name of
a project in the list.
46. 46Working on tasks in Project Web App
3. Click Project Site
on the Quick
Launch.
4. Click Risks on the
Quick Launch.
5. Click New Item.
6. Fill out the form,
including as many
details as you can
about the risk.
47. More than just hours: Updating task progress47

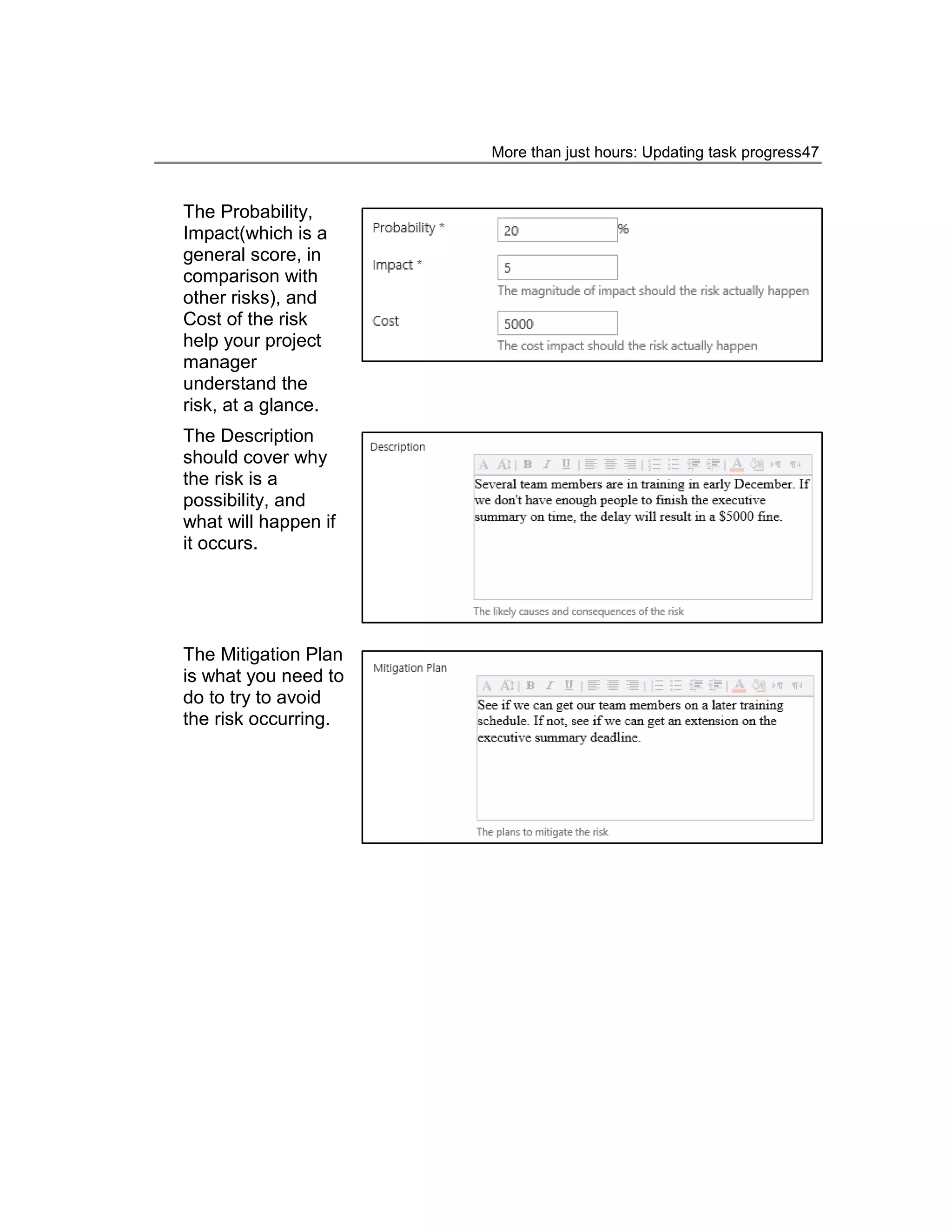

The Probability,
Impact(which is a
general score, in
comparison with
other risks), and
Cost of the risk
help your project
manager
understand the
risk, at a glance.
The Description
should cover why
the risk is a
possibility, and
what will happen if
it occurs.
The Mitigation Plan
is what you need to
do to try to avoid
the risk occurring.

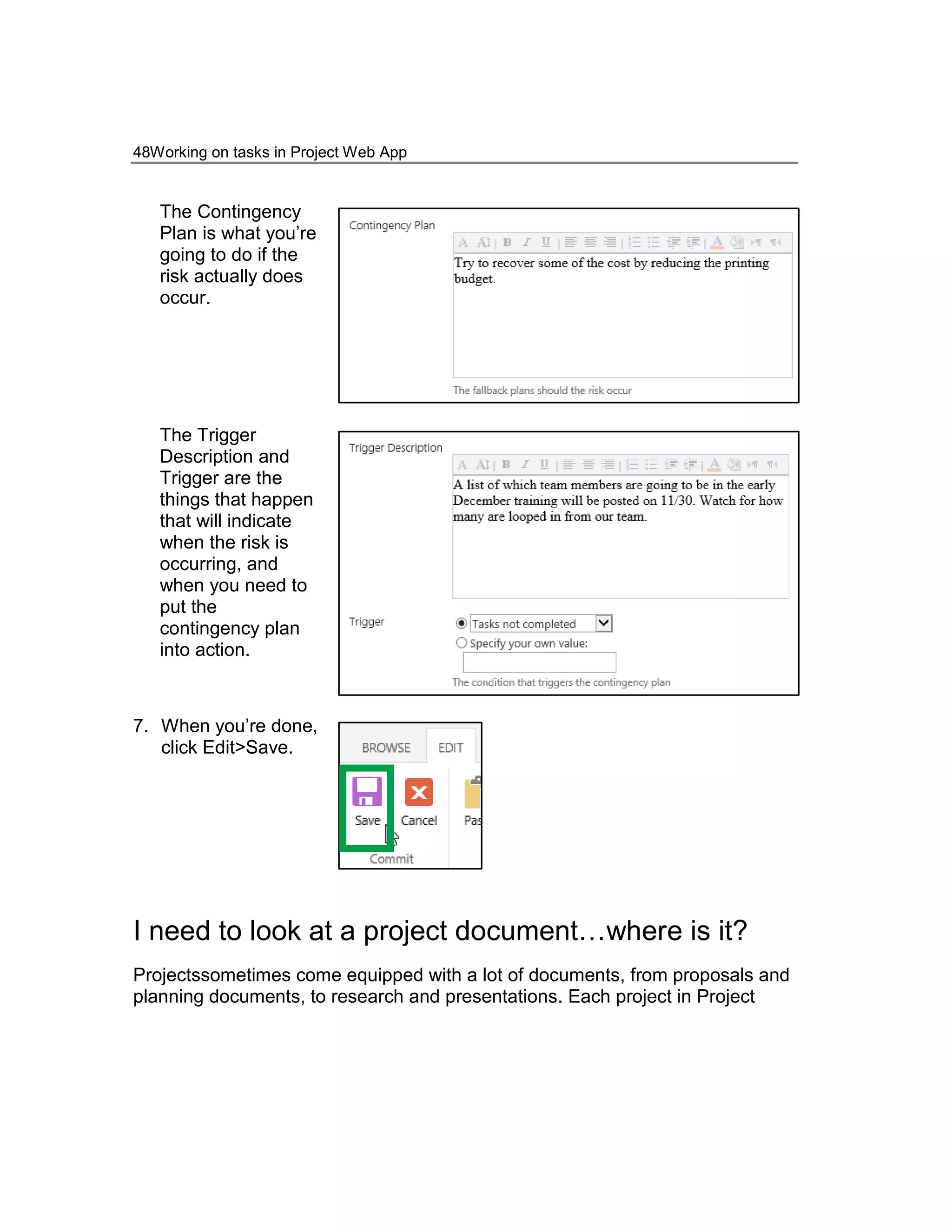

48. 48Working on tasks in Project Web App
The Contingency
Plan is what you’re
going to do if the
risk actually does
occur.
The Trigger
Description and
Trigger are the
things that happen
that will indicate
when the risk is
occurring, and
when you need to
put the
contingency plan
into action.
7. When you’re done,
click Edit>Save.
I need to look at a project document…where is it?
Projectssometimes come equipped with a lot of documents, from proposals and
planning documents, to research and presentations. Each project in Project
49. More than just hours: Updating task progress49
Web App has an associated project site, with a spot for storing and working with
documents.
1. Click Projects on
the Quick Launch.
2. Click the name of
a project in the list.
3. Click Project Site
on the Quick
Launch.
4. Click Documents
on the Quick
Launch.
50. 50Working on tasks in Project Web App
5. Click the name of
the document in
the list, to open it.
Hand off work to someone else
There are a lot of reasons why you’d need to reassign one of your tasks to
someone else. Here are some examples:
Maybe you’re being pulled onto another, higher-priority project, and you
need someone else to take on part of your existing workload.
Maybe another person on the team has more experience than you do
with a certain aspect of the project, and your project manager has asked
you to transition your work to that person.
Or…maybe you’re just really good at delegating.
Regardless, reassigning a task is easy.
51. More than just hours: Updating task progress51
1. Click Tasks on the
Quick Launch.
2. Click
Tasks>Reassign.
3. Find the task that
you want to
reassign in the
Select New
Resources grid,
and choose a new
team member in
the Reassign To
column.
52. 52Working on tasks in Project Web App
4. Set a Start Date for
when the transition
should happen,
and add
Comments if you’d
like.
5. Click Submit to
send the
reassignment to
the project
manager.
53. Vacation, sick leave, andother non-project hours53
4
Vacation, sick leave, andother
non-project hours
Hard work frequently results in one of two things: a welldeserved vacation, or a miserable, knock-you-off-your-feet
headcold.
Okay, maybe there isn’t a direct correlation, but in the course of
working on a project, you will surely have some time that you’ve
spent doing things other than working on your tasks. Sometimes
it’s vacation, sometimes it’s sick leave, and sometimes it’s workrelated (but not project-related) things like training or business
travel.
This chapter covers what you need to do ahead of time, while you’re out, and
after you’re back from time spent outside of your assigned tasks.
Ahead of time
There are a couple of things that you can do ahead of time, when you know
you’re not going to be working on your tasks for a certain day or set of days.
You can let your project manager know, for planning purposes, and you may be
able to assign someone to enter time and task progress for you while you’re out.
54. 54Working on tasks in Project Web App
Let your project manager know
If you know ahead of time that you’re going to be out of the office, or not able to
work on your tasks for some other reason, you can do your project manager a
huge favor by sharing that information as soon as you know you’re going to be
out.
Your project manager can enter your planned timeaway into a
calendar that reflects your working hours. Project Web App uses
that calendar to determine the project schedule, and your task
work will be automatically pushed out until you get back.
Assign someone to enter your time and task progress
Depending on how your organization uses Project Web App, you may be able to
identify someone who can enter and submit time and task progress on your
behalf while you’re out. This person is know as a “delegate.”
Before you leave for vacation (or whatever else has you away from your project
for a short period), set up a new delegation in Project Web App, so that
someone else can log in for you while you’re out.
1. Click Settings> PWA
Settings.
2. Under Personal
Settings, click Manage
Delegates.
3. Click
Delegations>New.
55. Vacation, sick leave, andother non-project hours55
4. Use the From and To
dates to set the time
period when you’ll be
away.
5. Enter the name of the
person that you want
to enter things for you
while you’re out.
6. Click Save.
After you get the delegation saved, don’t forget to chat with the person you just
assigned to let them know that they’re set up.
While you’re out
Time spent away from your project tasks can make for a
refreshing change of pace…especially if that time is spent
poolside with a tasty beverage. But even if your time away is
spent in a training session, or under a blanket on the couch
with a box of tissues, you’ll probably find that when you return
to your task work, you have a new perspective.
�
Really, the only thing you need to worry about while you’re out is making sure
that your time and task progress gets submitted on time. In some cases, you
can submit your information ahead of time, but not always. Some organizations
require that you submit things only on specific days or dates. That’s where your
delegate comes in.
If you assigned a delegate to enter time and task progress for you, that person
can log in by clicking Settings>PWA Settings, and then clicking Act as a
Delegate under Personal Settings.
56. 56Working on tasks in Project Web App
After you’re back
Welcome back to your tasks! Now that you’re back, you need to account for
your time away on your timesheet. Time spent on non-project work, including
vacation and sick time, is called administrative time in Project Web App.
1. Click Timesheet on the
Quick Launch.
2. Fill out the Actual row, on
the right side of the grid, for
vacation, sick time, or
another category of
administrative time.
If the administrative task
you need isn’t listed on your
timesheet, click
Timesheet>AddRow>Add
Non-Project Line.
3. Continue filling out the rest of your timesheet, and submit it whenever
you’re ready. For more information on this, see Chapter 2: Turning in
timesheets.
57. Uh oh, I didn’t mean to submit that!57
5
Uh oh, I didn’t mean to submit
that!
Maybe you were working from home and your four-year-old accidentally
submitted your timesheet, or your cat walked across your keyboard and entered
some extra hours for you. Or, more likely, you forgot to add some task work to
your timesheet before sending it to your project manager. Whatever the reason,
sometimes, you just didn’t mean to submit things yet.
This chapter covers how to recall a timesheet you’ve already submitted, and
how to delete a timesheet altogether.
▶
NOTEYou can only recall or delete timesheets that are not yet
approved. If they’re approved, you’ll need to chat with your project
manager about your changes.
Take back a timesheet that you sent for approval
If you realize, after you’ve sent your timesheet for approval, that you need to
make changes, you can recall your timesheet if it hasn’t been approved yet.
1. Click Settings
Settings.
> PWA
58. 58Working on tasks in Project Web App
2. Under Time and Task
Management, click Manage
Timesheets.
3. Click the row for the timesheet
you want to recall.
4. Click Timesheets>Recall.
5. Click OK to confirm the recall.
Delete a timesheet and start over
Sometimes it’s easier just to start a timesheet over from scratch. You can delete the
existing timesheet, as long as you haven’t sent it for approval yet.
1. Click Settings
Settings.
> PWA
59. Uh oh, I didn’t mean to submit that!59
2. Under Time and Task
Management, click Manage
Timesheets.
3. Click the row for the timesheet
you want to delete.
4. Click Timesheets>Delete.
5. Click OK to confirm the
deletion.
60. 60Working on tasks in Project Web App
6
Rejected! Now what?
If your timesheet or task progress doesn’t match what your
manager was expecting, you may find out it’s been rejected. This
never feels great, but it’s probably not personal, and hopefully
your project manager has included some comments outlining why
your updates were rejected.
This chapter covers how to figure out if your updates are rejected, how to find
out why they were rejected, and what you should do to get your time and task
progress resubmitted.
How do I know if my updates were rejected?
When your time or task progress is rejected, this status shows up in the Process
Status column on the Timesheet or Tasks view.
61. Rejected! Now what?61
In the Timesheet view…
In the Tasks view…
Why were my updates rejected?
Hopefully, your project manager will chat with you about why they’re rejecting
your updates. If not, he or she may have added a comment before sending it
back to you. If you see an update that has been rejected, it’s best to look closely
at the task and see if a comment has been added, before hunting down your
project manager to ask questions.
1. Click the name of the
rejected task in the
list on the Timesheet
or Tasks view.
2. Comments are listed
under Recent Task
Changes.
What do I do now?
Once you’ve reviewed comments, and chatted with your project manager if
needed, the next step is to make appropriate changes to your timesheet and
task progress, and then resubmit it.
62. 62Working on tasks in Project Web App
When you see that
your updates have
been rejected…
…you figure out what
you need to do to fix
them…
…then you resubmit
your updates…
Task A
8
8
4
4
Task B
4
Task C
Task A
8
8
8
6
Task B
Task A
Task B
Task C
6
2
8
8
8
2
Task C
…and your project
manager can approve
them if they make
sense.
6
2
Task C
8
8
2
6
Task B
Task A
4
8
2
6
6
2
8
Okay, but how?
This process doesn’t require anything different or fancy…you just do things the
same way you submitted things initially:
If you need help resubmitting your timesheet,see Chapter 2: Turning in
timesheets.
If you need help resubmitting your task progress,see Chapter 3: More
than just hours: Updating task progress.
When in doubt, add comments…
Adding comments when you resubmit your updates can help your manager
understand what changes you made, and how they address the issues that
came up initially.Chapter 3: More than just hours: Updating task progress
covers how to add comments in the Timesheet and Tasks views.
64. In Project Web App, how do I…
See a list of my projects?
Click Projects on the Quick Launch.
Add a task to my timesheet?
Click Timesheet>Add Row.
Enter vacation or sick time?
Fill out the Administrative lines on your
timesheet.
Switch to a different timesheet?
Click Timesheet>Select Period.
Add a task in the Tasks view?
Click Tasks>Add Row.
Add comments about my work in
the Timesheet view?
Choose Options>Comment on Submit.
Add comments about my work in
the Tasks view?
Choose Tasks>Comment on Submit.
Hand off work to someone else?
Click Tasks>Reassign.
Find out why my updates were
rejected?
Click the task name on the Timesheet or
Tasks view, and look under Recent Task
Changes.
My Project Web Appadministrator [name]
is: [contact info line 1]
[contact info line 2]
My Project Web App address is: [URL]
