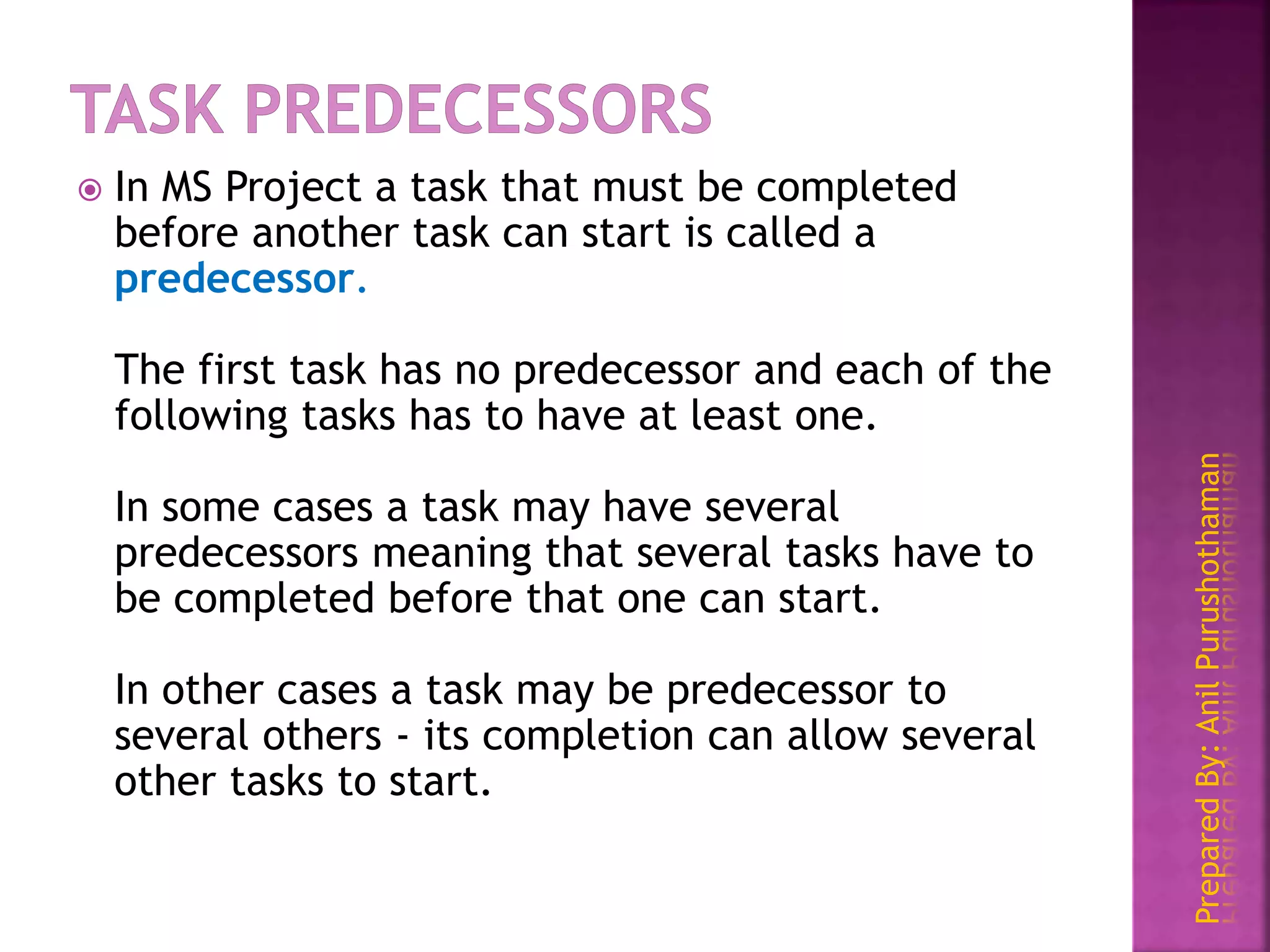

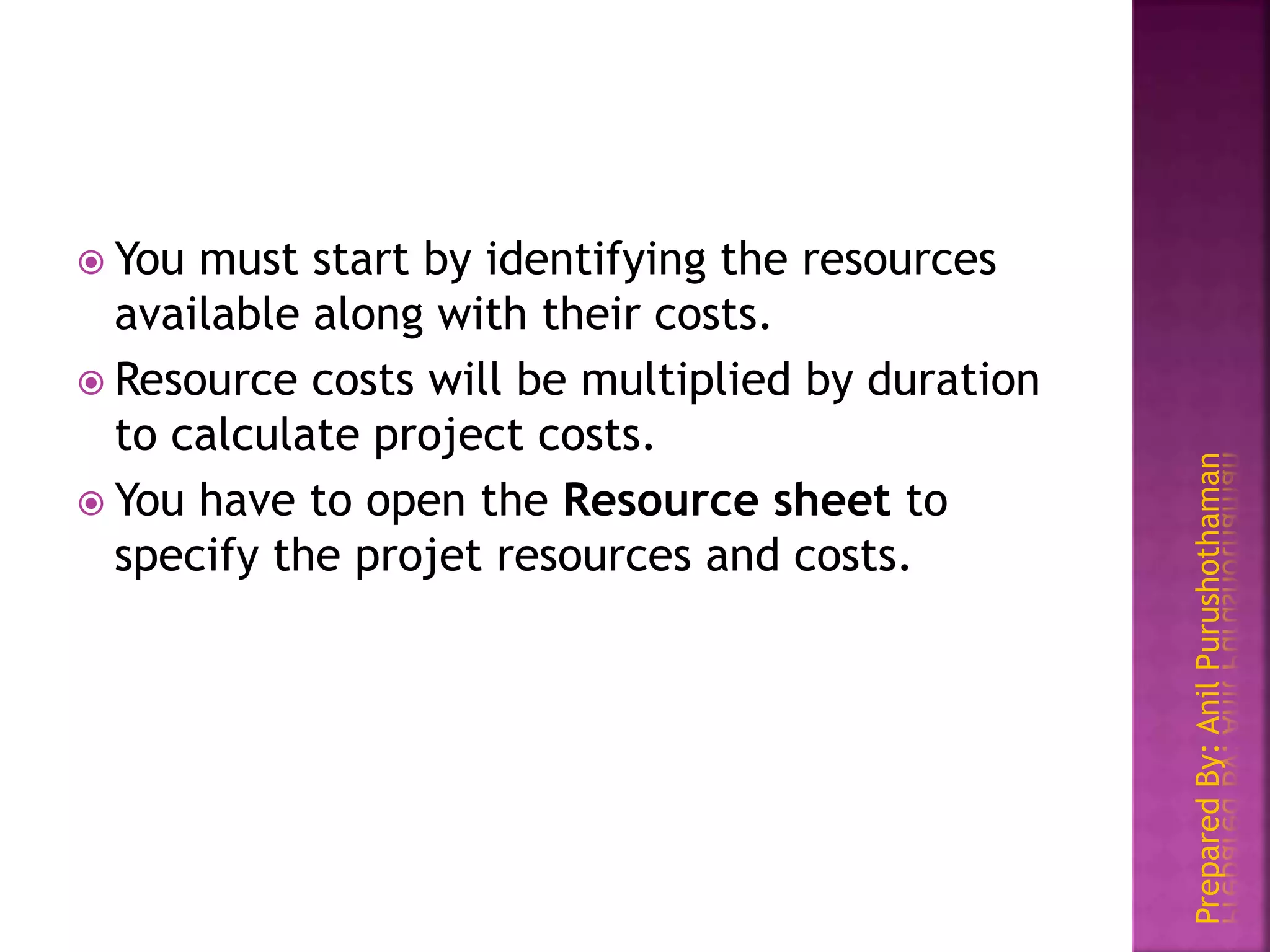

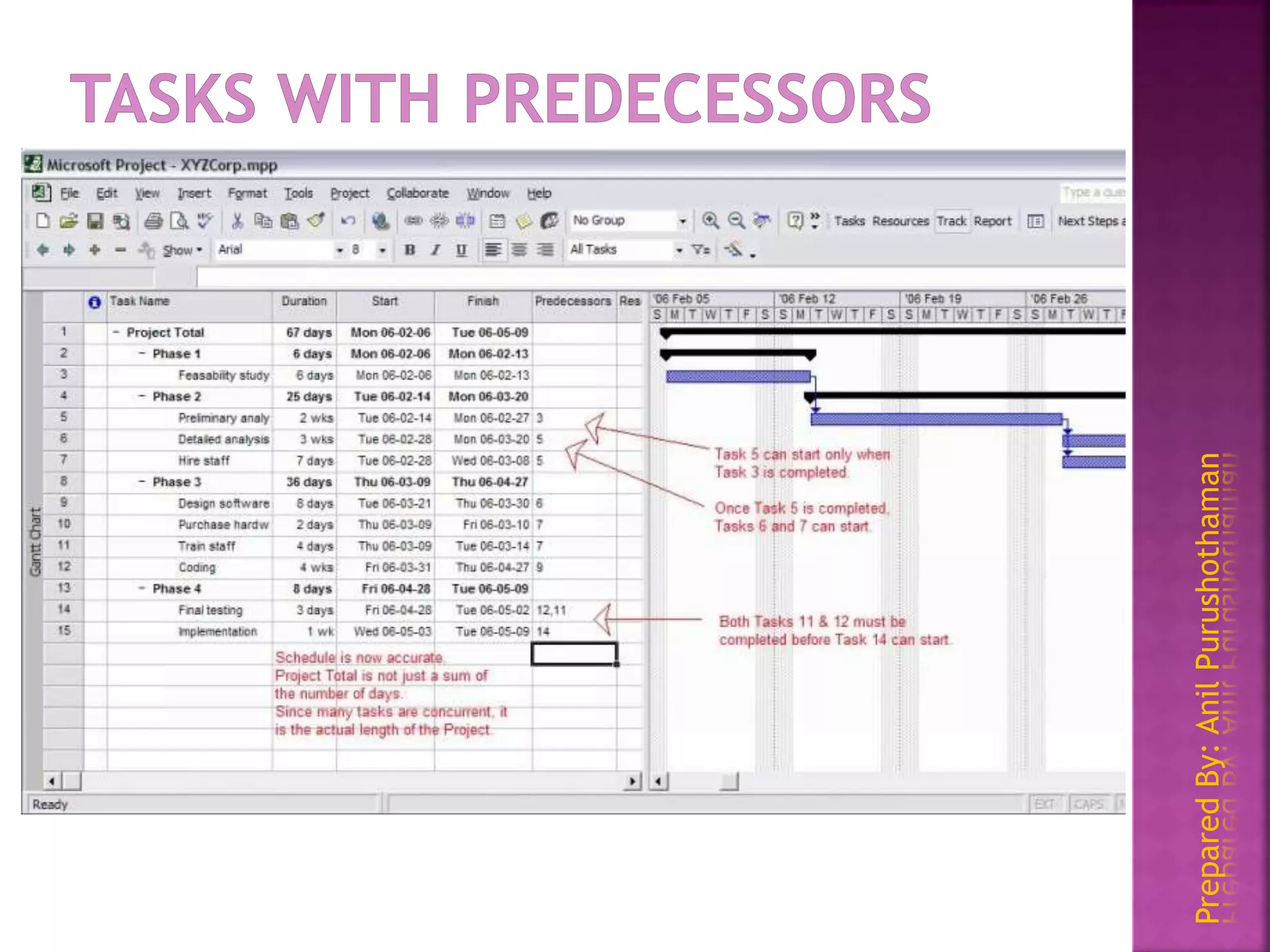

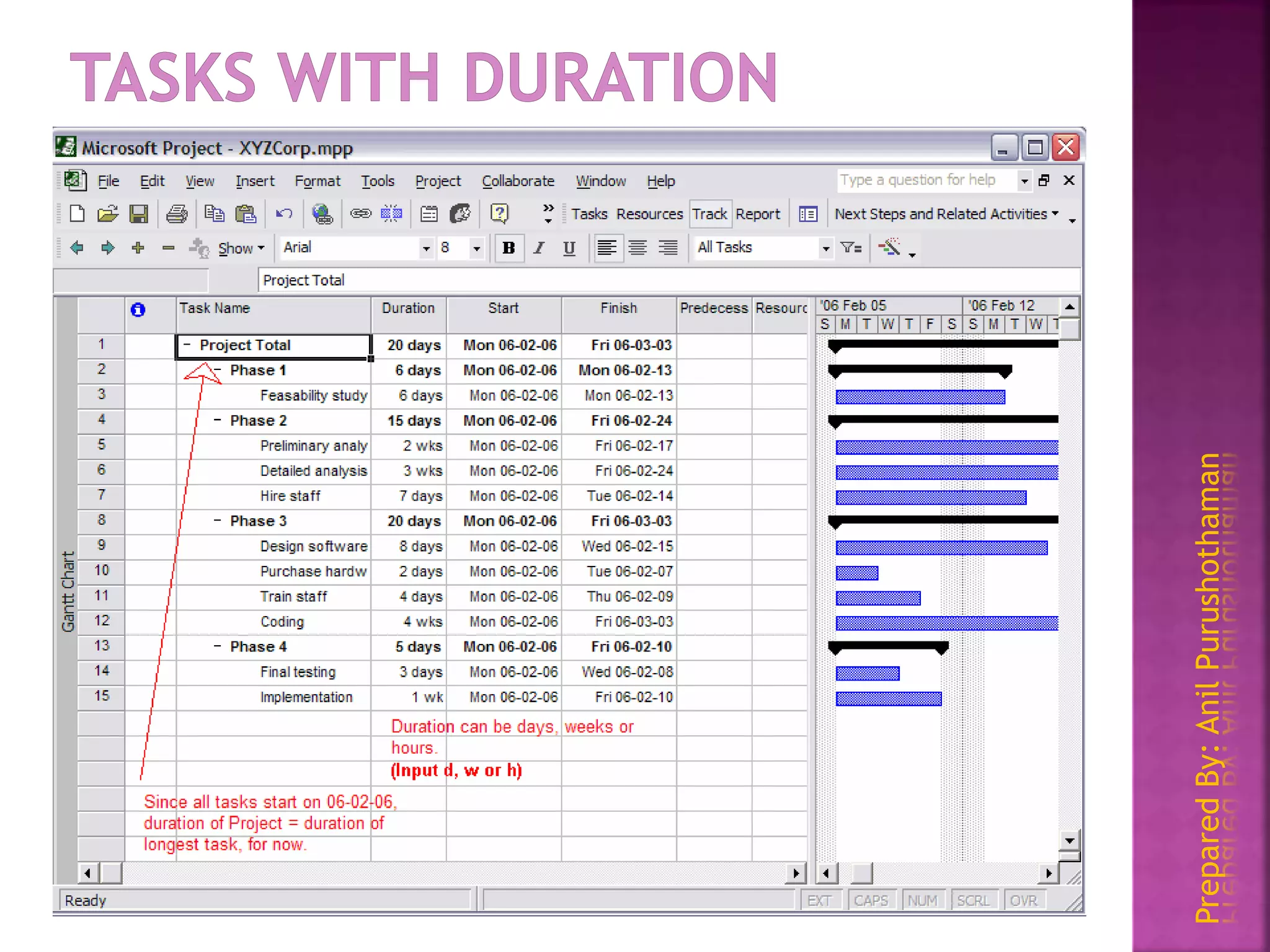

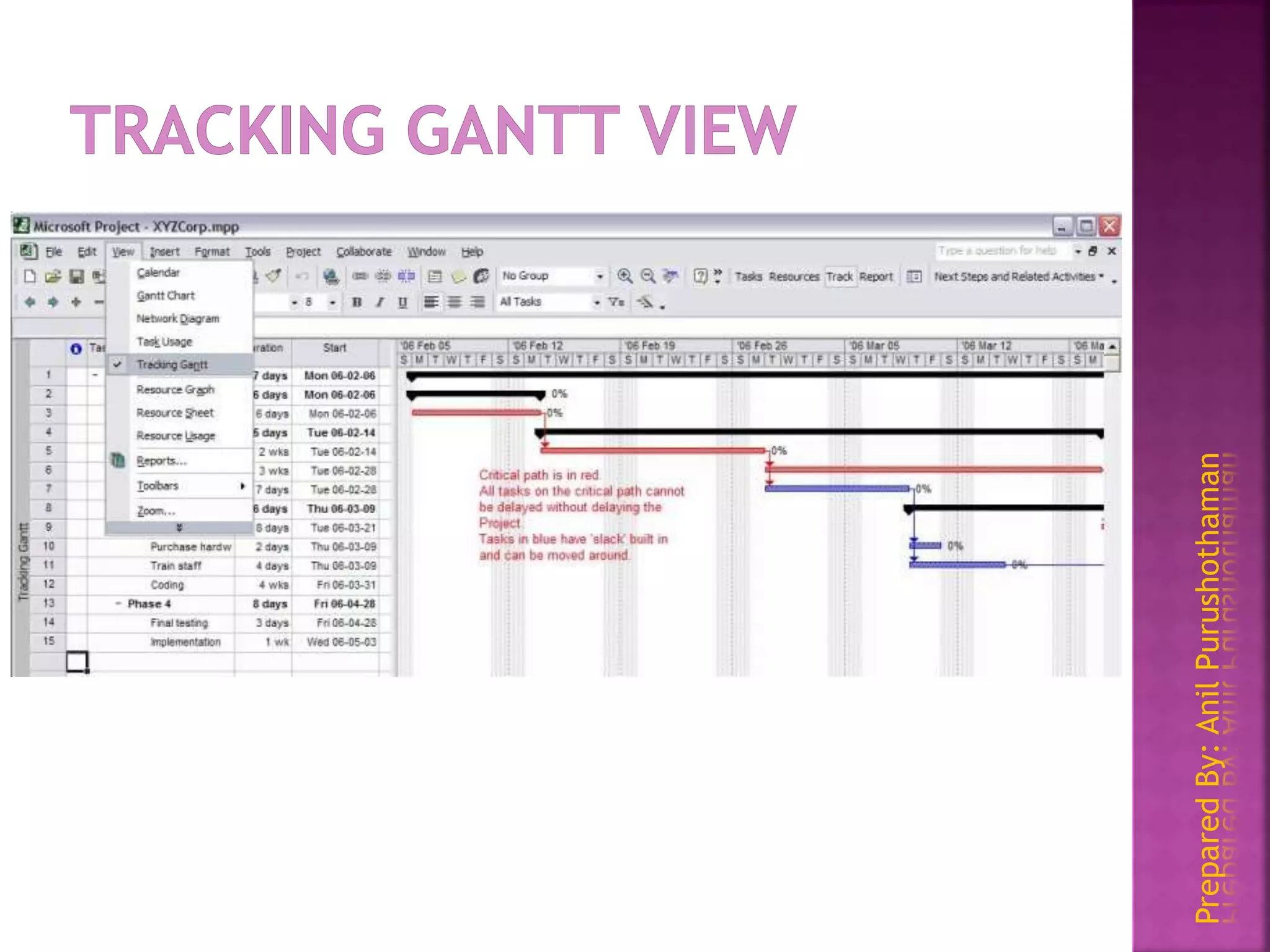

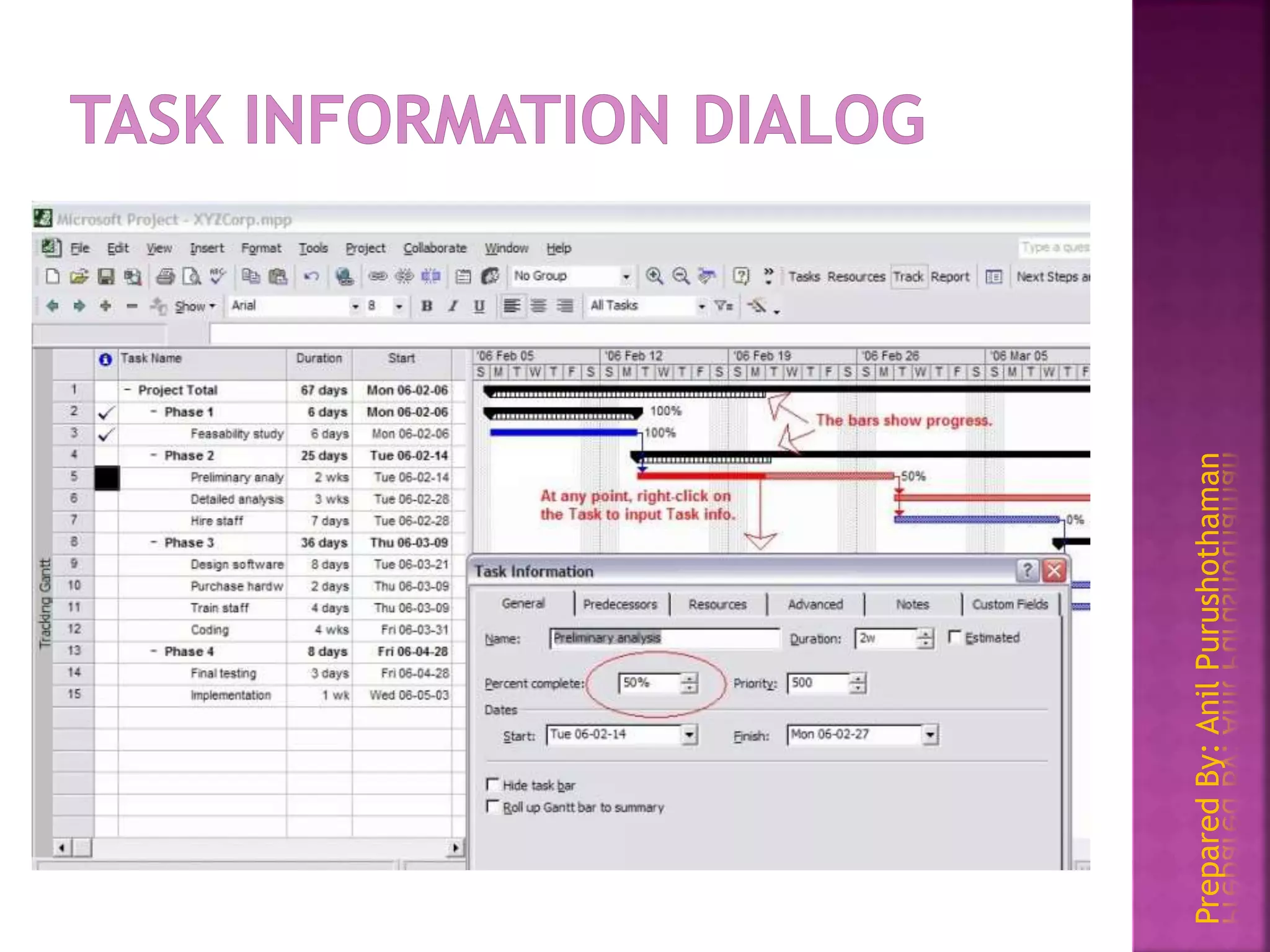

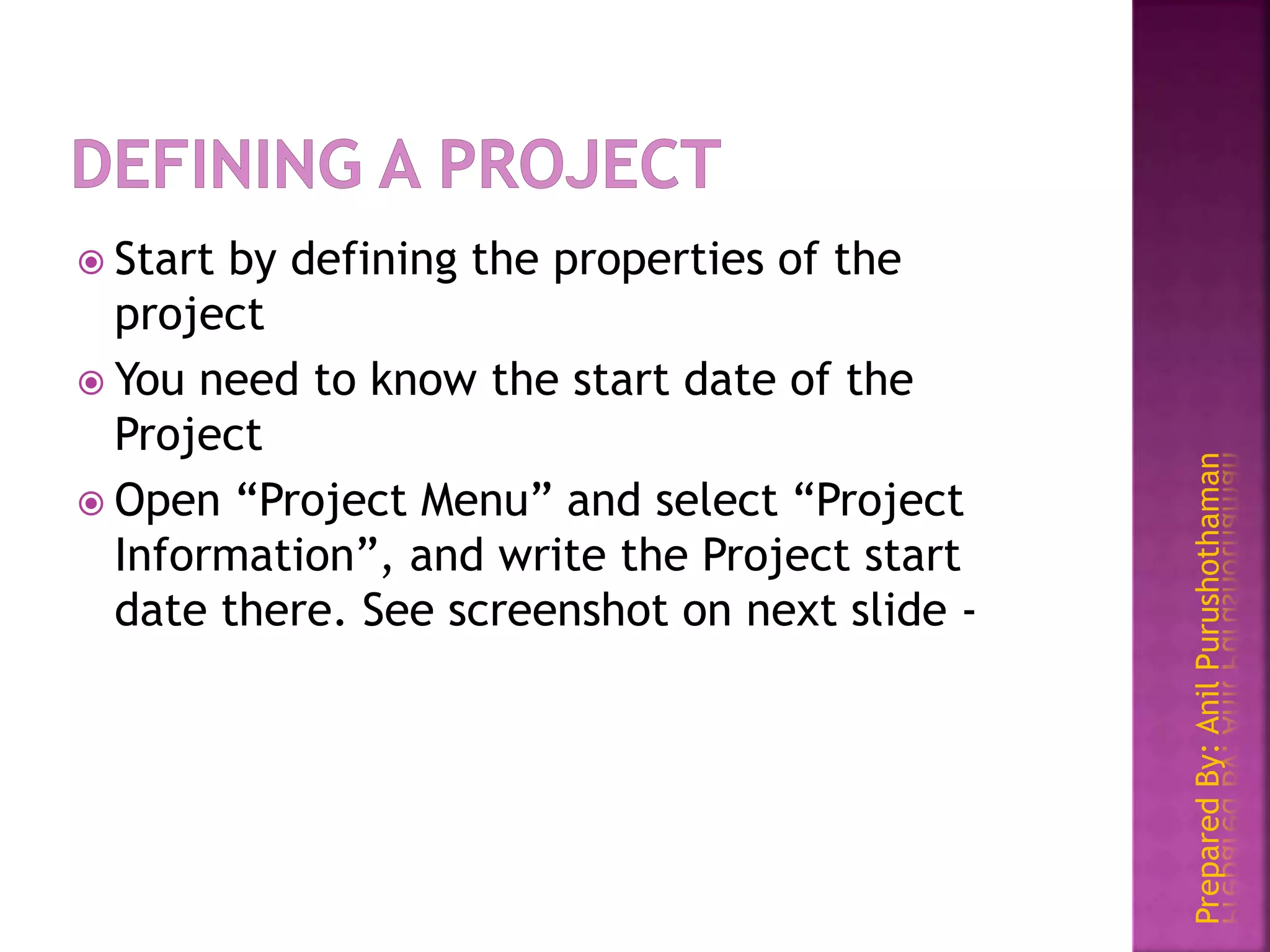

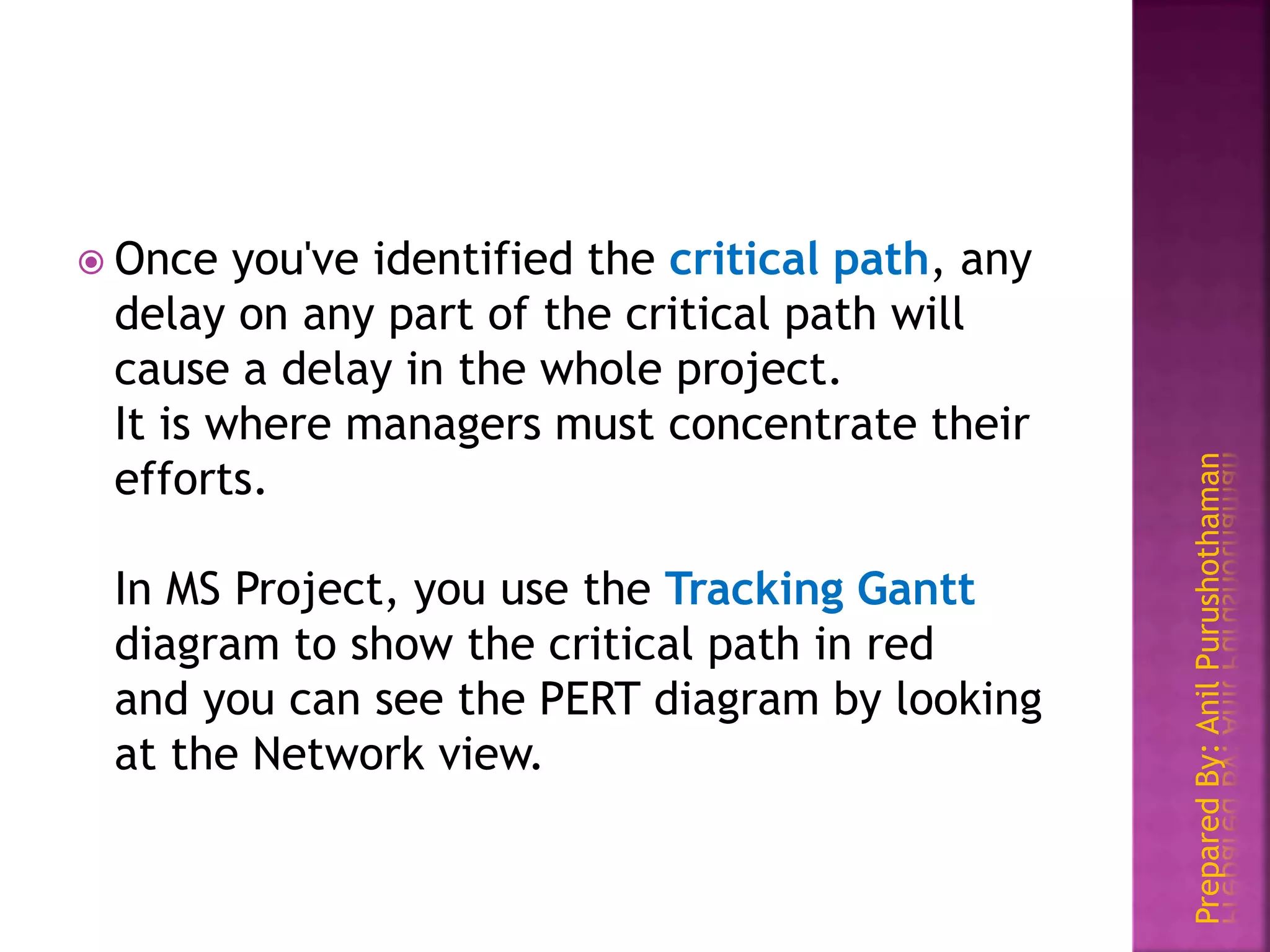

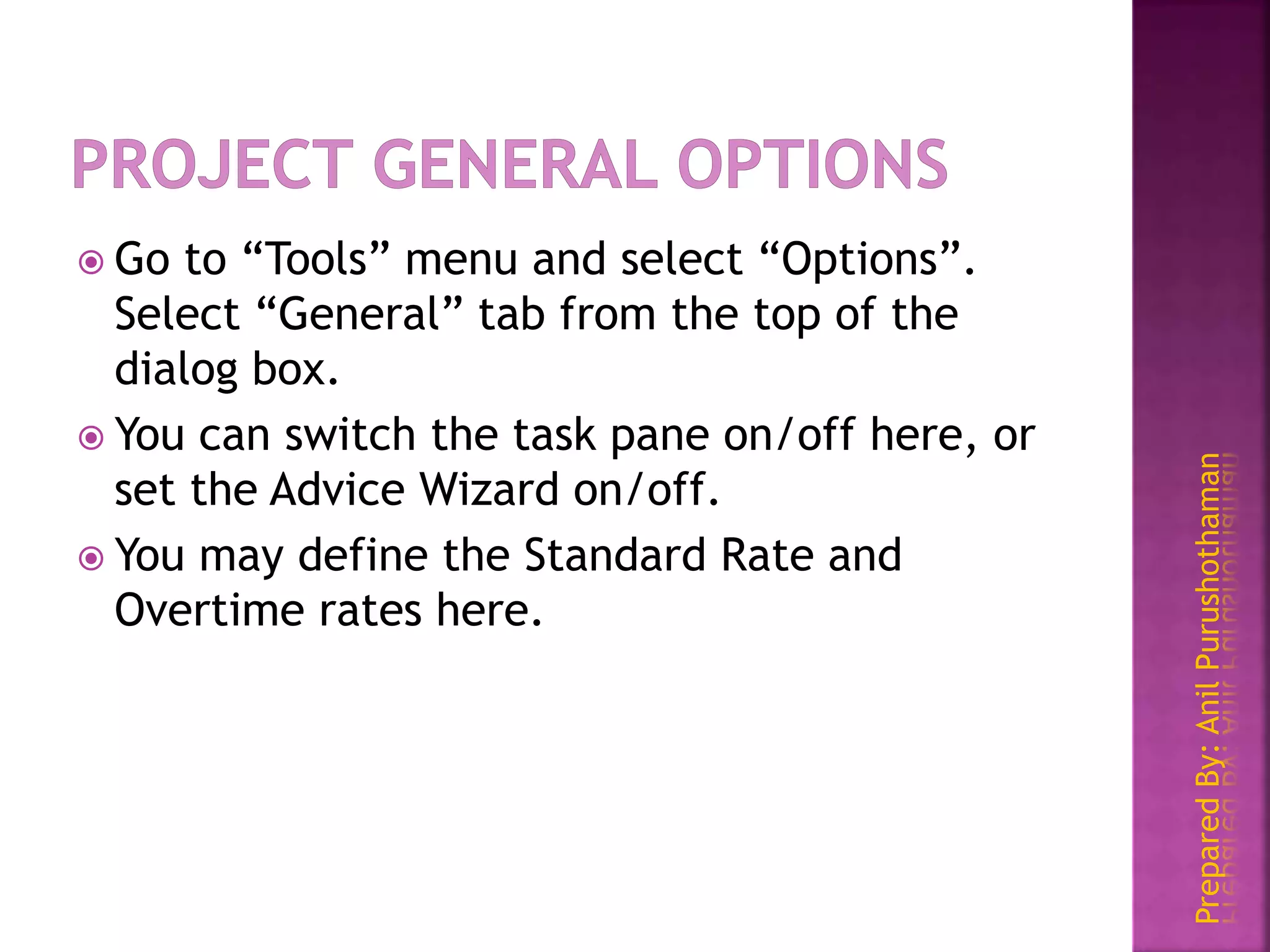

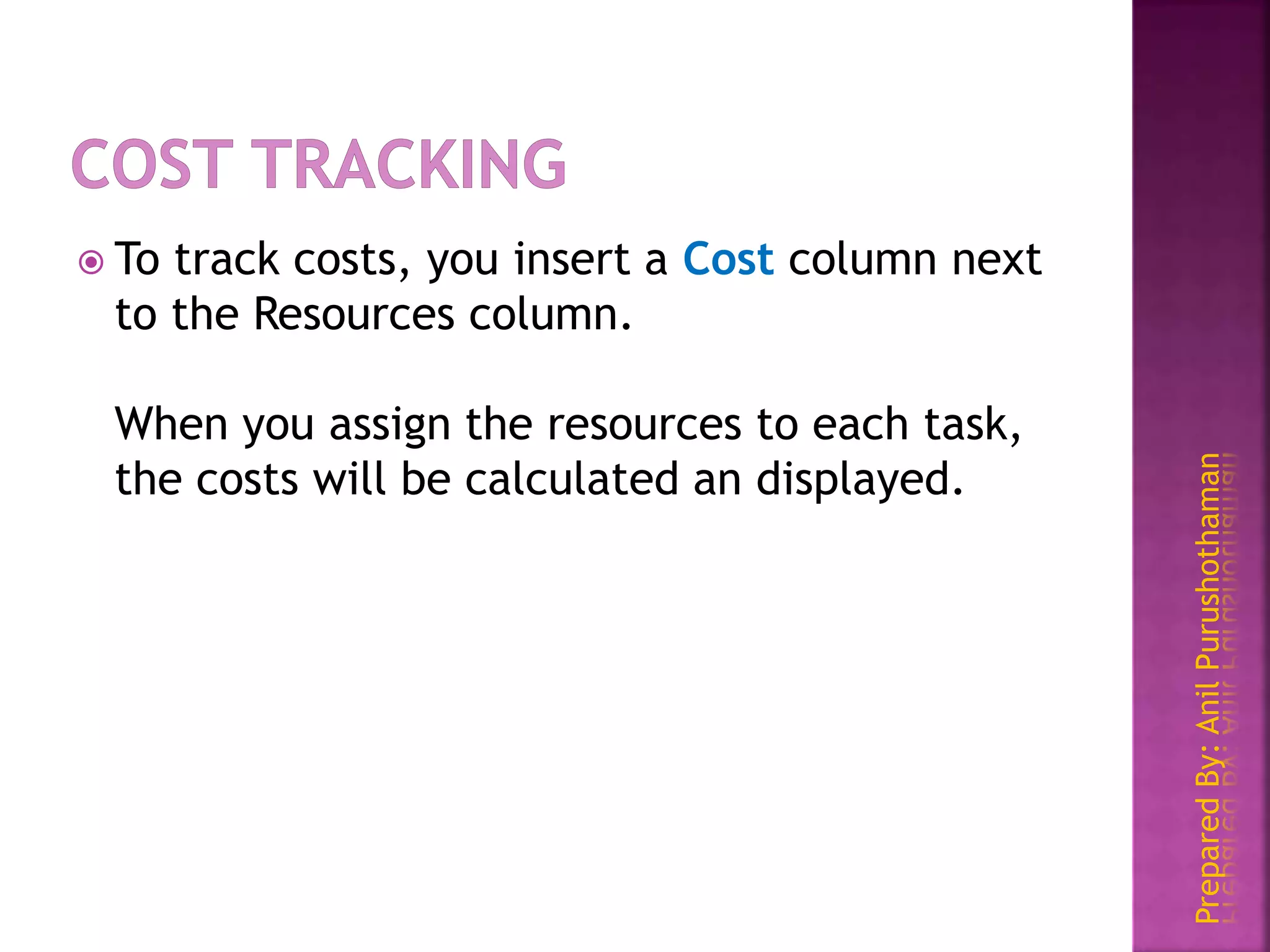

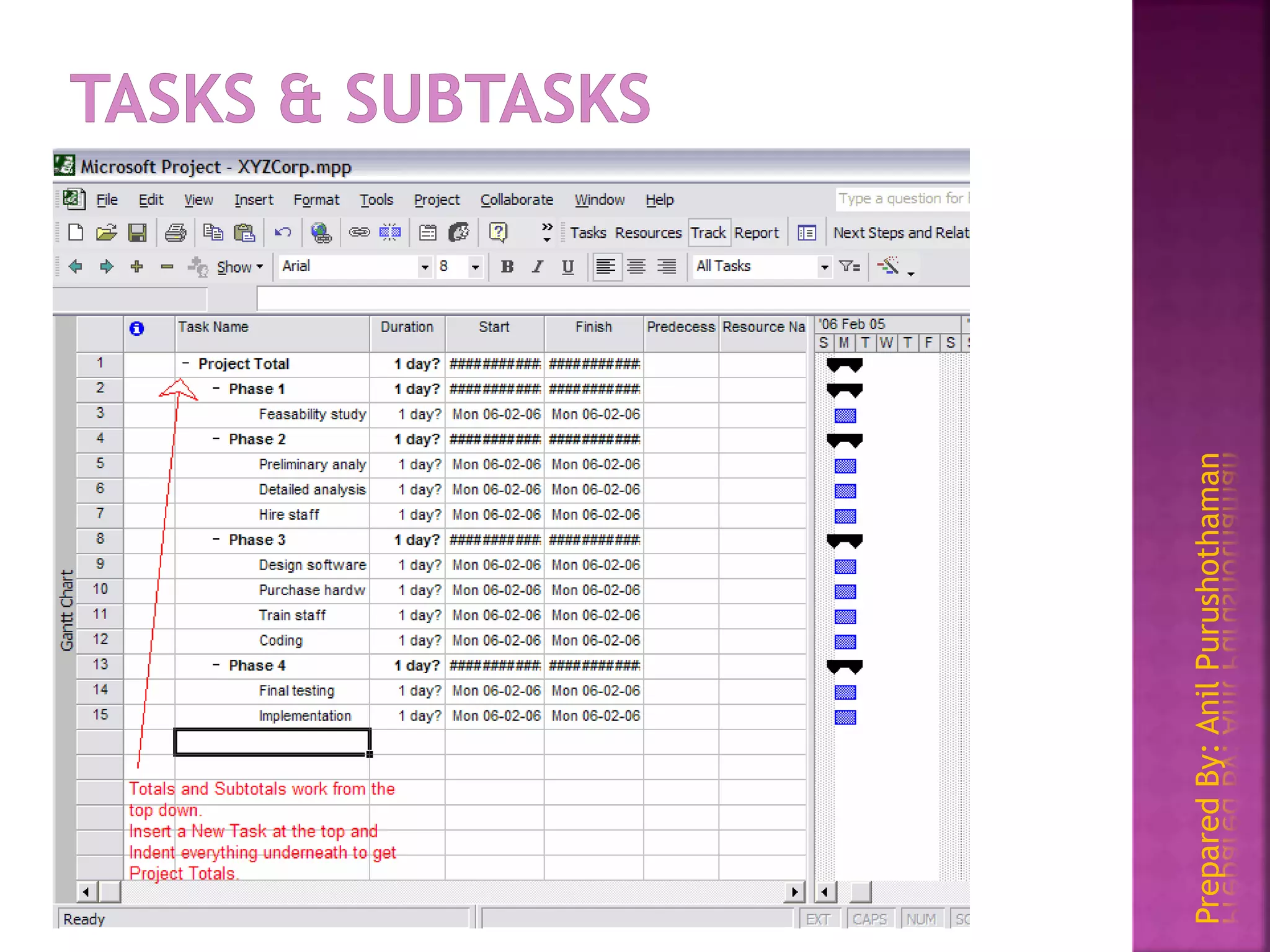

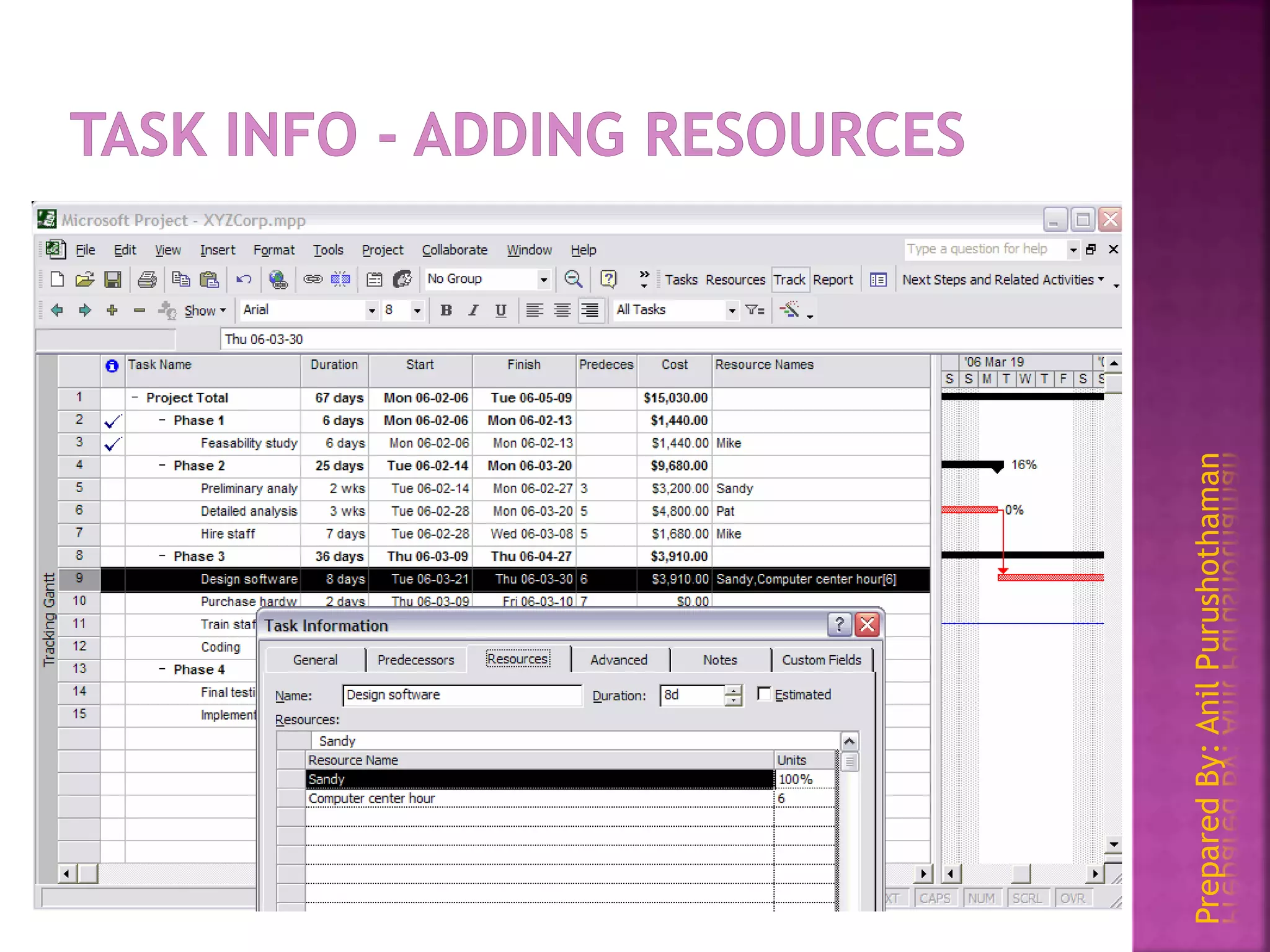

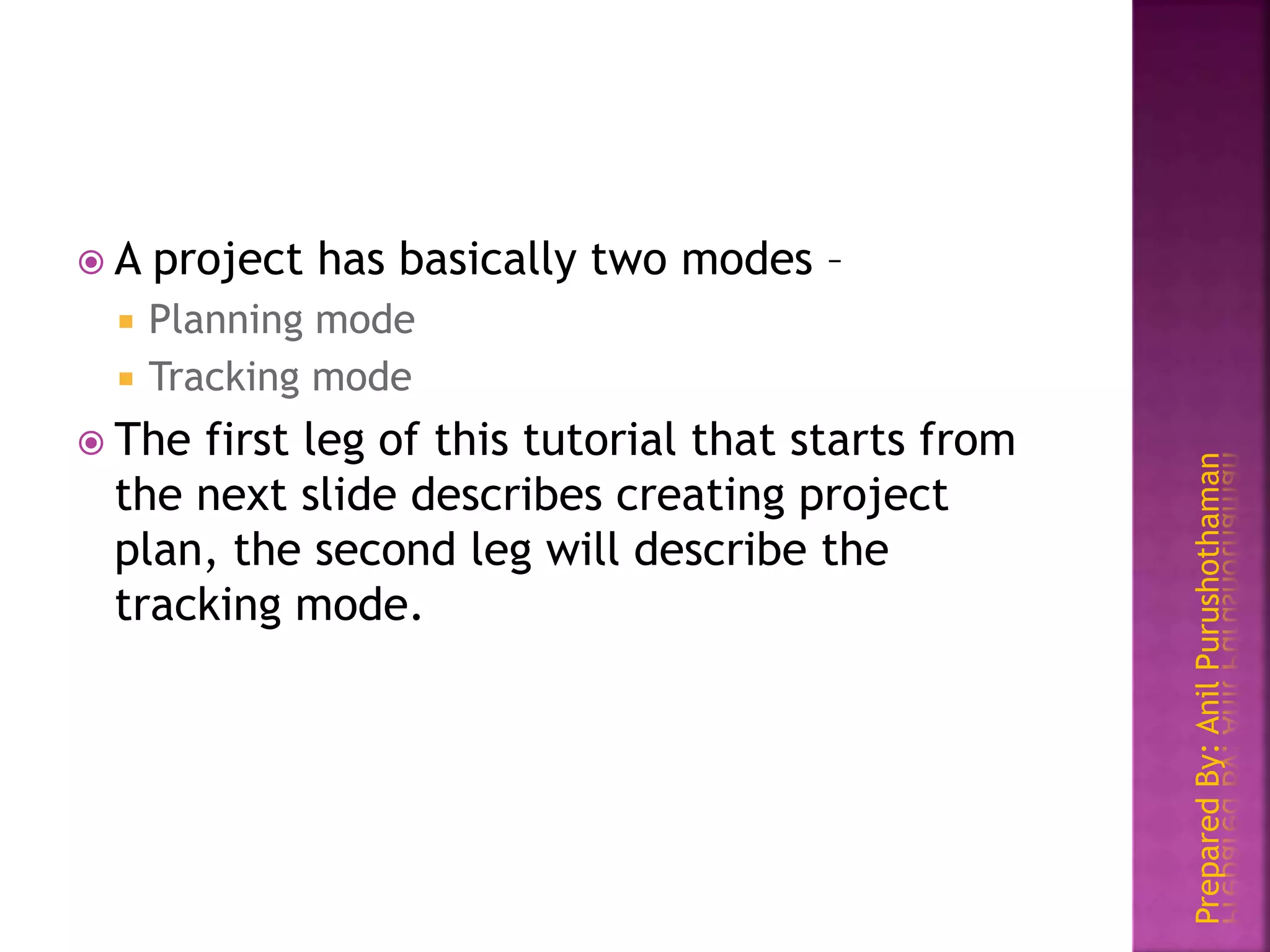

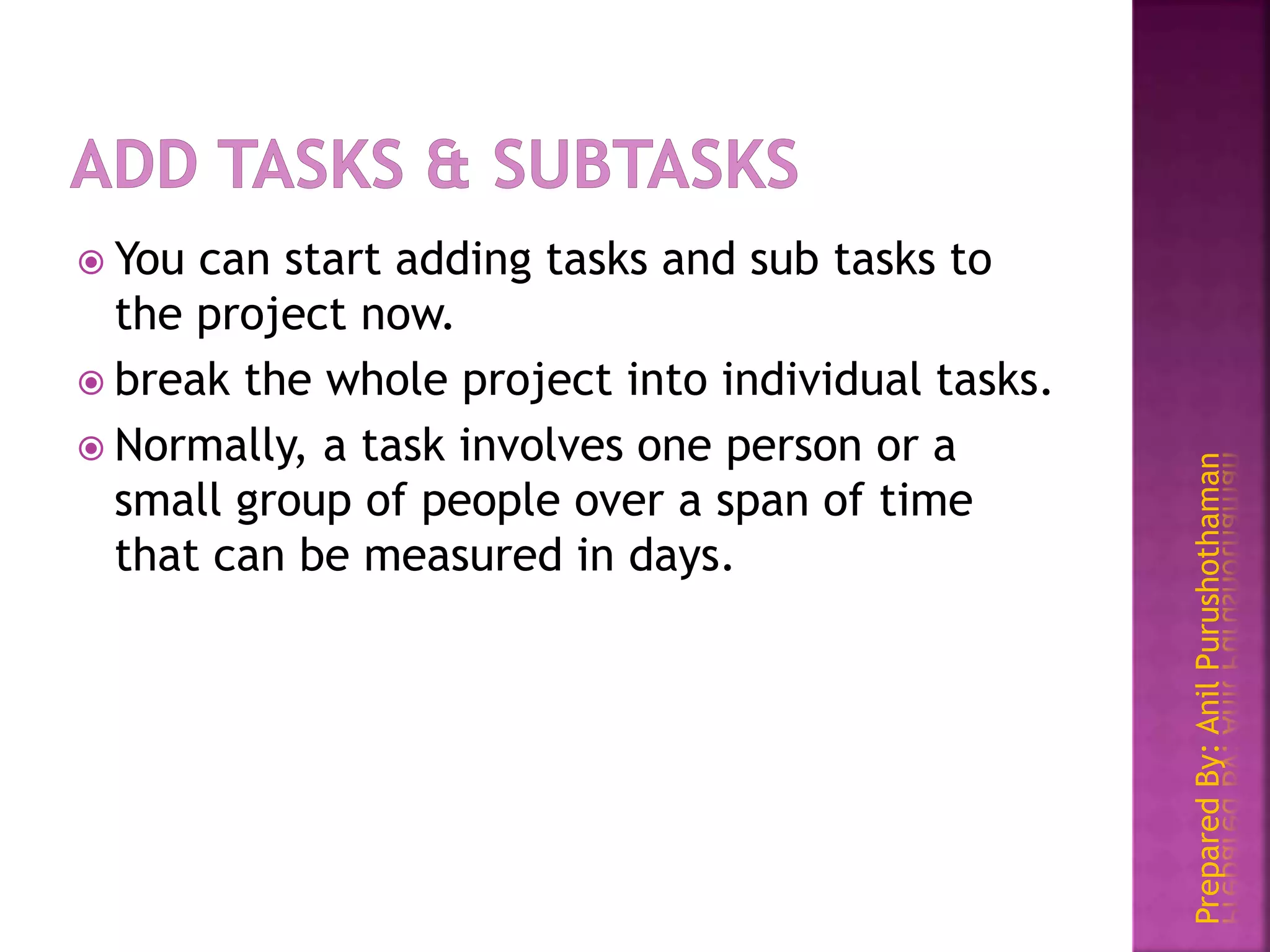

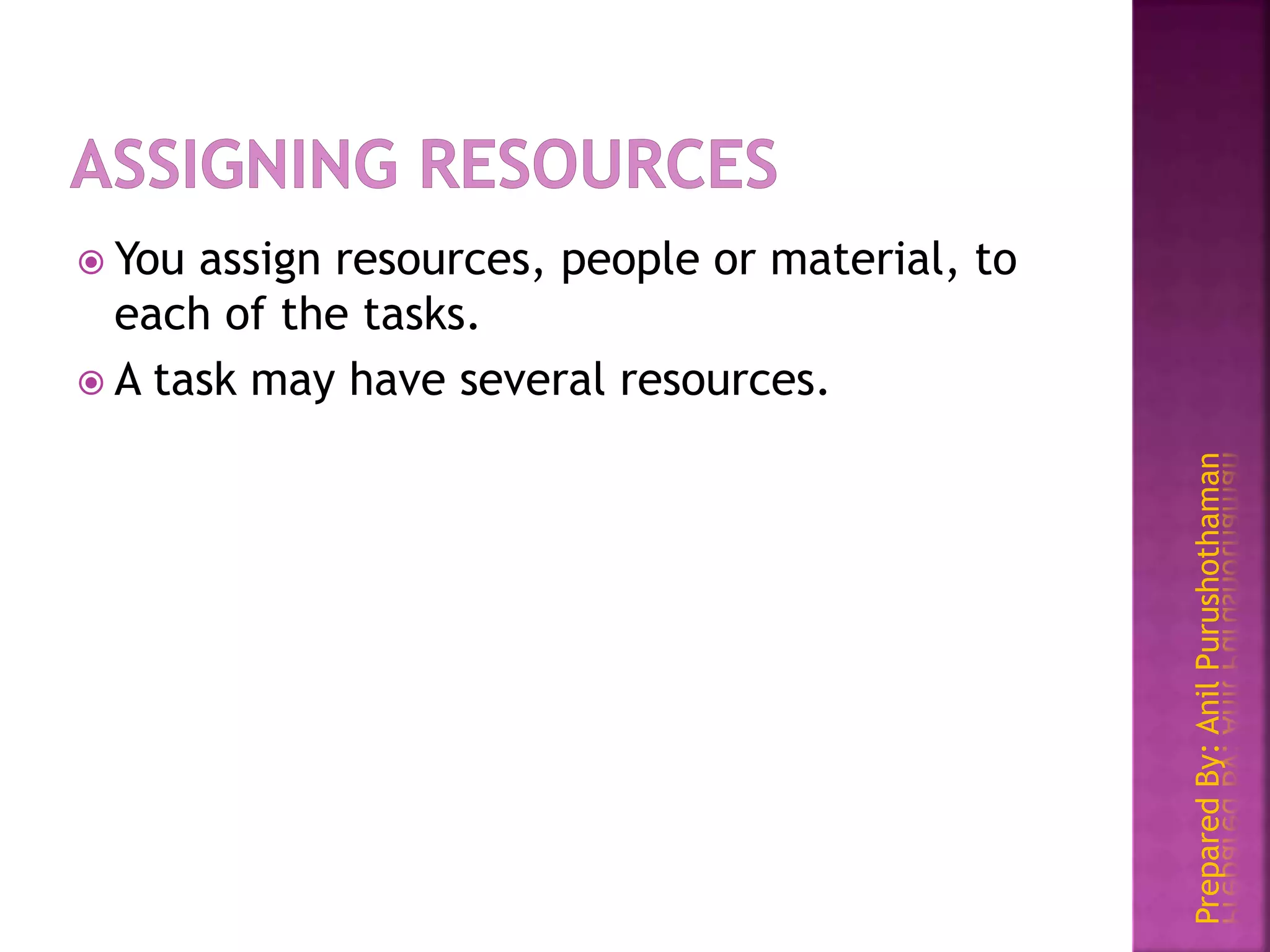

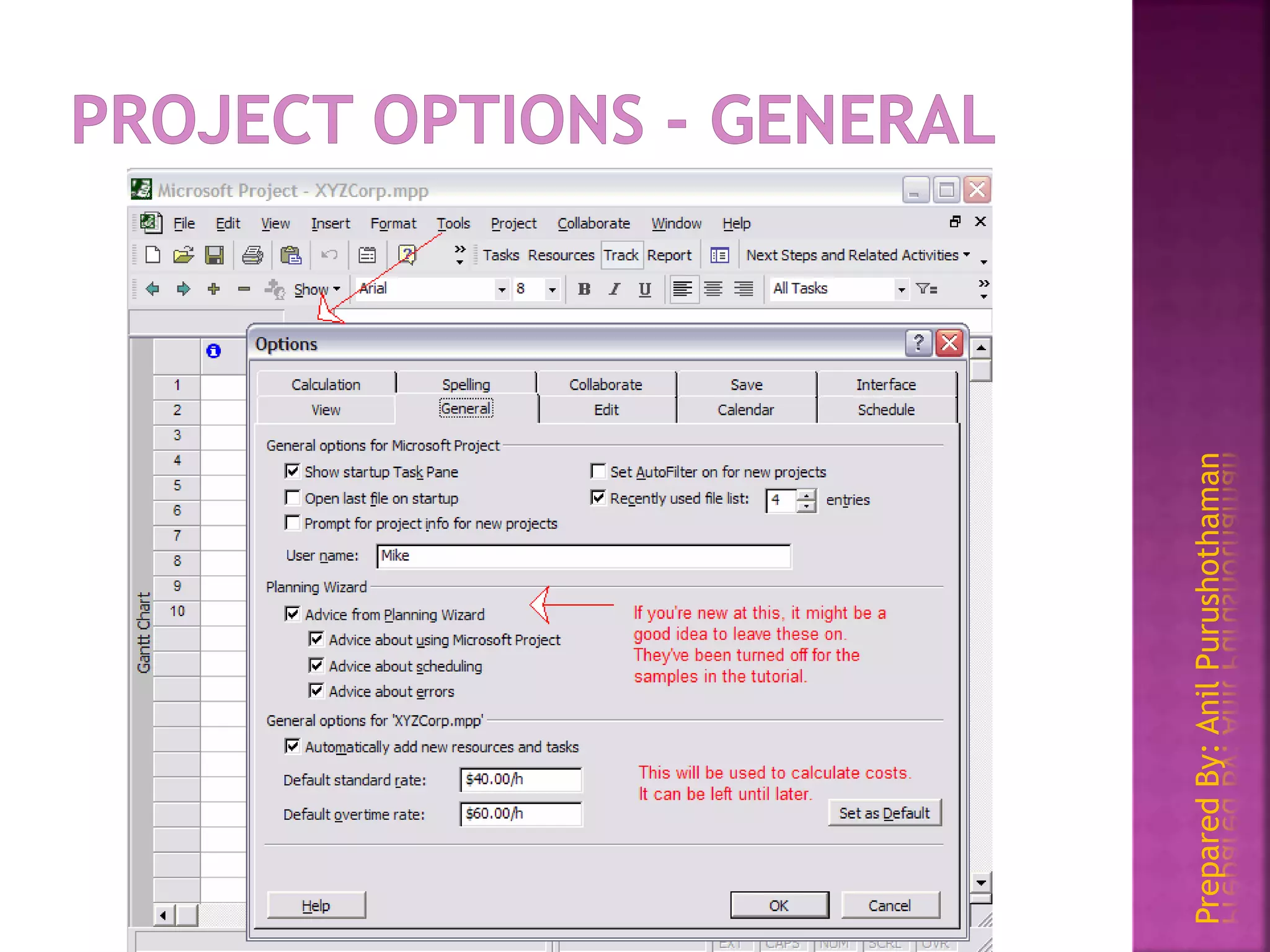

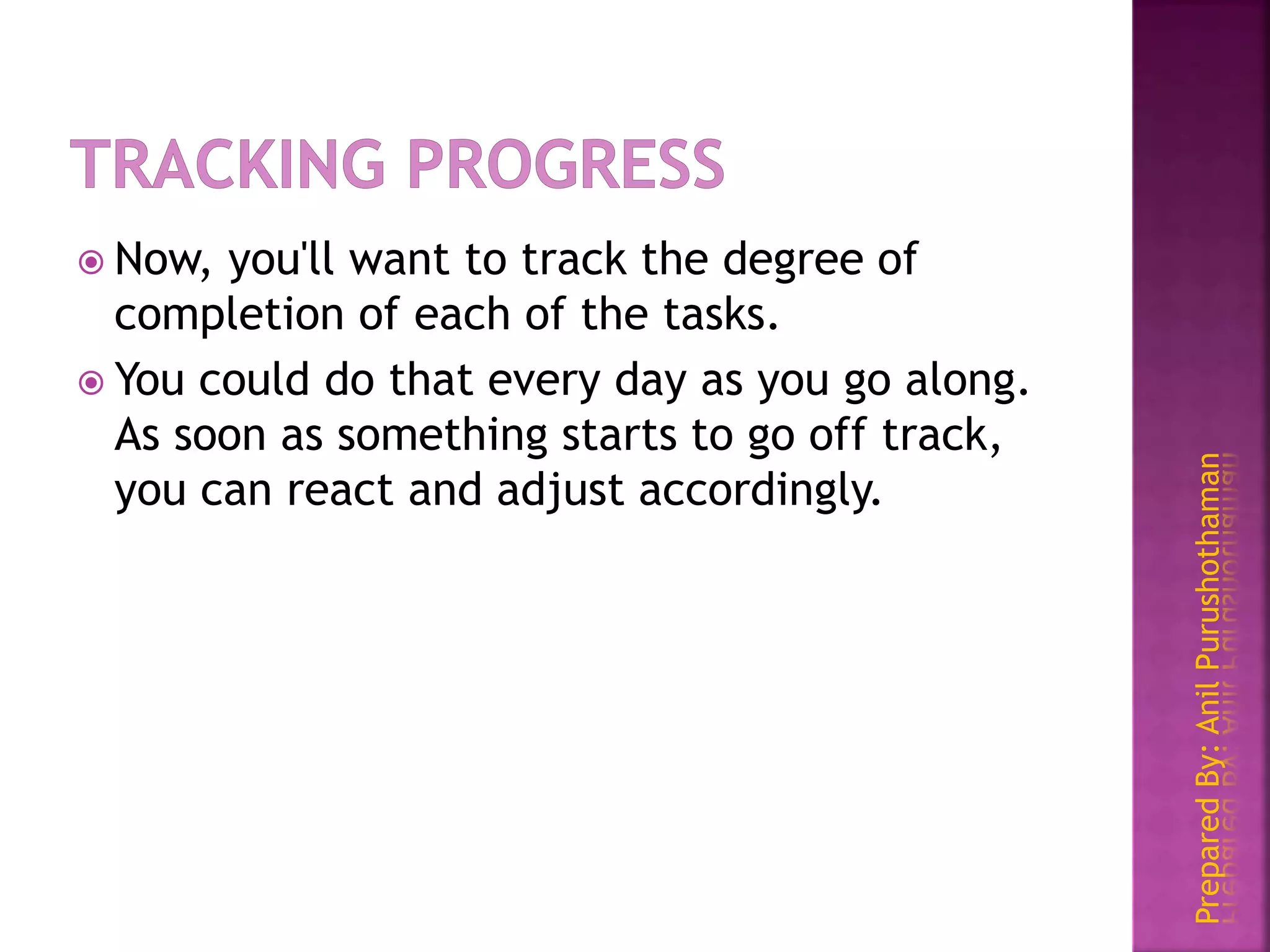

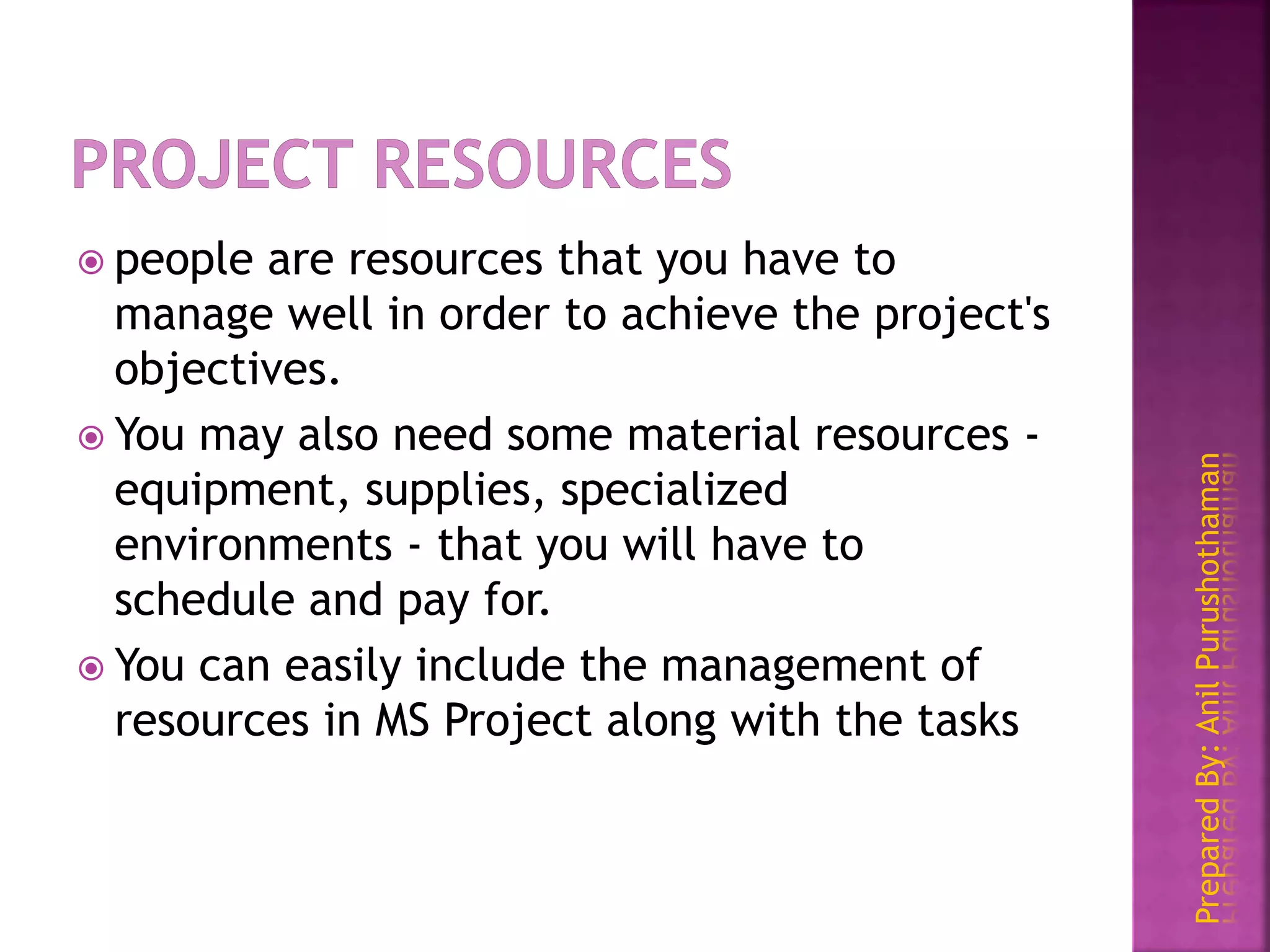

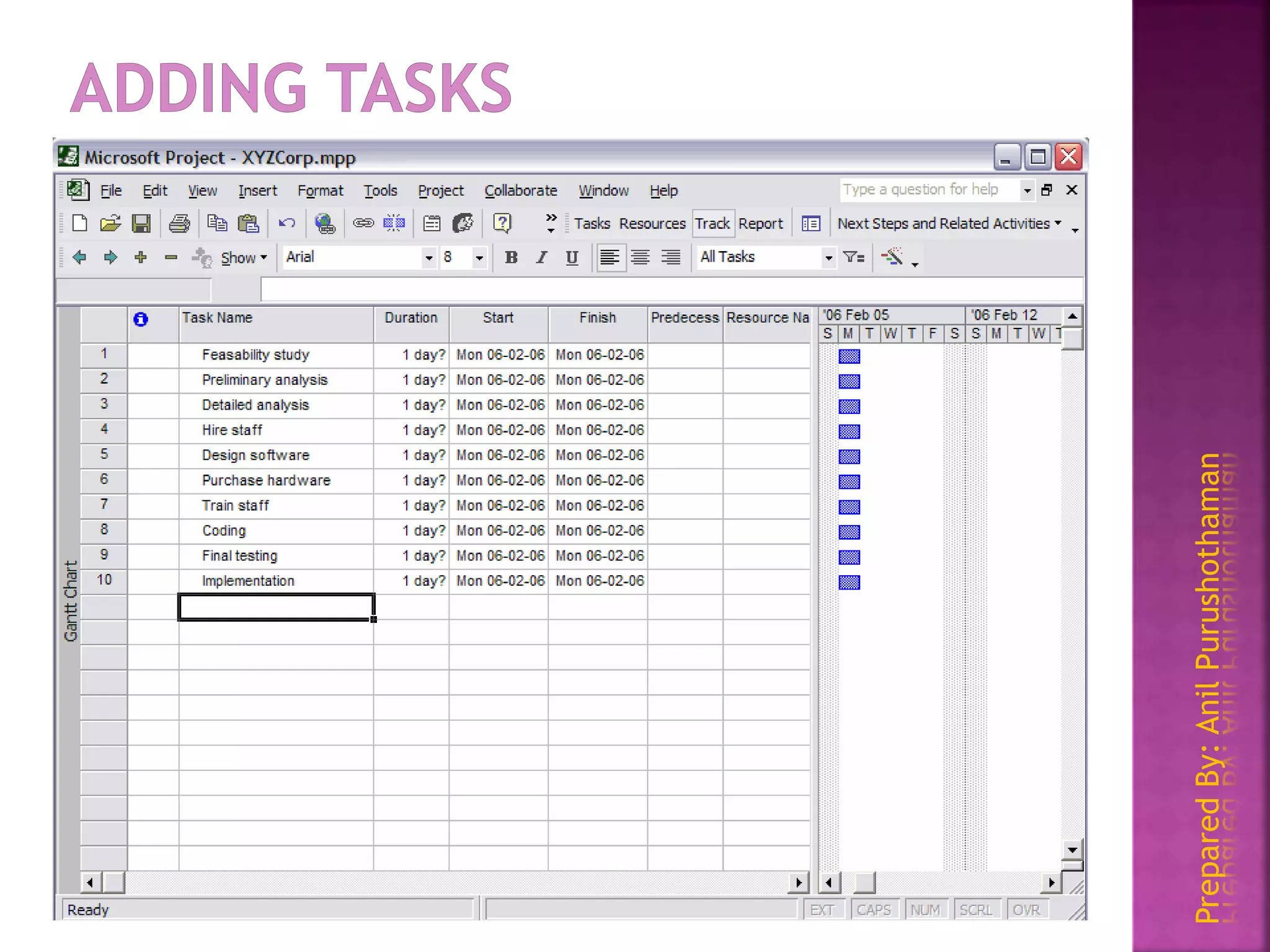

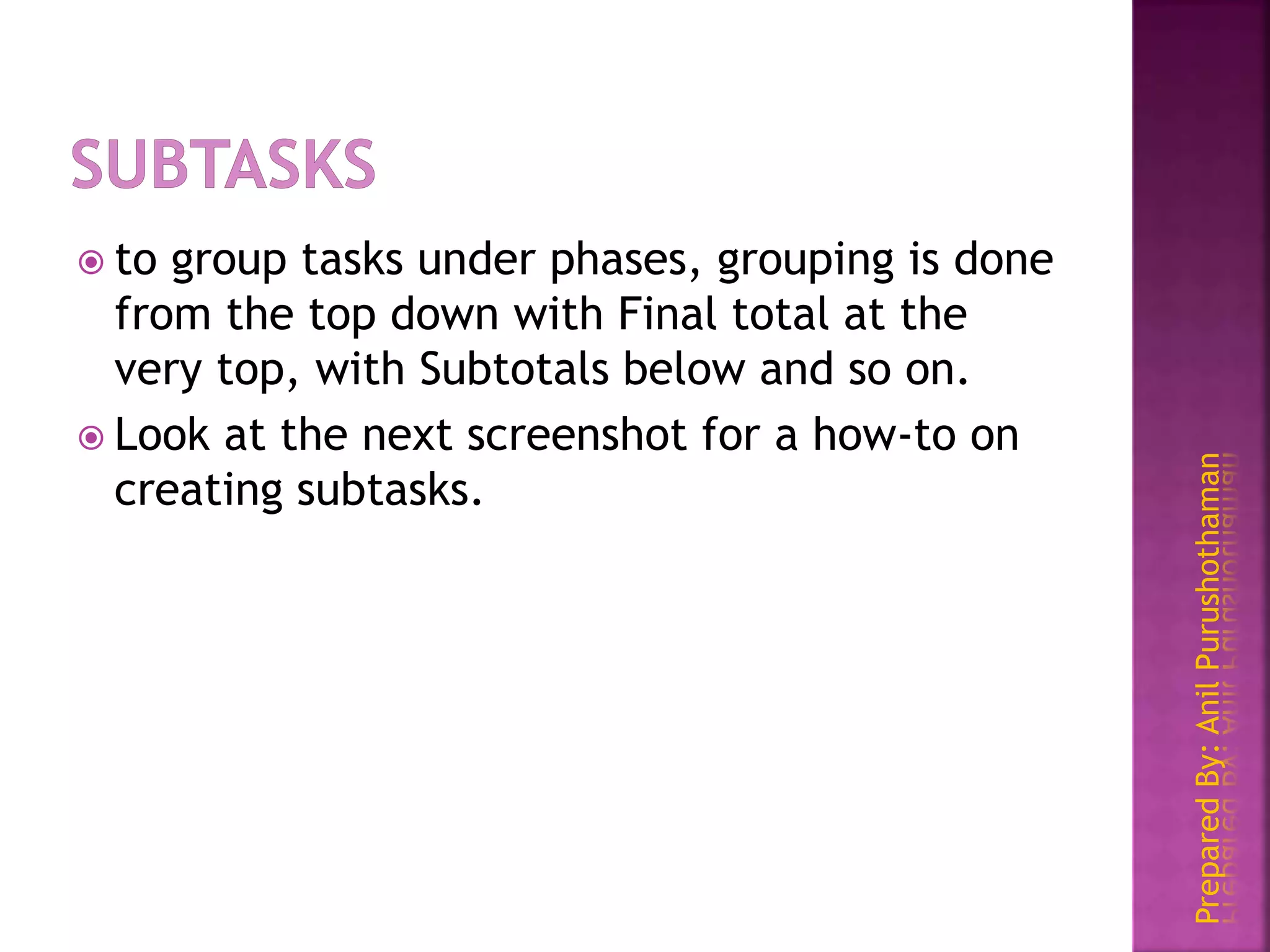

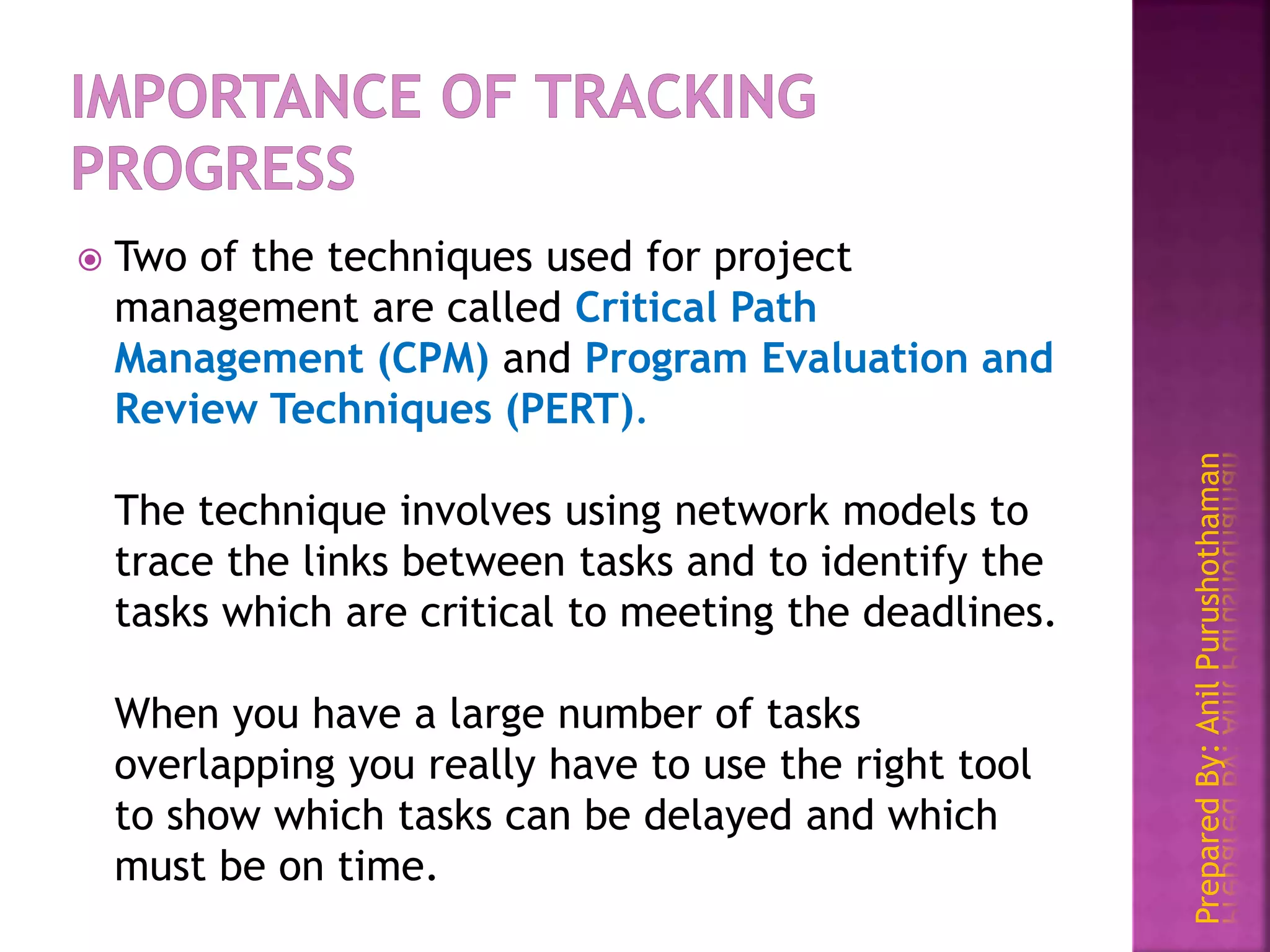

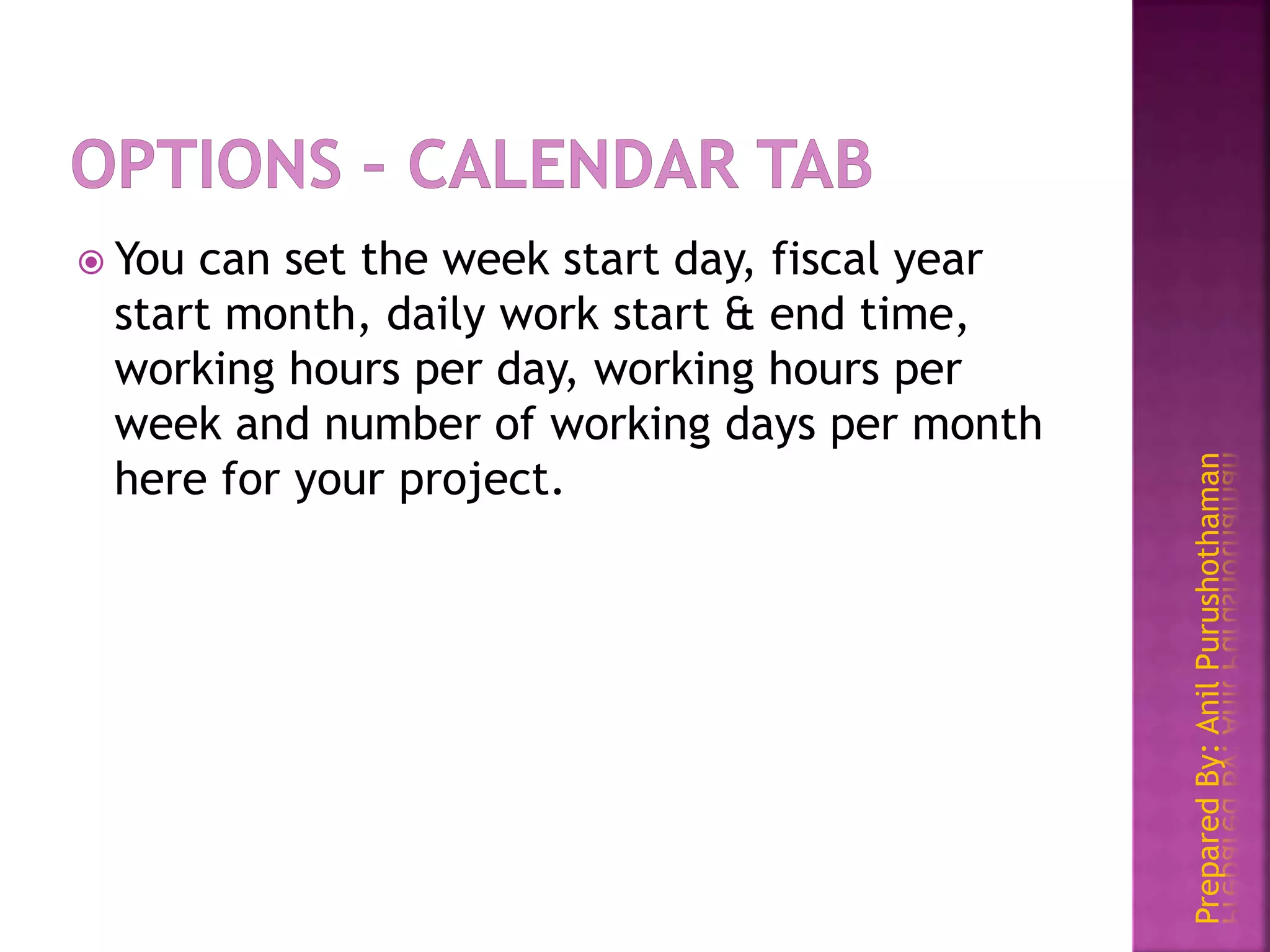

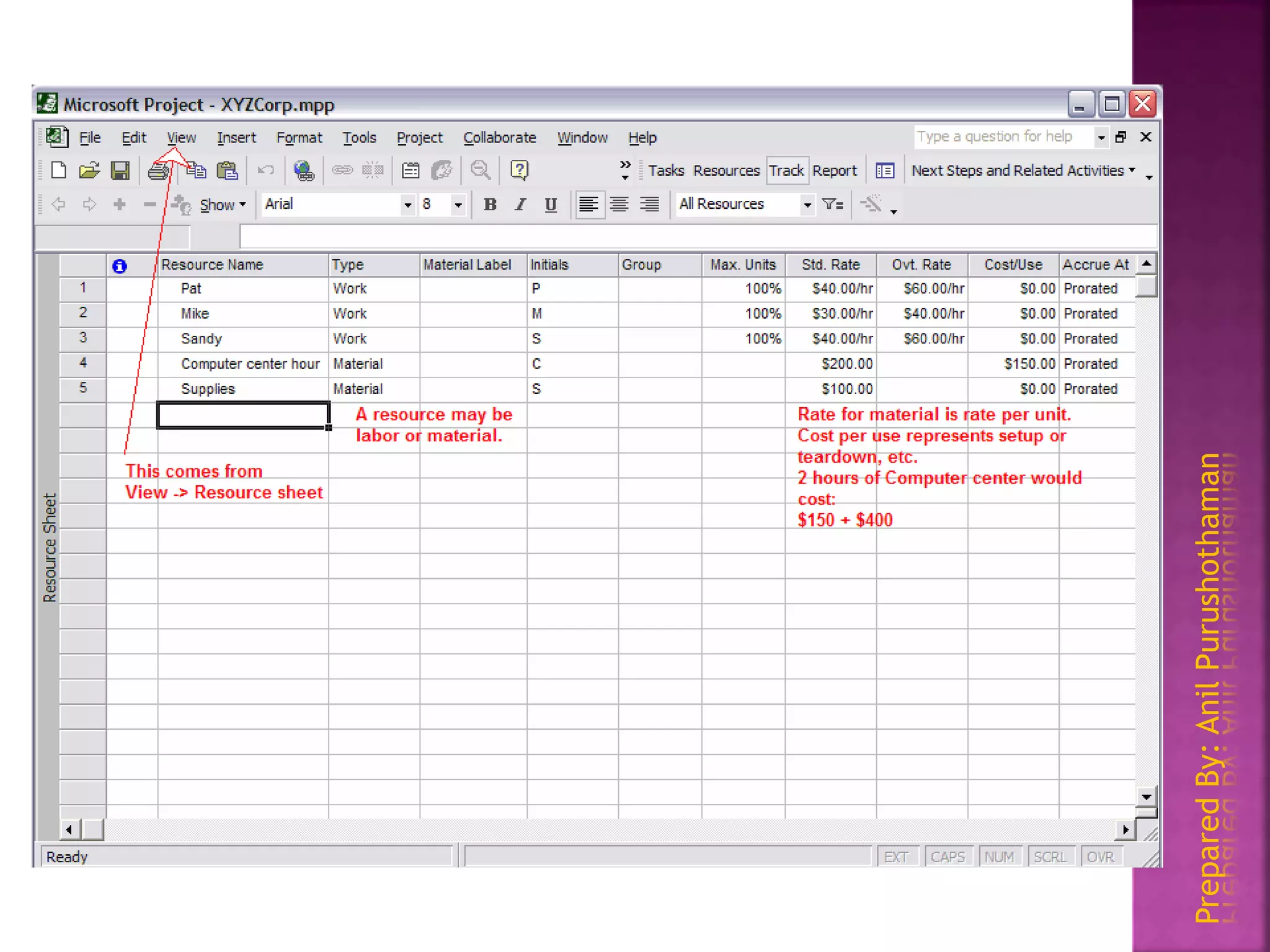

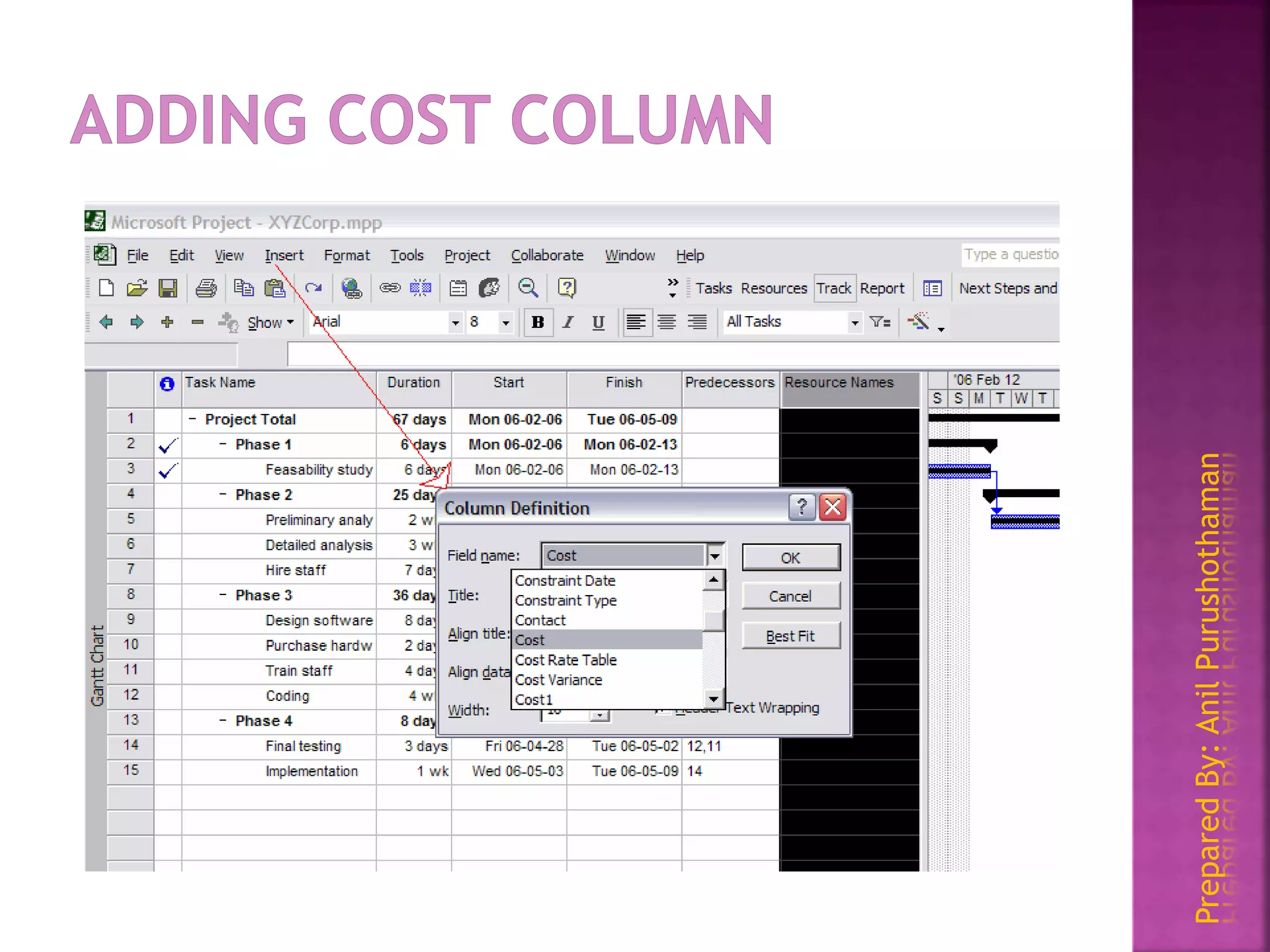

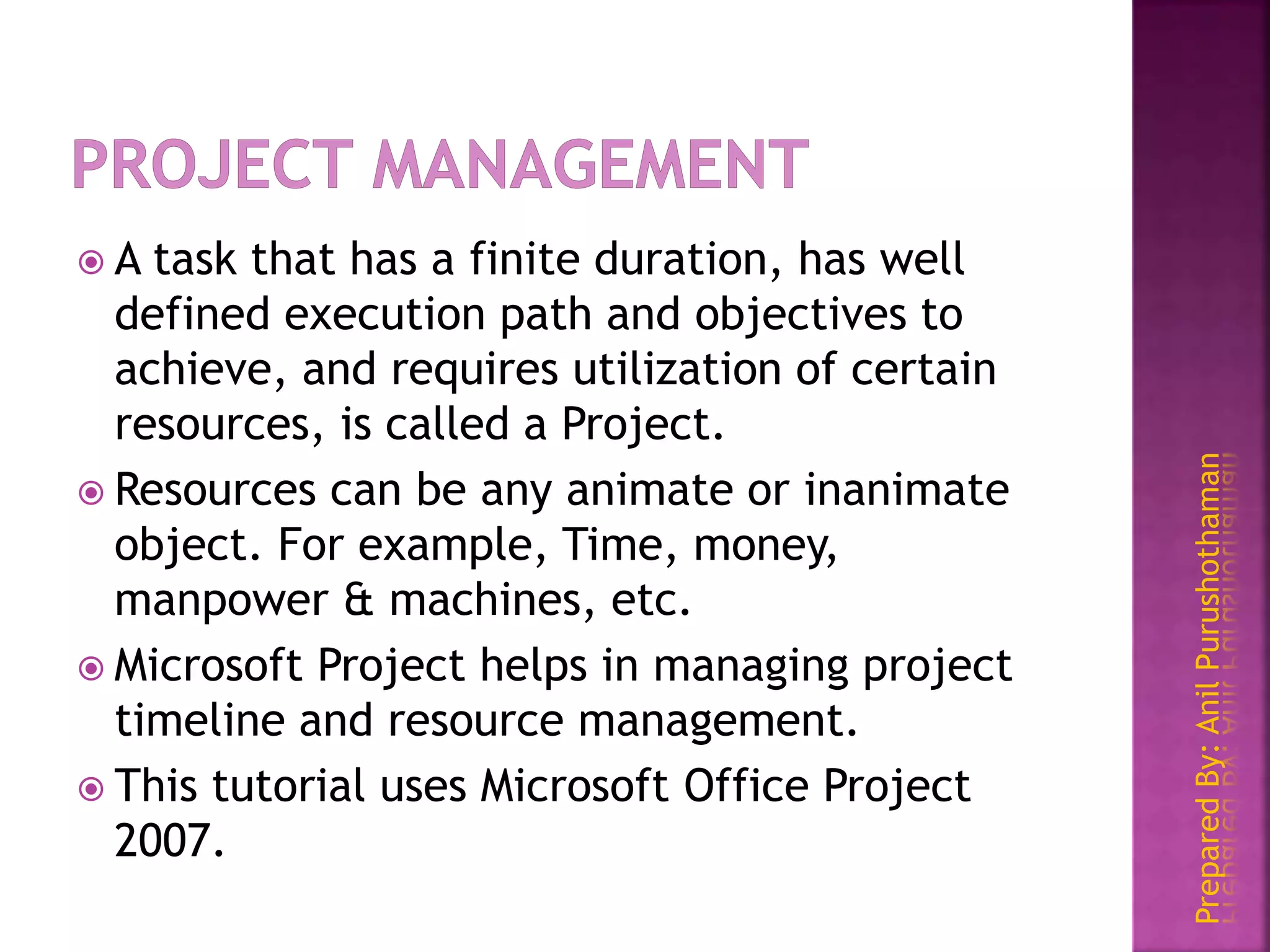

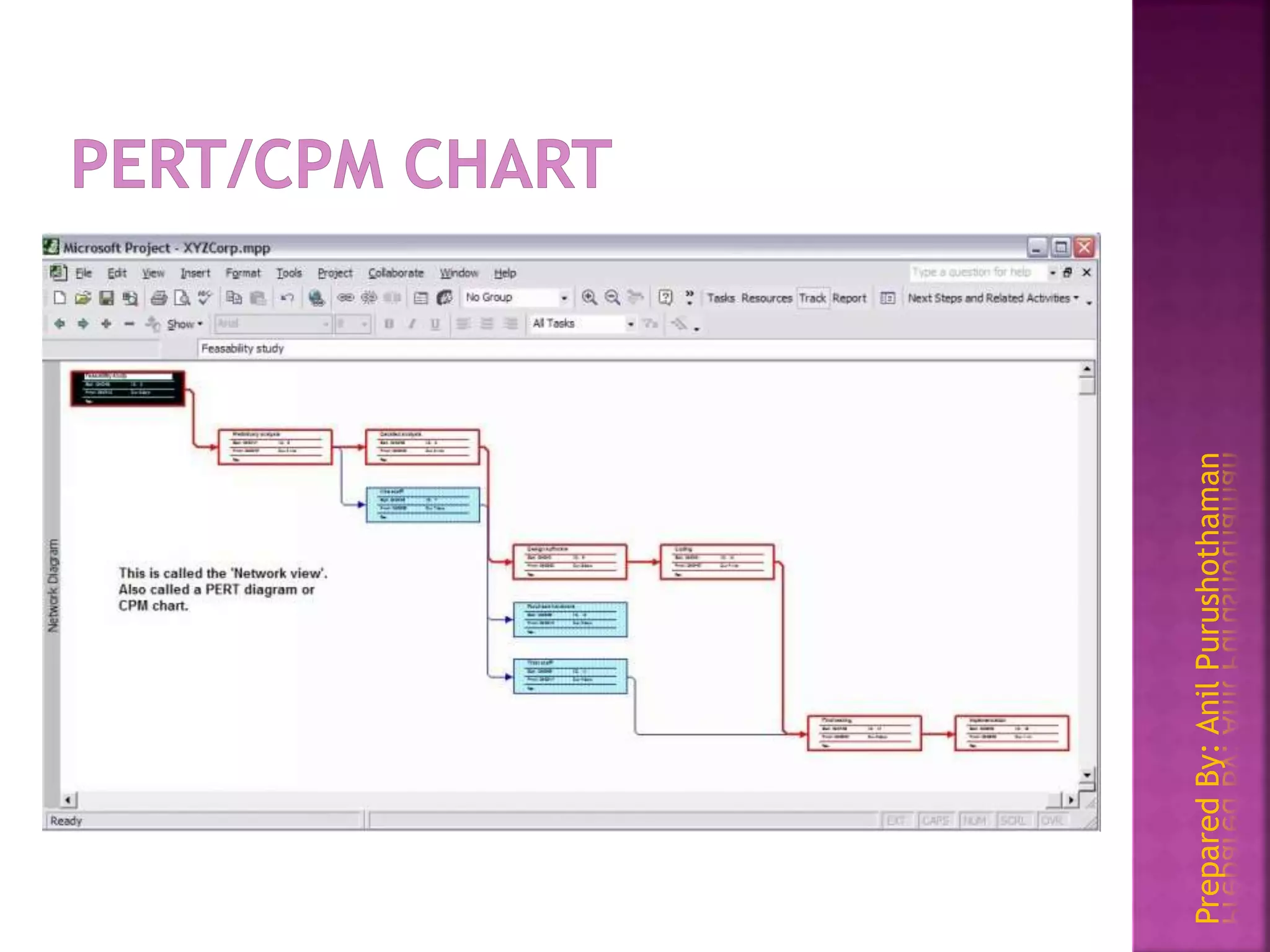

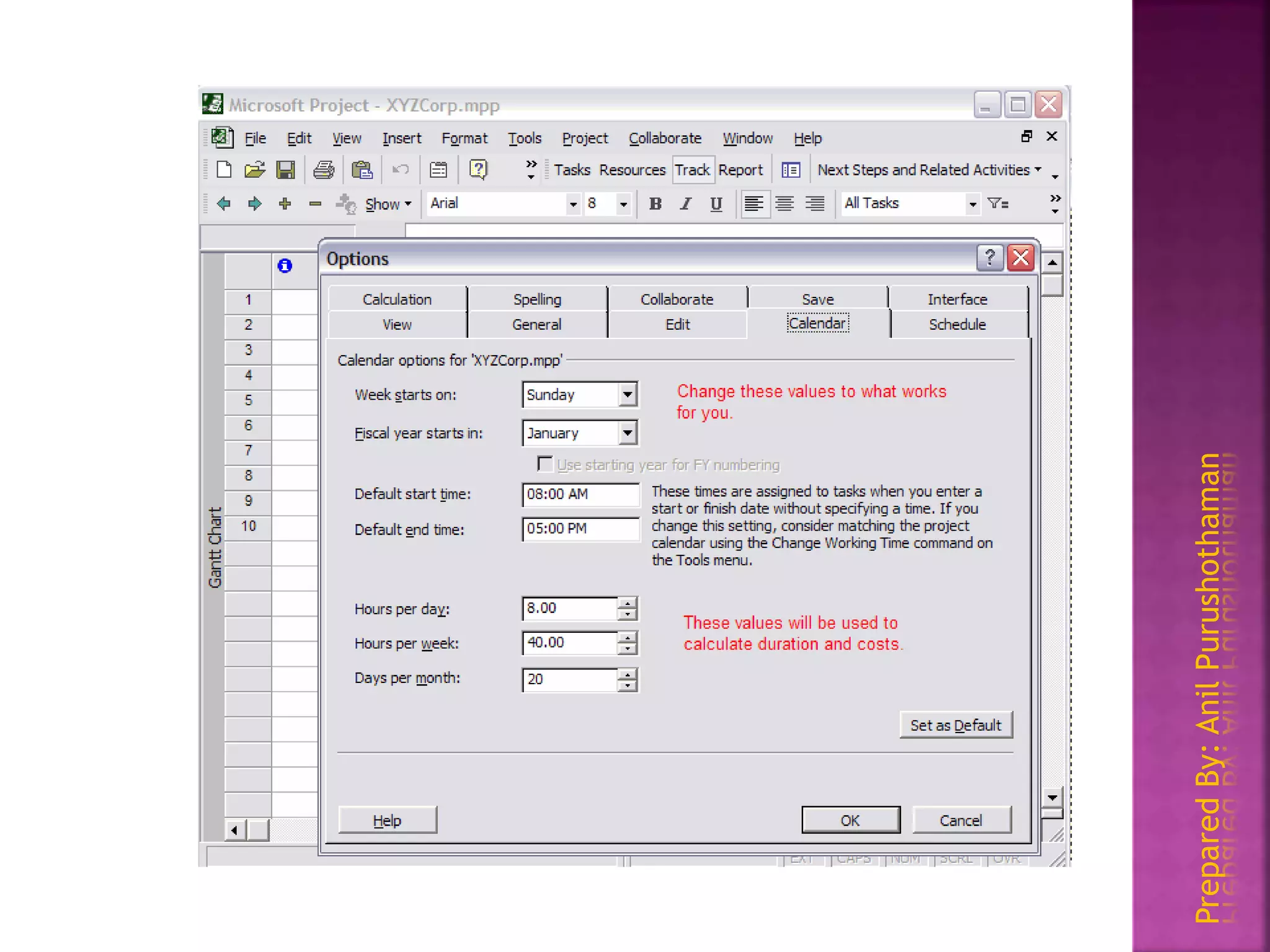

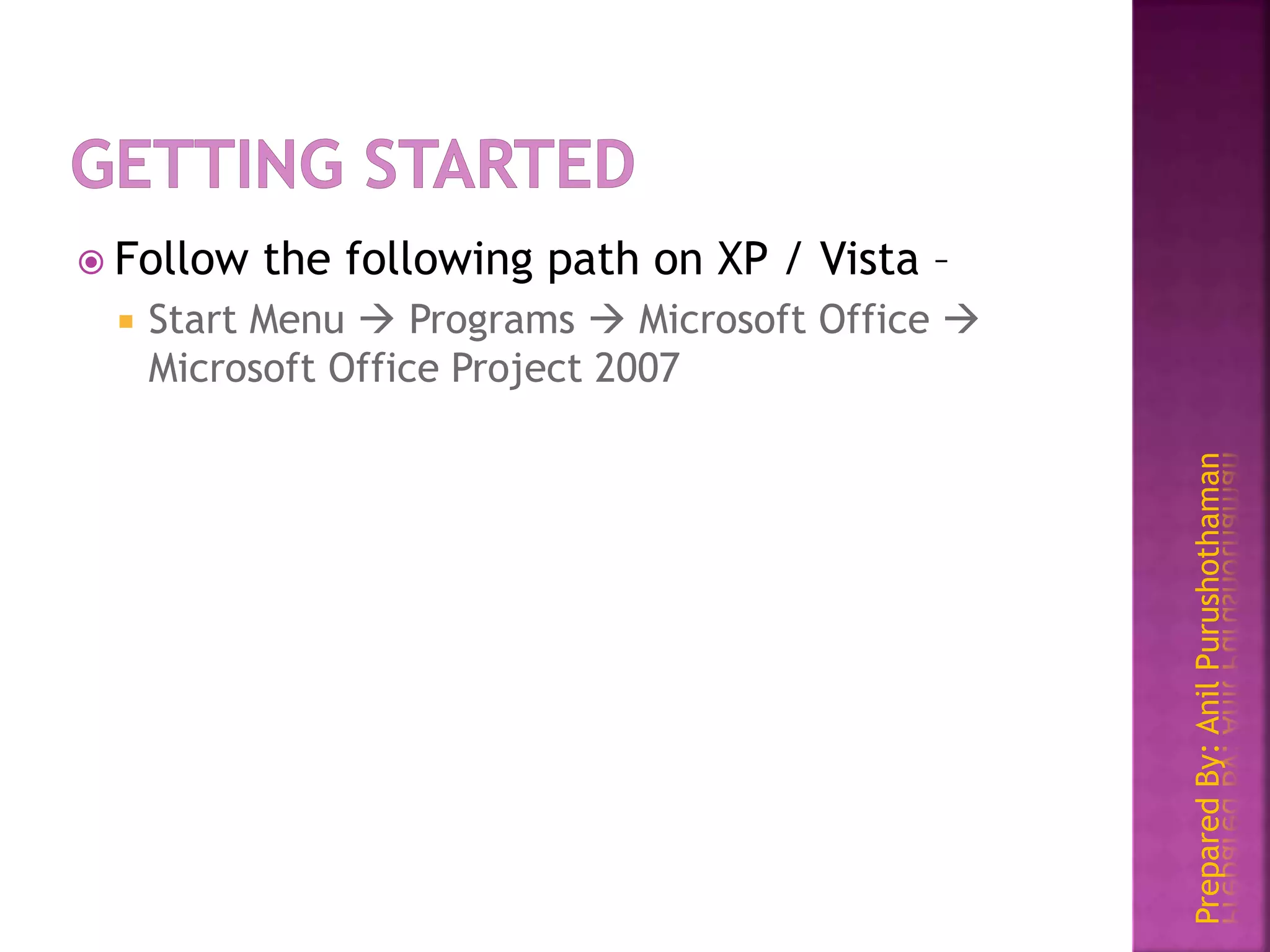

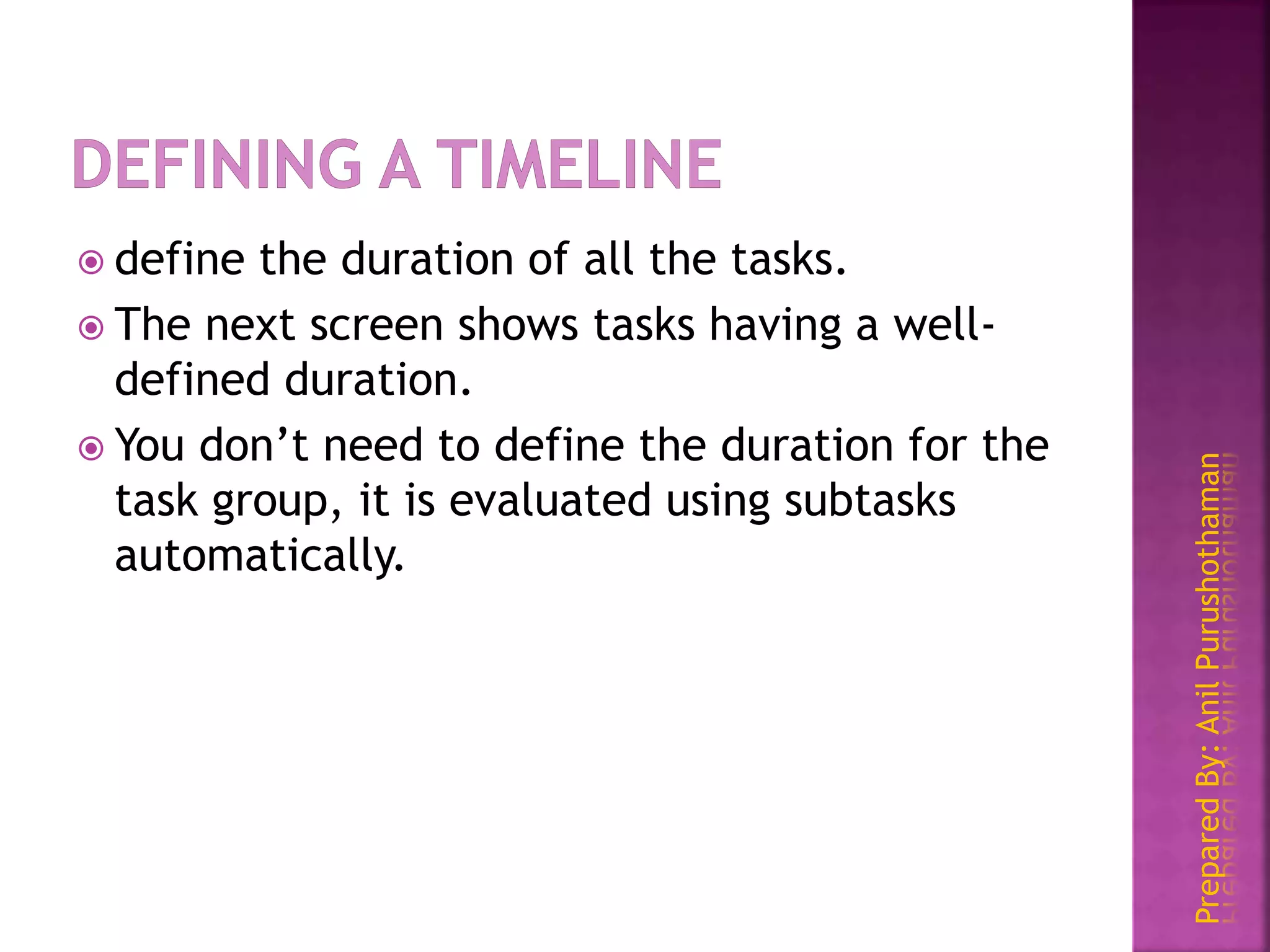

This document provides an overview of how to use Microsoft Project to plan and track a project. It discusses defining the project properties including the start date. It describes adding tasks, durations, predecessors and grouping tasks. It explains identifying and tracking the critical path. Finally, it covers managing resources by identifying available resources, assigning them to tasks, and tracking costs. The overall document serves as a tutorial for using Microsoft Project to manage all aspects of a project from initial planning through ongoing tracking.
