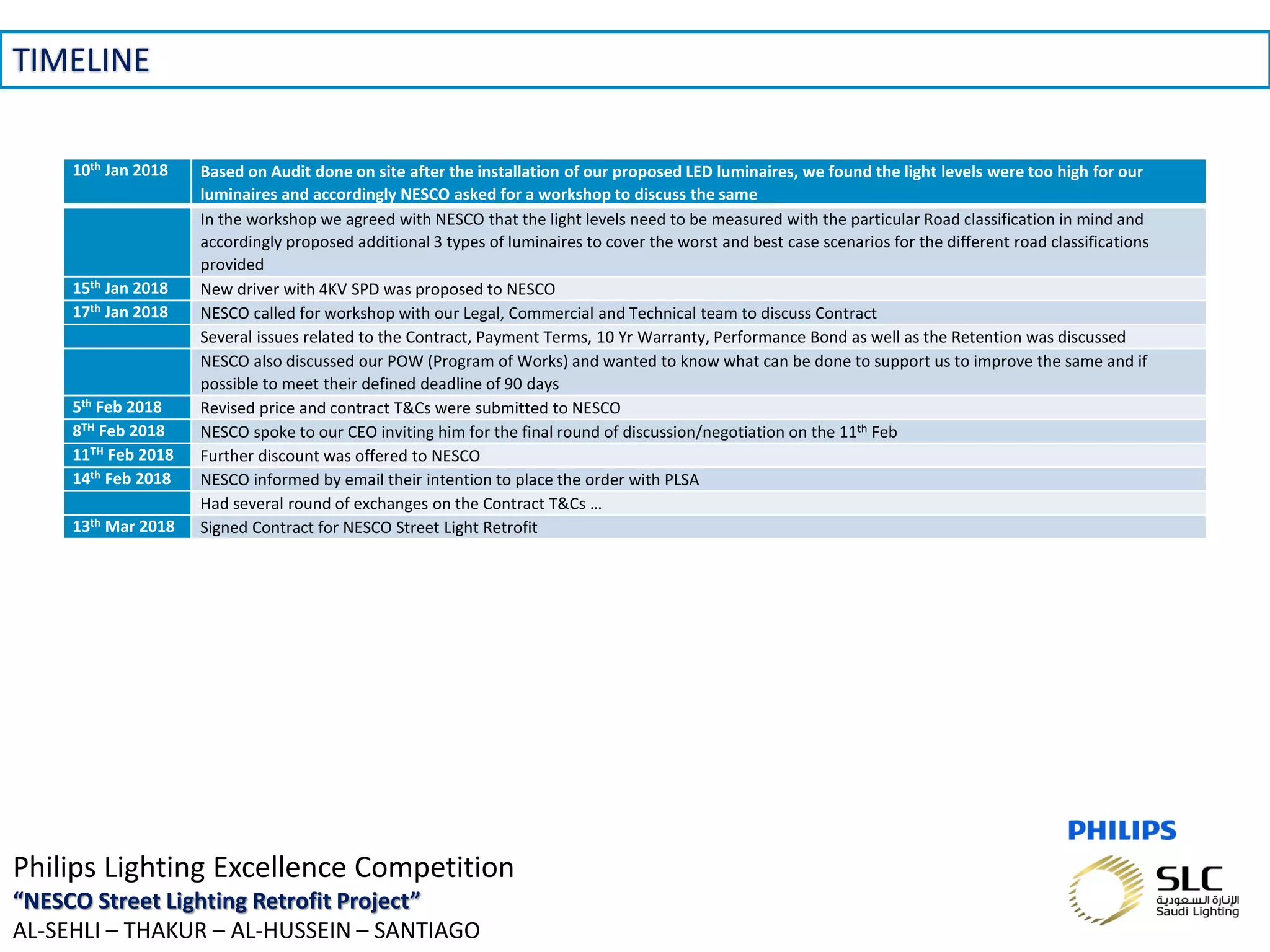

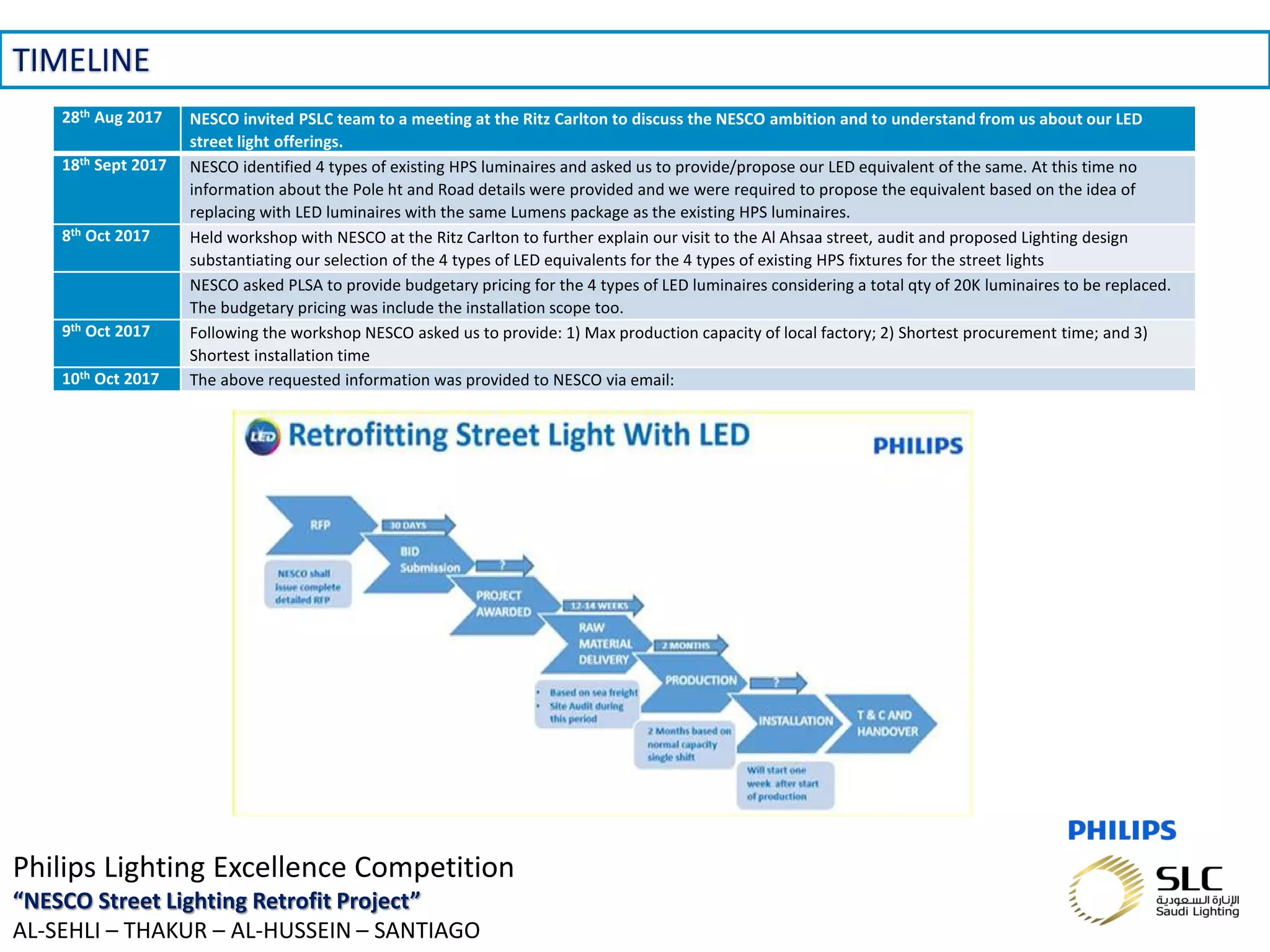

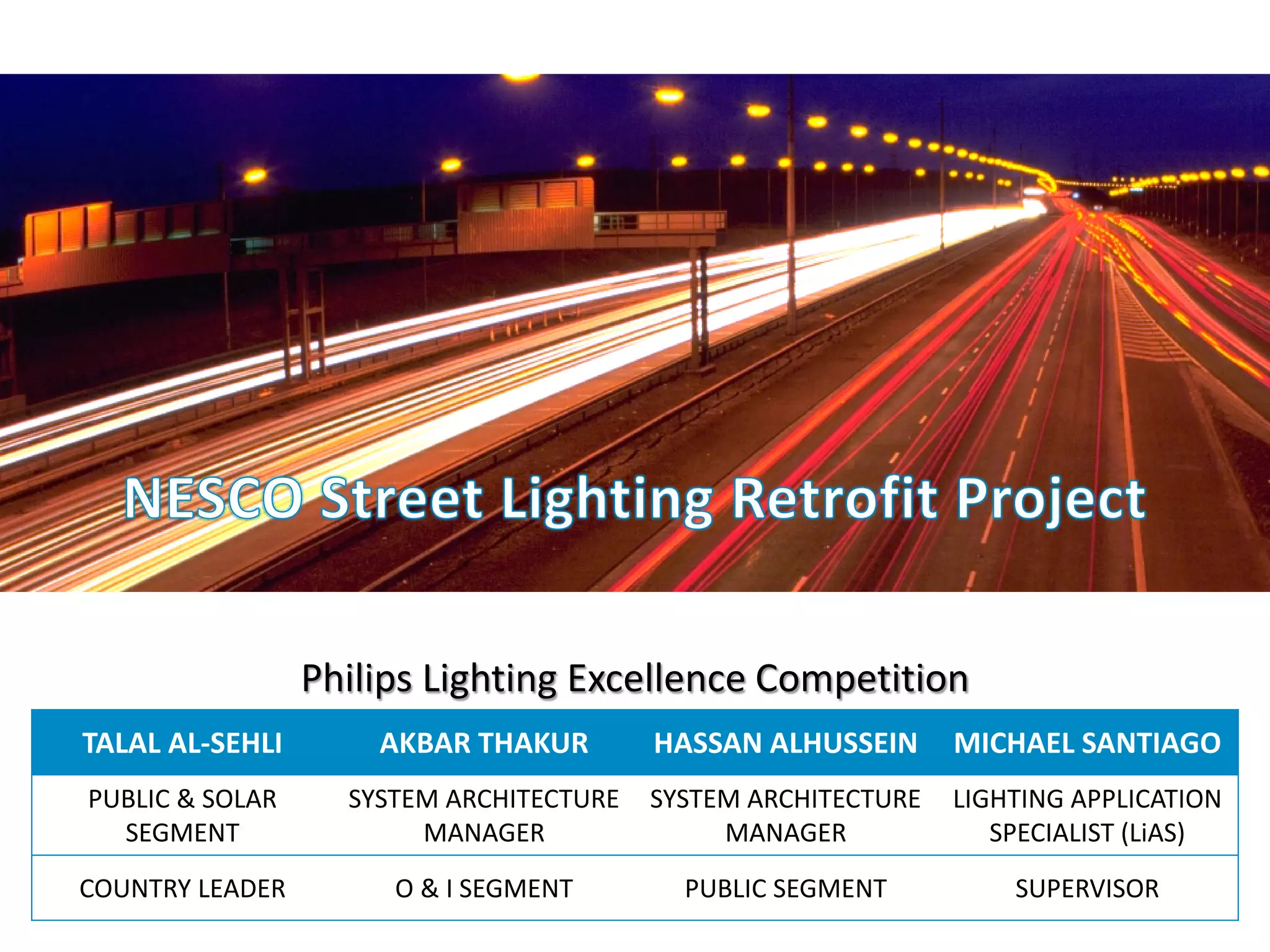

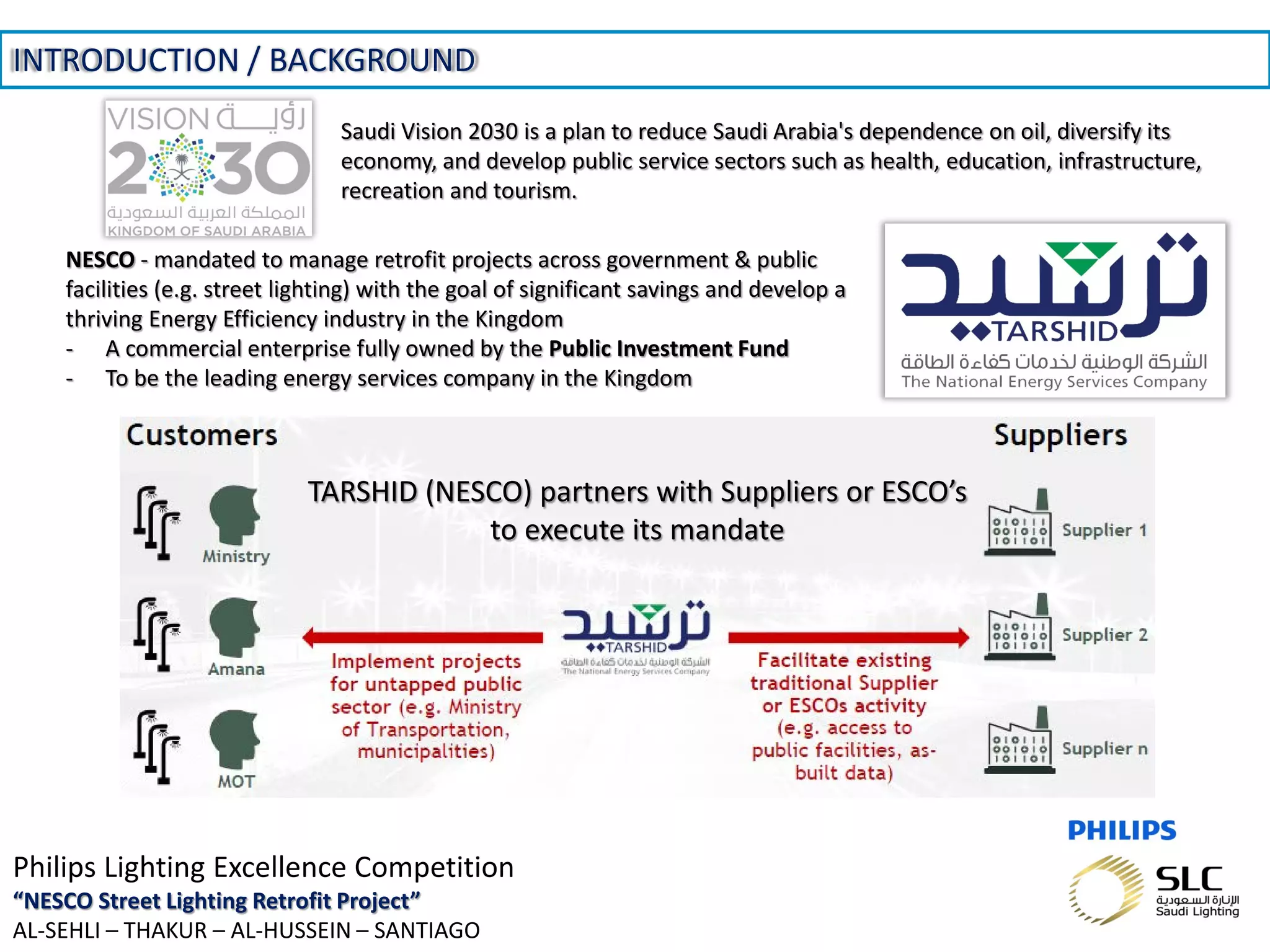

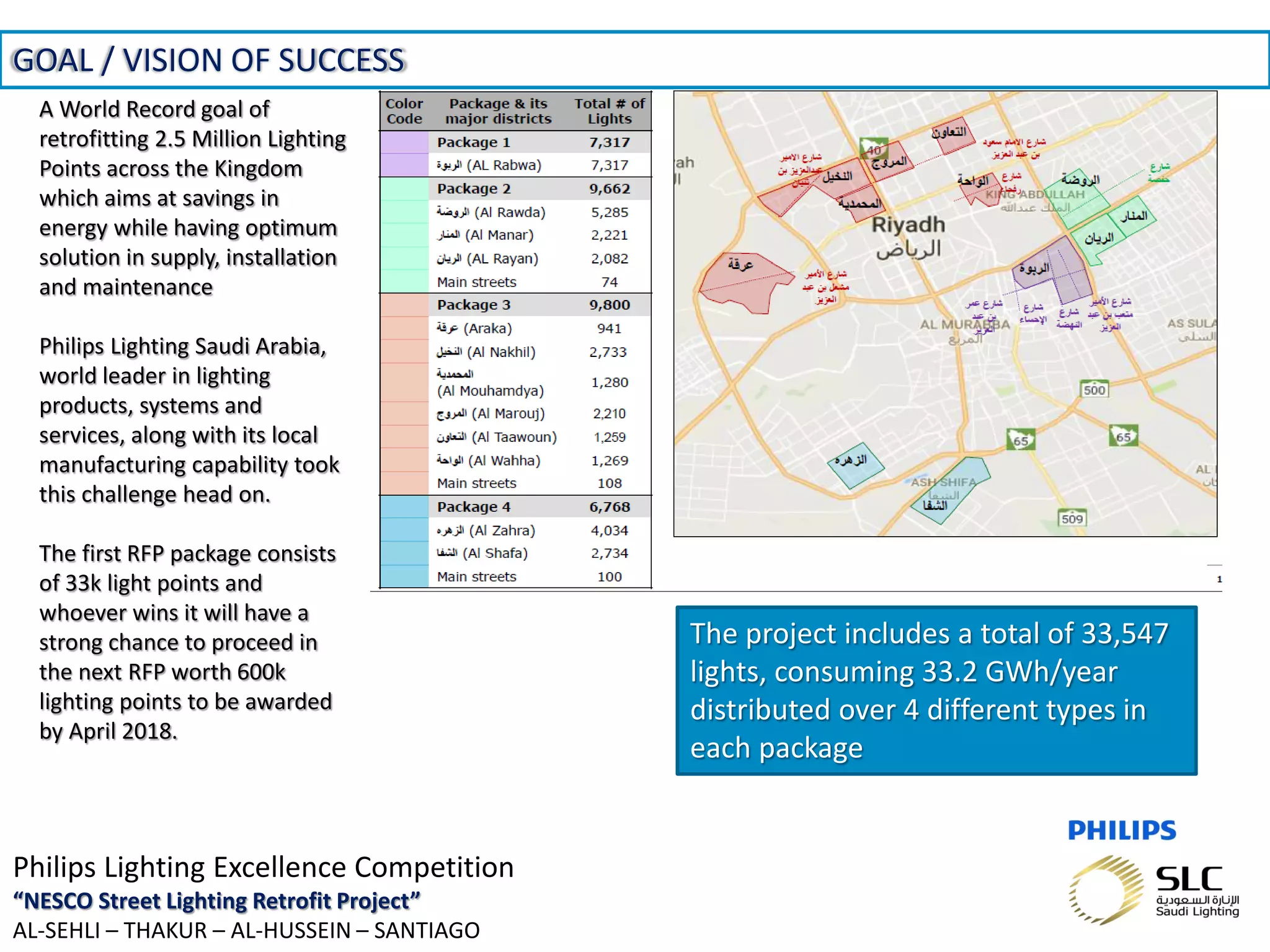

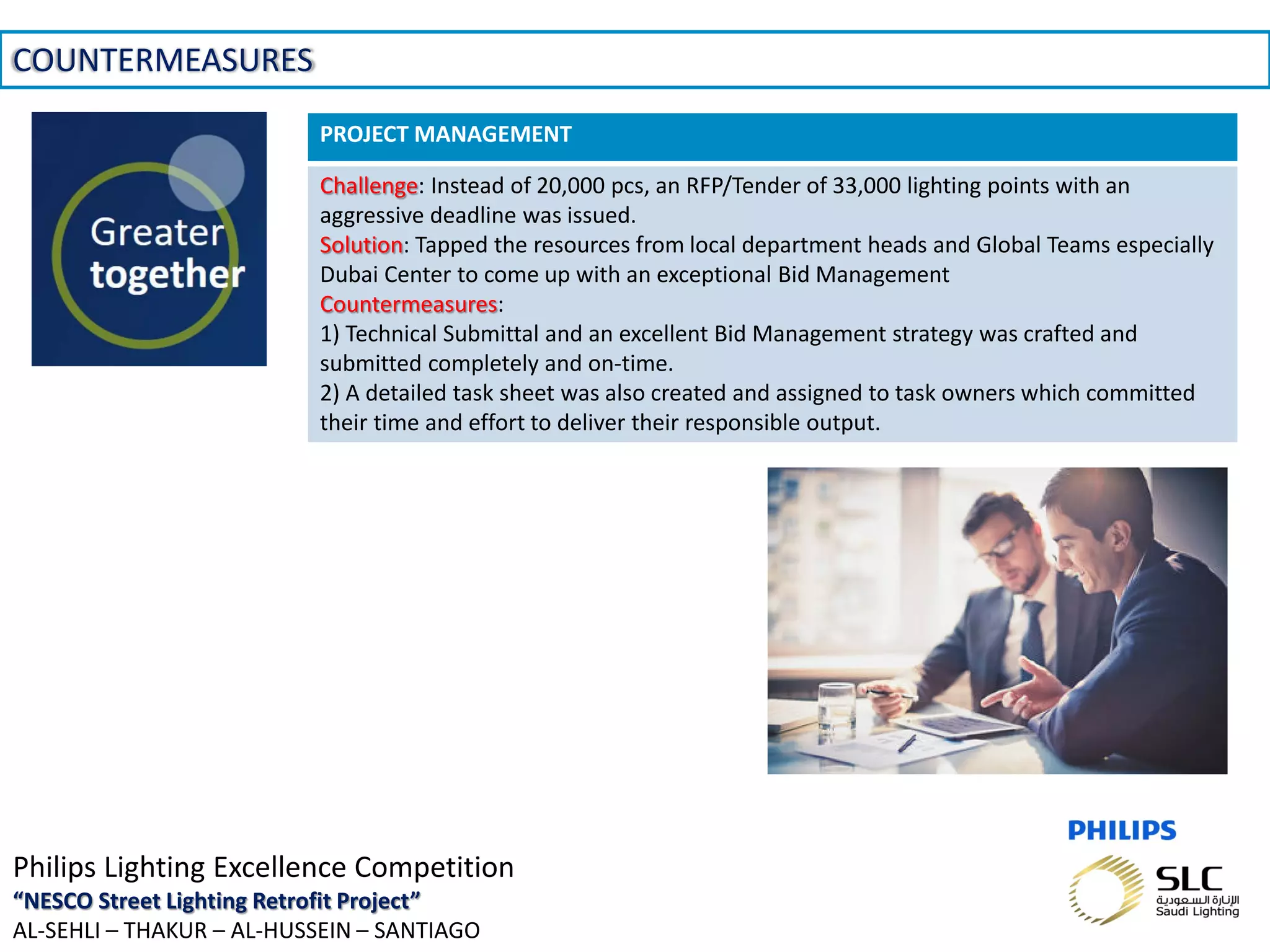

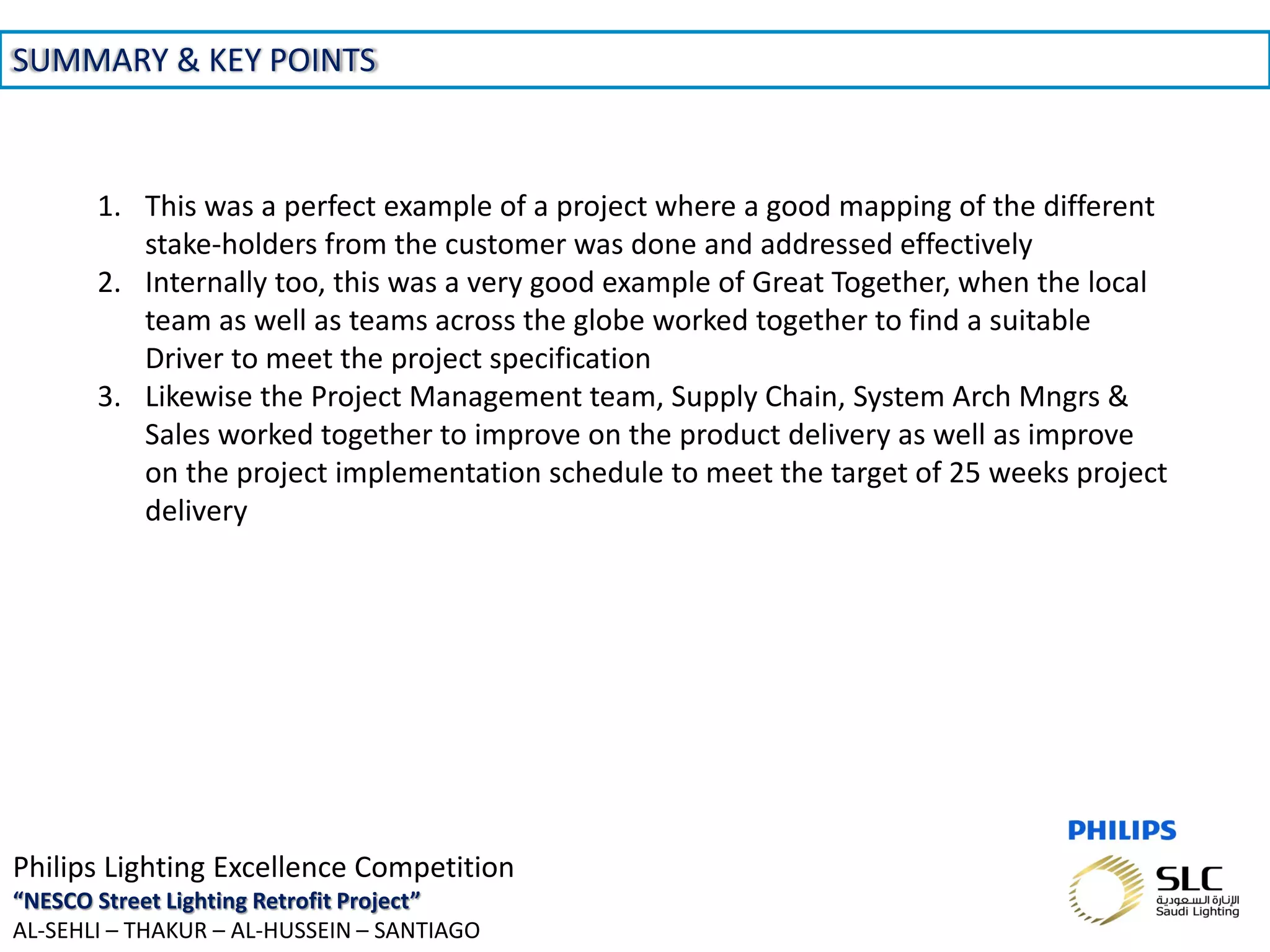

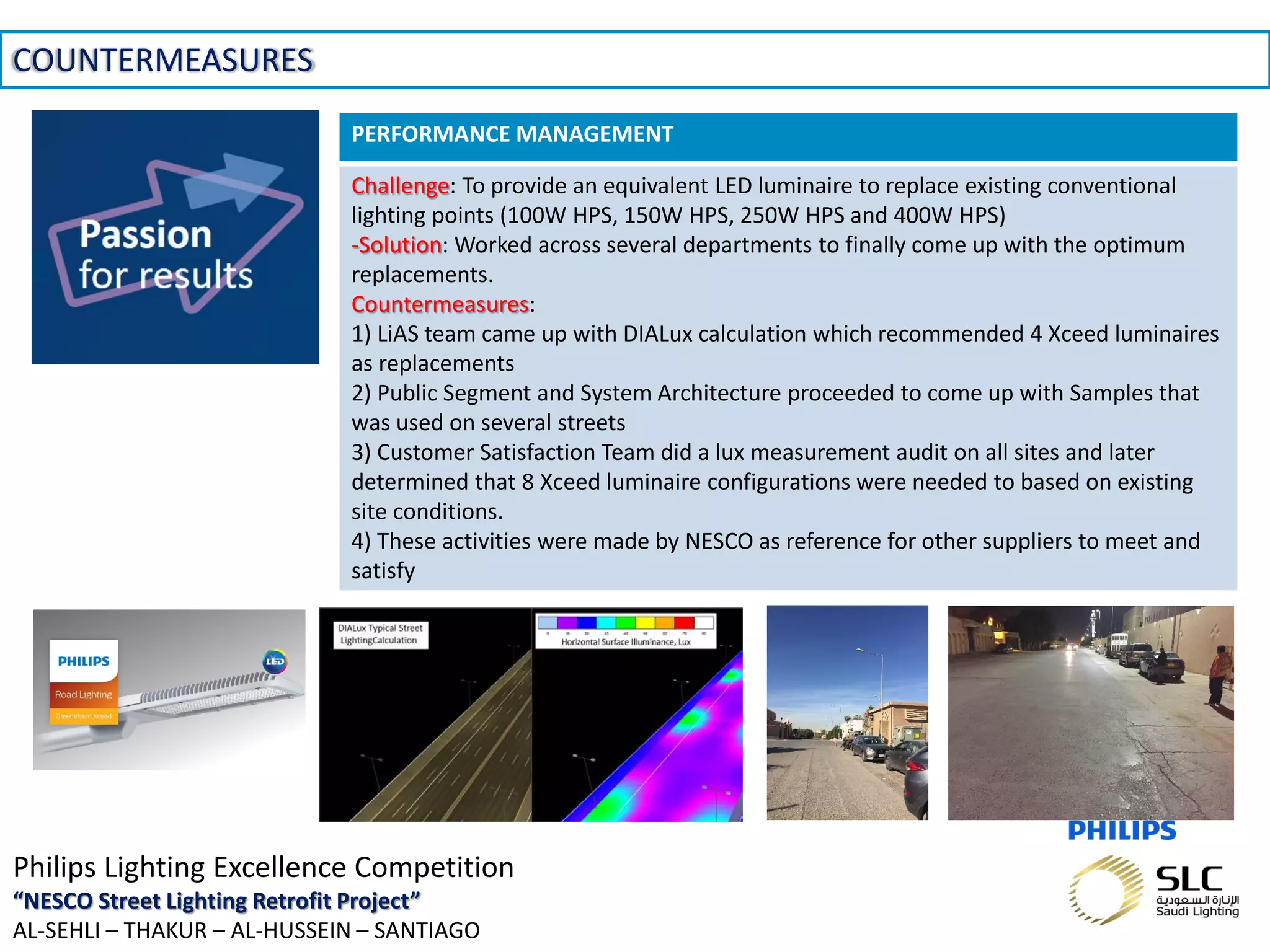

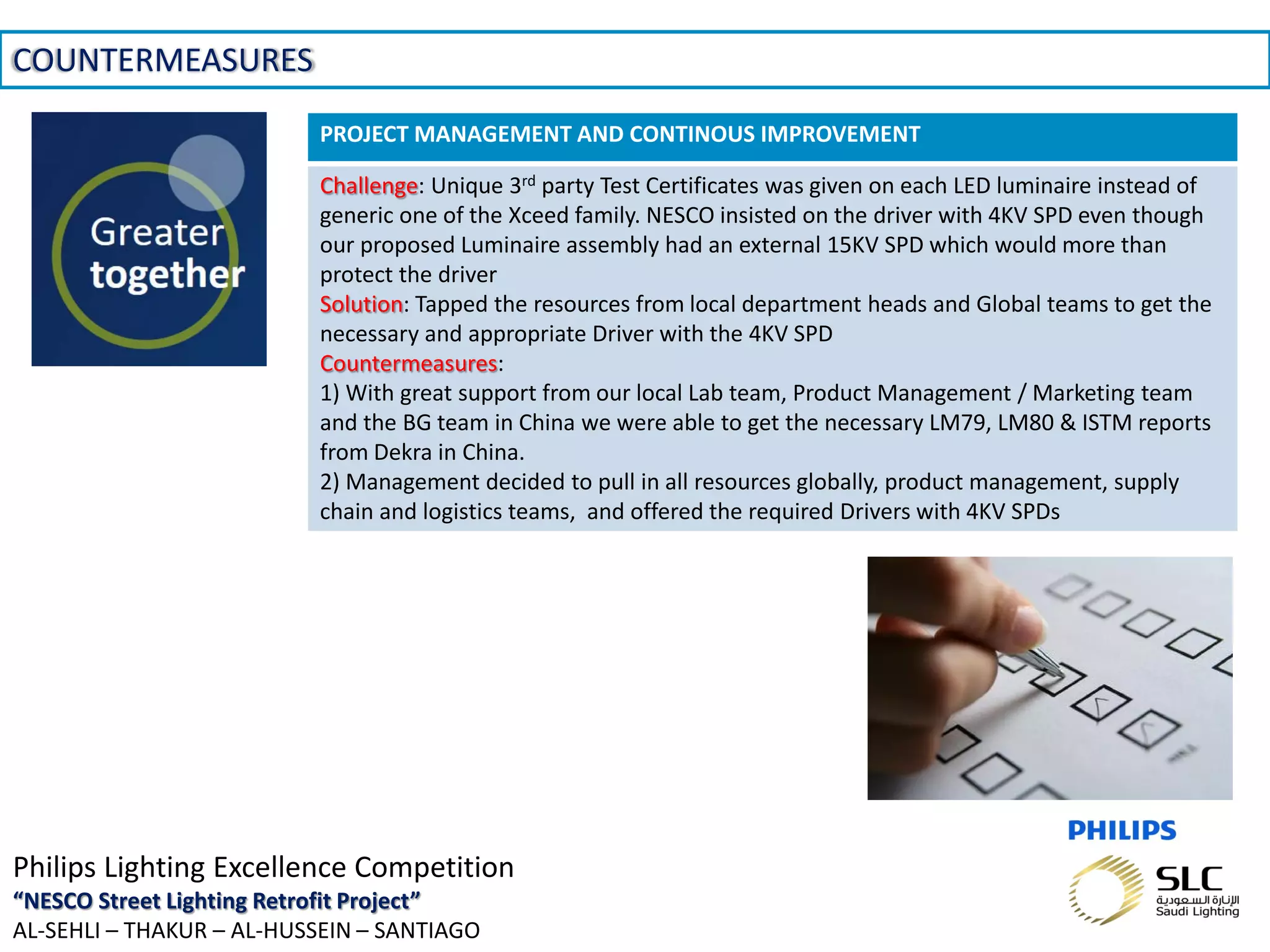

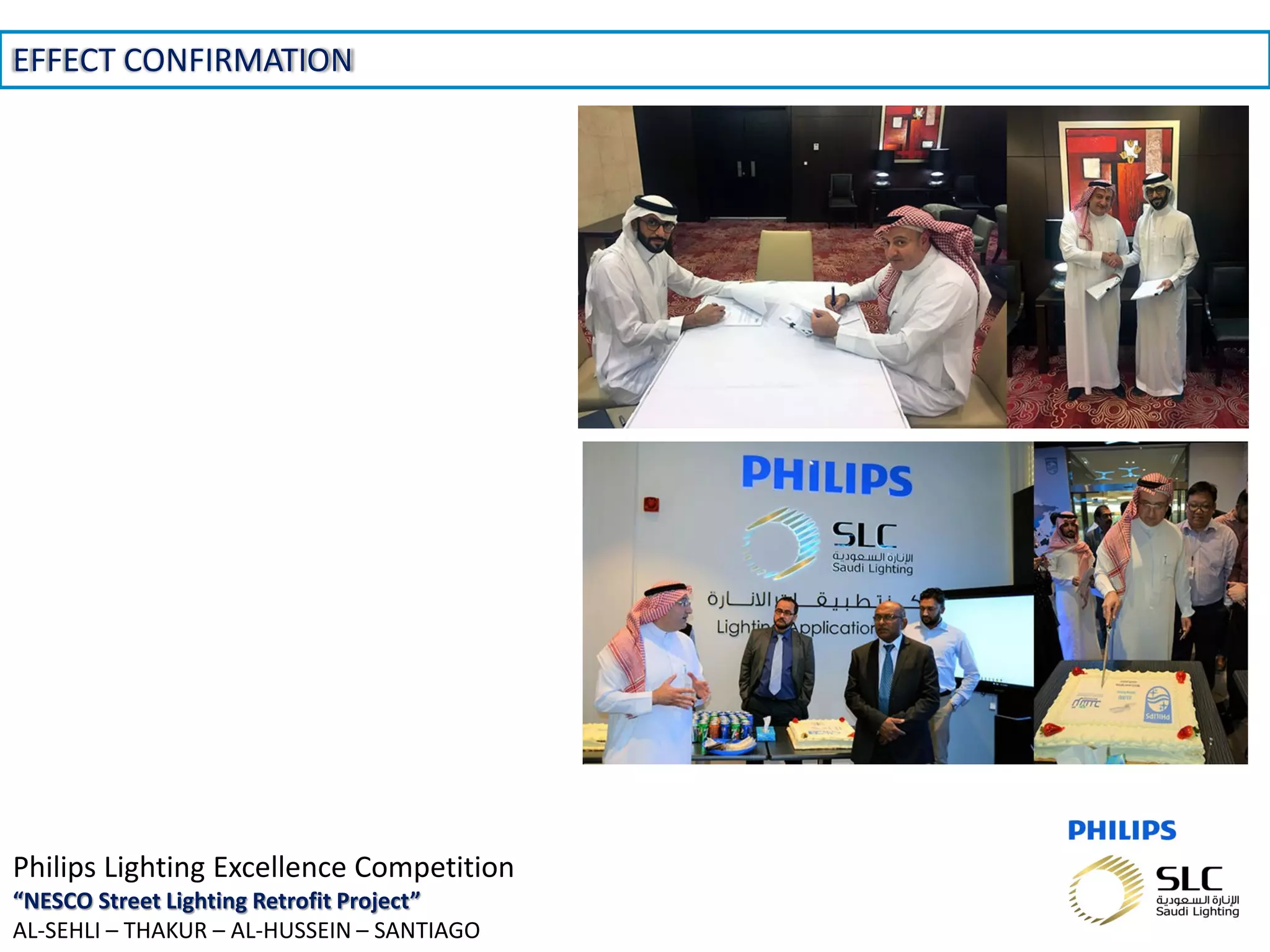

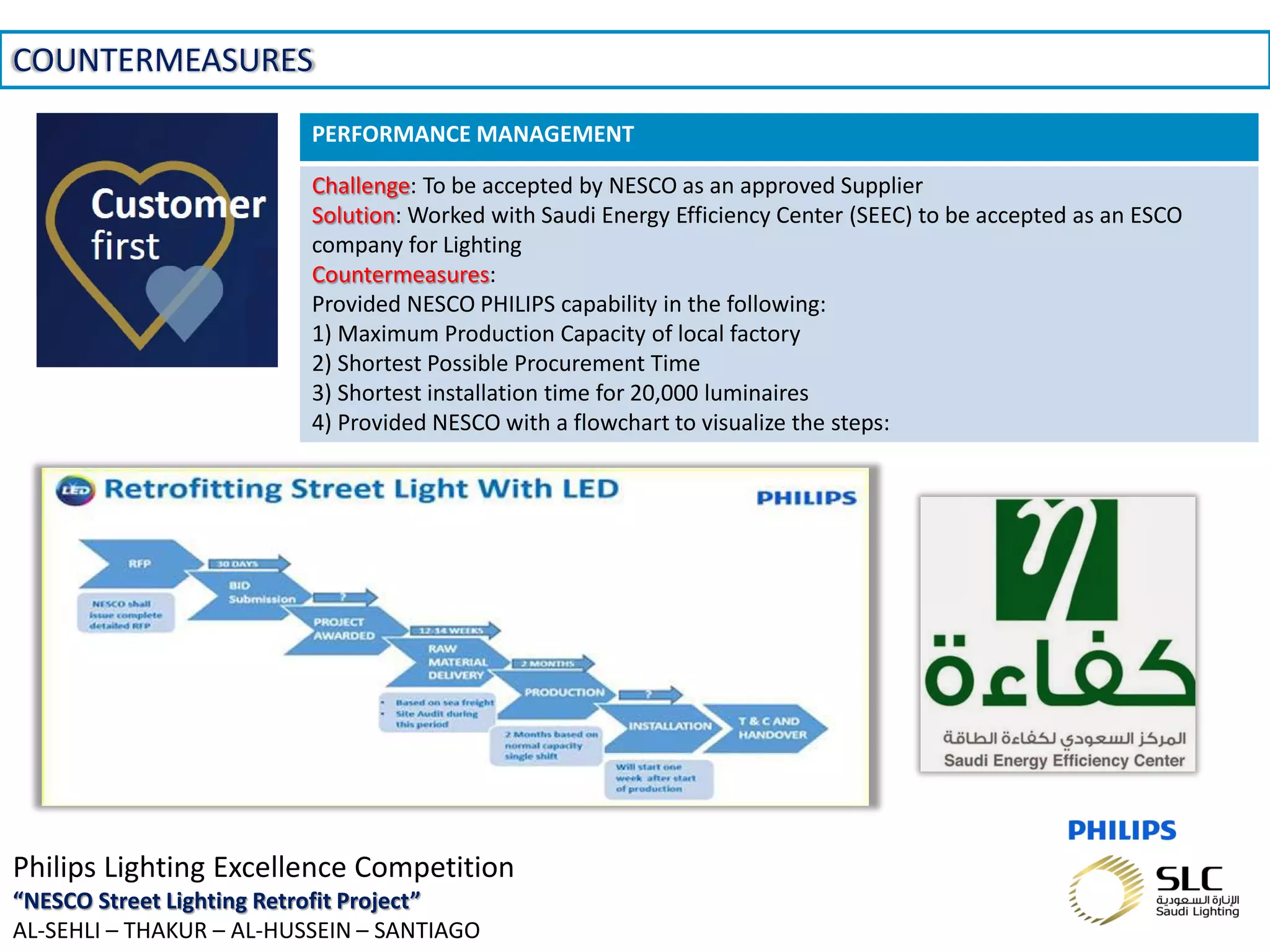

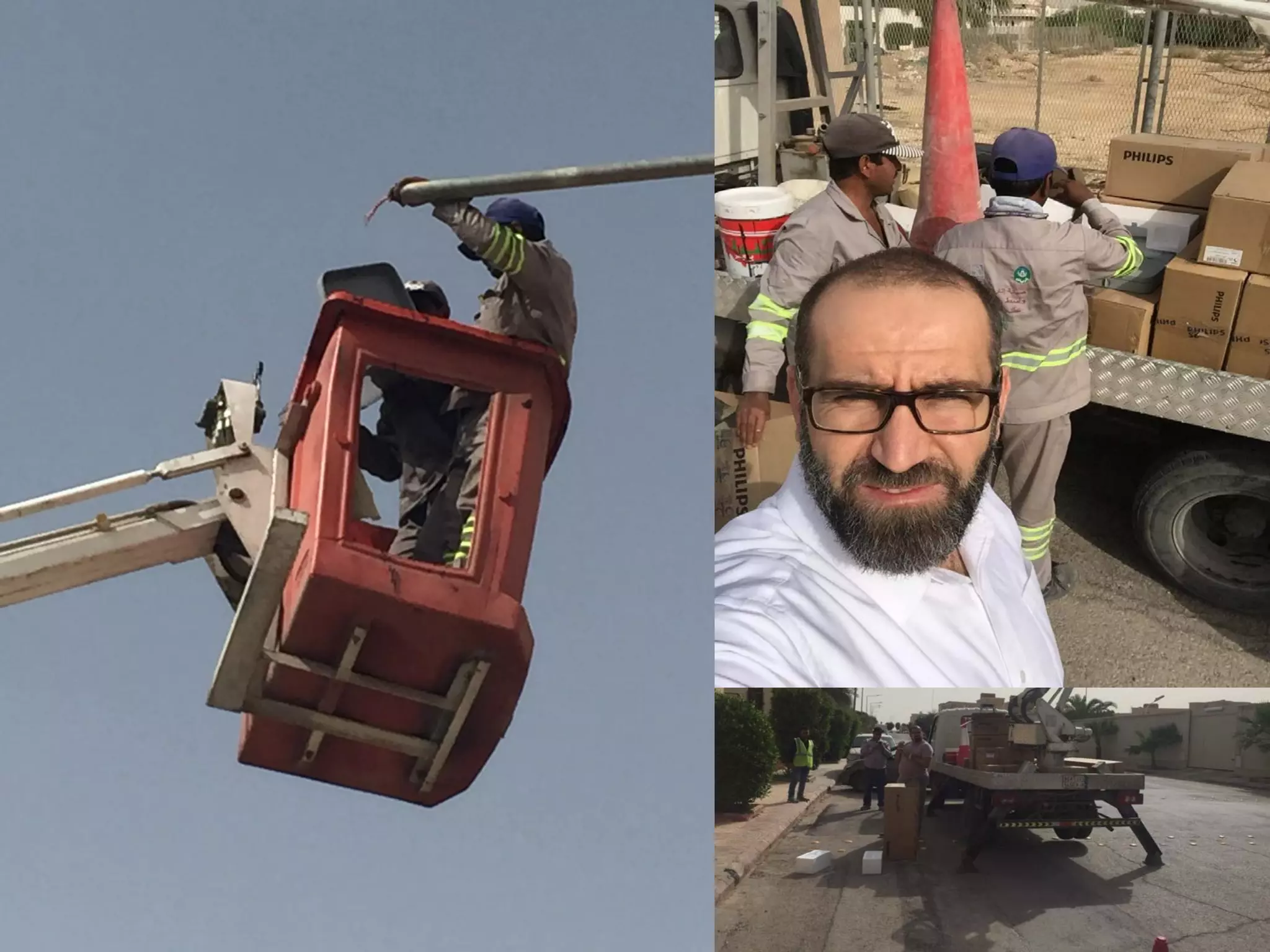

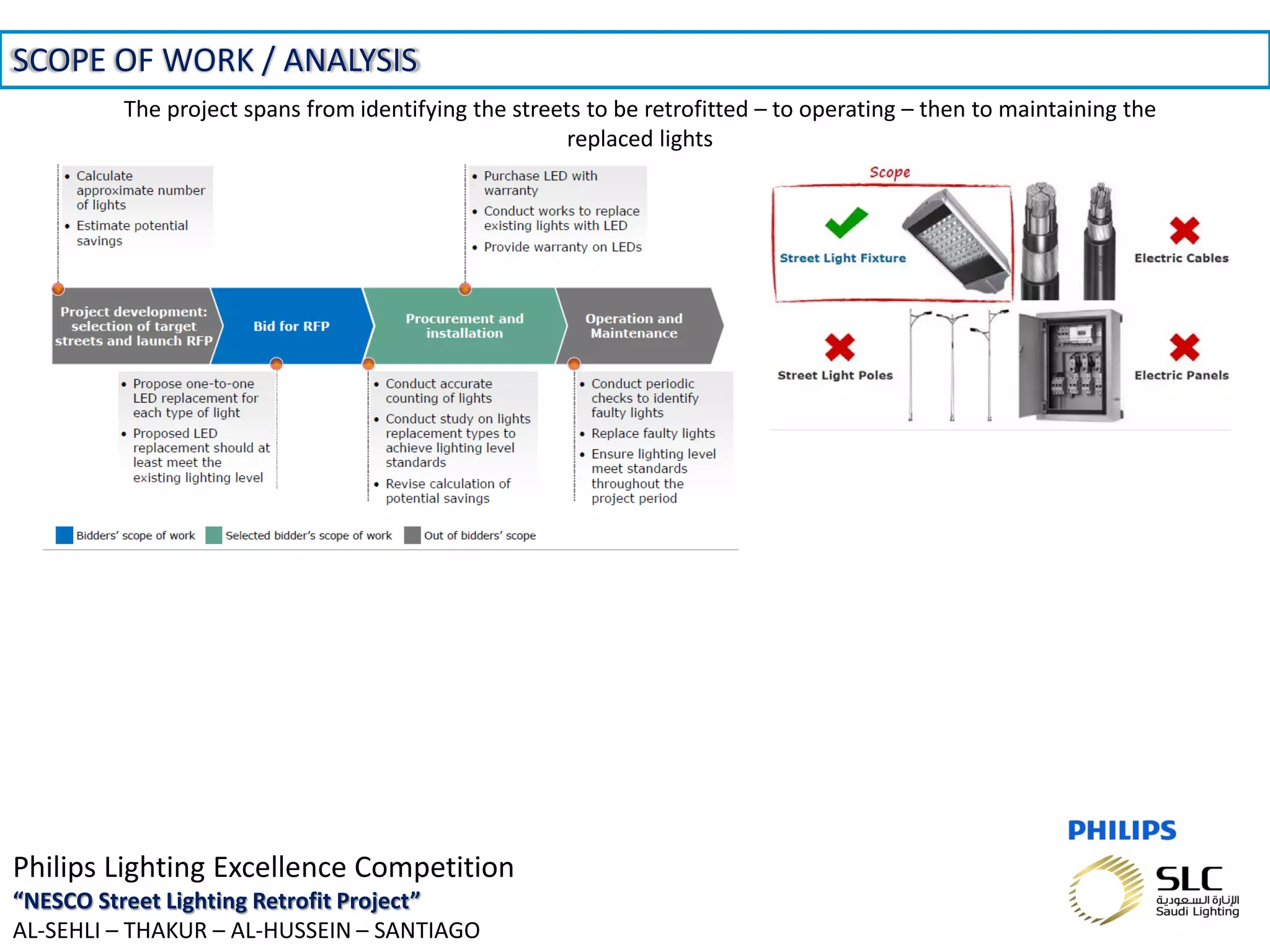

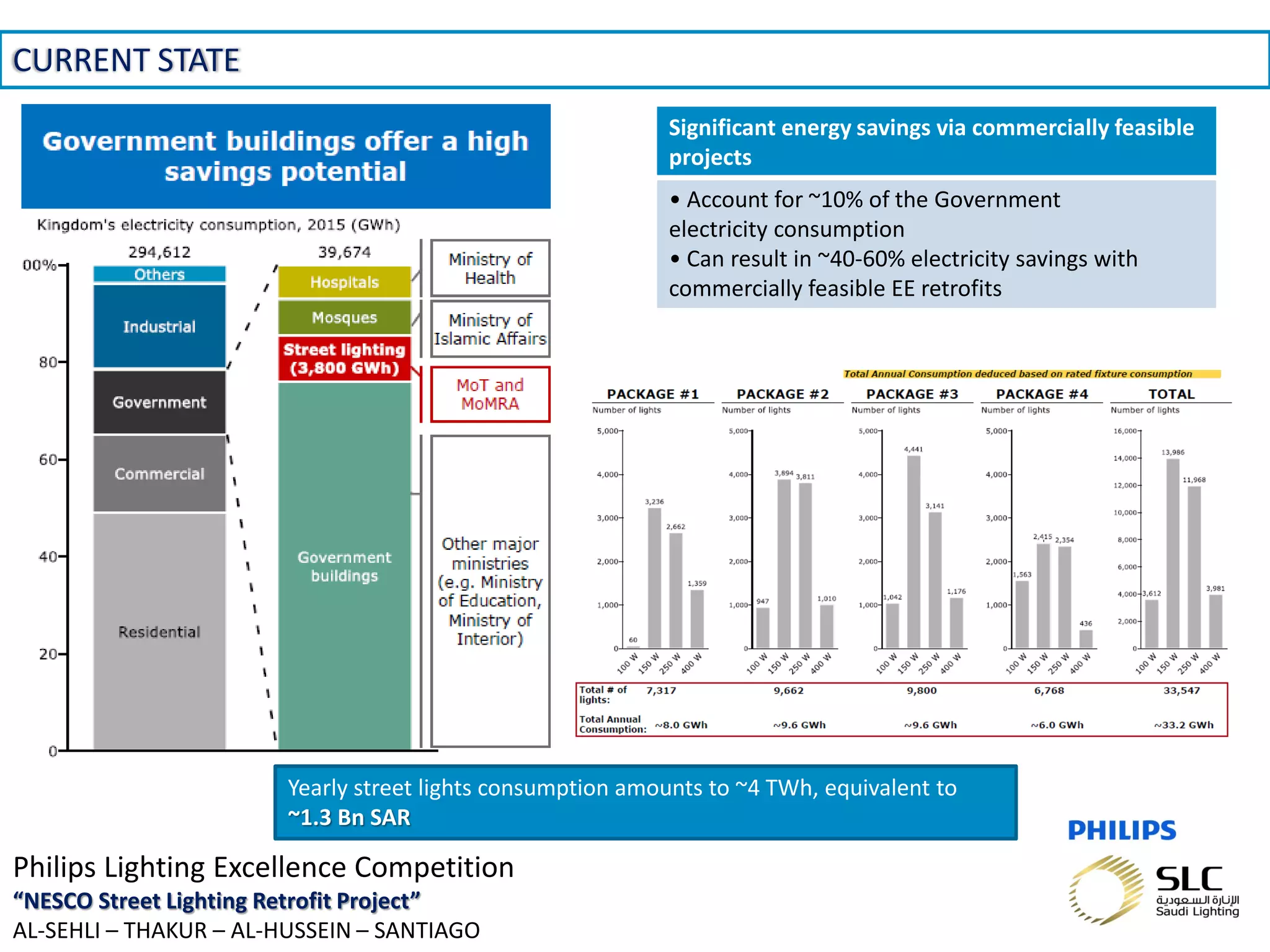

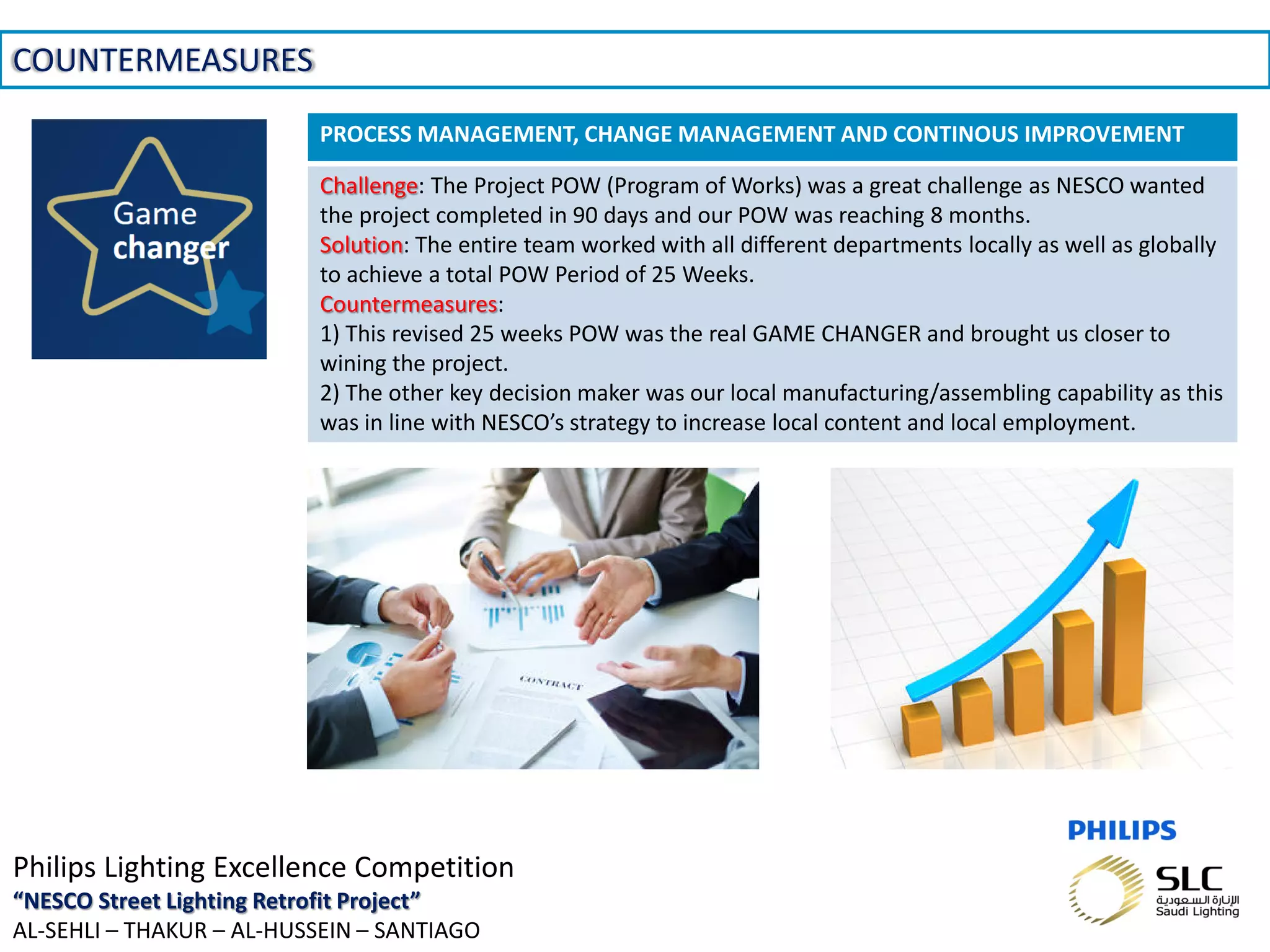

The document discusses the NESCO street lighting retrofit project aimed at improving energy efficiency in Saudi Arabia as part of the Saudi Vision 2030. Philips Lighting is involved in retrofitting 2.5 million lighting points, focusing on significant electricity savings, and faced project management challenges that required collaborative efforts across departments to meet a 25-week implementation timeline. Key successes included securing proper testing certifications and local manufacturing capabilities to align with the project's goals.
