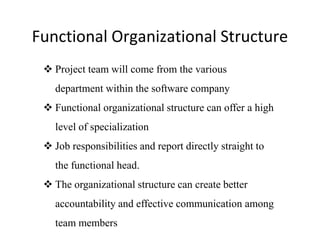

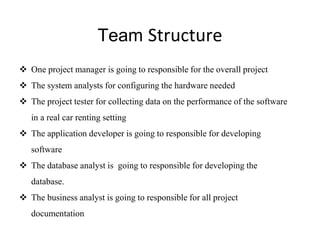

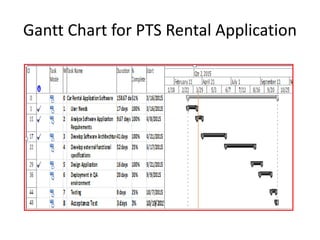

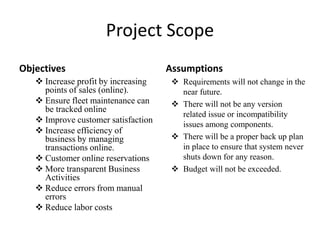

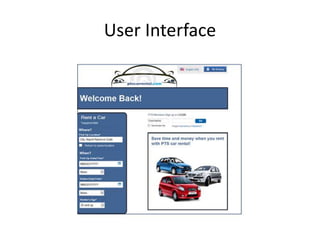

This document outlines a proposed software application project for a car rental company called PTS Car Rental Group. The project aims to develop a web-based application to help the company manage its fleet, track maintenance and reservations online, and attract more customers. A project team of 4 people plans to complete the project within 6 months with a $200,000 budget. Key deliverables include gathering requirements, developing the application design, and getting client approval. The document provides details on project scope, resources, risks, and a Gantt chart timeline.
