The ]project-open[ Data Model
Frank Bergmann, 2010-05-22

This guide contains overview information that is useful if you
want to write reports or if you need to extract information from
the API.
It is not ment as a developer guide. Please check the OpenACS
manual for more detailed information.
Payroll
                             HR               ProjectMgmt.
                                  Project Subprojects
                                                                        Trans-lation
                                                            TranslationWorkflow
                                                                                                    Room
                                                                                                  Reservation
                                                                                                                 Other
                                                                                                                                 ]po[
                 Skill Database        ProjectControlling          TMIntegration
                                                                                                          E-
                                                                                                     Commerce                    Overview
                     Recruiting                                                                              Surveys
                                           TimesheetMgmt.          AutomaticInvoicing
                     Workflow                                                                    Web-Mail
                                                                                Glossary                                                       Available
Application                                                                                                                                  Documentation
 Modules
                         Collaboration,Content  KM                                 Finance                                 CRM
                Filestorage Calendar                           FinanceBase                            ContactMgmt.                            FinanceGuide
                                                                              Controlling
              OnlineDiscussions Wiki         Chat              Quotes Invoice                        CustomerWeb Reg.
                                                                            FreelanceInvoicing                                                  Translation
                                             WebDAV
                          Mail ServerIntegration
                                                                   Payments                              MarketingCampaigns                      Workflow
                IncidentWorkflow
                                                                              TimesheetInvoicing                                                   Guide
                               ContentManagement
                        CMS                                      FinancialReporting                              CRMTracking
                                               Blog                                                                                                 Forum
                                                                                                                                                    Guide

Application     Full-Text                                        Localization                                                                   Filestorage
 Services                 WorkflowEngine
                                      ReportingEngine Components
                                                  Portal                   Mail ServerIntegration
                                                                                          ISDN TelIntegration                                      Guide
                 Search                                           Framework

                         SoftwareDevelopment                  OOFrame                                               Security
              PackageManager                                OO Model                  OpenACSPermission
                                                                                                          PageContracts                       Configuration
              Profiling  Performance Templates            ObjectMetadata              BasicAuthentication                                      Guide
 Platform
 Services                             Automatic                                                             SQLTemplates
                      DebuggingSystem                                                      LDAPAuthentication                                    OpenACS
                                        Testing       DynField Object Extensions
        AutomaticSoftwareUpdates                                                                                 AutomaticAudits                 Developer
                            FormBuilder                                                                                                            Guide
                                                                        SOAP
                                                                       XML-RPC
                                                                                                                                                Operations
   Web                                                                                                                    System
  Server               TCL                                                   DB-API          Pound                                                Maint.
                                              AOLServer                                                      CVS
                                                                                          Revers Proxy                                             Guide
                                                                                                                  Mondrian
  Search                                                                                     BigBrother
  Engine                       TSearch2                   Oracle Intermedia/Text                                    Data-
                                                                                             Sys Mgmt.            Warehouse              OpenACSInst. Guid
Database                     PostgreSQL                       Oracle 8i, 9i, 10g             Database
                                                                                             Replication            Postfix/
Operating           Windows                                                                                        Sendmail
 System                            Linux        Solaris          BSD         Mac OS                                                         Unix InstallGuide
                    + CygWin
                                                                                                              © ]project-open[ 2010, Data-Model / Frank Bergmann / 2
Other Documentation

This is a limited overview document.
For more detailed information please see:

 ]po[ Wiki: http://www.project-open.org/
 OpenACS Developer Guide:
  http://www.openacs.org/doc/
 ]po[ List of packages: http://www.project-
  open.org/documentation/list_packages

                                       © ]project-open[ 2010, Data-Model / Frank Bergmann / 3
General System Architecture

 ]po[ consists of three main parts:
    – A powerful object-relational data model
    – TCL pages that render the contents of the database
      and
    – TCL libraries that provide auxilary functions to the
      TCL pages                                                            TCL Pages
 The Data Model is particularly important in ]
  po[ because:                                                            TCL Library
    – It is object-oriented
    – The TCL layer does not contain objects. It merely
      renders the content of the Data Model                               Data Model
 The Data Model is the location where you need to
  go if you want to extract information from the
  system

                                                             © ]project-open[ 2010, Data-Model / Frank Bergmann / 4
General Conventions

   Tables names are always in plural form and written in lower case
   Tables are held in general in 2nd normal form
   De-normalized table columns are named with a _cache postfix.                    Normal arrow
                                                                                      means referential
   All main tables have an integer primary key table_name_id.                      integrity relation-
    This primary key references the table acs_objects which contains                  ship between
    the type of the object.                                                           tables.
   Most object-object mappings are handleled by the acs_rels
    table and its sub-types (see below). Other mapping tables are
    called something_something_map
   Boolean fields have a _p postfix and contain 't' or 'f' char values
   All main objects include object_type_id and object_status_id
    fields. Type is used to create minor sub-types of the objects,                  Big arrow tip means
    such as the distinction of im_companies such as customer and                    inheritance relation-
    provider. Status is used to deal with the object's lifecycle,                 ship. An inheriting
                                                                                      object references
    such as potential, active, closed and deleted.                            its parent type with
                                                                                      its object_id.

                                                                      © ]project-open[ 2010, Data-Model / Frank Bergmann / 5
“Business Objects”

             © ]project-open[ 2010, Data-Model / Frank Bergmann / 6
Data Model Overview – Business Objects

                          Most data in the ]po[ data model are
   acs_objects            structured as “Business Objects”
           object_id
         object_type
                           (BizObj).
                          A “BizObj” is just a database table
   im_projects
                           following a number of conventions
            project_id
        project_name        – A integer primary key called object_id
            project_nr
          company_id          representing a unique object ID
    project_status_id
      project_type_id       – The primary key references the
      project_lead_id
        supervisor_id         “acs_objects” table. acs_objects includes
                    …
                              object meta-information such as object
                              type, creation date, creation user etc.
                            – Every ]po[ BizObj includes a field
                              “object_status_id” re

                                                   © ]project-open[ 2010, Data-Model / Frank Bergmann / 7
Data Model Overview – Business Objects

                                                           The ]po[ data model is
                                                            based on the notion of
        acs_objects
                                                            “Business Objects”
                                                           A “BizObj” is just a
     object_id
     object_type
                                                            database table following
                                                            a number of
                                                            conventions
        im_projects                                         –   A primary key
                                im_categories                  representing a unique
                  project_id                                     object identifier
              project_name               category_id         –   The primary key
                  project_nr           category_type             references the
                company_id                     name
          project_status_id
                                                                 “acs_objects” table.
                                          description            acs_objects includes
            project_type_id
                                                                 object meta-information
            project_lead_id                                      such as object type,
              supervisor_id         persons                     creation date, creation
                          …                                      user etc.
                               person_id
                               first_names                   –   Every ]po[ BizObj includes
                               last_name                         a field “object_status_id”
                                                                 and “object_type_id” to
                                                                 deal with the objects’
                                                                 livecycle (status_id) and
                                                                 sub-types (type_id).

                                    persons
            acs_rels
                               person_id
         rel_id
                               first_names
         object_id_one
                               last_name
         object_id_two

                                                                 © ]project-open[ 2010, Data-Model / Frank Bergmann / 8
Data Model Overview – Business Objects

 The ]po[ data model is based on the notion of “Business
  Objects”
 A “BizObj” is just a database table following a number of
  conventions
   – A primary key representing a unique object identifier
   – The primary key references the “acs_objects” table. acs_objects
     includes object meta-information such as object type, creation
     date, creation user etc.
   – Every ]po[ BizObj includes a field “object_status_id” re

                                                    © ]project-open[ 2010, Data-Model / Frank Bergmann / 9
Categories

     © ]project-open[ 2010, Data-Model / Frank Bergmann / 10

Categories

                                                                object                          object_type
 Conventional/ traditional database design normally           object_type_id                          object_type_id
 includes “foreign key tables” defining the type and         object_status_id                                  name
 status of an object.                                                   name                              description
                                                                  description
                                                                           ...                  object_status
 ]po[ takes a different approach in order to
 minimize the number of database tables and to simplify                                            object_status_id
                                                                                                              name
 maintenance. We use a single im_categories table for                                                 description
 all types of status and type information:
                                                           The Classical DB-Design: Every table has
 Pros:                                                     it's own tables for type, status and similar
                                                           information.
 + The total number of DB tables is reduced to a third.
 + A single maintenance screen can deal with all
     categories.                                                object                        im_categories
 + Built-in features:                                         object_type_id                             category_id
      +   Translation/Localization                           object_status_id                          category_type
      +   Hierarchical categories                                       name                                   name
                                                                  description                             description
      +   Common GUI widgets                                               ...
 +   Referential Integrity is enforced
                                                                            im_category_hierarchy
 Cons:
 - In theory it is possible to assign the wrong Category                                       parent_category_id
                                                                                                child_category_id
    to a field. However this has never happened in
    practice yet.                                          ]po[ DB-Design: All type and status information
                                                           is stored in a single im_categories table.

                                                                                 © ]project-open[ 2010, Data-Model / Frank Bergmann / 11
Categories

Categories form a DAG:
 A Directed Acyclic Graph is like a Tree with                                                All
   multiple inheritance                                                                    Companies
 A DAG allows you to tag categories with

                                                       don't change!
   meta-information

                                                        Constants,
                                                                                 CustOrIntl

Categories are partly constants, partly                                         Customers      Internal        Providers
configurable:
                                                                                         Consulting                           Freelance
                                                                                          Agencies                            Providers
    The top level (customers, internal, providers,

                                                          Freely Configurable
                                                                                         Law Firm                          Office Equ.
    custorintl) are used as constants by the system.                                     Customers                           Providers

    You'll break the system if you change them.                                         Localization
                                                                                         Customer
                                                                                                                                   ...

    However, you can localize them.
   The lower level values are freely configurable                                           ...

    to the specific company structure

Details for each category are found in the
PO-Configuration-Guide.

                                                                                      © ]project-open[ 2010, Data-Model / Frank Bergmann / 12
Categories

                                                                                                                                 Sample SQL
Categories Definition                                              Select Everything About Categories
-- We use categories as a universal storage for business           select
-- object states and types, instead of a zillion of tables               c.*,
-- like 'im_project_status' and 'im_project_type'.                       im_category_from_id(aux_int1) as aux_int1_cat,
                                                                         im_category_from_id(aux_int2) as aux_int2_cat,
create sequence im_categories_seq start 100000;                          h.parent_id,
create table im_categories (                                             im_category_from_id(h.parent_id) as parent
   category_id        integer                                       from
                             constraint im_categories_pk                 im_categories c
                             primary key,                                    left outer join im_category_hierarchy h
   category                  varchar(50) not null,                           on (c.category_id = h.child_id)
   category_description      varchar(4000),                         where
   category_type             varchar(50),                                c.category_type = 'Intranet Cost Types'
   category_gif       varchar(100) default 'category',              order by
   enabled_p                 char(1) default 't'                         category_type,
                             constraint im_enabled_p_ck                  category_id;
                             check(enabled_p in ('t','f')),
                             -- used to indicate abstract
                             -- super-categorys that are not
                             -- valid values for objects.          Extract Categories Without Join
                             -- For example: Translation          -- A helper functions to make our queries easier to
                             -- Project is not a project_type,       read
                             -- but a class of project_types.      create or replace function im_category_from_id
   parent_only_p             char(1) default 'f'                      (integer)
                             constraint im_parent_only_p_ck        returns varchar as '
                             check(parent_only_p in ('t','f'))     DECLARE
);                                                                         p_category_id   alias for $1;
                                                                           v_category      varchar(50);
                                                                   BEGIN
                                                                           select category
Category Hierarchy                                                         into v_category
--   Optional system to put categories in a hierarchy.                     from im_categories
--   This table stores the transitive closure of the                     where category_id = p_category_id;
--   is-a relationship between categories in a kind of matrix.
--   Let's asume: B isa A and C isa B. So we'll store                      return v_category;
--   the tupels (C,A), (C,B) and (B,A).                            end;' language 'plpgsql';
--   This structure is a very fast structure for asking:
--                                                                 -- Example:
--       is category A a subcategory of B?                       -- select im_category_from_id(48);
--                                                                  Create a New Category Entry
--   but requires n^2 storage space in the worst case and           insert into im_categories (
--   it's a mess retracting settings from the hierarchy.               category_id, category, category_type,
--   We won't have very deep hierarchies, so storage complexity        category_description, enabled_p,
--   is not going to be a problem.                                     aux_int1, aux_int2,
                                                                       aux_string1, aux_string2
create table im_category_hierarchy (                                ) values (
        parent_id               integer                                :category_id, :category, :category_type,
                                constraint im_parent_category_fk       :category_description, :enabled_p,
                                references im_categories,              :aux_int1, :aux_int2,
        child_id                integer                                :aux_string1, :aux_string2
                                constraint im_child_category_fk     );
                                references im_categories,
                                constraint category_hierarchy_un
                                unique (parent_id, child_id)
);

                                                                                                        © ]project-open[ 2010, Data-Model / Frank Bergmann / 13
]po[ Objects and Types

                                                                                     acs_attributes
All major ]po[ tables are Objects                                                             attribute_id
   Objects are identified by an object_id.                                                    pretty_name
                                                                                                object_type
   Information about object type is stored in the acs_objects                                  table_name
    table, together with metadata and creation information.                                   column_name

                                                                                acs_object_types
Advantages of being an object:
                                                                                                 object_type
   Permission system:                                                                              supertype
    Associates objects with privileges, including all necessary                                table_name
    maintenance screens                                                                            id_column
                                                                                               name_method
   SQL metadata system:
    Allows the administrators to dynamically extend object types
    with new attributes
                                                                                          acs_objects
   Full-Text search:
    Indexes all objects and produces generic URL for the search                          object_id
    results                                                                              object_type
   Configurable workflow:
    Allows to manage the status of any object. The WF includes
                                                                                               object
    a graphical WF editor.
   Generic Object Relations:                                                            object_type_id
                                                                                         object_status_id
    acs_rels allows you to define generic relationships between                          name
    objects.                                                                             description
                                                                                         ...

                                                                    © ]project-open[ 2010, Data-Model / Frank Bergmann / 14

]po[ Objects and Types

 acs_attributes:
   – Each row in acs_attributes table defines an attribute of the specified
     object type.
   – The contents of the table is managed by the intranet-dynfield
     package that contains a SQL metadata editor.
 acs_privileges:
   – Contains permissions tokens (= privileges). These privileges allow a
     user to perform a certain operation in the system.
 acs_permissions:
   – Defines a mapping between acs_objects and acs_privileges.
   – The mapping is per user group (grantee_id). Groups can be
     hierarchical.

                                                            © ]project-open[ 2010, Data-Model / Frank Bergmann / 15
Main Object Types

            © ]project-open[ 2010, Data-Model / Frank Bergmann / 16
Main Object Types                                    acs_objects
                                                       object_id
                                                       object_type

   acs_rels                 groups                                                      parties
                                                                                                                       users_contact
rel_id                   group_id                                                     party_id
object_id_one            group_name                                                   email                          Home Address
object_id_two                                                                         url                            Work Address

                          im_profiles                im_biz_objects                    persons                     im_employees
                         profile_id
                                                  object_id                           person_id                      Payroll Info
                         profile_gif
                                                                                      first_names                    Recruiting Info
                                                                                      last_name

                                                                                                                      im_freelancers
 im_companies                    im_offices                 im_projects                users
                                                                                                                     Freelance Info
          company_id                      office_id                      project_id   user_id
       company_name                    company_id                    project_name     username
   company_status_id              office_status_id                      project_nr    password
     company_type_id                office_type_id                    project_path    salt
        main_office_id                  Address                     customer_id     auth_token
   primary_contact_id
                                                               project_status_id
accounting_contact_id
                                                                 project_type_id
          vat_number
                                                                 project_lead_id
                  note
                                                                   supervisor_id
                                                                 project_budget
                                                               budget_currency
                                                                   budget_hours
                                                                       start_date
                                                                        end_date
                                                                      description
                                                                             note

                                                                                                    © ]project-open[ 2010, Data-Model / Frank Bergmann / 17
Main Types

 im_biz_objects:
   – This abstract type defines a number of functions to manage horizontal
     permissions (= Please see other ]po[ documentation) for project,
     companies and offices
   – Horizontal permissions currently include roles such as Project
     Manager of Full Member.
 parties, persons, users:
   – These three tables form an inheritance hierarchy. There is a view
     cc_users that unifies the information from these tables.
 im_freelancers, im_employees, users_contact:
   – These are extension tables for persons and define additional
     information for users with particular profiles.
 im_profiles:
   – This table defines the groups that are relevant for ]po[, as opposed to
     potentially hundreds of groups of the underlying OpenACS system.

                                                           © ]project-open[ 2010, Data-Model / Frank Bergmann / 18
Users, Groups and Their Relationships
Users and their groups in ]po[ are modeled               Groups              Relations                                                      User Types
using a number of types and tables:
                                                    groups                acs_rels                   parties
 User information is stored in 5 different                                                                                        users_contact
  tables, depending on the type of user         group_id               rel_id                    party_id
  (see below).                                  group_name             object_id_one             email                            Home Address
 General (OpenACS) groups consist of a                                object_id_two             url                              Work Address
  basic “groups” table. The groups
  (“profiles”) used in ]po[ “profiles” are
  identified by an entry in “profiles”.          im_profiles                                        persons                      im_employees
 A user-group membership is established                               membership
  when creating a “membership_rel”              profile_id
  between the two. The membership_rel           profile_gif               _rels                 person_id                       Payroll Info
                                                                                                 first_names                     Recruiting Info
  consists of an acs_rels entry mapping                                         rel_id
  the user to the group, plus a                                                                  last_name
                                                                          member_state
  membership_rels entry containing the
  information about the member state                                                                                               im_freelancers
  (“active”). To disable a membership, you                                                             users
  can update the member_state to                                                                                                  Freelance Info
  “deleted”.                                                                                     user_id
                                                                                                 username
This way of modeling users allows to                                                             password
dynamically extend users, groups and
                                                                                                 salt
their relations. This is heavily used in ]po[
(for example there is an “employee_rel”).                                                        auth_token
However, it adds a certain overhead (9
tables instead of 3).

User Types:
 Party: Super-type of both “person” “group” and “im_company”, allowing to compose new groups of both users and groups.
 Person: Represents a natural person with first- and last name
 User: Contains the login information necessary for a person to participate in ]project-open[
 users_contact: Extension table with address information
 im_employees: Extension table with employee information
 im_freelancers: Extension table with freelancer information

                                                                                                              © ]project-open[ 2010, Data-Model / Frank Bergmann / 19
Financial Types
                             acs_objects
                            object_id
                                                                          All financial objects in ]po[ are based on the object
                            object_type
                                                                           type “Cost Item” in table “im_cost”. This table
                                                                           contains the common information shared across all
             Inheritance!                                                  types of cost items.
                               im_costs          im_payments             The field im_cost.cost_type_id determines the
                                       cost_id   payment_id                specific type of the cost item.
     im_invoices                  cost_name     cost_id                  The following cost sub-types are derived from the
                                      cost_nr    company_id                “Cost Item” base type:
  invoice_id
                               cost_status_id    provider_id                    –   Timesheet Cost – The monthly cost of an
  company_contact_id                                                                employee
                                 cost_type_id    received_date
  invoice_nr
                                                 payment_type_id                –   Expense Bundle – A collected and “bundled” group
  invoice_office_id                project_id                                       of Expense Items (see below)
                                                 payment_status_id
                                 customer_id
                                                 amount                   “Expense” is a sub-type of Cost Item. Expenses
im_invoice_items                provider_id
                                                 currency                  represent money paid by employees to external
                               cost_center_id
                                                 note                      companies. Expenses are bundled together as
item_id                        investment_id
                                                                           “Expense Bundles”. These Expense Bundles are
item_name                        template_id
                                                                           typically approved by the finance department and the
project_id                   effective_date_id   im_cost_centers         reimbursed to the employee. Sub-types of Expense
invoice_id                      payment_days                               refer to the different types of expenses:
item_units                             amount    cost_center_id                 –   Airfare
item_uom_id                           currency   cost_center_name               –   Taxi
price_per_unit                   paid_amount     cost_center_code               –   Book
currency                        paid_currency    cost_center_type_id
                                                                                –   …
sort_order                                       cost_center_status_id
                                           tax   department_p             “Financial Document” is a sub-type of Cost Item
item_type_id                               vat                             implementing any financial items with lines in it. Sub-
item_status_id                     description                             types include:
description                               note
                                                  im_expenses                –   Customer Invoice
                                                                                –   Delivery Note
                                                 expense_id                     –   Quote
                                                 ext._company_name              –   Provider Bill
                                                 ext._comp._vat_num.            –   Purchase Order
                                                 billable_p               “Repeating Costs” are not yet 100% implemented in ]
                                                 reimbursable              po[ as of 3.4.0.8.9. This type will represent recurring
                                                 bundle_id                 cost items in the future, including monthly service
                                                                           fees, employee salaries etc.2010, Data-Model / Frank Bergmann / 20
                                                                                           © ]project-open[
Financial Types

 im_costs:
   – This is the main table for all cost items.
   – All financial elements in the system are stored in this table. The table
     also receives updates from timesheet (cost related to users working on
     a project) etc.
 im_cost_centers:
   – Is currently not used. The table has been included in the current
     datamodel for smooth upgrade in future versions.
 im_invoices:
   – This table contains financial documents such as Invoices, Quotes,
     Bills and Purchase Orders (the name im_invoices is a bit
     misleading).
 im_invoice_items:
   – These are the individual lines of an invoice.

                                                           © ]project-open[ 2010, Data-Model / Frank Bergmann / 21
Financial Types (2)

Relationship between Costs and Projects

                                             acs_rels
                                         rel_id
                                         object_id_one                                                   select distinct
                                                                                                               c.cost_name,
                                         object_id_two                                                         im_category_from_id(c.cost_type_id) as cost_type,
                                                                                                               c.amount * im_exchange_rate(c.effective_date::date,
                                                                                                         c.currency, 'EUR') as amount_converted
     im_projects                                                                                        from
                                                                              im_costs                         im_projects main_p,
                                                                                                               im_projects sub_p,
 project_id
                                                                                                               acs_rels r,
 …                                                                                     cost_id                 im_costs c
                                                                                                         where
                                                                                   cost_name                   main_p.project_id = :main_project_id and
                                                                                      cost_nr                  sub_p.tree_sortkey between main_p.tree_sortkey and
                                                                                                         tree_right(main_p.tree_sortkey) and
                                                                                            …                  r.object_id_one = sub_p.project_id and
                                                                                    project_id                 r.object_id_two = c.cost_id

                                                                                                                   A sample query to extract all financial items
                                                                                                                related to a certain main-project.
 The Problem:
 Cost and Projects can have a N:M relationship:
      One project may have more then one invoice/cost item.
      One cost item may “relate” to more then one project (in particular: project + sub-project, but also the item may be split between two main
       projects).
      An invoice may actually not belong to any project at all.

 Solution:
     In general, the relationship between projects and costs is defined as an N:M relationship by acs_rel.
     im_costs.project_id points to im_projects ONLY in the case that one cost item relates to exactly one project

 Watch out:
    Relation between Projects and Costs:
         –    im_cost.project_id: Refers to the project only if there is exactly one project per cost item
         –    acs-rels: Establishes a N:M relationship between projects and cost items. This is used to include several (small) projects in a single invoice.
      Cost Items can be related to a main-project or to a sub-project or any level. So in order to calculate the main project’s total Profit  Loss,
       you need to sum up the financial items through the full project tree (hierarchical query)

                                                                                                                       © ]project-open[ 2010, Data-Model / Frank Bergmann / 22
Financial Types (3)
                                                                                                    Example

                               Main project

   im_projects
project_id
…

                                                    Sub-project
                                                   with cost item

                      im_projects              acs_rels           im_costs
                  project_id                  rel_id                        cost_id
                  parent_id                   object_id_one             cost_name
                  …                           object_id_two                cost_nr
                                                                                 …
                                                                        project_id

                      im_projects                  Sub-project
                  project_id                       with cost item
                  parent_id
                  …

                                                                     © ]project-open[ 2010, Data-Model / Frank Bergmann / 23
Relationship Types

                                    acs_objects
                                   object_id
                                   object_type

                                                                            acs_rel_type
                                                                                           rel_type
                                                                                  object_type_one
                                      acs_rels                                   object_type_two
                                                                                          role_one
                                                     rel_id
                                                                                          role_two
                                                  rel_type
                                            object_id_one                         min_n_rels_one
                                            object_id_two                         max_n_rels_one
                                                                                  min_n_rels_two
                                                                                  max_n_rels_two

membership_rels    composition_rels          admin_rels            group_rels
             rel_id                rel_id                     rel_id                rel_id
       member_state                                                              rel_type
                                                                                group_id

                             im_biz_object_members
                                                                       Defines the relationships between an
                                                        rel_id         im_biz_object and some users. The membership
                                                object_role_id         type corresponds to horizontal permissions and
                                                                       usually includes full member, project manager,
                                                                       key account and user-defined roles.
                                                                                       © ]project-open[ 2010, Data-Model / Frank Bergmann / 24
Relationship Types

   acs-rels:
     – The acs_rels table is essentially a generic mapping table for acs_objects. Once
       we come up with a way to associate attributes with relationship types, we could
       replace many of the ACS 3.x mapping tables like user_content_map,
       user_group_map, and user_group_type_modules_map with this one table. Much
       application logic consists of asking questions like Does object X have a
       relationship of type Y to object Z? where all that differs is X, Y, and Z. Thus, the
       value of consolidating many mapping tables into one is that we can provide a
       generic API for defining and querying relationships. In addition, we may need to
       design a way to enable type_specific storage for relationships (i.e., foreign key
       columns for one-to-many relationships and custom mapping tables for many-to-
       many relationships), instead of only supporting generic storage in the acs_rels
       table. This would parallel what we do with acs_attributes.
   im_biz_object_members:
     – Defines the member of a im_biz_object and their roles (project manager of full
       member).
     – Such a membership has an impact on the access rights of members to the
       business object.
   membership_rels: Defines group-supergroup relations

                                                                    © ]project-open[ 2010, Data-Model / Frank Bergmann / 25
Translation Types          acs_objects
                           object_id
                           object_type

                          im_trans_tasks
     im_costs
                                        task_id
                                    task_name         im_trans_prices
                                 task_filename
                                task_status_id       price_id
   im_invoices                      project_id      company_id
                                  task_type_id       task_type_id
                           source_language_id        source_lang_id
                           target_language_id        target_lang_id
                               subject_area_id       subject_area_id
im_trans_invoices                task_uom_id        uom_id
                                     invoice_id      currency
                                       quote_id      price
                                      end_date       note
                                      task_units
                                  billable_units     im_trans_quality_reports
                                         trans_id
                                                     report_id
                                           edit_id
 im_trans_trados_matrix                  proof_id
                                                     task_id
                                                     report_date
                                         other_id
object_id                                            reviewer_id
match_x                               match_x        sample_size
match_rep                           match_rep        allowed_errors
match_100                           match_100        total_errors
match_95                             match_95        comments
match_85                             match_85
match_75                             match_75        im_trans_quality_entries
match_50                             match_50
match_0                               match_0        report_id
                                                     quality_category_id
                                             note
                                                     minor_errors
                                                     major_errors
                                                     critical_errors
                                                             © ]project-open[ 2010, Data-Model / Frank Bergmann / 26

Translation Types

   im_trans_tasks:
     –   This tables contains the description of the main activity related to translation projects.
     –   Includes information about Translation Memory repetitions
     –   Inludes information about the translator, editor, proof-reader and other assigned to
         perform this task (static workflow)
   im_trans_invoices:
     –   This is currently just a flag (binary information) to identify invoices that have been created
         based on im_trans_tasks. Translation invoices are referenced by im_trans_tasks.invoice_id
         in order to make sure that every trans_task is included in exactly one invoice. These
         references need to be removed if a translation invoice is deleted.
   im_trados_matrix:
     –   Contains the discounts per customer and translation task type for different Translation
         Memory matches.
     –   The trados_matrix associated with the internal company contains the site-wide defaults
         for customer translation prices.

                                                                                © ]project-open[ 2010, Data-Model / Frank Bergmann / 27
Timesheet Types

                                          acs_objects
                                         object_id
                                         object_type                               im_timesheet_prices
                                                                                price_id
                                                                                company_id
    im_costs                              im_projects                          task_type_id
                                                                                material_id
                                                      project_id                uom_id
                                                  project_name                  currency
                                                   customer_id                  price
  im_invoices                                  project_type_id                 note

                                                       start_date
                                                        end_date
                                                                                        im_ts_task_deps.
 im_ts_invoices                                              ...
                                                                                     task_id_one
                                                                                     task_id_two
                                                                                     dependency_type_id
                                                                                     difference
                                                                                     hardness_type_id

                        im_tickets                    im_timesheet_tasks
                 ticket_id                         task_id
                                                                                                  im_materials
                 ticket_status_id                  material_id                                  material_id
                 ticket_type_id                    uom_id                                       material_name
                 ticket_prio_id                    planned_units                                material_nr
                 ticket_customer_contact_id        billable_units                               material_type_id
                 ticket_assignee_id                cost_center_id                               material_status_id
                 ticket_sla_id                     invoice_id                                   material_uom_id
                 ticket_queue_id                   priority                                     description

                                                                               © ]project-open[ 2010, Data-Model / Frank Bergmann / 28
Consulting Types

 im_timesheet_tasks:
   – This tables contains the description of the main activity related to
     projects.
 im_timesheet_invoices:
   – This is currently just a flag (binary information) to identify invoices that
     have been created based on im_timesheet_tasks. Timesheet invoices
     are referenced by im_timesheet_tasks.invoice_id in order to make sure
     that every task is included in exactly one invoice. These references
     need to be removed if a timesheet invoice is deleted.
 im_timesheet_prices:
   – Contains a price per material and customer.
   – The timesheet_prices associated with the internal company contains
     the site-wide default price list.

                                                              © ]project-open[ 2010, Data-Model / Frank Bergmann / 29
Workflow

           © ]project-open[ 2010, Data-Model / Frank Bergmann / 30

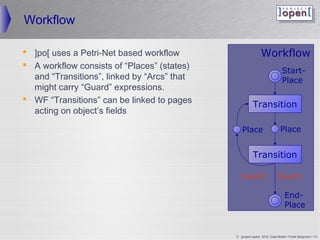

Workflow

 ]po[ uses a Petri-Net based workflow                       Workflow
 A workflow consists of “Places” (states)
                                                                           Start-
  and “Transitions”, linked by “Arcs” that                                 Place
  might carry “Guard” expressions.
 WF “Transitions” can be linked to pages
                                                        Transition
  acting on object’s fields

                                                 Place                    Place

                                                        Transition

                                                [Guard]                 [Guard]

                                                                             End-
                                                                             Place

                                             © ]project-open[ 2010, Data-Model / Frank Bergmann / 31

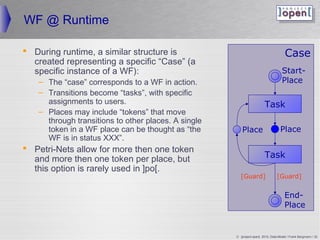

WF @ Runtime

 During runtime, a similar structure is                                             Case
  created representing a specific “Case” (a
  specific instance of a WF):                                                      Start-
   – The “case” corresponds to a WF in action.                                     Place
   – Transitions become “tasks”, with specific
     assignments to users.                                              Task
   – Places may include “tokens” that move
     through transitions to other places. A single
     token in a WF place can be thought as “the          Place                    Place
     WF is in status XXX”.
 Petri-Nets allow for more then one token
  and more then one token per place, but                                Task
  this option is rarely used in ]po[.
                                                        [Guard]                 [Guard]

                                                                                     End-
                                                                                     Place

                                                     © ]project-open[ 2010, Data-Model / Frank Bergmann / 32
WF Tables

      Static        Workflow                           Case
Assignments
                   wf_workflows         wf_cases
                  workflow_key      case_id
                                    workflow_key
                                    object_id
                                    state

      wf_roles    wf_transitions       wf_tasks
                  transition_key    task_id
  role_key        workflow_key      case_id
  workflow_key    role_key          transition_key
                  direction         state

                      wf_places        wf_tokens
                  place_key         token_id
                  workflow_key      case_id
                                    place_key
                                    state
                       wf_arcs
                  transition_key
                  place_key
                  direction

                                                     © ]project-open[ 2010, Data-Model / Frank Bergmann / 33
WF “Callbacks”
                                                                                             Transition
“Callbacks” are Pl/SQL database                                                                 States
procedures that determine the behavior                    “Enable”

of a transition:                                          “Unassigned”     Enable
 A number of “Outgoing Events” allow to
    customize the behavior of WF transitions:                                           Enabled

     –   Enable: Is called when the transition is         “Fire”
         enabled (a token is placed in one of its input                      Start
         places)
     –   Unassigned: Is called if the transition hasn’t   Time                          Started
         been statically (see below) assigned to a user   Deadline
         or a group.
     –   Fire: Is called once the transition gets fired
                                                          Hold Timeout      Finish                   Cancel
                                                          Notification
   A number of transition’s parameters can be
                                                                                                                 Can
    determined by external routines:                                                     Finished
                                                                                                                celed
     –   Time:
                                                          “Fire”
     –   Deadline:                                                       autom
     –   Hold Timeout
     –   Notification

                                                                         © ]project-open[ 2010, Data-Model / Frank Bergmann / 34

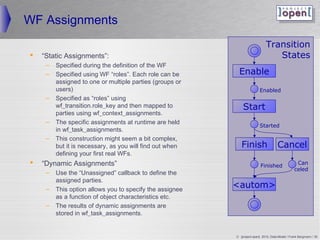

WF Assignments
                                                                              Transition
   “Static Assignments”:                                                        States
     –   Specified during the definition of the WF
     –   Specified using WF “roles”. Each role can be       Enable
         assigned to one or multiple parties (groups or
         users)                                                          Enabled
     –   Specified as “roles” using
         wf_transition.role_key and then mapped to            Start
         parties using wf_context_assignments.
     –   The specific assignments at runtime are held
                                                                         Started
         in wf_task_assignments.
     –   This construction might seem a bit complex,
         but it is necessary, as you will find out when      Finish                   Cancel
         defining your first real WFs.
   “Dynamic Assignments”                                                 Finished
                                                                                                  Can
                                                                                                 celed
     –   Use the “Unassigned” callback to define the
         assigned parties.
     –   This option allows you to specify the assignee
                                                          autom
         as a function of object characteristics etc.
     –   The results of dynamic assignments are
         stored in wf_task_assignments.

                                                          © ]project-open[ 2010, Data-Model / Frank Bergmann / 35
Timesheet
Controlling

          © ]project-open[ 2010, Data-Model / Frank Bergmann / 36
Timesheet  Controlling
                                                      Requirements and Architecture

 Controlling uses caches per project in order to maintain
  aggregated Profit  Loss (PL) information.
 The project caches are updated via triggers
 Reporting on portfolios  customers is handled by the
  reporting engine.

   Customer                            Main               Sub                  “Timesheet”
                       Customer
    Group                             Project            Project                   Task

  “Backward” Reporting                       “Forward” Propagation
  Values are summarized via Reports    Costs are cached. Caches are updated via triggers

                                                                  © ]project-open[ 2010, Data-Model / Frank Bergmann / 37
Timesheet  Controlling
                                                     Controlling cache architecture

                                                                         im_projects
    Projects contain a set of “xxx_cache” fields that
     contain the aggregated cost elements per type.                                              project_id
                                                                                                         …

    CUD (create, update, delete) operations on                              cost_quotes_cache
                                                                            cost_invoices_cache
     costs (timesheet hours, expenses, …) does NOT               cost_timesheet_planned_cache
                                                                    cost_purchase_orders_cache
     update the caches, for performance reasons.                                 cost_bills_cache
                                                                  cost_timesheet_logged_cache
     Instead,                                                      cost_expense_planned_cache

     triggers reset the                                             cost_expense_logged_cache
                                                                      cost_delivery_notes_cache
     “cost_cache_dirty” to NULL.                  “Sweeper”               reported_hours_cache
                                                   Process                            cost_cache_dirty
    There is a “sweeper” process that periodically
     checks “cost_cache_dirty” and updates the
     cache. This might be a nightly activity, or every
     few minutes.

                                                              © ]project-open[ 2010, Data-Model / Frank Bergmann / 38

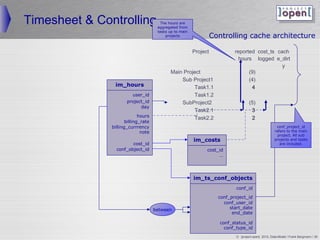

Timesheet  Controlling                 The hours are
                                      aggregated from
                                      tasks up to main
                                          projects                 Controlling cache architecture

                                                         Project            reported cost_ts cach
                                                                              hours logged e_dirt
                                                                                               y
                                            Main Project                          (9)
                                                Sub Project1                      (4)
                im_hours                             Task1.1                       4
                        user_id                      Task1.2
                      project_id                SubProject2                         (5)
                            day
                                                     Task2.1                         3
                             hours                   Task2.2                         2
                      billing_rate
               billing_currrency                                                                       conf_project_id
                              note                                                                    refers to the main
                                                                                                        project. All sub
                                                         im_costs                                     projects and tasks
                        cost_id                                                                          are included.
                 conf_object_id                                cost_id
                                                                    …

                                                         im_ts_conf_objects
                                                                             conf_id

                                                                     conf_project_id
                                                                       conf_user_id
                                     between                              start_date
                                                                           end_date

                                                                      conf_status_id
                                                                        conf_type_id
                                                                            © ]project-open[ 2010, Data-Model / Frank Bergmann / 39
Hierarchical Queries

Main Project

      Sub-Project 1

           Sub-Project 1.1

           Sub-Project 1.2

      Sub-Project 2

           Sub-Project 2.1

           Sub-Project 2.2

                             © ]project-open[ 2010, Data-Model / Frank Bergmann / 40
Auxiliary Tables

         © ]project-open[ 2010, Data-Model / Frank Bergmann / 41
Auxilary Tables

                         GUI
                          Define what plugins (these grey boxes) should appear on what
 im_component_plugins
                             page

        Menu               Defines the hierarchical menu structure of the system

 ViewColumn                Define the columns for ListPages in the core. The ListPages
 view                        need to be extensible at runtime because they might have to
                             accomodate new columns from add-on modules
        View

                            The list of all countries in the world
    Country

                            The list of all currencies
   Currency

                                                                      © ]project-open[ 2010, Data-Model / Frank Bergmann / 42
Auxilary Tables

                         GUI
                          Define what plugins (these grey boxes) should appear on what
 im_component_plugins
                             page

        Menu               Defines the hierarchical menu structure of the system

 ViewColumn                Define the columns for ListPages in the core. The ListPages
 view                        need to be extensible at runtime because they might have to
                             accomodate new columns from add-on modules
        View

                            The list of all countries in the world
    Country

                            The list of all currencies
   Currency

                                                                      © ]project-open[ 2010, Data-Model / Frank Bergmann / 43
]project-open[
As a set of services

             © ]project-open[ 2010, Data-Model / Frank Bergmann / 44
]po[ As a set of Services

 The difficulty of learning OpenACS and ]
  po[ are mostly due to learning and
  understanding the “infrastructure” of
  OpenACS and to learn how to plug new
  functionality into the existing
  infrastructure.

                                 © ]project-open[ 2010, Data-Model / Frank Bergmann / 45
Services Provided by OpenACS / ]po[
Part I: SQL
   Packages  Package Manager
   Object Oriented Data Model
     – PL/SQL Constructors  Destructors
   Permissions
   Business Objects
     – Status Lifecycle Management
     – Type – Subtype Management
     – DynFields
   ]po[ Categories
   PostgreSQL
     –   Referential Integrity
     –   Indices
     –   Unique Constraints
     –   Triggers  Transactions
     –   Constraints
     –   Hierarchical Objects  Queries
   “Portlet” Plug-in Components
   Menu Tabs

                                           © ]project-open[ 2010, Data-Model / Frank Bergmann / 46
Services Provided by OpenACS / ]po[
Part II: TCL
   TCL Pages vs. Library
   Constants
   Packages  Package Permissions
   Page Contracts
   Colon Variables
   Authentication System  User Management
   TCL Permission API
   Context Bar
   Cascading TCL/ADP Template System
   “return_url” Pattern
   List Builder
   Form Builder
   db_foreach  Database Interface
   ]po[ Navbar System
   Localization System
   Oracle/PostgreSQL Database Support
   API-Browser

                                              © ]project-open[ 2010, Data-Model / Frank Bergmann / 47
Frank Bergmann
frank.bergmann@project-open.com
           www.project-open.com

            © ]project-open[ 2010, Data-Model / Frank Bergmann / 48

]project-open[ Data-Model 100511b

  • 1.
    The ]project-open[ DataModel Frank Bergmann, 2010-05-22 This guide contains overview information that is useful if you want to write reports or if you need to extract information from the API. It is not ment as a developer guide. Please check the OpenACS manual for more detailed information.
  • 2.
    Payroll HR ProjectMgmt. Project Subprojects Trans-lation TranslationWorkflow Room Reservation Other ]po[ Skill Database ProjectControlling TMIntegration E- Commerce Overview Recruiting Surveys TimesheetMgmt. AutomaticInvoicing Workflow Web-Mail Glossary Available Application Documentation Modules Collaboration,Content KM Finance CRM Filestorage Calendar FinanceBase ContactMgmt. FinanceGuide Controlling OnlineDiscussions Wiki Chat Quotes Invoice CustomerWeb Reg. FreelanceInvoicing Translation WebDAV Mail ServerIntegration Payments MarketingCampaigns Workflow IncidentWorkflow TimesheetInvoicing Guide ContentManagement CMS FinancialReporting CRMTracking Blog Forum Guide Application Full-Text Localization Filestorage Services WorkflowEngine ReportingEngine Components Portal Mail ServerIntegration ISDN TelIntegration Guide Search Framework SoftwareDevelopment OOFrame Security PackageManager OO Model OpenACSPermission PageContracts Configuration Profiling Performance Templates ObjectMetadata BasicAuthentication Guide Platform Services Automatic SQLTemplates DebuggingSystem LDAPAuthentication OpenACS Testing DynField Object Extensions AutomaticSoftwareUpdates AutomaticAudits Developer FormBuilder Guide SOAP XML-RPC Operations Web System Server TCL DB-API Pound Maint. AOLServer CVS Revers Proxy Guide Mondrian Search BigBrother Engine TSearch2 Oracle Intermedia/Text Data- Sys Mgmt. Warehouse OpenACSInst. Guid Database PostgreSQL Oracle 8i, 9i, 10g Database Replication Postfix/ Operating Windows Sendmail System Linux Solaris BSD Mac OS Unix InstallGuide + CygWin © ]project-open[ 2010, Data-Model / Frank Bergmann / 2
  • 3.
    Other Documentation This isa limited overview document. For more detailed information please see:  ]po[ Wiki: http://www.project-open.org/  OpenACS Developer Guide: http://www.openacs.org/doc/  ]po[ List of packages: http://www.project- open.org/documentation/list_packages © ]project-open[ 2010, Data-Model / Frank Bergmann / 3
  • 4.
    General System Architecture ]po[ consists of three main parts: – A powerful object-relational data model – TCL pages that render the contents of the database and – TCL libraries that provide auxilary functions to the TCL pages TCL Pages  The Data Model is particularly important in ] po[ because: TCL Library – It is object-oriented – The TCL layer does not contain objects. It merely renders the content of the Data Model Data Model  The Data Model is the location where you need to go if you want to extract information from the system © ]project-open[ 2010, Data-Model / Frank Bergmann / 4
  • 5.
    General Conventions  Tables names are always in plural form and written in lower case  Tables are held in general in 2nd normal form  De-normalized table columns are named with a _cache postfix. Normal arrow means referential  All main tables have an integer primary key table_name_id. integrity relation- This primary key references the table acs_objects which contains ship between the type of the object. tables.  Most object-object mappings are handleled by the acs_rels table and its sub-types (see below). Other mapping tables are called something_something_map  Boolean fields have a _p postfix and contain 't' or 'f' char values  All main objects include object_type_id and object_status_id fields. Type is used to create minor sub-types of the objects, Big arrow tip means such as the distinction of im_companies such as customer and inheritance relation- provider. Status is used to deal with the object's lifecycle, ship. An inheriting object references such as potential, active, closed and deleted. its parent type with its object_id. © ]project-open[ 2010, Data-Model / Frank Bergmann / 5
  • 6.
    “Business Objects” © ]project-open[ 2010, Data-Model / Frank Bergmann / 6
  • 7.
    Data Model Overview– Business Objects  Most data in the ]po[ data model are acs_objects structured as “Business Objects” object_id object_type (BizObj).  A “BizObj” is just a database table im_projects following a number of conventions project_id project_name – A integer primary key called object_id project_nr company_id representing a unique object ID project_status_id project_type_id – The primary key references the project_lead_id supervisor_id “acs_objects” table. acs_objects includes … object meta-information such as object type, creation date, creation user etc. – Every ]po[ BizObj includes a field “object_status_id” re © ]project-open[ 2010, Data-Model / Frank Bergmann / 7
  • 8.
    Data Model Overview– Business Objects  The ]po[ data model is based on the notion of acs_objects “Business Objects”  A “BizObj” is just a object_id object_type database table following a number of conventions im_projects – A primary key im_categories representing a unique project_id object identifier project_name category_id – The primary key project_nr category_type references the company_id name project_status_id “acs_objects” table. description acs_objects includes project_type_id object meta-information project_lead_id such as object type, supervisor_id persons creation date, creation … user etc. person_id first_names – Every ]po[ BizObj includes last_name a field “object_status_id” and “object_type_id” to deal with the objects’ livecycle (status_id) and sub-types (type_id). persons acs_rels person_id rel_id first_names object_id_one last_name object_id_two © ]project-open[ 2010, Data-Model / Frank Bergmann / 8
  • 9.
    Data Model Overview– Business Objects  The ]po[ data model is based on the notion of “Business Objects”  A “BizObj” is just a database table following a number of conventions – A primary key representing a unique object identifier – The primary key references the “acs_objects” table. acs_objects includes object meta-information such as object type, creation date, creation user etc. – Every ]po[ BizObj includes a field “object_status_id” re © ]project-open[ 2010, Data-Model / Frank Bergmann / 9
  • 10.
    Categories © ]project-open[ 2010, Data-Model / Frank Bergmann / 10
  • 11.
    Categories object object_type Conventional/ traditional database design normally object_type_id object_type_id includes “foreign key tables” defining the type and object_status_id name status of an object. name description description ... object_status ]po[ takes a different approach in order to minimize the number of database tables and to simplify object_status_id name maintenance. We use a single im_categories table for description all types of status and type information: The Classical DB-Design: Every table has Pros: it's own tables for type, status and similar information. + The total number of DB tables is reduced to a third. + A single maintenance screen can deal with all categories. object im_categories + Built-in features: object_type_id category_id + Translation/Localization object_status_id category_type + Hierarchical categories name name description description + Common GUI widgets ... + Referential Integrity is enforced im_category_hierarchy Cons: - In theory it is possible to assign the wrong Category parent_category_id child_category_id to a field. However this has never happened in practice yet. ]po[ DB-Design: All type and status information is stored in a single im_categories table. © ]project-open[ 2010, Data-Model / Frank Bergmann / 11
  • 12.
    Categories Categories form aDAG:  A Directed Acyclic Graph is like a Tree with All multiple inheritance Companies  A DAG allows you to tag categories with don't change! meta-information Constants, CustOrIntl Categories are partly constants, partly Customers Internal Providers configurable: Consulting Freelance Agencies Providers The top level (customers, internal, providers, Freely Configurable  Law Firm Office Equ. custorintl) are used as constants by the system. Customers Providers You'll break the system if you change them. Localization Customer ... However, you can localize them.  The lower level values are freely configurable ... to the specific company structure Details for each category are found in the PO-Configuration-Guide. © ]project-open[ 2010, Data-Model / Frank Bergmann / 12
  • 13.
    Categories Sample SQL Categories Definition Select Everything About Categories -- We use categories as a universal storage for business select -- object states and types, instead of a zillion of tables c.*, -- like 'im_project_status' and 'im_project_type'. im_category_from_id(aux_int1) as aux_int1_cat, im_category_from_id(aux_int2) as aux_int2_cat, create sequence im_categories_seq start 100000; h.parent_id, create table im_categories ( im_category_from_id(h.parent_id) as parent category_id integer from constraint im_categories_pk im_categories c primary key, left outer join im_category_hierarchy h category varchar(50) not null, on (c.category_id = h.child_id) category_description varchar(4000), where category_type varchar(50), c.category_type = 'Intranet Cost Types' category_gif varchar(100) default 'category', order by enabled_p char(1) default 't' category_type, constraint im_enabled_p_ck category_id; check(enabled_p in ('t','f')), -- used to indicate abstract -- super-categorys that are not -- valid values for objects. Extract Categories Without Join -- For example: Translation -- A helper functions to make our queries easier to -- Project is not a project_type, read -- but a class of project_types. create or replace function im_category_from_id parent_only_p char(1) default 'f' (integer) constraint im_parent_only_p_ck returns varchar as ' check(parent_only_p in ('t','f')) DECLARE ); p_category_id alias for $1; v_category varchar(50); BEGIN select category Category Hierarchy into v_category -- Optional system to put categories in a hierarchy. from im_categories -- This table stores the transitive closure of the where category_id = p_category_id; -- is-a relationship between categories in a kind of matrix. -- Let's asume: B isa A and C isa B. So we'll store return v_category; -- the tupels (C,A), (C,B) and (B,A). end;' language 'plpgsql'; -- This structure is a very fast structure for asking: -- -- Example: -- is category A a subcategory of B? -- select im_category_from_id(48); -- Create a New Category Entry -- but requires n^2 storage space in the worst case and insert into im_categories ( -- it's a mess retracting settings from the hierarchy. category_id, category, category_type, -- We won't have very deep hierarchies, so storage complexity category_description, enabled_p, -- is not going to be a problem. aux_int1, aux_int2, aux_string1, aux_string2 create table im_category_hierarchy ( ) values ( parent_id integer :category_id, :category, :category_type, constraint im_parent_category_fk :category_description, :enabled_p, references im_categories, :aux_int1, :aux_int2, child_id integer :aux_string1, :aux_string2 constraint im_child_category_fk ); references im_categories, constraint category_hierarchy_un unique (parent_id, child_id) ); © ]project-open[ 2010, Data-Model / Frank Bergmann / 13
  • 14.
    ]po[ Objects andTypes acs_attributes All major ]po[ tables are Objects attribute_id  Objects are identified by an object_id. pretty_name object_type  Information about object type is stored in the acs_objects table_name table, together with metadata and creation information. column_name acs_object_types Advantages of being an object: object_type  Permission system: supertype Associates objects with privileges, including all necessary table_name maintenance screens id_column name_method  SQL metadata system: Allows the administrators to dynamically extend object types with new attributes acs_objects  Full-Text search: Indexes all objects and produces generic URL for the search object_id results object_type  Configurable workflow: Allows to manage the status of any object. The WF includes object a graphical WF editor.  Generic Object Relations: object_type_id object_status_id acs_rels allows you to define generic relationships between name objects. description ... © ]project-open[ 2010, Data-Model / Frank Bergmann / 14
  • 15.
    ]po[ Objects andTypes  acs_attributes: – Each row in acs_attributes table defines an attribute of the specified object type. – The contents of the table is managed by the intranet-dynfield package that contains a SQL metadata editor.  acs_privileges: – Contains permissions tokens (= privileges). These privileges allow a user to perform a certain operation in the system.  acs_permissions: – Defines a mapping between acs_objects and acs_privileges. – The mapping is per user group (grantee_id). Groups can be hierarchical. © ]project-open[ 2010, Data-Model / Frank Bergmann / 15
  • 16.
    Main Object Types © ]project-open[ 2010, Data-Model / Frank Bergmann / 16
  • 17.
    Main Object Types acs_objects object_id object_type acs_rels groups parties users_contact rel_id group_id party_id object_id_one group_name email Home Address object_id_two url Work Address im_profiles im_biz_objects persons im_employees profile_id object_id person_id Payroll Info profile_gif first_names Recruiting Info last_name im_freelancers im_companies im_offices im_projects users Freelance Info company_id office_id project_id user_id company_name company_id project_name username company_status_id office_status_id project_nr password company_type_id office_type_id project_path salt main_office_id Address customer_id auth_token primary_contact_id project_status_id accounting_contact_id project_type_id vat_number project_lead_id note supervisor_id project_budget budget_currency budget_hours start_date end_date description note © ]project-open[ 2010, Data-Model / Frank Bergmann / 17
  • 18.
    Main Types  im_biz_objects: – This abstract type defines a number of functions to manage horizontal permissions (= Please see other ]po[ documentation) for project, companies and offices – Horizontal permissions currently include roles such as Project Manager of Full Member.  parties, persons, users: – These three tables form an inheritance hierarchy. There is a view cc_users that unifies the information from these tables.  im_freelancers, im_employees, users_contact: – These are extension tables for persons and define additional information for users with particular profiles.  im_profiles: – This table defines the groups that are relevant for ]po[, as opposed to potentially hundreds of groups of the underlying OpenACS system. © ]project-open[ 2010, Data-Model / Frank Bergmann / 18
  • 19.
    Users, Groups andTheir Relationships Users and their groups in ]po[ are modeled Groups Relations User Types using a number of types and tables: groups acs_rels parties  User information is stored in 5 different users_contact tables, depending on the type of user group_id rel_id party_id (see below). group_name object_id_one email Home Address  General (OpenACS) groups consist of a object_id_two url Work Address basic “groups” table. The groups (“profiles”) used in ]po[ “profiles” are identified by an entry in “profiles”. im_profiles persons im_employees  A user-group membership is established membership when creating a “membership_rel” profile_id between the two. The membership_rel profile_gif _rels person_id Payroll Info first_names Recruiting Info consists of an acs_rels entry mapping rel_id the user to the group, plus a last_name member_state membership_rels entry containing the information about the member state im_freelancers (“active”). To disable a membership, you users can update the member_state to Freelance Info “deleted”. user_id username This way of modeling users allows to password dynamically extend users, groups and salt their relations. This is heavily used in ]po[ (for example there is an “employee_rel”). auth_token However, it adds a certain overhead (9 tables instead of 3). User Types:  Party: Super-type of both “person” “group” and “im_company”, allowing to compose new groups of both users and groups.  Person: Represents a natural person with first- and last name  User: Contains the login information necessary for a person to participate in ]project-open[  users_contact: Extension table with address information  im_employees: Extension table with employee information  im_freelancers: Extension table with freelancer information © ]project-open[ 2010, Data-Model / Frank Bergmann / 19
  • 20.
    Financial Types acs_objects object_id  All financial objects in ]po[ are based on the object object_type type “Cost Item” in table “im_cost”. This table contains the common information shared across all Inheritance! types of cost items. im_costs im_payments  The field im_cost.cost_type_id determines the cost_id payment_id specific type of the cost item. im_invoices cost_name cost_id  The following cost sub-types are derived from the cost_nr company_id “Cost Item” base type: invoice_id cost_status_id provider_id – Timesheet Cost – The monthly cost of an company_contact_id employee cost_type_id received_date invoice_nr payment_type_id – Expense Bundle – A collected and “bundled” group invoice_office_id project_id of Expense Items (see below) payment_status_id customer_id amount  “Expense” is a sub-type of Cost Item. Expenses im_invoice_items provider_id currency represent money paid by employees to external cost_center_id note companies. Expenses are bundled together as item_id investment_id “Expense Bundles”. These Expense Bundles are item_name template_id typically approved by the finance department and the project_id effective_date_id im_cost_centers reimbursed to the employee. Sub-types of Expense invoice_id payment_days refer to the different types of expenses: item_units amount cost_center_id – Airfare item_uom_id currency cost_center_name – Taxi price_per_unit paid_amount cost_center_code – Book currency paid_currency cost_center_type_id – … sort_order cost_center_status_id tax department_p  “Financial Document” is a sub-type of Cost Item item_type_id vat implementing any financial items with lines in it. Sub- item_status_id description types include: description note im_expenses – Customer Invoice – Delivery Note expense_id – Quote ext._company_name – Provider Bill ext._comp._vat_num. – Purchase Order billable_p  “Repeating Costs” are not yet 100% implemented in ] reimbursable po[ as of 3.4.0.8.9. This type will represent recurring bundle_id cost items in the future, including monthly service fees, employee salaries etc.2010, Data-Model / Frank Bergmann / 20 © ]project-open[
  • 21.
    Financial Types  im_costs: – This is the main table for all cost items. – All financial elements in the system are stored in this table. The table also receives updates from timesheet (cost related to users working on a project) etc.  im_cost_centers: – Is currently not used. The table has been included in the current datamodel for smooth upgrade in future versions.  im_invoices: – This table contains financial documents such as Invoices, Quotes, Bills and Purchase Orders (the name im_invoices is a bit misleading).  im_invoice_items: – These are the individual lines of an invoice. © ]project-open[ 2010, Data-Model / Frank Bergmann / 21
  • 22.
    Financial Types (2) Relationshipbetween Costs and Projects acs_rels rel_id object_id_one select distinct c.cost_name, object_id_two im_category_from_id(c.cost_type_id) as cost_type, c.amount * im_exchange_rate(c.effective_date::date, c.currency, 'EUR') as amount_converted im_projects from im_costs im_projects main_p, im_projects sub_p, project_id acs_rels r, … cost_id im_costs c where cost_name main_p.project_id = :main_project_id and cost_nr sub_p.tree_sortkey between main_p.tree_sortkey and tree_right(main_p.tree_sortkey) and … r.object_id_one = sub_p.project_id and project_id r.object_id_two = c.cost_id A sample query to extract all financial items related to a certain main-project. The Problem: Cost and Projects can have a N:M relationship:  One project may have more then one invoice/cost item.  One cost item may “relate” to more then one project (in particular: project + sub-project, but also the item may be split between two main projects).  An invoice may actually not belong to any project at all. Solution:  In general, the relationship between projects and costs is defined as an N:M relationship by acs_rel.  im_costs.project_id points to im_projects ONLY in the case that one cost item relates to exactly one project Watch out:  Relation between Projects and Costs: – im_cost.project_id: Refers to the project only if there is exactly one project per cost item – acs-rels: Establishes a N:M relationship between projects and cost items. This is used to include several (small) projects in a single invoice.  Cost Items can be related to a main-project or to a sub-project or any level. So in order to calculate the main project’s total Profit Loss, you need to sum up the financial items through the full project tree (hierarchical query) © ]project-open[ 2010, Data-Model / Frank Bergmann / 22
  • 23.
    Financial Types (3) Example Main project im_projects project_id … Sub-project with cost item im_projects acs_rels im_costs project_id rel_id cost_id parent_id object_id_one cost_name … object_id_two cost_nr … project_id im_projects Sub-project project_id with cost item parent_id … © ]project-open[ 2010, Data-Model / Frank Bergmann / 23
  • 24.
    Relationship Types acs_objects object_id object_type acs_rel_type rel_type object_type_one acs_rels object_type_two role_one rel_id role_two rel_type object_id_one min_n_rels_one object_id_two max_n_rels_one min_n_rels_two max_n_rels_two membership_rels composition_rels admin_rels group_rels rel_id rel_id rel_id rel_id member_state rel_type group_id im_biz_object_members Defines the relationships between an rel_id im_biz_object and some users. The membership object_role_id type corresponds to horizontal permissions and usually includes full member, project manager, key account and user-defined roles. © ]project-open[ 2010, Data-Model / Frank Bergmann / 24
  • 25.
    Relationship Types  acs-rels: – The acs_rels table is essentially a generic mapping table for acs_objects. Once we come up with a way to associate attributes with relationship types, we could replace many of the ACS 3.x mapping tables like user_content_map, user_group_map, and user_group_type_modules_map with this one table. Much application logic consists of asking questions like Does object X have a relationship of type Y to object Z? where all that differs is X, Y, and Z. Thus, the value of consolidating many mapping tables into one is that we can provide a generic API for defining and querying relationships. In addition, we may need to design a way to enable type_specific storage for relationships (i.e., foreign key columns for one-to-many relationships and custom mapping tables for many-to- many relationships), instead of only supporting generic storage in the acs_rels table. This would parallel what we do with acs_attributes.  im_biz_object_members: – Defines the member of a im_biz_object and their roles (project manager of full member). – Such a membership has an impact on the access rights of members to the business object.  membership_rels: Defines group-supergroup relations © ]project-open[ 2010, Data-Model / Frank Bergmann / 25
  • 26.
    Translation Types acs_objects object_id object_type im_trans_tasks im_costs task_id task_name im_trans_prices task_filename task_status_id price_id im_invoices project_id company_id task_type_id task_type_id source_language_id source_lang_id target_language_id target_lang_id subject_area_id subject_area_id im_trans_invoices task_uom_id uom_id invoice_id currency quote_id price end_date note task_units billable_units im_trans_quality_reports trans_id report_id edit_id im_trans_trados_matrix proof_id task_id report_date other_id object_id reviewer_id match_x match_x sample_size match_rep match_rep allowed_errors match_100 match_100 total_errors match_95 match_95 comments match_85 match_85 match_75 match_75 im_trans_quality_entries match_50 match_50 match_0 match_0 report_id quality_category_id note minor_errors major_errors critical_errors © ]project-open[ 2010, Data-Model / Frank Bergmann / 26
  • 27.
    Translation Types  im_trans_tasks: – This tables contains the description of the main activity related to translation projects. – Includes information about Translation Memory repetitions – Inludes information about the translator, editor, proof-reader and other assigned to perform this task (static workflow)  im_trans_invoices: – This is currently just a flag (binary information) to identify invoices that have been created based on im_trans_tasks. Translation invoices are referenced by im_trans_tasks.invoice_id in order to make sure that every trans_task is included in exactly one invoice. These references need to be removed if a translation invoice is deleted.  im_trados_matrix: – Contains the discounts per customer and translation task type for different Translation Memory matches. – The trados_matrix associated with the internal company contains the site-wide defaults for customer translation prices. © ]project-open[ 2010, Data-Model / Frank Bergmann / 27
  • 28.
    Timesheet Types acs_objects object_id object_type im_timesheet_prices price_id company_id im_costs im_projects task_type_id material_id project_id uom_id project_name currency customer_id price im_invoices project_type_id note start_date end_date im_ts_task_deps. im_ts_invoices ... task_id_one task_id_two dependency_type_id difference hardness_type_id im_tickets im_timesheet_tasks ticket_id task_id im_materials ticket_status_id material_id material_id ticket_type_id uom_id material_name ticket_prio_id planned_units material_nr ticket_customer_contact_id billable_units material_type_id ticket_assignee_id cost_center_id material_status_id ticket_sla_id invoice_id material_uom_id ticket_queue_id priority description © ]project-open[ 2010, Data-Model / Frank Bergmann / 28
  • 29.
    Consulting Types  im_timesheet_tasks: – This tables contains the description of the main activity related to projects.  im_timesheet_invoices: – This is currently just a flag (binary information) to identify invoices that have been created based on im_timesheet_tasks. Timesheet invoices are referenced by im_timesheet_tasks.invoice_id in order to make sure that every task is included in exactly one invoice. These references need to be removed if a timesheet invoice is deleted.  im_timesheet_prices: – Contains a price per material and customer. – The timesheet_prices associated with the internal company contains the site-wide default price list. © ]project-open[ 2010, Data-Model / Frank Bergmann / 29
  • 30.
    Workflow © ]project-open[ 2010, Data-Model / Frank Bergmann / 30
  • 31.
    Workflow  ]po[ usesa Petri-Net based workflow Workflow  A workflow consists of “Places” (states) Start- and “Transitions”, linked by “Arcs” that Place might carry “Guard” expressions.  WF “Transitions” can be linked to pages Transition acting on object’s fields Place Place Transition [Guard] [Guard] End- Place © ]project-open[ 2010, Data-Model / Frank Bergmann / 31
  • 32.
    WF @ Runtime During runtime, a similar structure is Case created representing a specific “Case” (a specific instance of a WF): Start- – The “case” corresponds to a WF in action. Place – Transitions become “tasks”, with specific assignments to users. Task – Places may include “tokens” that move through transitions to other places. A single token in a WF place can be thought as “the Place Place WF is in status XXX”.  Petri-Nets allow for more then one token and more then one token per place, but Task this option is rarely used in ]po[. [Guard] [Guard] End- Place © ]project-open[ 2010, Data-Model / Frank Bergmann / 32
  • 33.
    WF Tables Static Workflow Case Assignments wf_workflows wf_cases workflow_key case_id workflow_key object_id state wf_roles wf_transitions wf_tasks transition_key task_id role_key workflow_key case_id workflow_key role_key transition_key direction state wf_places wf_tokens place_key token_id workflow_key case_id place_key state wf_arcs transition_key place_key direction © ]project-open[ 2010, Data-Model / Frank Bergmann / 33
  • 34.
    WF “Callbacks” Transition “Callbacks” are Pl/SQL database States procedures that determine the behavior “Enable” of a transition: “Unassigned” Enable  A number of “Outgoing Events” allow to customize the behavior of WF transitions: Enabled – Enable: Is called when the transition is “Fire” enabled (a token is placed in one of its input Start places) – Unassigned: Is called if the transition hasn’t Time Started been statically (see below) assigned to a user Deadline or a group. – Fire: Is called once the transition gets fired Hold Timeout Finish Cancel Notification  A number of transition’s parameters can be Can determined by external routines: Finished celed – Time: “Fire” – Deadline: autom – Hold Timeout – Notification © ]project-open[ 2010, Data-Model / Frank Bergmann / 34
  • 35.
    WF Assignments Transition  “Static Assignments”: States – Specified during the definition of the WF – Specified using WF “roles”. Each role can be Enable assigned to one or multiple parties (groups or users) Enabled – Specified as “roles” using wf_transition.role_key and then mapped to Start parties using wf_context_assignments. – The specific assignments at runtime are held Started in wf_task_assignments. – This construction might seem a bit complex, but it is necessary, as you will find out when Finish Cancel defining your first real WFs.  “Dynamic Assignments” Finished Can celed – Use the “Unassigned” callback to define the assigned parties. – This option allows you to specify the assignee autom as a function of object characteristics etc. – The results of dynamic assignments are stored in wf_task_assignments. © ]project-open[ 2010, Data-Model / Frank Bergmann / 35
  • 36.
    Timesheet Controlling © ]project-open[ 2010, Data-Model / Frank Bergmann / 36
  • 37.
    Timesheet Controlling Requirements and Architecture  Controlling uses caches per project in order to maintain aggregated Profit Loss (PL) information.  The project caches are updated via triggers  Reporting on portfolios customers is handled by the reporting engine. Customer Main Sub “Timesheet” Customer Group Project Project Task “Backward” Reporting “Forward” Propagation Values are summarized via Reports Costs are cached. Caches are updated via triggers © ]project-open[ 2010, Data-Model / Frank Bergmann / 37
  • 38.
    Timesheet Controlling Controlling cache architecture im_projects  Projects contain a set of “xxx_cache” fields that contain the aggregated cost elements per type. project_id …  CUD (create, update, delete) operations on cost_quotes_cache cost_invoices_cache costs (timesheet hours, expenses, …) does NOT cost_timesheet_planned_cache cost_purchase_orders_cache update the caches, for performance reasons. cost_bills_cache cost_timesheet_logged_cache Instead, cost_expense_planned_cache triggers reset the cost_expense_logged_cache cost_delivery_notes_cache “cost_cache_dirty” to NULL. “Sweeper” reported_hours_cache Process cost_cache_dirty  There is a “sweeper” process that periodically checks “cost_cache_dirty” and updates the cache. This might be a nightly activity, or every few minutes. © ]project-open[ 2010, Data-Model / Frank Bergmann / 38
  • 39.
    Timesheet Controlling The hours are aggregated from tasks up to main projects Controlling cache architecture Project reported cost_ts cach hours logged e_dirt y Main Project (9) Sub Project1 (4) im_hours Task1.1 4 user_id Task1.2 project_id SubProject2 (5) day Task2.1 3 hours Task2.2 2 billing_rate billing_currrency conf_project_id note refers to the main project. All sub im_costs projects and tasks cost_id are included. conf_object_id cost_id … im_ts_conf_objects conf_id conf_project_id conf_user_id between start_date end_date conf_status_id conf_type_id © ]project-open[ 2010, Data-Model / Frank Bergmann / 39
  • 40.
    Hierarchical Queries Main Project Sub-Project 1 Sub-Project 1.1 Sub-Project 1.2 Sub-Project 2 Sub-Project 2.1 Sub-Project 2.2 © ]project-open[ 2010, Data-Model / Frank Bergmann / 40
  • 41.
    Auxiliary Tables © ]project-open[ 2010, Data-Model / Frank Bergmann / 41
  • 42.
    Auxilary Tables GUI  Define what plugins (these grey boxes) should appear on what im_component_plugins page Menu  Defines the hierarchical menu structure of the system ViewColumn  Define the columns for ListPages in the core. The ListPages view need to be extensible at runtime because they might have to accomodate new columns from add-on modules View  The list of all countries in the world Country  The list of all currencies Currency © ]project-open[ 2010, Data-Model / Frank Bergmann / 42
  • 43.
    Auxilary Tables GUI  Define what plugins (these grey boxes) should appear on what im_component_plugins page Menu  Defines the hierarchical menu structure of the system ViewColumn  Define the columns for ListPages in the core. The ListPages view need to be extensible at runtime because they might have to accomodate new columns from add-on modules View  The list of all countries in the world Country  The list of all currencies Currency © ]project-open[ 2010, Data-Model / Frank Bergmann / 43
  • 44.
    ]project-open[ As a setof services © ]project-open[ 2010, Data-Model / Frank Bergmann / 44
  • 45.
    ]po[ As aset of Services  The difficulty of learning OpenACS and ] po[ are mostly due to learning and understanding the “infrastructure” of OpenACS and to learn how to plug new functionality into the existing infrastructure. © ]project-open[ 2010, Data-Model / Frank Bergmann / 45
  • 46.
    Services Provided byOpenACS / ]po[ Part I: SQL  Packages Package Manager  Object Oriented Data Model – PL/SQL Constructors Destructors  Permissions  Business Objects – Status Lifecycle Management – Type – Subtype Management – DynFields  ]po[ Categories  PostgreSQL – Referential Integrity – Indices – Unique Constraints – Triggers Transactions – Constraints – Hierarchical Objects Queries  “Portlet” Plug-in Components  Menu Tabs © ]project-open[ 2010, Data-Model / Frank Bergmann / 46
  • 47.
    Services Provided byOpenACS / ]po[ Part II: TCL  TCL Pages vs. Library  Constants  Packages Package Permissions  Page Contracts  Colon Variables  Authentication System User Management  TCL Permission API  Context Bar  Cascading TCL/ADP Template System  “return_url” Pattern  List Builder  Form Builder  db_foreach Database Interface  ]po[ Navbar System  Localization System  Oracle/PostgreSQL Database Support  API-Browser © ]project-open[ 2010, Data-Model / Frank Bergmann / 47
  • 48.
    Frank Bergmann frank.bergmann@project-open.com www.project-open.com © ]project-open[ 2010, Data-Model / Frank Bergmann / 48
