3-0 PROJECT PLANNING - The purpose of Project Planning is to define the exact parameters of a project and ensure that all the pre-requisites for Project Execution and Control are in place.
Project Planning is an opportunity to identify and resolve any remaining issues and answer outstanding questions that may undermine the goals of the project or threaten its success. It is an opportunity to plan and prepare, as opposed to react and catch up.
3-0 PROJECT PLANNING - The purpose of Project Planning is to define the exact parameters of a project and ensure that all the pre-requisites for Project Execution and Control are in place.
Project Planning is an opportunity to identify and resolve any remaining issues and answer outstanding questions that may undermine the goals of the project or threaten its success. It is an opportunity to plan and prepare, as opposed to react and catch up.
Are you thinking to craft a good PPT on project execution? Not to worry! We have come up with the project execution PowerPoint presentation slides that will help you build up your key program deliverables. Using our project management PPT designs, you can promote your business plan by specifying project quality management, work plan, etc. Furthermore, these control execution PPT graphics have been incorporated by highly qualified designers & with extensive research. Furthermore, our project development presentation illustrations cover all the related templates such as project progress summary, issues management, line chart, clustered column chart and many more. What more do you expect? In addition to this, execution plan PowerPoint designs can also be used for similar topics such as program documentation, execution plan, earned value management, risk analysis matrix, resource allocation, critical path method, product benefit realization, program charter, and responsibility assignment matrix. So without wasting your time, just grab our PowerPoint Visuals. Evaluate concepts with our Project Execution Powerpoint Presentation Slides. Be able to assess the depth behind it. https://bit.ly/3y8LoTy
4-0 PROJECT EXECUTION AND CONTROL - The purpose of Project Execution and Control is to develop the product or service that the project was commissioned to deliver. Typically, this is the longest part of the project management lifecycle, where most resources are applied.
The conclusion of Project Execution and Control arrives when the product of the project is fully constructed, commissioned, accepted, and transitioned to the Client.
Accurate records need to be kept throughout Project Execution and Control. They serve as input to the final step, Project Closeout.
Project Management Training in Indonesia - Module 05 Project Closing ProcessAlin Veronika
A brief description about Applied Project Management Course.
In this course, you will be introduced to the core knowledge required around project management skills and key initiatives for quality, human resource, communications, risk management, and procurement management.
Aligned with the Project Management Institute’s A Guide to the Project Management Body of Knowledge (PMBOK® Guide) latest edition, this course will build new competencies and skills to complete an extensive, realistic, project case study. This course is designed to master the core principles of project management and gain the hands-on confidence to practice new skills in your organizations.
You will propose, plan and execute a full-scale project under typical organizational constraints. You will work together in teams with other participants and each team member will take a turn as project manager, defining objectives and performing tasks and producing deliverables critical to the project success. Follow your project through the life cycle, resolving issues of performance, scheduling and control as you address questions of leadership and management.
At the conclusion of the course, you will provide a closing presentation to the project sponsor that includes a thorough review of the results, lessons learned, and recommendations for improvements.
For more information:
PT. Avenew Indonesia
Tel: +62 21 3005 3639
HP: +62 812 9788 2500 (Bayu)
Email: info@avenew-indonesia.com
Web: avenew-indonesia.com
blog: http://avenew-indonesia.blogspot.com
A contracting and project management firm, The Dalton Company has been involved with significant projects for nonprofits, including Toronto’s Wychwood Barns. Using ArtsBuild’s online guide to capital projects PLAN IT | BUILD IT, The Dalton Company discusses the planning and decision-making needed to deliver projects on budget and in time.
2-0 PROJECT STARTUP - The purpose of Project Startup is to begin to define the overall parameters of a project and to establish the appropriate project management and quality environment required to complete the project.
Are you thinking to craft a good PPT on project execution? Not to worry! We have come up with the project execution PowerPoint presentation slides that will help you build up your key program deliverables. Using our project management PPT designs, you can promote your business plan by specifying project quality management, work plan, etc. Furthermore, these control execution PPT graphics have been incorporated by highly qualified designers & with extensive research. Furthermore, our project development presentation illustrations cover all the related templates such as project progress summary, issues management, line chart, clustered column chart and many more. What more do you expect? In addition to this, execution plan PowerPoint designs can also be used for similar topics such as program documentation, execution plan, earned value management, risk analysis matrix, resource allocation, critical path method, product benefit realization, program charter, and responsibility assignment matrix. So without wasting your time, just grab our PowerPoint Visuals. Evaluate concepts with our Project Execution Powerpoint Presentation Slides. Be able to assess the depth behind it. https://bit.ly/3y8LoTy
4-0 PROJECT EXECUTION AND CONTROL - The purpose of Project Execution and Control is to develop the product or service that the project was commissioned to deliver. Typically, this is the longest part of the project management lifecycle, where most resources are applied.
The conclusion of Project Execution and Control arrives when the product of the project is fully constructed, commissioned, accepted, and transitioned to the Client.
Accurate records need to be kept throughout Project Execution and Control. They serve as input to the final step, Project Closeout.
Project Management Training in Indonesia - Module 05 Project Closing ProcessAlin Veronika
A brief description about Applied Project Management Course.
In this course, you will be introduced to the core knowledge required around project management skills and key initiatives for quality, human resource, communications, risk management, and procurement management.
Aligned with the Project Management Institute’s A Guide to the Project Management Body of Knowledge (PMBOK® Guide) latest edition, this course will build new competencies and skills to complete an extensive, realistic, project case study. This course is designed to master the core principles of project management and gain the hands-on confidence to practice new skills in your organizations.
You will propose, plan and execute a full-scale project under typical organizational constraints. You will work together in teams with other participants and each team member will take a turn as project manager, defining objectives and performing tasks and producing deliverables critical to the project success. Follow your project through the life cycle, resolving issues of performance, scheduling and control as you address questions of leadership and management.
At the conclusion of the course, you will provide a closing presentation to the project sponsor that includes a thorough review of the results, lessons learned, and recommendations for improvements.
For more information:
PT. Avenew Indonesia
Tel: +62 21 3005 3639
HP: +62 812 9788 2500 (Bayu)
Email: info@avenew-indonesia.com
Web: avenew-indonesia.com
blog: http://avenew-indonesia.blogspot.com
A contracting and project management firm, The Dalton Company has been involved with significant projects for nonprofits, including Toronto’s Wychwood Barns. Using ArtsBuild’s online guide to capital projects PLAN IT | BUILD IT, The Dalton Company discusses the planning and decision-making needed to deliver projects on budget and in time.
2-0 PROJECT STARTUP - The purpose of Project Startup is to begin to define the overall parameters of a project and to establish the appropriate project management and quality environment required to complete the project.
This talk given at MeetMagento Poland 2014 presents my experience with doing Agile development and its challenges on development vs support projects. It will be a practical approach to project management, with how Agile can be applied inside a modern web development agency. Talk covers resource assignment, Scrum, Kanban, developer empowerment and continuous delivery with client satisfaction.
Your Strategy Guide for Managing Project ScopeMatthew Hunt
A guide created and presented by Afteractive and Sevenality for web and tech project teams on how to manage scope changes better. This presentation covers strategies for mitigating the impact of scope risk and planning a well-defined scope of work.
BEST PRACTICES FOR COMMUNICATING WITH KEY PROJECT STAKEHOLDERS A Case StudyEna Arel
Convincing the organization to embrace a new IA is no small task. Effective communication with key project stakeholders is essential for winning—and keeping—their support in managing change. Cross-functional stakeholders typically present diverse and, sometimes, conflicting requirements that must be successfully reconciled. This presentation describes how the Mathworks Documentation Group engaged with various stakeholders across the organization to redesign and implement a new Help system over the past three years. Learn how our communication strategies and tactics helped us to build organizational consensus around requirements and structure design reviews to inspire support for the new IA across the organization.

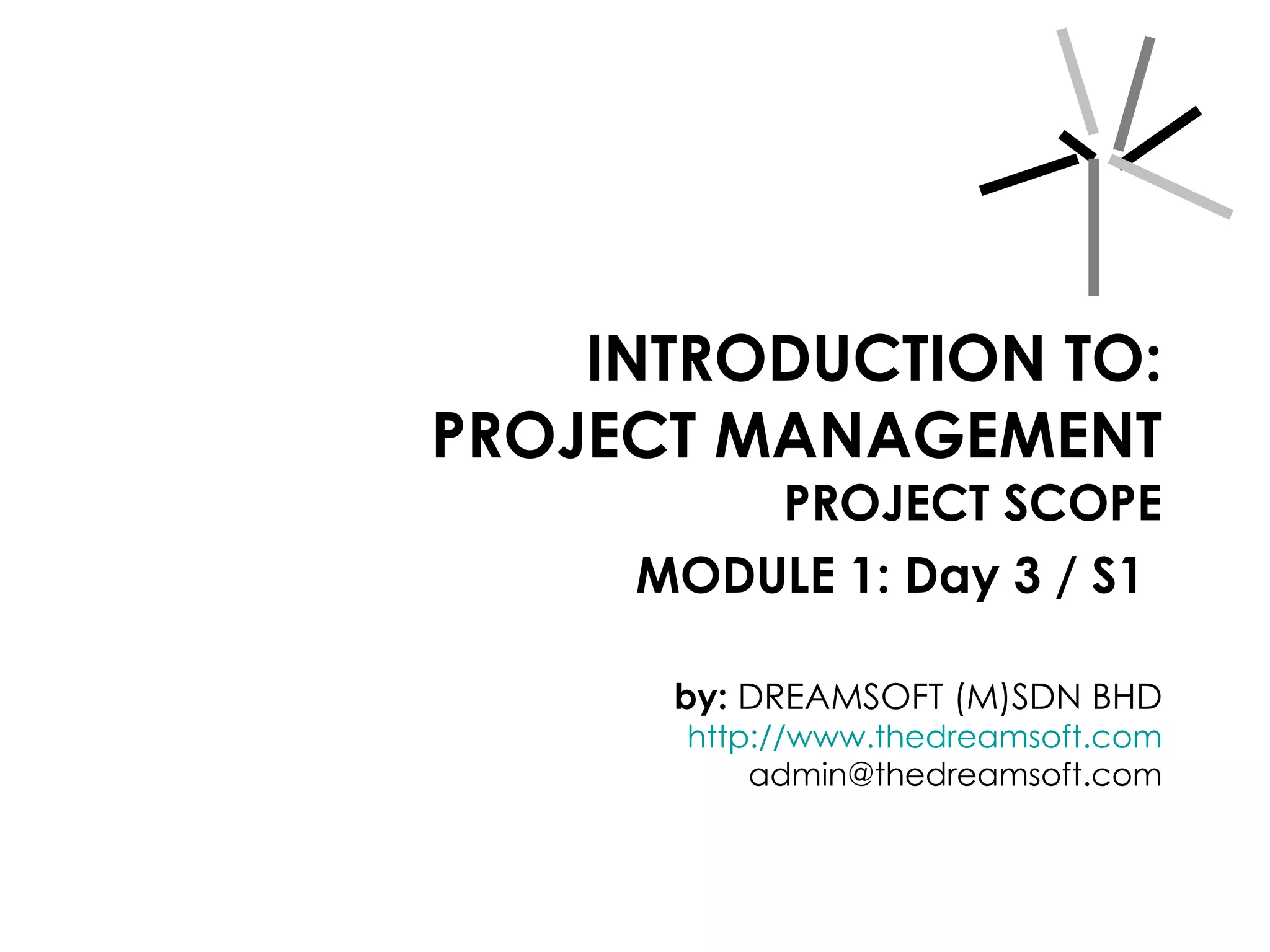

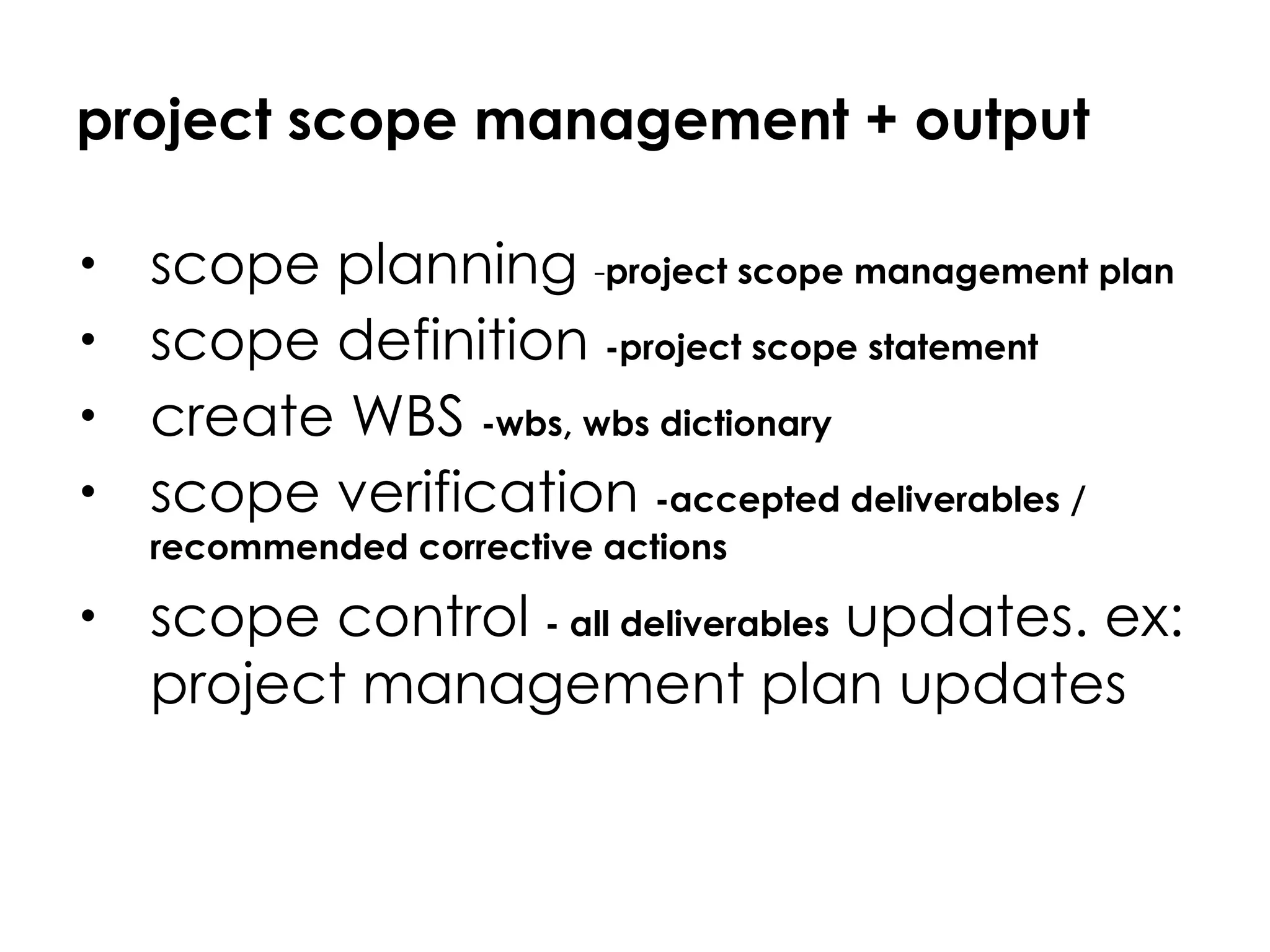

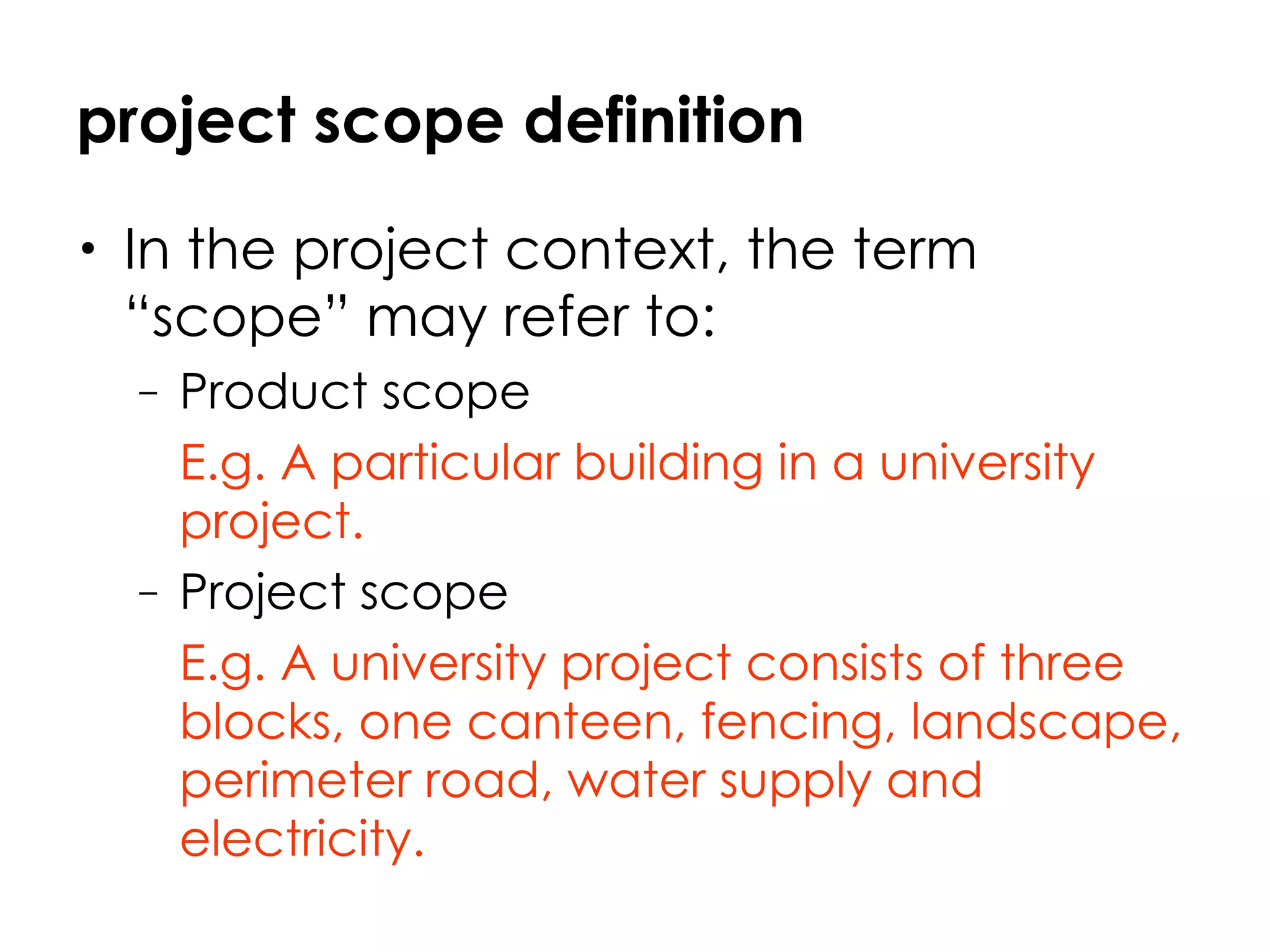

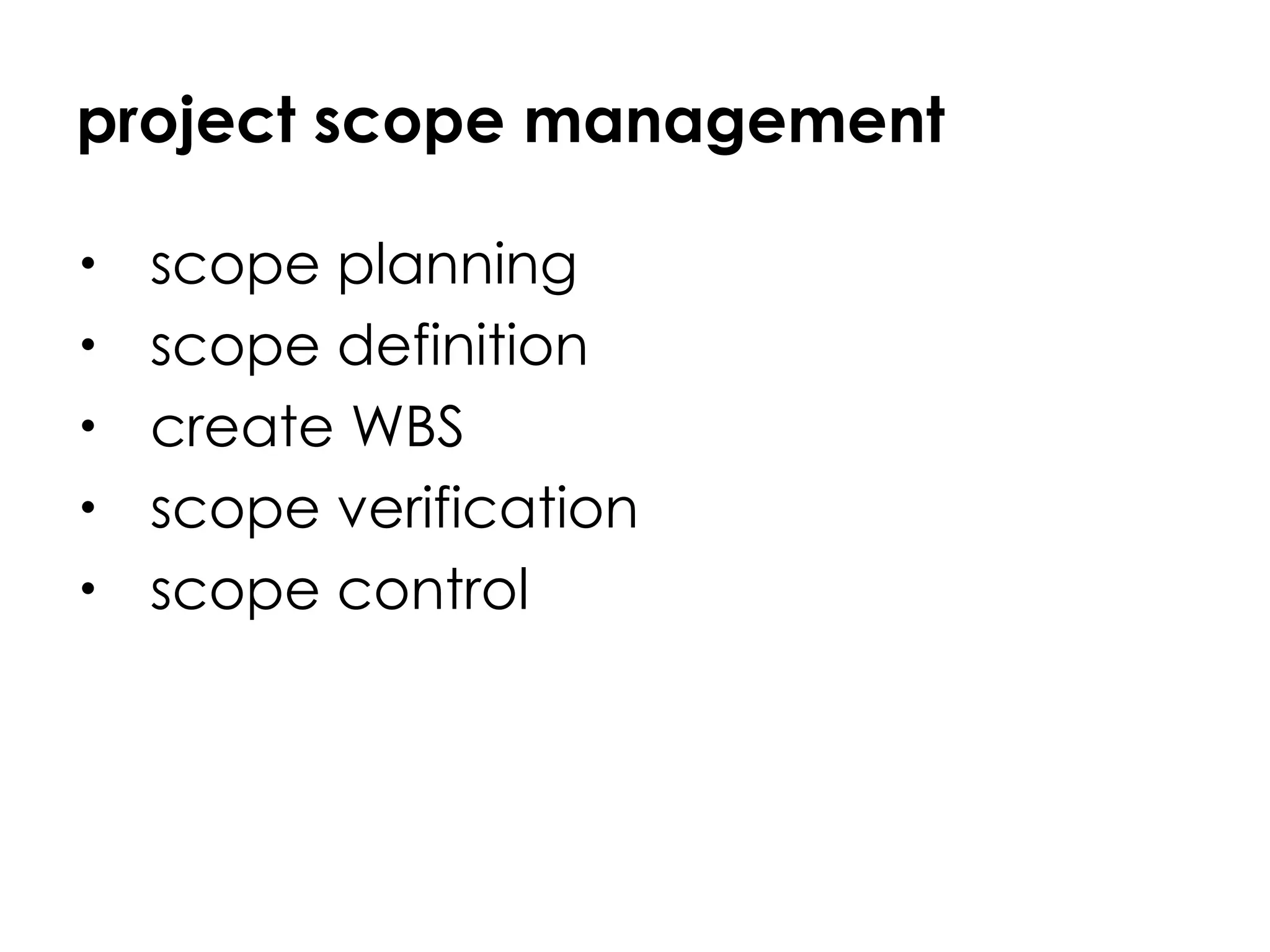

Episode 21 : Project Scope Management

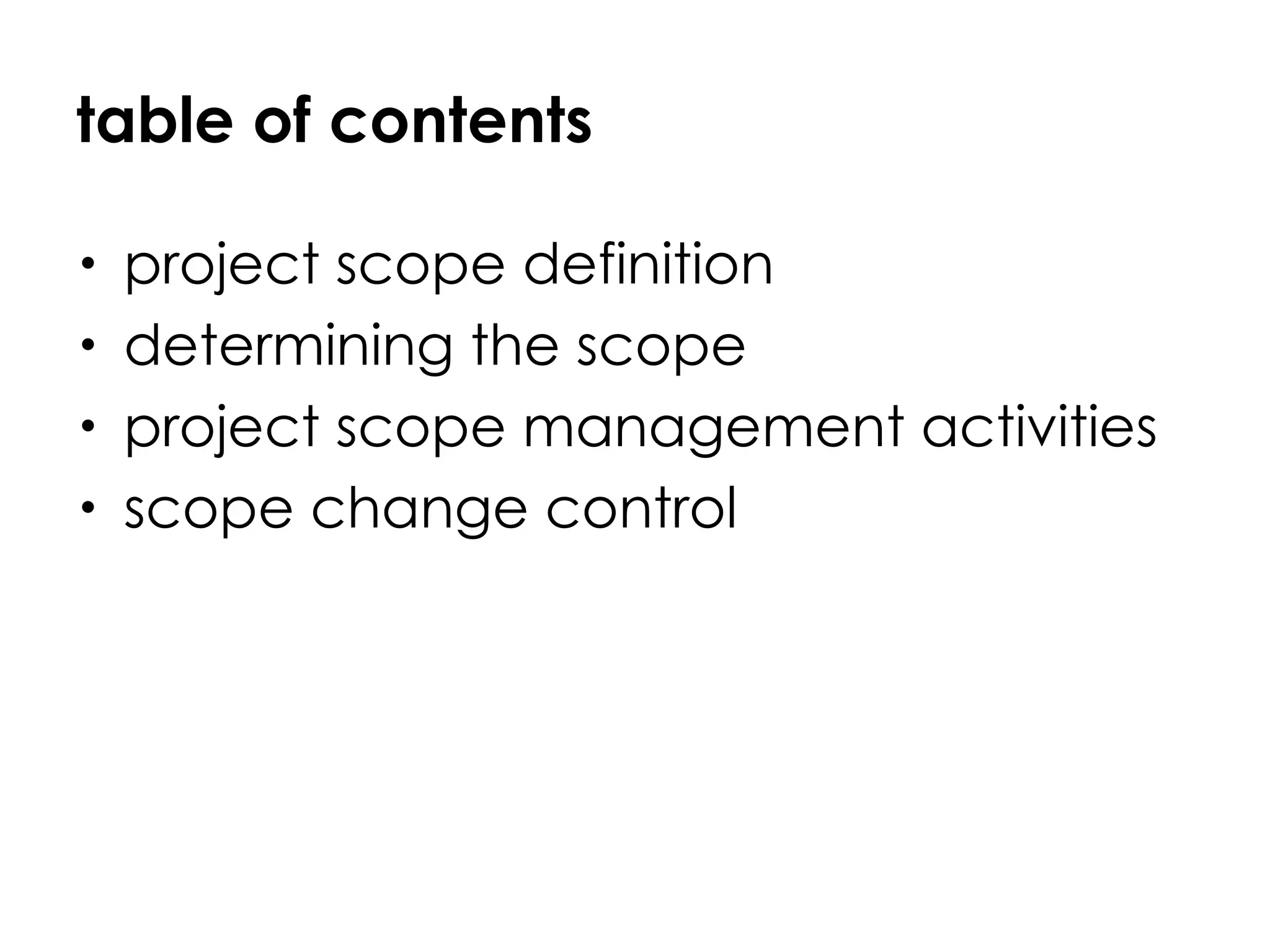

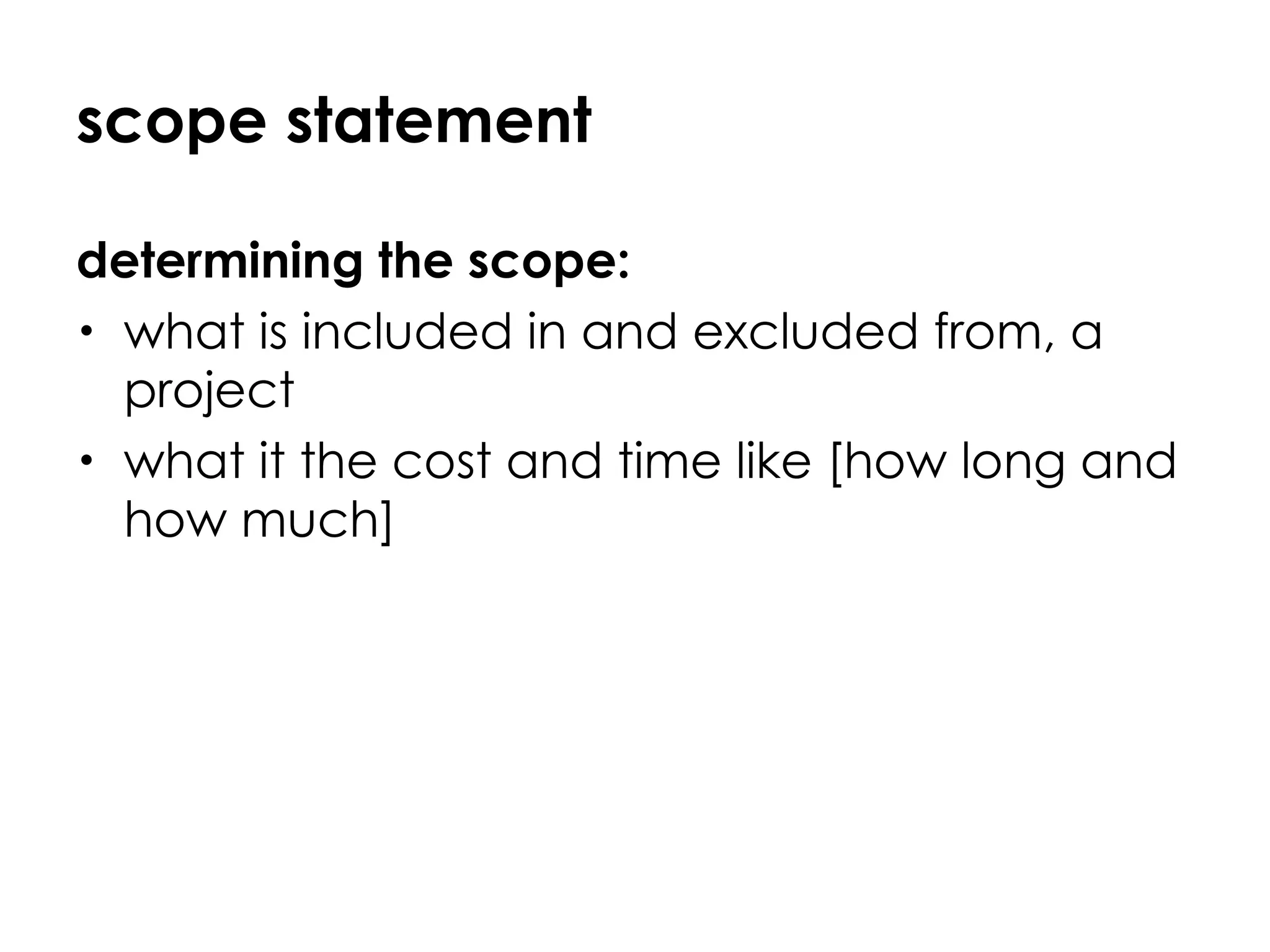

Introduction to Project scope management

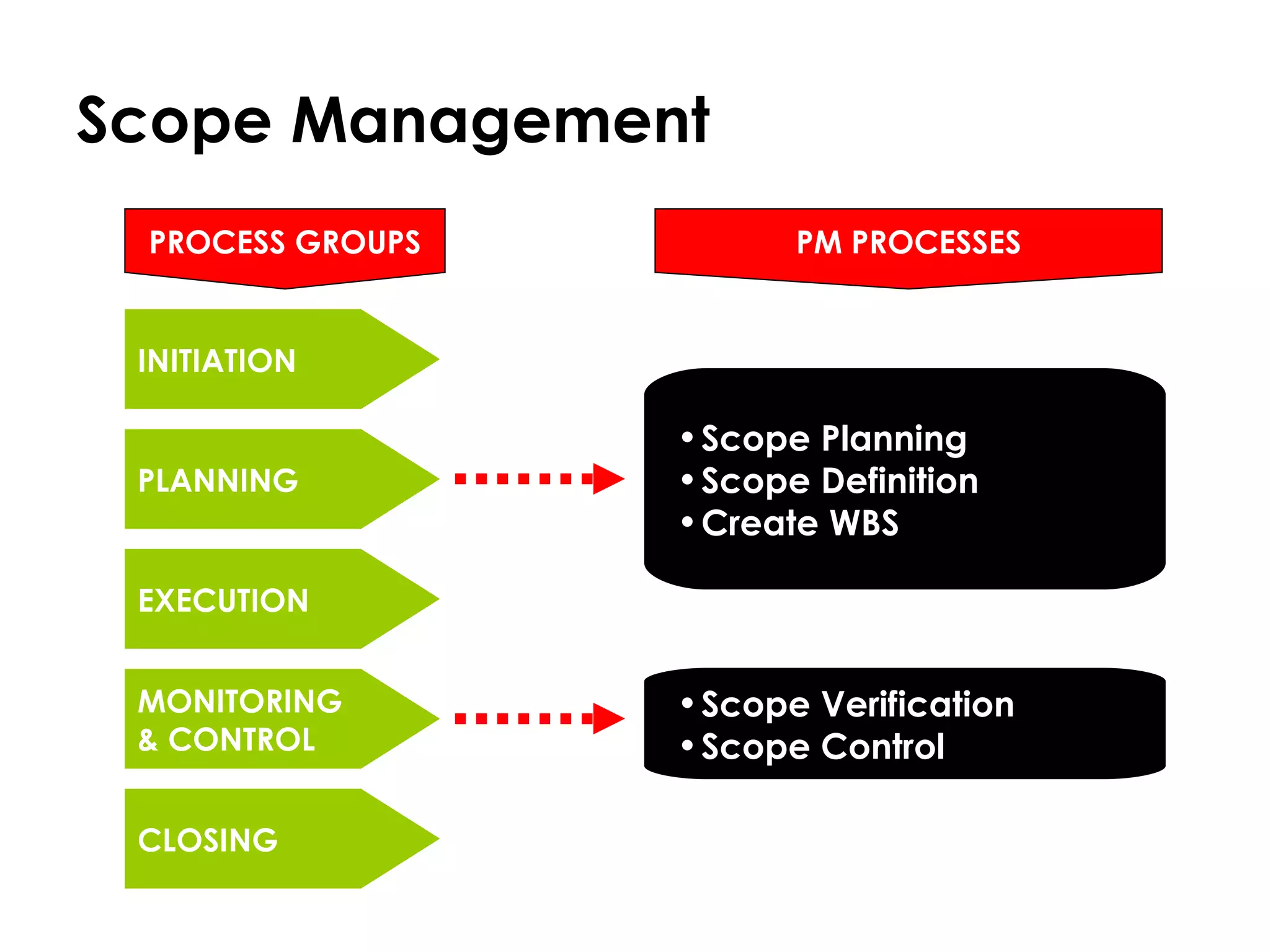

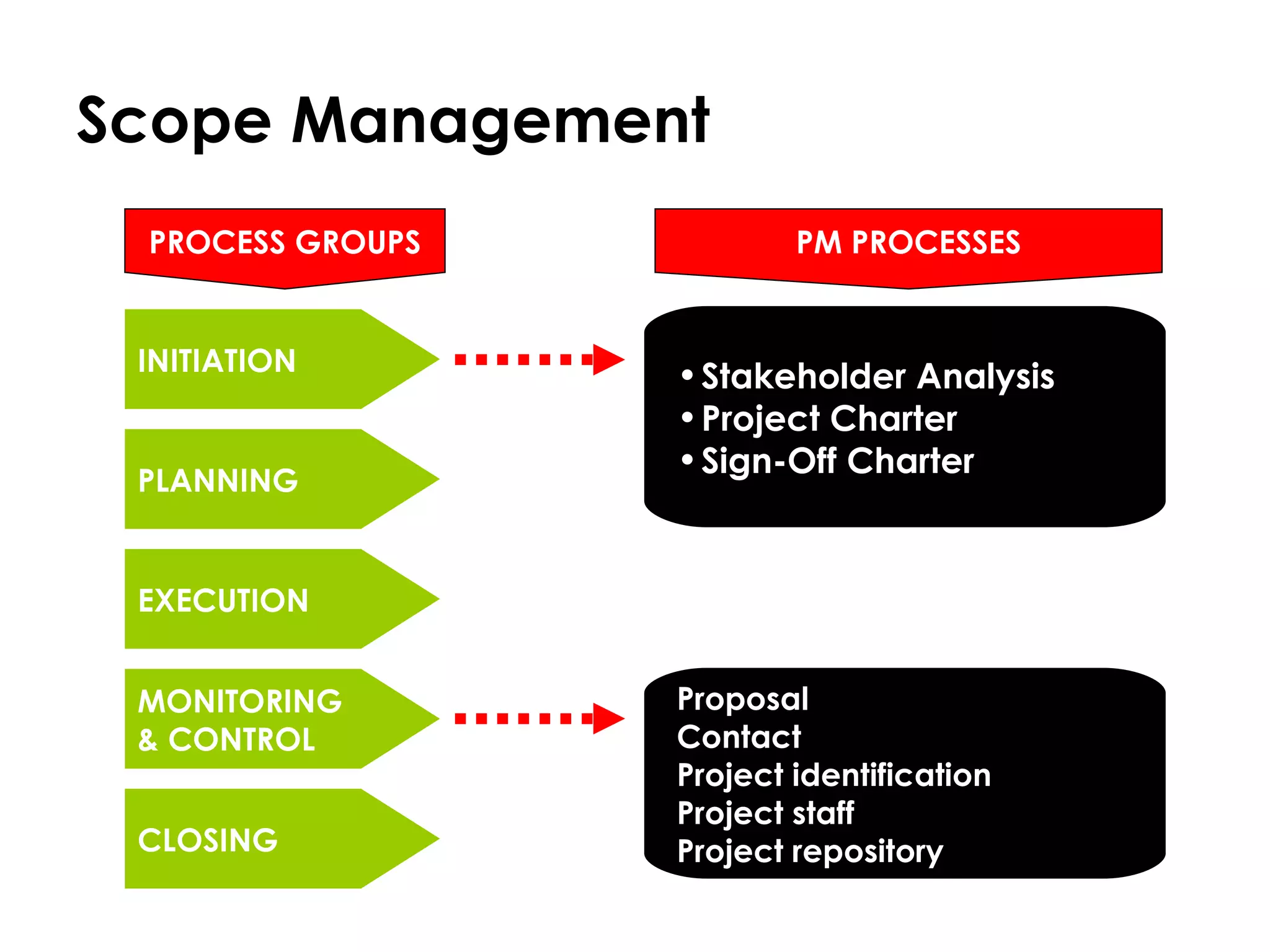

Initiation
Scope Planning
Scope Definition
Scope Verification
Scope Change Control
SAJJAD KHUDHUR ABBAS
Chemical Engineering , Al-Muthanna University, Iraq
Oil & Gas Safety and Health Professional – OSHACADEMY
Trainer of Trainers (TOT) - Canadian Center of Human
Development
Learn the 5 Key Project Management Phases that every project manager knows. Perfect information for those professionals curious about how Project Managers plan their projects.
Managing stakeholders as critical success factor in operational excellenceThe Jamilah H
Knowing stakeholders is the key thing in any transformational or continuous improvement initiatives, The presentation covers both high level and inter personal level of stake holders management techniques.
Among key contents are 7 Prevention Steps of Stakeholders misalignment and tools for Stakeholders Planning, Stakeholders Mapping, and Stakeholders Support Level.
PROJECT PART ONE
1
Part-1: Creating a New Plane
Students Name
Institution Affiliation
Course
Date
Part-1: Creating a New Plane
Project Title: Creating a New Plane
A Work Breakdown Structure (WBS) lists all project duties. WBS is hierarchical and offers logical, ambiguity-free categorization. Activities or deliverables may define these categories. The WBS must represent the approved work. The project's scope statement should be used to create a timetable and cost estimate. Project managers must construct a WBS before developing a strategy and timeline. Developing a WBS and WBS Dictionary will allow the project team to: 1)gather information on the project's work requirements for creating a new plane, 2)divide operations into smaller portions that will fulfill the project's goals, and 3)design the project so that it is proactive and logical from beginning to end.
Before the project begins, the PM has minimal influence. without specifying project scope. Through scope management, the project manager can design and maintain the scope statement. This statement describes the project manager's deliverables. This phase ensures and communicates to project management that only scope-related activity is done. This step helps complete the work.
Planning
Most firms that use project management make their OPA available to project managers. This, along with a Project Charter and Preliminary Project Scope Statement, will help the PM launch this part of the project. The Project Manager will have a Scope Management Plan after this stage. According to the Scope Management Plan, the PM will document, refine, verify, and oversee the project scope.
Define.
Project scope is next. To define project requirements, the project manager must interview all relevant parties. After understanding the project's stakeholders' needs and expectations, the scope can be established by prioritizing outputs. Discussing some options now may be helpful if they need to be documented later. After completing the scope definition, the project manager should conclude the scope statement. This will help in later project stages when making selections and ensuring everyone knows the project's goals.
Create a WBS.
A well-designed WBS should focus on project deliverables, not tasks (WBS). If you don't use the Work Breakdown Structure (WBS) as a checklist of activities to do (your project plan will help), you can focus on the WBS's primary purpose: organizing and outlining the project's scope. Work packages should be the foundation of the Work Breakdown Structure (WBS). These work bundles should help you estimate the project's cost and timeline.
Verification
In "Scope Verification," you'll win stakeholders' formal approval of your project's scope. To acquire this degree of acceptability, you must often undergo Inspection.
Control
Change Integrated Any project changes require a Control Process (ICCP). During Scope Control, you'll address ever.
Work breakdown structure WBS Columbia Southe.docxericbrooks84875
Work breakdown structure
WBS
Columbia Southern University
Tiffany Williams
The work breakdown structure is a key project deliverable that organizes the team's work into
manageable sections. Is a "deliverable oriented hierarchical decomposition of the work to be executed
by the project team." The work breakdown structure visually defines the scope into manageable chunks
that a project team can understand, as each level of the work breakdown structure provides further
definition and detail. (Work Breakdown Structure (WBS). (n.d.). Retrieved from
https://www.workbreakdownstructure.com)IN this case, I would use a three level work breakdown to
illustrate the processes in the construction project. In the paper am going to outline the work break
down structure for the construction project of a warehouse showing the various stages, participants, the
budget, as well as project timeline and constraints.
The depiction of the WBS will be using both charts and tables indicating codes for the various activities.
The idea process can be illustrated in the diagram below together with the OBS
WBS #: 1.1.1 Task: Create Plan
Est. Level of
Effort:
40 hrs Owner: Project Manager
Resources Needed: Subject Matter Experts Work
Products:
MS Project Plan
Description of
Task:
Development of a detailed project plan that lists all key resources,
tasks, milestones, dependencies, and durations.
Input: 1. Approved Project Charter
2. SMEs
Dependencies: 3. Approval of Budget
Risk: 4. Changes to IT Apps plans and deliverables
5. IT Apps implementation releases, which conflict with
implementation
WBS #: 1.1.2 Work Item: Make Budget
Est. Level of
Effort:
16 hrs. Owner: Project Manager
Resources Needed: CFO, CIO, Executive
Sponsor
Work
Products:
ITPR
Description of
Task:
Development and documentation of the project budget based on
plan and resources.
Input: 6. Approved Project Charter
7. SMEs
Dependencies: 8. Approval of Project Charter
Risk: 9. Collapse of house
WBS FIELDS
WBS
#
Task Description of Task
Work
Products
Owners
Est. Level
of Effort
1 PLANNIN
G
All task management and
management activities
1.1 Plan and
Supervise
Roll-up Task Project
Manager
N/A
1.1.
1
Create Plan Development of WBS, work
package identification,
schedule formulation,
staffing projection, resource
estimation. Followed by
development of a detail
project plan that list all the
key resources, task,
milestones, dependencies,
and duration.
WBS,
WBS
Dictionary,
MS Project
Plan
Project
Manager
40 hrs
1.1.
2
Create
Budget
Development and
documentation of the project
budget based on plan and
resources
ITPR Project
Manager
40 hrs
1.1.
3
Prepare
Disburseme
nt /
Reconciliati
on
Development of
disbursement process for the
project including
acceptan.
The world of search engine optimization (SEO) is buzzing with discussions after Google confirmed that around 2,500 leaked internal documents related to its Search feature are indeed authentic. The revelation has sparked significant concerns within the SEO community. The leaked documents were initially reported by SEO experts Rand Fishkin and Mike King, igniting widespread analysis and discourse. For More Info:- https://news.arihantwebtech.com/search-disrupted-googles-leaked-documents-rock-the-seo-world/
India Orthopedic Devices Market: Unlocking Growth Secrets, Trends and Develop...Kumar Satyam
According to TechSci Research report, “India Orthopedic Devices Market -Industry Size, Share, Trends, Competition Forecast & Opportunities, 2030”, the India Orthopedic Devices Market stood at USD 1,280.54 Million in 2024 and is anticipated to grow with a CAGR of 7.84% in the forecast period, 2026-2030F. The India Orthopedic Devices Market is being driven by several factors. The most prominent ones include an increase in the elderly population, who are more prone to orthopedic conditions such as osteoporosis and arthritis. Moreover, the rise in sports injuries and road accidents are also contributing to the demand for orthopedic devices. Advances in technology and the introduction of innovative implants and prosthetics have further propelled the market growth. Additionally, government initiatives aimed at improving healthcare infrastructure and the increasing prevalence of lifestyle diseases have led to an upward trend in orthopedic surgeries, thereby fueling the market demand for these devices.
Business Valuation Principles for EntrepreneursBen Wann
This insightful presentation is designed to equip entrepreneurs with the essential knowledge and tools needed to accurately value their businesses. Understanding business valuation is crucial for making informed decisions, whether you're seeking investment, planning to sell, or simply want to gauge your company's worth.
Putting the SPARK into Virtual Training.pptxCynthia Clay
This 60-minute webinar, sponsored by Adobe, was delivered for the Training Mag Network. It explored the five elements of SPARK: Storytelling, Purpose, Action, Relationships, and Kudos. Knowing how to tell a well-structured story is key to building long-term memory. Stating a clear purpose that doesn't take away from the discovery learning process is critical. Ensuring that people move from theory to practical application is imperative. Creating strong social learning is the key to commitment and engagement. Validating and affirming participants' comments is the way to create a positive learning environment.
"𝑩𝑬𝑮𝑼𝑵 𝑾𝑰𝑻𝑯 𝑻𝑱 𝑰𝑺 𝑯𝑨𝑳𝑭 𝑫𝑶𝑵𝑬"
𝐓𝐉 𝐂𝐨𝐦𝐬 (𝐓𝐉 𝐂𝐨𝐦𝐦𝐮𝐧𝐢𝐜𝐚𝐭𝐢𝐨𝐧𝐬) is a professional event agency that includes experts in the event-organizing market in Vietnam, Korea, and ASEAN countries. We provide unlimited types of events from Music concerts, Fan meetings, and Culture festivals to Corporate events, Internal company events, Golf tournaments, MICE events, and Exhibitions.
𝐓𝐉 𝐂𝐨𝐦𝐬 provides unlimited package services including such as Event organizing, Event planning, Event production, Manpower, PR marketing, Design 2D/3D, VIP protocols, Interpreter agency, etc.
Sports events - Golf competitions/billiards competitions/company sports events: dynamic and challenging
⭐ 𝐅𝐞𝐚𝐭𝐮𝐫𝐞𝐝 𝐩𝐫𝐨𝐣𝐞𝐜𝐭𝐬:
➢ 2024 BAEKHYUN [Lonsdaleite] IN HO CHI MINH
➢ SUPER JUNIOR-L.S.S. THE SHOW : Th3ee Guys in HO CHI MINH
➢FreenBecky 1st Fan Meeting in Vietnam
➢CHILDREN ART EXHIBITION 2024: BEYOND BARRIERS
➢ WOW K-Music Festival 2023
➢ Winner [CROSS] Tour in HCM
➢ Super Show 9 in HCM with Super Junior
➢ HCMC - Gyeongsangbuk-do Culture and Tourism Festival
➢ Korean Vietnam Partnership - Fair with LG
➢ Korean President visits Samsung Electronics R&D Center
➢ Vietnam Food Expo with Lotte Wellfood
"𝐄𝐯𝐞𝐫𝐲 𝐞𝐯𝐞𝐧𝐭 𝐢𝐬 𝐚 𝐬𝐭𝐨𝐫𝐲, 𝐚 𝐬𝐩𝐞𝐜𝐢𝐚𝐥 𝐣𝐨𝐮𝐫𝐧𝐞𝐲. 𝐖𝐞 𝐚𝐥𝐰𝐚𝐲𝐬 𝐛𝐞𝐥𝐢𝐞𝐯𝐞 𝐭𝐡𝐚𝐭 𝐬𝐡𝐨𝐫𝐭𝐥𝐲 𝐲𝐨𝐮 𝐰𝐢𝐥𝐥 𝐛𝐞 𝐚 𝐩𝐚𝐫𝐭 𝐨𝐟 𝐨𝐮𝐫 𝐬𝐭𝐨𝐫𝐢𝐞𝐬."
Attending a job Interview for B1 and B2 Englsih learnersErika906060
It is a sample of an interview for a business english class for pre-intermediate and intermediate english students with emphasis on the speking ability.
As a business owner in Delaware, staying on top of your tax obligations is paramount, especially with the annual deadline for Delaware Franchise Tax looming on March 1. One such obligation is the annual Delaware Franchise Tax, which serves as a crucial requirement for maintaining your company’s legal standing within the state. While the prospect of handling tax matters may seem daunting, rest assured that the process can be straightforward with the right guidance. In this comprehensive guide, we’ll walk you through the steps of filing your Delaware Franchise Tax and provide insights to help you navigate the process effectively.
Explore our most comprehensive guide on lookback analysis at SafePaaS, covering access governance and how it can transform modern ERP audits. Browse now!
What are the main advantages of using HR recruiter services.pdfHumanResourceDimensi1
HR recruiter services offer top talents to companies according to their specific needs. They handle all recruitment tasks from job posting to onboarding and help companies concentrate on their business growth. With their expertise and years of experience, they streamline the hiring process and save time and resources for the company.
3.0 Project 2_ Developing My Brand Identity Kit.pptxtanyjahb
A personal brand exploration presentation summarizes an individual's unique qualities and goals, covering strengths, values, passions, and target audience. It helps individuals understand what makes them stand out, their desired image, and how they aim to achieve it.
RMD24 | Retail media: hoe zet je dit in als je geen AH of Unilever bent? Heid...BBPMedia1
Grote partijen zijn al een tijdje onderweg met retail media. Ondertussen worden in dit domein ook de kansen zichtbaar voor andere spelers in de markt. Maar met die kansen ontstaan ook vragen: Zelf retail media worden of erop adverteren? In welke fase van de funnel past het en hoe integreer je het in een mediaplan? Wat is nu precies het verschil met marketplaces en Programmatic ads? In dit half uur beslechten we de dilemma's en krijg je antwoorden op wanneer het voor jou tijd is om de volgende stap te zetten.

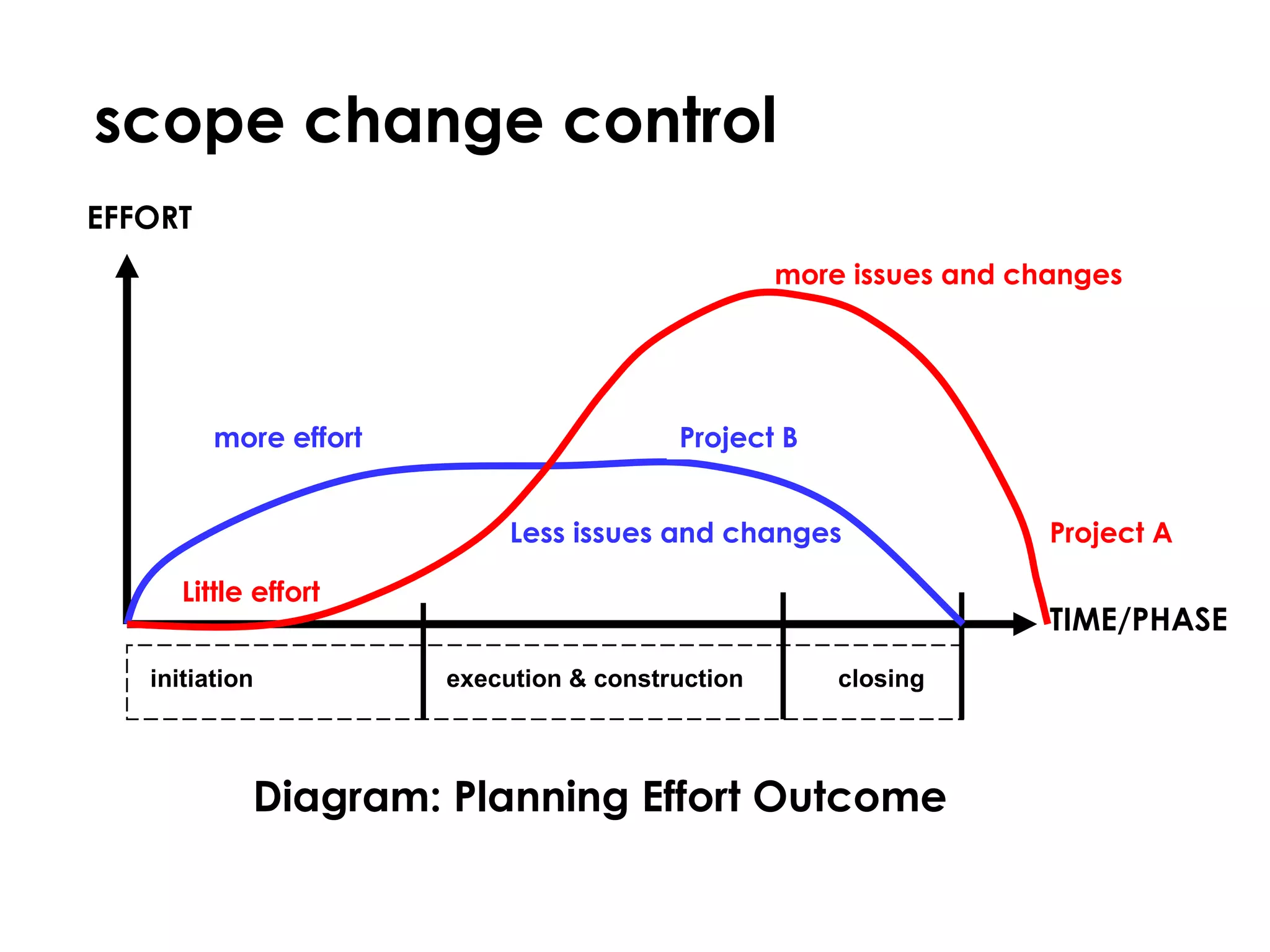

11. scope change control Diagram: Planning Effort Outcome EFFORT TIME/PHASE Little effort more effort more issues and changes Less issues and changes Project A Project B initiation execution & construction closing
