Lean Software Process
Handling Muda in the IT Industry


                               Dhivya Arunagiri
                               Senior Business Analyst
                               Thoughtworks, Chennai




            March 11th, 2011
Muda – The 7 variants
Wastage Due to

1. Over Production

2. Process Failure

3. Bad Quality

4. Transport

5. Inventory

6. Idle Time

7. Operator Motion
Muda 1: Overproduction


    My client has 5 different types of end users.
   Some users have a lot of extra features while
      others do not have even the basic ones

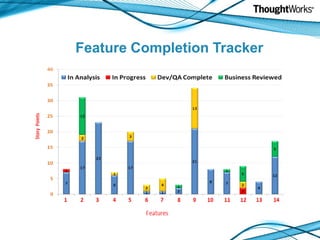

Requirement Maps
Feature Completion Tracker

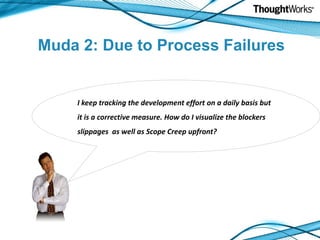

Muda 2: Due to Process Failures


    I keep tracking the development effort on a daily basis but
    it is a corrective measure. How do I visualize the blockers
    slippages as well as Scope Creep upfront?
Finger Charts – Data Capture
                                                                     90% 100%       1.1

                            Wait        Park   Rea     Buff               Point   Point
                                                                   Points
    End of             Appr for  In     ed/d   dy /    er     Tota        s 1.0   s 1.1 Dev
              #                                                    1.0                      Scope
    Date               oved appr Dev    esco   defin   (10%   l           (100%   (100% s
                                                                   (90%)
                            oval        ped    ed      )                  )       )

    Aug-6          1      0    0    8      0    864      86    872      0     0           6     880
    Aug-7          2      0    0    8      0    864      86    872      0     0           6     880
1   Aug-8          3      0    0   20      0    852      86    872      5     6       7   6     880
    Aug-11         4      0    0   20      0    852      86    872     11    12      13   6     880
    Aug-12         5      4    0   28      8    854      86    894     16    18      20   6     880
    Aug-13         6      4    0   28      8    854      86    894     22    24      26   6     880
    Aug-14         7      4    0   36      0    854      86    894     27    30      33   6     880
2   Aug-15         8      4    0   36      0    854      86    894     27    30      33   6     880
    Aug-18         9      4   12   30     66    782      86    894     32    36      40   6     880
    Aug-19        10      4   12   36     64    778      86    894     38    42      46   6     880
    Aug-20        11      6   22   38     64    764      86    894     43    48      53   6     880
    Aug-21        12     14   22   38     66    764      86    904     49    54      59   6     880
3   Aug-22        13     14   24   46     66    758      86    908     54    60      66   6     880
    Aug-25        14     14   30   40     68    764      86    916     59    66      73   6     880
    Aug-26        15     38   18   34     88    740      86    918     65    72      79   6     880

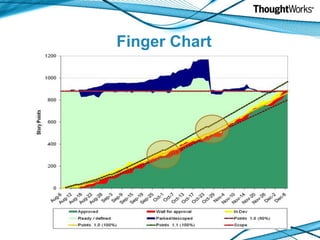

Finger Chart

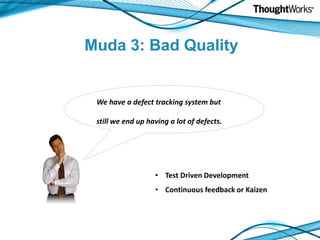

Muda 3: Bad Quality


 We have a defect tracking system but

 still we end up having a lot of defects.




                   • Test Driven Development
                   • Continuous feedback or Kaizen
Cycle Time Tracker

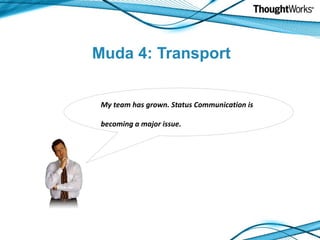

Muda 4: Transport


 My team has grown. Status Communication is

 becoming a major issue.

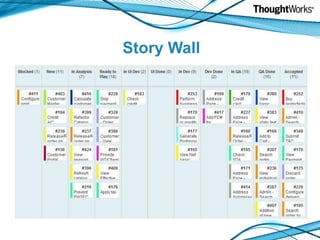

Story Wall
Muda 5: Inventory


My Client is in a volatile industry. By the time, we

release a feature, parts of it have become redundant




                           Plan for the current and consecutive
                                       iteration only
Muda 6: Idle Time

If one pair slips off on the completion date for a

requirement, the second pair remains idle.

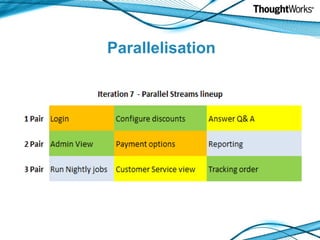

Parallelisation
Muda 7: Operator Motion

 Each developer is specialised in one area. How do we

 ensure we disseminate the knowledge?




                             •   Paired Programming

                             •   Pair Rotation
A quick recap….
Thank You !!!

Questions??

Lean software process

  • 1.
    Lean Software Process HandlingMuda in the IT Industry Dhivya Arunagiri Senior Business Analyst Thoughtworks, Chennai March 11th, 2011
  • 2.
    Muda – The7 variants Wastage Due to 1. Over Production 2. Process Failure 3. Bad Quality 4. Transport 5. Inventory 6. Idle Time 7. Operator Motion
  • 3.
    Muda 1: Overproduction My client has 5 different types of end users. Some users have a lot of extra features while others do not have even the basic ones
  • 4.
  • 5.
  • 6.
    Muda 2: Dueto Process Failures I keep tracking the development effort on a daily basis but it is a corrective measure. How do I visualize the blockers slippages as well as Scope Creep upfront?
  • 7.
    Finger Charts –Data Capture 90% 100% 1.1 Wait Park Rea Buff Point Point Points End of Appr for In ed/d dy / er Tota s 1.0 s 1.1 Dev # 1.0 Scope Date oved appr Dev esco defin (10% l (100% (100% s (90%) oval ped ed ) ) ) Aug-6 1 0 0 8 0 864 86 872 0 0 6 880 Aug-7 2 0 0 8 0 864 86 872 0 0 6 880 1 Aug-8 3 0 0 20 0 852 86 872 5 6 7 6 880 Aug-11 4 0 0 20 0 852 86 872 11 12 13 6 880 Aug-12 5 4 0 28 8 854 86 894 16 18 20 6 880 Aug-13 6 4 0 28 8 854 86 894 22 24 26 6 880 Aug-14 7 4 0 36 0 854 86 894 27 30 33 6 880 2 Aug-15 8 4 0 36 0 854 86 894 27 30 33 6 880 Aug-18 9 4 12 30 66 782 86 894 32 36 40 6 880 Aug-19 10 4 12 36 64 778 86 894 38 42 46 6 880 Aug-20 11 6 22 38 64 764 86 894 43 48 53 6 880 Aug-21 12 14 22 38 66 764 86 904 49 54 59 6 880 3 Aug-22 13 14 24 46 66 758 86 908 54 60 66 6 880 Aug-25 14 14 30 40 68 764 86 916 59 66 73 6 880 Aug-26 15 38 18 34 88 740 86 918 65 72 79 6 880
  • 8.
  • 9.
    Muda 3: BadQuality We have a defect tracking system but still we end up having a lot of defects. • Test Driven Development • Continuous feedback or Kaizen
  • 10.
  • 11.
    Muda 4: Transport My team has grown. Status Communication is becoming a major issue.
  • 12.
  • 13.
    Muda 5: Inventory MyClient is in a volatile industry. By the time, we release a feature, parts of it have become redundant Plan for the current and consecutive iteration only
  • 14.
    Muda 6: IdleTime If one pair slips off on the completion date for a requirement, the second pair remains idle.
  • 15.
  • 16.
    Muda 7: OperatorMotion Each developer is specialised in one area. How do we ensure we disseminate the knowledge? • Paired Programming • Pair Rotation
  • 17.
  • 18.
