Tathagat Varma


Tathagat Varma
 Session 7/12: 22-Jun-2010

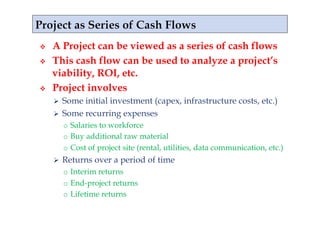

    A Project can be viewed as a series of cash flows
    This cash flow can be used to analyze a project’s
     viability, ROI, etc.
    Project involves
       Some initial investment (capex, infrastructure costs, etc.)
       Some recurring expenses
          o  Salaries to workforce
          o  Buy additional raw material
          o  Cost of project site (rental, utilities, data communication, etc.)
         Returns over a period of time
          o  Interim returns
          o  End-project returns
          o  Lifetime returns

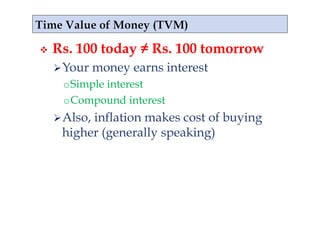

    Rs. 100 today ≠ Rs. 100 tomorrow
      Your    money earns interest
      o Simple interest
      o Compound interest
      Also,
           inflation makes cost of buying
      higher (generally speaking)

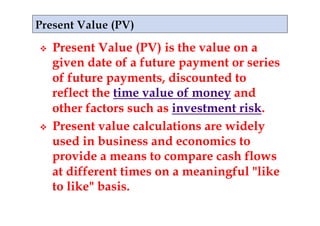

    Present Value (PV) is the value on a
     given date of a future payment or series
     of future payments, discounted to
     reflect the time value of money and
     other factors such as investment risk.
    Present value calculations are widely
     used in business and economics to
     provide a means to compare cash flows
     at different times on a meaningful "like
     to like" basis.

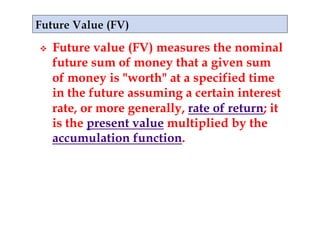

    Future value (FV) measures the nominal
     future sum of money that a given sum
     of money is "worth" at a specified time
     in the future assuming a certain interest
     rate, or more generally, rate of return; it
     is the present value multiplied by the
     accumulation function.

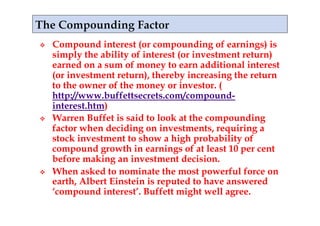

    Compound interest (or compounding of earnings) is
     simply the ability of interest (or investment return)
     earned on a sum of money to earn additional interest
     (or investment return), thereby increasing the return
     to the owner of the money or investor. (
     http://www.buffettsecrets.com/compound-
     interest.htm)
    Warren Buffet is said to look at the compounding
     factor when deciding on investments, requiring a
     stock investment to show a high probability of
     compound growth in earnings of at least 10 per cent
     before making an investment decision.
    When asked to nominate the most powerful force on
     earth, Albert Einstein is reputed to have answered
     ‘compound interest’. Buffett might well agree.

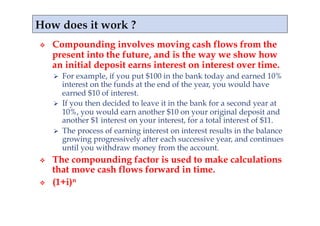

    Compounding involves moving cash flows from the
     present into the future, and is the way we show how
     an initial deposit earns interest on interest over time.
       For example, if you put $100 in the bank today and earned 10%
        interest on the funds at the end of the year, you would have
        earned $10 of interest.
       If you then decided to leave it in the bank for a second year at
        10%, you would earn another $10 on your original deposit and
        another $1 interest on your interest, for a total interest of $11.
       The process of earning interest on interest results in the balance
        growing progressively after each successive year, and continues
        until you withdraw money from the account.
    The compounding factor is used to make calculations
     that move cash flows forward in time.

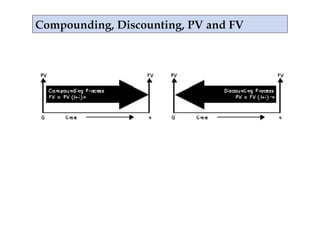

    (1+i)n

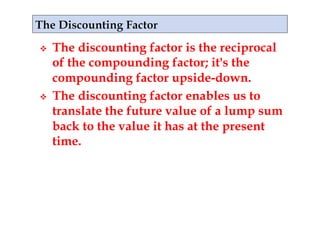

    The discounting factor is the reciprocal
     of the compounding factor; it's the
     compounding factor upside-down.
    The discounting factor enables us to
     translate the future value of a lump sum
     back to the value it has at the present
     time.

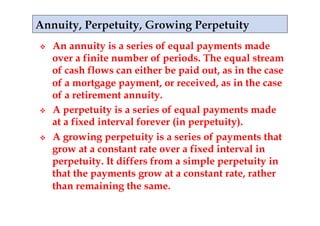

    An annuity is a series of equal payments made
     over a finite number of periods. The equal stream
     of cash flows can either be paid out, as in the case
     of a mortgage payment, or received, as in the case
     of a retirement annuity.
    A perpetuity is a series of equal payments made
     at a fixed interval forever (in perpetuity).
    A growing perpetuity is a series of payments that
     grow at a constant rate over a fixed interval in
     perpetuity. It differs from a simple perpetuity in
     that the payments grow at a constant rate, rather
     than remaining the same.
    The minimum acceptable rate of return, often
     abbreviated MARR, or hurdle rate is the minimum
     rate of return on a project a manager or company is
     willing to accept before starting a project, given its
     risk and the opportunity cost of forgoing other
     projects.[1]. A synonym seen in many contexts is
     minimum attractive rate of return (MARR)
    The MARR is often decomposed into the sum of
     following components (range of typical values
     shown)[4]:
       Traditional inflation-free rate of interest for risk-free loans: 3-5%
       Expected rate of inflation: 5%
       The anticipated change in the rate of inflation, if any, over the
        life of the investment: Usually taken at 0%
       The risk of defaulting on a loan: 0-5%
       The risk profile of a particular venture: 0-50% and higher

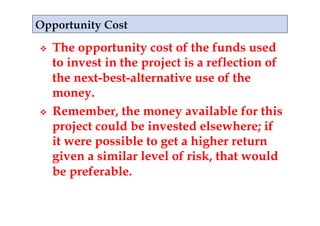

    The opportunity cost of the funds used
     to invest in the project is a reflection of
     the next-best-alternative use of the
     money.
    Remember, the money available for this
     project could be invested elsewhere; if
     it were possible to get a higher return
     given a similar level of risk, that would
     be preferable.
    The expected number of years required to
     recover a project's initial investment. Payback
     period is an appropriate rule to use when
     there is a concern for fast capital turnover.
       Forecastthe amount and timing of the cash flows.
       Determine the maximum payback period acceptable
        to you.
       Sum the consecutive cash flows to find the year at
        which the project is paid back.
    Using this method, accept the project if the
     payback period is less than or equal to the
     maximum payback period acceptable to you.

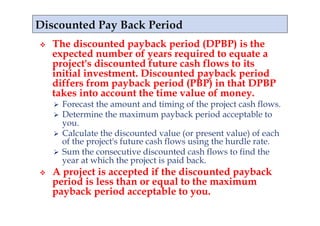

    The discounted payback period (DPBP) is the
     expected number of years required to equate a
     project's discounted future cash flows to its
     initial investment. Discounted payback period
     differs from payback period (PBP) in that DPBP
     takes into account the time value of money.
       Forecast the amount and timing of the project cash flows.
       Determine the maximum payback period acceptable to
        you.
       Calculate the discounted value (or present value) of each
        of the project's future cash flows using the hurdle rate.
       Sum the consecutive discounted cash flows to find the
        year at which the project is paid back.
    A project is accepted if the discounted payback
     period is less than or equal to the maximum
     payback period acceptable to you.
    The profitability index (PI) is the net present value of future
     cash flows divided by the initial investment. The profitability
     index approach presents what is known as a constrained
     optimization problem, where the constraint is cash (it could be
     any limited resource). Modifications of the profitability index
     can be useful when any resource is limited. For example, the
     resource could be floor space in a manufacturing plant, gates at
     an airport, or the hours available from an employee who
     performs a specialized task.
         Forecast the amount and timing of the cash flows.
         Using the estimated hurdle rate, find the net present value of the future cash
          flows.
         Divide the net present value of the future cash flows by the initial investment.
    If the profitability index is greater than 0, accept the project. For
     multiple projects, rank the projects by their profitability indexes
     and accept them in order until you've exhausted the funds
     available or have run out of projects with a PI greater than 0.

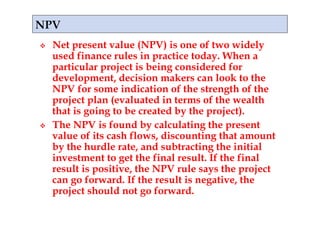

    Net present value (NPV) is one of two widely
     used finance rules in practice today. When a
     particular project is being considered for
     development, decision makers can look to the
     NPV for some indication of the strength of the
     project plan (evaluated in terms of the wealth
     that is going to be created by the project).
    The NPV is found by calculating the present
     value of its cash flows, discounting that amount
     by the hurdle rate, and subtracting the initial
     investment to get the final result. If the final
     result is positive, the NPV rule says the project
     can go forward. If the result is negative, the
     project should not go forward.
    The internal rate of return (IRR) is the discount rate at
     which the NPV will be 0; that is, the rate that equates
     the present value of a project's cash outflows to the
     present value of its cash inflows. If the IRR is greater
     than the hurdle rate, the investors will earn more than
     they require. Thus, when the IRR is greater than the
     hurdle rate, accept the project.
       Forecast the amount and timing of the cash flows.
       Using the formula for net present value, set the net present
        value to 0 and solve for the discount rate (the sole unknown).
        This is usually done using a financial calculator or spreadsheet
        program.
    Compare the calculated IRR to the hurdle rate. If the
     IRR is greater than the hurdle rate, the IRR rule
     recommends that you go ahead with the project.
    As a PM, you will take capital investment
     decisions
    Never decide on a single metric
    Identify what is more critical to a project:
     whether it is
       Profitability?
       NPV?
       IRR?
       PBP?
       or   something else ?

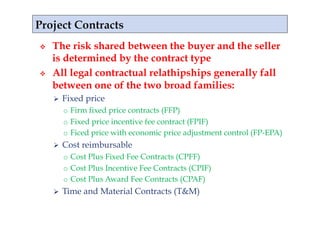

    The risk shared between the buyer and the seller
     is determined by the contract type
    All legal contractual relathipships generally fall
     between one of the two broad families:
         Fixed price
          o  Firm fixed price contracts (FFP)
          o  Fixed price incentive fee contract (FPIF)
          o  Ficed price with economic price adjustment control (FP-EPA)
         Cost reimbursable
          o  Cost Plus Fixed Fee Contracts (CPFF)
          o  Cost Plus Incentive Fee Contracts (CPIF)
          o  Cost Plus Award Fee Contracts (CPAF)
         Time and Material Contracts (T&M)
