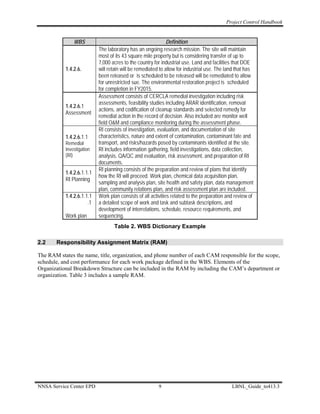

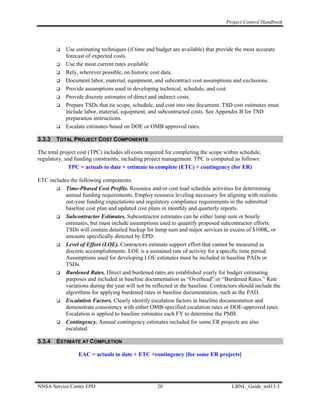

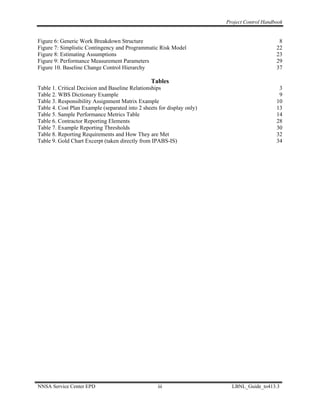

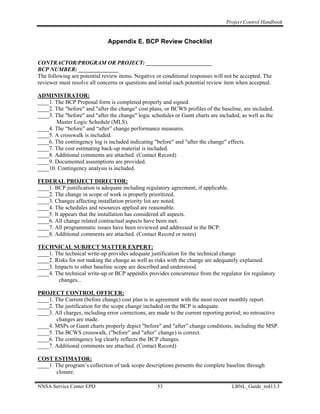

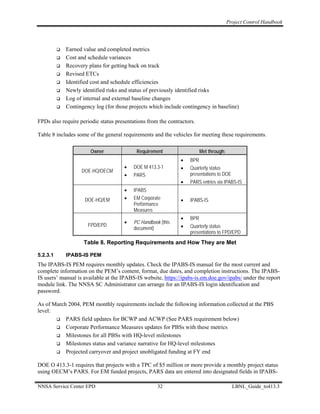

This document provides guidance on project control and baseline management for environmental projects at Department of Energy sites. It describes the framework for integrating project management critical decisions with baseline documentation, including the prerequisite baseline developed during planning, the performance baseline used during project execution, and the post-completion baseline. The document provides guidance on developing key baseline documents such as the work breakdown structure, schedule, cost plans, and risk management plan. It also addresses baseline change control, performance reporting, and maintenance.
