The document provides background information on the Department of Urban Development and Building Construction (DUDBC) in Nepal. DUDBC was established in 1970 and has undergone several name and structural changes over time to better address the growing needs of housing, urban planning, and building construction in Nepal. Currently, DUDBC is mandated to regulate the approval and construction of apartment buildings in Kathmandu Valley and ensure they meet necessary safety and quality standards.
I came to know regarding this competition from rediff.com
Salient features of a well-designed inclusive Neighbourhood (Colony) for the urban poor is characterized by a well conceptualized effort at social cohesion:
I. Housing Unit and Layouts of Cluster Housing
II. Neighbourhood Colony Layouts
III. Basic Physical Infrastructure (Water Supply, Sanitation, Drainage, Roads, Street Lighting, Solid
Waste Management, etc.)
IV. Cohesive Social Infrastructure (Community Centre, Informal Sector Market, Livelihood Centre,
etc.)
A Report on Urban Redevelopment which covers Introduction, Indicators of Redevelopment(Construction, Rehabilitation & Relocation), Local Study(Bangladesh), International Study of Redevelopment, Preservation aspect, and most important part of Redevelopment i.e. Methodology.
While the supply side constraints for low cost and affordable housing include lack of availability of land and finance at reasonable rates, the demand drivers include the growing
middle class and urbanisation. Real estate developers, private players in particular, have primarily targeted luxury, high-end and upper-mid housing segment owing to the higher returns that can be gained from such projects.
Case Study on
. Vinayak Colony
. Mero City Apartments
. Aranya Housing
. Unite De Habitation
For Housing/Apartment Study for Design Studio ,B. Architecture Pulchowk Campus, Nepal
I came to know regarding this competition from rediff.com
Salient features of a well-designed inclusive Neighbourhood (Colony) for the urban poor is characterized by a well conceptualized effort at social cohesion:
I. Housing Unit and Layouts of Cluster Housing
II. Neighbourhood Colony Layouts
III. Basic Physical Infrastructure (Water Supply, Sanitation, Drainage, Roads, Street Lighting, Solid
Waste Management, etc.)
IV. Cohesive Social Infrastructure (Community Centre, Informal Sector Market, Livelihood Centre,
etc.)
A Report on Urban Redevelopment which covers Introduction, Indicators of Redevelopment(Construction, Rehabilitation & Relocation), Local Study(Bangladesh), International Study of Redevelopment, Preservation aspect, and most important part of Redevelopment i.e. Methodology.
While the supply side constraints for low cost and affordable housing include lack of availability of land and finance at reasonable rates, the demand drivers include the growing
middle class and urbanisation. Real estate developers, private players in particular, have primarily targeted luxury, high-end and upper-mid housing segment owing to the higher returns that can be gained from such projects.
Case Study on
. Vinayak Colony
. Mero City Apartments
. Aranya Housing
. Unite De Habitation
For Housing/Apartment Study for Design Studio ,B. Architecture Pulchowk Campus, Nepal
Valuation - professional prractice and valuationKavin Raval
VALUATION IS USED TO DECIDE THE VALUE OF A STRUCTURE OR A RENT OF A HOUSE OR OFFICE . THE TYPES OF RENT ARE DESCRIBED. THE METHOD OF FIXING RENT IS ILLUSTRATED.
Stanlee's presentation on affordable housingStanLee GeorGe
Urbanization has resulted in people increasingly living in slums and squatter settlements and has deteriorated the housing conditions of the economically weaker sections of the society. This is primarily due to the skyrocketing prices of land and real estate in urban areas that have forced the poor and the economically weaker sections of the society to occupy the marginal lands typified by poor housing stock, congestion and obsolescence.
In this dissertation, we will explore major issues in the development of affordable housing in India and steps taken by the Government and private sector to address them inclusively.
GARDEN CITY(garden city concept), the perfect blend of city and nature.
the preservation of agricultural and rural life, nature and heritage conservation, recreation, pollution minimization, and growth management as well as the city endowed the tradition of urban planning with a social and community dimensions.
If you are looking to buy/sell/rent an apartment in Commonwealth Games Village then call us: 9717288533
Mail: info@guptarealty.in
We have a wide range of inventory in this complex. We have a professional approach towards our services in real estate.
Easements are certain rights connected with enjoyment o immovable property. The easement rights and obligation arise as a result of local or general custom. It is the right which the owner or occupier of a land possesses for the beneficial enjoyment of that land.
The Land on which the right of beneficial enjoyment has been created is called the dominant heritage (owner: Dominant owner)
The land on which easement is created is called the Servient heritage ( owner: Servient owner)
This modular housing based in Belapur, New Mumbai, is designed by Ar. Charles Correa. This project, which was constructed in the 1980s, stands as a perfect example of affordable and high density housing, which is the need of the hour.
National Workshop on Standards and Testing of Cookstoves in Nepal
25 July 2013, Hotel Himalaya, Kathmandu, Nepal
Policy session
Presenter: Ganesh Prasad Pathak, Senior Divisional Engineer
Nepal Bureau of Standards and Meteorology
Valuation - professional prractice and valuationKavin Raval
VALUATION IS USED TO DECIDE THE VALUE OF A STRUCTURE OR A RENT OF A HOUSE OR OFFICE . THE TYPES OF RENT ARE DESCRIBED. THE METHOD OF FIXING RENT IS ILLUSTRATED.
Stanlee's presentation on affordable housingStanLee GeorGe
Urbanization has resulted in people increasingly living in slums and squatter settlements and has deteriorated the housing conditions of the economically weaker sections of the society. This is primarily due to the skyrocketing prices of land and real estate in urban areas that have forced the poor and the economically weaker sections of the society to occupy the marginal lands typified by poor housing stock, congestion and obsolescence.
In this dissertation, we will explore major issues in the development of affordable housing in India and steps taken by the Government and private sector to address them inclusively.
GARDEN CITY(garden city concept), the perfect blend of city and nature.
the preservation of agricultural and rural life, nature and heritage conservation, recreation, pollution minimization, and growth management as well as the city endowed the tradition of urban planning with a social and community dimensions.
If you are looking to buy/sell/rent an apartment in Commonwealth Games Village then call us: 9717288533
Mail: info@guptarealty.in
We have a wide range of inventory in this complex. We have a professional approach towards our services in real estate.
Easements are certain rights connected with enjoyment o immovable property. The easement rights and obligation arise as a result of local or general custom. It is the right which the owner or occupier of a land possesses for the beneficial enjoyment of that land.
The Land on which the right of beneficial enjoyment has been created is called the dominant heritage (owner: Dominant owner)
The land on which easement is created is called the Servient heritage ( owner: Servient owner)
This modular housing based in Belapur, New Mumbai, is designed by Ar. Charles Correa. This project, which was constructed in the 1980s, stands as a perfect example of affordable and high density housing, which is the need of the hour.
National Workshop on Standards and Testing of Cookstoves in Nepal
25 July 2013, Hotel Himalaya, Kathmandu, Nepal
Policy session
Presenter: Ganesh Prasad Pathak, Senior Divisional Engineer
Nepal Bureau of Standards and Meteorology
It is realized that Nepalese construction had undertaken a high rise in its image internationally and nationally and has been participating in various organization as an active member. Besides these, there are many rumours and conflicts about the capability of Nepalese contractors about their technical and financial ability for not completing the projects undertaken by them within the given timeframe and of standard quality. Although construction entrepreneur of Class A in Nepal, have the opportunities to withstand in construction industry (as country is still in construction phase of infrastructure development) with full enthusiasm and effort, they seems to be demoralized by the policies, rules, guidance and support from the government and procedure of procurement of donor agencies during bidding in Mega Projects.
The study has covered construction firms registered as class A construction entrepreneur. The numbers of construction firms studied were fifty one (51). Random sampling method was performed to select the respondents. A questionnaire was developed to collect the datas for the study. The close ended question, open ended question, and ranking method of prioritization was adopted to obtain the necessary datas from the respondents.
The purpose of the study was to compare the existing equipment capabilities of Class A construction entrepreneurs with the prescribed requirement as per CBA 2055 & CBR 2056 and also to determine the current capacity of the class A construction entrepreneurs in terms of technical and financial capabilities. The study also has covered the exploration of common problems and difficulties felt in criteria of achieving qualification documents during bidding procedure , receiving payment during payment schedule, , taxation part, hiring qualified human resource in different construction sector and insecure felt during stages of tender purchase, tender drop and construction site execution works by class A construction entrepreneurs.
Percentage, frequency and charts were used to analyze the data. The result has showed that, in owning equipments most of the companies have failed to meet the prescribed standard as per CBA 2055 & CBR 2056. Only few numbers of contractors are extremely satisfied with their business. There are various factors like annual turnover & similar experience part in qualification procedure, escalated amount & running bill payment in payment procedure, insecurity due to hooliganism in construction business during site execution and tender drop, taxation system during refunding of the tax deducted at source amount. The research has also shown the unavailability of human resources in tunnel sector, hydropower sector and bridge sector in construction sector in present context.
Seismic evaluation of rc frame with brick masonry infill wallseSAT Journals
Abstract
Infill panels are widely used as partition walls as well as external walls of the building to fill the gap between RC frames. Non-structural member may provide considerable stiffness to the building and hence may improve the performance of the RC building during ground motions. But In most of the cases, the ignorance of this property of masonry in designing of the RC frame may get an unsafe design. There are two methods are used to determine the effect of ground motion. The effect of ground motion on RC frame building has been carried out by considering with and without the stiffness of infill wall. A comparative study is carried out with RC building using Equivalent Lateral Force method and Response Spectrum method. The masonry infill has been modeled as an equivalent diagonal strut element using Hendry formula. Pushover analysis is carried out on bare frame and frame with infill wall. The model has been generated using STAAD Pro and results obtained from the analysis are compared in terms of strength and stiffness with bare frame.
Keywords: Seismic evaluation, Response Spectrum, masonry infill, diagonal strut.
Code approaches to seismic design of masonry infiled rc framesBinay Shrestha
Masonry infill (MI) increases the initial stiffness of reinforced concrete RC frames. Behavior of MI is difficult to predict because of significant variations in material properties and because of failure modes that are brittle in nature.
A Presentation made to the student of BDevS at Center for Development Studies, National College for Higher Education, KU in October 2014, kathmandu, Nepal
THE DIGITAL TURN. Pathways for higher education in the digital age.
ABOUT THIS REPORT
This summary report presents key statements,
findings and recommendations by Hochschulforum Digitalisierung (German Forum for Higher Education in the Digital Age, abbreviated
HFD) with regard to shaping forward-looking
higher education for the digital age in Germany.
This condensed version of the report is geared
first and foremost towards readers with limited
time and above all to representatives of higher
education institution administrations and policymakers who have a key role in the strategic
development of the digital turn at German
higher education institutions (HEIs). The basis of
and background to the analyses and recommendations can be found in the full-length version of the report. It illustrates and documents
the findings of a three-year project involving
the work of over 70 experts who examined the
opportunities and challenges of digitalisation in
six expert groups.
Thèse professionnelle sur les indicateurs de performance RSE et le management...Chris Delepierre
Thèse professionnelle sur les indicateurs de développement durable dans le cadre du Master of Science de gestion de projet à Skema Business School - octobre 2013.
La mesure de la performance durable des projets en entreprise est un thème assez récent que de nombreuses recherches tentent d'approfondir car, après s'être peu à peu installées en entreprise, les stratégies RSE ont désormais besoin de s'armer d'outils et de méthodes rationnels pour légitimer leurs bénéfices et mesurer les progrès accomplis grâce à des données fiables à l'échelle des projets, au niveau opérationnel, et non plus seulement au niveau corporate de la stratégie globale de l'entreprise.
Elimination of Bonded Labour due to Bondage in the Brick Kilns in 4 Districts...Ihsan Nadir
This report is aimed to analysis and evaluate the project’s objectives/targets verses the achievements made till May 31, 2017, project conceived for Elimination of Bonded Labour in 04 Districts of Punjab (EBLIK-4D), total cost of Rs. 196.987 million had been prepared and submitted for approval from concerned authorities and recommendations for further improvements in the project implementation in order to achieve desired outcomes and have sustainable impact.
“Bank Finance in Real Estate – Significance and Impact” (India)RITESH BAFNA
With over 8 years of Business Experience and having spent over 6 years with a revered name in Mumbai Real Estate "Vardhman Group", I was looking at an opportunity for sharing my observation about the impact and significance of Banks on Real Estate. As part of our Masters Program at JBIMS, I had to conduct a short study on a topic that interests me. This is where “Bank Finance in Real Estate – Significance and Impact” was created. Its a simple analysis and correlation of Banks and Real Estate in India.

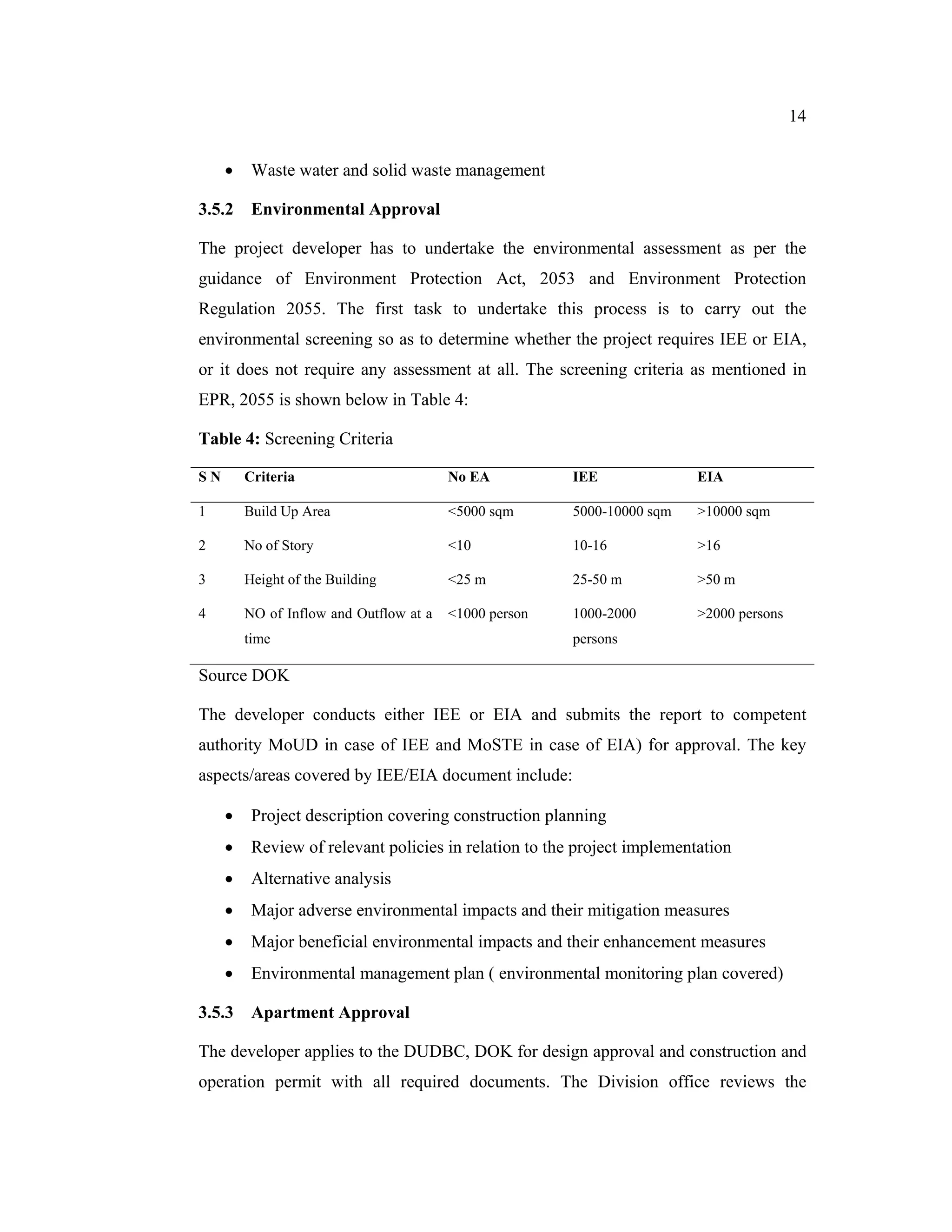

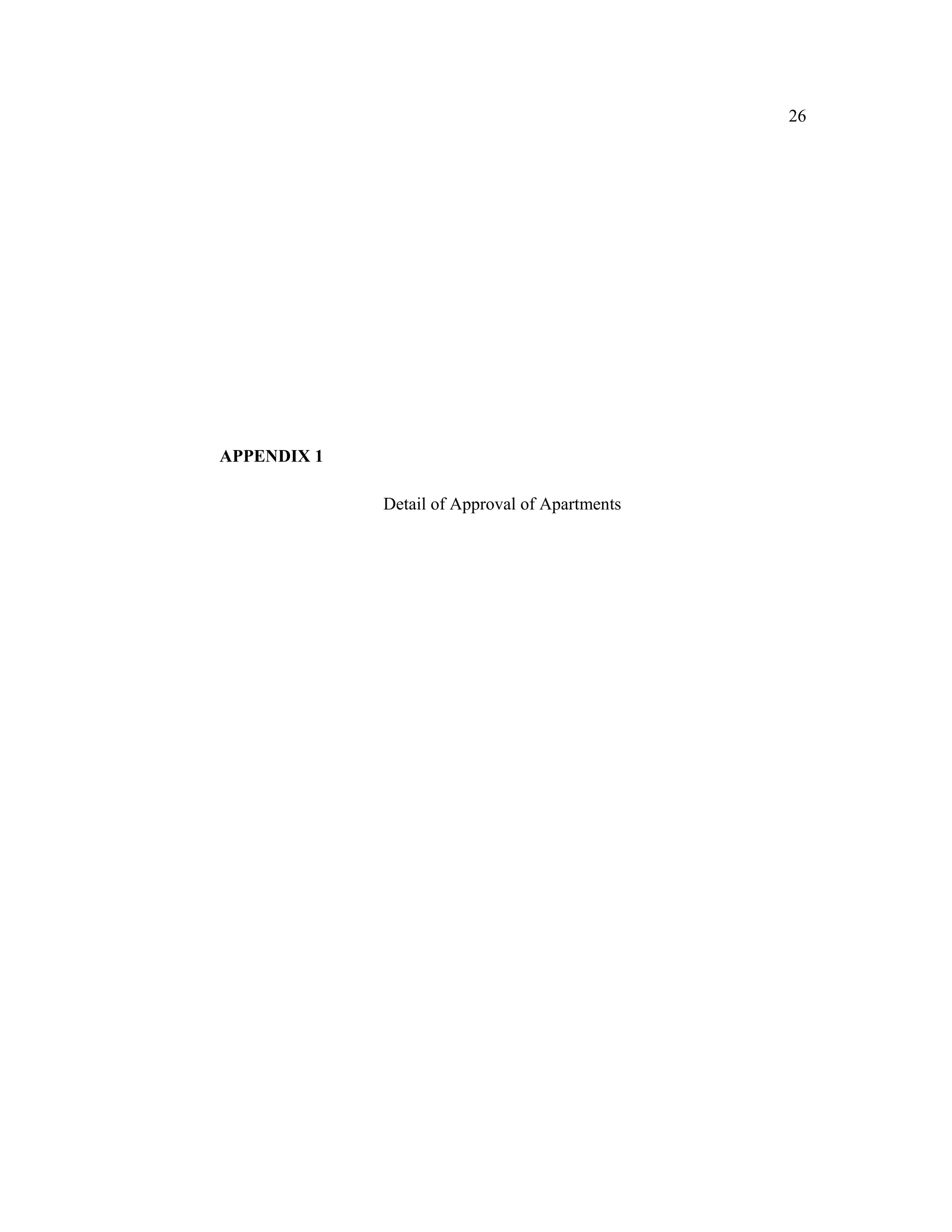

Present status of apartment building approval and construction
1. PRESENT STATUS OF APARTMENT BUILDING
APPROVAL AND CONSTRUCTION IN
KATHMANDU VALLEY
Study Report
SUBMITTED TO
NEPAL ADMINISTRATIVE STAFF COLLEGE
JAWALAKHEL, LALITPUR, NEPAL
In partial fulfillment of “Advanced Course on Management and
Development” for Class II Officers of the Government of Nepal
(Paush 23 – Falgun 10, 2069)
SUBMITTED BY:
Binay Charan Shrestha (DUDBC)
Dilip Kumar Sadaula (DSCWM)
Kamaldeo Prasad Shah (DoR)
Mahendra Dhose Adhikari (MoHP)
Rudra Nath Devkota (MoHA)
Sanjaya Dhungel (WECS)
FALGUN 2069

2. ACKNOWLEDGEMENT
We would like to extend our sincere gratitude to respective Ministries for providing
opportunity to take part in the training program and Nepal Administrative Staff
College for providing the training.
We are grateful to Division Chief Mr. Shiv Hari Sharma, Engineer Mr. Himal KC and
Architect Mr. Rajendra Khatiwada of Department of Urban Development and
Building Construction, Division office Kathmandu, for providing data / information
on the topic and also for extending continued support to complete the study.
We are very much thankful to Mr. Ishwari Prasad Ghimire and his team members Mr.
Santosh Koirala, Mr. Hari Lal Gyawali and Ms. Achala Dahal for their kind
cooperation during the whole training period.
We would also like to convey our sincere thanks to the respondents from the Kalash
Apartment, Tahachal, Kathmandu for providing the insight of the apartment living.
Finally, the study team would like to express their sincere gratitude to all who directly
or indirectly helped in bringing this report in the present form.
The Study Team
3. Abstract

The study entitled “Present Status of Apartment Building Approval and Construction
in Kathmandu Valley” has been undertaken as a project work in the context of
completing “Advanced Course on Management and Development” for class II
officers of Government of Nepal conducted by Nepal Administrative Staff College
during the period of Paush 23 to Falgun 10, 2069.
Job opportunities and availability of physical facilities causes rapid increase in
population in the urban areas. The increase in population demands the housing
facilities and accordingly the construction of multi-story buildings/apartments are
taking place. Apartment construction is providing the business opportunities for the
builders, financial institutions and manufacturers of construction materials.
Realizing the need to provide safe as well as quality living standard housing facilities,
government has designed the procedures and mandated different agencies as a
regulators. This study is focused mainly in examining the apartment buildings
approval procedures as well as monitoring and supervision process currently practiced
by DOK.
The relevant primary data are collected from residents of Kalash Apartment through
questionnaire survey and secondary data are collected from DUDBC, DOK. The
collected data were analyzed and inferences were drawn. Till Paush 2069, sixty-four

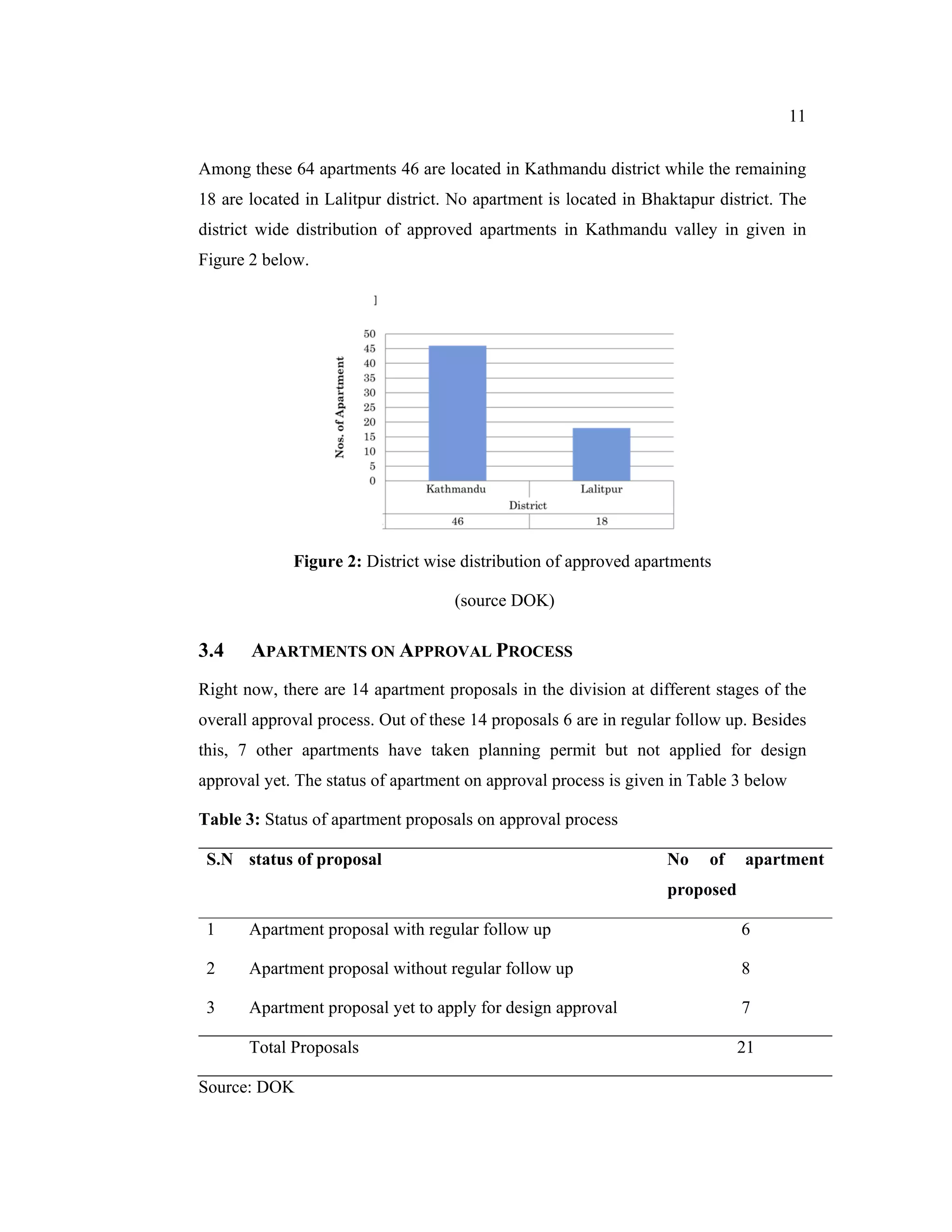

apartments have obtained approval from DOK in the Kathmandu Valley out of which
thirteen apartments are in operation with completion certificate and 15 are on
operation without obtaining completion certificate. 28 are under construction and 8
apartments have yet to start construction. There are many agencies (at least 6)
involved in apartment approval process. DOK lies at the core, but is working under
the condition of resource constraint.

Many issues have emerged as pertinent and challenging in this sector. Some of them
are related to project management while other is ethical.

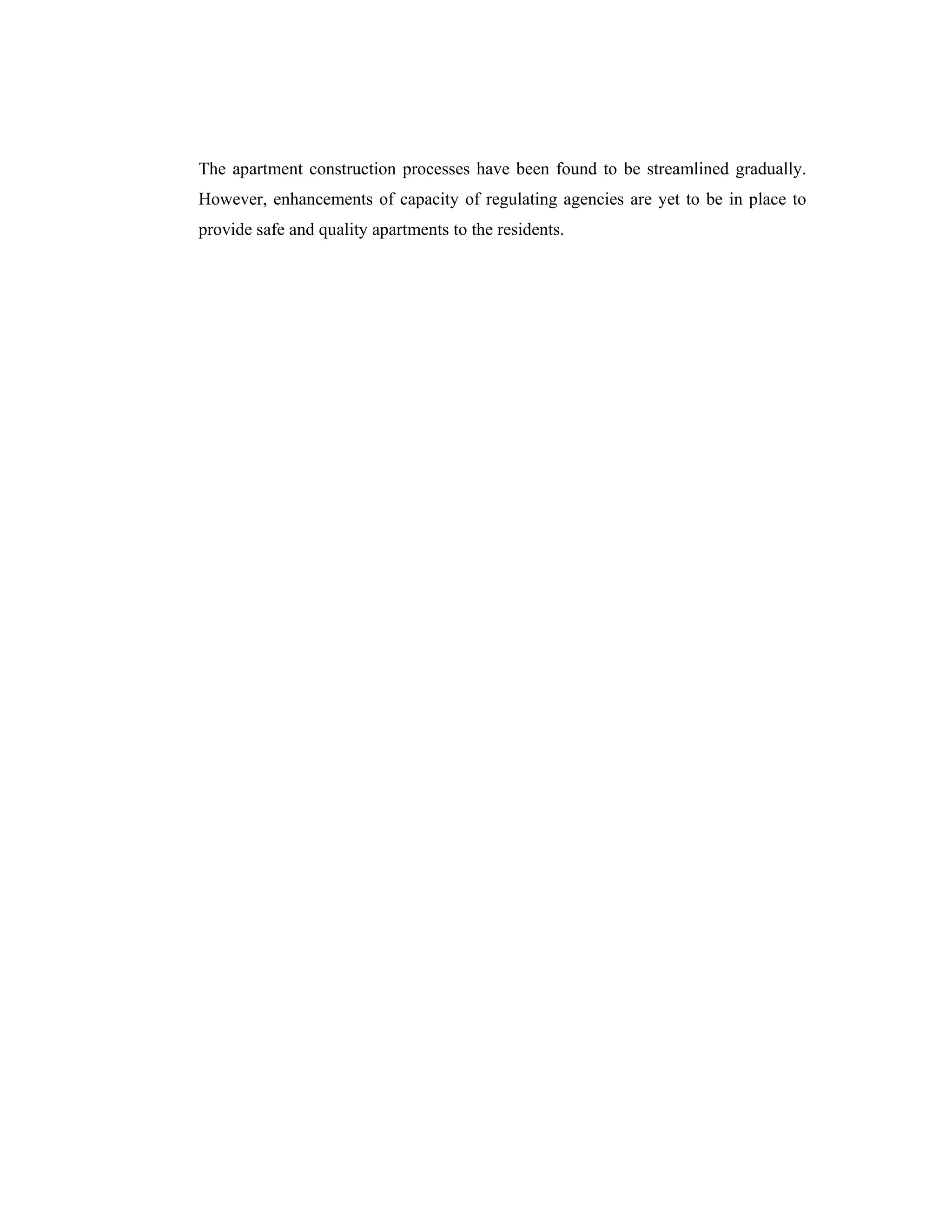

4. The apartment construction processes have been found to be streamlined gradually.
However, enhancements of capacity of regulating agencies are yet to be in place to
provide safe and quality apartments to the residents.
5. i

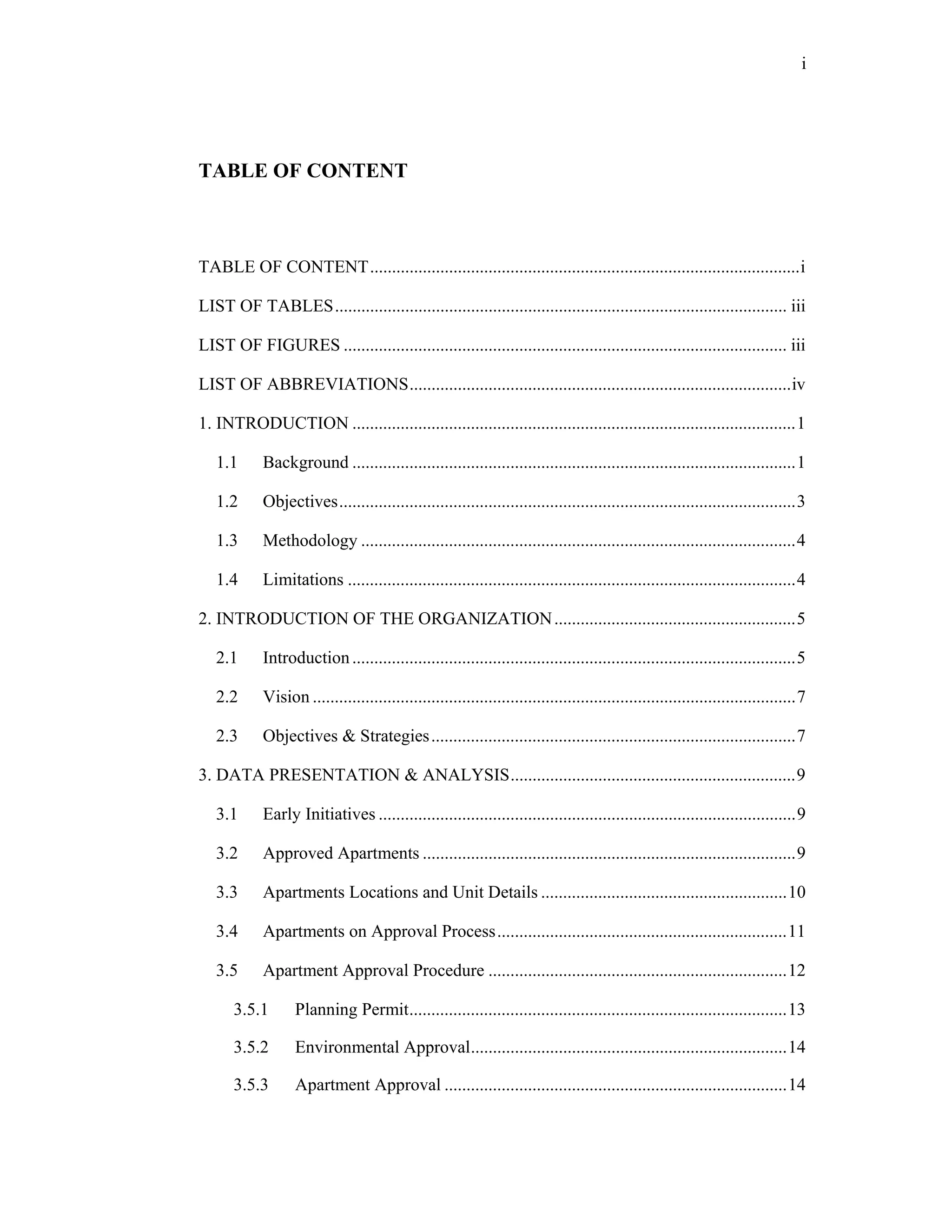

TABLE OF CONTENT

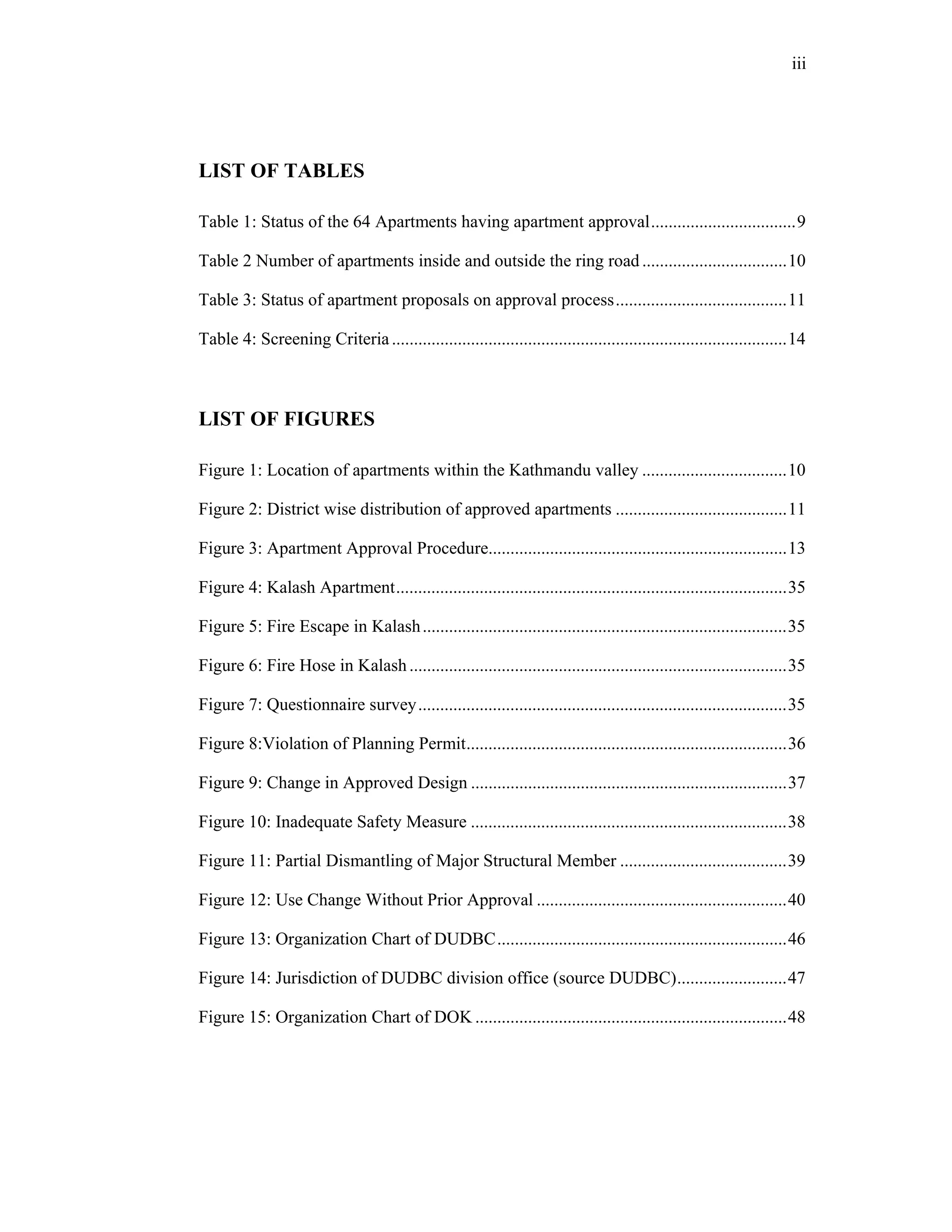

TABLE OF CONTENT .................................................................................................. i
LIST OF TABLES ....................................................................................................... iii
LIST OF FIGURES ..................................................................................................... iii

LIST OF ABBREVIATIONS ....................................................................................... iv
1. INTRODUCTION ..................................................................................................... 1
1.1 Background ..................................................................................................... 1
1.2 Objectives ........................................................................................................ 3
1.3 Methodology ................................................................................................... 4
1.4 Limitations ...................................................................................................... 4

2. INTRODUCTION OF THE ORGANIZATION ....................................................... 5
2.1 Introduction ..................................................................................................... 5
2.2 Vision .............................................................................................................. 7
2.3 Objectives & Strategies ................................................................................... 7

3. DATA PRESENTATION & ANALYSIS ................................................................. 9
3.1 Early Initiatives ............................................................................................... 9
3.2 Approved Apartments ..................................................................................... 9

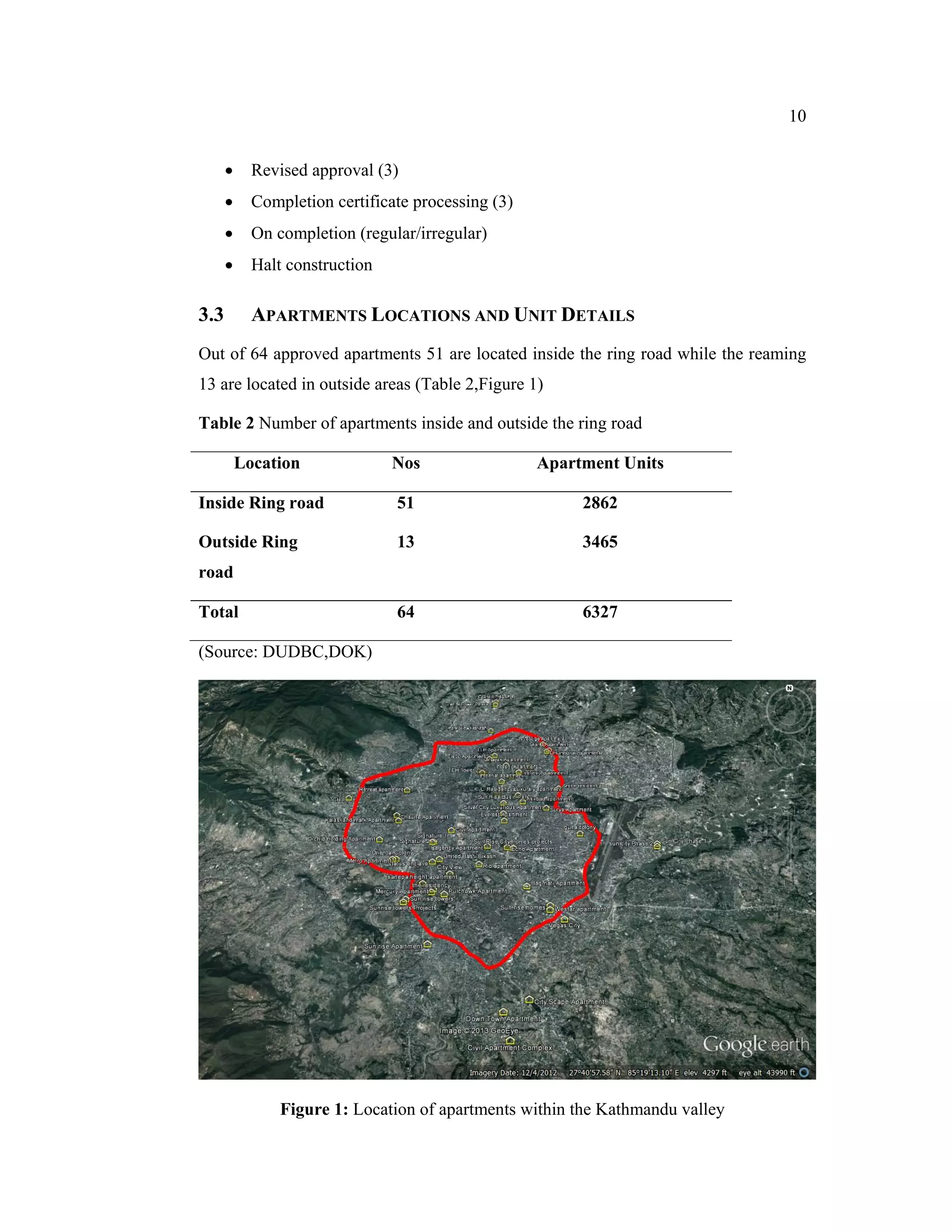

3.3 Apartments Locations and Unit Details ........................................................ 10
3.4 Apartments on Approval Process .................................................................. 11
3.5 Apartment Approval Procedure .................................................................... 12
3.5.1 Planning Permit ...................................................................................... 13
3.5.2 Environmental Approval ........................................................................ 14
3.5.3 Apartment Approval .............................................................................. 14
6. ii

3.6 Monitoring and Supervision .......................................................................... 16
3.7 Issuance of Completion Certificate ............................................................... 17
3.8 APARTMENT LIVING CONDITION ........................................................ 17
3.8 KEY ISSUES ................................................................................................ 18
3.8.1 Time Taken for Approval Process ......................................................... 18
3.8.2 Project Management Issues.................................................................... 19
3.8.3 Insufficient Resources ............................................................................ 19
3.8.4 `Unethical Practices ............................................................................... 20
4. MAJOR FINDINGS, CONCLUSION & RECOMMENDATIONS ....................... 21
4.1 Major Findings .............................................................................................. 21
4.2 Conclusion ..................................................................................................... 22
4.3 Recommendation ........................................................................................... 22
Bibliography ................................................................................................................ 24
APPENDICES ............................................................................................................. 25
Appendix 1 ................................................................................................................... 26
Appendix 2 ................................................................................................................... 31
Appendix 3 ................................................................................................................... 34
Appendix 4 ................................................................................................................... 41
Appendix 5 ................................................................................................................... 45
7. iii
LIST OF TABLES
Table 1: Status of the 64 Apartments having apartment approval ................................. 9
Table 2 Number of apartments inside and outside the ring road ................................. 10
Table 3: Status of apartment proposals on approval process ....................................... 11
Table 4: Screening Criteria .......................................................................................... 14
LIST OF FIGURES
Figure 1: Location of apartments within the Kathmandu valley ................................. 10
Figure 2: District wise distribution of approved apartments ....................................... 11
Figure 3: Apartment Approval Procedure.................................................................... 13
Figure 4: Kalash Apartment ......................................................................................... 35
Figure 5: Fire Escape in Kalash ................................................................................... 35
Figure 6: Fire Hose in Kalash ...................................................................................... 35
Figure 7: Questionnaire survey .................................................................................... 35
Figure 8:Violation of Planning Permit ......................................................................... 36
Figure 9: Change in Approved Design ........................................................................ 37
Figure 10: Inadequate Safety Measure ........................................................................ 38

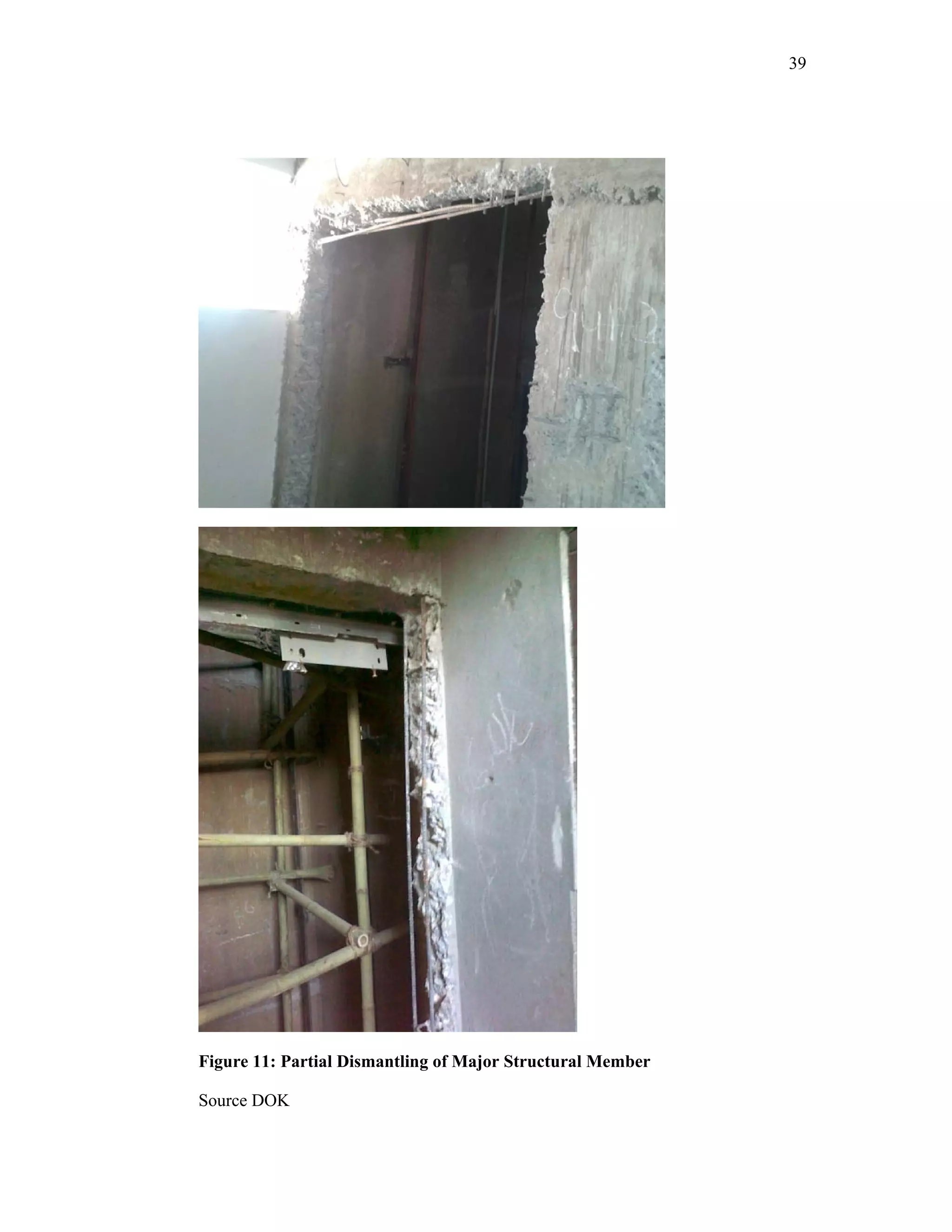

Figure 11: Partial Dismantling of Major Structural Member ...................................... 39
Figure 12: Use Change Without Prior Approval ......................................................... 40
Figure 13: Organization Chart of DUDBC .................................................................. 46
Figure 14: Jurisdiction of DUDBC division office (source DUDBC) ......................... 47
Figure 15: Organization Chart of DOK ....................................................................... 48
8. iv
LIST OF ABBREVIATIONS
CANN Civil Aviation authority of Nepal
DOK Division Office Kathmandu
DUDBC Department of Urban Development and
Building Construction
EIA Environmental Impact Assessment
IEE Initial Environmental Examination
KVDA Kathmandu Valley Development Authority
KVWSMB Kathmandu Valley water supply Management
Board
MoPPW Ministry of Physical Planning & Works
MoUD Ministry of Urban Development
MoSTE Ministry of Science, Technology &
Environment
NNBC Nepal National Building Code
NRRC Nepal Risk Reduction Consortium
OJHA Ownership of Joint Housing Act
OJHR Ownership of Joint Housing Regulation
9. 1
CHAPTER 1
1. INTRODUCTION
1.1 BACKGROUND
The study entitled “Present Status of Apartment Building Approval and Construction
in Kathmandu Valley “has been undertaken as a project work in the context of
completing “Advanced Course on Management and Development” conducted by
Nepal Administrative Staff College from Paush 23 to Falgun 10, 2069.
The National Census (2068 B.S.) revealed that the total population in Nepal is
26,494,504. Out of which the male and female population are 48.50% and 51.50%
respectively. The populations settling in the urban areas are 17.07%.The density of
population in the urban area is 1381 compared to 153 persons per square kilometer in
rural area. Though Nepal has the lowest urbanization rate in south Asia at 14 per cent
its urban growth rate is 6.4 per cent which is the highest in south-Asia. In the last
decade population growth in the urban areas was 3 times that of the country as a
whole. Kathmandu has high population density (4416 person per square kilometer)
compared to other part of the country. Nepal has a total of 5,423,297 households, of
which 85.26% and 12.81% families are residing in their own house and rented houses
respectively. The total number of houses/buildings or residential structures until 2068
are 4,768,196.
The development pace between rural and urban parts of the country resulted people
migrating to urban areas for better opportunities and quality life. Opportunities for
self-employment in enterprises have attracted people in urban areas. Health, education
and other facilities are well developed in urban areas compared to rural. The
migration of the large rural population from the countryside and the influx of
foreigner for business and other purposes have created a need for additional housing
facilities. The available land in the urban areas is limited to provide housing facilities
to the growing population. In order to cater the housing needs of increasing
population, multi-story buildings in the forms of collective and apartment housings
are being developed. People residing in urban areas have less time to arrange the
various physical facilities and security measures on their own. Further, those residing

10. 2
in the individual houses also prefer to move into the apartments for availing better
security and physical facilities. The good earning populations, who are unable to
spend time for building their house are also seeking for the readymade
apartments/buildings. These factors necessitate the need for the apartment buildings.
Increase in demand of housing will continue as the new generation prefers nuclear
families.
The growing demand of the apartments has provided the opportunities for business
communities to diverse the investment in the multi-story building sector. Likewise,
the commercial banks, financial institutions and cooperatives also took this as an
opportunity to diversify the loan portfolio. The construction materials manufacturers
and suppliers are also attracted in this sector. The skilled and unskilled construction
workers also prefer to work in multi-story building construction as it provides long
term employment with assured wages. Thus, the builders, financial institutions and
manufacturers are putting collaborative efforts to get cash benefits from the housing
business.
Building construction around a decade ago was completely a personal matter. There is
a tradition of constructing houses through self-effort and utilizing own resources and
means. The local municipalities were the only authority to give approval to construct
a house after examining the drawings and inspecting the construction site. The limited
technical and financial resources in the municipalities has posed a problem to examine
the overall aspects of construction that includes environmental assessment, structural
design, sanitary, water supply and plumbing system, firefighting system, electrical
system and design etc. in details. These factors are of utmost importance to maintain
safe and quality living.
Considering these aspects, government has formulated 'National Shelter Policy, 2012'
with the vision of providing housing, which is safe, adequate and as per living
standard to all. Change in attitude and working style of both regulating authorities and
construction entrepreneurs are the prime factors for translating the vision into reality.
Multiple agencies are involved in providing clearance to the builder for apartment
construction. Ministry of Science, Technology and Environment (MoSTE) is
responsible for Environmental assessment, Kathmandu Valley Development
11. 3
Authority (KVDA) is for providing planning permit, Civil Aviation Authority
(CAAN) is for clearing safe flying zone, Kathmandu Valley Water Supply and
Management Board (KVWSMB) for groundwater use and Department of Urban
Development and Building Construction (DUDBC) granting approval for apartment
construction. After the clearance from these agencies, final approval is given by the
concerned local government (Municipalities / Village Development
Committee(VDC)).
In the construction of apartments, on the one hand multiple regulatory agencies and
on the other several builders/companies from different background are involved. The
objective of regulatory agencies is to ensure compliance of specified design as well as
quality construction and safety measures whereas, the objective of the
builders/companies is to complete the construction at earliest with minimum cost
ensuring higher profit. The regulating agencies should sincerely adhere to the stated
policy and procedure to approve, monitor and supervise the construction process.
Likewise, the honest effort of the builders is required for timely completion and
quality of construction.
In this context, the team has identified the apartment construction process including
monitoring and supervision as a pertinent issue and decided to undertake as a study
project.
1.2 OBJECTIVES
The general objective of the study is to review the present status of apartment
construction industry in Kathmandu valley.
The specific objectives are:
To assess the apartment construction approval procedures.
To examine the monitoring and supervision process currently adopted by
DUDBC, DOK.
To access the present apartment living condition in a sample apartment.
12. 4
1.3 METHODOLOGY
The information on the apartment construction approval process was gathered from
presentation made by officials from DUDBC, DOK. The unpublished materials
provided during the presentation were reviewed and studied in detail. Legal
provisions relating to apartments were also studied from different acts, regulations
and building bylaws.
The study group visited the Kalash apartment, Tahachal and interacted with the
apartment dwellers and collected necessary information and verified them through
observation at the site. The inference has been derived based on the available data.
1.4 LIMITATIONS
The present study is mainly based on secondary data / information collected
from DUDBC, DOK.
Review of apartment construction approval procedure is mainly focused on the
role of DUDBC, DOK.
The primary information collected is from one apartment (10 residential units)
only and may not represent the case of all the apartments. It is of qualitative
type and only subjective inferences have been made.
13. 5
CHAPTER 2
2. INTRODUCTION OF THE ORGANIZATION
2.1 INTRODUCTION
The first public entity office established in Nepal for construction sector was named
as “Banaune Adda” in 1970 BS during the Rana Regime. Its main objectives were to
maintain the royal palace, existing government buildings and construction of new
project. This office was then renamed as the Department of Building (DoB) in 2020
BS under the then Ministry of Works and Transportation (MoWT) and was mandated
to design and construct the government buildings. From the fiscal year 2027/28 the
department was reformed as Department of Housing, Building and Physical Planning
(DHBUP) and was also mandated to address the growing need of housing and Urban
Planning in Nepal.
In 2044 BS the government of Nepal gave priority to planned urban growth as well as
safe shelter and formed a new Housing and Physical Planning Ministry. In 2045 BS
under this new ministry DHBUP was reconstituted into two separate entities namely;
Department of Buildings(DOB) and The Department of Housing & Urban
Development(DHUD) at the central level; whereas as the regional and district level,
both the departments have the same offices. The district chiefs of these offices were
deputed as the member secretary of the concerned Town Development Committees.
Again in 2058 the government of Nepal reorganized the two departments into one
single unit under the Ministry of Physical Planning & Works (MPPW) and named the
newly formed entity as Department of Urban Development and Building construction
(DUDBC) to avoid duplications in works carried out by the then two departments.
Recently in 2069 BS this department has been put under the newly formed Ministry of
Urban Development (MoUD).
At present DUDBC have three divisions, twenty-four division offices and one training
center (Appendix 5,Figure 13) The main task of the Department of Urban
Development and Building Construction (DUDBC) lies in the sphere of planning.
Since 2002, the office assisted in the preparation of Periodic Plans following the

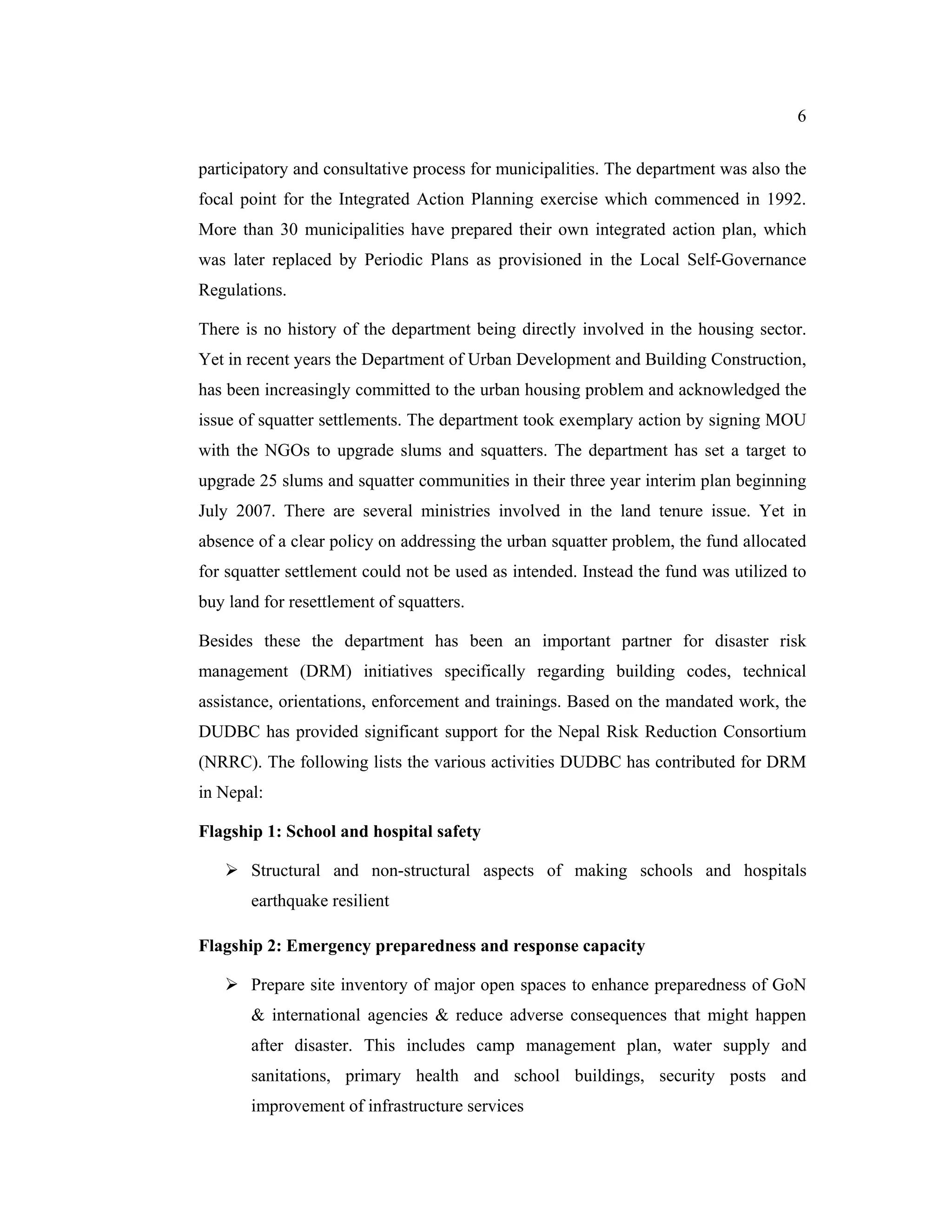

14. 6
participatory and consultative process for municipalities. The department was also the
focal point for the Integrated Action Planning exercise which commenced in 1992.
More than 30 municipalities have prepared their own integrated action plan, which
was later replaced by Periodic Plans as provisioned in the Local Self-Governance
Regulations.
There is no history of the department being directly involved in the housing sector.
Yet in recent years the Department of Urban Development and Building Construction,
has been increasingly committed to the urban housing problem and acknowledged the
issue of squatter settlements. The department took exemplary action by signing MOU
with the NGOs to upgrade slums and squatters. The department has set a target to
upgrade 25 slums and squatter communities in their three year interim plan beginning
July 2007. There are several ministries involved in the land tenure issue. Yet in
absence of a clear policy on addressing the urban squatter problem, the fund allocated
for squatter settlement could not be used as intended. Instead the fund was utilized to
buy land for resettlement of squatters.
Besides these the department has been an important partner for disaster risk
management (DRM) initiatives specifically regarding building codes, technical
assistance, orientations, enforcement and trainings. Based on the mandated work, the
DUDBC has provided significant support for the Nepal Risk Reduction Consortium
(NRRC). The following lists the various activities DUDBC has contributed for DRM
in Nepal:
Flagship 1: School and hospital safety
Structural and non-structural aspects of making schools and hospitals
earthquake resilient
Flagship 2: Emergency preparedness and response capacity
Prepare site inventory of major open spaces to enhance preparedness of GoN
& international agencies & reduce adverse consequences that might happen
after disaster. This includes camp management plan, water supply and
sanitations, primary health and school buildings, security posts and
improvement of infrastructure services
15. 7
Municipal Profiles in terms of Earthquake Risk and Vulnerability,
Vulnerability Assessment and Damage Assessment.
Flagship 5: Policy/institutional support for disaster risk management
Preparation of Risk Hazard Map, GIS map of municipalities.
Study of Existing Practices in High Rise Building & Recommendation for
safety.
Support to municipalities on Building code implimentation & Update of Nepal
National Building Code
Seismic Vulnerability Evaluation Guideline for Private and Public Building /
Training Manual / Training on Damage Assessment, Vulnerability
Assessment, Demonstrative Retrofitting works
2.2 VISION
The main vision of the Department is:
Urban Development Sector: Achieve a balanced national urban structure,
Promote safe and economically vibrant urban environment and Promote
effective urban management.
Housing Sector: Promote Planned Development through providing affordable,
adequate and safe shelter to all income group people.
Building: Promote safe, economical and Environment friendly buildings that
can display indigenous architecture
2.3 OBJECTIVES & STRATEGIES
Objectives
Urban Development
To invest in urban infrastructure and other services through inter-agency coordination,
to legally empower and institutionally strengthen local bodies in order to build a
clean, safe and prosperous urban environment, and to progressively guide rural
settlements towards urbanization by expanding rural urban inter-relationship under
the overall notion that urban development promotes rural development.
16. 8
Housing
To provide safe and economical housing facility by developing organized habitats
under the notion of “shelter for all”.
Building
To construct and develop buildings which portray Nepalese architecture to the extent
possible, and are safe, affordable and environmental friendly.
Strategies
• To develop large urban centers in the country as regional economic centers, and to
link them with medium and small centers through roads and other infrastructures,
and thereby strengthen the rural urban inter-relationship.
• To guide urban development by establishing urban infrastructure through physical
development planning with an aim to preserve and conserve the existing cultural,
historical and tourist areas. To develop suburbs at the periphery of the city and to
prepare a base for planned development of urbanizing VDCs.
• To develop local bodies as the major agency to implement urban plans, and also
strengthen institutional capability of concerned central agencies involved in urban
planning and policy formulation, and monitoring.
• To develop urban housing with the participation and involvement of the
government, cooperatives and the private sector.
• To develop market centers in the urbanizing settlements and develop requisite
infrastructure in the scattered settlements in rural areas, while regulating
development in urban and rural settlements to preserve historical and cultural
heritage.
• To update and implement the Building Code and byelaws in the government and
private sectors as well.
• To promote and develop the capability of national consultants and contractors.
• To develop appropriate building construction technology and materials.
17. 9
CHAPTER 3
3. DATA PRESENTATION & ANALYSIS
3.1 EARLY INITIATIVES
The need of "Joint housing" was felt during early 2050BS due to the sudden increase
of population pressure on urban areas and the subsequent increase in the land price.
Nepal enacted the Ownership of Joint Housing Act (OJHA), in 2054 (authentication
and publication date: 2054.9.7). However, the actual apartment building began after
the approval of Ownership of Joint Housing Regulation (OJHR) by the then HMG/N
in 2060/04/12 B.S. Indreni Apartment - 1 (having 32 units), located at Kathmandu
municipality - 4, Bhatbhateni, Kathmandu and owned by Subhakamana Housing
company Pvt. Ltd, was the first to obtain the apartment construction approval from
DUDBC, DOK.
3.2 APPROVED APARTMENTS
In total 64 apartments have obtained apartment construction approval from the
division till paush 2069. Status of these 64 apartments has been summarized in Table
1 below.
Table 1: Status of the 64 Apartments having apartment approval
S. Status No of apartments
No
1 On operation with completion certificate 13
2 On operation without completion certificate 15
3 On construction phase and others* 28
4 Construction not started 8
Total 64
Source: DUDBC, Division office, Babarmahal, Kathmandu
*On construction phase and others
18. 10
Revised approval (3)
Completion certificate processing (3)
On completion (regular/irregular)
Halt construction
3.3 APARTMENTS LOCATIONS AND UNIT DETAILS
Out of 64 approved apartments 51 are located inside the ring road while the reaming
13 are located in outside areas (Table 2,Figure 1)
Table 2 Number of apartments inside and outside the ring road
Location Nos Apartment Units
Inside Ring road 51 2862
Outside Ring 13 3465
road
Total 64 6327
(Source: DUDBC,DOK)
Figure 1: Location of apartments within the Kathmandu valley
19. 11
Among these 64 apartments 46 are located in Kathmandu district while the remaining
18 are located in Lalitpur district. No apartment is located in Bhaktapur district. The
district wide distribution of approved apartments in Kathmandu valley in given in
Figure 2 below.
Figure 2: District wise distribution of approved apartments
(source DOK)
3.4 APARTMENTS ON APPROVAL PROCESS
Right now, there are 14 apartment proposals in the division at different stages of the
overall approval process. Out of these 14 proposals 6 are in regular follow up. Besides
this, 7 other apartments have taken planning permit but not applied for design
approval yet. The status of apartment on approval process is given in Table 3 below
Table 3: Status of apartment proposals on approval process
S.N status of proposal No of apartment
proposed
1 Apartment proposal with regular follow up 6
2 Apartment proposal without regular follow up 8
3 Apartment proposal yet to apply for design approval 7
Total Proposals 21
Source: DOK
20. 12
3.5 APARTMENT APPROVAL PROCEDURE
The entire apartment approval procedure can be discussed under the following three
stages.
Stage 1: Planning Permit Stage
Developer produce project proposal with design and drawings for planning
permit
Developer applies for planning permit from KVDA
Developer undertakes environmental screening
Stage 2: Apartment Approval Stage
Developer applies for apartment approval from DOK, DUDBC
Developer undertakes EIA/IEE study as required
Developer applies for clearance from civil aviation authority for safe flying
zone
Developer applies for approval from KVWSMB for groundwater use
Stage 3: Local Body Approval Stage
Applies for approval from municipality/VDC concerned
21. 13
The overall apartment approval procedure has been summarized in Figure 3 below.

Figure 3: Apartment Approval Procedure
(Source DOK, modified)
3.5.1 Planning Permit
As mention above, the developer has to apply to Kathmandu Valley Development
Authority (KVDA) with required planning permit design and drawing for planning
permit. KVDA reviews the documents within the broad framework of:
Town Development Act, 2045
Gazette published on BS 2062/11/22 and
Building by-laws 2064
The key elements covered by planning permit include:
Construction area, approach road, Set back, FAR, light plane
Ground coverage, greenery (open surface) and other open spaces
Distance between blocks
Parking facilities
Planning related issues like sewer, electrical systems, GLD lines, HT line,
water supply plan
22. 14
Waste water and solid waste management
3.5.2 Environmental Approval
The project developer has to undertake the environmental assessment as per the
guidance of Environment Protection Act, 2053 and Environment Protection
Regulation 2055. The first task to undertake this process is to carry out the
environmental screening so as to determine whether the project requires IEE or EIA,
or it does not require any assessment at all. The screening criteria as mentioned in
EPR, 2055 is shown below in Table 4:
Table 4: Screening Criteria
SN Criteria No EA IEE EIA
1 Build Up Area <5000 sqm 5000-10000 sqm >10000 sqm
2 No of Story <10 10-16 >16
3 Height of the Building <25 m 25-50 m >50 m
4 NO of Inflow and Outflow at a <1000 person 1000-2000 >2000 persons
time persons
Source DOK
The developer conducts either IEE or EIA and submits the report to competent
authority MoUD in case of IEE and MoSTE in case of EIA) for approval. The key
aspects/areas covered by IEE/EIA document include:
Project description covering construction planning
Review of relevant policies in relation to the project implementation
Alternative analysis
Major adverse environmental impacts and their mitigation measures
Major beneficial environmental impacts and their enhancement measures
Environmental management plan ( environmental monitoring plan covered)
3.5.3 Apartment Approval
The developer applies to the DUDBC, DOK for design approval and construction and
operation permit with all required documents. The Division office reviews the
23. 15
proposal in line with the broad framework provided by the following policy
instruments.
OJHA 2054 & OJHR 2060
Building act 2055
Nepal National building code 2060
Work procedure 2060
The key elements covered by Apartment Approval are:
Architectural Design
Light and ventilation system
Staircase, exit
Lobby, lift, disable ramp, parapet height
Glazing system
Structural Design
Geo-technical investigation
Structural analysis/model as per NNBC 2060
Structural drawing with respect to output of structural design and ductile
detailing code
Sanitary, water supply and planning system
• Water supply/Treatment Plant/Pumping System
• Toilet Bath fixtures and installation systems.
• Liquid waste and solid waste management system.
• Rain water Harvesting Systems.
Firefighting system
• Fire Detector, Fire extinguisher, Firefighting Hose reels, Hose pipes, Water
tank, Hydrant stations.
• Fire escape staircase, Exit, Lobby, Escape route.
Electrical system and design
• Electrical Points, load calculation, Cable sizes.
• Earthing, Lightning arrestor.
24. 16
• Safety against electrical hazards.
• Transformer, Generator and Panel Boards.
Operation and management plan (including safety management plan)
• Electrical, Sanitary services operation and management plan.
• Fire safety management and earthquake safety management plan.
• Evacuation area, Exit, Use of Open Spaces during Disaster
The division office may ask for presentation from designer for complex structures.
There is also the provision for "review" by "expert panel" for such complex
structures. The documents to be submitted to DOK along with the proposal are:
• Application form.
• Provision of details of Services/Facilities.
• Sample of Contract agreement paper. (As per clause 15 of OJHA2054)
• Land and Company related ownership documents.
• Proprietor, Developers Representatives.
• Quality assurance documents and designer’s affidavit papers.
• Project brief reports, design reports and soil test reports.
• Insurance letter.
3.6 MONITORING AND SUPERVISION
Monitoring and supervision from DOK is mainly focused on checking of
reinforcement detailing before/during casting of important structural components e.g.
foundation, column, slab and beam. Monitoring from DOK also involves reviewing of
the periodic progress reports and lab test reports. The main constraint on monitoring
and supervision from the DOK prospective is the lack of adequate resources, mainly
the human resources (Shown in Appendix 5, Figure 15).
The task of conducting environmental monitoring lies within the concerned line
ministry, MoUD in this case. However, no regular and systematic environmental
monitoring has been conducted so far. Monitoring from other agencies like KVDA
and local bodies (Municipality/VDC) have been reported to be weak as well.
Monitoring of the DOK has reported the following diversified observations:
25. 17
Violations of planning permit and building by-laws(Appendix 3, Figure 8)
Change in approved design/drawings. (Appendix 3, Figure 9)
Major construction work without presence of technical team (Project
manager, engineer, architects)
Approved drawing/detailing not available at site.
Project manager/site engineer unknown about approved drawings
Inadequate safety measures (Appendix 3,Figure 10)
Approved design followed strictly and safety tools used properly
Partial dismantling of major structural elements (Appendix 3, Figure 11)
Use change without prior approval (Appendix 3, Figure 12)
3.7 ISSUANCE OF COMPLETION CERTIFICATE
The project developer submits the project completion report (with as built drawings),
quality control reports and environmental compliance report to DOK. The DOK
engineers undertake site visits for final checking including the firefighting system. In
case, where the regular quality test reports were not submitted to the DOK, the third
party consultant is hired for post construction quality test and structural design
verification.
The Division office issues the completion certificates when all the reports and
observations comply with the design requirements.
3.8 APARTMENT LIVING CONDITION
The aim of the study team was to visit at least one apartment in Kathmandu valley to
access the existing situations. The study team decided to visit Kalash Apartment
which is situated at Tahachal, Kathmandu. It is centrally located. It is a multi-story
(nine stories) apartment. It has been functioning since two years. There are altogether
75 units out of which only 50 units are found to be occupied. Developer has already
obtained construction completion certificate from DOK.

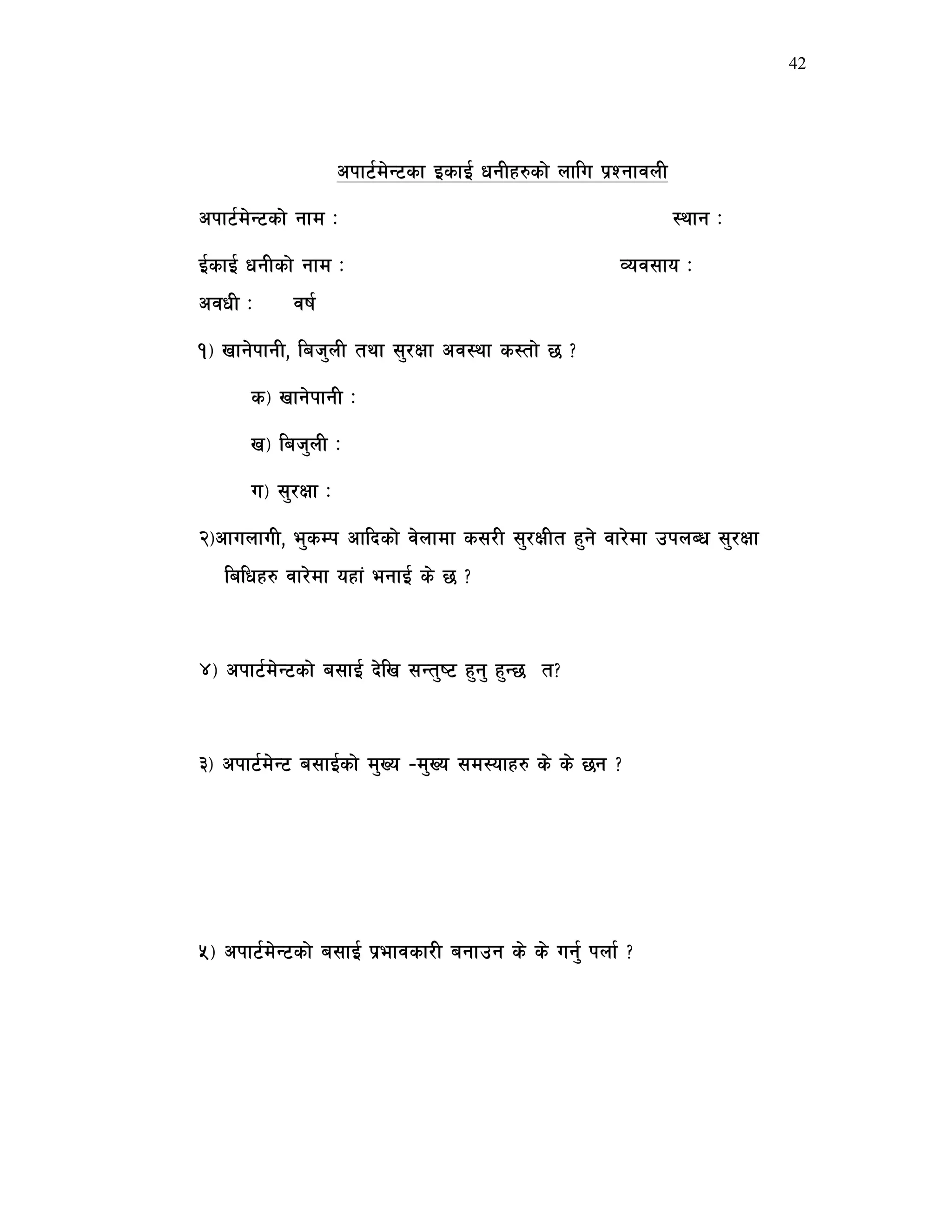

A sample questionnaire was prepared which was mostly related with the extent of
satisfactions of the unit owner, major problems faced by unit owners in smooth
operation and their opinion for its improvement. The interaction was two way and
26. 18
conducted in an open environment. They inquired us about existing policies, acts and
regulation. Most of them were not aware with OJHA and OJHR. After interaction the
team walked around and had a look on facilities provided. Apartment has been found
to be furnished with most required facilities like parking space, exits for emergency,
sauna, health club, fire extinguisher etc.
The assessment from the interaction was very much interesting to us. Apartment is
completely dependent on ground water supply for bathing, utensils cleaning, cloth
washing etc. and unit owners uses aqua guards for drinking purpose. It has a generator
for electricity backup during load shedding, but it faces fuel shortage and improper
management. The unit owners have themselves arranged security personnel and they
are quite satisfied with securities arrangements made by them. There were several
issues opined from most of them. Unit owners are still without ownership certificate
(LALPURJA) of their units. Ownership transfer must have completed by December,
2011 but still they are in hands of developer. Most of the unit owners are
businessman. They need PAN numbers urgently but in absence of ownership
document they are unable to get it. Developers still have not yet transferred
apartments operation and management to existing society. The open space for
children is not available. There is a temporary arrangement for garbage disposal
which is altogether managed by dwellers themselves. There is not sufficient space
available after exit which is must in the case of emergency.
3.8 KEY ISSUES
3.8.1 Time Taken for Approval Process
Organization structure of the Kathmandu Division (Appendix5, Figure 15) depicts
inadequacy of technical manpower for the evaluation of structural and non-structural
designs along with monitoring of mushrooming apartments of Kathmandu valley.
Developer’s unwillingness to obtain design approval due to uncertainty in the market
behavior either from government’s inconsistent decisions or from economic recession
also becomes the cause of some delay in approval process. IEE/EIA processes
(though necessary and mandatory) were identified as being cumbersome and time
consuming due to its unclear (non-standardized) processes and guidelines. Apartment
27. 19
construction approval process seeks approval from as many as nine (6) agencies. All
those agencies have their own working norms. It is natural that delay occurs due to
several agency involvements.
3.8.2 Project Management Issues
There are some smaller but significant issues relating to project management. Some of
important issues that have emerged during the past years of apartment housing in
Nepal are:
1. Frequent change of technical personnel leading to a gap between old and new
and between the business and the regulating authority.
2. Weaker coordination between developer, consultant and the contractor's
technical personnel hindering the smooth, timely and orderly implementation
of the activities.
3. Improper and inadequate safety consideration during construction.
4. Weak progress reporting.
5. Construction without prior checking by DOK.
6. Use change without prior approval.
3.8.3 Insufficient Resources
In Kathmandu valley, urbanization is in rapid expansion and a large number of
apartments are under construction. Giving permission of building construction,
supervision and monitoring during construction and issuing completion certificate to
the developer are the major responsibilities of the DOK in the apartment sector.
Within the division, having no separate section for apartment, the available human
resources (technical as well as administrative) are insufficient in relation to its work-
load. Still the division is working under the old organogram. It is realized that due to
insufficient human resource, division has felt difficulty in delivering its services
smoothly. The issue is not related to human resource only, other resources like budget
and vehicles for supervision and monitoring are also felt inadequate. On the other
hand, the office management/operational cost are same as in the past despite increased
28. 20
work load. In totality all the factors discussed above are hindering the apartment
construction business as a whole.
3.8.4 `Unethical Practices
It has been reported that designer change (one person designs and the other signs the
drawings and affidavit) is prevailing in practice. Such unethical practices are indeed
one of the serious concerns for the DOK and are yet to be checked.
29. 21
CHAPTER 4
4. MAJOR FINDINGS, CONCLUSION & RECOMMENDATIONS
4.1 MAJOR FINDINGS
1. There are at least 6 agencies directly involved in the apartment approval
process. In this sense it can be regarded as a multi stakeholder task. The DOK,
has a key role and is focused mainly on safety criteria by ensuring adoption of
National Building Code.
2. It has been noticed that the time taken for the apartment approval process
(from planning permit to approval from local body) was found to be varying
widely (6 months to 3 years). It is not only the regulatory body's role which is
responsible for such wide variation; equally important factors are the market
condition and the promoter's management skill.
3. The Kathmandu Division Office is handling the entire task of apartment
approval, monitoring and supervision on top of its regular job. The
organization structure of the division has remained the same since 2058 B.S.
No arrangements have been made to accomplish the additional task on
"apartment" which was assigned to the division by the gazette dated
2060/01/02 B.S. In addition to this, the division office is also facing serious
resource constraints.
4. Some apartments have been reported to be operating without completion
certificate from DOK. Furthermore few cases of even ownership transfer
(without completion certificate from DOK) have also been reported.
5. During the period of last 8/9 years some issues has been emerged as pertinent
and challenging. Some are ethical (designer change) while other are related to
project management (weak progress reporting, safety during construction,
construction without prior checking by DOK etc.) . Use change has emerged
as another major issue.
6. The residents (apartment owner) of the surveyed apartment are found to be
unaware of the concerning laws and regulations. They doubt whether the

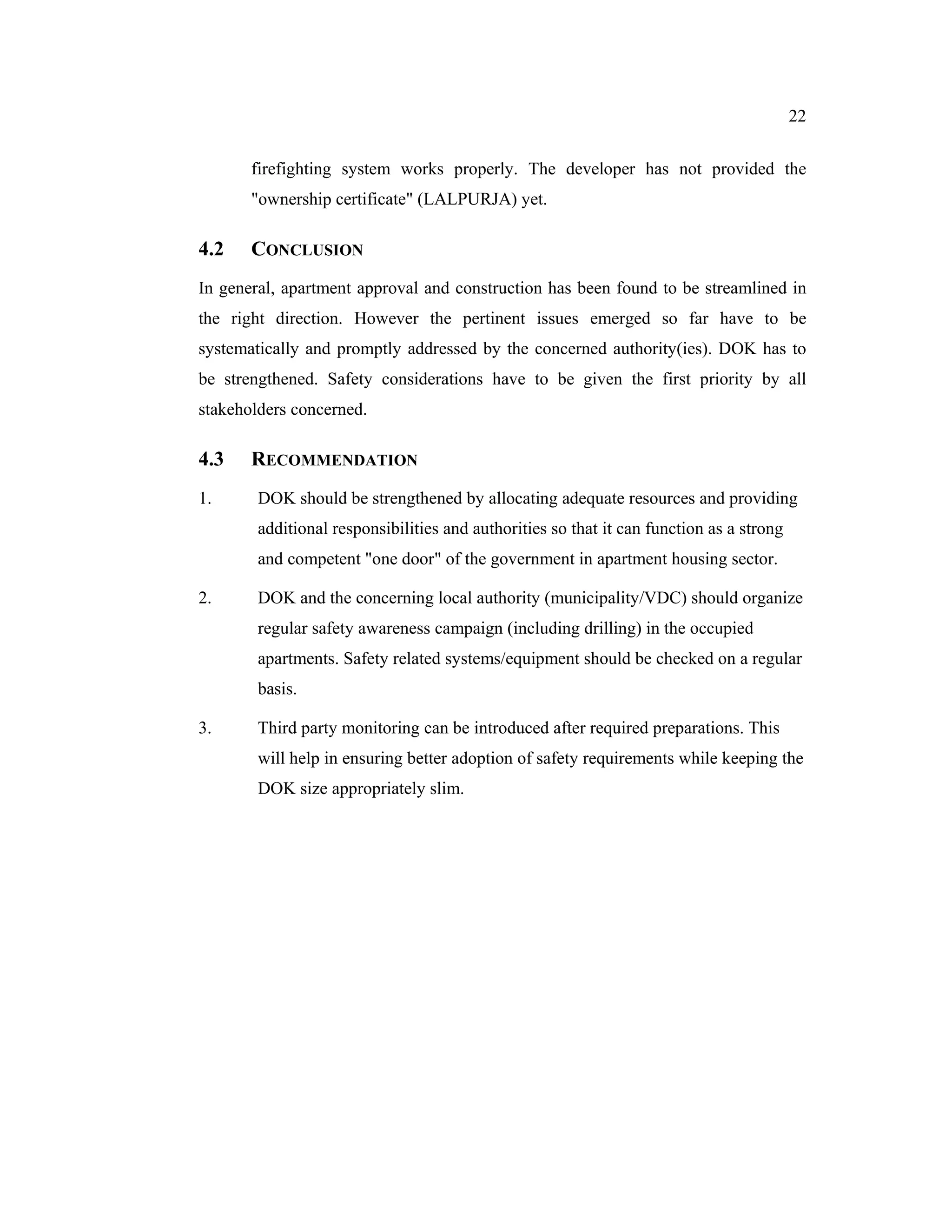

30. 22
firefighting system works properly. The developer has not provided the
"ownership certificate" (LALPURJA) yet.
4.2 CONCLUSION
In general, apartment approval and construction has been found to be streamlined in
the right direction. However the pertinent issues emerged so far have to be
systematically and promptly addressed by the concerned authority(ies). DOK has to
be strengthened. Safety considerations have to be given the first priority by all
stakeholders concerned.
4.3 RECOMMENDATION
1. DOK should be strengthened by allocating adequate resources and providing
additional responsibilities and authorities so that it can function as a strong
and competent "one door" of the government in apartment housing sector.
2. DOK and the concerning local authority (municipality/VDC) should organize
regular safety awareness campaign (including drilling) in the occupied
apartments. Safety related systems/equipment should be checked on a regular
basis.

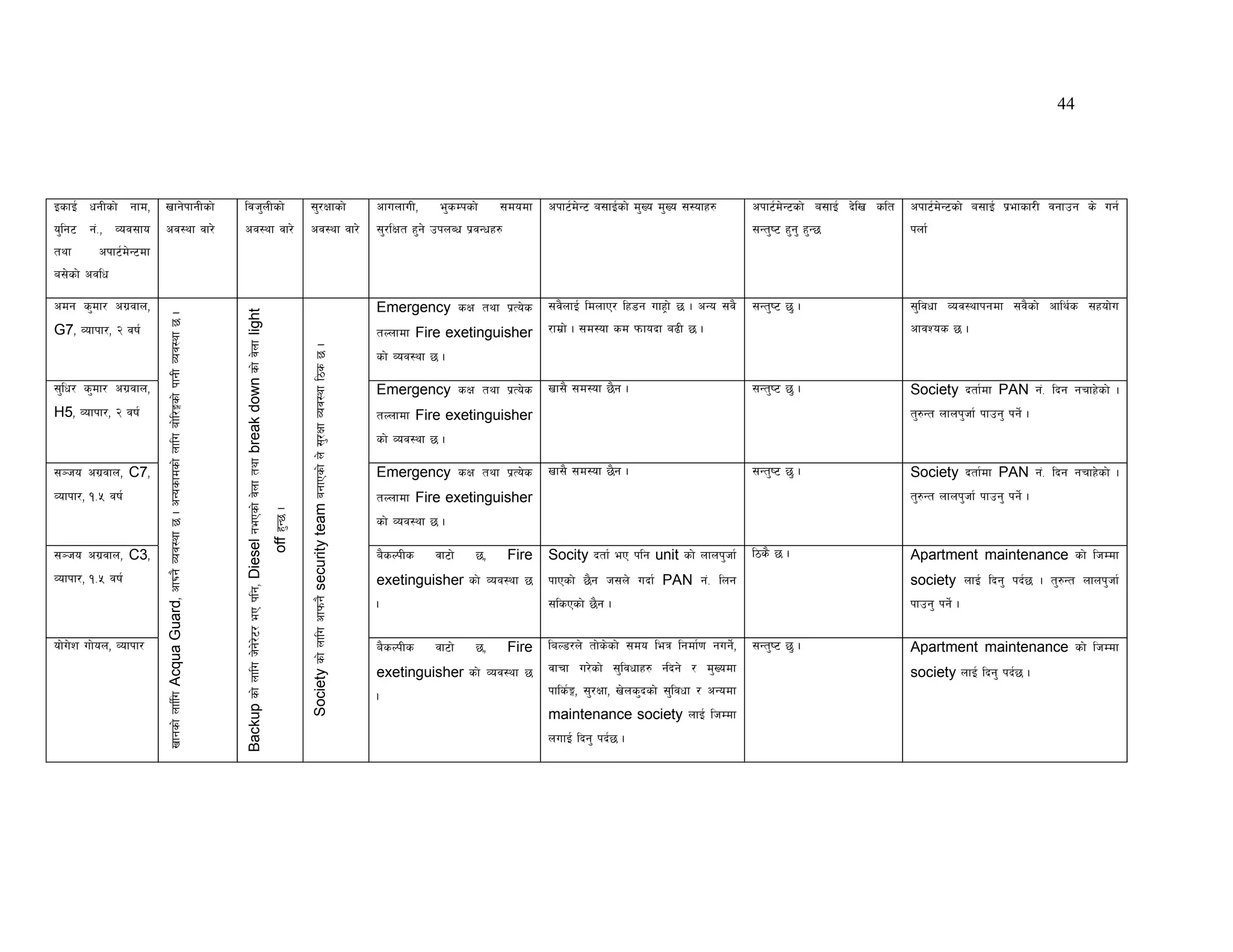

3. Third party monitoring can be introduced after required preparations. This
will help in ensuring better adoption of safety requirements while keeping the
DOK size appropriately slim.
32. 24
BIBLIOGRAPHY
Government of Nepal Building Bye Law. - 2064.
Government of Nepal Environment Protection Act. - 2053.
Government of Nepal Environment Protection Regulations. - 2055.
Government of Nepal Ownership of Joint Housing Act, 2054. - 1997.
Government of Nepal Ownership of Joint Housing Regulations. - 2060.
http:www.dudbc.gov.np [Online]. - Department of Urban Development & Building
Construction.
National Census: A Brief Report [Report]. - [s.l.] : Bureau of Statistic,Government of
Nepal, 2012.
National Shelter Police [Report]. - [s.l.] : Ministry of Urban Development,
Government of Nepal, 2012.
Nepal Urban Housing sector Profile [Report]. - [s.l.] : UN-HABITAT, 2010.
54. 46
Director General
DDG DDG DDG
Urban Dev Building Divison
Housing Divison
Divison
Physical Planning & Building Housing Division Office Building
Urban Dev Construction
(24 Nos.) construction &
Building Code maintenance
Urban Environment Planning Divison
Building
Small Town
Monitoring
Maintenance &
Municipality Evaluation Class II
Class I
Standardization Foreign Aid Division Chief Division
Stastical & Coordination Chief
GIS
Building General Fiscal Procuremen Legal
Technology Administration t Unit
Administration
Research & & HR
Training Center
