Bachelor of Quantity Surveying (Honours)
Professional Practice 1
Group members: Felix Vong Zhi Wei 0318462
Lee Ern Hui 0319703
Elliot Pang Tiu Seng 0319438
Welson Lum Wei Jiunn 0319514
Kevin Lee Hee Xian 0315192
2 | P a g e
Table of content
Content Page
1.0 Introduction 3
2.0 Management Contracting 4
2.1 Advantages 4
2.2 Disadvantages 4
3.0 Traditional Procurement Method 5
3.1 Advantages 5
3.2 Disadvantages 5
4.0 Lump Sum Contract 6
4.1 Suitability of Lump Sum Contract 6
4.2 Lump Sum Contract Analysis 6
5.0 Design and Build 8
6.0 Critical Analysis 10
7.0 Reference Link 11
3 | P a g e

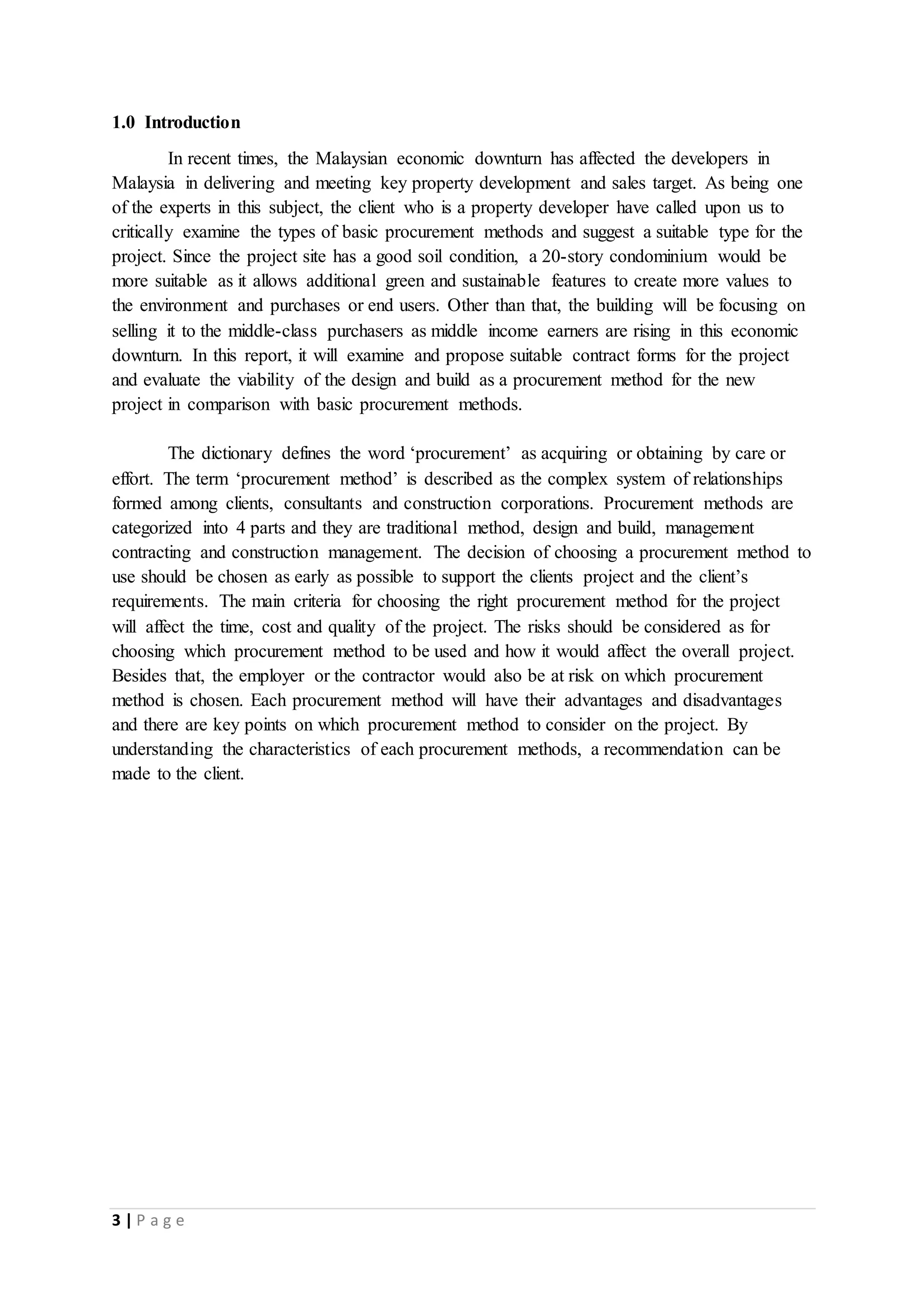

1.0 Introduction
In recent times, the Malaysian economic downturn has affected the developers in
Malaysia in delivering and meeting key property development and sales target. As being one
of the experts in this subject, the client who is a property developer have called upon us to
critically examine the types of basic procurement methods and suggest a suitable type for the
project. Since the project site has a good soil condition, a 20-story condominium would be
more suitable as it allows additional green and sustainable features to create more values to
the environment and purchases or end users. Other than that, the building will be focusing on
selling it to the middle-class purchasers as middle income earners are rising in this economic
downturn. In this report, it will examine and propose suitable contract forms for the project
and evaluate the viability of the design and build as a procurement method for the new
project in comparison with basic procurement methods.
The dictionary defines the word ‘procurement’ as acquiring or obtaining by care or
effort. The term ‘procurement method’ is described as the complex system of relationships
formed among clients, consultants and construction corporations. Procurement methods are
categorized into 4 parts and they are traditional method, design and build, management
contracting and construction management. The decision of choosing a procurement method to
use should be chosen as early as possible to support the clients project and the client’s
requirements. The main criteria for choosing the right procurement method for the project
will affect the time, cost and quality of the project. The risks should be considered as for
choosing which procurement method to be used and how it would affect the overall project.
Besides that, the employer or the contractor would also be at risk on which procurement
method is chosen. Each procurement method will have their advantages and disadvantages
and there are key points on which procurement method to consider on the project. By
understanding the characteristics of each procurement methods, a recommendation can be
made to the client.
4 | P a g e

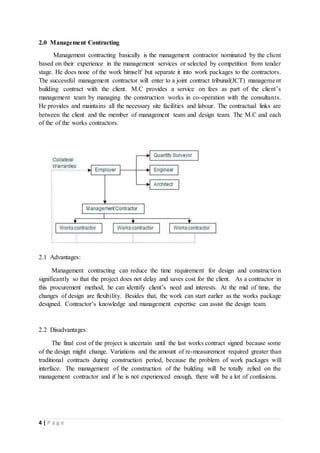

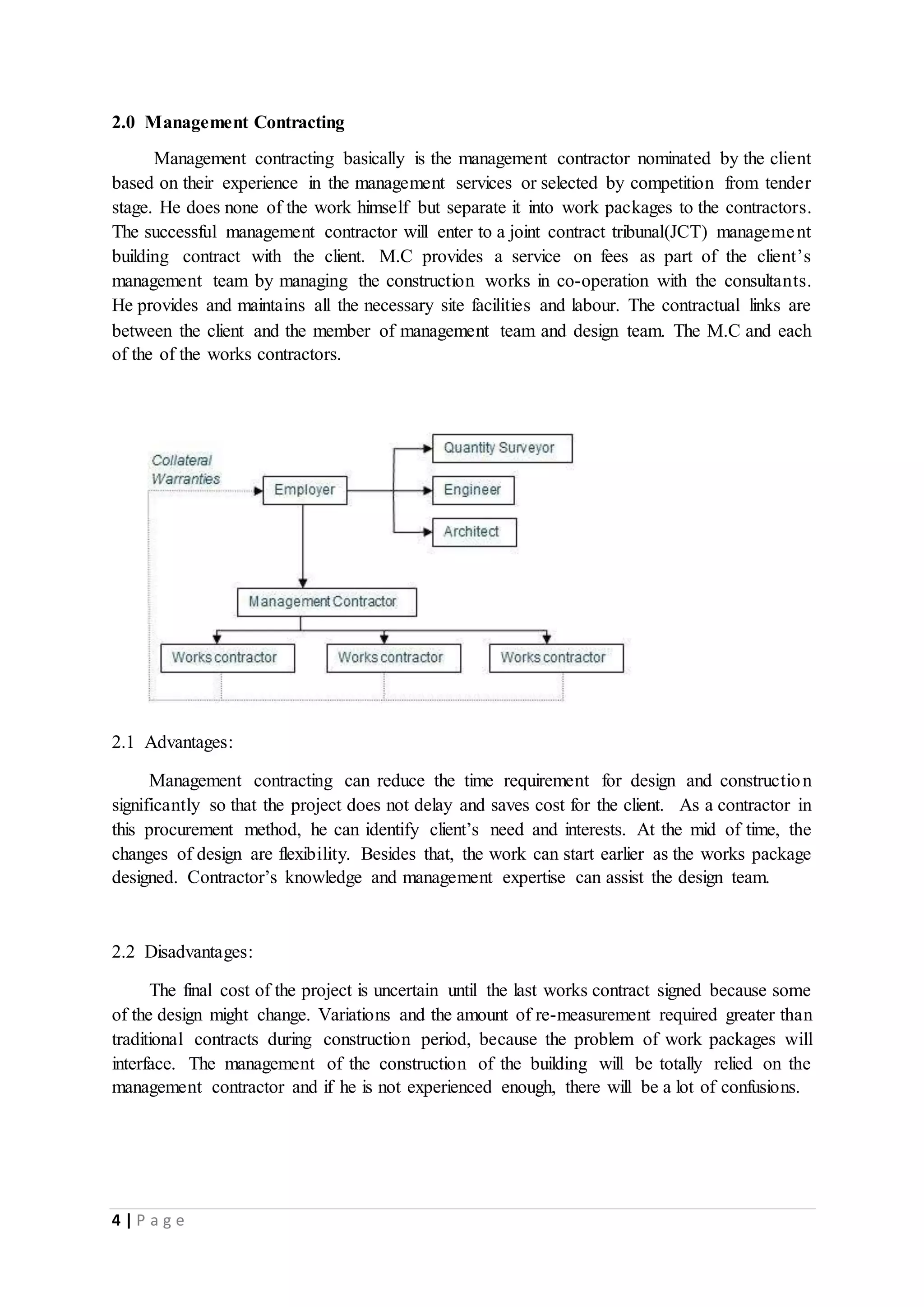

2.0 Management Contracting
Management contracting basically is the management contractor nominated by the client
based on their experience in the management services or selected by competition from tender
stage. He does none of the work himself but separate it into work packages to the contractors.
The successful management contractor will enter to a joint contract tribunal(JCT) management
building contract with the client. M.C provides a service on fees as part of the client’s
management team by managing the construction works in co-operation with the consultants.
He provides and maintains all the necessary site facilities and labour. The contractual links are
between the client and the member of management team and design team. The M.C and each
of the of the works contractors.
2.1 Advantages:
Management contracting can reduce the time requirement for design and construction
significantly so that the project does not delay and saves cost for the client. As a contractor in
this procurement method, he can identify client’s need and interests. At the mid of time, the
changes of design are flexibility. Besides that, the work can start earlier as the works package
designed. Contractor’s knowledge and management expertise can assist the design team.
2.2 Disadvantages:
The final cost of the project is uncertain until the last works contract signed because some
of the design might change. Variations and the amount of re-measurement required greater than
traditional contracts during construction period, because the problem of work packages will
interface. The management of the construction of the building will be totally relied on the
management contractor and if he is not experienced enough, there will be a lot of confusions.
5 | P a g e

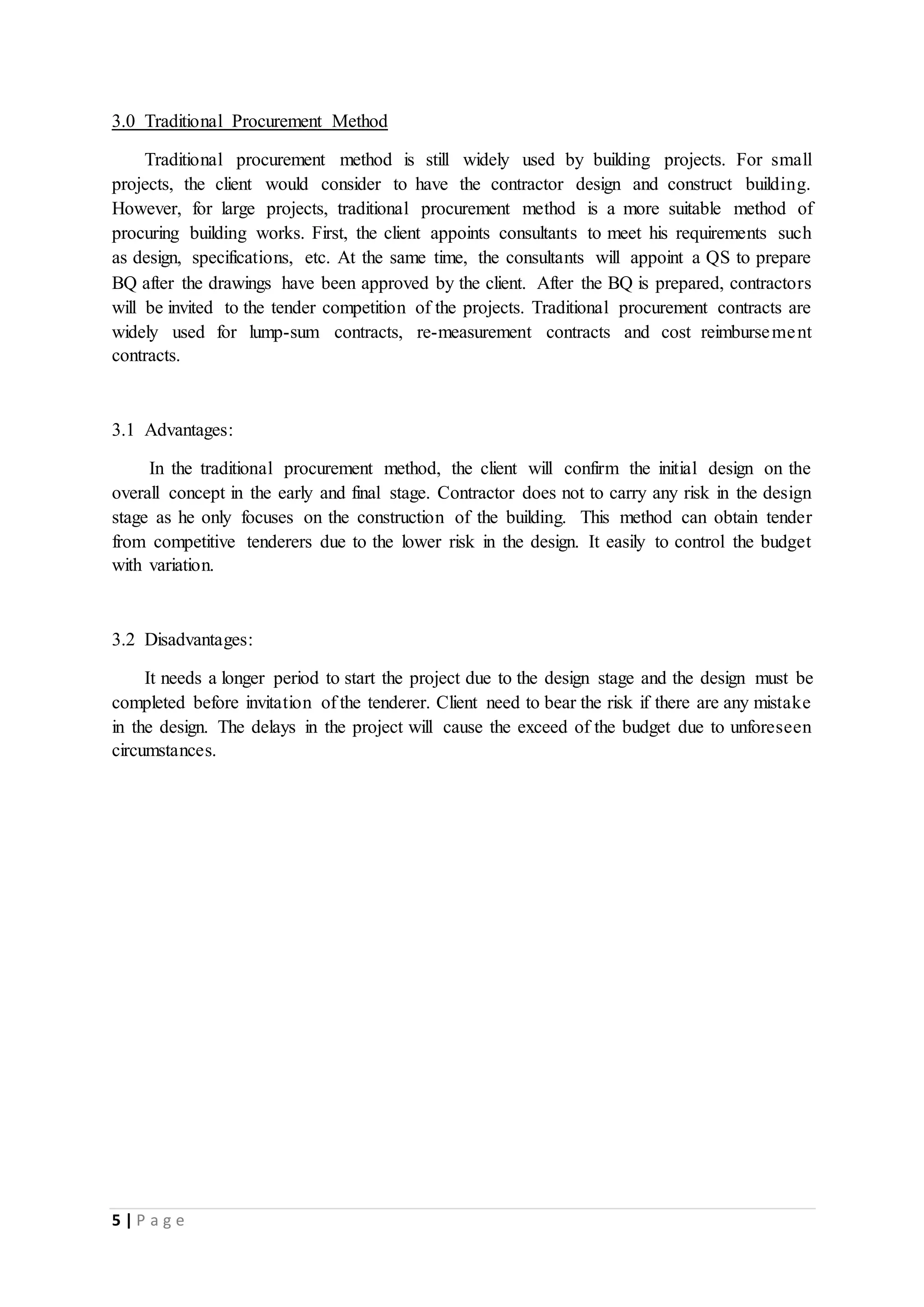

3.0 Traditional Procurement Method
Traditional procurement method is still widely used by building projects. For small
projects, the client would consider to have the contractor design and construct building.
However, for large projects, traditional procurement method is a more suitable method of
procuring building works. First, the client appoints consultants to meet his requirements such
as design, specifications, etc. At the same time, the consultants will appoint a QS to prepare
BQ after the drawings have been approved by the client. After the BQ is prepared, contractors
will be invited to the tender competition of the projects. Traditional procurement contracts are
widely used for lump-sum contracts, re-measurement contracts and cost reimbursement
contracts.
3.1 Advantages:
In the traditional procurement method, the client will confirm the initial design on the
overall concept in the early and final stage. Contractor does not to carry any risk in the design
stage as he only focuses on the construction of the building. This method can obtain tender
from competitive tenderers due to the lower risk in the design. It easily to control the budget
with variation.
3.2 Disadvantages:
It needs a longer period to start the project due to the design stage and the design must be
completed before invitation of the tenderer. Client need to bear the risk if there are any mistake
in the design. The delays in the project will cause the exceed of the budget due to unforeseen
circumstances.
6 | P a g e

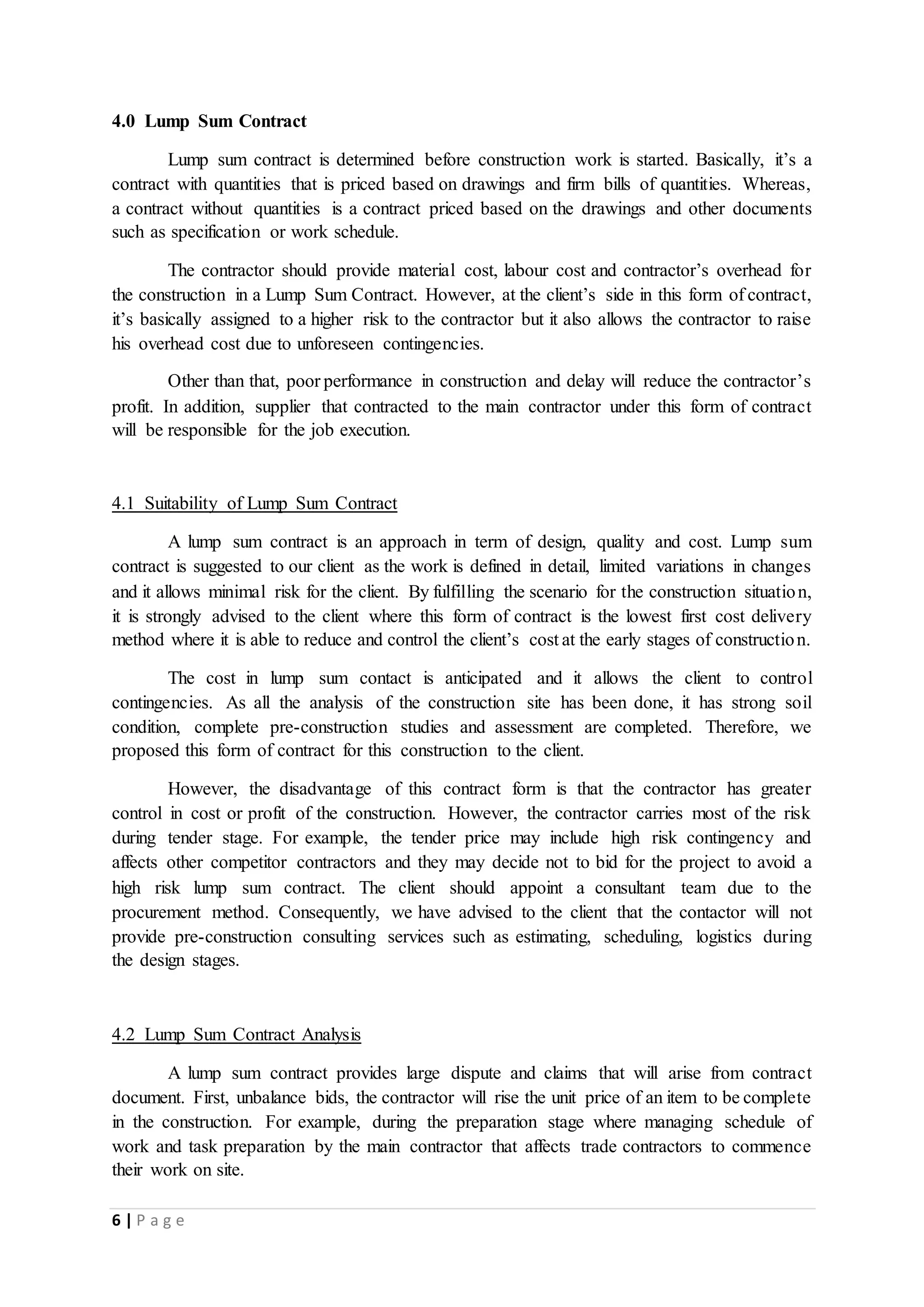

4.0 Lump Sum Contract
Lump sum contract is determined before construction work is started. Basically, it’s a
contract with quantities that is priced based on drawings and firm bills of quantities. Whereas,
a contract without quantities is a contract priced based on the drawings and other documents
such as specification or work schedule.
The contractor should provide material cost, labour cost and contractor’s overhead for
the construction in a Lump Sum Contract. However, at the client’s side in this form of contract,
it’s basically assigned to a higher risk to the contractor but it also allows the contractor to raise
his overhead cost due to unforeseen contingencies.
Other than that, poor performance in construction and delay will reduce the contractor’s
profit. In addition, supplier that contracted to the main contractor under this form of contract
will be responsible for the job execution.
4.1 Suitability of Lump Sum Contract
A lump sum contract is an approach in term of design, quality and cost. Lump sum
contract is suggested to our client as the work is defined in detail, limited variations in changes
and it allows minimal risk for the client. By fulfilling the scenario for the construction situation,
it is strongly advised to the client where this form of contract is the lowest first cost delivery
method where it is able to reduce and control the client’s cost at the early stages of construction.
The cost in lump sum contact is anticipated and it allows the client to control
contingencies. As all the analysis of the construction site has been done, it has strong soil
condition, complete pre-construction studies and assessment are completed. Therefore, we
proposed this form of contract for this construction to the client.
However, the disadvantage of this contract form is that the contractor has greater
control in cost or profit of the construction. However, the contractor carries most of the risk
during tender stage. For example, the tender price may include high risk contingency and
affects other competitor contractors and they may decide not to bid for the project to avoid a
high risk lump sum contract. The client should appoint a consultant team due to the
procurement method. Consequently, we have advised to the client that the contactor will not
provide pre-construction consulting services such as estimating, scheduling, logistics during
the design stages.
4.2 Lump Sum Contract Analysis
A lump sum contract provides large dispute and claims that will arise from contract
document. First, unbalance bids, the contractor will rise the unit price of an item to be complete
in the construction. For example, during the preparation stage where managing schedule of
work and task preparation by the main contractor that affects trade contractors to commence
their work on site.
7 | P a g e

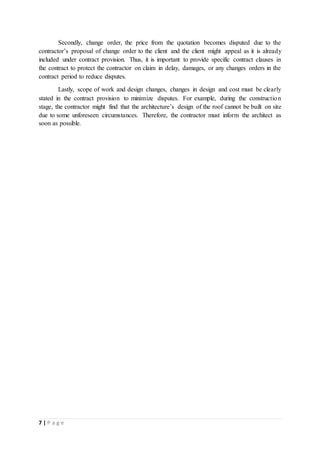

Secondly, change order, the price from the quotation becomes disputed due to the
contractor’s proposal of change order to the client and the client might appeal as it is already
included under contract provision. Thus, it is important to provide specific contract clauses in
the contract to protect the contractor on claim in delay, damages, or any changes orders in the
contract period to reduce disputes.
Lastly, scope of work and design changes, changes in design and cost must be clearly
stated in the contract provision to minimize disputes. For example, during the construction
stage, the contractor might find that the architecture’s design of the roof cannot be built on site
due to some unforeseen circumstances. Therefore, the contractor must inform the architect as
soon as possible.
8 | P a g e

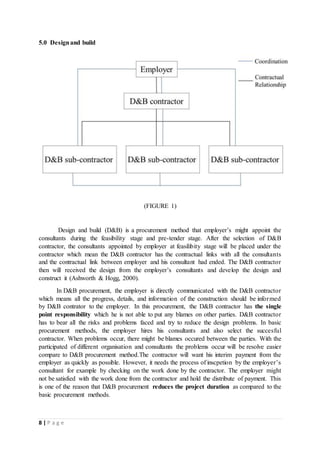

5.0 Designand build

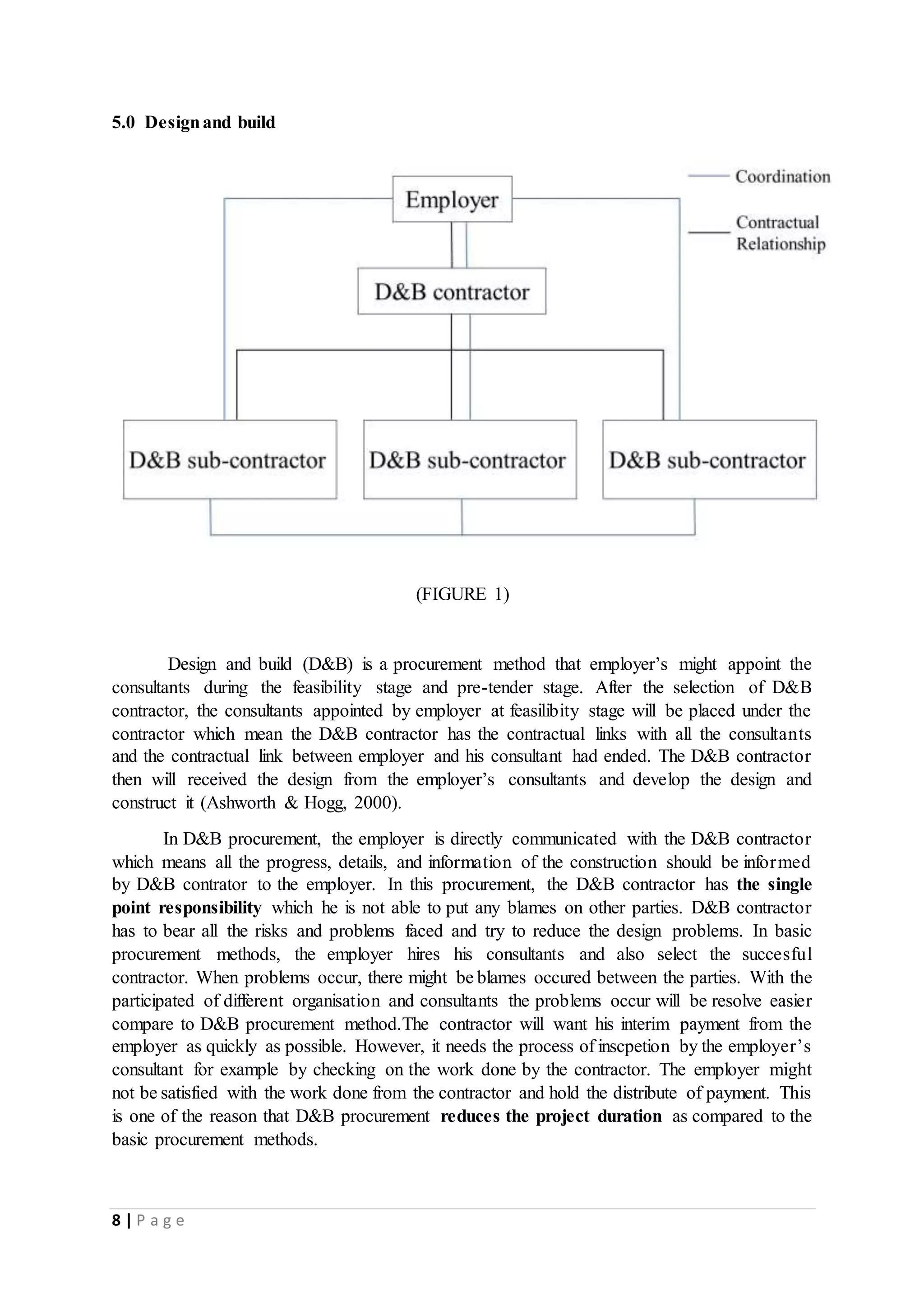

(FIGURE 1)
Design and build (D&B) is a procurement method that employer’s might appoint the
consultants during the feasibility stage and pre-tender stage. After the selection of D&B
contractor, the consultants appointed by employer at feasilibity stage will be placed under the
contractor which mean the D&B contractor has the contractual links with all the consultants
and the contractual link between employer and his consultant had ended. The D&B contractor
then will received the design from the employer’s consultants and develop the design and
construct it (Ashworth & Hogg, 2000).
In D&B procurement, the employer is directly communicated with the D&B contractor
which means all the progress, details, and information of the construction should be informed
by D&B contrator to the employer. In this procurement, the D&B contractor has the single
point responsibility which he is not able to put any blames on other parties. D&B contractor
has to bear all the risks and problems faced and try to reduce the design problems. In basic
procurement methods, the employer hires his consultants and also select the succesful
contractor. When problems occur, there might be blames occured between the parties. With the
participated of different organisation and consultants the problems occur will be resolve easier
compare to D&B procurement method.The contractor will want his interim payment from the
employer as quickly as possible. However, it needs the process of inscpetion by the employer’s
consultant for example by checking on the work done by the contractor. The employer might
not be satisfied with the work done from the contractor and hold the distribute of payment. This
is one of the reason that D&B procurement reduces the project duration as compared to the
basic procurement methods.
9 | P a g e

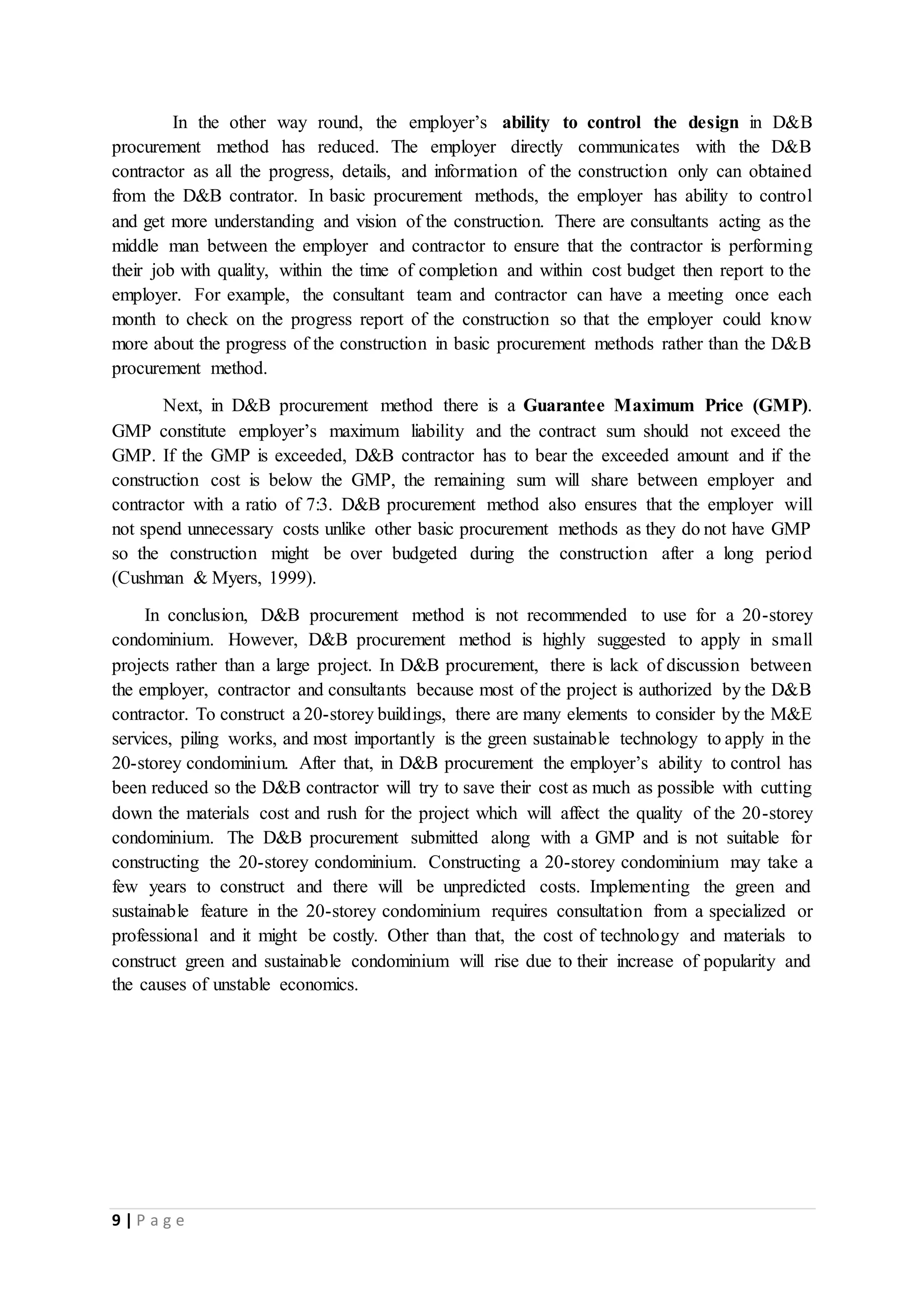

In the other way round, the employer’s ability to control the design in D&B
procurement method has reduced. The employer directly communicates with the D&B
contractor as all the progress, details, and information of the construction only can obtained
from the D&B contrator. In basic procurement methods, the employer has ability to control
and get more understanding and vision of the construction. There are consultants acting as the
middle man between the employer and contractor to ensure that the contractor is performing
their job with quality, within the time of completion and within cost budget then report to the
employer. For example, the consultant team and contractor can have a meeting once each
month to check on the progress report of the construction so that the employer could know
more about the progress of the construction in basic procurement methods rather than the D&B
procurement method.
Next, in D&B procurement method there is a Guarantee Maximum Price (GMP).
GMP constitute employer’s maximum liability and the contract sum should not exceed the
GMP. If the GMP is exceeded, D&B contractor has to bear the exceeded amount and if the
construction cost is below the GMP, the remaining sum will share between employer and
contractor with a ratio of 7:3. D&B procurement method also ensures that the employer will
not spend unnecessary costs unlike other basic procurement methods as they do not have GMP
so the construction might be over budgeted during the construction after a long period
(Cushman & Myers, 1999).
In conclusion, D&B procurement method is not recommended to use for a 20-storey
condominium. However, D&B procurement method is highly suggested to apply in small
projects rather than a large project. In D&B procurement, there is lack of discussion between
the employer, contractor and consultants because most of the project is authorized by the D&B
contractor. To construct a 20-storey buildings, there are many elements to consider by the M&E
services, piling works, and most importantly is the green sustainable technology to apply in the
20-storey condominium. After that, in D&B procurement the employer’s ability to control has
been reduced so the D&B contractor will try to save their cost as much as possible with cutting
down the materials cost and rush for the project which will affect the quality of the 20-storey
condominium. The D&B procurement submitted along with a GMP and is not suitable for
constructing the 20-storey condominium. Constructing a 20-storey condominium may take a
few years to construct and there will be unpredicted costs. Implementing the green and
sustainable feature in the 20-storey condominium requires consultation from a specialized or
professional and it might be costly. Other than that, the cost of technology and materials to
construct green and sustainable condominium will rise due to their increase of popularity and
the causes of unstable economics.
10 | P a g e
6.0 CRITICAL ANALYSIS
The proposed project is to build a 20-storey condominium. As mentioned in the
previous part, the two procurement methods are traditional procurement method and
management contracting. Both methods basically have different principles as well as
advantages and disadvantages.
There are many factors influencing the evaluation of the most appropriate procurement
method. One of the main factor is the project characteristics including size and location of the
project should be considered. Project characteristics will affect the time, cost and risks such as
larger projects might need longer time to construct and unforeseen circumstances might lead
the project to a halt or causes delay to the project. If the time given is insufficient, traditional
method would not be a suitable choice because design process must be completed before
calling of tender. Therefore, it is not suitable for fast track project as it takes a longer time
whereas if early completion is required, management contracting is more suitable for this
scenario as design and construction can be overlapped so that construction can start off earlier.
However, if the client wishes to complete the project in a shorter time, there is also the
‘Accelerated Traditional Method’ which allows early commencement on site by the design and
construction running in parallel to a limited extent but the cost would be less certain.
The following factor is the cost issues. At the time of tender, the design completed will
affect the cost greatly. Lump sum contract under traditional method is where the contract sum
is a fixed amount under an agreement before construction starts. Furthermore, the contractual
date for completion is also firm. For management contracting, the management contractor can
begin construction before the design is completed but the final cost would be uncertain until
the final works contract is signed. If price certainty is required by the client, then the design
must be completed before construction starts showing that traditional method is more suitable
in this situation.
Which procurement method is more appropriate in each situation depends on the
client’s requirement. The degree of the client to involve in the project should also be considered.
Client can lead and have direct influence on the design and quality as well as functionality can
be assured in traditional method. As for management contracting, the client loses direct control
of design quality because it is under the control of management contractor. If the client has
high requirement on overall design quality, then traditional procurement method would be
better compared to management contracting.
The project characteristics, needs of client, time frame and cost issues should be a major
consideration in selecting the suitable procurement method. In conclusion, traditional
procurement method would be suggested for this project. This method is suitable for all clients
including inexperienced clients. Moreover, the price certainty is achieved early which can
secure the project within the client’s budget and provides a firm contractual date for completion.
Consideration should also be given to the risk of client by external factors such as impact of
economic. The amount is fixed after contract signed so lower financial risk on client but the
contractor should bear majority of the risk in terms of any cost fluctuation. Therefore, this
method is more suitable for the developer on this 20-storey condominium project.
11 | P a g e
7.0 Reference link:
Ashworth, A. & Hogg, K. (2000) Added value in design and construction. 1st edition.
Harlow: Longman.
Ashworth, (2013) Willis's Practice and Procedure for the Quantity Surveyor 13e. 1st edition.
John Wiley & Sons.
CHAPTER 2 CONTRACT STRATEGY (no date) Available at: http://docplayer.net/8769421-
Chapter-2-contract-strategy.html (Accessed: 19 November 2016).
Cushman, R. & Myers, J. (1999) Construction law handbook. 1st edition. Gaithersburg
[MD]: Aspen Law & Business.
Davis, P., Love, P. & Baccarini, D. (2016) Building procurement methods. [online].
Available from: http://www.construction-
innovation.info/images/pdfs/Research_library/ResearchLibraryC/2006-034-
C/reports/Report_-_Building_Procurement_Methods.pdf [Accessed 11 November 2016].
Davis, P., Love, P., Baccarini, D., Wilson, G. & Lopez, R. (2016) Capital works
procurement: The selection of a building procurement method. [online]. Available from:
http://www.construction-
innovation.info/images/pdfs/Research_library/ResearchLibraryC/2006-034-
C/reports/Report_-_Capital_Works_Procurement_-
_The_Selection_of_a_Building_Procurement_Method.pdf [Accessed 11 November 2016].
Emad, E. (no date) Available at: http://osp.mans.edu.eg/elbeltagi/Cost%20Ch1.pdf
(Accessed: 19 November 2016).
Inc, S. (2016) Estimation and costing. Available at:
https://www.scribd.com/document/136930578/estimation-and-costing (Accessed: 19
November 2016).
Lupton, S., Cox, S. & Clamp, H. (2016) Which procurement method?. Available from:
https://www.thenbs.com/knowledge/which-procurement-method [Accessed 11 November
2016].
12 | P a g e
Masterman, J. (2001) Introduction to Building Procurement Systems. 1st edition. London:
Spon Press.
Rijn, J. (2016) Procurement in the construction industry. [online]. Available from:
http://www.indevelopment.nl/PDFfiles/ProcurementConstructionIndustry.pdf [Accessed 11
November 2016].
Rodriguez, J. (2016) What is a lump sum construction contract? Available at:
https://www.thebalance.com/lump-sum-construction-contract-844915 (Accessed: 19
November 2016).

More Related Content

What's hot

Professional practice 2
Professional practice 2Professional practice 2
Professional practice 2
ahmong4

Pp group assignment
Pp group assignmentPp group assignment
Pp group assignment
wendyteosy

Pp2 p5
Pp2   p5Pp2   p5
Pp2 p5
Shze Hwa Lee

PP1 assignment
PP1 assignment PP1 assignment
PP1 assignment
Enoch Wong

Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017
DarrenTofu

Professional practice 1 (QS)
Professional practice 1 (QS)Professional practice 1 (QS)
Professional practice 1 (QS)
Hasif Alias

Strategies in building procurement (summarized)
Strategies in building procurement (summarized)Strategies in building procurement (summarized)
Strategies in building procurement (summarized)
Michael Audu

Pp1 assignment group 8
Pp1 assignment group 8Pp1 assignment group 8
Pp1 assignment group 8
lohwenjun

A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006
Melvin Lim

Procurement Methods and their Application.
Procurement Methods and their Application.Procurement Methods and their Application.
Procurement Methods and their Application.Lilian Nwachukwu

The architect as contract administrator a legal perspective - presentation ...
The architect as contract administrator   a legal perspective - presentation ...The architect as contract administrator   a legal perspective - presentation ...
The architect as contract administrator a legal perspective - presentation ...Zainab Zainordin

A Report on Procurement Strategies - PP1
A Report on Procurement Strategies - PP1 A Report on Procurement Strategies - PP1
A Report on Procurement Strategies - PP1
Pang Khai Shuen

PP2 Seminar - Determination of Contractor's Employment by Employer
PP2 Seminar - Determination of Contractor's Employment by EmployerPP2 Seminar - Determination of Contractor's Employment by Employer
PP2 Seminar - Determination of Contractor's Employment by Employer
Trace96

Software assignment 1
Software assignment 1Software assignment 1
Software assignment 1
Timun Loh

Professional Practice 2: Group Assignment
Professional Practice 2: Group AssignmentProfessional Practice 2: Group Assignment
Professional Practice 2: Group Assignment
마 이환

Professional Practice I Assignment
Professional Practice I AssignmentProfessional Practice I Assignment
Professional Practice I Assignment
ashleyyeap

Lecture 4 - selection of contract forms
Lecture 4 - selection of contract formsLecture 4 - selection of contract forms
Lecture 4 - selection of contract forms
kohwenqi

Construction Law Final Report
Construction Law Final ReportConstruction Law Final Report
Construction Law Final Report
Arissa Loh


What's hot (20)

Professional practice 2
Professional practice 2Professional practice 2
Professional practice 2

Pp group assignment
Pp group assignmentPp group assignment
Pp group assignment

Pp2 p5
Pp2   p5Pp2   p5
Pp2 p5

PP1 assignment
PP1 assignment PP1 assignment
PP1 assignment

Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017Construction lawprint-final-update-21112017
Construction lawprint-final-update-21112017

Professional practice 1 (QS)
Professional practice 1 (QS)Professional practice 1 (QS)
Professional practice 1 (QS)

Strategies in building procurement (summarized)
Strategies in building procurement (summarized)Strategies in building procurement (summarized)
Strategies in building procurement (summarized)

Pp1 assignment group 8
Pp1 assignment group 8Pp1 assignment group 8
Pp1 assignment group 8

A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006A Case Study based on FIDIC and PAM Form 2006
A Case Study based on FIDIC and PAM Form 2006

Procurement system
Procurement systemProcurement system
Procurement system

Procurement Methods and their Application.
Procurement Methods and their Application.Procurement Methods and their Application.
Procurement Methods and their Application.

The architect as contract administrator a legal perspective - presentation ...
The architect as contract administrator   a legal perspective - presentation ...The architect as contract administrator   a legal perspective - presentation ...
The architect as contract administrator a legal perspective - presentation ...

A Report on Procurement Strategies - PP1
A Report on Procurement Strategies - PP1 A Report on Procurement Strategies - PP1
A Report on Procurement Strategies - PP1

Procurement Methods
Procurement MethodsProcurement Methods
Procurement Methods

PP2 Seminar - Determination of Contractor's Employment by Employer
PP2 Seminar - Determination of Contractor's Employment by EmployerPP2 Seminar - Determination of Contractor's Employment by Employer
PP2 Seminar - Determination of Contractor's Employment by Employer

Software assignment 1
Software assignment 1Software assignment 1
Software assignment 1

Professional Practice 2: Group Assignment
Professional Practice 2: Group AssignmentProfessional Practice 2: Group Assignment
Professional Practice 2: Group Assignment

Professional Practice I Assignment
Professional Practice I AssignmentProfessional Practice I Assignment
Professional Practice I Assignment

Lecture 4 - selection of contract forms
Lecture 4 - selection of contract formsLecture 4 - selection of contract forms
Lecture 4 - selection of contract forms

Construction Law Final Report
Construction Law Final ReportConstruction Law Final Report
Construction Law Final Report


Similar to Pp1 assignment

Pp1 final
Pp1 finalPp1 final
Pp1 final
Timun Loh

Professional practice 1 (1)
Professional practice 1 (1)Professional practice 1 (1)
Professional practice 1 (1)
tfkc1212

Professional Practice 1 Proposal Report
Professional Practice 1 Proposal ReportProfessional Practice 1 Proposal Report
Professional Practice 1 Proposal Report
Arissa Loh

Yam yih hwan pp1 assignment aug 14
Yam yih hwan   pp1 assignment aug 14Yam yih hwan   pp1 assignment aug 14
Yam yih hwan pp1 assignment aug 14마 이환

Pp1 report
Pp1 reportPp1 report
Pp1 report
ahmong4

Professional Practice
Professional PracticeProfessional Practice
Professional Practice
seenyeeyong

Estimating and Tendering methods for Construction Work
Estimating and Tendering methods for Construction WorkEstimating and Tendering methods for Construction Work
Estimating and Tendering methods for Construction Work
Daniel Ross

Professional practice-1-presentation
Professional practice-1-presentationProfessional practice-1-presentation
Professional practice-1-presentation
Timun Loh

Preparation of boq
Preparation of boqPreparation of boq
Preparation of boq
R.R.G.S Bandara

CON_CONTRACTS_all_till_mid. bgf uggttyy ppt
CON_CONTRACTS_all_till_mid. bgf uggttyy pptCON_CONTRACTS_all_till_mid. bgf uggttyy ppt
CON_CONTRACTS_all_till_mid. bgf uggttyy ppt
2cd

TOPIC2.pdf
TOPIC2.pdfTOPIC2.pdf
TOPIC2.pdf
HASMANIRA

Contract Management - Contracts Types and Payment Structure
Contract Management - Contracts Types and Payment StructureContract Management - Contracts Types and Payment Structure
Contract Management - Contracts Types and Payment Structure
HASMANIRA

PP1 report
PP1 reportPP1 report
PP1 report
Doreen Yeo

TOPIC1.pdf
TOPIC1.pdfTOPIC1.pdf
TOPIC1.pdf
HASMANIRA

2.12 procurement management 1
2.12  procurement management 12.12  procurement management 1
2.12 procurement management 1reddvise

Construction contract
Construction contractConstruction contract
Construction contract
Delhi Technological University

Construction contract
Construction contractConstruction contract
Construction contract
Delhi Technological University


Similar to Pp1 assignment (20)

Pp1 final
Pp1 finalPp1 final
Pp1 final

Professional practice 1 (1)
Professional practice 1 (1)Professional practice 1 (1)
Professional practice 1 (1)

Professional Practice 1 Proposal Report
Professional Practice 1 Proposal ReportProfessional Practice 1 Proposal Report
Professional Practice 1 Proposal Report

Yam yih hwan pp1 assignment aug 14
Yam yih hwan   pp1 assignment aug 14Yam yih hwan   pp1 assignment aug 14
Yam yih hwan pp1 assignment aug 14

Pp1 report
Pp1 reportPp1 report
Pp1 report

Purpose
PurposePurpose
Purpose

Pp report
Pp reportPp report
Pp report

Professional Practice
Professional PracticeProfessional Practice
Professional Practice

p1p
p1pp1p
p1p

Estimating and Tendering methods for Construction Work
Estimating and Tendering methods for Construction WorkEstimating and Tendering methods for Construction Work
Estimating and Tendering methods for Construction Work

Professional practice-1-presentation
Professional practice-1-presentationProfessional practice-1-presentation
Professional practice-1-presentation

Preparation of boq
Preparation of boqPreparation of boq
Preparation of boq

CON_CONTRACTS_all_till_mid. bgf uggttyy ppt
CON_CONTRACTS_all_till_mid. bgf uggttyy pptCON_CONTRACTS_all_till_mid. bgf uggttyy ppt
CON_CONTRACTS_all_till_mid. bgf uggttyy ppt

TOPIC2.pdf
TOPIC2.pdfTOPIC2.pdf
TOPIC2.pdf

Contract Management - Contracts Types and Payment Structure
Contract Management - Contracts Types and Payment StructureContract Management - Contracts Types and Payment Structure
Contract Management - Contracts Types and Payment Structure

PP1 report
PP1 reportPP1 report
PP1 report

TOPIC1.pdf
TOPIC1.pdfTOPIC1.pdf
TOPIC1.pdf

2.12 procurement management 1
2.12  procurement management 12.12  procurement management 1
2.12 procurement management 1

Construction contract
Construction contractConstruction contract
Construction contract

Construction contract
Construction contractConstruction contract
Construction contract


More from Lwj Welson

De assignment
De assignmentDe assignment
De assignment
Lwj Welson

Pm only
Pm onlyPm only
Pm only
Lwj Welson

Vm presentation
Vm presentationVm presentation
Vm presentation
Lwj Welson

Mah Sing Group Berhad
Mah Sing Group BerhadMah Sing Group Berhad
Mah Sing Group Berhad
Lwj Welson

Be cost appraisal
Be cost appraisalBe cost appraisal
Be cost appraisal
Lwj Welson

Pp1 assignment
Pp1 assignmentPp1 assignment
Pp1 assignment
Lwj Welson

Final pp1
Final pp1Final pp1
Final pp1
Lwj Welson

Bs ii-assignment
Bs ii-assignmentBs ii-assignment
Bs ii-assignment
Lwj Welson

Safety complete
Safety completeSafety complete
Safety complete
Lwj Welson

Thc construction-company-completed
Thc construction-company-completedThc construction-company-completed
Thc construction-company-completed
Lwj Welson

Management science presentation slides
Management science  presentation slidesManagement science  presentation slides
Management science presentation slides
Lwj Welson

Building services-i (2)
Building services-i (2)Building services-i (2)
Building services-i (2)
Lwj Welson

Assignment (1)
Assignment (1)Assignment (1)
Assignment (1)
Lwj Welson

Assignment (1)
Assignment (1)Assignment (1)
Assignment (1)
Lwj Welson

Ct
CtCt
Epc oral presentation part 2
Epc oral presentation part 2Epc oral presentation part 2
Epc oral presentation part 2
Lwj Welson

Epc oral presentation part 1
Epc oral presentation part 1Epc oral presentation part 1
Epc oral presentation part 1
Lwj Welson

Psy final-write-up
Psy final-write-upPsy final-write-up
Psy final-write-up
Lwj Welson

Psychology social elements
Psychology social elementsPsychology social elements
Psychology social elements
Lwj Welson

Social behavior
Social behaviorSocial behavior
Social behavior
Lwj Welson


More from Lwj Welson (20)

De assignment
De assignmentDe assignment
De assignment

Pm only
Pm onlyPm only
Pm only

Vm presentation
Vm presentationVm presentation
Vm presentation

Mah Sing Group Berhad
Mah Sing Group BerhadMah Sing Group Berhad
Mah Sing Group Berhad

Be cost appraisal
Be cost appraisalBe cost appraisal
Be cost appraisal

Pp1 assignment
Pp1 assignmentPp1 assignment
Pp1 assignment

Final pp1
Final pp1Final pp1
Final pp1

Bs ii-assignment
Bs ii-assignmentBs ii-assignment
Bs ii-assignment

Safety complete
Safety completeSafety complete
Safety complete

Thc construction-company-completed
Thc construction-company-completedThc construction-company-completed
Thc construction-company-completed

Management science presentation slides
Management science  presentation slidesManagement science  presentation slides
Management science presentation slides

Building services-i (2)
Building services-i (2)Building services-i (2)
Building services-i (2)

Assignment (1)
Assignment (1)Assignment (1)
Assignment (1)

Assignment (1)
Assignment (1)Assignment (1)
Assignment (1)

Ct
CtCt
Ct

Epc oral presentation part 2
Epc oral presentation part 2Epc oral presentation part 2
Epc oral presentation part 2

Epc oral presentation part 1
Epc oral presentation part 1Epc oral presentation part 1
Epc oral presentation part 1

Psy final-write-up
Psy final-write-upPsy final-write-up
Psy final-write-up

Psychology social elements
Psychology social elementsPsychology social elements
Psychology social elements

Social behavior
Social behaviorSocial behavior
Social behavior


Recently uploaded

一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理
一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理
一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理
9a93xvy

Research 20 slides Amelia gavryliuks.pdf
Research 20 slides Amelia gavryliuks.pdfResearch 20 slides Amelia gavryliuks.pdf
Research 20 slides Amelia gavryliuks.pdf
ameli25062005

PORTFOLIO FABIANA VILLANI ARCHITECTURE.pdf
PORTFOLIO FABIANA VILLANI ARCHITECTURE.pdfPORTFOLIO FABIANA VILLANI ARCHITECTURE.pdf
PORTFOLIO FABIANA VILLANI ARCHITECTURE.pdf
fabianavillanib

一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理
一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理
一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理
708pb191

Expert Accessory Dwelling Unit (ADU) Drafting Services
Expert Accessory Dwelling Unit (ADU) Drafting ServicesExpert Accessory Dwelling Unit (ADU) Drafting Services
Expert Accessory Dwelling Unit (ADU) Drafting Services
ResDraft

一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理
一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理
一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理
7sd8fier

Top Israeli Products and Brands - Plan it israel.pdf
Top Israeli Products and Brands - Plan it israel.pdfTop Israeli Products and Brands - Plan it israel.pdf
Top Israeli Products and Brands - Plan it israel.pdf
PlanitIsrael

一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理
一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理
一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理
smpc3nvg

一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理
一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理
一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理
9a93xvy

一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理
一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理
一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理
7sd8fier

一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理
一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理
一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理
n0tivyq

一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理
一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理
一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理
h7j5io0

Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...
Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...
Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...
Mansi Shah

Mohannad Abdullah portfolio _ V2 _22-24
Mohannad Abdullah  portfolio _ V2 _22-24Mohannad Abdullah  portfolio _ V2 _22-24
Mohannad Abdullah portfolio _ V2 _22-24
M. A. Architect

一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理
一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理
一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理
smpc3nvg

Portfolio.pdf
Portfolio.pdfPortfolio.pdf
Portfolio.pdf
garcese

Exploring the Future of Smart Garages.pdf
Exploring the Future of Smart Garages.pdfExploring the Future of Smart Garages.pdf
Exploring the Future of Smart Garages.pdf
fastfixgaragedoor

Common Designing Mistakes and How to avoid them
Common Designing Mistakes and How to avoid themCommon Designing Mistakes and How to avoid them
Common Designing Mistakes and How to avoid them
madhavlakhanpal29

Let's Summon Demons Shirt Let's Summon Demons Shirt
Let's Summon Demons Shirt Let's Summon Demons ShirtLet's Summon Demons Shirt Let's Summon Demons Shirt
Let's Summon Demons Shirt Let's Summon Demons Shirt
TeeFusion

White wonder, Work developed by Eva Tschopp
White wonder, Work developed by Eva TschoppWhite wonder, Work developed by Eva Tschopp
White wonder, Work developed by Eva Tschopp
Mansi Shah


Recently uploaded (20)

一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理
一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理
一比一原版(RHUL毕业证书)伦敦大学皇家霍洛威学院毕业证如何办理

Research 20 slides Amelia gavryliuks.pdf
Research 20 slides Amelia gavryliuks.pdfResearch 20 slides Amelia gavryliuks.pdf
Research 20 slides Amelia gavryliuks.pdf

PORTFOLIO FABIANA VILLANI ARCHITECTURE.pdf
PORTFOLIO FABIANA VILLANI ARCHITECTURE.pdfPORTFOLIO FABIANA VILLANI ARCHITECTURE.pdf
PORTFOLIO FABIANA VILLANI ARCHITECTURE.pdf

一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理
一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理
一比一原版(UAL毕业证书)伦敦艺术大学毕业证成绩单如何办理

Expert Accessory Dwelling Unit (ADU) Drafting Services
Expert Accessory Dwelling Unit (ADU) Drafting ServicesExpert Accessory Dwelling Unit (ADU) Drafting Services
Expert Accessory Dwelling Unit (ADU) Drafting Services

一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理
一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理
一比一原版(NCL毕业证书)纽卡斯尔大学毕业证成绩单如何办理

Top Israeli Products and Brands - Plan it israel.pdf
Top Israeli Products and Brands - Plan it israel.pdfTop Israeli Products and Brands - Plan it israel.pdf
Top Israeli Products and Brands - Plan it israel.pdf

一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理
一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理
一比一原版(Brunel毕业证书)布鲁内尔大学毕业证成绩单如何办理

一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理
一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理
一比一原版(CITY毕业证书)谢菲尔德哈勒姆大学毕业证如何办理

一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理
一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理
一比一原版(MMU毕业证书)曼彻斯特城市大学毕业证成绩单如何办理

一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理
一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理
一比一原版(Glasgow毕业证书)格拉斯哥大学毕业证成绩单如何办理

一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理
一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理
一比一原版(BU毕业证书)伯恩茅斯大学毕业证成绩单如何办理

Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...
Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...
Between Filth and Fortune- Urban Cattle Foraging Realities by Devi S Nair, An...

Mohannad Abdullah portfolio _ V2 _22-24
Mohannad Abdullah  portfolio _ V2 _22-24Mohannad Abdullah  portfolio _ V2 _22-24
Mohannad Abdullah portfolio _ V2 _22-24

一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理
一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理
一比一原版(Bristol毕业证书)布里斯托大学毕业证成绩单如何办理

Portfolio.pdf
Portfolio.pdfPortfolio.pdf
Portfolio.pdf

Exploring the Future of Smart Garages.pdf
Exploring the Future of Smart Garages.pdfExploring the Future of Smart Garages.pdf
Exploring the Future of Smart Garages.pdf

Common Designing Mistakes and How to avoid them
Common Designing Mistakes and How to avoid themCommon Designing Mistakes and How to avoid them
Common Designing Mistakes and How to avoid them

Let's Summon Demons Shirt Let's Summon Demons Shirt
Let's Summon Demons Shirt Let's Summon Demons ShirtLet's Summon Demons Shirt Let's Summon Demons Shirt
Let's Summon Demons Shirt Let's Summon Demons Shirt

White wonder, Work developed by Eva Tschopp
White wonder, Work developed by Eva TschoppWhite wonder, Work developed by Eva Tschopp
White wonder, Work developed by Eva Tschopp


Pp1 assignment

  • 1. SCHOOL OF ARCHITECTURE, BUILDING AND DESIGN Bachelor of Quantity Surveying (Honours) Professional Practice 1 Group members: Felix Vong Zhi Wei 0318462 Lee Ern Hui 0319703 Elliot Pang Tiu Seng 0319438 Welson Lum Wei Jiunn 0319514 Kevin Lee Hee Xian 0315192
  • 2. 2 | P a g e Table of content Content Page 1.0 Introduction 3 2.0 Management Contracting 4 2.1 Advantages 4 2.2 Disadvantages 4 3.0 Traditional Procurement Method 5 3.1 Advantages 5 3.2 Disadvantages 5 4.0 Lump Sum Contract 6 4.1 Suitability of Lump Sum Contract 6 4.2 Lump Sum Contract Analysis 6 5.0 Design and Build 8 6.0 Critical Analysis 10 7.0 Reference Link 11
  • 3. 3 | P a g e 1.0 Introduction In recent times, the Malaysian economic downturn has affected the developers in Malaysia in delivering and meeting key property development and sales target. As being one of the experts in this subject, the client who is a property developer have called upon us to critically examine the types of basic procurement methods and suggest a suitable type for the project. Since the project site has a good soil condition, a 20-story condominium would be more suitable as it allows additional green and sustainable features to create more values to the environment and purchases or end users. Other than that, the building will be focusing on selling it to the middle-class purchasers as middle income earners are rising in this economic downturn. In this report, it will examine and propose suitable contract forms for the project and evaluate the viability of the design and build as a procurement method for the new project in comparison with basic procurement methods. The dictionary defines the word ‘procurement’ as acquiring or obtaining by care or effort. The term ‘procurement method’ is described as the complex system of relationships formed among clients, consultants and construction corporations. Procurement methods are categorized into 4 parts and they are traditional method, design and build, management contracting and construction management. The decision of choosing a procurement method to use should be chosen as early as possible to support the clients project and the client’s requirements. The main criteria for choosing the right procurement method for the project will affect the time, cost and quality of the project. The risks should be considered as for choosing which procurement method to be used and how it would affect the overall project. Besides that, the employer or the contractor would also be at risk on which procurement method is chosen. Each procurement method will have their advantages and disadvantages and there are key points on which procurement method to consider on the project. By understanding the characteristics of each procurement methods, a recommendation can be made to the client.
  • 4. 4 | P a g e 2.0 Management Contracting Management contracting basically is the management contractor nominated by the client based on their experience in the management services or selected by competition from tender stage. He does none of the work himself but separate it into work packages to the contractors. The successful management contractor will enter to a joint contract tribunal(JCT) management building contract with the client. M.C provides a service on fees as part of the client’s management team by managing the construction works in co-operation with the consultants. He provides and maintains all the necessary site facilities and labour. The contractual links are between the client and the member of management team and design team. The M.C and each of the of the works contractors. 2.1 Advantages: Management contracting can reduce the time requirement for design and construction significantly so that the project does not delay and saves cost for the client. As a contractor in this procurement method, he can identify client’s need and interests. At the mid of time, the changes of design are flexibility. Besides that, the work can start earlier as the works package designed. Contractor’s knowledge and management expertise can assist the design team. 2.2 Disadvantages: The final cost of the project is uncertain until the last works contract signed because some of the design might change. Variations and the amount of re-measurement required greater than traditional contracts during construction period, because the problem of work packages will interface. The management of the construction of the building will be totally relied on the management contractor and if he is not experienced enough, there will be a lot of confusions.
  • 5. 5 | P a g e 3.0 Traditional Procurement Method Traditional procurement method is still widely used by building projects. For small projects, the client would consider to have the contractor design and construct building. However, for large projects, traditional procurement method is a more suitable method of procuring building works. First, the client appoints consultants to meet his requirements such as design, specifications, etc. At the same time, the consultants will appoint a QS to prepare BQ after the drawings have been approved by the client. After the BQ is prepared, contractors will be invited to the tender competition of the projects. Traditional procurement contracts are widely used for lump-sum contracts, re-measurement contracts and cost reimbursement contracts. 3.1 Advantages: In the traditional procurement method, the client will confirm the initial design on the overall concept in the early and final stage. Contractor does not to carry any risk in the design stage as he only focuses on the construction of the building. This method can obtain tender from competitive tenderers due to the lower risk in the design. It easily to control the budget with variation. 3.2 Disadvantages: It needs a longer period to start the project due to the design stage and the design must be completed before invitation of the tenderer. Client need to bear the risk if there are any mistake in the design. The delays in the project will cause the exceed of the budget due to unforeseen circumstances.
  • 6. 6 | P a g e 4.0 Lump Sum Contract Lump sum contract is determined before construction work is started. Basically, it’s a contract with quantities that is priced based on drawings and firm bills of quantities. Whereas, a contract without quantities is a contract priced based on the drawings and other documents such as specification or work schedule. The contractor should provide material cost, labour cost and contractor’s overhead for the construction in a Lump Sum Contract. However, at the client’s side in this form of contract, it’s basically assigned to a higher risk to the contractor but it also allows the contractor to raise his overhead cost due to unforeseen contingencies. Other than that, poor performance in construction and delay will reduce the contractor’s profit. In addition, supplier that contracted to the main contractor under this form of contract will be responsible for the job execution. 4.1 Suitability of Lump Sum Contract A lump sum contract is an approach in term of design, quality and cost. Lump sum contract is suggested to our client as the work is defined in detail, limited variations in changes and it allows minimal risk for the client. By fulfilling the scenario for the construction situation, it is strongly advised to the client where this form of contract is the lowest first cost delivery method where it is able to reduce and control the client’s cost at the early stages of construction. The cost in lump sum contact is anticipated and it allows the client to control contingencies. As all the analysis of the construction site has been done, it has strong soil condition, complete pre-construction studies and assessment are completed. Therefore, we proposed this form of contract for this construction to the client. However, the disadvantage of this contract form is that the contractor has greater control in cost or profit of the construction. However, the contractor carries most of the risk during tender stage. For example, the tender price may include high risk contingency and affects other competitor contractors and they may decide not to bid for the project to avoid a high risk lump sum contract. The client should appoint a consultant team due to the procurement method. Consequently, we have advised to the client that the contactor will not provide pre-construction consulting services such as estimating, scheduling, logistics during the design stages. 4.2 Lump Sum Contract Analysis A lump sum contract provides large dispute and claims that will arise from contract document. First, unbalance bids, the contractor will rise the unit price of an item to be complete in the construction. For example, during the preparation stage where managing schedule of work and task preparation by the main contractor that affects trade contractors to commence their work on site.
  • 7. 7 | P a g e Secondly, change order, the price from the quotation becomes disputed due to the contractor’s proposal of change order to the client and the client might appeal as it is already included under contract provision. Thus, it is important to provide specific contract clauses in the contract to protect the contractor on claim in delay, damages, or any changes orders in the contract period to reduce disputes. Lastly, scope of work and design changes, changes in design and cost must be clearly stated in the contract provision to minimize disputes. For example, during the construction stage, the contractor might find that the architecture’s design of the roof cannot be built on site due to some unforeseen circumstances. Therefore, the contractor must inform the architect as soon as possible.
  • 8. 8 | P a g e 5.0 Designand build (FIGURE 1) Design and build (D&B) is a procurement method that employer’s might appoint the consultants during the feasibility stage and pre-tender stage. After the selection of D&B contractor, the consultants appointed by employer at feasilibity stage will be placed under the contractor which mean the D&B contractor has the contractual links with all the consultants and the contractual link between employer and his consultant had ended. The D&B contractor then will received the design from the employer’s consultants and develop the design and construct it (Ashworth & Hogg, 2000). In D&B procurement, the employer is directly communicated with the D&B contractor which means all the progress, details, and information of the construction should be informed by D&B contrator to the employer. In this procurement, the D&B contractor has the single point responsibility which he is not able to put any blames on other parties. D&B contractor has to bear all the risks and problems faced and try to reduce the design problems. In basic procurement methods, the employer hires his consultants and also select the succesful contractor. When problems occur, there might be blames occured between the parties. With the participated of different organisation and consultants the problems occur will be resolve easier compare to D&B procurement method.The contractor will want his interim payment from the employer as quickly as possible. However, it needs the process of inscpetion by the employer’s consultant for example by checking on the work done by the contractor. The employer might not be satisfied with the work done from the contractor and hold the distribute of payment. This is one of the reason that D&B procurement reduces the project duration as compared to the basic procurement methods.
  • 9. 9 | P a g e In the other way round, the employer’s ability to control the design in D&B procurement method has reduced. The employer directly communicates with the D&B contractor as all the progress, details, and information of the construction only can obtained from the D&B contrator. In basic procurement methods, the employer has ability to control and get more understanding and vision of the construction. There are consultants acting as the middle man between the employer and contractor to ensure that the contractor is performing their job with quality, within the time of completion and within cost budget then report to the employer. For example, the consultant team and contractor can have a meeting once each month to check on the progress report of the construction so that the employer could know more about the progress of the construction in basic procurement methods rather than the D&B procurement method. Next, in D&B procurement method there is a Guarantee Maximum Price (GMP). GMP constitute employer’s maximum liability and the contract sum should not exceed the GMP. If the GMP is exceeded, D&B contractor has to bear the exceeded amount and if the construction cost is below the GMP, the remaining sum will share between employer and contractor with a ratio of 7:3. D&B procurement method also ensures that the employer will not spend unnecessary costs unlike other basic procurement methods as they do not have GMP so the construction might be over budgeted during the construction after a long period (Cushman & Myers, 1999). In conclusion, D&B procurement method is not recommended to use for a 20-storey condominium. However, D&B procurement method is highly suggested to apply in small projects rather than a large project. In D&B procurement, there is lack of discussion between the employer, contractor and consultants because most of the project is authorized by the D&B contractor. To construct a 20-storey buildings, there are many elements to consider by the M&E services, piling works, and most importantly is the green sustainable technology to apply in the 20-storey condominium. After that, in D&B procurement the employer’s ability to control has been reduced so the D&B contractor will try to save their cost as much as possible with cutting down the materials cost and rush for the project which will affect the quality of the 20-storey condominium. The D&B procurement submitted along with a GMP and is not suitable for constructing the 20-storey condominium. Constructing a 20-storey condominium may take a few years to construct and there will be unpredicted costs. Implementing the green and sustainable feature in the 20-storey condominium requires consultation from a specialized or professional and it might be costly. Other than that, the cost of technology and materials to construct green and sustainable condominium will rise due to their increase of popularity and the causes of unstable economics.
  • 10. 10 | P a g e 6.0 CRITICAL ANALYSIS The proposed project is to build a 20-storey condominium. As mentioned in the previous part, the two procurement methods are traditional procurement method and management contracting. Both methods basically have different principles as well as advantages and disadvantages. There are many factors influencing the evaluation of the most appropriate procurement method. One of the main factor is the project characteristics including size and location of the project should be considered. Project characteristics will affect the time, cost and risks such as larger projects might need longer time to construct and unforeseen circumstances might lead the project to a halt or causes delay to the project. If the time given is insufficient, traditional method would not be a suitable choice because design process must be completed before calling of tender. Therefore, it is not suitable for fast track project as it takes a longer time whereas if early completion is required, management contracting is more suitable for this scenario as design and construction can be overlapped so that construction can start off earlier. However, if the client wishes to complete the project in a shorter time, there is also the ‘Accelerated Traditional Method’ which allows early commencement on site by the design and construction running in parallel to a limited extent but the cost would be less certain. The following factor is the cost issues. At the time of tender, the design completed will affect the cost greatly. Lump sum contract under traditional method is where the contract sum is a fixed amount under an agreement before construction starts. Furthermore, the contractual date for completion is also firm. For management contracting, the management contractor can begin construction before the design is completed but the final cost would be uncertain until the final works contract is signed. If price certainty is required by the client, then the design must be completed before construction starts showing that traditional method is more suitable in this situation. Which procurement method is more appropriate in each situation depends on the client’s requirement. The degree of the client to involve in the project should also be considered. Client can lead and have direct influence on the design and quality as well as functionality can be assured in traditional method. As for management contracting, the client loses direct control of design quality because it is under the control of management contractor. If the client has high requirement on overall design quality, then traditional procurement method would be better compared to management contracting. The project characteristics, needs of client, time frame and cost issues should be a major consideration in selecting the suitable procurement method. In conclusion, traditional procurement method would be suggested for this project. This method is suitable for all clients including inexperienced clients. Moreover, the price certainty is achieved early which can secure the project within the client’s budget and provides a firm contractual date for completion. Consideration should also be given to the risk of client by external factors such as impact of economic. The amount is fixed after contract signed so lower financial risk on client but the contractor should bear majority of the risk in terms of any cost fluctuation. Therefore, this method is more suitable for the developer on this 20-storey condominium project.
  • 11. 11 | P a g e 7.0 Reference link: Ashworth, A. & Hogg, K. (2000) Added value in design and construction. 1st edition. Harlow: Longman. Ashworth, (2013) Willis's Practice and Procedure for the Quantity Surveyor 13e. 1st edition. John Wiley & Sons. CHAPTER 2 CONTRACT STRATEGY (no date) Available at: http://docplayer.net/8769421- Chapter-2-contract-strategy.html (Accessed: 19 November 2016). Cushman, R. & Myers, J. (1999) Construction law handbook. 1st edition. Gaithersburg [MD]: Aspen Law & Business. Davis, P., Love, P. & Baccarini, D. (2016) Building procurement methods. [online]. Available from: http://www.construction- innovation.info/images/pdfs/Research_library/ResearchLibraryC/2006-034- C/reports/Report_-_Building_Procurement_Methods.pdf [Accessed 11 November 2016]. Davis, P., Love, P., Baccarini, D., Wilson, G. & Lopez, R. (2016) Capital works procurement: The selection of a building procurement method. [online]. Available from: http://www.construction- innovation.info/images/pdfs/Research_library/ResearchLibraryC/2006-034- C/reports/Report_-_Capital_Works_Procurement_- _The_Selection_of_a_Building_Procurement_Method.pdf [Accessed 11 November 2016]. Emad, E. (no date) Available at: http://osp.mans.edu.eg/elbeltagi/Cost%20Ch1.pdf (Accessed: 19 November 2016). Inc, S. (2016) Estimation and costing. Available at: https://www.scribd.com/document/136930578/estimation-and-costing (Accessed: 19 November 2016). Lupton, S., Cox, S. & Clamp, H. (2016) Which procurement method?. Available from: https://www.thenbs.com/knowledge/which-procurement-method [Accessed 11 November 2016].
  • 12. 12 | P a g e Masterman, J. (2001) Introduction to Building Procurement Systems. 1st edition. London: Spon Press. Rijn, J. (2016) Procurement in the construction industry. [online]. Available from: http://www.indevelopment.nl/PDFfiles/ProcurementConstructionIndustry.pdf [Accessed 11 November 2016]. Rodriguez, J. (2016) What is a lump sum construction contract? Available at: https://www.thebalance.com/lump-sum-construction-contract-844915 (Accessed: 19 November 2016).
