Contract Procurement
Management
Dr. M.K. Mlela

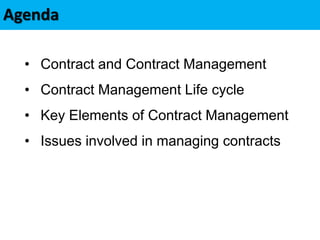

Agenda
• Contract and Contract Management
• Contract Management Life cycle
• Key Elements of Contract Management
• Issues involved in managing contracts
What is a Contract ?
• A contract is an agreement between two or more
people that is legally binding. A contract can be
verbal or written.
• The contract, in terms of enforceability, includes
an offer and an acceptance, has consideration
for the exchange, clearly sets out the terms of
the agreement without ambiguity and is signed
by the involved parties who have the proper
capacity to enter into the contract
Contract Management
 Contract management is the
process which ensures all
parties to a contract fully meet
their obligations, in order to
satisfy the operational objectives
of the contract and the strategic
business goals of the customer.
Why Contract management ?
Risk is the chance of an event occurring that would cause
actual project circumstances to differ from those assumed
when forecasting project benefits and costs.
Effective contract management incorporates identifying,
monitoring and managing all risks and opportunities over
the life of the project contract to achieve project objectives
and value for money outcomes.
Risks not identified cannot be proactively managed.
They can be very damaging. Risks cannot be correctly
identified unless there are clear project objectives that
provide an unambiguous description of success for the
project.

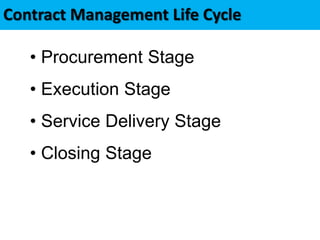

Contract Management Life Cycle
• Procurement Stage
• Execution Stage
• Service Delivery Stage
• Closing Stage

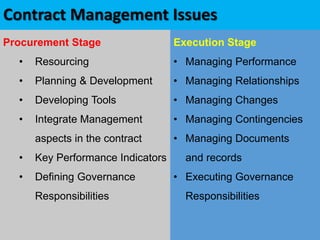

Contract Management Issues
Procurement Stage
• Resourcing
• Planning & Development
• Developing Tools
• Integrate Management
aspects in the contract
• Key Performance Indicators
• Defining Governance
Responsibilities
Execution Stage
• Managing Performance
• Managing Relationships
• Managing Changes
• Managing Contingencies
• Managing Documents
and records
• Executing Governance
Responsibilities
Contract Management Issues
Service Delivery
• Managing Performance
• Managing Relationship
• Managing Changes
• Managing Contingencies
• Managing Documents
and Records
• Delivering Governance
Responsibilities
Contract Closure
• Managing Compliance
• Maintaining Relationships
• Documenting Changes
• Regularizing Contingencies
• Saving Documents for
Asset Management
• Informing the Management
of the closure
Procurement Process
The foundations for effective contract and
performance management are typically set during
the procurement planning process;
Sound contractual basis for effective contract
management is incorporated in the contract;
There is adequate knowledge transfer from the
procurement team to the contract management
team;
The contract management strategy for the project is
in place as soon as practical after the contract is
executed.
The relationship between contract management and the
procurement process
Procurement process Contract management
Expressions of interest
Request for Tenders
Contract execution
Financial close
Transfer of accountability to the contract director
Appointment of contract management team
Planning, information collection and analysis
Development of tools and processes, including
monitoring and reporting requirements
Further development of tools and processes
Contract Management Team
• Small team
• Skills need to cover
 Project Management
 Technical
 Financial
 Legal
• Authority to negotiate
Effective contract risk
management requires the
dedication of appropriate financial
resources and experienced
personnel to the establishment of
a contract risk management
strategy during the procurement
phase of the project and the
maintenance of that strategy
throughout the project lifecycle.
Ideal Contract
Allocation of risk
Service requirements
Value for Money Mechanisms
Procedures for contract management
Service Level
The Contract should set out clearly the
expected performance and Quality
Who is responsible for what needs to be
clear, both mutual and individual
Flexibility especially in early stages of long
term contracts
Enter into mutual Service Level Agreements

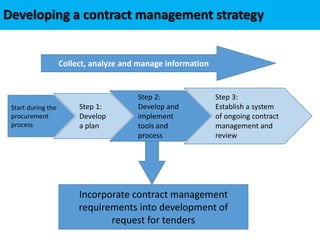

Developing a contract management strategy
Step 1:
Develop
a plan
Step 2:
Develop and
implement
tools and
process
Start during the
procurement
process
Step 3:
Establish a system
of ongoing contract
management and
review
Collect, analyze and manage information
Incorporate contract management
requirements into development of
request for tenders
Key Elements of effective Contract Management
i. Planning, Information Collection and Analysis
ii. Contract Administration
iii. Performance Reporting and Monitoring
iv. Relationship management, dispute resolution
and issue management
v. Governance, probity and compliance
vi. Knowledge and Information management
vii. Change management
viii. Contingency Planning
ix. Ongoing Review
x. Contract Management Training

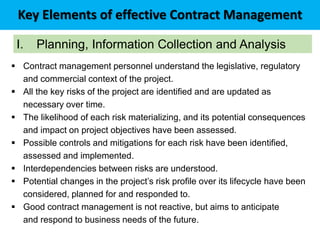

Key Elements of effective Contract Management
I. Planning, Information Collection and Analysis
 Contract management personnel understand the legislative, regulatory
and commercial context of the project.
 All the key risks of the project are identified and are updated as
necessary over time.
 The likelihood of each risk materializing, and its potential consequences
and impact on project objectives have been assessed.
 Possible controls and mitigations for each risk have been identified,
assessed and implemented.
 Interdependencies between risks are understood.
 Potential changes in the project’s risk profile over its lifecycle have been
considered, planned for and responded to.
 Good contract management is not reactive, but aims to anticipate
and respond to business needs of the future.
Procurement
team
Contract
documentation
Advisors
Other
information

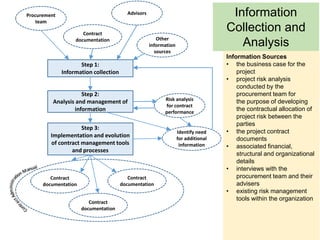

sources
Step 1:
Information collection
Step 2:
Analysis and management of
information
Step 3:
Implementation and evolution
of contract management tools
and processes
Risk analysis
for contract
performance
Identify need
for additional
information
Contract
documentation
Contract
documentation
Contract
documentation
Information
Collection and
Analysis
Information Sources
• the business case for the
project
• project risk analysis
conducted by the
procurement team for
the purpose of developing
the contractual allocation of
project risk between the
parties
• the project contract
documents
• associated financial,
structural and organizational
details
• interviews with the
procurement team and their
advisers
• existing risk management
tools within the organization
Key Elements of effective Contract Management
II. Contract Administration
• Contract administration requires an understanding of the
legal documentation for the project and also:
 the commercial intent of the parties
 the operating, industry and community issues associated with service
provision
 the legislative and regulatory context in which the project operates
• It is the best practice to prepare a comprehensive
Contract Administration Manual that enables the Project
Director to understand the key contract provisions and the
environment in which the contract must be administered,
which will specify:
 What needs to be done, by whom and when ?
 How will employer’s role be performed ?
 What are the ramifications of any non-performance or default by
either party and how these should be addressed ?
Key Elements of effective Contract Management
III. Performance Reporting and Monitoring
• Performance measures lie at the heart of performance management and it
is important that performance measures are linked to strategic objectives,
or to desired outcomes.
• The employer understands the contractor’s internal operating
environment, such as its cash flows. It is through this understanding that
the employer can derive an awareness of the private party’s strengths and
weaknesses, including financial performance.
• The Employer monitors ‘soft’ indicators of the management quality of
contractor looking for weaknesses or trends that may provide an early
indication of trouble ahead.
• The employer regularly reviews the quality of the service as measured
against the KPIs and output specifications.
• Having assessed the data collected through these monitoring activities,
the employer takes appropriate action to mitigate or control any risks that
are materializing, and to maximize value for money from the project.

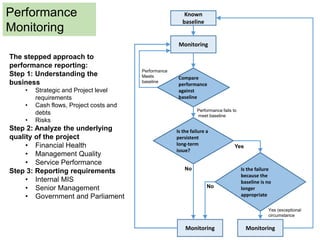

Performance
Monitoring
The stepped approach to
performance reporting:
Step 1: Understanding the
business
• Strategic and Project level
requirements
• Cash flows, Project costs and
debts
• Risks
Step 2: Analyze the underlying
quality of the project
• Financial Health
• Management Quality
• Service Performance
Step 3: Reporting requirements
• Internal MIS
• Senior Management
• Government and Parliament
Known
baseline
Compare
performance
against
baseline
Monitoring
Is the failure a
persistent
long-term
issue?
Is the failure
because the
baseline is no
longer
appropriate
Monitoring
Monitoring
Performance fails to
meet baseline
No
No
Yes
Yes (exceptional
circumstance
Performance
Meets
baseline
Key Elements of effective Contract Management
IV. Relationship Management, Dispute Resolution
and Issue management
• It is imperative to maintain a strong relationship between the employer
and the contractor. Good relationship management enables the parties
to anticipate risk events more effectively and deal with those risks that
do materialize.
• Good communication and a strong relationship are essential,
especially if issues arise which go to the heart of the contract’s
operation.
• It is also important to recognize that disputes and service delivery
issues most likely will arise and will need to be appropriately managed.
• If the parties have strong dispute and issue management principles
and procedures in place, these will help minimize damage to the
relationship and assist the parties to achieve success in the project.
Key Elements of effective Contract Management
 Relationship Management
• Establishing relationship management structures
– Senior Management Support; Peer to Peer communication; separation
of roles; Defined roles and responsibilities; escalation paths
• Understanding one another
 Objectives and expectations; future plan and directions; concerns about
wider relationship; Opinion surveys
• Establishing and using communication channels
 Formal and informal contact points; horizontal and vertical
communications; documenting verbal communication
• Relationship management and succession planning
• Monitoring the Relationship

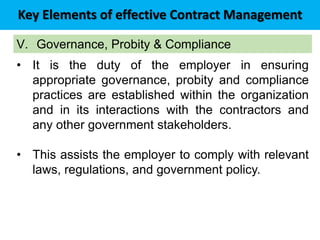

Key Elements of effective Contract Management
V. Governance, Probity & Compliance
• It is the duty of the employer in ensuring
appropriate governance, probity and compliance
practices are established within the organization
and in its interactions with the contractors and
any other government stakeholders.
• This assists the employer to comply with relevant
laws, regulations, and government policy.
Key Elements of effective Contract Management
VI. Knowledge and Information Management
• Employer’s ability to successfully manage a contract can
depend upon the Project Director having an effective
knowledge and information management strategy tailored
to the project’s needs.
• In a well-managed project, the Project Director ensures
the information collected in relation to a project is
maintained, periodically reviewed, and organized for easy
retrieval and access. These practices assist the employer
to comply with:
 record-keeping obligations
 disclosure obligations, such as those under RTI act
 intellectual property laws and confidentiality obligations
Key Elements of effective Contract Management
VII.Change Management
• During the lifecycle of any project, it is likely that a number
of changes will occur, requiring proper management.
• Changes may be contemplated at the time of procurement
and provided for in the contract, or not contemplated during
procurement but seen as desirable or necessary
alterations to services or the contract.
• In either case, change events are both a source of risk
and a potential opportunity to extract additional
benefits from the project.
Key Elements of effective Contract Management
Change Management Cont.…
• Good change management processes incorporate
the following features:
 Appropriate protocols are in place to manage change
 Appropriate staff have the authority to request and authorise
changes
 Potential changes are assessed thoroughly by suitably experienced
personnel, having consulted with all relevant stakeholders
 Changes are appropriately prioritised and their implementation is
properly resourced
 The implementation of changes is controlled and tested
 Changes are appropriately documented
 Changes do not compromise value for money outcomes
Key Elements of effective Contract Management
VIII.Contingency Planning
• It may not be possible to fully transfer responsibility for the risk of
service delivery failure to the contractor.
• If the contractor fails to deliver services according to the
requirements of the contract, the employer, and possibly
government as a whole, may retain accountability, and potentially
face adverse reaction from end users and third parties.
• In addition, the contractor’s obligation to provide services may be
suspended through the operation of force majeure provisions. If so,
the employer may be compelled or subjected to strong pressure to
ensure that the public or other third parties are not inconvenienced
by a disruption to the supply of those services.
• Effective contingency planning is that the employer can react to
unplanned events and control the impact of these events on service
delivery value for money outcomes.
Key Elements of effective Contract Management
IX. Ongoing Review
• Contract management processes must change and adapt
throughout the lifecycle of a contract, and therefore should
be reviewed on an ongoing basis to ensure that
management is sufficiently informed of current and
emerging risks and issues.
• In addition to regular reviews, the impact of the following
events should be considered as and when they occur:
 divergence between each party’s expectations and actual project
outcomes
 changes in the project itself through change events, contingency
events, or as a result of the project moving from one stage to
another in its lifecycle
 changes in the external environment in which the project operates.
Key Elements of effective Contract Management
IX. Contract Management Training
• For contract management to be effective, Project Directors
need not only a strong knowledge of the basics, but also a
detailed practical understanding of commercial and legal
dimensions of contract management. The training will meet
this second need.
• As this practical understanding is vital to the success of the
Project Director, and the contract management team, in
implementing effective contract management practices, the
training will be mandatory for employer’s personnel
involved in the management of projects.
L8_PROJECT CONTRACT Management.ppt

More Related Content

What's hot

Iso 9001:2015 internal auditor Course
Iso 9001:2015  internal auditor Course Iso 9001:2015  internal auditor Course
Iso 9001:2015 internal auditor Course Atif Alhaj

Project Procurement - Principles and Case Study
Project Procurement - Principles and Case StudyProject Procurement - Principles and Case Study
Project Procurement - Principles and Case StudyKiran Radhakrishnan

Iso 9001 2015 documented information guidlines
Iso 9001 2015 documented information guidlinesIso 9001 2015 documented information guidlines
Iso 9001 2015 documented information guidlinesRajeesh Thumpayil

ISO 9001 2015 Quality Management System (Implementation)
ISO 9001 2015 Quality Management System (Implementation)ISO 9001 2015 Quality Management System (Implementation)
ISO 9001 2015 Quality Management System (Implementation)Rozil Anwar

5S training manual
5S training manual5S training manual
5S training manualHasan319365

Contract management
Contract managementContract management
Contract managementNishant Rai

Quality Control
Quality ControlQuality Control
Quality ControlCarul Push

Good Documentation Practice
Good Documentation PracticeGood Documentation Practice
Good Documentation PracticeManpreet Rait

Quality Awareness Session.pptx
Quality Awareness Session.pptxQuality Awareness Session.pptx
Quality Awareness Session.pptxssuser7e363f

Quality Management System awareness for all
Quality Management System awareness for all Quality Management System awareness for all
Quality Management System awareness for all ANUPAM RAY

ISO 9001:2015 Awareness Training
ISO 9001:2015 Awareness TrainingISO 9001:2015 Awareness Training
ISO 9001:2015 Awareness TrainingANUPAM RAY

Change Management - 4 m change
Change Management - 4 m changeChange Management - 4 m change
Change Management - 4 m changeHardil Shah

Quality control
Quality controlQuality control
Quality controlHpm India


What's hot (20)

Iso 9001:2015 internal auditor Course
Iso 9001:2015  internal auditor Course Iso 9001:2015  internal auditor Course
Iso 9001:2015 internal auditor Course

Facing an audit
Facing an auditFacing an audit
Facing an audit

Introdution of qa qc
Introdution of qa qcIntrodution of qa qc
Introdution of qa qc

Project Procurement - Principles and Case Study
Project Procurement - Principles and Case StudyProject Procurement - Principles and Case Study
Project Procurement - Principles and Case Study

Iso 9001 2015 documented information guidlines
Iso 9001 2015 documented information guidlinesIso 9001 2015 documented information guidlines
Iso 9001 2015 documented information guidlines

ISO 9001 2015 Quality Management System (Implementation)
ISO 9001 2015 Quality Management System (Implementation)ISO 9001 2015 Quality Management System (Implementation)
ISO 9001 2015 Quality Management System (Implementation)

ISO lead auditor Training
ISO lead auditor TrainingISO lead auditor Training
ISO lead auditor Training

5S training manual
5S training manual5S training manual
5S training manual

Contract management
Contract managementContract management
Contract management

Quality Control
Quality ControlQuality Control
Quality Control

Good Documentation Practice
Good Documentation PracticeGood Documentation Practice
Good Documentation Practice

Quality Awareness Session.pptx
Quality Awareness Session.pptxQuality Awareness Session.pptx
Quality Awareness Session.pptx

Quality Management System awareness for all
Quality Management System awareness for all Quality Management System awareness for all
Quality Management System awareness for all

ISO 9001:2015 Awareness Training
ISO 9001:2015 Awareness TrainingISO 9001:2015 Awareness Training
ISO 9001:2015 Awareness Training

Material management
Material managementMaterial management
Material management

Change Management - 4 m change
Change Management - 4 m changeChange Management - 4 m change
Change Management - 4 m change

Quality control
Quality controlQuality control
Quality control

Iso 9001
Iso 9001Iso 9001
Iso 9001

Third Party Quality Inspections
Third Party Quality Inspections Third Party Quality Inspections
Third Party Quality Inspections

Iso17025
Iso17025Iso17025
Iso17025


Similar to L8_PROJECT CONTRACT Management.ppt

Overview to contract management
Overview to contract managementOverview to contract management
Overview to contract managementPriyesh Nair

Post Award Contract Management for IT Suppliers v1.0 20200701
Post Award Contract Management for IT Suppliers v1.0 20200701Post Award Contract Management for IT Suppliers v1.0 20200701
Post Award Contract Management for IT Suppliers v1.0 20200701Peter Soetevent

Contracting process paper cpmgt302september 21, 2015
Contracting process paper cpmgt302september 21, 2015Contracting process paper cpmgt302september 21, 2015
Contracting process paper cpmgt302september 21, 2015SONU61709

Contracting Process Paper CPMGT_302.docx
Contracting Process Paper CPMGT_302.docxContracting Process Paper CPMGT_302.docx
Contracting Process Paper CPMGT_302.docxRebeccaEdwards88

What is Contract Lifecycle Management?
What is Contract Lifecycle Management?What is Contract Lifecycle Management?
What is Contract Lifecycle Management?Bywater Training

L7_PROJECT PROCUREMENT Management.pdf
L7_PROJECT PROCUREMENT Management.pdfL7_PROJECT PROCUREMENT Management.pdf
L7_PROJECT PROCUREMENT Management.pdfMUST

Contract management.ppt
Contract management.pptContract management.ppt
Contract management.pptMUST

Manage Your Organization's Contract Risks Final
Manage Your Organization's Contract Risks FinalManage Your Organization's Contract Risks Final
Manage Your Organization's Contract Risks FinalFred Travis

CONTRACT MANAGEMENT.pptx
CONTRACT MANAGEMENT.pptxCONTRACT MANAGEMENT.pptx
CONTRACT MANAGEMENT.pptxihsanmuhammad44

Prepare for the asc 606 revenue standard
Prepare for the asc 606 revenue standardPrepare for the asc 606 revenue standard
Prepare for the asc 606 revenue standardPromapp Solutions

Best Practices To Improve Contract Management Process
Best Practices To Improve Contract Management Process Best Practices To Improve Contract Management Process
Best Practices To Improve Contract Management Process Benny Henson

contract management, stages of contract management
 contract management, stages of contract management contract management, stages of contract management
contract management, stages of contract managementVISHAKA BOTHRA

0.Commercial Management slides _Lvl3.pdf
0.Commercial Management slides _Lvl3.pdf0.Commercial Management slides _Lvl3.pdf
0.Commercial Management slides _Lvl3.pdfRahulSamadhiya2

Chapter 5.1 Contracts Management - Contract Administration-owners perspective...
Chapter 5.1 Contracts Management - Contract Administration-owners perspective...Chapter 5.1 Contracts Management - Contract Administration-owners perspective...
Chapter 5.1 Contracts Management - Contract Administration-owners perspective...ChandanLawrence

Ahmed Faheem Resume 17-04-2016
Ahmed Faheem Resume 17-04-2016Ahmed Faheem Resume 17-04-2016
Ahmed Faheem Resume 17-04-2016Ahmed Faheem

Systech International Corporate Profile
Systech International Corporate ProfileSystech International Corporate Profile
Systech International Corporate Profilejason_eve3

Systech International Corporate Profile
Systech International Corporate ProfileSystech International Corporate Profile
Systech International Corporate Profilejason_eve


Similar to L8_PROJECT CONTRACT Management.ppt (20)

Contract management general
Contract management generalContract management general
Contract management general

Overview to contract management
Overview to contract managementOverview to contract management
Overview to contract management

Post Award Contract Management for IT Suppliers v1.0 20200701
Post Award Contract Management for IT Suppliers v1.0 20200701Post Award Contract Management for IT Suppliers v1.0 20200701
Post Award Contract Management for IT Suppliers v1.0 20200701

Contracting process paper cpmgt302september 21, 2015
Contracting process paper cpmgt302september 21, 2015Contracting process paper cpmgt302september 21, 2015
Contracting process paper cpmgt302september 21, 2015

Contracting Process Paper CPMGT_302.docx
Contracting Process Paper CPMGT_302.docxContracting Process Paper CPMGT_302.docx
Contracting Process Paper CPMGT_302.docx

What is Contract Lifecycle Management?
What is Contract Lifecycle Management?What is Contract Lifecycle Management?
What is Contract Lifecycle Management?

L7_PROJECT PROCUREMENT Management.pdf
L7_PROJECT PROCUREMENT Management.pdfL7_PROJECT PROCUREMENT Management.pdf
L7_PROJECT PROCUREMENT Management.pdf

ECM BY KP - Copy
ECM BY KP - CopyECM BY KP - Copy
ECM BY KP - Copy

Contract management.ppt
Contract management.pptContract management.ppt
Contract management.ppt

Manage Your Organization's Contract Risks Final
Manage Your Organization's Contract Risks FinalManage Your Organization's Contract Risks Final
Manage Your Organization's Contract Risks Final

CONTRACT MANAGEMENT.pptx
CONTRACT MANAGEMENT.pptxCONTRACT MANAGEMENT.pptx
CONTRACT MANAGEMENT.pptx

Prepare for the asc 606 revenue standard
Prepare for the asc 606 revenue standardPrepare for the asc 606 revenue standard
Prepare for the asc 606 revenue standard

Best Practices To Improve Contract Management Process
Best Practices To Improve Contract Management Process Best Practices To Improve Contract Management Process
Best Practices To Improve Contract Management Process

contract management, stages of contract management
 contract management, stages of contract management contract management, stages of contract management
contract management, stages of contract management

0.Commercial Management slides _Lvl3.pdf
0.Commercial Management slides _Lvl3.pdf0.Commercial Management slides _Lvl3.pdf
0.Commercial Management slides _Lvl3.pdf

Lecture 2
Lecture 2Lecture 2
Lecture 2

Chapter 5.1 Contracts Management - Contract Administration-owners perspective...
Chapter 5.1 Contracts Management - Contract Administration-owners perspective...Chapter 5.1 Contracts Management - Contract Administration-owners perspective...
Chapter 5.1 Contracts Management - Contract Administration-owners perspective...

Ahmed Faheem Resume 17-04-2016
Ahmed Faheem Resume 17-04-2016Ahmed Faheem Resume 17-04-2016
Ahmed Faheem Resume 17-04-2016

Systech International Corporate Profile
Systech International Corporate ProfileSystech International Corporate Profile
Systech International Corporate Profile

Systech International Corporate Profile
Systech International Corporate ProfileSystech International Corporate Profile
Systech International Corporate Profile


More from MUST

Lecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.ppt
Lecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.pptLecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.ppt
Lecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.pptMUST

NYQUIST_PLOTS.pdf
NYQUIST_PLOTS.pdfNYQUIST_PLOTS.pdf
NYQUIST_PLOTS.pdfMUST

ME451_L10_RouthHurwitz.pdf
ME451_L10_RouthHurwitz.pdfME451_L10_RouthHurwitz.pdf
ME451_L10_RouthHurwitz.pdfMUST

LECTURE 1. Control Systems Engineering_MEB 4101.pdf
LECTURE 1. Control Systems Engineering_MEB 4101.pdfLECTURE 1. Control Systems Engineering_MEB 4101.pdf
LECTURE 1. Control Systems Engineering_MEB 4101.pdfMUST

Stability criteria and Analysis_Control Systems Engineering_MEB 4101.pdf
Stability criteria and Analysis_Control Systems Engineering_MEB 4101.pdfStability criteria and Analysis_Control Systems Engineering_MEB 4101.pdf
Stability criteria and Analysis_Control Systems Engineering_MEB 4101.pdfMUST

LECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptx
LECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptxLECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptx
LECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptxMUST

LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...
LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...
LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...MUST

2 Robot Actuators and drive systems.ppt
2 Robot Actuators and drive systems.ppt2 Robot Actuators and drive systems.ppt
2 Robot Actuators and drive systems.pptMUST

ON-OFF CONTROL (2).ppt
ON-OFF CONTROL (2).pptON-OFF CONTROL (2).ppt
ON-OFF CONTROL (2).pptMUST

L4_Cost Management.ppt
L4_Cost Management.pptL4_Cost Management.ppt
L4_Cost Management.pptMUST

Project procurement Management.ppt
Project procurement Management.pptProject procurement Management.ppt
Project procurement Management.pptMUST

PROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdfPROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdfMUST

pmp11-risk-180412035349-2.pdf
pmp11-risk-180412035349-2.pdfpmp11-risk-180412035349-2.pdf
pmp11-risk-180412035349-2.pdfMUST

2nd_order.pdf
2nd_order.pdf2nd_order.pdf
2nd_order.pdfMUST

History of Robotics.ppt
History of Robotics.pptHistory of Robotics.ppt
History of Robotics.pptMUST

Machine Vision Systems.pptx
Machine Vision Systems.pptxMachine Vision Systems.pptx
Machine Vision Systems.pptxMUST

Project Human Resources Management.ppt
Project Human Resources Management.pptProject Human Resources Management.ppt
Project Human Resources Management.pptMUST

Robot actuation and feedback components.pptx
Robot actuation and feedback components.pptxRobot actuation and feedback components.pptx
Robot actuation and feedback components.pptxMUST

L2_Scope Management.ppt
L2_Scope Management.pptL2_Scope Management.ppt
L2_Scope Management.pptMUST

L1-Project Integration Management.pdf
L1-Project Integration Management.pdfL1-Project Integration Management.pdf
L1-Project Integration Management.pdfMUST


More from MUST (20)

Lecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.ppt
Lecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.pptLecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.ppt
Lecture 4-ELECTRIC MOTORS-ACTUATION SYSTEMS2.ppt

NYQUIST_PLOTS.pdf
NYQUIST_PLOTS.pdfNYQUIST_PLOTS.pdf
NYQUIST_PLOTS.pdf

ME451_L10_RouthHurwitz.pdf
ME451_L10_RouthHurwitz.pdfME451_L10_RouthHurwitz.pdf
ME451_L10_RouthHurwitz.pdf

LECTURE 1. Control Systems Engineering_MEB 4101.pdf
LECTURE 1. Control Systems Engineering_MEB 4101.pdfLECTURE 1. Control Systems Engineering_MEB 4101.pdf
LECTURE 1. Control Systems Engineering_MEB 4101.pdf

Stability criteria and Analysis_Control Systems Engineering_MEB 4101.pdf
Stability criteria and Analysis_Control Systems Engineering_MEB 4101.pdfStability criteria and Analysis_Control Systems Engineering_MEB 4101.pdf
Stability criteria and Analysis_Control Systems Engineering_MEB 4101.pdf

LECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptx
LECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptxLECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptx
LECTURE 3_On-off_Control Systems Engineering_MEB 4101.pptx

LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...
LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...
LECTURE 4. Stability criteria and Analysis_Control Systems Engineering_MEB 41...

2 Robot Actuators and drive systems.ppt
2 Robot Actuators and drive systems.ppt2 Robot Actuators and drive systems.ppt
2 Robot Actuators and drive systems.ppt

ON-OFF CONTROL (2).ppt
ON-OFF CONTROL (2).pptON-OFF CONTROL (2).ppt
ON-OFF CONTROL (2).ppt

L4_Cost Management.ppt
L4_Cost Management.pptL4_Cost Management.ppt
L4_Cost Management.ppt

Project procurement Management.ppt
Project procurement Management.pptProject procurement Management.ppt
Project procurement Management.ppt

PROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdfPROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdf

pmp11-risk-180412035349-2.pdf
pmp11-risk-180412035349-2.pdfpmp11-risk-180412035349-2.pdf
pmp11-risk-180412035349-2.pdf

2nd_order.pdf
2nd_order.pdf2nd_order.pdf
2nd_order.pdf

History of Robotics.ppt
History of Robotics.pptHistory of Robotics.ppt
History of Robotics.ppt

Machine Vision Systems.pptx
Machine Vision Systems.pptxMachine Vision Systems.pptx
Machine Vision Systems.pptx

Project Human Resources Management.ppt
Project Human Resources Management.pptProject Human Resources Management.ppt
Project Human Resources Management.ppt

Robot actuation and feedback components.pptx
Robot actuation and feedback components.pptxRobot actuation and feedback components.pptx
Robot actuation and feedback components.pptx

L2_Scope Management.ppt
L2_Scope Management.pptL2_Scope Management.ppt
L2_Scope Management.ppt

L1-Project Integration Management.pdf
L1-Project Integration Management.pdfL1-Project Integration Management.pdf
L1-Project Integration Management.pdf


Recently uploaded

Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)jennyeacort

self respect is very important in this crual word where everyone in just thin...
self respect is very important in this crual word where everyone in just thin...self respect is very important in this crual word where everyone in just thin...
self respect is very important in this crual word where everyone in just thin...afaqsaeed463

Unlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency MatrixUnlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency MatrixCIToolkit

Measuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield MetricsMeasuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield MetricsCIToolkit

ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...AgileNetwork

原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证jdkhjh

Fifteenth Finance Commission Presentation
Fifteenth Finance Commission PresentationFifteenth Finance Commission Presentation
Fifteenth Finance Commission Presentationmintusiprd

Simplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes ThinkingSimplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes ThinkingCIToolkit

Reflecting, turning experience into insight
Reflecting, turning experience into insightReflecting, turning experience into insight
Reflecting, turning experience into insightWayne Abrahams

LPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations ReviewLPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations Reviewthomas851723

Introduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-EngineeringIntroduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-Engineeringthomas851723

Board Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch PresentationBoard Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch Presentationcraig524401

VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With RoomVIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Roomdivyansh0kumar0

LPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business SectorLPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business Sectorthomas851723

Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Nehwal

Farmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan ManchFarmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan ManchRashtriya Kisan Manch


Recently uploaded (17)

Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)

self respect is very important in this crual word where everyone in just thin...
self respect is very important in this crual word where everyone in just thin...self respect is very important in this crual word where everyone in just thin...
self respect is very important in this crual word where everyone in just thin...

Unlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency MatrixUnlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency Matrix

Measuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield MetricsMeasuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield Metrics

ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...

原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证

Fifteenth Finance Commission Presentation
Fifteenth Finance Commission PresentationFifteenth Finance Commission Presentation
Fifteenth Finance Commission Presentation

Simplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes ThinkingSimplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes Thinking

Reflecting, turning experience into insight
Reflecting, turning experience into insightReflecting, turning experience into insight
Reflecting, turning experience into insight

LPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations ReviewLPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations Review

Introduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-EngineeringIntroduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-Engineering

Board Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch PresentationBoard Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch Presentation

sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service
sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Servicesauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service
sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service

VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With RoomVIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room

LPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business SectorLPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business Sector

Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...

Farmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan ManchFarmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan Manch


L8_PROJECT CONTRACT Management.ppt

  • 2. Agenda • Contract and Contract Management • Contract Management Life cycle • Key Elements of Contract Management • Issues involved in managing contracts
  • 3. What is a Contract ? • A contract is an agreement between two or more people that is legally binding. A contract can be verbal or written. • The contract, in terms of enforceability, includes an offer and an acceptance, has consideration for the exchange, clearly sets out the terms of the agreement without ambiguity and is signed by the involved parties who have the proper capacity to enter into the contract
  • 4. Contract Management  Contract management is the process which ensures all parties to a contract fully meet their obligations, in order to satisfy the operational objectives of the contract and the strategic business goals of the customer.
  • 5. Why Contract management ? Risk is the chance of an event occurring that would cause actual project circumstances to differ from those assumed when forecasting project benefits and costs. Effective contract management incorporates identifying, monitoring and managing all risks and opportunities over the life of the project contract to achieve project objectives and value for money outcomes. Risks not identified cannot be proactively managed. They can be very damaging. Risks cannot be correctly identified unless there are clear project objectives that provide an unambiguous description of success for the project.
  • 6. Contract Management Life Cycle • Procurement Stage • Execution Stage • Service Delivery Stage • Closing Stage
  • 7. Contract Management Issues Procurement Stage • Resourcing • Planning & Development • Developing Tools • Integrate Management aspects in the contract • Key Performance Indicators • Defining Governance Responsibilities Execution Stage • Managing Performance • Managing Relationships • Managing Changes • Managing Contingencies • Managing Documents and records • Executing Governance Responsibilities
  • 8. Contract Management Issues Service Delivery • Managing Performance • Managing Relationship • Managing Changes • Managing Contingencies • Managing Documents and Records • Delivering Governance Responsibilities Contract Closure • Managing Compliance • Maintaining Relationships • Documenting Changes • Regularizing Contingencies • Saving Documents for Asset Management • Informing the Management of the closure
  • 9. Procurement Process The foundations for effective contract and performance management are typically set during the procurement planning process; Sound contractual basis for effective contract management is incorporated in the contract; There is adequate knowledge transfer from the procurement team to the contract management team; The contract management strategy for the project is in place as soon as practical after the contract is executed.
  • 10. The relationship between contract management and the procurement process Procurement process Contract management Expressions of interest Request for Tenders Contract execution Financial close Transfer of accountability to the contract director Appointment of contract management team Planning, information collection and analysis Development of tools and processes, including monitoring and reporting requirements Further development of tools and processes
  • 11. Contract Management Team • Small team • Skills need to cover  Project Management  Technical  Financial  Legal • Authority to negotiate Effective contract risk management requires the dedication of appropriate financial resources and experienced personnel to the establishment of a contract risk management strategy during the procurement phase of the project and the maintenance of that strategy throughout the project lifecycle.
  • 12. Ideal Contract Allocation of risk Service requirements Value for Money Mechanisms Procedures for contract management
  • 13. Service Level The Contract should set out clearly the expected performance and Quality Who is responsible for what needs to be clear, both mutual and individual Flexibility especially in early stages of long term contracts Enter into mutual Service Level Agreements
  • 14. Developing a contract management strategy Step 1: Develop a plan Step 2: Develop and implement tools and process Start during the procurement process Step 3: Establish a system of ongoing contract management and review Collect, analyze and manage information Incorporate contract management requirements into development of request for tenders
  • 15. Key Elements of effective Contract Management i. Planning, Information Collection and Analysis ii. Contract Administration iii. Performance Reporting and Monitoring iv. Relationship management, dispute resolution and issue management v. Governance, probity and compliance vi. Knowledge and Information management vii. Change management viii. Contingency Planning ix. Ongoing Review x. Contract Management Training
  • 16. Key Elements of effective Contract Management I. Planning, Information Collection and Analysis  Contract management personnel understand the legislative, regulatory and commercial context of the project.  All the key risks of the project are identified and are updated as necessary over time.  The likelihood of each risk materializing, and its potential consequences and impact on project objectives have been assessed.  Possible controls and mitigations for each risk have been identified, assessed and implemented.  Interdependencies between risks are understood.  Potential changes in the project’s risk profile over its lifecycle have been considered, planned for and responded to.  Good contract management is not reactive, but aims to anticipate and respond to business needs of the future.
  • 17. Procurement team Contract documentation Advisors Other information sources Step 1: Information collection Step 2: Analysis and management of information Step 3: Implementation and evolution of contract management tools and processes Risk analysis for contract performance Identify need for additional information Contract documentation Contract documentation Contract documentation Information Collection and Analysis Information Sources • the business case for the project • project risk analysis conducted by the procurement team for the purpose of developing the contractual allocation of project risk between the parties • the project contract documents • associated financial, structural and organizational details • interviews with the procurement team and their advisers • existing risk management tools within the organization
  • 18. Key Elements of effective Contract Management II. Contract Administration • Contract administration requires an understanding of the legal documentation for the project and also:  the commercial intent of the parties  the operating, industry and community issues associated with service provision  the legislative and regulatory context in which the project operates • It is the best practice to prepare a comprehensive Contract Administration Manual that enables the Project Director to understand the key contract provisions and the environment in which the contract must be administered, which will specify:  What needs to be done, by whom and when ?  How will employer’s role be performed ?  What are the ramifications of any non-performance or default by either party and how these should be addressed ?
  • 19. Key Elements of effective Contract Management III. Performance Reporting and Monitoring • Performance measures lie at the heart of performance management and it is important that performance measures are linked to strategic objectives, or to desired outcomes. • The employer understands the contractor’s internal operating environment, such as its cash flows. It is through this understanding that the employer can derive an awareness of the private party’s strengths and weaknesses, including financial performance. • The Employer monitors ‘soft’ indicators of the management quality of contractor looking for weaknesses or trends that may provide an early indication of trouble ahead. • The employer regularly reviews the quality of the service as measured against the KPIs and output specifications. • Having assessed the data collected through these monitoring activities, the employer takes appropriate action to mitigate or control any risks that are materializing, and to maximize value for money from the project.
  • 20. Performance Monitoring The stepped approach to performance reporting: Step 1: Understanding the business • Strategic and Project level requirements • Cash flows, Project costs and debts • Risks Step 2: Analyze the underlying quality of the project • Financial Health • Management Quality • Service Performance Step 3: Reporting requirements • Internal MIS • Senior Management • Government and Parliament Known baseline Compare performance against baseline Monitoring Is the failure a persistent long-term issue? Is the failure because the baseline is no longer appropriate Monitoring Monitoring Performance fails to meet baseline No No Yes Yes (exceptional circumstance Performance Meets baseline
  • 21. Key Elements of effective Contract Management IV. Relationship Management, Dispute Resolution and Issue management • It is imperative to maintain a strong relationship between the employer and the contractor. Good relationship management enables the parties to anticipate risk events more effectively and deal with those risks that do materialize. • Good communication and a strong relationship are essential, especially if issues arise which go to the heart of the contract’s operation. • It is also important to recognize that disputes and service delivery issues most likely will arise and will need to be appropriately managed. • If the parties have strong dispute and issue management principles and procedures in place, these will help minimize damage to the relationship and assist the parties to achieve success in the project.
  • 22. Key Elements of effective Contract Management  Relationship Management • Establishing relationship management structures – Senior Management Support; Peer to Peer communication; separation of roles; Defined roles and responsibilities; escalation paths • Understanding one another  Objectives and expectations; future plan and directions; concerns about wider relationship; Opinion surveys • Establishing and using communication channels  Formal and informal contact points; horizontal and vertical communications; documenting verbal communication • Relationship management and succession planning • Monitoring the Relationship
  • 23. Key Elements of effective Contract Management V. Governance, Probity & Compliance • It is the duty of the employer in ensuring appropriate governance, probity and compliance practices are established within the organization and in its interactions with the contractors and any other government stakeholders. • This assists the employer to comply with relevant laws, regulations, and government policy.
  • 24. Key Elements of effective Contract Management VI. Knowledge and Information Management • Employer’s ability to successfully manage a contract can depend upon the Project Director having an effective knowledge and information management strategy tailored to the project’s needs. • In a well-managed project, the Project Director ensures the information collected in relation to a project is maintained, periodically reviewed, and organized for easy retrieval and access. These practices assist the employer to comply with:  record-keeping obligations  disclosure obligations, such as those under RTI act  intellectual property laws and confidentiality obligations
  • 25. Key Elements of effective Contract Management VII.Change Management • During the lifecycle of any project, it is likely that a number of changes will occur, requiring proper management. • Changes may be contemplated at the time of procurement and provided for in the contract, or not contemplated during procurement but seen as desirable or necessary alterations to services or the contract. • In either case, change events are both a source of risk and a potential opportunity to extract additional benefits from the project.
  • 26. Key Elements of effective Contract Management Change Management Cont.… • Good change management processes incorporate the following features:  Appropriate protocols are in place to manage change  Appropriate staff have the authority to request and authorise changes  Potential changes are assessed thoroughly by suitably experienced personnel, having consulted with all relevant stakeholders  Changes are appropriately prioritised and their implementation is properly resourced  The implementation of changes is controlled and tested  Changes are appropriately documented  Changes do not compromise value for money outcomes
  • 27. Key Elements of effective Contract Management VIII.Contingency Planning • It may not be possible to fully transfer responsibility for the risk of service delivery failure to the contractor. • If the contractor fails to deliver services according to the requirements of the contract, the employer, and possibly government as a whole, may retain accountability, and potentially face adverse reaction from end users and third parties. • In addition, the contractor’s obligation to provide services may be suspended through the operation of force majeure provisions. If so, the employer may be compelled or subjected to strong pressure to ensure that the public or other third parties are not inconvenienced by a disruption to the supply of those services. • Effective contingency planning is that the employer can react to unplanned events and control the impact of these events on service delivery value for money outcomes.
  • 28. Key Elements of effective Contract Management IX. Ongoing Review • Contract management processes must change and adapt throughout the lifecycle of a contract, and therefore should be reviewed on an ongoing basis to ensure that management is sufficiently informed of current and emerging risks and issues. • In addition to regular reviews, the impact of the following events should be considered as and when they occur:  divergence between each party’s expectations and actual project outcomes  changes in the project itself through change events, contingency events, or as a result of the project moving from one stage to another in its lifecycle  changes in the external environment in which the project operates.
  • 29. Key Elements of effective Contract Management IX. Contract Management Training • For contract management to be effective, Project Directors need not only a strong knowledge of the basics, but also a detailed practical understanding of commercial and legal dimensions of contract management. The training will meet this second need. • As this practical understanding is vital to the success of the Project Director, and the contract management team, in implementing effective contract management practices, the training will be mandatory for employer’s personnel involved in the management of projects.
