An Example of Using Key Performance Indicators for Software Development
                         Process Efficiency Evaluation

                                                          Ž. Antolić
                                                         R&D Center
                                                  Ericsson Nikola Tesla d.d.
                                  Complete Address: Krapinska 45, Zagreb, HR-10000, Croatia
                       Phone: +385 1 365 4584 Fax: +385 1 365 4082 E-mail: zeljko.antolic@ericsson.com

Abstract - This paper gives an overview of possible Key            measurement across the entire life cycle of a software
Performance Indicators (KPI) that can be used for                  project, from inception to retirement. Measurement is
software process efficiency evaluation. The overview is            implemented as a proactive discipline, and measurement
based on currently used KPIs in software development               derived information is considered to be a strategic
projects on CPP platform. The most important KPIs are              resource.
analyzed, and their usage in the process efficiency                   Measurement is most important at the project level.
evaluation is discussed. The outcome of the measurement is         Software measurement helps the project manager do a
used to initiate further process adjustments and                   better job. It helps to define and implement more
improvements. In addition, there is possibility to perform         realistic plans, to properly allocate scarce resources to
benchmarking between different development projects,               put those plans into place, and to accurately monitor
and based on collected data easier search for best practices       progress and performance against those plans. Software
in the projects that can be broadly implemented. Some              measurement provides the information required to make
proposals and future directions in the area of process             key project decisions and to take appropriate action.
measurement are given.                                             Measurement helps to relate and integrate the
                                                                   information derived from other project and technical
                                                                   management disciplines. In effect, it allows the software
                  I. INTRODUCTION                                  project manager to make decisions using objective
                                                                   information.
   All successful software organizations implement                    In this article, the overview of process measurement
measurement as part of their day-to-day management                 in software development projects on CPP platform will
and technical activities. Measurement provides the                 be given, and some Key Performance Indicators (KPIs)
objective information they need to make informed                   will be discussed. Also, one example of project
decisions that positively impact their business and                benchmarking will be presented. At the end, some
engineering performance. In successful software                    improvement proposals, and directions for further work
organizations, measurement-derived information is                  will be given.
treated as an important resource and is made available to
decision makers throughout all levels of management.
   The way measurement is actually implemented and
used in a software organization determines how much
                                                                        II. ISO/IEC 15939 Software Measurement Process
value is realized in terms of business and engineering
performance. Measurement is most effective when                       The International Standard ISO/IEC 15939 identifies
implemented in support of an organization’s business               the activities and tasks that are necessary to successfully
and technical objectives and when integrated with the              identify, define, select, apply, and improve software
existing technical and management activities that define           measurement within an overall project or organizational
a software project. Measurement works best when it                 measurement structure. It also provides definitions for
provides objective information related to the risks and            measurement terms commonly used within the software
problems that may impact a project’s defined objectives.           industry [2]. The software measurement process itself is
In other words, measurement works best when it is                  shown on Fig. 1.
considered a significant, integral part of project
management [1].                                                                               Measurement

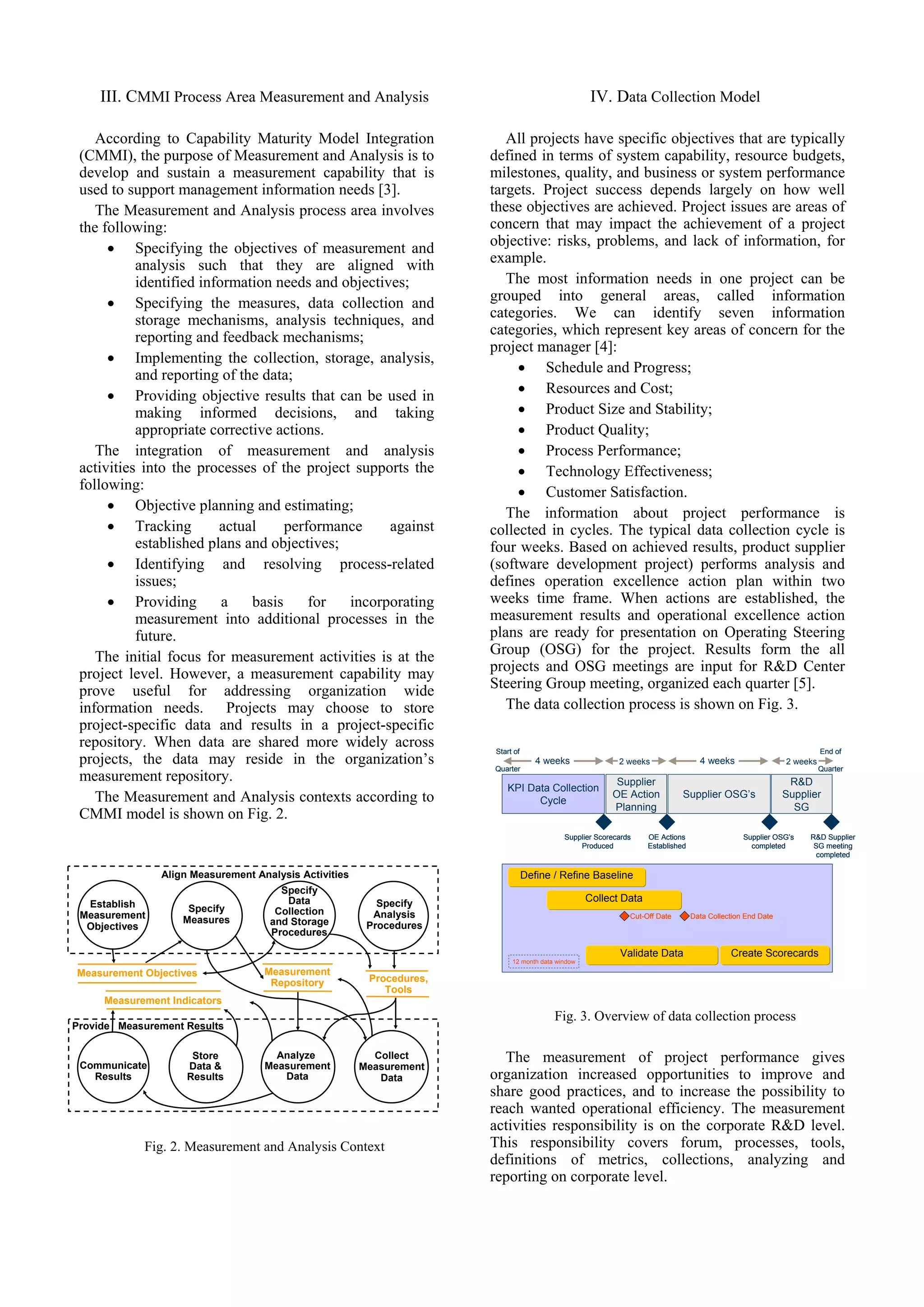

                                                                                              Requirements
                                                                                                                                      User
                                                                                                                                    Feedback
                                                                                                              Technical and
   Top-performing organizations design their technical                                                        Management
and management processes to make use of objective                                            Objectives and
                                                                                                 Issues
                                                                                                               Processes             Analysis
                                                                                                                                     Results

measurement data. Measurement data and associated                                                              Measurement

analysis results support both short and long-term
                                                                                                                  Plan
                                                                             Establish
                                                                                                Plan                            Perform
                                                                            and Sustain
decision making. A mature software development                              Commitment
                                                                                             Measurement
                                                                                                                   New
                                                                                                                              Measurement

organization typically uses measurement to help plan
                                                                                                                  Issues
                                                                                                                                Analysis Results
                                                                                                                                and Performance
and evaluate a proposed software project, to objectively                                     Improvement
                                                                                               Actions
                                                                                                               Evaluate
                                                                                                                                   Measures

track actual performance against planned objectives, to             Scope of
                                                                    Measurement
                                                                                                              Measurement

guide software process improvement decisions and                    Process

investments, and to help assess overall business and
technical      performance     against    market-driven                     Fig. 1. ISO/IEC 15939 Software Measurement Process
requirements. A top-performing organization uses
III. CMMI Process Area Measurement and Analysis                                                IV. Data Collection Model

    According to Capability Maturity Model Integration                   All projects have specific objectives that are typically
 (CMMI), the purpose of Measurement and Analysis is to                defined in terms of system capability, resource budgets,
 develop and sustain a measurement capability that is                 milestones, quality, and business or system performance
 used to support management information needs [3].                    targets. Project success depends largely on how well
    The Measurement and Analysis process area involves                these objectives are achieved. Project issues are areas of
 the following:                                                       concern that may impact the achievement of a project
      • Specifying the objectives of measurement and                  objective: risks, problems, and lack of information, for
           analysis such that they are aligned with                   example.
           identified information needs and objectives;                  The most information needs in one project can be
      • Specifying the measures, data collection and                  grouped into general areas, called information
           storage mechanisms, analysis techniques, and               categories. We can identify seven information
           reporting and feedback mechanisms;                         categories, which represent key areas of concern for the
                                                                      project manager [4]:
      • Implementing the collection, storage, analysis,
           and reporting of the data;                                      • Schedule and Progress;
      • Providing objective results that can be used in                    • Resources and Cost;
           making informed decisions, and taking                           • Product Size and Stability;
           appropriate corrective actions.                                 • Product Quality;
    The integration of measurement and analysis                            • Process Performance;
 activities into the processes of the project supports the                 • Technology Effectiveness;
 following:                                                                • Customer Satisfaction.
      • Objective planning and estimating;                               The information about project performance is
      • Tracking         actual     performance     against           collected in cycles. The typical data collection cycle is
           established plans and objectives;                          four weeks. Based on achieved results, product supplier
      • Identifying and resolving process-related                     (software development project) performs analysis and
           issues;                                                    defines operation excellence action plan within two
      • Providing         a   basis     for  incorporating            weeks time frame. When actions are established, the
           measurement into additional processes in the               measurement results and operational excellence action
           future.                                                    plans are ready for presentation on Operating Steering
    The initial focus for measurement activities is at the            Group (OSG) for the project. Results form the all
 project level. However, a measurement capability may                 projects and OSG meetings are input for R&D Center
 prove useful for addressing organization wide                        Steering Group meeting, organized each quarter [5].
 information needs. Projects may choose to store                         The data collection process is shown on Fig. 3.
 project-specific data and results in a project-specific
 repository. When data are shared more widely across                  Start of                                                                                       End of
 projects, the data may reside in the organization’s                  Quarter
                                                                                    4 weeks               2 weeks                 4 weeks                  2 weeks
                                                                                                                                                                     Quarter
 measurement repository.                                                                                 Supplier                                           R&D
                                                                         KPI Data Collection

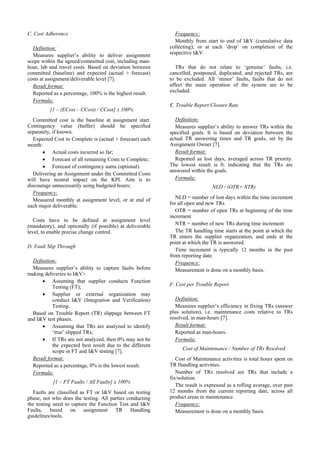

    The Measurement and Analysis contexts according to                         Cycle
                                                                                                        OE Action           Supplier OSG’s                 Supplier
                                                                                                        Planning                                             SG
 CMMI model is shown on Fig. 2.
                                                                                           Supplier Scorecards    OE Actions                   Supplier OSG’s   R&D Supplier
                                                                                               Produced           Established                    completed       SG meeting
                                                                                                                                                                  completed

               Align Measurement Analysis Activities                             Define / Refine Baseline
                                      Specify
                                       Data                                                       Collect Data
  Establish                                               Specify
                    Specify          Collection
 Measurement                                             Analysis                                            Cut-Off Date       Data Collection End Date
                   Measures         and Storage
  Objectives                                            Procedures
                                    Procedures

                                                                                                          Validate Data                    Create Scorecards
                                                                           12 month data window

Measurement Objectives             Measurement
                                    Repository          Procedures,
                                                           Tools
     Measurement Indicators
                                                                                        Fig. 3. Overview of data collection process
Provide Measurement Results

 Communicate
                     Store
                    Data &
                                     Analyze
                                   Measurement
                                                         Collect         The measurement of project performance gives
                                                       Measurement
   Results          Results           Data                Data        organization increased opportunities to improve and
                                                                      share good practices, and to increase the possibility to
                                                                      reach wanted operational efficiency. The measurement
                                                                      activities responsibility is on the corporate R&D level.
            Fig. 2. Measurement and Analysis Context                  This responsibility covers forum, processes, tools,
                                                                      definitions of metrics, collections, analyzing and
                                                                      reporting on corporate level.
V. KPI Definitions for CPP Development Projects                                  B. Assignment Content Adherence

  In order to follow performance of CPP software                                       Definition:
development projects, we have defined set of KPIs.                                     Measures supplier’s ability to deliver full assignment
Some of KPIs are applicable for early project                                        scope by end of assignment. It is based on percentage of
development phases, some of them for complete life                                   completed functionality/requirements [7].
cycle, and some of them only for product maintenance.                                  Result format:
  The set of KPIs, their behavior and applicability are                                Reported as a percentage, 100% is the highest result.
shown on Fig. 4 [6].
                                                                                       Formula:
  For each KPI we have defined:
       • Description;                                                                       (No. of Compl. Req. / No. of Commit. Req.) x 100
       • Results format;
                                                                                       Requirements are smallest measurable ‘packages’ of
       • Formula;                                                                    functionality; e.g. features, documents, items in
       • Frequency.                                                                  Statement of Compliance, Requirement Specification,
                                                                                     Requirement Management Tool, or Implementation

A. Schedule Adherence                                                                Proposal.
                                                                                        Number of Completed Requirements counts packages
   Definition:                                                                       of functionality delivered during the entire assignment.
   Measures timeliness and ‘quality’ of deliveries                                      Total Number of Committed Requirements counts the
relative to baseline schedule and acceptance criteria.                               packages of functionality originally planned for the
Based on percentage deviation between planned and                                    assignment; may be revised based on Change Request
actual lead times [7].                                                               guidelines.
   Result format:                                                                       Frequency:
   Reported as a percentage, 100% is the highest result.                                Measured and reported at the end of an assignment.
   Formula:
              [1 – ABS (ALT – PLT) / PLT] x 100                                         KPI measurement has to be based on requirements
                                                                                     that are the smallest objects of measurement and easily
  PLT = Planned Start Date – Planned Finish Date                                     measurable. For example, content adherence for an
  ALT = Actual Finish Date – Planned Start Date                                      assignment with 2 major deliveries should not be based
  If no planned start date is specified for intermediate or                          at the ‘delivery level’ but rather based at the core
parallel deliverables, the earliest planned start date (e.g.                         functionalities/requirements within each delivery.
TG2 or assignment start date) may be used.                                           Assignments where scope is not frozen at TG2 (Project
                                                                                     GO decision) need to handle scope additions through the
  Planned Start/Finish Dates are replaced with revised                               CR handling guidelines.
dates in case of Ericsson caused/mandated CRs.

                                                                                                                   Assignment Phase
    Performance                                                                                                                  Design
                KPIs                           Desired Behaviour                                   Pre-TG2 and Development      Follow-up    Maintenance
    Metric
                                                                                                       RXI      (TG2-PRA)     (Maintenance    (Post GA)
                                                                                                                               PRA to GA)
                                                 Delivery to Commitment
                      Schedule
    Time                                         Accurate Estimating
                      Adherence
                                                 Avoid Delaying Scope Until Later Assignments
                      Overall Assignment         Delivery to Commitment
    Content
                      Content Adherence          Delivery of Full Scope
                                                 Delivery to Commitment
    Cost              Cost Adherence             Accurate Estimating
                                                 Avoidance of Buffers
                      Fault Slip Through         Quality of Supplier Deliverables to Ericsson
    Quality
                      (FST)                      Delivery of fault free deliverables to Ericsson

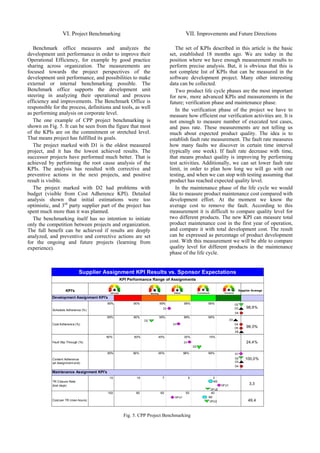

    Service Levels TR Closure Rate               TR response to Commitment

                                                 Efficiency in resolving quality issues
    Cost of Quality Cost per TR (CTR)
                                                 Reduction in cost of poor quality

     Key:       KPI Applicable to Assignment          KPI N/A to Assignment               May be applicable (decided case by case)

                                                    Fig. 4. KPI Definitions for CPP projects
C. Cost Adherence                                             Frequency:
                                                              Monthly from start to end of I&V (cumulative data
  Definition:                                              collecting); or at each ‘drop’ on completion of the
  Measures supplier’s ability to deliver assignment        respective I&V.
scope within the agreed/committed cost, including man-
hour, lab and travel costs. Based on deviation between        TRs that do not relate to ‘genuine’ faults,        i.e.
committed (baseline) and expected (actual + forecast)      cancelled, postponed, duplicated, and rejected TRs,   are
costs at assignment/deliverable level [7].                 to be excluded. All ‘minor’ faults, faults that do    not
  Result format:                                           affect the main operation of the system are to         be
  Reported as a percentage, 100% is the highest result.    excluded.
  Formula:
                                                           E. Trouble Report Closure Rate
          [1 – (ECost – CCost) / CCost] x 100%
   Committed cost is the baseline at assignment start.       Definition:
Contingency value (buffer) should be specified               Measures supplier’s ability to answer TRs within the
separately, if known.                                      specified goals. It is based on deviation between the
   Expected Cost to Complete is (actual + forecast) each   actual TR answering times and TR goals, set by the
month:                                                     Assignment Owner [7].
       • Actual costs incurred so far;                       Result format:
       • Forecast of all remaining Costs to Complete;        Reported as lost days, averaged across TR priority.
       • Forecast of contingency sums (optional).          The lowest result is 0, indicating that the TRs are
                                                           answered within the goals.
   Delivering an Assignment under the Committed Costs
will have neutral impact on the KPI. Aim is to               Formula:
discourage unnecessarily using budgeted hours;                                 NLD / (OTR+ NTR)
   Frequency:
   Measured monthly at assignment level, or at end of         NLD = number of lost days within the time increment
each major deliverable.                                    for all open and new TRs
                                                              OTR = number of open TRs at beginning of the time
                                                           increment
   Costs have to be defined at assignment level
(mandatory), and optionally (if possible) at deliverable      NTR = number of new TRs during time increment
level, to enable precise change control.                      The TR handling time starts at the point at which the
                                                           TR enters the supplier organization, and ends at the
                                                           point at which the TR is answered.
D. Fault Slip Through
                                                              Time increment is typically 12 months in the past
                                                           from reporting date.
  Definition:                                                 Frequency:
  Measures supplier’s ability to capture faults before        Measurement is done on a monthly basis.
making deliveries to I&V>
      • Assuming that supplier conducts Function
           Testing (FT);                                   F. Cost per Trouble Report
      • Supplier or external organization may
           conduct I&V (Integration and Verification)         Definition:
           Testing.                                           Measures supplier’s efficiency in fixing TRs (answer
  Based on Trouble Report (TR) slippage between FT         plus solution), i.e. maintenance costs relative to TRs
and I&V test phases.                                       resolved, in man-hours [7].
      • Assuming that TRs are analyzed to identify            Result format:
           ‘true’ slipped TRs;                                Reported as man-hours.
      • If TRs are not analyzed, then 0% may not be           Formula:
           the expected best result due to the different
           scope in FT and I&V testing [7].                      Cost of Maintenance / Number of TRs Resolved
  Result format:                                              Cost of Maintenance activities is total hours spent on
  Reported as a percentage, 0% is the lowest result.       TR Handling activities.
  Formula:                                                    Number of TRs resolved are TRs that include a
                                                           fix/solution.
           [1 – FT Faults / All Faults] x 100%
                                                              The result is expressed as a rolling average, over past
   Faults are classified as FT or I&V based on testing     12 months from the current reporting date, across all
phase, not who does the testing. All parties conducting    product areas in maintenance.
the testing need to capture the Function Test and I&V         Frequency:
Faults, based on assignment TR Handling                       Measurement is done on a monthly basis.
guidelines/tools.
VI. Project Benchmarking                                        VII. Improvements and Future Directions

   Benchmark office measures and analyzes the                               The set of KPIs described in this article is the basic
development unit performance in order to improve their                   set, established 18 months ago. We are today in the
Operational Efficiency, for example by good practice                     position where we have enough measurement results to
sharing across organization. The measurements are                        perform precise analysis. But, it is obvious that this is
focused towards the project perspectives of the                          not complete list of KPIs that can be measured in the
development unit performance, and possibilities to make                  software development project. Many other interesting
external or internal benchmarking possible. The                          data can be collected.
Benchmark office supports the development unit                              Two product life cycle phases are the most important
steering in analyzing their operational and process                      for new, more advanced KPIs and measurements in the
efficiency and improvements. The Benchmark Office is                     future; verification phase and maintenance phase.
responsible for the process, definitions and tools, as well                 In the verification phase of the project we have to
as performing analysis on corporate level.                               measure how efficient our verification activities are. It is
   The one example of CPP project benchmarking is                        not enough to measure number of executed test cases,
shown on Fig. 5. It can be seen from the figure that most                and pass rate. These measurements are not telling us
of the KPIs are on the commitment or stretched level.                    much about expected product quality. The idea is to
That means project has fulfilled its goals.                              establish fault rate measurement. The fault rate measures
   The project marked with D1 is the oldest measured                     how many faults we discover in certain time interval
project, and it has the lowest achieved results. The                     (typically one week). If fault rate decrease with time,
successor projects have performed much better. That is                   that means product quality is improving by performing
achieved by performing the root cause analysis of the                    test activities. Additionally, we can set lower fault rate
KPIs. The analysis has resulted with corrective and                      limit, in order to plan how long we will go with our
preventive actions in the next projects, and positive                    testing, and when we can stop with testing assuming that
result is visible.                                                       product has reached expected quality level.
   The project marked with D2 had problems with                             In the maintenance phase of the life cycle we would
budget (visible from Cost Adherence KPI). Detailed                       like to measure product maintenance cost compared with
analysis shown that initial estimations were too                         development effort. At the moment we know the
optimistic, and 3rd party supplier part of the project has               average cost to remove the fault. According to this
spent much more than it was planned.                                     measurement it is difficult to compare quality level for
   The benchmarking itself has no intention to initiate                  two different products. The new KPI can measure total
only the competition between projects and organization.                  product maintenance cost in the first year of operation,
The full benefit can be achieved if results are deeply                   and compare it with total development cost. The result
analyzed, and preventive and corrective actions are set                  can be expressed as percentage of product development
for the ongoing and future projects (learning from                       cost. With this measurement we will be able to compare
experience).                                                             quality level for different products in the maintenance
                                                                         phase of the life cycle.

                              Supplier Assignment KPI Results vs. Sponsor Expectations
                                                KPI Performance Range of Assignments

                     KPI's                                                                                           Supplier Average

           Development Assignment KPI's
                                          85%         90%         95%             98%           99%                 D2
                                                                    D1                                              D3    98,9%
            Schedule Adherence (%)
                                                                                                                    D4
                                          85%         90%         95%             98%           99%
                                                             D2                                                D3
            Cost Adherence (%)                                            D1                                        D4
                                                                                                                    D5    98,0%
                                                                                                                    D6
                                       80%             60%        45%             30%           15%
            Fault Slip Through (%)                                                D1                                      24,4%
                                                                                           D2

                                          85%         90%         95%             98%           99%                 D1
            Content Adherence                                                                                       D2   100,0%
            (at Assignment end)                                                                                     D3
                                                                                                                    D4

           Maintenance Assignment KPI's
                                           15           10          7                  5          3
            TR Closure Rate                                                                       M3
            (lost days)                                                                                 DFU1                3,3
                                                                                                 DFU2
                                          100          80          60              50            40
                                                                           DFU1                 M3
            Cost per TR (man-hours)                                                              DFU2                      49,4

                                                 Fig. 5. CPP Project Benchmarking
VIII. Conclusion                                                 References

   The measurement method and KPIs described in this       [1]   J.McGarry, “Measurement Key Concepts and
article are coming from the CPP software development             Practices,” Practical Software & System Measurements,
projects at Ericsson. We have started this process as            USA, 2003.
measurement program, and have implemented in all           [2]   ***, “Systems and Software Engineering - Measurement
development projects from the end of year 2006. The
                                                                 Process”, International Organization for Standardization,
data were collected and analyzed on monthly basis, and
                                                                 Geneva, 2002.
used as input for further improvement activities in the
development projects.                                      [3]   M.B.Chrissis, M.Konrad, S.Shrum, “Capability Maturity
   The measurement process should be an integral part            Model Integration – Guidelines for Process Integration
of the way business is conducted. Data must be provided          and Product Improvement”, Pearson Education Inc.,
early enough to allow management to take actions.                Boston, 2004.
Results must be communicated throughout the                [4]   D.Ishigaki, C.Jones, “Practical Measurement in the
organization in a timely manner. Decisions should not            Rational Unified Process”, Rational Software, USA,
wait for perfect data, but should be based on accurate           2003.
data, supported by risk management and root cause
analysis.                                                  [5]   ***, “Data Collection Process 2007 – R&D Consultancy
   Both the measurement process and the specific KPIs            Supplier Benchmark”, Internal Ericsson documentation,
should be periodically evaluated and improved.                   Stockholm, Sweden, 2007.
Measurement is an iterative process; the KPIs are          [6]   Z.Antolic, “CPP KPI Measurements 2008”, Internal
refined as information needs change and the                      Ericsson Documentation, Zagreb, Croatia, 2004.
organization implements improvement actions.               [7]   C.Braf, “KPI Definitions and Guidelines”, Internal
   In the future, we can expect more demands on                  Ericsson Documentation, Stockholm, Sweden, 2006.
software product quality, reduced project lead-time, and
reduced project budgets. The possible answer on these
demands is to always have accurate data about project
and product performance, and fast improvement
programs, preventive and corrective actions based on
analysis of key performance indicators in the project.

Jurnal an example of using key performance indicators for software development

  • 1.
    An Example ofUsing Key Performance Indicators for Software Development Process Efficiency Evaluation Ž. Antolić R&D Center Ericsson Nikola Tesla d.d. Complete Address: Krapinska 45, Zagreb, HR-10000, Croatia Phone: +385 1 365 4584 Fax: +385 1 365 4082 E-mail: zeljko.antolic@ericsson.com Abstract - This paper gives an overview of possible Key measurement across the entire life cycle of a software Performance Indicators (KPI) that can be used for project, from inception to retirement. Measurement is software process efficiency evaluation. The overview is implemented as a proactive discipline, and measurement based on currently used KPIs in software development derived information is considered to be a strategic projects on CPP platform. The most important KPIs are resource. analyzed, and their usage in the process efficiency Measurement is most important at the project level. evaluation is discussed. The outcome of the measurement is Software measurement helps the project manager do a used to initiate further process adjustments and better job. It helps to define and implement more improvements. In addition, there is possibility to perform realistic plans, to properly allocate scarce resources to benchmarking between different development projects, put those plans into place, and to accurately monitor and based on collected data easier search for best practices progress and performance against those plans. Software in the projects that can be broadly implemented. Some measurement provides the information required to make proposals and future directions in the area of process key project decisions and to take appropriate action. measurement are given. Measurement helps to relate and integrate the information derived from other project and technical management disciplines. In effect, it allows the software I. INTRODUCTION project manager to make decisions using objective information. All successful software organizations implement In this article, the overview of process measurement measurement as part of their day-to-day management in software development projects on CPP platform will and technical activities. Measurement provides the be given, and some Key Performance Indicators (KPIs) objective information they need to make informed will be discussed. Also, one example of project decisions that positively impact their business and benchmarking will be presented. At the end, some engineering performance. In successful software improvement proposals, and directions for further work organizations, measurement-derived information is will be given. treated as an important resource and is made available to decision makers throughout all levels of management. The way measurement is actually implemented and used in a software organization determines how much II. ISO/IEC 15939 Software Measurement Process value is realized in terms of business and engineering performance. Measurement is most effective when The International Standard ISO/IEC 15939 identifies implemented in support of an organization’s business the activities and tasks that are necessary to successfully and technical objectives and when integrated with the identify, define, select, apply, and improve software existing technical and management activities that define measurement within an overall project or organizational a software project. Measurement works best when it measurement structure. It also provides definitions for provides objective information related to the risks and measurement terms commonly used within the software problems that may impact a project’s defined objectives. industry [2]. The software measurement process itself is In other words, measurement works best when it is shown on Fig. 1. considered a significant, integral part of project management [1]. Measurement Requirements User Feedback Technical and Top-performing organizations design their technical Management and management processes to make use of objective Objectives and Issues Processes Analysis Results measurement data. Measurement data and associated Measurement analysis results support both short and long-term Plan Establish Plan Perform and Sustain decision making. A mature software development Commitment Measurement New Measurement organization typically uses measurement to help plan Issues Analysis Results and Performance and evaluate a proposed software project, to objectively Improvement Actions Evaluate Measures track actual performance against planned objectives, to Scope of Measurement Measurement guide software process improvement decisions and Process investments, and to help assess overall business and technical performance against market-driven Fig. 1. ISO/IEC 15939 Software Measurement Process requirements. A top-performing organization uses
  • 2.
    III. CMMI ProcessArea Measurement and Analysis IV. Data Collection Model According to Capability Maturity Model Integration All projects have specific objectives that are typically (CMMI), the purpose of Measurement and Analysis is to defined in terms of system capability, resource budgets, develop and sustain a measurement capability that is milestones, quality, and business or system performance used to support management information needs [3]. targets. Project success depends largely on how well The Measurement and Analysis process area involves these objectives are achieved. Project issues are areas of the following: concern that may impact the achievement of a project • Specifying the objectives of measurement and objective: risks, problems, and lack of information, for analysis such that they are aligned with example. identified information needs and objectives; The most information needs in one project can be • Specifying the measures, data collection and grouped into general areas, called information storage mechanisms, analysis techniques, and categories. We can identify seven information reporting and feedback mechanisms; categories, which represent key areas of concern for the project manager [4]: • Implementing the collection, storage, analysis, and reporting of the data; • Schedule and Progress; • Providing objective results that can be used in • Resources and Cost; making informed decisions, and taking • Product Size and Stability; appropriate corrective actions. • Product Quality; The integration of measurement and analysis • Process Performance; activities into the processes of the project supports the • Technology Effectiveness; following: • Customer Satisfaction. • Objective planning and estimating; The information about project performance is • Tracking actual performance against collected in cycles. The typical data collection cycle is established plans and objectives; four weeks. Based on achieved results, product supplier • Identifying and resolving process-related (software development project) performs analysis and issues; defines operation excellence action plan within two • Providing a basis for incorporating weeks time frame. When actions are established, the measurement into additional processes in the measurement results and operational excellence action future. plans are ready for presentation on Operating Steering The initial focus for measurement activities is at the Group (OSG) for the project. Results form the all project level. However, a measurement capability may projects and OSG meetings are input for R&D Center prove useful for addressing organization wide Steering Group meeting, organized each quarter [5]. information needs. Projects may choose to store The data collection process is shown on Fig. 3. project-specific data and results in a project-specific repository. When data are shared more widely across Start of End of projects, the data may reside in the organization’s Quarter 4 weeks 2 weeks 4 weeks 2 weeks Quarter measurement repository. Supplier R&D KPI Data Collection The Measurement and Analysis contexts according to Cycle OE Action Supplier OSG’s Supplier Planning SG CMMI model is shown on Fig. 2. Supplier Scorecards OE Actions Supplier OSG’s R&D Supplier Produced Established completed SG meeting completed Align Measurement Analysis Activities Define / Refine Baseline Specify Data Collect Data Establish Specify Specify Collection Measurement Analysis Cut-Off Date Data Collection End Date Measures and Storage Objectives Procedures Procedures Validate Data Create Scorecards 12 month data window Measurement Objectives Measurement Repository Procedures, Tools Measurement Indicators Fig. 3. Overview of data collection process Provide Measurement Results Communicate Store Data & Analyze Measurement Collect The measurement of project performance gives Measurement Results Results Data Data organization increased opportunities to improve and share good practices, and to increase the possibility to reach wanted operational efficiency. The measurement activities responsibility is on the corporate R&D level. Fig. 2. Measurement and Analysis Context This responsibility covers forum, processes, tools, definitions of metrics, collections, analyzing and reporting on corporate level.
  • 3.
    V. KPI Definitionsfor CPP Development Projects B. Assignment Content Adherence In order to follow performance of CPP software Definition: development projects, we have defined set of KPIs. Measures supplier’s ability to deliver full assignment Some of KPIs are applicable for early project scope by end of assignment. It is based on percentage of development phases, some of them for complete life completed functionality/requirements [7]. cycle, and some of them only for product maintenance. Result format: The set of KPIs, their behavior and applicability are Reported as a percentage, 100% is the highest result. shown on Fig. 4 [6]. Formula: For each KPI we have defined: • Description; (No. of Compl. Req. / No. of Commit. Req.) x 100 • Results format; Requirements are smallest measurable ‘packages’ of • Formula; functionality; e.g. features, documents, items in • Frequency. Statement of Compliance, Requirement Specification, Requirement Management Tool, or Implementation A. Schedule Adherence Proposal. Number of Completed Requirements counts packages Definition: of functionality delivered during the entire assignment. Measures timeliness and ‘quality’ of deliveries Total Number of Committed Requirements counts the relative to baseline schedule and acceptance criteria. packages of functionality originally planned for the Based on percentage deviation between planned and assignment; may be revised based on Change Request actual lead times [7]. guidelines. Result format: Frequency: Reported as a percentage, 100% is the highest result. Measured and reported at the end of an assignment. Formula: [1 – ABS (ALT – PLT) / PLT] x 100 KPI measurement has to be based on requirements that are the smallest objects of measurement and easily PLT = Planned Start Date – Planned Finish Date measurable. For example, content adherence for an ALT = Actual Finish Date – Planned Start Date assignment with 2 major deliveries should not be based If no planned start date is specified for intermediate or at the ‘delivery level’ but rather based at the core parallel deliverables, the earliest planned start date (e.g. functionalities/requirements within each delivery. TG2 or assignment start date) may be used. Assignments where scope is not frozen at TG2 (Project GO decision) need to handle scope additions through the Planned Start/Finish Dates are replaced with revised CR handling guidelines. dates in case of Ericsson caused/mandated CRs. Assignment Phase Performance Design KPIs Desired Behaviour Pre-TG2 and Development Follow-up Maintenance Metric RXI (TG2-PRA) (Maintenance (Post GA) PRA to GA) Delivery to Commitment Schedule Time Accurate Estimating Adherence Avoid Delaying Scope Until Later Assignments Overall Assignment Delivery to Commitment Content Content Adherence Delivery of Full Scope Delivery to Commitment Cost Cost Adherence Accurate Estimating Avoidance of Buffers Fault Slip Through Quality of Supplier Deliverables to Ericsson Quality (FST) Delivery of fault free deliverables to Ericsson Service Levels TR Closure Rate TR response to Commitment Efficiency in resolving quality issues Cost of Quality Cost per TR (CTR) Reduction in cost of poor quality Key: KPI Applicable to Assignment KPI N/A to Assignment May be applicable (decided case by case) Fig. 4. KPI Definitions for CPP projects
  • 4.
    C. Cost Adherence Frequency: Monthly from start to end of I&V (cumulative data Definition: collecting); or at each ‘drop’ on completion of the Measures supplier’s ability to deliver assignment respective I&V. scope within the agreed/committed cost, including man- hour, lab and travel costs. Based on deviation between TRs that do not relate to ‘genuine’ faults, i.e. committed (baseline) and expected (actual + forecast) cancelled, postponed, duplicated, and rejected TRs, are costs at assignment/deliverable level [7]. to be excluded. All ‘minor’ faults, faults that do not Result format: affect the main operation of the system are to be Reported as a percentage, 100% is the highest result. excluded. Formula: E. Trouble Report Closure Rate [1 – (ECost – CCost) / CCost] x 100% Committed cost is the baseline at assignment start. Definition: Contingency value (buffer) should be specified Measures supplier’s ability to answer TRs within the separately, if known. specified goals. It is based on deviation between the Expected Cost to Complete is (actual + forecast) each actual TR answering times and TR goals, set by the month: Assignment Owner [7]. • Actual costs incurred so far; Result format: • Forecast of all remaining Costs to Complete; Reported as lost days, averaged across TR priority. • Forecast of contingency sums (optional). The lowest result is 0, indicating that the TRs are answered within the goals. Delivering an Assignment under the Committed Costs will have neutral impact on the KPI. Aim is to Formula: discourage unnecessarily using budgeted hours; NLD / (OTR+ NTR) Frequency: Measured monthly at assignment level, or at end of NLD = number of lost days within the time increment each major deliverable. for all open and new TRs OTR = number of open TRs at beginning of the time increment Costs have to be defined at assignment level (mandatory), and optionally (if possible) at deliverable NTR = number of new TRs during time increment level, to enable precise change control. The TR handling time starts at the point at which the TR enters the supplier organization, and ends at the point at which the TR is answered. D. Fault Slip Through Time increment is typically 12 months in the past from reporting date. Definition: Frequency: Measures supplier’s ability to capture faults before Measurement is done on a monthly basis. making deliveries to I&V> • Assuming that supplier conducts Function Testing (FT); F. Cost per Trouble Report • Supplier or external organization may conduct I&V (Integration and Verification) Definition: Testing. Measures supplier’s efficiency in fixing TRs (answer Based on Trouble Report (TR) slippage between FT plus solution), i.e. maintenance costs relative to TRs and I&V test phases. resolved, in man-hours [7]. • Assuming that TRs are analyzed to identify Result format: ‘true’ slipped TRs; Reported as man-hours. • If TRs are not analyzed, then 0% may not be Formula: the expected best result due to the different scope in FT and I&V testing [7]. Cost of Maintenance / Number of TRs Resolved Result format: Cost of Maintenance activities is total hours spent on Reported as a percentage, 0% is the lowest result. TR Handling activities. Formula: Number of TRs resolved are TRs that include a fix/solution. [1 – FT Faults / All Faults] x 100% The result is expressed as a rolling average, over past Faults are classified as FT or I&V based on testing 12 months from the current reporting date, across all phase, not who does the testing. All parties conducting product areas in maintenance. the testing need to capture the Function Test and I&V Frequency: Faults, based on assignment TR Handling Measurement is done on a monthly basis. guidelines/tools.
  • 5.
    VI. Project Benchmarking VII. Improvements and Future Directions Benchmark office measures and analyzes the The set of KPIs described in this article is the basic development unit performance in order to improve their set, established 18 months ago. We are today in the Operational Efficiency, for example by good practice position where we have enough measurement results to sharing across organization. The measurements are perform precise analysis. But, it is obvious that this is focused towards the project perspectives of the not complete list of KPIs that can be measured in the development unit performance, and possibilities to make software development project. Many other interesting external or internal benchmarking possible. The data can be collected. Benchmark office supports the development unit Two product life cycle phases are the most important steering in analyzing their operational and process for new, more advanced KPIs and measurements in the efficiency and improvements. The Benchmark Office is future; verification phase and maintenance phase. responsible for the process, definitions and tools, as well In the verification phase of the project we have to as performing analysis on corporate level. measure how efficient our verification activities are. It is The one example of CPP project benchmarking is not enough to measure number of executed test cases, shown on Fig. 5. It can be seen from the figure that most and pass rate. These measurements are not telling us of the KPIs are on the commitment or stretched level. much about expected product quality. The idea is to That means project has fulfilled its goals. establish fault rate measurement. The fault rate measures The project marked with D1 is the oldest measured how many faults we discover in certain time interval project, and it has the lowest achieved results. The (typically one week). If fault rate decrease with time, successor projects have performed much better. That is that means product quality is improving by performing achieved by performing the root cause analysis of the test activities. Additionally, we can set lower fault rate KPIs. The analysis has resulted with corrective and limit, in order to plan how long we will go with our preventive actions in the next projects, and positive testing, and when we can stop with testing assuming that result is visible. product has reached expected quality level. The project marked with D2 had problems with In the maintenance phase of the life cycle we would budget (visible from Cost Adherence KPI). Detailed like to measure product maintenance cost compared with analysis shown that initial estimations were too development effort. At the moment we know the optimistic, and 3rd party supplier part of the project has average cost to remove the fault. According to this spent much more than it was planned. measurement it is difficult to compare quality level for The benchmarking itself has no intention to initiate two different products. The new KPI can measure total only the competition between projects and organization. product maintenance cost in the first year of operation, The full benefit can be achieved if results are deeply and compare it with total development cost. The result analyzed, and preventive and corrective actions are set can be expressed as percentage of product development for the ongoing and future projects (learning from cost. With this measurement we will be able to compare experience). quality level for different products in the maintenance phase of the life cycle. Supplier Assignment KPI Results vs. Sponsor Expectations KPI Performance Range of Assignments KPI's Supplier Average Development Assignment KPI's 85% 90% 95% 98% 99% D2 D1 D3 98,9% Schedule Adherence (%) D4 85% 90% 95% 98% 99% D2 D3 Cost Adherence (%) D1 D4 D5 98,0% D6 80% 60% 45% 30% 15% Fault Slip Through (%) D1 24,4% D2 85% 90% 95% 98% 99% D1 Content Adherence D2 100,0% (at Assignment end) D3 D4 Maintenance Assignment KPI's 15 10 7 5 3 TR Closure Rate M3 (lost days) DFU1 3,3 DFU2 100 80 60 50 40 DFU1 M3 Cost per TR (man-hours) DFU2 49,4 Fig. 5. CPP Project Benchmarking
  • 6.
    VIII. Conclusion References The measurement method and KPIs described in this [1] J.McGarry, “Measurement Key Concepts and article are coming from the CPP software development Practices,” Practical Software & System Measurements, projects at Ericsson. We have started this process as USA, 2003. measurement program, and have implemented in all [2] ***, “Systems and Software Engineering - Measurement development projects from the end of year 2006. The Process”, International Organization for Standardization, data were collected and analyzed on monthly basis, and Geneva, 2002. used as input for further improvement activities in the development projects. [3] M.B.Chrissis, M.Konrad, S.Shrum, “Capability Maturity The measurement process should be an integral part Model Integration – Guidelines for Process Integration of the way business is conducted. Data must be provided and Product Improvement”, Pearson Education Inc., early enough to allow management to take actions. Boston, 2004. Results must be communicated throughout the [4] D.Ishigaki, C.Jones, “Practical Measurement in the organization in a timely manner. Decisions should not Rational Unified Process”, Rational Software, USA, wait for perfect data, but should be based on accurate 2003. data, supported by risk management and root cause analysis. [5] ***, “Data Collection Process 2007 – R&D Consultancy Both the measurement process and the specific KPIs Supplier Benchmark”, Internal Ericsson documentation, should be periodically evaluated and improved. Stockholm, Sweden, 2007. Measurement is an iterative process; the KPIs are [6] Z.Antolic, “CPP KPI Measurements 2008”, Internal refined as information needs change and the Ericsson Documentation, Zagreb, Croatia, 2004. organization implements improvement actions. [7] C.Braf, “KPI Definitions and Guidelines”, Internal In the future, we can expect more demands on Ericsson Documentation, Stockholm, Sweden, 2006. software product quality, reduced project lead-time, and reduced project budgets. The possible answer on these demands is to always have accurate data about project and product performance, and fast improvement programs, preventive and corrective actions based on analysis of key performance indicators in the project.
