SlideShare a Scribd company logo
1 of 28
Project Audit Guideline
Project Audit Guideline
INTRODUCTION
There comes a time as a project manager that
you will need to conduct a project audit when
the project is not achieving the planned goals
and objectives.
Even the best planned projects will encounter
problems along the way. These hurdles
however, do not mean that your project is
doomed to failure. The key is to identify these
challenges early and take the appropriate steps
to get your project back on track.
A project audit can be conducted when you
have just taken over a project from a project
manager or during a project that is underway
and you need to have an understanding of why
the project is running into trouble.

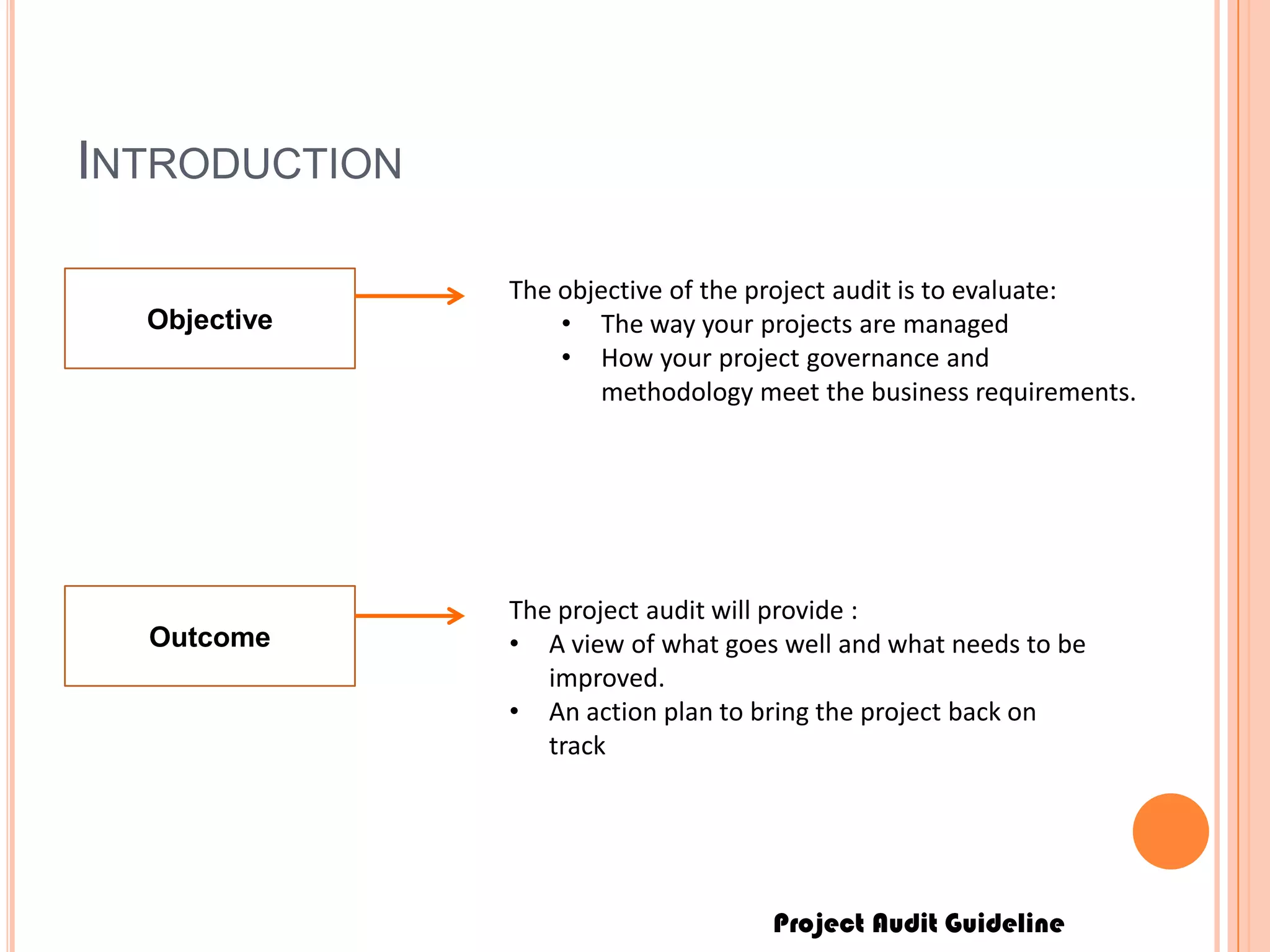

Project Audit Guideline
INTRODUCTION
Objective
The objective of the project audit is to evaluate:
• The way your projects are managed
• How your project governance and
methodology meet the business requirements.
Outcome
The project audit will provide :
• A view of what goes well and what needs to be
improved.
• An action plan to bring the project back on
track
Project Audit Guideline

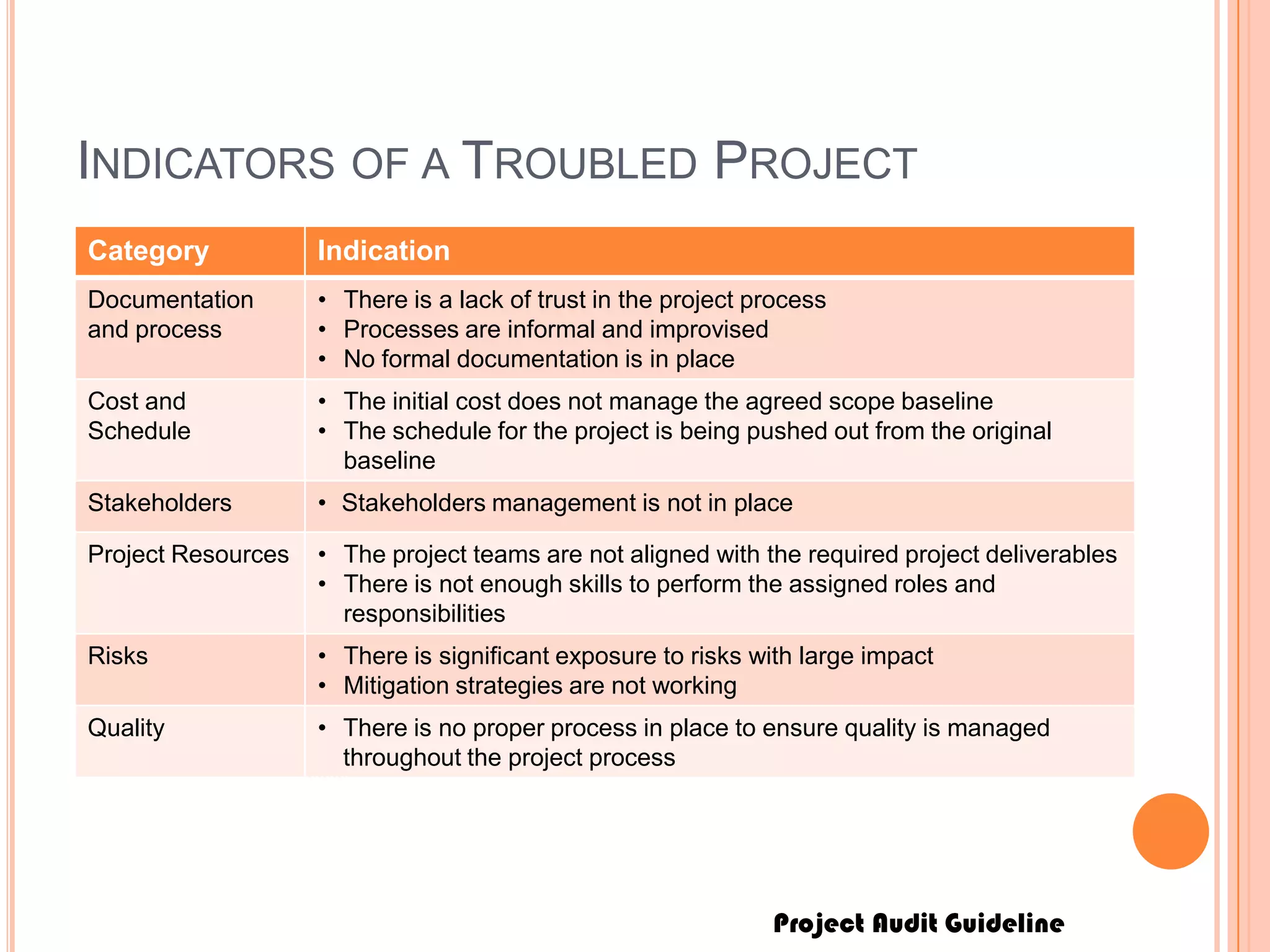

INDICATORS OF A TROUBLED PROJECT
Category Indication
Documentation
and process
• There is a lack of trust in the project process
• Processes are informal and improvised
• No formal documentation is in place
Cost and
Schedule
• The initial cost does not manage the agreed scope baseline
• The schedule for the project is being pushed out from the original
baseline
Stakeholders • Stakeholders management is not in place
Project Resources • The project teams are not aligned with the required project deliverables
• There is not enough skills to perform the assigned roles and
responsibilities
Risks • There is significant exposure to risks with large impact
• Mitigation strategies are not working
Quality • There is no proper process in place to ensure quality is managed
throughout the project process
Project Audit Guideline

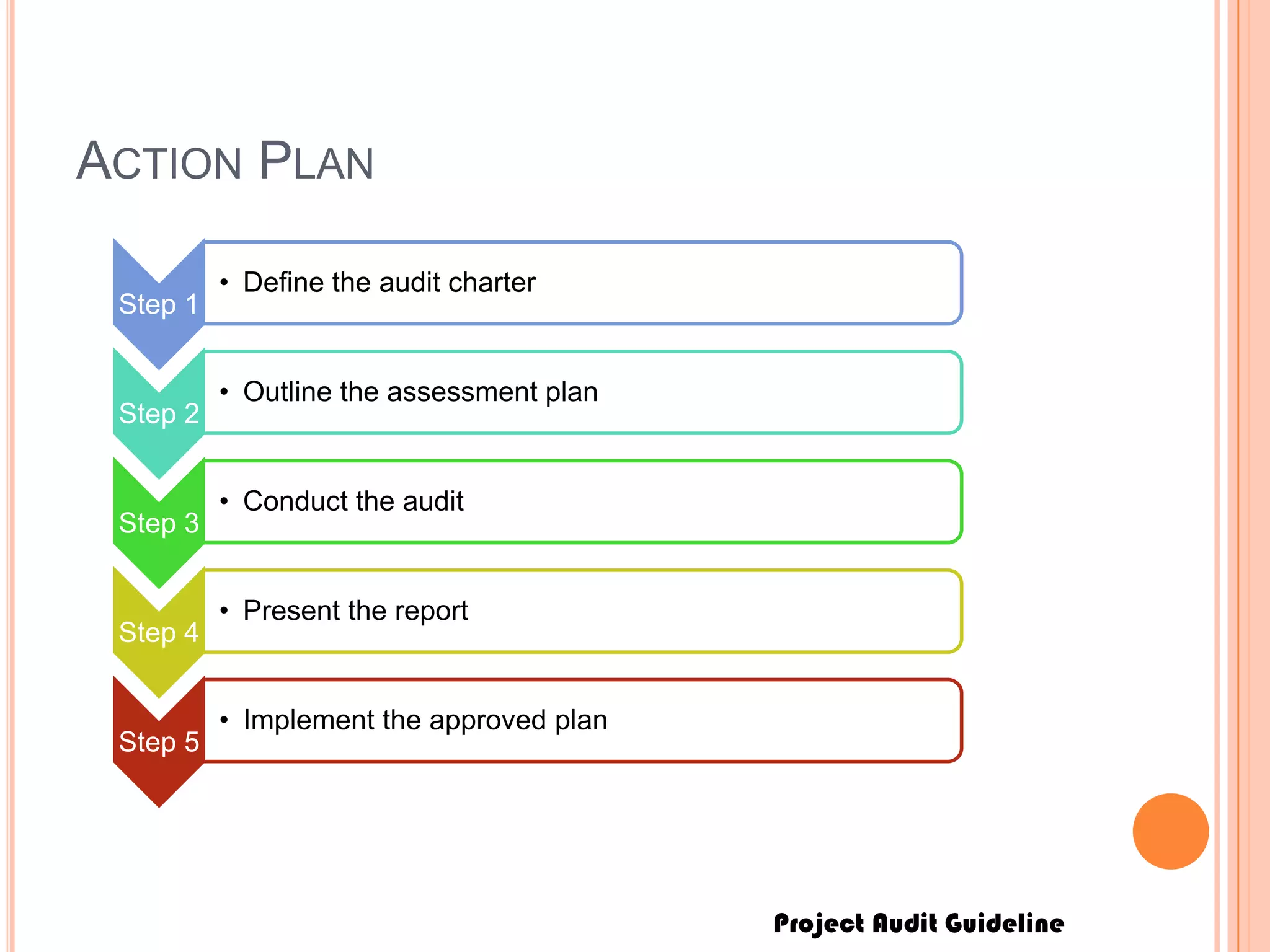

ACTION PLAN
Step 1
• Define the audit charter
Step 2
• Outline the assessment plan
Step 3
• Conduct the audit
Step 4
• Present the report
Step 5
• Implement the approved plan
Project Audit Guideline

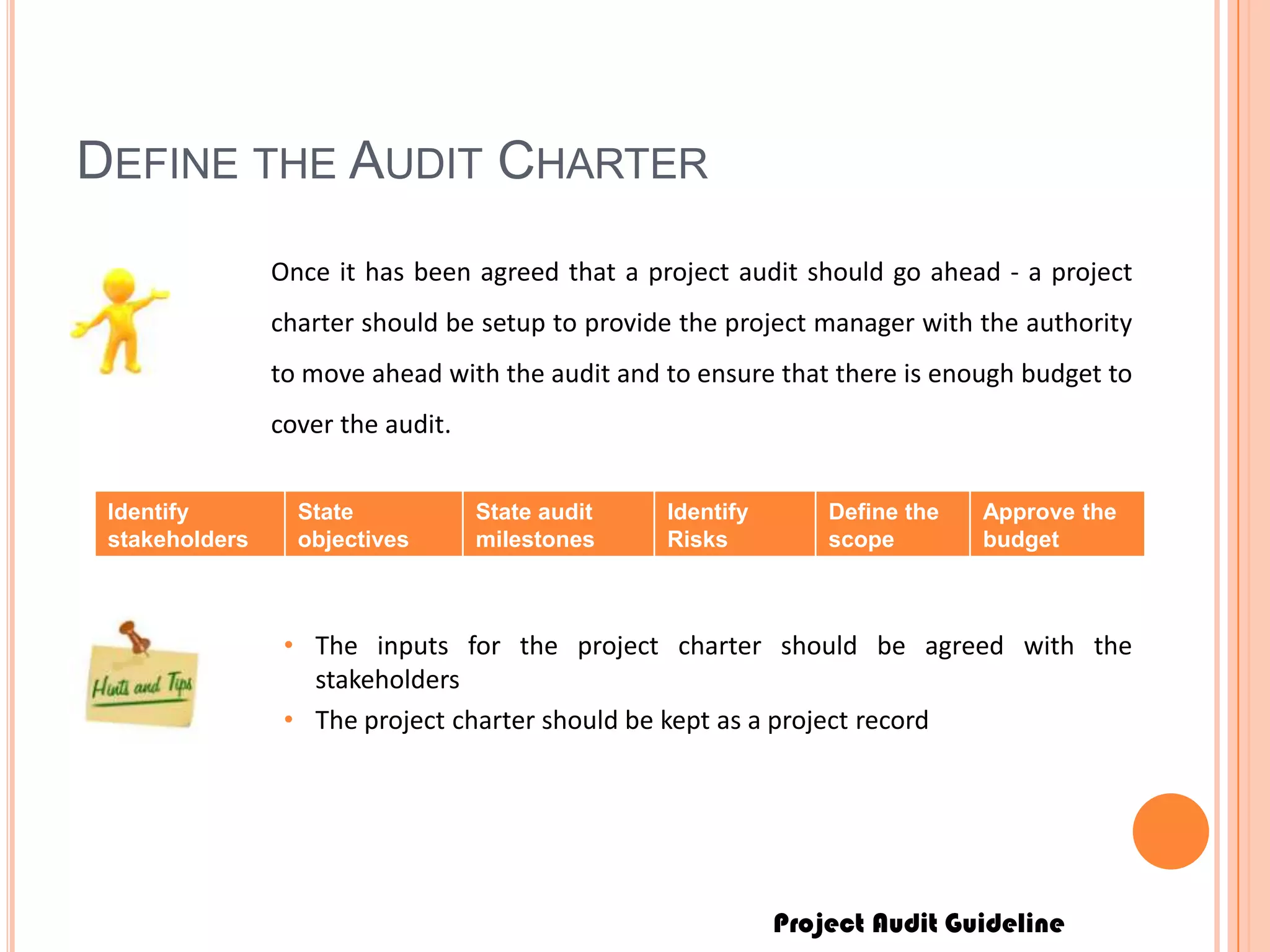

DEFINE THE AUDIT CHARTER
Once it has been agreed that a project audit should go ahead - a project
charter should be setup to provide the project manager with the authority
to move ahead with the audit and to ensure that there is enough budget to
cover the audit.
Identify
stakeholders
State
objectives
State audit
milestones
Identify
Risks
Define the
scope
Approve the
budget
• The inputs for the project charter should be agreed with the
stakeholders
• The project charter should be kept as a project record
Project Audit Guideline
OUTLINE THE AUDIT PLAN
The plan should very clearly outline what tasks/activities will need to be
carried out to perform the audit. Once the tasks have been agreed the
allocation of the teams and costs can be aligned to allow the project plan
to be approved by the stakeholders
Finalise the
tasks
Finalise the
timeline
Assign the
team
Confirm the
costs
Review the
plan
Finalise the
plan
• During the course of the audit there will be updates to the project
plan.
• Each plan should be re-baselined against the first baseline to manage
and track all of the changes
Project Audit Guideline

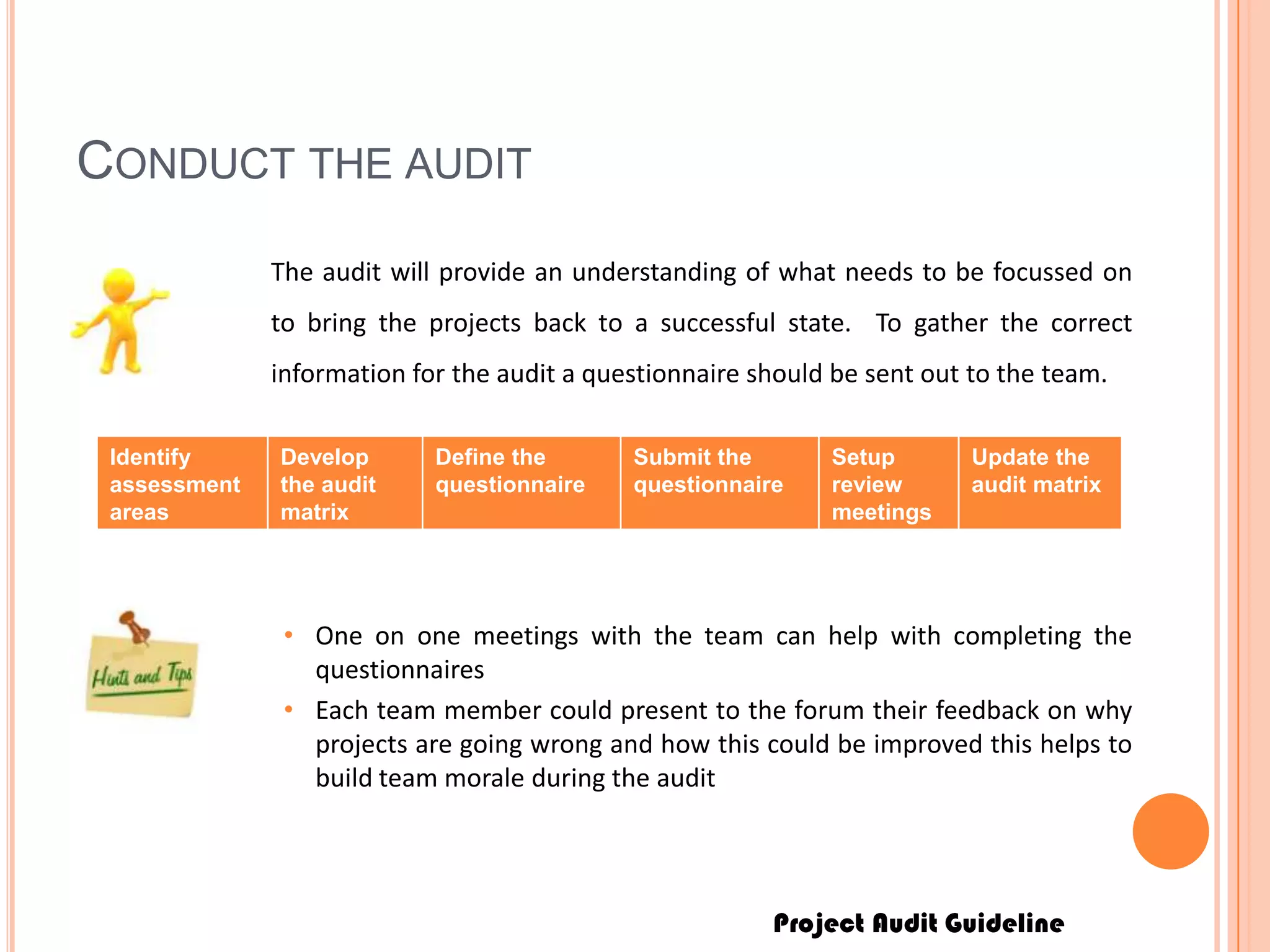

CONDUCT THE AUDIT
The audit will provide an understanding of what needs to be focussed on
to bring the projects back to a successful state. To gather the correct
information for the audit a questionnaire should be sent out to the team.
Identify
assessment
areas
Develop
the audit
matrix
Define the
questionnaire
Submit the
questionnaire
Setup
review
meetings
Update the
audit matrix
• One on one meetings with the team can help with completing the
questionnaires
• Each team member could present to the forum their feedback on why
projects are going wrong and how this could be improved this helps to
build team morale during the audit
Project Audit Guideline

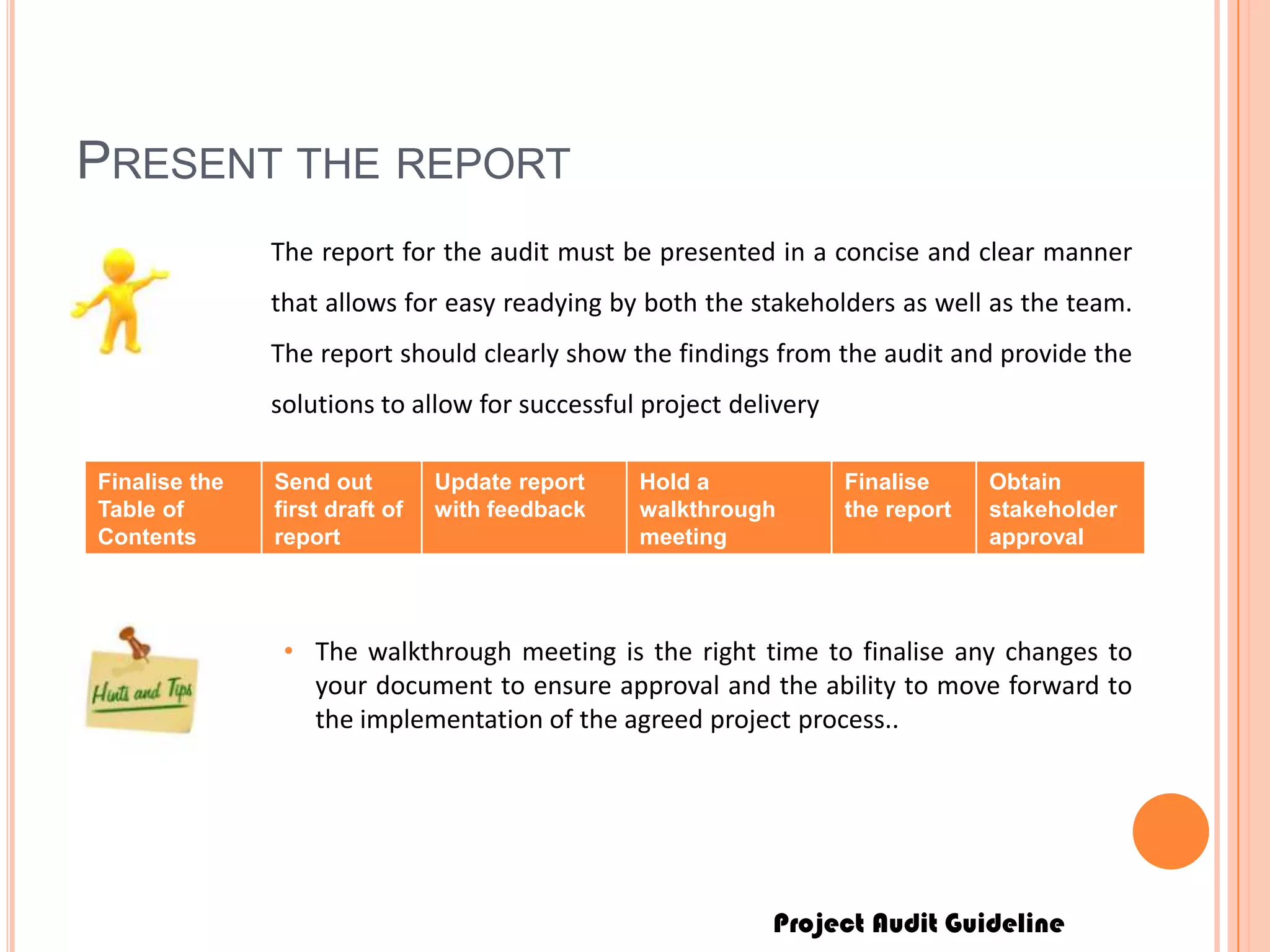

PRESENT THE REPORT
The report for the audit must be presented in a concise and clear manner
that allows for easy readying by both the stakeholders as well as the team.
The report should clearly show the findings from the audit and provide the
solutions to allow for successful project delivery
Finalise the
Table of
Contents
Send out
first draft of
report
Update report
with feedback
Hold a
walkthrough
meeting
Finalise
the report
Obtain
stakeholder
approval
• The walkthrough meeting is the right time to finalise any changes to
your document to ensure approval and the ability to move forward to
the implementation of the agreed project process..
Project Audit Guideline
IMPLEMENT THE APPROVED PLAN
The implementation of the approved plan must be conducted as a normal
project following the agreed process and governance. Training will be
required to introduce the amended process and governance
Confirm
projects to
be rolled
out
Finalise the
project
roadmap
Provide training
for the project
rollout
Monitor the
progress of
the projects
Final
review on
projects
Finalise process
and move into
project office
• It is important to get buy-in from both the stakeholders and team
during the implementation of the new process. As you rollout the
process allow the team to feedback on what they are happy with and
what needs to be changed.
PROJECT AUDIT
Planning and Implementation Guide
Project Audit Guideline

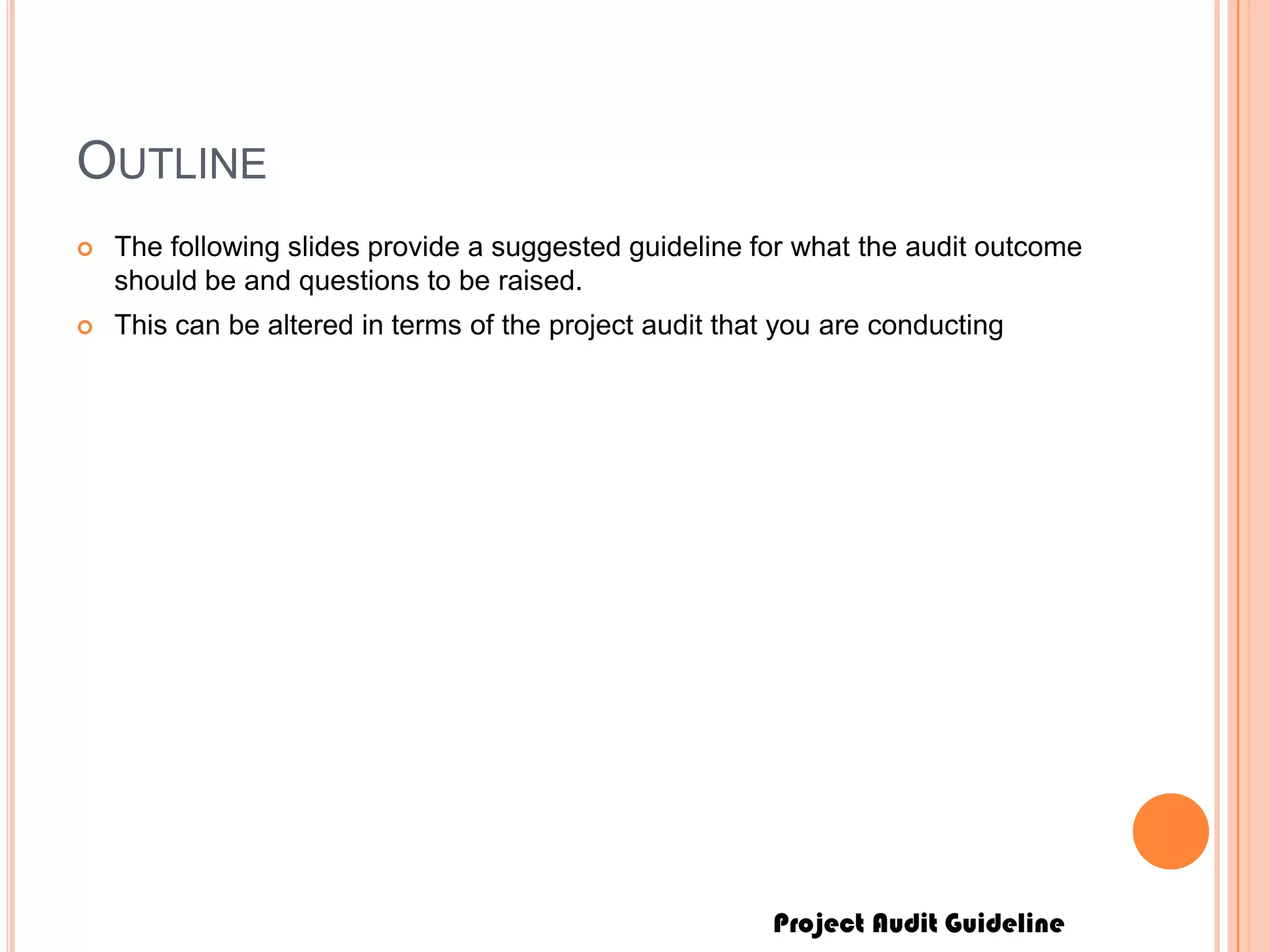

OUTLINE
 The following slides provide a suggested guideline for what the audit outcome
should be and questions to be raised.
 This can be altered in terms of the project audit that you are conducting
Project Audit Guideline

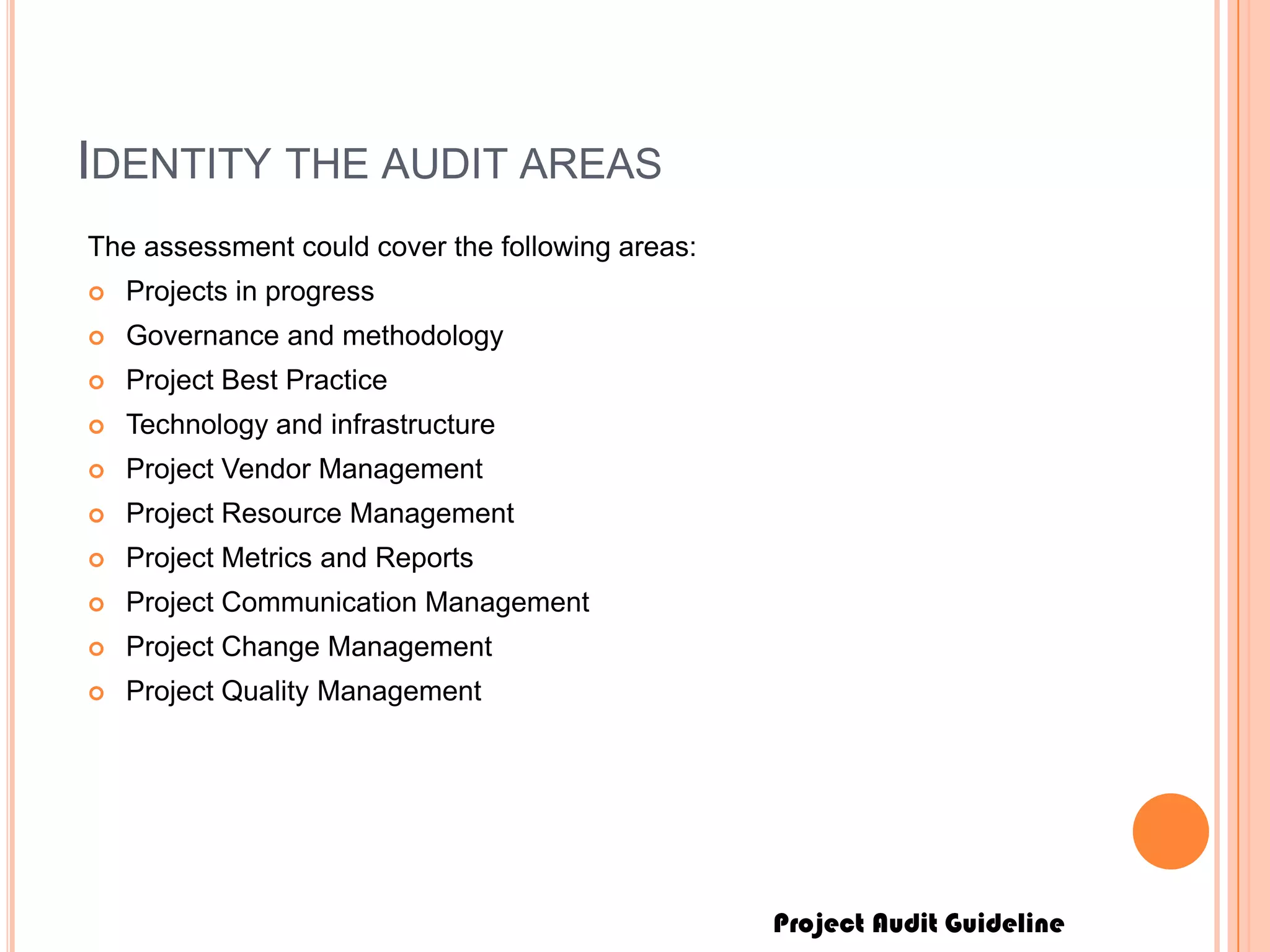

IDENTITY THE AUDIT AREAS
The assessment could cover the following areas:
 Projects in progress
 Governance and methodology
 Project Best Practice
 Technology and infrastructure
 Project Vendor Management
 Project Resource Management
 Project Metrics and Reports
 Project Communication Management
 Project Change Management
 Project Quality Management
Project Audit Guideline

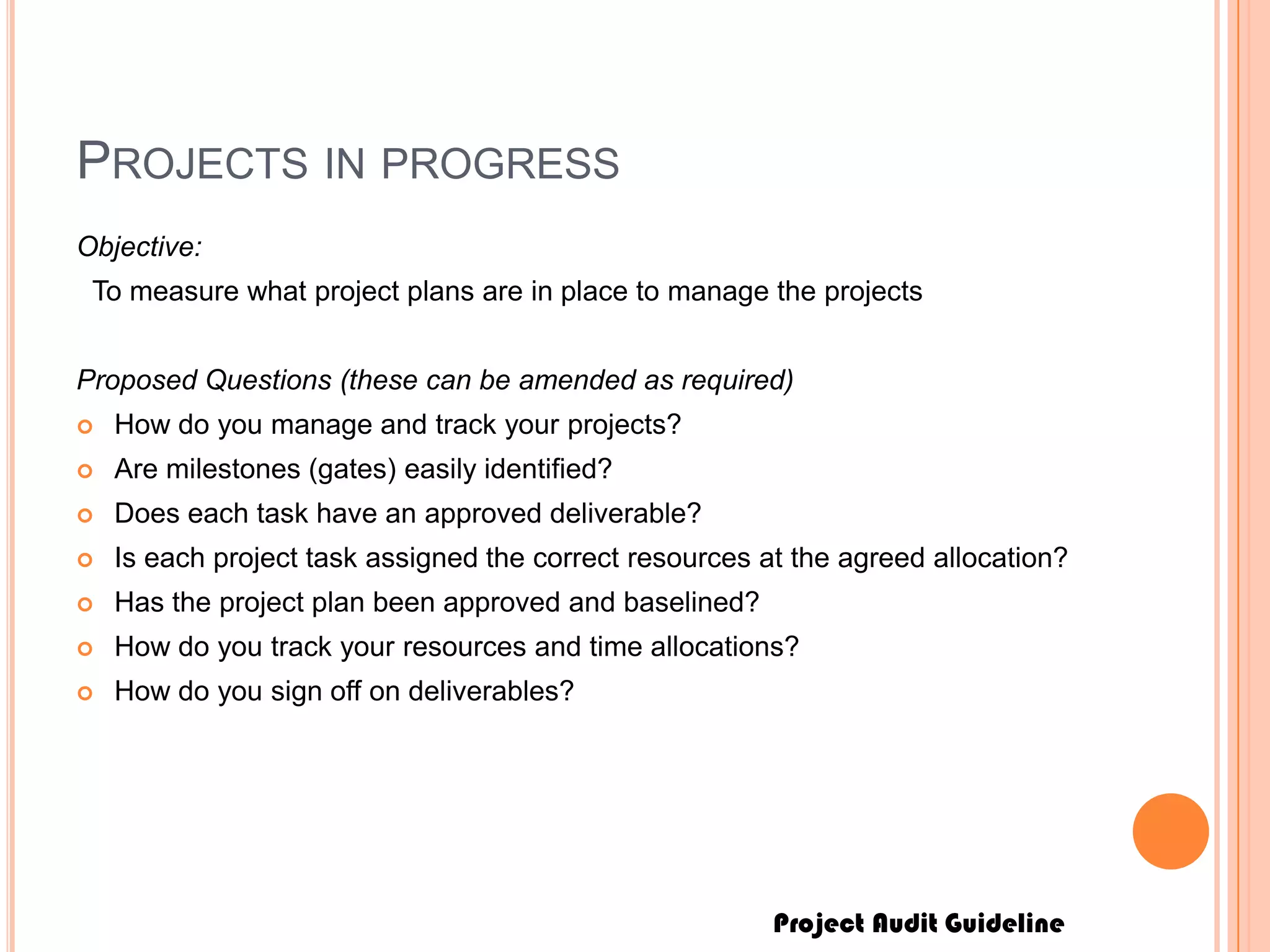

PROJECTS IN PROGRESS
Objective:
To measure what project plans are in place to manage the projects
Proposed Questions (these can be amended as required)
 How do you manage and track your projects?
 Are milestones (gates) easily identified?
 Does each task have an approved deliverable?
 Is each project task assigned the correct resources at the agreed allocation?
 Has the project plan been approved and baselined?
 How do you track your resources and time allocations?
 How do you sign off on deliverables?
Project Audit Guideline

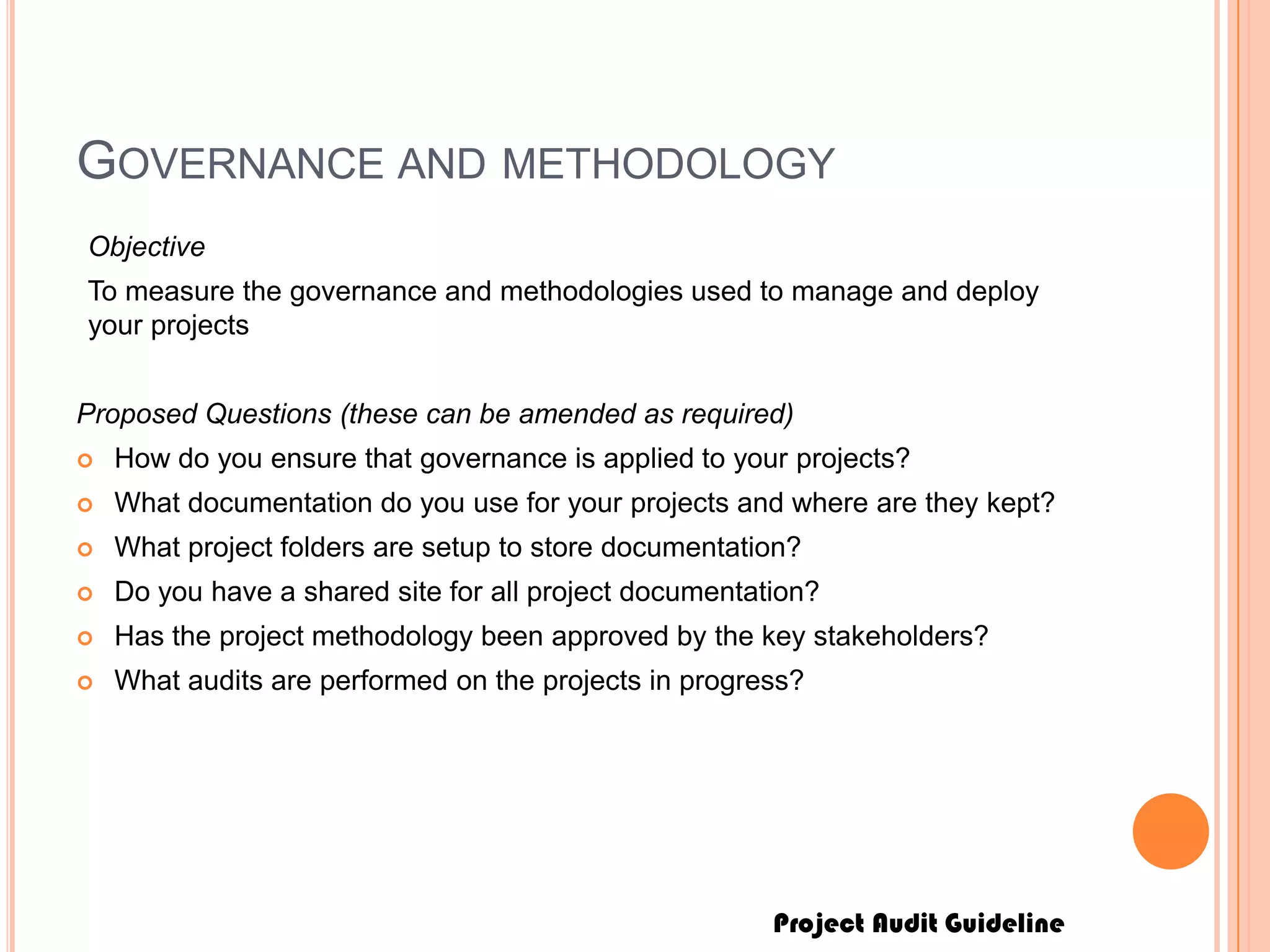

GOVERNANCE AND METHODOLOGY
Objective
To measure the governance and methodologies used to manage and deploy
your projects
Proposed Questions (these can be amended as required)
 How do you ensure that governance is applied to your projects?
 What documentation do you use for your projects and where are they kept?
 What project folders are setup to store documentation?
 Do you have a shared site for all project documentation?
 Has the project methodology been approved by the key stakeholders?
 What audits are performed on the projects in progress?
Project Audit Guideline
PROJECT BEST PRACTICE
Objective:
To measure if your company uses best practices for the project management
Proposed Questions (these can be amended as required)
 Do you apply the principles of PMBOK for your project management process?
 Do you use Prince2 in any of your processes?
 How do you align your software deliverables and what process are they
based on e.g. Waterfall, Agile, Scrum, Iterative, etc.?
 Are the processes integrated to work within your organisation?
Project Audit Guideline
TECHNOLOGY AND INFRASTRUCTURE
Objective:
To ensure that the correct technology and infrastructure is in place to manage
your project effectively
Proposed Questions (these can be amended as required)
 Does building the system in-house deliver strategic advantage to the
organization (i.e., would it give the company a competitive edge)?
 Is it a maintenance project or a new initiative that requires significant work?
 Are specific technical skills required for the project's completion? If so, do
they exist in-house?
 Does the requested product exist? If so, are well-established vendors
available?
 Could the organization experience any integration issues if a solution is
purchased?
 If customization is required, is the vendor willing to perform it?
Project Audit Guideline
VENDOR MANAGEMENT
Objective:
To measure how the contracts and service level agreements are managed for
the suppliers and vendors
Proposed Questions (these can be amended as required)
 How do you manage your relationships with your vendors?
 What process do you use for Request for Proposal?
 How do you notify vendors that they have been successful?
 What contracts are in place to manage the deliverables?
 How do you measure the deliverables from the vendors?
 What Service Level Agreements do you have in place to maintain operations
within your live environment?
 What outsourcing are you currently performing?
 How do you manage your contracted staff?
 What audits are in place to measure the performance of your suppliers and
contractors?
Project Audit Guideline
RESOURCE MANAGEMENT
Objective:
To measure the project teams and how they are aligned to project deliverables
Proposed Questions (these can be amended as required)
 Does each resource have a defined job description?
 Does the project team understand their specific role and responsibility within
the project?
 Are there the correct skills for the projects to be delivered?
 Are there enough resources on board to deliver the projects?
 Is there an organogram showing how the company structure works?
Project Audit Guideline

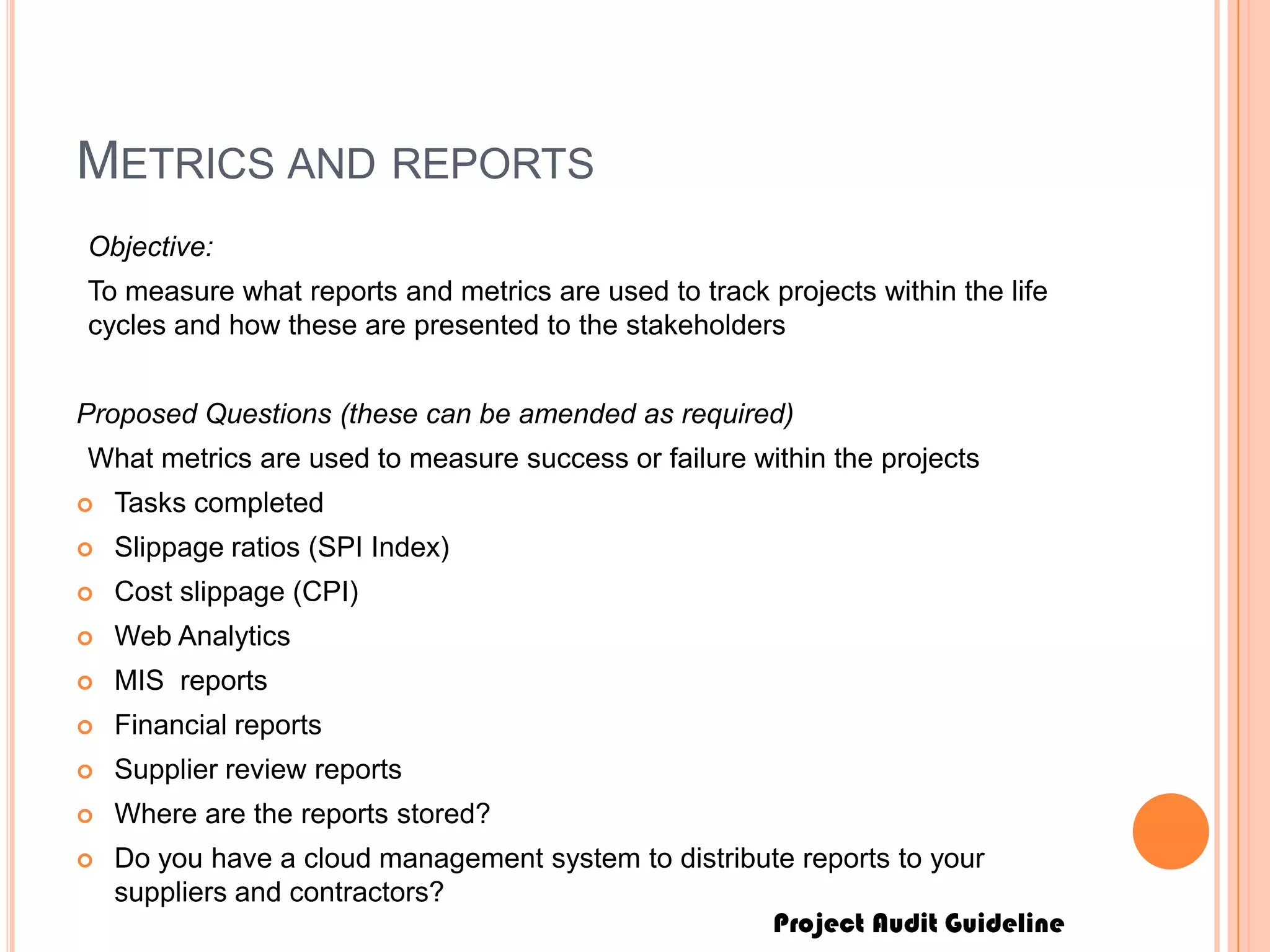

METRICS AND REPORTS
Objective:
To measure what reports and metrics are used to track projects within the life
cycles and how these are presented to the stakeholders
Proposed Questions (these can be amended as required)
What metrics are used to measure success or failure within the projects
 Tasks completed
 Slippage ratios (SPI Index)
 Cost slippage (CPI)
 Web Analytics
 MIS reports
 Financial reports
 Supplier review reports
 Where are the reports stored?
 Do you have a cloud management system to distribute reports to your
suppliers and contractors?
Project Audit Guideline

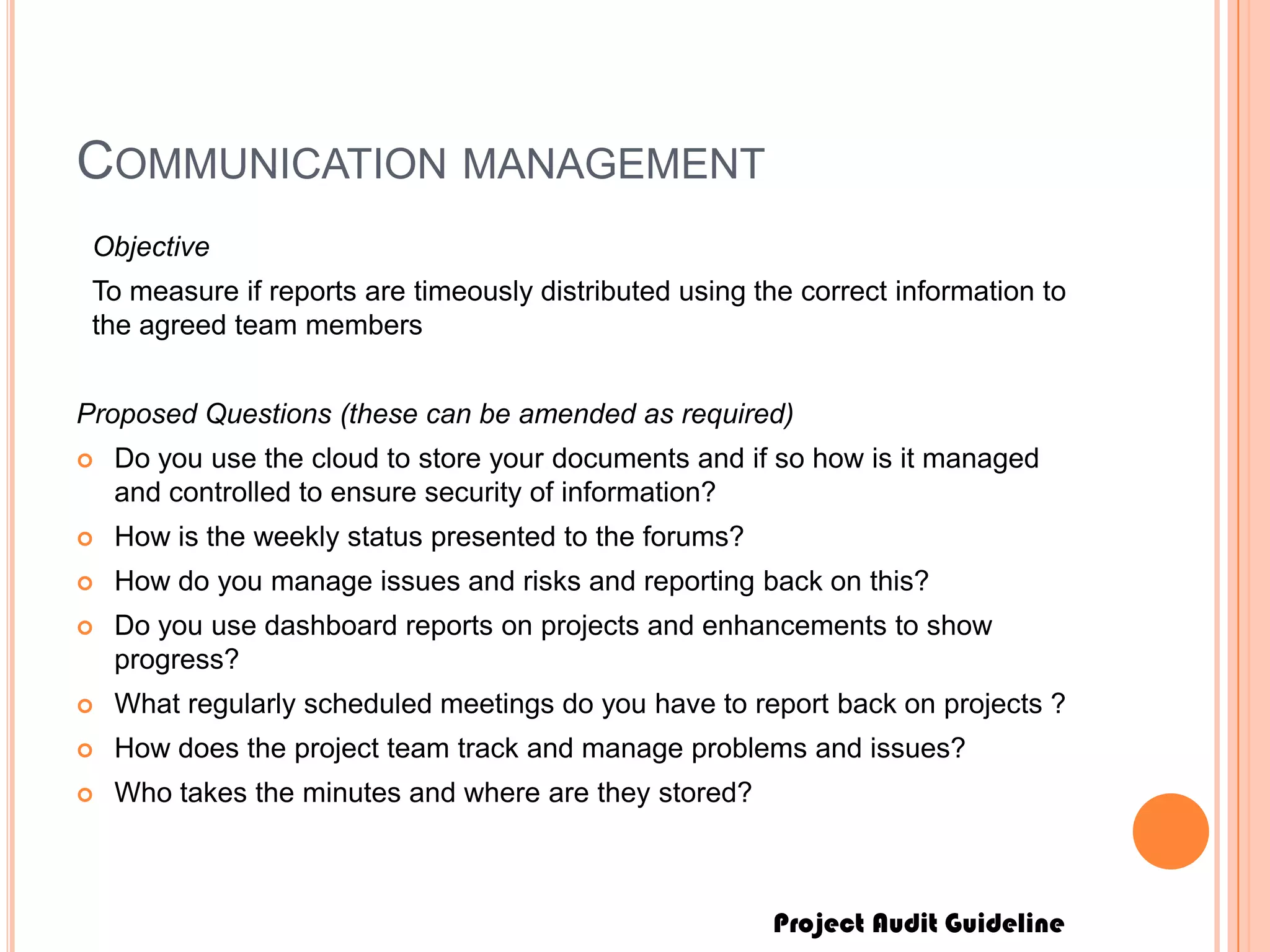

COMMUNICATION MANAGEMENT
Objective
To measure if reports are timeously distributed using the correct information to
the agreed team members
Proposed Questions (these can be amended as required)
 Do you use the cloud to store your documents and if so how is it managed
and controlled to ensure security of information?
 How is the weekly status presented to the forums?
 How do you manage issues and risks and reporting back on this?
 Do you use dashboard reports on projects and enhancements to show
progress?
 What regularly scheduled meetings do you have to report back on projects ?
 How does the project team track and manage problems and issues?
 Who takes the minutes and where are they stored?
Project Audit Guideline

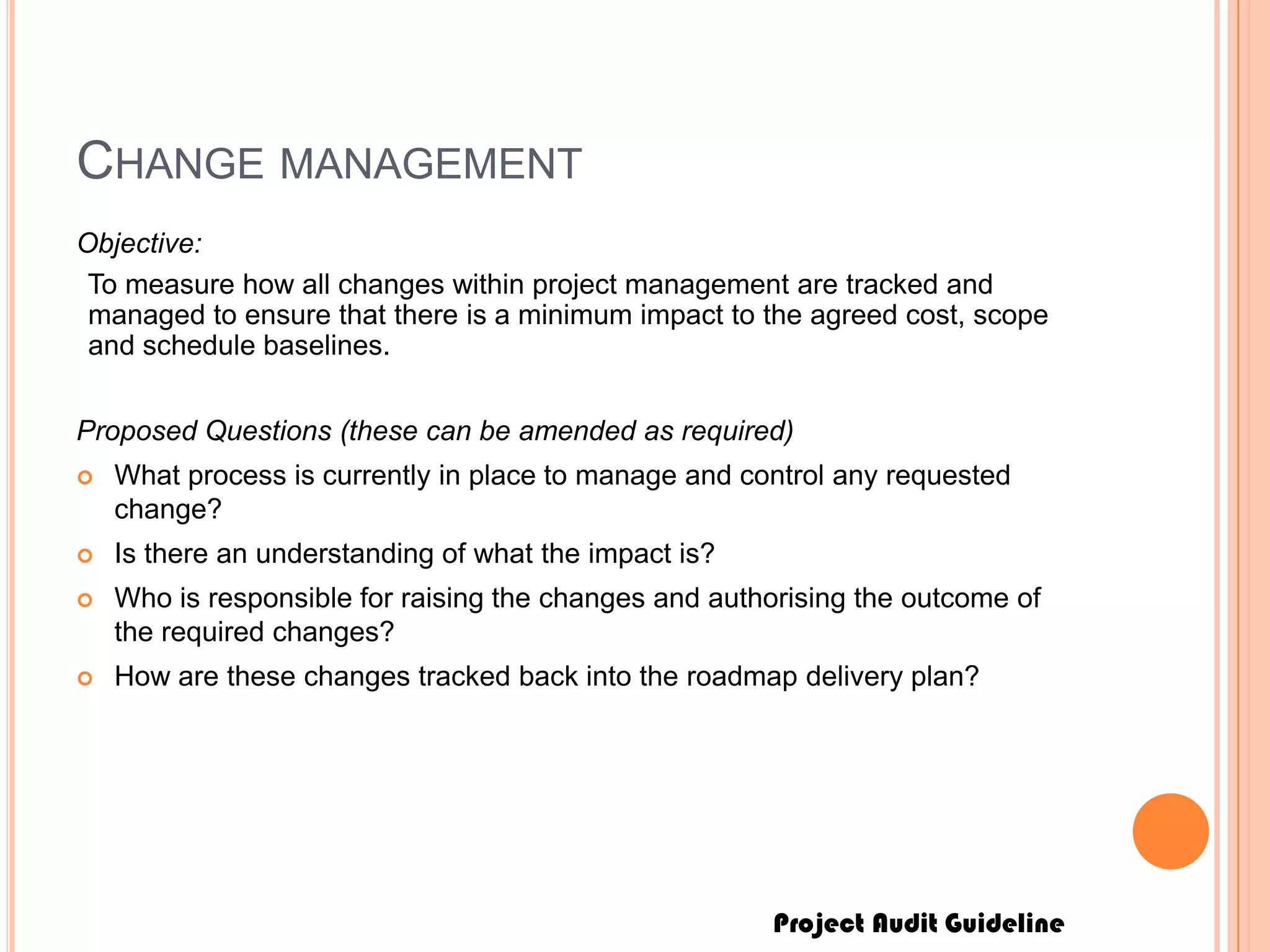

CHANGE MANAGEMENT
Objective:
To measure how all changes within project management are tracked and
managed to ensure that there is a minimum impact to the agreed cost, scope
and schedule baselines.
Proposed Questions (these can be amended as required)
 What process is currently in place to manage and control any requested
change?
 Is there an understanding of what the impact is?
 Who is responsible for raising the changes and authorising the outcome of
the required changes?
 How are these changes tracked back into the roadmap delivery plan?
Project Audit Guideline
PROJECT IMPLEMENTATION
Objective
To ensure that the quality of the product is managed controlled and meets the
correct standards before being deployed
Proposed Questions (these can be amended as required)
 What quality standards are in place for the deployment of projects into the live
environment?
 Are there project-specific instructions regarding the procedures, naming
conventions, supporting tools, equipment, standards and metrics to be
applied by the project team to achieve quality objectives at each phase of the
Project
 How is the testing controlled and tracked before deploying the product?
 Is there a roll back process in place?
Project Audit Guideline
Area Priority to correct
Projects in progress High Medium Low
Governance and Priority
Project Best Practice
Technology and Infrastructure
Project Vendor Management
Project Resource Management
Project Metrics and Reports
Project Communication Management
Project Change Management
Project Quality Management
IDENTIFY THE PRIORITY
Priority Amount
High
Medium
Low
Project Audit Guideline
PLAN THE IMPROVEMENT ROADMAP
Phase P1 P2 P3 P4 P5 P6 P7 P8 P9 P10
Projects in Progress
Governance and methodology
Project Best Practice
Technology and infrastructure
Project Vendor Management
Project Resource Management
Project Metrics and Reports
Project Communication Management
Project Change Management
Project Quality Management
Project Audit Guideline

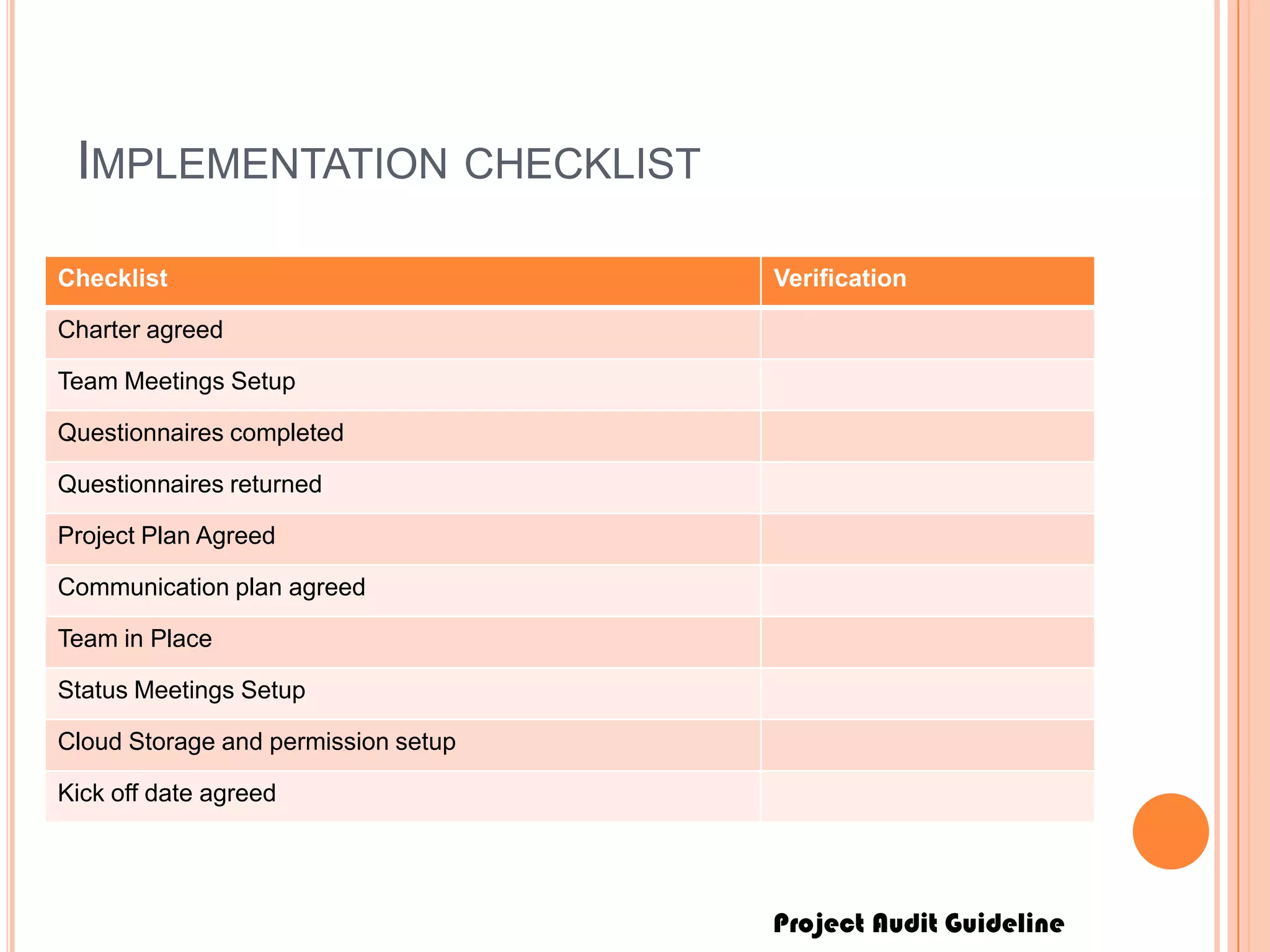

IMPLEMENTATION CHECKLIST
Checklist Verification
Charter agreed
Team Meetings Setup
Questionnaires completed
Questionnaires returned
Project Plan Agreed
Communication plan agreed
Team in Place
Status Meetings Setup
Cloud Storage and permission setup
Kick off date agreed
Project Audit Guideline
CLOSING SUMMARY
• When there is a common, simple approach for Project Management and the
correct tools are available, your project team will be empowered to reach their
goals, together and individually.
• A easy to use Project Management Methodology gives your business a
framework that makes it achievable for your product to move from vision to
action.
• It will also provide you with a competitive advantage to get your product into
the market on time within budget and meeting the quality requirements each
and every time.
Project Audit Guideline
CLOSING SUMMARY
• When there is a common, simple approach for Project Management and the correct tools
are available, your project team will be empowered to reach their goals, together and
individually.
• A easy to use Project Management Methodology gives your business a framework that
makes it achievable for your product to move from vision to action.
• It will also provide you with a competitive advantage to get your product into the market
on time within budget and meeting the quality requirements each and every time.

More Related Content

What's hot

Lecture 05:Advanced Project Management PM Processes and Framework
Lecture 05:Advanced Project Management   PM Processes and FrameworkLecture 05:Advanced Project Management   PM Processes and Framework
Lecture 05:Advanced Project Management PM Processes and FrameworkFida Karim 🇵🇰

Pmi - Project Management Professional (Pmp) Certification Study Guide
Pmi - Project Management Professional (Pmp)   Certification Study GuidePmi - Project Management Professional (Pmp)   Certification Study Guide
Pmi - Project Management Professional (Pmp) Certification Study Guiderobsonnasc

Project Management Presentation material
Project Management Presentation material Project Management Presentation material
Project Management Presentation material Abdel Rahman okasha

Quality Management Knowledge Area
Quality Management Knowledge AreaQuality Management Knowledge Area
Quality Management Knowledge AreaJoshua Render

Project Management: Integration Management Knowledge Area
Project Management: Integration Management Knowledge AreaProject Management: Integration Management Knowledge Area
Project Management: Integration Management Knowledge AreaJoshua Render

Project Management: Cost Management Knowledge Area
Project Management: Cost Management Knowledge AreaProject Management: Cost Management Knowledge Area
Project Management: Cost Management Knowledge AreaJoshua Render

Project Scope Management - PMBOK6
Project Scope Management - PMBOK6Project Scope Management - PMBOK6
Project Scope Management - PMBOK6Agus Suhanto

Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...
Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...
Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...ASPE, Inc.

Vanessa Hartsfield Gm591 Unit 4 Project Management Process Groups
Vanessa Hartsfield Gm591 Unit 4 Project Management Process GroupsVanessa Hartsfield Gm591 Unit 4 Project Management Process Groups
Vanessa Hartsfield Gm591 Unit 4 Project Management Process Groupsvanessahartsfield

Online PMP Prep Material for PMP Exam - Project management process groups
Online PMP Prep Material for PMP Exam - Project management process groupsOnline PMP Prep Material for PMP Exam - Project management process groups
Online PMP Prep Material for PMP Exam - Project management process groupsGlobalSkillup

Project Scope Management
Project Scope ManagementProject Scope Management
Project Scope ManagementAhmed Alageed

2. traditional project management -ch2
2. traditional project management -ch22. traditional project management -ch2
2. traditional project management -ch2Mazhar Poohlah

Project Scope Management Knowledge Area
Project Scope Management Knowledge AreaProject Scope Management Knowledge Area
Project Scope Management Knowledge AreaJoshua Render


What's hot (20)

Lecture 05:Advanced Project Management PM Processes and Framework
Lecture 05:Advanced Project Management   PM Processes and FrameworkLecture 05:Advanced Project Management   PM Processes and Framework
Lecture 05:Advanced Project Management PM Processes and Framework

Portfolio mostafa saad_jan_2020
Portfolio mostafa saad_jan_2020Portfolio mostafa saad_jan_2020
Portfolio mostafa saad_jan_2020

Pmi - Project Management Professional (Pmp) Certification Study Guide
Pmi - Project Management Professional (Pmp)   Certification Study GuidePmi - Project Management Professional (Pmp)   Certification Study Guide
Pmi - Project Management Professional (Pmp) Certification Study Guide

Project health check updated and improved
Project health check updated and improvedProject health check updated and improved
Project health check updated and improved

Project Management Presentation material
Project Management Presentation material Project Management Presentation material
Project Management Presentation material

Quality Management Knowledge Area
Quality Management Knowledge AreaQuality Management Knowledge Area
Quality Management Knowledge Area

Project Management: Integration Management Knowledge Area
Project Management: Integration Management Knowledge AreaProject Management: Integration Management Knowledge Area
Project Management: Integration Management Knowledge Area

Project Management: Cost Management Knowledge Area
Project Management: Cost Management Knowledge AreaProject Management: Cost Management Knowledge Area
Project Management: Cost Management Knowledge Area

Project Scope Management - PMBOK6
Project Scope Management - PMBOK6Project Scope Management - PMBOK6
Project Scope Management - PMBOK6

Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...
Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...
Understanding the Project Management Body of Knowledge (PMBOK®) Guide: Transi...

Vanessa Hartsfield Gm591 Unit 4 Project Management Process Groups
Vanessa Hartsfield Gm591 Unit 4 Project Management Process GroupsVanessa Hartsfield Gm591 Unit 4 Project Management Process Groups
Vanessa Hartsfield Gm591 Unit 4 Project Management Process Groups

Building a Milestone Plan
Building a Milestone PlanBuilding a Milestone Plan
Building a Milestone Plan

Online PMP Prep Material for PMP Exam - Project management process groups
Online PMP Prep Material for PMP Exam - Project management process groupsOnline PMP Prep Material for PMP Exam - Project management process groups
Online PMP Prep Material for PMP Exam - Project management process groups

Project Scope Management
Project Scope ManagementProject Scope Management
Project Scope Management

Project scope management
Project scope managementProject scope management
Project scope management

2. traditional project management -ch2
2. traditional project management -ch22. traditional project management -ch2
2. traditional project management -ch2

Project management
Project managementProject management
Project management

Project Scope Management Knowledge Area
Project Scope Management Knowledge AreaProject Scope Management Knowledge Area
Project Scope Management Knowledge Area

1. introduction
1. introduction1. introduction
1. introduction

PM FrameWork: Module 2
PM FrameWork: Module 2PM FrameWork: Module 2
PM FrameWork: Module 2


Similar to Is your project not going well this will help you get it back on track

ICB Competence, Project Standards
ICB Competence, Project StandardsICB Competence, Project Standards
ICB Competence, Project StandardsUjjwal Joshi

Final Class Presentation on Project Audit and Closure.ppt
Final Class Presentation on Project Audit and Closure.pptFinal Class Presentation on Project Audit and Closure.ppt
Final Class Presentation on Project Audit and Closure.pptGeorgeKabongah2

Introduction to Project Management.pdf
Introduction to Project Management.pdfIntroduction to Project Management.pdf
Introduction to Project Management.pdfGourhariBiswas1

Project Management Cycle and MS Project 2013 By Subodh Kumar PMP
Project Management Cycle and  MS Project 2013  By Subodh Kumar PMPProject Management Cycle and  MS Project 2013  By Subodh Kumar PMP
Project Management Cycle and MS Project 2013 By Subodh Kumar PMPSubodh Kumar

PMI Project Management Principles
PMI Project Management PrinciplesPMI Project Management Principles
PMI Project Management Principlestltiede

Projects2016_Franks_Top10ReasonsProjectsFail
Projects2016_Franks_Top10ReasonsProjectsFailProjects2016_Franks_Top10ReasonsProjectsFail
Projects2016_Franks_Top10ReasonsProjectsFailBarbara Franks

Projectmanagement 130721095616-phpapp01
Projectmanagement 130721095616-phpapp01Projectmanagement 130721095616-phpapp01
Projectmanagement 130721095616-phpapp01samansari22

Lec 08 project scope_management
Lec 08 project scope_managementLec 08 project scope_management
Lec 08 project scope_managementSAJID ALI RUK

Post Project Evaluation
Post Project EvaluationPost Project Evaluation
Post Project EvaluationDemand Metric

DISE - Introduction to Project Management
DISE - Introduction to Project ManagementDISE - Introduction to Project Management
DISE - Introduction to Project ManagementRasan Samarasinghe

CAPM Exam preparation - series 1
CAPM Exam preparation - series 1CAPM Exam preparation - series 1
CAPM Exam preparation - series 1Toe Myint Naing


Similar to Is your project not going well this will help you get it back on track (20)

Setting up a project framework phase 1 june 20162
Setting up a project framework phase 1 june 20162Setting up a project framework phase 1 june 20162
Setting up a project framework phase 1 june 20162

ICB Competence, Project Standards
ICB Competence, Project StandardsICB Competence, Project Standards
ICB Competence, Project Standards

Project Cost.pptx
Project Cost.pptxProject Cost.pptx
Project Cost.pptx

Final Class Presentation on Project Audit and Closure.ppt
Final Class Presentation on Project Audit and Closure.pptFinal Class Presentation on Project Audit and Closure.ppt
Final Class Presentation on Project Audit and Closure.ppt

Introduction to Project Management.pdf
Introduction to Project Management.pdfIntroduction to Project Management.pdf
Introduction to Project Management.pdf

Project Management Cycle and MS Project 2013 By Subodh Kumar PMP
Project Management Cycle and  MS Project 2013  By Subodh Kumar PMPProject Management Cycle and  MS Project 2013  By Subodh Kumar PMP
Project Management Cycle and MS Project 2013 By Subodh Kumar PMP

PMI Project Management Principles
PMI Project Management PrinciplesPMI Project Management Principles
PMI Project Management Principles

Projects2016_Franks_Top10ReasonsProjectsFail
Projects2016_Franks_Top10ReasonsProjectsFailProjects2016_Franks_Top10ReasonsProjectsFail
Projects2016_Franks_Top10ReasonsProjectsFail

6396901
63969016396901
6396901

Projectmanagement 130721095616-phpapp01
Projectmanagement 130721095616-phpapp01Projectmanagement 130721095616-phpapp01
Projectmanagement 130721095616-phpapp01

Session 22 4th edition PMP
Session 22 4th edition PMPSession 22 4th edition PMP
Session 22 4th edition PMP

The role of the project manager
The role of the project managerThe role of the project manager
The role of the project manager

Lec 08 project scope_management
Lec 08 project scope_managementLec 08 project scope_management
Lec 08 project scope_management

Project auditing
Project auditingProject auditing
Project auditing

Post Project Evaluation
Post Project EvaluationPost Project Evaluation
Post Project Evaluation

Project scheduling
Project schedulingProject scheduling
Project scheduling

DISE - Introduction to Project Management
DISE - Introduction to Project ManagementDISE - Introduction to Project Management
DISE - Introduction to Project Management

PMP PMBok 5th ch 5 scope management
PMP PMBok 5th ch 5 scope managementPMP PMBok 5th ch 5 scope management
PMP PMBok 5th ch 5 scope management

CAPM Exam preparation - series 1
CAPM Exam preparation - series 1CAPM Exam preparation - series 1
CAPM Exam preparation - series 1

SPM Unit 1.pptx
SPM Unit 1.pptxSPM Unit 1.pptx
SPM Unit 1.pptx


More from Project Management Solutions

A guide for the rolling out of a software delivery project
A guide for the rolling out of a software delivery projectA guide for the rolling out of a software delivery project
A guide for the rolling out of a software delivery projectProject Management Solutions


More from Project Management Solutions (16)

A project quick start guide
A project quick start guideA project quick start guide
A project quick start guide

Taking a web site from concept to launch
Taking a web site from concept to launchTaking a web site from concept to launch
Taking a web site from concept to launch

Managing multiple projects
Managing multiple projectsManaging multiple projects
Managing multiple projects

Turning your project around
Turning your project aroundTurning your project around
Turning your project around

A guide for the rolling out of a software delivery project
A guide for the rolling out of a software delivery projectA guide for the rolling out of a software delivery project
A guide for the rolling out of a software delivery project

The agile pmo v2
The agile pmo v2The agile pmo v2
The agile pmo v2

Business and project changing the paradigm
Business and project changing the paradigmBusiness and project changing the paradigm
Business and project changing the paradigm

Why not - Words to make you think
Why not - Words to make you thinkWhy not - Words to make you think
Why not - Words to make you think

Project management today a step ahead
Project management today   a step aheadProject management today   a step ahead
Project management today a step ahead

Managing your suppliers makes perfect sense
Managing your suppliers makes perfect senseManaging your suppliers makes perfect sense
Managing your suppliers makes perfect sense

Ready get set go your project is approved
Ready get set go your project is approvedReady get set go your project is approved
Ready get set go your project is approved

The digital project manager
The digital project managerThe digital project manager
The digital project manager

Lets get digital
Lets get digitalLets get digital
Lets get digital

Getting Ready for UAT
Getting Ready for UATGetting Ready for UAT
Getting Ready for UAT

Strategy planning for small digital companies
Strategy planning for small digital companiesStrategy planning for small digital companies
Strategy planning for small digital companies

Cliona O Hanrahan Introduction 2011
Cliona O Hanrahan Introduction 2011Cliona O Hanrahan Introduction 2011
Cliona O Hanrahan Introduction 2011


Recently uploaded

VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With RoomVIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Roomdivyansh0kumar0

Beyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why Diagram
Beyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why DiagramBeyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why Diagram
Beyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why DiagramCIToolkit

Reflecting, turning experience into insight
Reflecting, turning experience into insightReflecting, turning experience into insight
Reflecting, turning experience into insightWayne Abrahams

Simplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes ThinkingSimplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes ThinkingCIToolkit

Board Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch PresentationBoard Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch Presentationcraig524401

Fifteenth Finance Commission Presentation
Fifteenth Finance Commission PresentationFifteenth Finance Commission Presentation
Fifteenth Finance Commission Presentationmintusiprd

原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证jdkhjh

Farmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan ManchFarmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan ManchRashtriya Kisan Manch

Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)jennyeacort

Measuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield MetricsMeasuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield MetricsCIToolkit

Unlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency MatrixUnlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency MatrixCIToolkit

LPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations ReviewLPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations Reviewthomas851723

ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...AgileNetwork

LPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business SectorLPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business Sectorthomas851723

Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Nehwal

Introduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-EngineeringIntroduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-Engineeringthomas851723


Recently uploaded (17)

VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With RoomVIP Kolkata Call Girl Rajarhat 👉 8250192130  Available With Room
VIP Kolkata Call Girl Rajarhat 👉 8250192130 Available With Room

sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service
sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Servicesauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service
sauth delhi call girls in Defence Colony🔝 9953056974 🔝 escort Service

Beyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why Diagram
Beyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why DiagramBeyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why Diagram
Beyond the Five Whys: Exploring the Hierarchical Causes with the Why-Why Diagram

Reflecting, turning experience into insight
Reflecting, turning experience into insightReflecting, turning experience into insight
Reflecting, turning experience into insight

Simplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes ThinkingSimplifying Complexity: How the Four-Field Matrix Reshapes Thinking
Simplifying Complexity: How the Four-Field Matrix Reshapes Thinking

Board Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch PresentationBoard Diversity Initiaive Launch Presentation
Board Diversity Initiaive Launch Presentation

Fifteenth Finance Commission Presentation
Fifteenth Finance Commission PresentationFifteenth Finance Commission Presentation
Fifteenth Finance Commission Presentation

原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证
原版1:1复刻密西西比大学毕业证Mississippi毕业证留信学历认证

Farmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan ManchFarmer Representative Organization in Lucknow | Rashtriya Kisan Manch
Farmer Representative Organization in Lucknow | Rashtriya Kisan Manch

Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)
Call Us🔝⇛+91-97111🔝47426 Call In girls Munirka (DELHI)

Measuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield MetricsMeasuring True Process Yield using Robust Yield Metrics
Measuring True Process Yield using Robust Yield Metrics

Unlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency MatrixUnlocking Productivity and Personal Growth through the Importance-Urgency Matrix
Unlocking Productivity and Personal Growth through the Importance-Urgency Matrix

LPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations ReviewLPC Operations Review PowerPoint | Operations Review
LPC Operations Review PowerPoint | Operations Review

ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...
ANIn Gurugram April 2024 |Can Agile and AI work together? by Pramodkumar Shri...

LPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business SectorLPC Warehouse Management System For Clients In The Business Sector
LPC Warehouse Management System For Clients In The Business Sector

Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...
Pooja Mehta 9167673311, Trusted Call Girls In NAVI MUMBAI Cash On Payment , V...

Introduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-EngineeringIntroduction to LPC - Facility Design And Re-Engineering
Introduction to LPC - Facility Design And Re-Engineering


Is your project not going well this will help you get it back on track

  • 2. Project Audit Guideline INTRODUCTION There comes a time as a project manager that you will need to conduct a project audit when the project is not achieving the planned goals and objectives. Even the best planned projects will encounter problems along the way. These hurdles however, do not mean that your project is doomed to failure. The key is to identify these challenges early and take the appropriate steps to get your project back on track. A project audit can be conducted when you have just taken over a project from a project manager or during a project that is underway and you need to have an understanding of why the project is running into trouble.
  • 3. Project Audit Guideline INTRODUCTION Objective The objective of the project audit is to evaluate: • The way your projects are managed • How your project governance and methodology meet the business requirements. Outcome The project audit will provide : • A view of what goes well and what needs to be improved. • An action plan to bring the project back on track
  • 4. Project Audit Guideline INDICATORS OF A TROUBLED PROJECT Category Indication Documentation and process • There is a lack of trust in the project process • Processes are informal and improvised • No formal documentation is in place Cost and Schedule • The initial cost does not manage the agreed scope baseline • The schedule for the project is being pushed out from the original baseline Stakeholders • Stakeholders management is not in place Project Resources • The project teams are not aligned with the required project deliverables • There is not enough skills to perform the assigned roles and responsibilities Risks • There is significant exposure to risks with large impact • Mitigation strategies are not working Quality • There is no proper process in place to ensure quality is managed throughout the project process
  • 5. Project Audit Guideline ACTION PLAN Step 1 • Define the audit charter Step 2 • Outline the assessment plan Step 3 • Conduct the audit Step 4 • Present the report Step 5 • Implement the approved plan
  • 6. Project Audit Guideline DEFINE THE AUDIT CHARTER Once it has been agreed that a project audit should go ahead - a project charter should be setup to provide the project manager with the authority to move ahead with the audit and to ensure that there is enough budget to cover the audit. Identify stakeholders State objectives State audit milestones Identify Risks Define the scope Approve the budget • The inputs for the project charter should be agreed with the stakeholders • The project charter should be kept as a project record
  • 7. Project Audit Guideline OUTLINE THE AUDIT PLAN The plan should very clearly outline what tasks/activities will need to be carried out to perform the audit. Once the tasks have been agreed the allocation of the teams and costs can be aligned to allow the project plan to be approved by the stakeholders Finalise the tasks Finalise the timeline Assign the team Confirm the costs Review the plan Finalise the plan • During the course of the audit there will be updates to the project plan. • Each plan should be re-baselined against the first baseline to manage and track all of the changes
  • 8. Project Audit Guideline CONDUCT THE AUDIT The audit will provide an understanding of what needs to be focussed on to bring the projects back to a successful state. To gather the correct information for the audit a questionnaire should be sent out to the team. Identify assessment areas Develop the audit matrix Define the questionnaire Submit the questionnaire Setup review meetings Update the audit matrix • One on one meetings with the team can help with completing the questionnaires • Each team member could present to the forum their feedback on why projects are going wrong and how this could be improved this helps to build team morale during the audit
  • 9. Project Audit Guideline PRESENT THE REPORT The report for the audit must be presented in a concise and clear manner that allows for easy readying by both the stakeholders as well as the team. The report should clearly show the findings from the audit and provide the solutions to allow for successful project delivery Finalise the Table of Contents Send out first draft of report Update report with feedback Hold a walkthrough meeting Finalise the report Obtain stakeholder approval • The walkthrough meeting is the right time to finalise any changes to your document to ensure approval and the ability to move forward to the implementation of the agreed project process..
  • 10. Project Audit Guideline IMPLEMENT THE APPROVED PLAN The implementation of the approved plan must be conducted as a normal project following the agreed process and governance. Training will be required to introduce the amended process and governance Confirm projects to be rolled out Finalise the project roadmap Provide training for the project rollout Monitor the progress of the projects Final review on projects Finalise process and move into project office • It is important to get buy-in from both the stakeholders and team during the implementation of the new process. As you rollout the process allow the team to feedback on what they are happy with and what needs to be changed.
  • 11. PROJECT AUDIT Planning and Implementation Guide
  • 12. Project Audit Guideline OUTLINE  The following slides provide a suggested guideline for what the audit outcome should be and questions to be raised.  This can be altered in terms of the project audit that you are conducting
  • 13. Project Audit Guideline IDENTITY THE AUDIT AREAS The assessment could cover the following areas:  Projects in progress  Governance and methodology  Project Best Practice  Technology and infrastructure  Project Vendor Management  Project Resource Management  Project Metrics and Reports  Project Communication Management  Project Change Management  Project Quality Management
  • 14. Project Audit Guideline PROJECTS IN PROGRESS Objective: To measure what project plans are in place to manage the projects Proposed Questions (these can be amended as required)  How do you manage and track your projects?  Are milestones (gates) easily identified?  Does each task have an approved deliverable?  Is each project task assigned the correct resources at the agreed allocation?  Has the project plan been approved and baselined?  How do you track your resources and time allocations?  How do you sign off on deliverables?
  • 15. Project Audit Guideline GOVERNANCE AND METHODOLOGY Objective To measure the governance and methodologies used to manage and deploy your projects Proposed Questions (these can be amended as required)  How do you ensure that governance is applied to your projects?  What documentation do you use for your projects and where are they kept?  What project folders are setup to store documentation?  Do you have a shared site for all project documentation?  Has the project methodology been approved by the key stakeholders?  What audits are performed on the projects in progress?
  • 16. Project Audit Guideline PROJECT BEST PRACTICE Objective: To measure if your company uses best practices for the project management Proposed Questions (these can be amended as required)  Do you apply the principles of PMBOK for your project management process?  Do you use Prince2 in any of your processes?  How do you align your software deliverables and what process are they based on e.g. Waterfall, Agile, Scrum, Iterative, etc.?  Are the processes integrated to work within your organisation?
  • 17. Project Audit Guideline TECHNOLOGY AND INFRASTRUCTURE Objective: To ensure that the correct technology and infrastructure is in place to manage your project effectively Proposed Questions (these can be amended as required)  Does building the system in-house deliver strategic advantage to the organization (i.e., would it give the company a competitive edge)?  Is it a maintenance project or a new initiative that requires significant work?  Are specific technical skills required for the project's completion? If so, do they exist in-house?  Does the requested product exist? If so, are well-established vendors available?  Could the organization experience any integration issues if a solution is purchased?  If customization is required, is the vendor willing to perform it?
  • 18. Project Audit Guideline VENDOR MANAGEMENT Objective: To measure how the contracts and service level agreements are managed for the suppliers and vendors Proposed Questions (these can be amended as required)  How do you manage your relationships with your vendors?  What process do you use for Request for Proposal?  How do you notify vendors that they have been successful?  What contracts are in place to manage the deliverables?  How do you measure the deliverables from the vendors?  What Service Level Agreements do you have in place to maintain operations within your live environment?  What outsourcing are you currently performing?  How do you manage your contracted staff?  What audits are in place to measure the performance of your suppliers and contractors?
  • 19. Project Audit Guideline RESOURCE MANAGEMENT Objective: To measure the project teams and how they are aligned to project deliverables Proposed Questions (these can be amended as required)  Does each resource have a defined job description?  Does the project team understand their specific role and responsibility within the project?  Are there the correct skills for the projects to be delivered?  Are there enough resources on board to deliver the projects?  Is there an organogram showing how the company structure works?
  • 20. Project Audit Guideline METRICS AND REPORTS Objective: To measure what reports and metrics are used to track projects within the life cycles and how these are presented to the stakeholders Proposed Questions (these can be amended as required) What metrics are used to measure success or failure within the projects  Tasks completed  Slippage ratios (SPI Index)  Cost slippage (CPI)  Web Analytics  MIS reports  Financial reports  Supplier review reports  Where are the reports stored?  Do you have a cloud management system to distribute reports to your suppliers and contractors?
  • 21. Project Audit Guideline COMMUNICATION MANAGEMENT Objective To measure if reports are timeously distributed using the correct information to the agreed team members Proposed Questions (these can be amended as required)  Do you use the cloud to store your documents and if so how is it managed and controlled to ensure security of information?  How is the weekly status presented to the forums?  How do you manage issues and risks and reporting back on this?  Do you use dashboard reports on projects and enhancements to show progress?  What regularly scheduled meetings do you have to report back on projects ?  How does the project team track and manage problems and issues?  Who takes the minutes and where are they stored?
  • 22. Project Audit Guideline CHANGE MANAGEMENT Objective: To measure how all changes within project management are tracked and managed to ensure that there is a minimum impact to the agreed cost, scope and schedule baselines. Proposed Questions (these can be amended as required)  What process is currently in place to manage and control any requested change?  Is there an understanding of what the impact is?  Who is responsible for raising the changes and authorising the outcome of the required changes?  How are these changes tracked back into the roadmap delivery plan?
  • 23. Project Audit Guideline PROJECT IMPLEMENTATION Objective To ensure that the quality of the product is managed controlled and meets the correct standards before being deployed Proposed Questions (these can be amended as required)  What quality standards are in place for the deployment of projects into the live environment?  Are there project-specific instructions regarding the procedures, naming conventions, supporting tools, equipment, standards and metrics to be applied by the project team to achieve quality objectives at each phase of the Project  How is the testing controlled and tracked before deploying the product?  Is there a roll back process in place?
  • 24. Project Audit Guideline Area Priority to correct Projects in progress High Medium Low Governance and Priority Project Best Practice Technology and Infrastructure Project Vendor Management Project Resource Management Project Metrics and Reports Project Communication Management Project Change Management Project Quality Management IDENTIFY THE PRIORITY Priority Amount High Medium Low
  • 25. Project Audit Guideline PLAN THE IMPROVEMENT ROADMAP Phase P1 P2 P3 P4 P5 P6 P7 P8 P9 P10 Projects in Progress Governance and methodology Project Best Practice Technology and infrastructure Project Vendor Management Project Resource Management Project Metrics and Reports Project Communication Management Project Change Management Project Quality Management
  • 26. Project Audit Guideline IMPLEMENTATION CHECKLIST Checklist Verification Charter agreed Team Meetings Setup Questionnaires completed Questionnaires returned Project Plan Agreed Communication plan agreed Team in Place Status Meetings Setup Cloud Storage and permission setup Kick off date agreed
  • 27. Project Audit Guideline CLOSING SUMMARY • When there is a common, simple approach for Project Management and the correct tools are available, your project team will be empowered to reach their goals, together and individually. • A easy to use Project Management Methodology gives your business a framework that makes it achievable for your product to move from vision to action. • It will also provide you with a competitive advantage to get your product into the market on time within budget and meeting the quality requirements each and every time.
  • 28. Project Audit Guideline CLOSING SUMMARY • When there is a common, simple approach for Project Management and the correct tools are available, your project team will be empowered to reach their goals, together and individually. • A easy to use Project Management Methodology gives your business a framework that makes it achievable for your product to move from vision to action. • It will also provide you with a competitive advantage to get your product into the market on time within budget and meeting the quality requirements each and every time.
