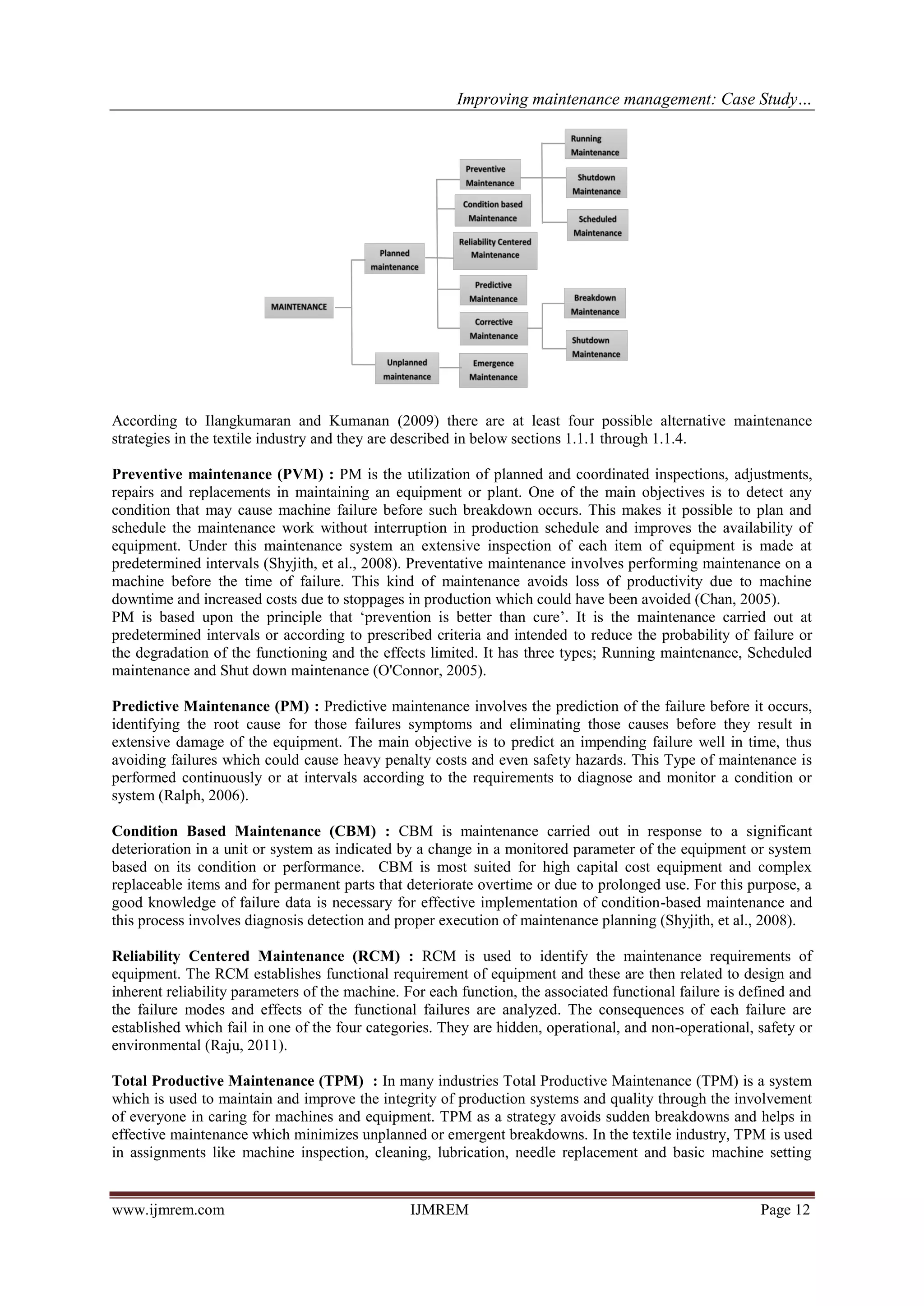

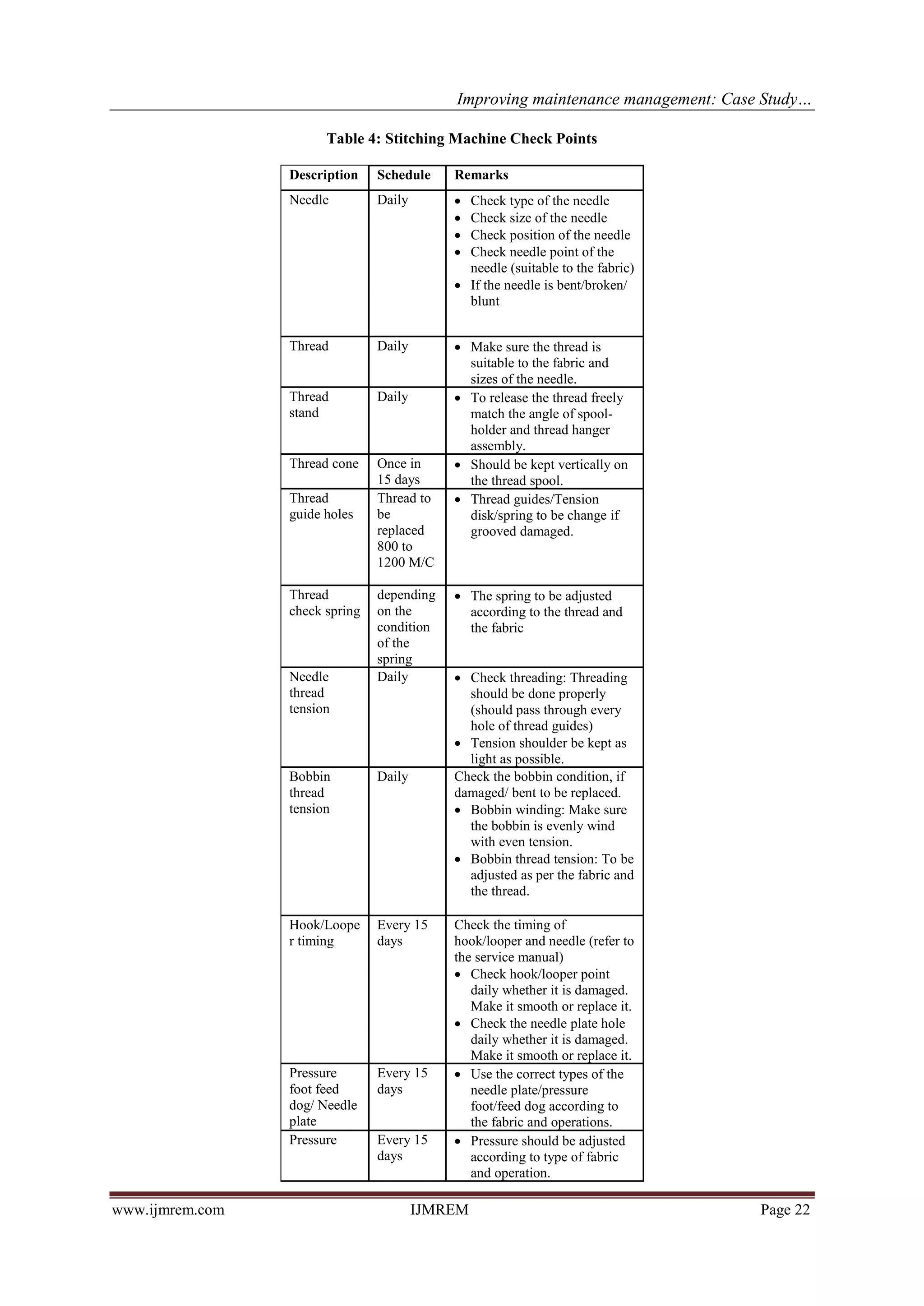

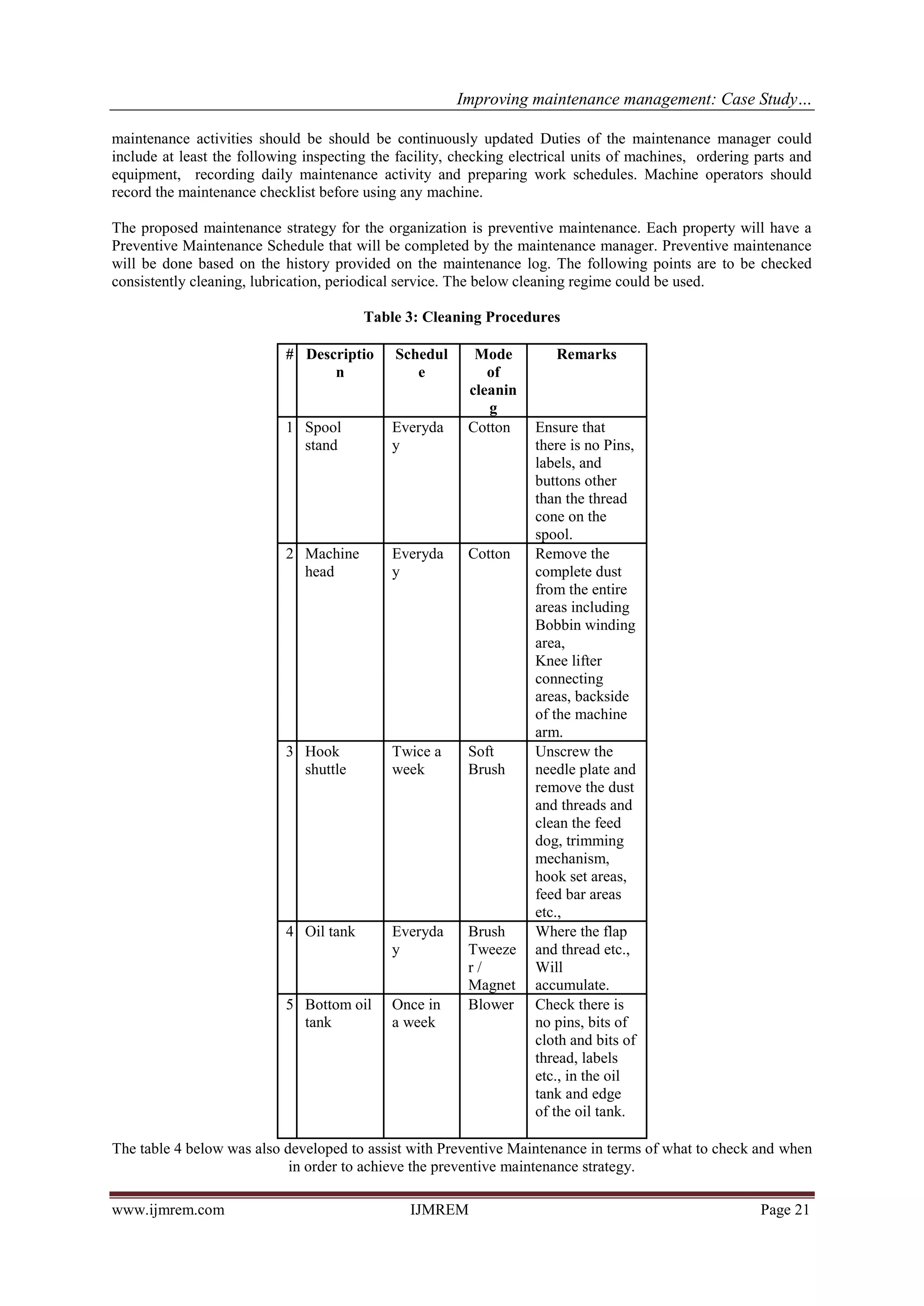

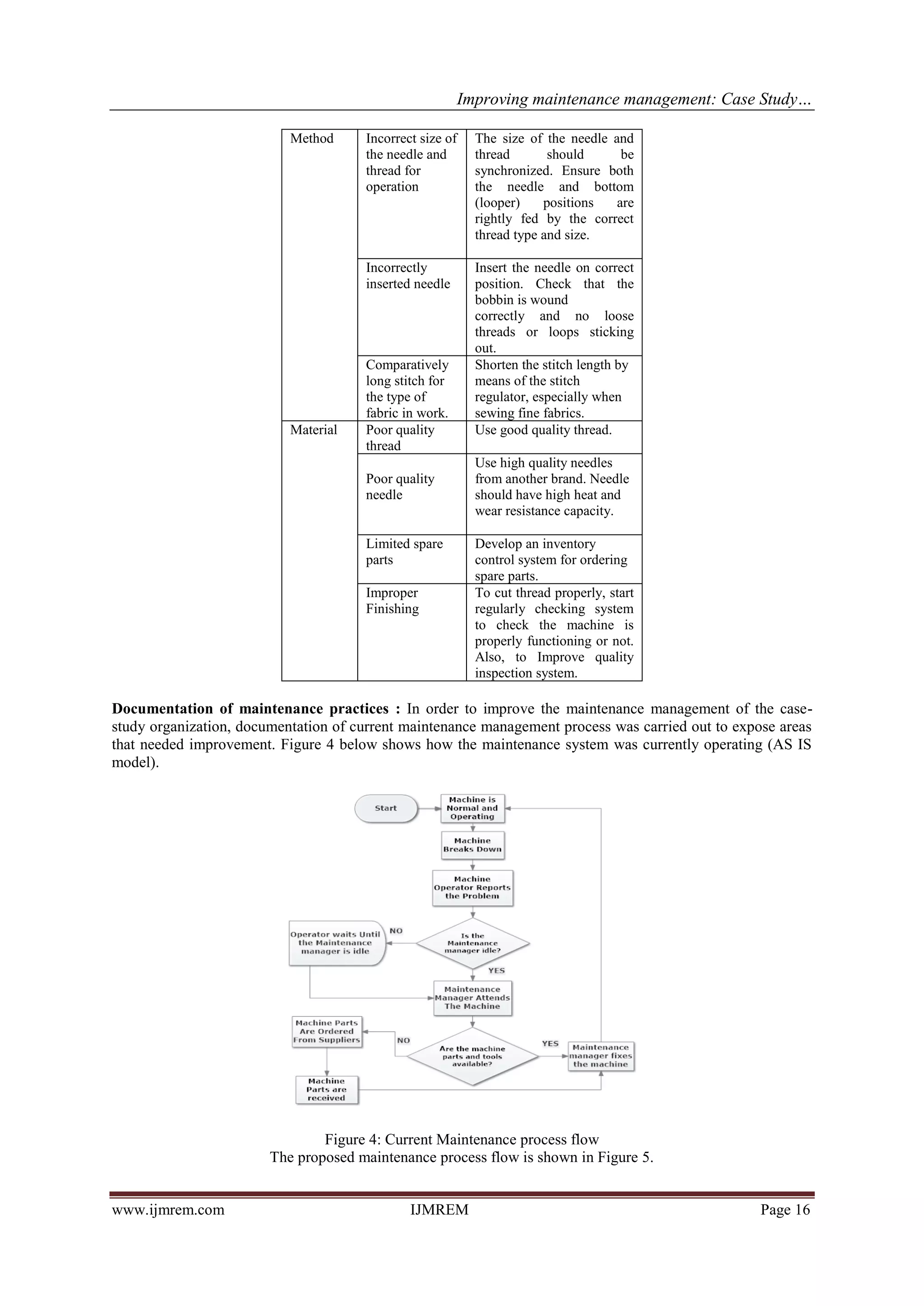

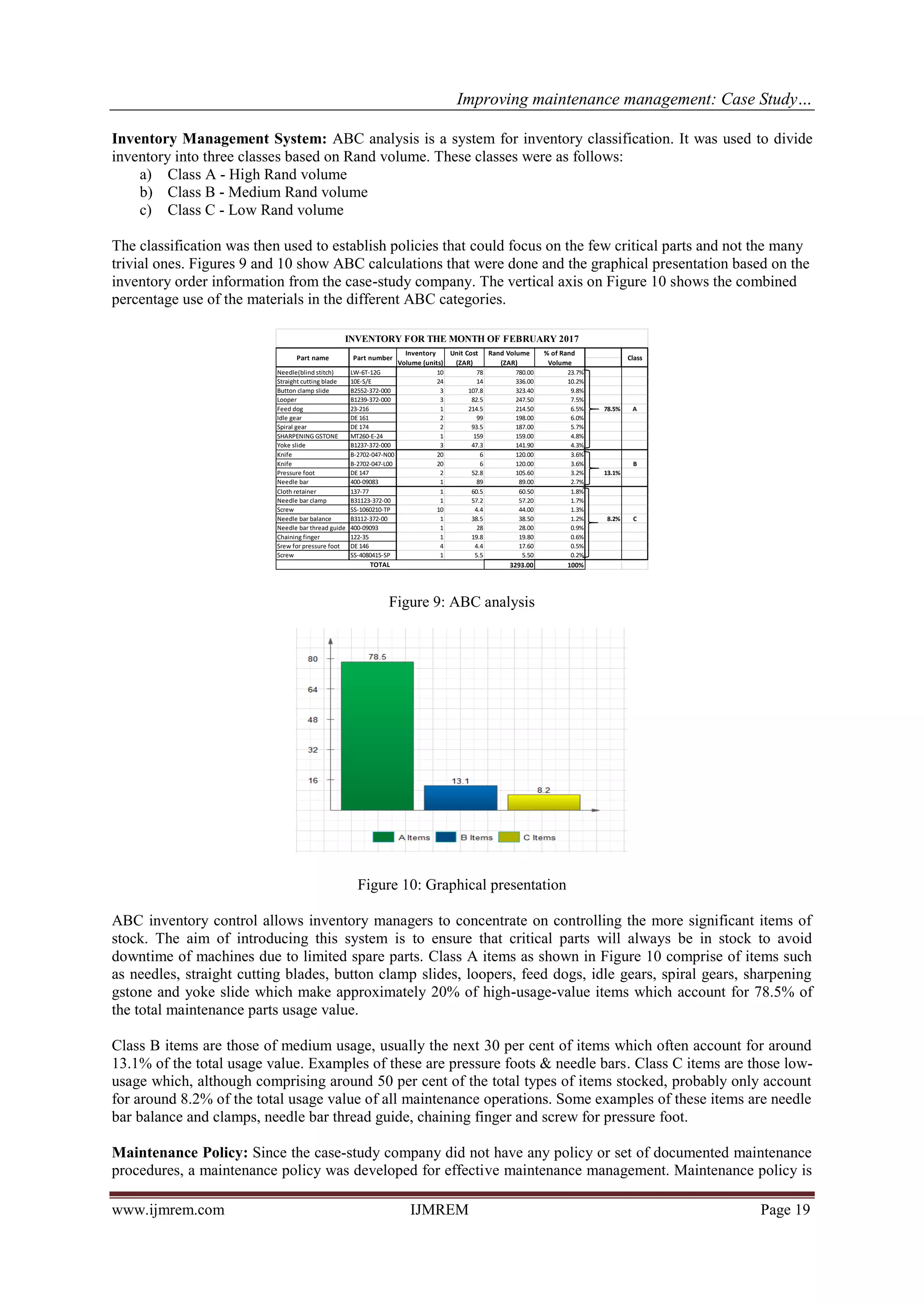

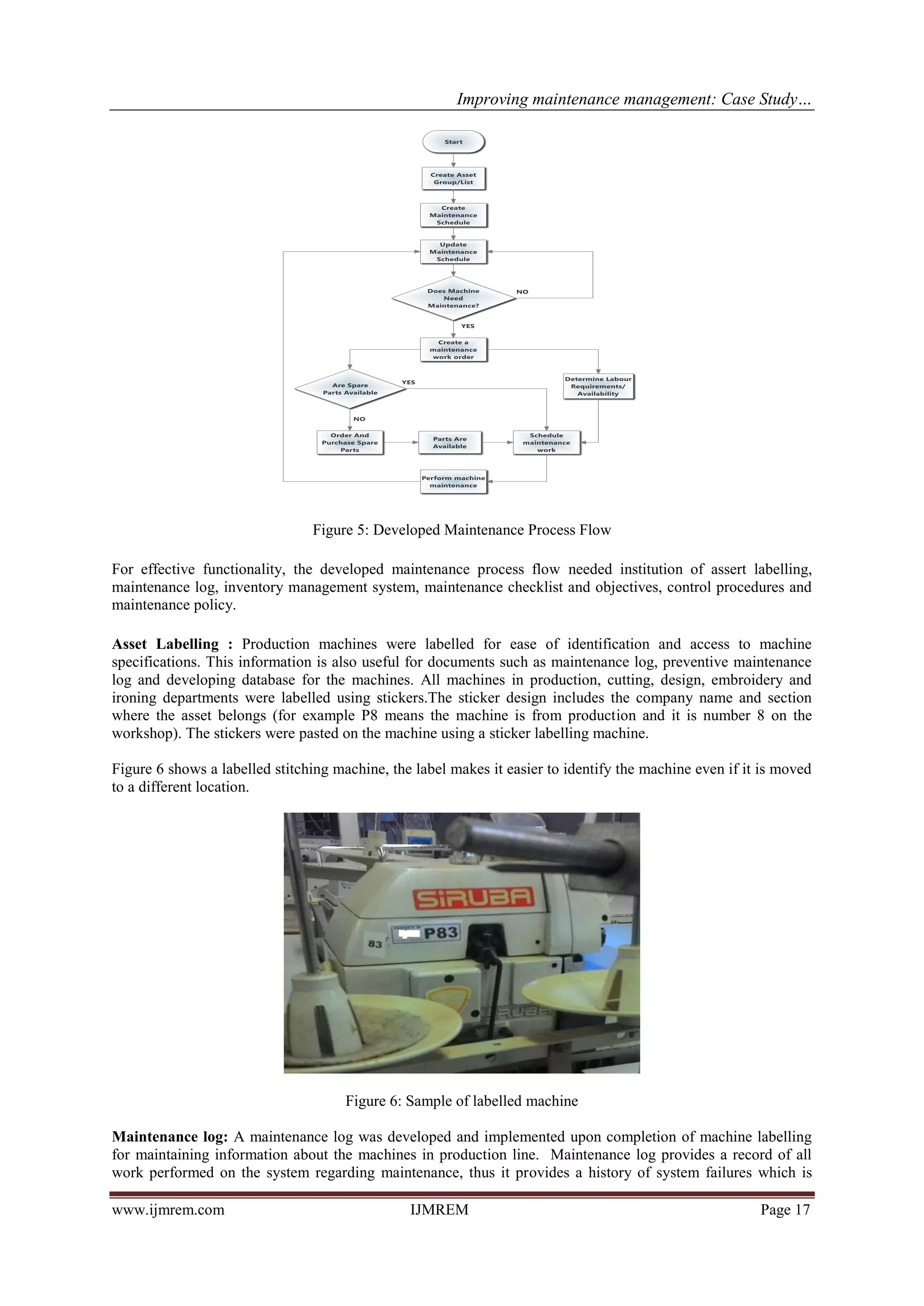

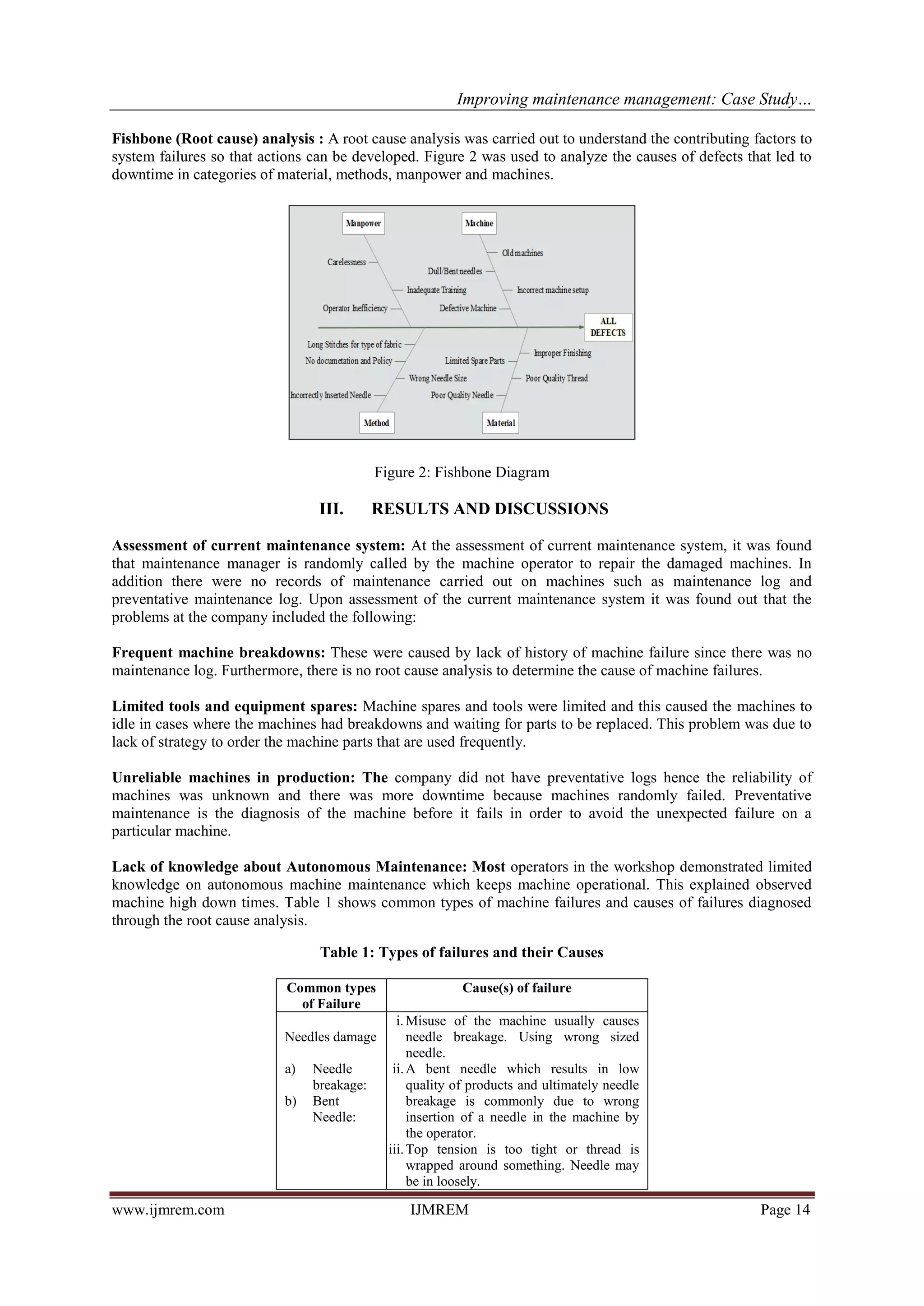

The document presents a case study focusing on improving maintenance management in a local textile company in Botswana, highlighting the significance of effective maintenance systems for enhancing equipment availability and productivity. It assesses the company's current maintenance practices, identifying issues such as frequent machine breakdowns and lack of preventive maintenance records, and proposes solutions including implementation of structured maintenance logs and inventory systems. Various maintenance strategies, including preventive, predictive, and total productive maintenance, are discussed to support the organization's aim to enhance production capabilities.
