QUALITY CIRCLE
Systematic Approach To Problem Solving

Prepared By
Mohamed Yusuff
Operations U & A

together we can

Quality Circle!
Introduction to Quality Circle
• It is a small group of frontline operators who
continually control and improve the quality of their
work, products and services.
• They voluntarily meet together on a regular basis to
identify improvements in their respective work areas
using proven techniques for analyzing and solving
work related problems.
• QC Circle activities are carried out as part of Total
Quality Management(TQM),
Operations U & A

together we can

Quality Circle!
QUALITY CIRCLE FROM TQM
• Continuous Process Improvement – Kaizen, Six
Sigma
• Employee Empowerment – Quality Circle
• Benchmarking – Legally stealing other people’s ideas
• Customer-Supplier Partnerships – JIT concept
• Management by fact.
Operations U & A

together we can

Quality Circle!
WHY WE NEED QUALITY CIRCLE

• Its provides an opportunity for members to
develop their creative thinking
• As the members study and learn together, their
full potential is realized
• To contribute to the improvement and
development of an Organisation.
Operations U & A

together we can

Quality Circle!
OBJECTVES OF QC
• Establishment of a pleasant workplace
• Establishment of a state of control
• Enhancement of morale
• Establishment of sound human relations
• Better income
• Improvement in Quality Assurance
Operations U & A

together we can

Quality Circle!
POTENTIAL BENIFITS
• Increased productivity
• Improved quality of work life
• Boost employee morale
• Enhances creativity
• Improved teamwork
• Employee involvement
Operations U & A

together we can

Quality Circle!
ORIGIN OF QC
• The first Quality Circle was organized in 1962,
by Japan Nippon Telegraph company.
• It was supervised by Mr.Deming and Dr.Juran.
• Japan Started JUSE (Union of Japan
Scientists and Engineers) to spread Quality
control circle.
Operations U & A

together we can

Quality Circle!
Asian Productivity Organization
•
•
•
•
•
•
•
•
•
•
•
•

Japan
South Korea
Taiwan
Singapore
Malaysia
the Philippines
Hong Kong
India,
Indonesia
Thailand
Sri Lanka
Pakistan and Vietnam

Operations U & A

together we can

Quality Circle!
QUALITY CIRCLE IN COIL SHOP
• In Coil shop Quality Circle successfully started
on 30th March 2013.
• Total 13 team formed on 24th March 2013.
• Booklet and training provided 8 th April 2013.
• Currently successfully continuing the Improve
phase.
Operations U & A

together we can

Quality Circle!

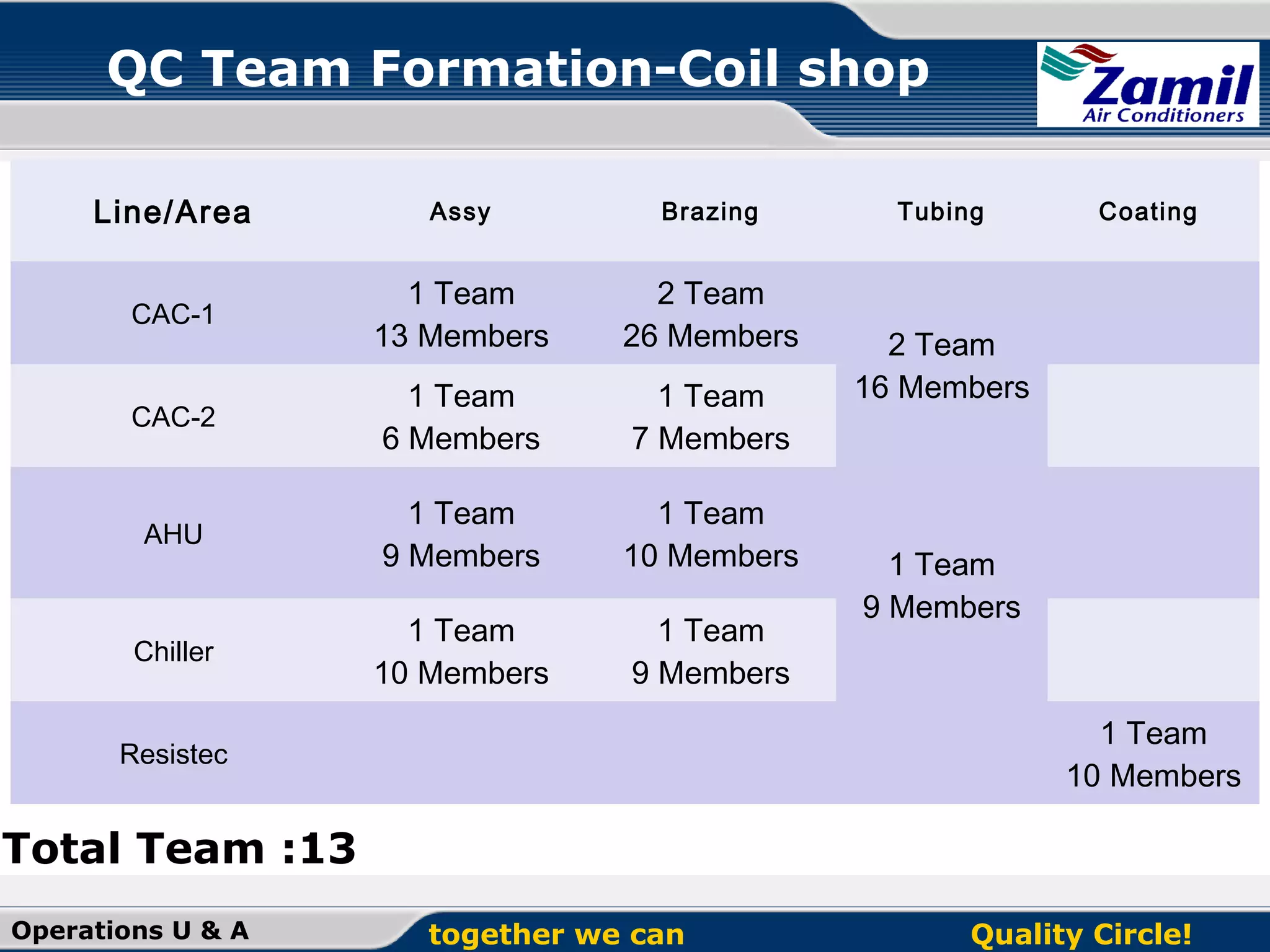

QC Team Formation-Coil shop
Line/Area

Assy

Brazing

CAC-1

1 Team
13 Members

2 Team
26 Members

CAC-2

1 Team
6 Members

1 Team
7 Members

AHU

1 Team
9 Members

1 Team
10 Members

Chiller

1 Team
10 Members

1 Team
9 Members

Tubing

Coating

2 Team
16 Members

1 Team
9 Members

1 Team
10 Members

Resistec

Total Team :13
Operations U & A

together we can

Quality Circle!
QUALITY CIRCLE IN COIL SHOP
• Assigned Leaders and sub leaders for each
team.
• Team name selected by each team members
• Each team took each project from their own
area. Total 13 project in progress.

Operations U & A

together we can

Quality Circle!

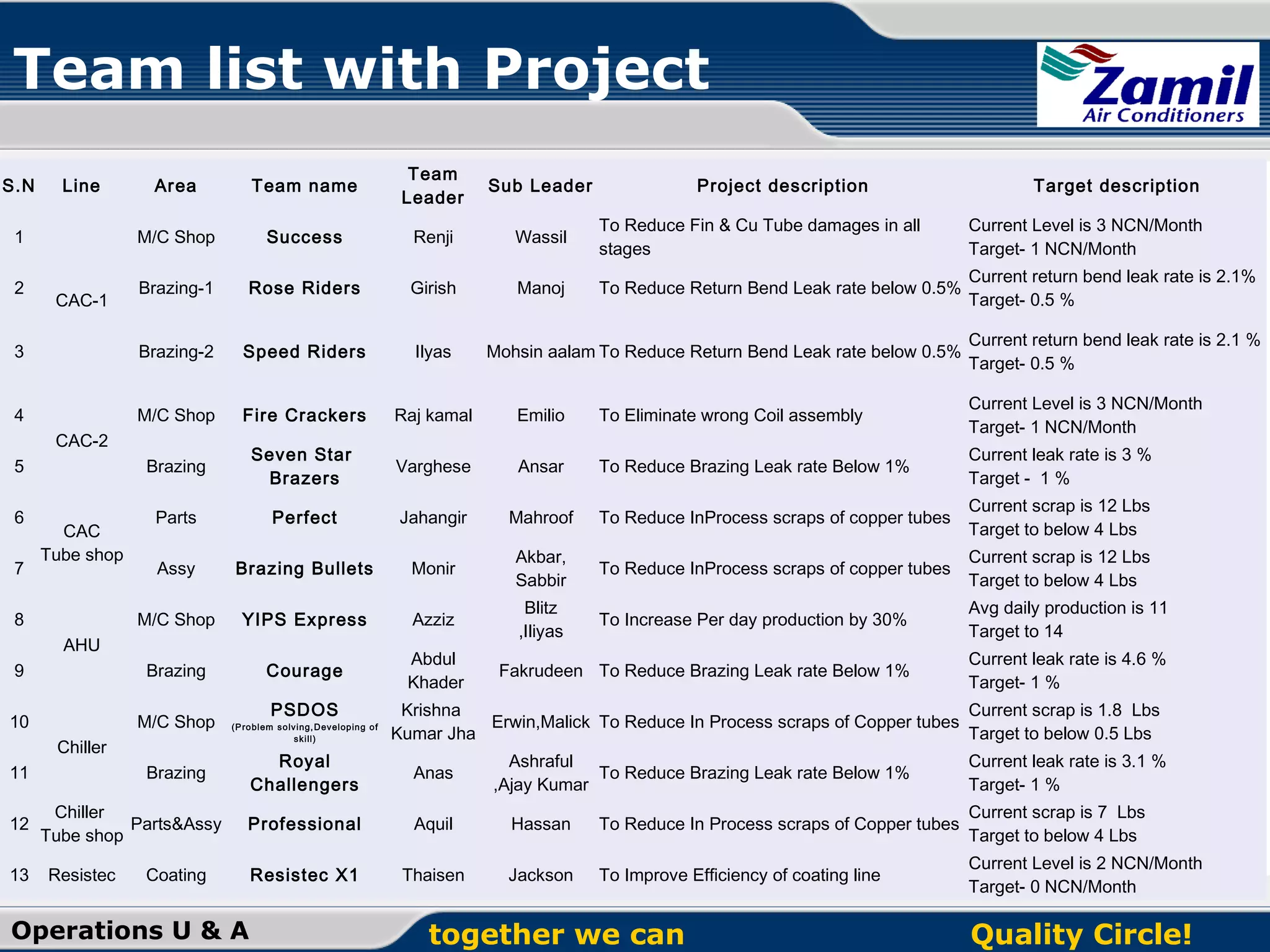

Team list with Project
Area

Team name

Team
Leader

Sub Leader

M/C Shop

Success

Renji

Wassil

To Reduce Fin & Cu Tube damages in all
stages

Current Level is 3 NCN/Month
Target- 1 NCN/Month

Brazing-1

Rose Riders

Girish

Manoj

To Reduce Return Bend Leak rate below 0.5%

Current return bend leak rate is 2.1%
Target- 0.5 %

3

Brazing-2

Speed Riders

Ilyas

Mohsin aalam To Reduce Return Bend Leak rate below 0.5%

Current return bend leak rate is 2.1 %
Target- 0.5 %

4

M/C Shop

Fire Crackers

Raj kamal

Emilio

To Eliminate wrong Coil assembly

Current Level is 3 NCN/Month
Target- 1 NCN/Month

5

Brazing

Seven Star
Brazers

Varghese

Ansar

To Reduce Brazing Leak rate Below 1%

Current leak rate is 3 %
Target - 1 %

6

Parts

Perfect

Jahangir

Mahroof

To Reduce InProcess scraps of copper tubes

Current scrap is 12 Lbs
Target to below 4 Lbs

Assy

Brazing Bullets

Monir

Akbar,
Sabbir

To Reduce InProcess scraps of copper tubes

Current scrap is 12 Lbs
Target to below 4 Lbs

M/C Shop

YIPS Express

Azziz

Blitz
,Iliyas

To Increase Per day production by 30%

Avg daily production is 11
Target to 14

9

Brazing

Courage

Abdul
Khader

Fakrudeen To Reduce Brazing Leak rate Below 1%

Current leak rate is 4.6 %
Target- 1 %

10

M/C Shop

S.N

Line

1
2

CAC-1

CAC-2

7

CAC
Tube shop

8
AHU

Chiller
11
12
13

PSDOS
(P ro blem so lving, Develop in g o f
skill)

Resistec

Target description

Krishna
Current scrap is 1.8 Lbs
Erwin,Malick To Reduce In Process scraps of Copper tubes
Kumar Jha
Target to below 0.5 Lbs

Royal
Challengers

Anas

Professional

Aquil

Hassan

To Reduce In Process scraps of Copper tubes

Current scrap is 7 Lbs
Target to below 4 Lbs

Resistec X1

Thaisen

Jackson

To Improve Efficiency of coating line

Current Level is 2 NCN/Month
Target- 0 NCN/Month

Brazing
Chiller
Parts&Assy
Tube shop

Project description

Coating

Operations U & A

Ashraful
To Reduce Brazing Leak rate Below 1%
,Ajay Kumar

together we can

Current leak rate is 3.1 %
Target- 1 %

Quality Circle!

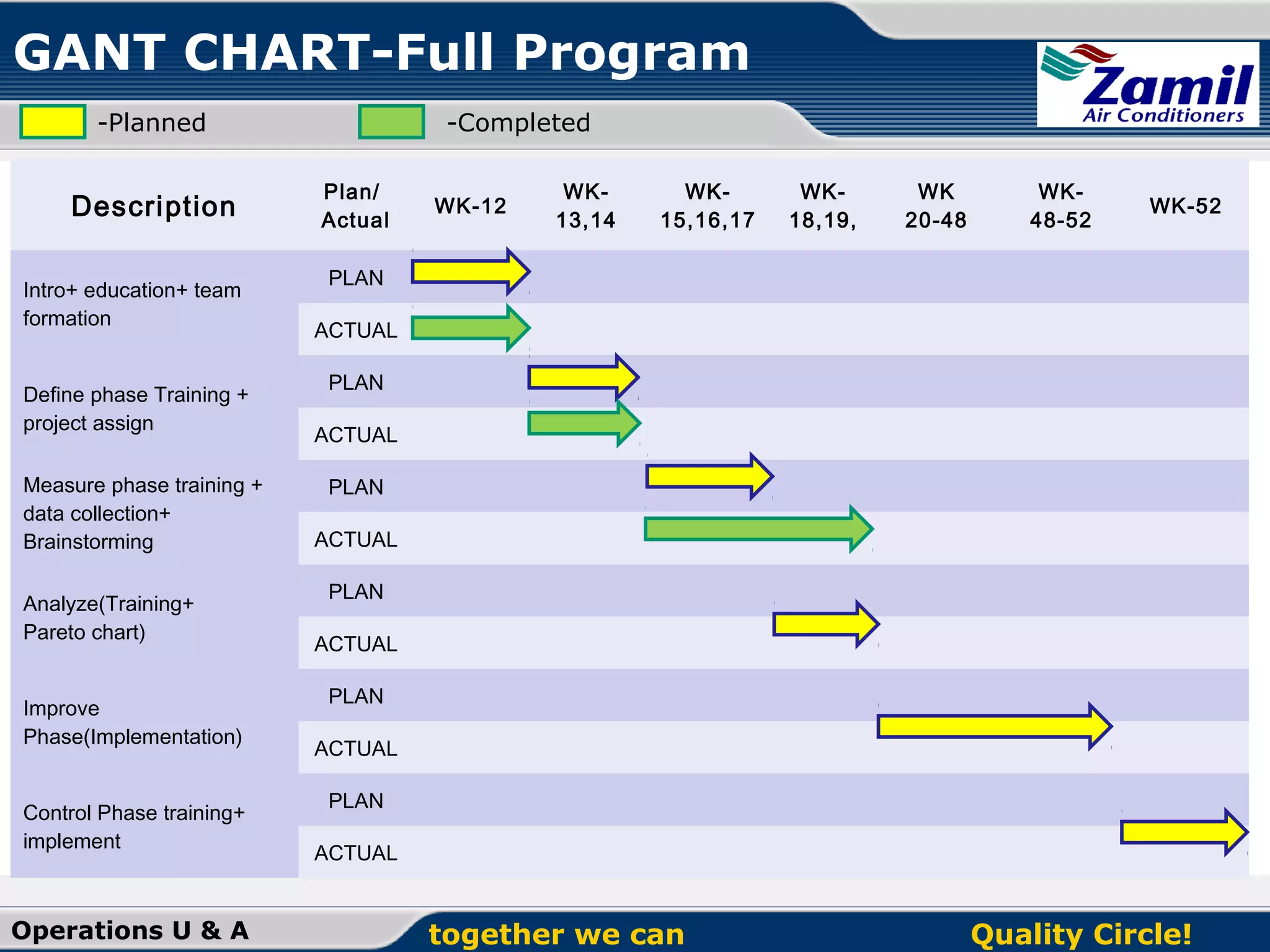

GANT CHART-Full Program
-Planned

Description
Intro+ education+ team
formation
Define phase Training +
project assign
Measure phase training +
data collection+
Brainstorming
Analyze(Training+
Pareto chart)
Improve
Phase(Implementation)
Control Phase training+
implement

Operations U & A

-Completed
Plan/
Actual

WK-12

WK13,14

WK15,16,17

WK18,19,

WK
20-48

WK48-52

WK-52

PLAN
ACTUAL
PLAN
ACTUAL
PLAN
ACTUAL
PLAN
ACTUAL
PLAN
ACTUAL
PLAN
ACTUAL

together we can

Quality Circle!
ABOUT PROJECTS
• Format used – DMAIC
Define, Measure, Analyze, Improve & Control
• Periodical training & meeting conducted.
• Internal meeting conducted by team leaders in
work place every month to define their own
stage problems.
Operations U & A

together we can

Quality Circle!
ABOUT PROJECTS
• Tools used
- Pareto chart
- Cause and Effect diagram
- FDM(Function Deployment Matrix)
- Brainstorming
- Check sheets
Operations U & A

together we can

Quality Circle!
Improvements observed
• Each Project working on minimum 2 problems
which is to improve on their stage.

• Total 32 improvements related to their own
stage is in progress.

Operations U & A

together we can

Quality Circle!

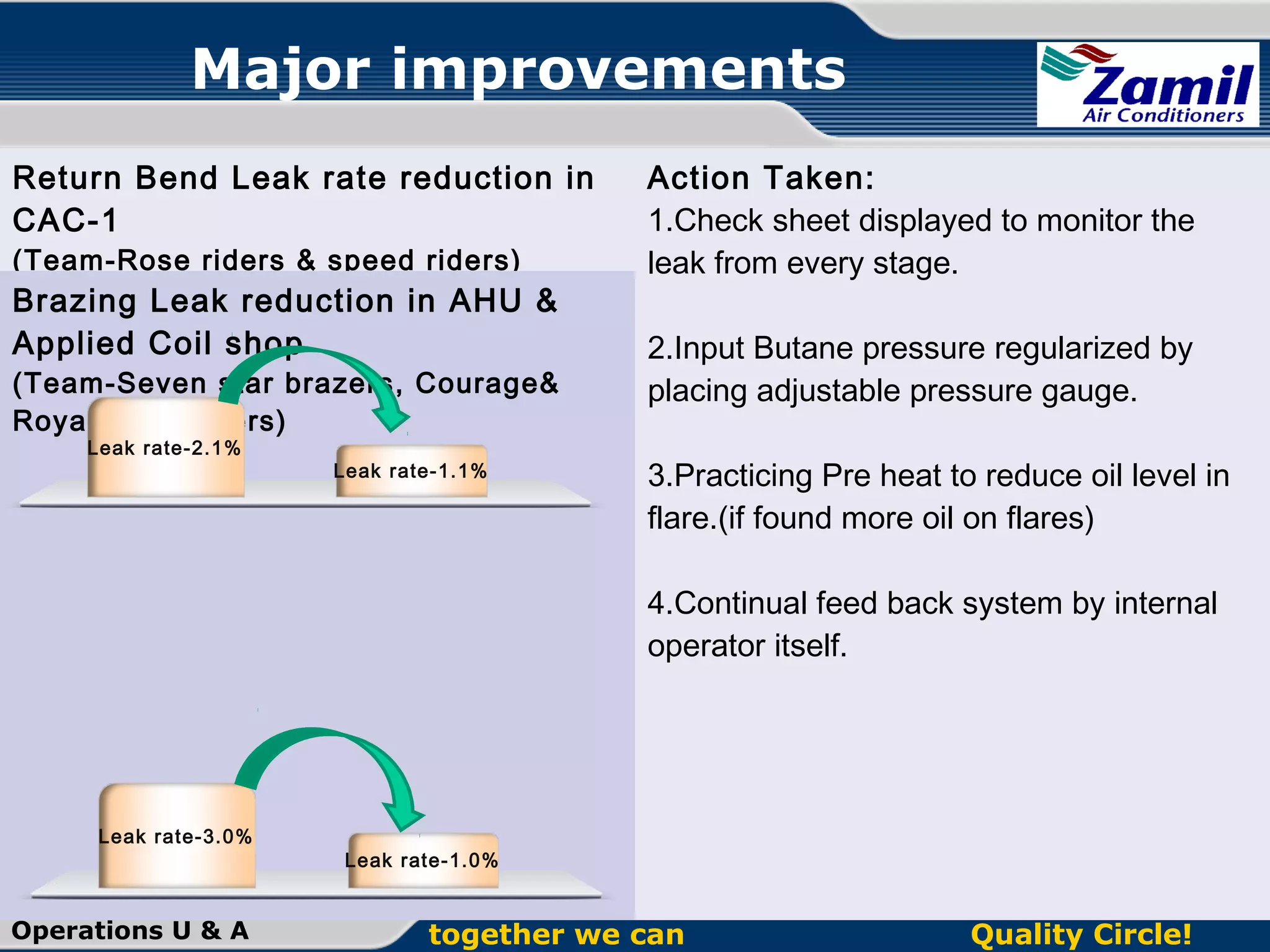

Major improvements
Return Bend Leak rate reduction in
CAC-1
(Team-Rose riders & speed riders)

Brazing Leak reduction in AHU &
Applied Coil shop
(Team-Seven star brazers, Courage&
Royal challengers)
Leak rate-2.1%

Leak rate-1.1%

Action Taken:
1.Check sheet displayed to monitor the
leak from every stage.
2.Input Butane pressure regularized by
placing adjustable pressure gauge.
3.Practicing Pre heat to reduce oil level in
flare.(if found more oil on flares)
4.Continual feed back system by internal
operator itself.

Leak rate-3.0%

Operations U & A

Leak rate-1.0%

together we can

Quality Circle!

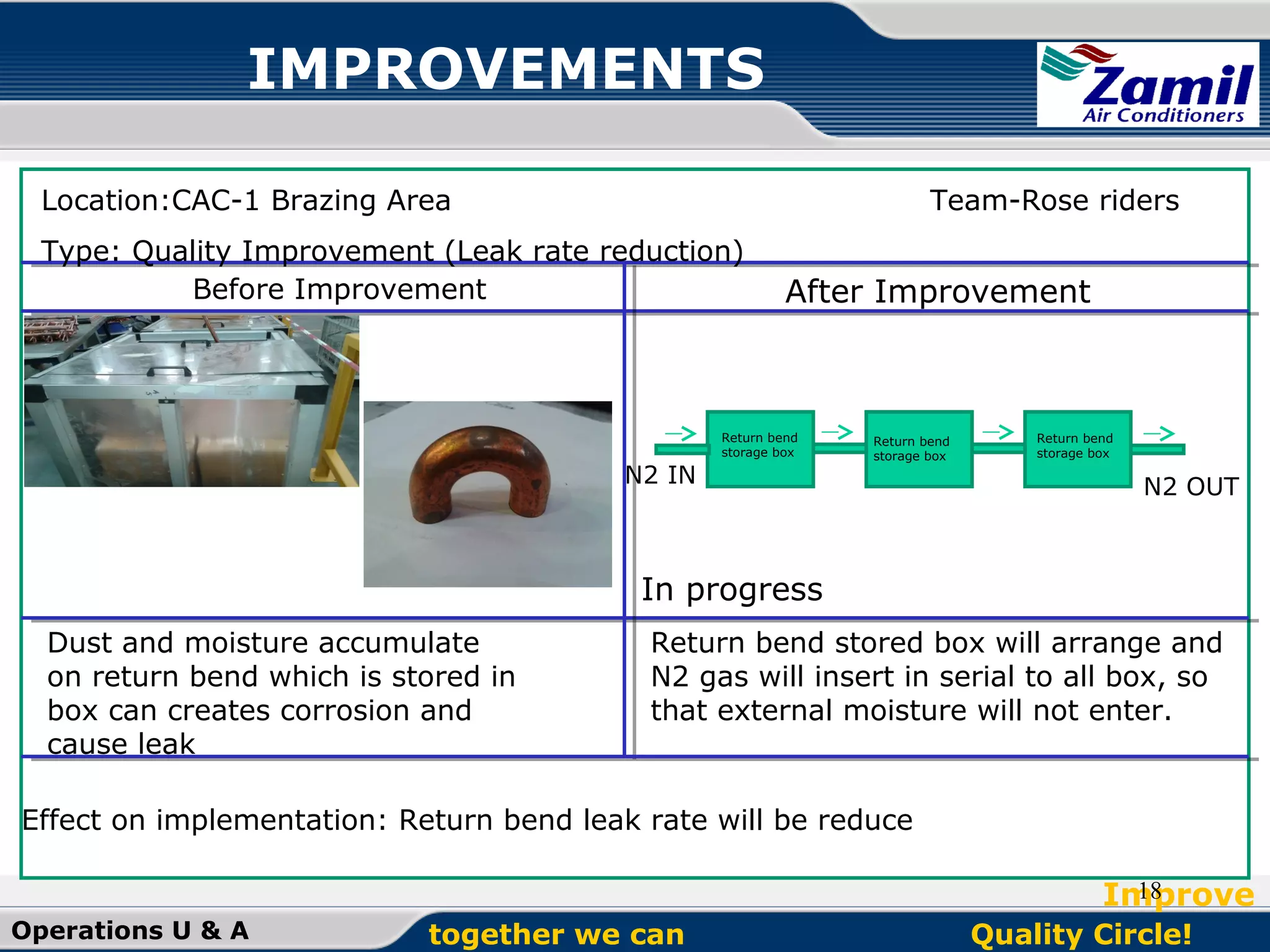

IMPROVEMENTS
Location:CAC-1 Brazing Area

Team-Rose riders

Type: Quality Improvement (Leak rate reduction)
Before Improvement

N2 IN

After Improvement

Return bend
storage box

Return bend
storage box

Return bend
storage box

N2 OUT

In progress
Dust and moisture accumulate
on return bend which is stored in
box can creates corrosion and
cause leak

Return bend stored box will arrange and
N2 gas will insert in serial to all box, so
that external moisture will not enter.

Effect on implementation: Return bend leak rate will be reduce
18
Improve
Operations U & A

together we can

Quality Circle!
IMPROVEMENTS
Location: CAC2 Machine shop

Team- Fire Crackers

Type: Productivity Improvement
Before Improvement

After Improvement

Photos attached
on next slide

Photos attached
on next slide
Process In progress

After Process sheet obtain from scheduling, in
coil shop there exist manual editing for coil
size and hair pin Qty which creates wrong coil
due to wrong entry.

With the help of Scheduling
process sheet changed with required
data to produce coil without manual
editing

Effect on implementation: Wrong coil assembly will reduce
19
Improve
Operations U & A

together we can

Quality Circle!

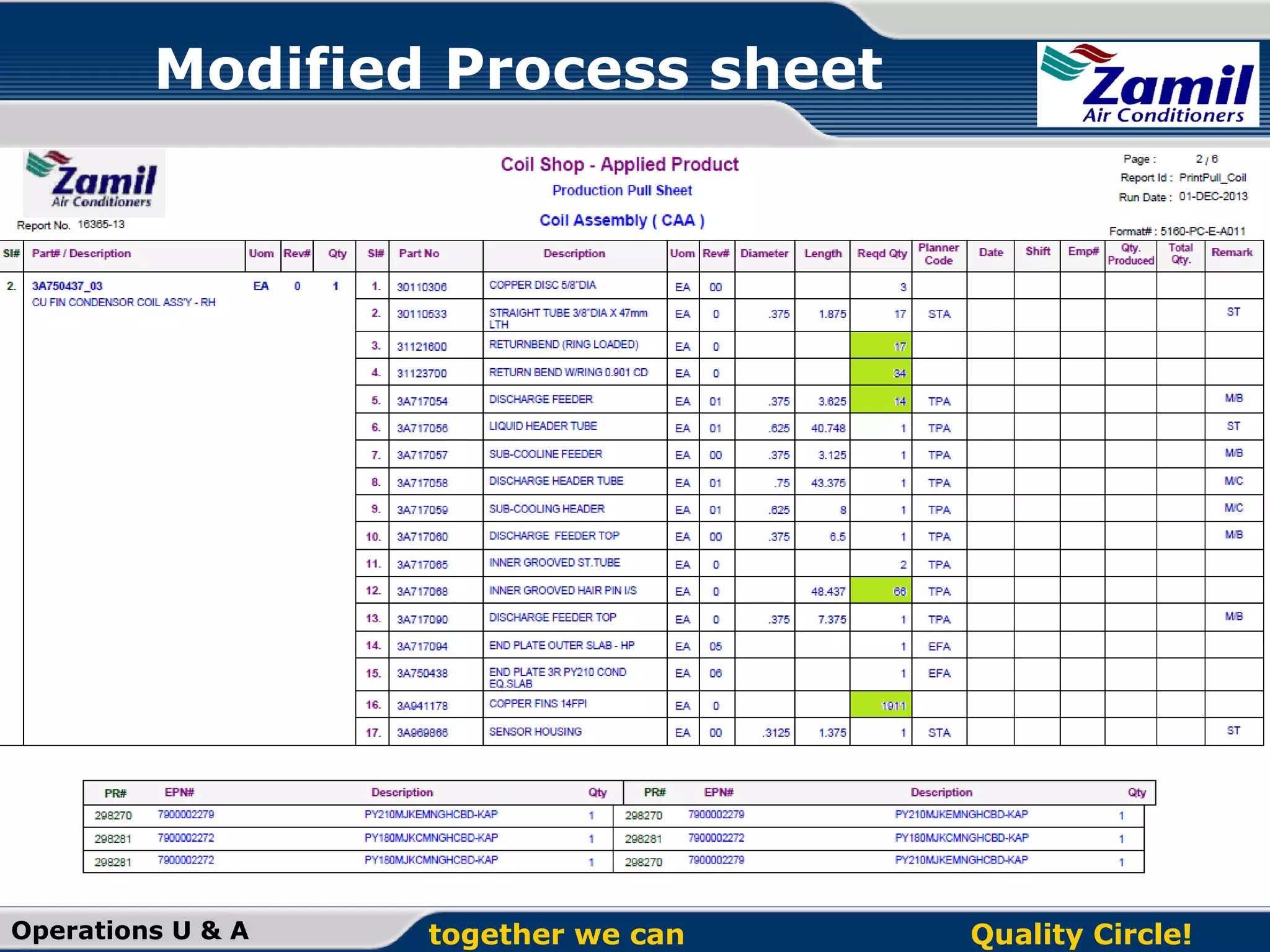

Process sheet-Current

Operations U & A

together we can

Quality Circle!
Modified Process sheet

Operations U & A

together we can

Quality Circle!

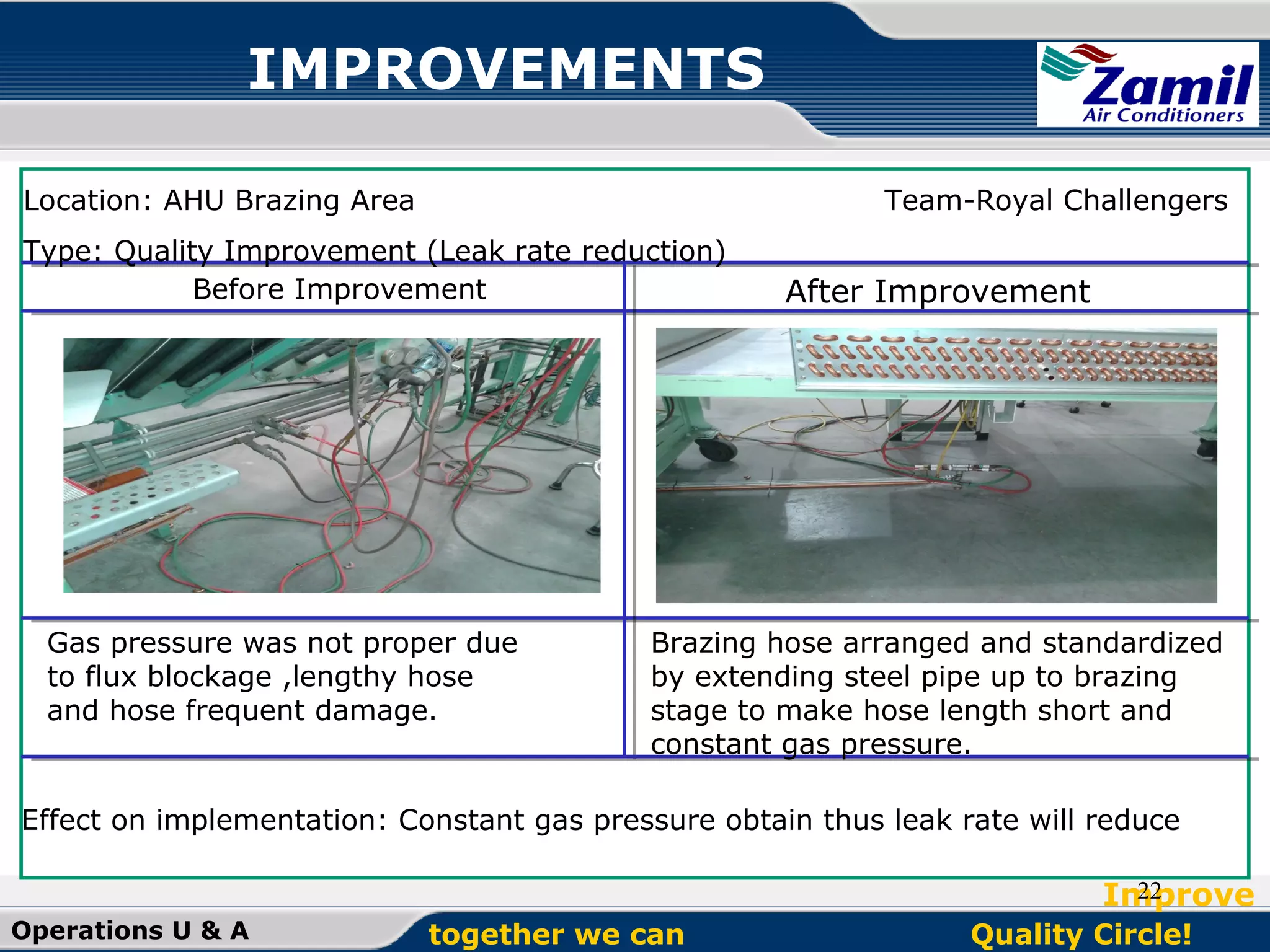

IMPROVEMENTS
Location: AHU Brazing Area

Team-Royal Challengers

Type: Quality Improvement (Leak rate reduction)
Before Improvement

Gas pressure was not proper due
to flux blockage ,lengthy hose
and hose frequent damage.

After Improvement

Brazing hose arranged and standardized
by extending steel pipe up to brazing
stage to make hose length short and
constant gas pressure.

Effect on implementation: Constant gas pressure obtain thus leak rate will reduce
22
Improve
Operations U & A

together we can

Quality Circle!
IMPROVEMENTS
Location: Resistec

Team-Resistec 11

Type: Productivity Improvement
Before Improvement

Coils were coated by keeping on
drums. Coating done on one face and
hold it for drying about 6 hrs and then
coating on the opposite side..

After Improvement

Moving trolley made with hanging
system, Now coils will coat/spray and
directly move to the oven without lifting
the coils

Effect on implementation: Process time reduction with improved Quality
23
Improve
Operations U & A

together we can

Quality Circle!

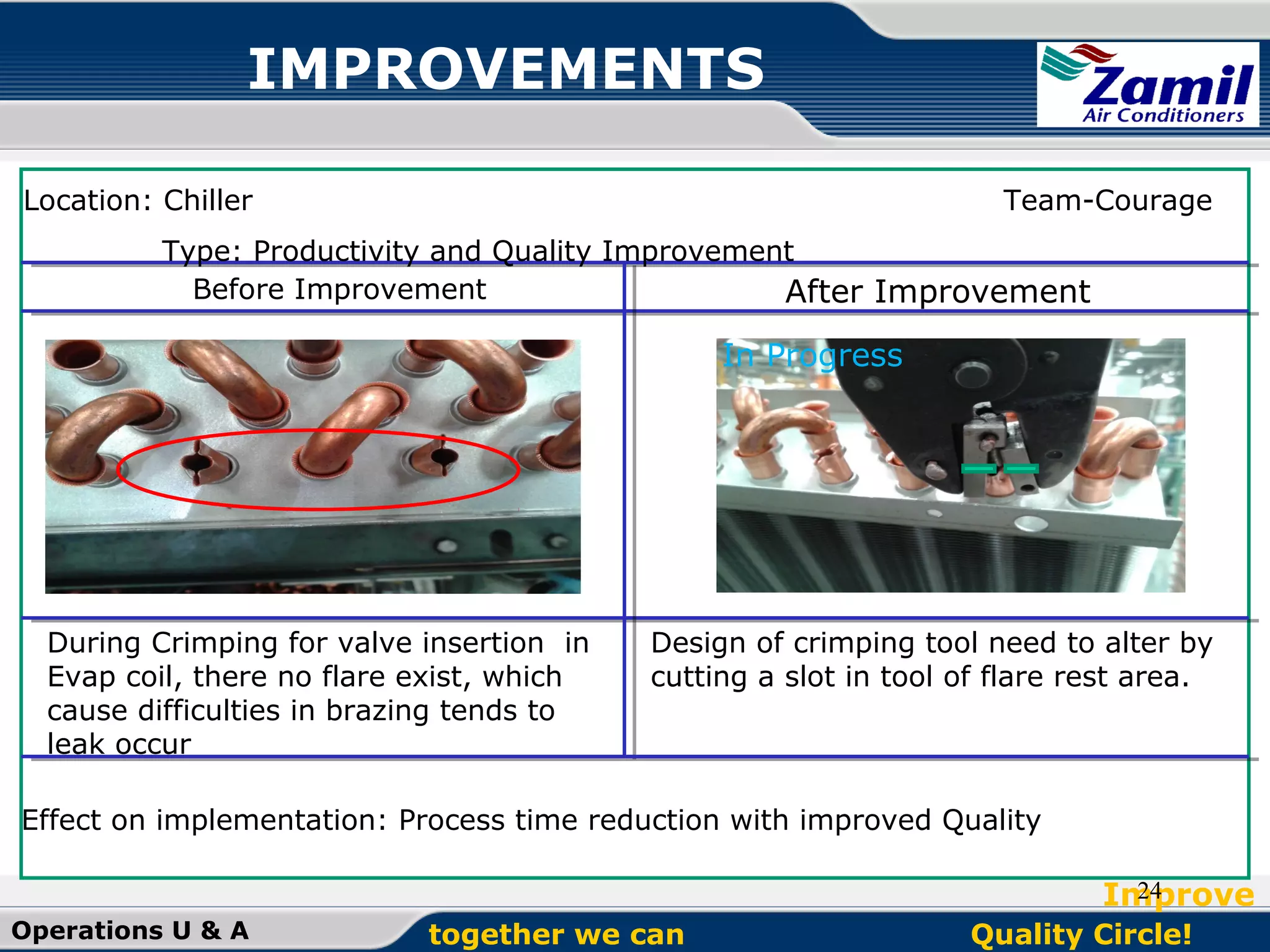

IMPROVEMENTS
Location: Chiller

Team-Courage

Type: Productivity and Quality Improvement
Before Improvement
After Improvement

In Progress

During Crimping for valve insertion in
Evap coil, there no flare exist, which
cause difficulties in brazing tends to
leak occur

Design of crimping tool need to alter by
cutting a slot in tool of flare rest area.

Effect on implementation: Process time reduction with improved Quality
24
Improve
Operations U & A

together we can

Quality Circle!

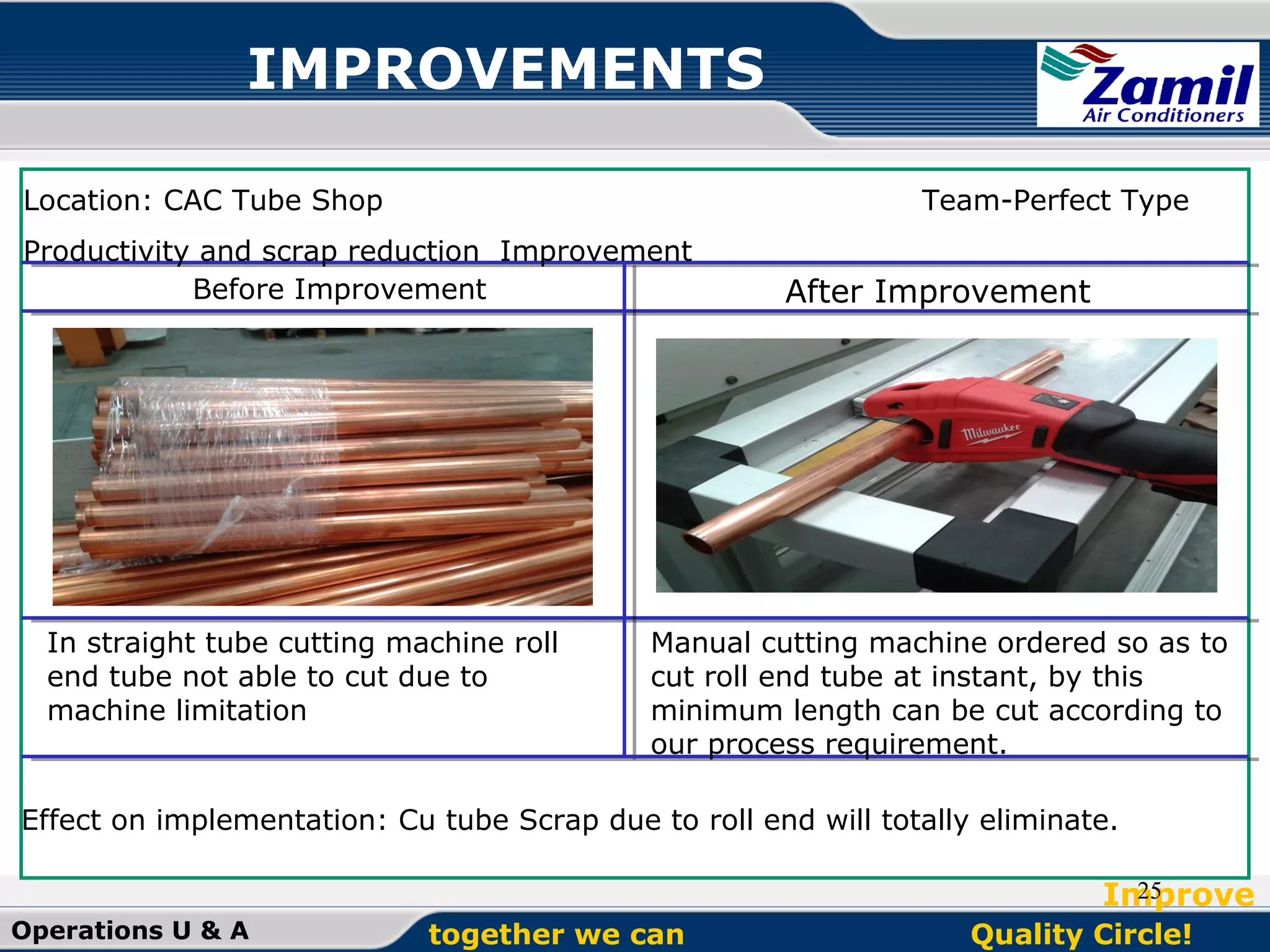

IMPROVEMENTS
Location: CAC Tube Shop

Team-Perfect Type

Productivity and scrap reduction Improvement
Before Improvement

In straight tube cutting machine roll
end tube not able to cut due to
machine limitation

After Improvement

Manual cutting machine ordered so as to
cut roll end tube at instant, by this
minimum length can be cut according to
our process requirement.

Effect on implementation: Cu tube Scrap due to roll end will totally eliminate.
25
Improve
Operations U & A

together we can

Quality Circle!

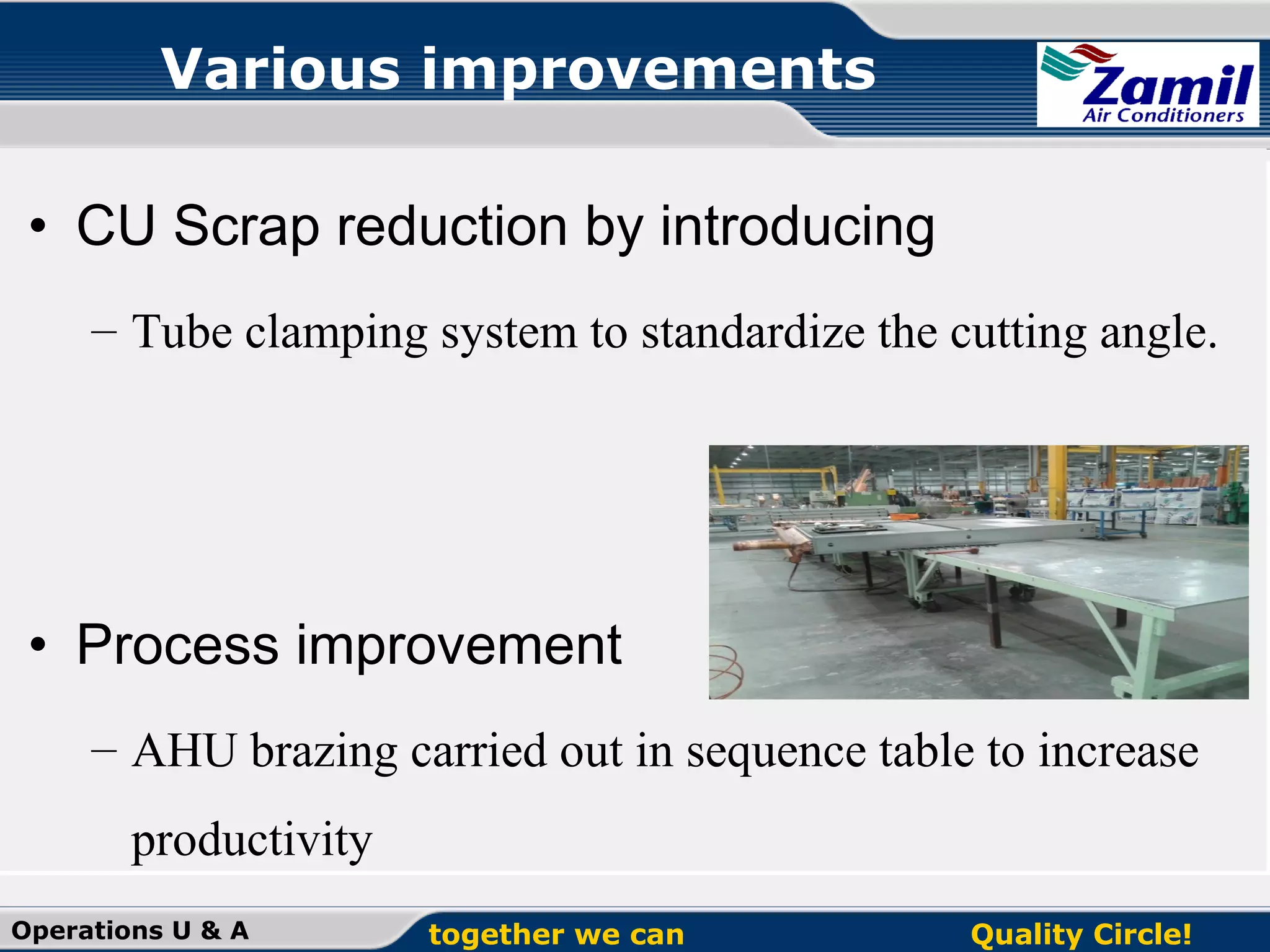

Various improvements
• CU Scrap reduction by introducing
– Tube clamping system to standardize the cutting angle.

• Process improvement
– AHU brazing carried out in sequence table to increase
productivity
Operations U & A

together we can

Quality Circle!
Operations U & A

together we can

Quality Circle!

Quality circle presentation by yusuff

  • 1.
    QUALITY CIRCLE Systematic ApproachTo Problem Solving Prepared By Mohamed Yusuff Operations U & A together we can Quality Circle!
  • 2.
    Introduction to QualityCircle • It is a small group of frontline operators who continually control and improve the quality of their work, products and services. • They voluntarily meet together on a regular basis to identify improvements in their respective work areas using proven techniques for analyzing and solving work related problems. • QC Circle activities are carried out as part of Total Quality Management(TQM), Operations U & A together we can Quality Circle!
  • 3.
    QUALITY CIRCLE FROMTQM • Continuous Process Improvement – Kaizen, Six Sigma • Employee Empowerment – Quality Circle • Benchmarking – Legally stealing other people’s ideas • Customer-Supplier Partnerships – JIT concept • Management by fact. Operations U & A together we can Quality Circle!
  • 4.
    WHY WE NEEDQUALITY CIRCLE • Its provides an opportunity for members to develop their creative thinking • As the members study and learn together, their full potential is realized • To contribute to the improvement and development of an Organisation. Operations U & A together we can Quality Circle!
  • 5.
    OBJECTVES OF QC •Establishment of a pleasant workplace • Establishment of a state of control • Enhancement of morale • Establishment of sound human relations • Better income • Improvement in Quality Assurance Operations U & A together we can Quality Circle!
  • 6.
    POTENTIAL BENIFITS • Increasedproductivity • Improved quality of work life • Boost employee morale • Enhances creativity • Improved teamwork • Employee involvement Operations U & A together we can Quality Circle!
  • 7.
    ORIGIN OF QC •The first Quality Circle was organized in 1962, by Japan Nippon Telegraph company. • It was supervised by Mr.Deming and Dr.Juran. • Japan Started JUSE (Union of Japan Scientists and Engineers) to spread Quality control circle. Operations U & A together we can Quality Circle!
  • 8.
    Asian Productivity Organization • • • • • • • • • • • • Japan SouthKorea Taiwan Singapore Malaysia the Philippines Hong Kong India, Indonesia Thailand Sri Lanka Pakistan and Vietnam Operations U & A together we can Quality Circle!
  • 9.
    QUALITY CIRCLE INCOIL SHOP • In Coil shop Quality Circle successfully started on 30th March 2013. • Total 13 team formed on 24th March 2013. • Booklet and training provided 8 th April 2013. • Currently successfully continuing the Improve phase. Operations U & A together we can Quality Circle!
  • 10.
    QC Team Formation-Coilshop Line/Area Assy Brazing CAC-1 1 Team 13 Members 2 Team 26 Members CAC-2 1 Team 6 Members 1 Team 7 Members AHU 1 Team 9 Members 1 Team 10 Members Chiller 1 Team 10 Members 1 Team 9 Members Tubing Coating 2 Team 16 Members 1 Team 9 Members 1 Team 10 Members Resistec Total Team :13 Operations U & A together we can Quality Circle!
  • 11.
    QUALITY CIRCLE INCOIL SHOP • Assigned Leaders and sub leaders for each team. • Team name selected by each team members • Each team took each project from their own area. Total 13 project in progress. Operations U & A together we can Quality Circle!
  • 12.
    Team list withProject Area Team name Team Leader Sub Leader M/C Shop Success Renji Wassil To Reduce Fin & Cu Tube damages in all stages Current Level is 3 NCN/Month Target- 1 NCN/Month Brazing-1 Rose Riders Girish Manoj To Reduce Return Bend Leak rate below 0.5% Current return bend leak rate is 2.1% Target- 0.5 % 3 Brazing-2 Speed Riders Ilyas Mohsin aalam To Reduce Return Bend Leak rate below 0.5% Current return bend leak rate is 2.1 % Target- 0.5 % 4 M/C Shop Fire Crackers Raj kamal Emilio To Eliminate wrong Coil assembly Current Level is 3 NCN/Month Target- 1 NCN/Month 5 Brazing Seven Star Brazers Varghese Ansar To Reduce Brazing Leak rate Below 1% Current leak rate is 3 % Target - 1 % 6 Parts Perfect Jahangir Mahroof To Reduce InProcess scraps of copper tubes Current scrap is 12 Lbs Target to below 4 Lbs Assy Brazing Bullets Monir Akbar, Sabbir To Reduce InProcess scraps of copper tubes Current scrap is 12 Lbs Target to below 4 Lbs M/C Shop YIPS Express Azziz Blitz ,Iliyas To Increase Per day production by 30% Avg daily production is 11 Target to 14 9 Brazing Courage Abdul Khader Fakrudeen To Reduce Brazing Leak rate Below 1% Current leak rate is 4.6 % Target- 1 % 10 M/C Shop S.N Line 1 2 CAC-1 CAC-2 7 CAC Tube shop 8 AHU Chiller 11 12 13 PSDOS (P ro blem so lving, Develop in g o f skill) Resistec Target description Krishna Current scrap is 1.8 Lbs Erwin,Malick To Reduce In Process scraps of Copper tubes Kumar Jha Target to below 0.5 Lbs Royal Challengers Anas Professional Aquil Hassan To Reduce In Process scraps of Copper tubes Current scrap is 7 Lbs Target to below 4 Lbs Resistec X1 Thaisen Jackson To Improve Efficiency of coating line Current Level is 2 NCN/Month Target- 0 NCN/Month Brazing Chiller Parts&Assy Tube shop Project description Coating Operations U & A Ashraful To Reduce Brazing Leak rate Below 1% ,Ajay Kumar together we can Current leak rate is 3.1 % Target- 1 % Quality Circle!
  • 13.
    GANT CHART-Full Program -Planned Description Intro+education+ team formation Define phase Training + project assign Measure phase training + data collection+ Brainstorming Analyze(Training+ Pareto chart) Improve Phase(Implementation) Control Phase training+ implement Operations U & A -Completed Plan/ Actual WK-12 WK13,14 WK15,16,17 WK18,19, WK 20-48 WK48-52 WK-52 PLAN ACTUAL PLAN ACTUAL PLAN ACTUAL PLAN ACTUAL PLAN ACTUAL PLAN ACTUAL together we can Quality Circle!
  • 14.
    ABOUT PROJECTS • Formatused – DMAIC Define, Measure, Analyze, Improve & Control • Periodical training & meeting conducted. • Internal meeting conducted by team leaders in work place every month to define their own stage problems. Operations U & A together we can Quality Circle!
  • 15.
    ABOUT PROJECTS • Toolsused - Pareto chart - Cause and Effect diagram - FDM(Function Deployment Matrix) - Brainstorming - Check sheets Operations U & A together we can Quality Circle!
  • 16.
    Improvements observed • EachProject working on minimum 2 problems which is to improve on their stage. • Total 32 improvements related to their own stage is in progress. Operations U & A together we can Quality Circle!
  • 17.
    Major improvements Return BendLeak rate reduction in CAC-1 (Team-Rose riders & speed riders) Brazing Leak reduction in AHU & Applied Coil shop (Team-Seven star brazers, Courage& Royal challengers) Leak rate-2.1% Leak rate-1.1% Action Taken: 1.Check sheet displayed to monitor the leak from every stage. 2.Input Butane pressure regularized by placing adjustable pressure gauge. 3.Practicing Pre heat to reduce oil level in flare.(if found more oil on flares) 4.Continual feed back system by internal operator itself. Leak rate-3.0% Operations U & A Leak rate-1.0% together we can Quality Circle!
  • 18.
    IMPROVEMENTS Location:CAC-1 Brazing Area Team-Roseriders Type: Quality Improvement (Leak rate reduction) Before Improvement N2 IN After Improvement Return bend storage box Return bend storage box Return bend storage box N2 OUT In progress Dust and moisture accumulate on return bend which is stored in box can creates corrosion and cause leak Return bend stored box will arrange and N2 gas will insert in serial to all box, so that external moisture will not enter. Effect on implementation: Return bend leak rate will be reduce 18 Improve Operations U & A together we can Quality Circle!
  • 19.
    IMPROVEMENTS Location: CAC2 Machineshop Team- Fire Crackers Type: Productivity Improvement Before Improvement After Improvement Photos attached on next slide Photos attached on next slide Process In progress After Process sheet obtain from scheduling, in coil shop there exist manual editing for coil size and hair pin Qty which creates wrong coil due to wrong entry. With the help of Scheduling process sheet changed with required data to produce coil without manual editing Effect on implementation: Wrong coil assembly will reduce 19 Improve Operations U & A together we can Quality Circle!
  • 20.
    Process sheet-Current Operations U& A together we can Quality Circle!
  • 21.
    Modified Process sheet OperationsU & A together we can Quality Circle!
  • 22.
    IMPROVEMENTS Location: AHU BrazingArea Team-Royal Challengers Type: Quality Improvement (Leak rate reduction) Before Improvement Gas pressure was not proper due to flux blockage ,lengthy hose and hose frequent damage. After Improvement Brazing hose arranged and standardized by extending steel pipe up to brazing stage to make hose length short and constant gas pressure. Effect on implementation: Constant gas pressure obtain thus leak rate will reduce 22 Improve Operations U & A together we can Quality Circle!
  • 23.
    IMPROVEMENTS Location: Resistec Team-Resistec 11 Type:Productivity Improvement Before Improvement Coils were coated by keeping on drums. Coating done on one face and hold it for drying about 6 hrs and then coating on the opposite side.. After Improvement Moving trolley made with hanging system, Now coils will coat/spray and directly move to the oven without lifting the coils Effect on implementation: Process time reduction with improved Quality 23 Improve Operations U & A together we can Quality Circle!
  • 24.
    IMPROVEMENTS Location: Chiller Team-Courage Type: Productivityand Quality Improvement Before Improvement After Improvement In Progress During Crimping for valve insertion in Evap coil, there no flare exist, which cause difficulties in brazing tends to leak occur Design of crimping tool need to alter by cutting a slot in tool of flare rest area. Effect on implementation: Process time reduction with improved Quality 24 Improve Operations U & A together we can Quality Circle!
  • 25.
    IMPROVEMENTS Location: CAC TubeShop Team-Perfect Type Productivity and scrap reduction Improvement Before Improvement In straight tube cutting machine roll end tube not able to cut due to machine limitation After Improvement Manual cutting machine ordered so as to cut roll end tube at instant, by this minimum length can be cut according to our process requirement. Effect on implementation: Cu tube Scrap due to roll end will totally eliminate. 25 Improve Operations U & A together we can Quality Circle!
  • 26.
    Various improvements • CUScrap reduction by introducing – Tube clamping system to standardize the cutting angle. • Process improvement – AHU brazing carried out in sequence table to increase productivity Operations U & A together we can Quality Circle!
  • 27.
    Operations U &A together we can Quality Circle!
