Planning: Part I
Evaluation of Necessity and Feasibility

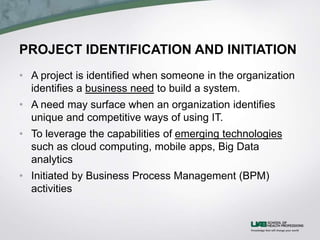

PROJECT IDENTIFICATION AND INITIATION
• A project is identified when someone in the organization
identifies a business need to build a system.
• A need may surface when an organization identifies
unique and competitive ways of using IT.
• To leverage the capabilities of emerging technologies
such as cloud computing, mobile apps, Big Data
analytics
• Initiated by Business Process Management (BPM)
activities

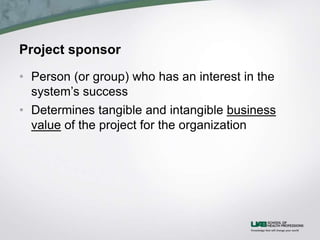

Project sponsor
• Person (or group) who has an interest in the
system’s success
• Determines tangible and intangible business
value of the project for the organization

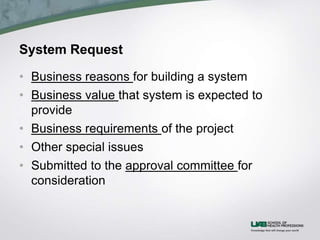

System Request
• Business reasons for building a system
• Business value that system is expected to
provide
• Business requirements of the project
• Other special issues
• Submitted to the approval committee for
consideration

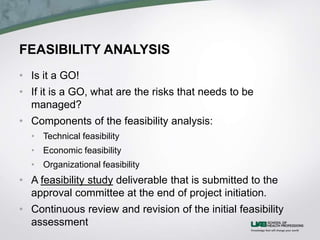

FEASIBILITY ANALYSIS
• Is it a GO!
• If it is a GO, what are the risks that needs to be
managed?
• Components of the feasibility analysis:
• Technical feasibility
• Economic feasibility
• Organizational feasibility
• A feasibility study deliverable that is submitted to the
approval committee at the end of project initiation.
• Continuous review and revision of the initial feasibility
assessment
Technical Feasibility
• Evaluating if the IT group is capable of carrying
out the development and/or implementation
• Technical risk analysis: Can our IT build and/or
implement it?
• Considerations:
• Users’ and analysts’ familiarity with the application
• Familiarity with the technology
• Project size
• Compatibility of the new system with the technology
that already exists
Economic Feasibility
• Analysis of cost and benefit: “Should we build the
system?”
• Usually, benefits of IT projects are not immediate
• Techniques to estimate cost-benefit over-time
• Simple Cash Flow
• Discounted Cash Flow
• Measures to determine economic feasibility
• Return on Investment (ROI)
• Break-Even Point (BEP)
• Net Present Value (NPV)
• Steps of Economic Feasibility Analysis
Simple and discounted cash flow projection

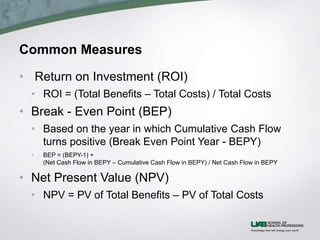

Common Measures
• Return on Investment (ROI)
• ROI = (Total Benefits – Total Costs) / Total Costs
• Break - Even Point (BEP)
• Based on the year in which Cumulative Cash Flow
turns positive (Break Even Point Year - BEPY)
• BEP = (BEPY-1) +
(Net Cash Flow in BEPY – Cumulative Cash Flow in BEPY) / Net Cash Flow in BEPY
• Net Present Value (NPV)
• NPV = PV of Total Benefits – PV of Total Costs
Steps of Economic Feasibility Analysis
• Identify Costs and Benefits
• Development costs
• Operational costs
• Tangible benefits
• Intangible benefits
• Assign Values to Costs
and Benefits
• Determine Cash Flow
• Assess Project’s Economic Value
• ROI
• BEP
• NPV
Cost-Benefit Analysis
Discounted cash flow method and NPV preferred

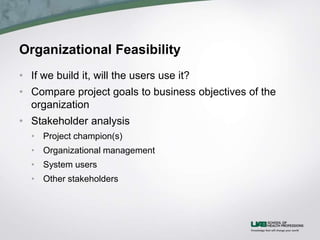

Organizational Feasibility
• If we build it, will the users use it?
• Compare project goals to business objectives of the
organization
• Stakeholder analysis
• Project champion(s)
• Organizational management
• System users
• Other stakeholders

Hi600 m1 u1_part2_instslides

  • 1.
    Planning: Part I Evaluationof Necessity and Feasibility
  • 2.
    PROJECT IDENTIFICATION ANDINITIATION • A project is identified when someone in the organization identifies a business need to build a system. • A need may surface when an organization identifies unique and competitive ways of using IT. • To leverage the capabilities of emerging technologies such as cloud computing, mobile apps, Big Data analytics • Initiated by Business Process Management (BPM) activities
  • 3.
    Project sponsor • Person(or group) who has an interest in the system’s success • Determines tangible and intangible business value of the project for the organization
  • 4.
    System Request • Businessreasons for building a system • Business value that system is expected to provide • Business requirements of the project • Other special issues • Submitted to the approval committee for consideration
  • 5.
    FEASIBILITY ANALYSIS • Isit a GO! • If it is a GO, what are the risks that needs to be managed? • Components of the feasibility analysis: • Technical feasibility • Economic feasibility • Organizational feasibility • A feasibility study deliverable that is submitted to the approval committee at the end of project initiation. • Continuous review and revision of the initial feasibility assessment
  • 6.

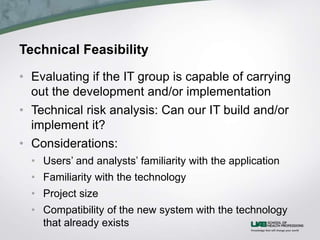

    Technical Feasibility • Evaluatingif the IT group is capable of carrying out the development and/or implementation • Technical risk analysis: Can our IT build and/or implement it? • Considerations: • Users’ and analysts’ familiarity with the application • Familiarity with the technology • Project size • Compatibility of the new system with the technology that already exists
  • 7.

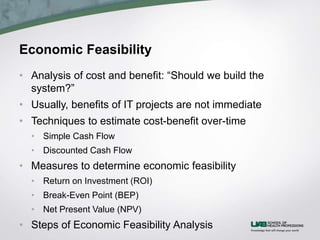

    Economic Feasibility • Analysisof cost and benefit: “Should we build the system?” • Usually, benefits of IT projects are not immediate • Techniques to estimate cost-benefit over-time • Simple Cash Flow • Discounted Cash Flow • Measures to determine economic feasibility • Return on Investment (ROI) • Break-Even Point (BEP) • Net Present Value (NPV) • Steps of Economic Feasibility Analysis
  • 8.

    Simple and discountedcash flow projection
